Come Live, Life's Little Treasures. Presenting Brigade Woods, just a handful of woods inspired dream homes that run a gamut of comforts to appeal to both kinds. Home to over 17 different species of flora, Brigade Woods is an exemplary project where nature and modern infrastructure entwine harmoniously. Located in Whitefield, one of the most exciting neighbourhoods in Bangalore, Brigade Woods is next to Brigade Tech Park and is surrounded by IT Parks, hospitals, banks, restaurants and reputed educational institutions. The location is known for its thriving social community and physical infrastructure.

Media

Other downloads

Master plans / Floor plans

Masterplan

Download

Typical Floorplans

Download

Application Form

Allotment Form

Download

3D Virtual Tour

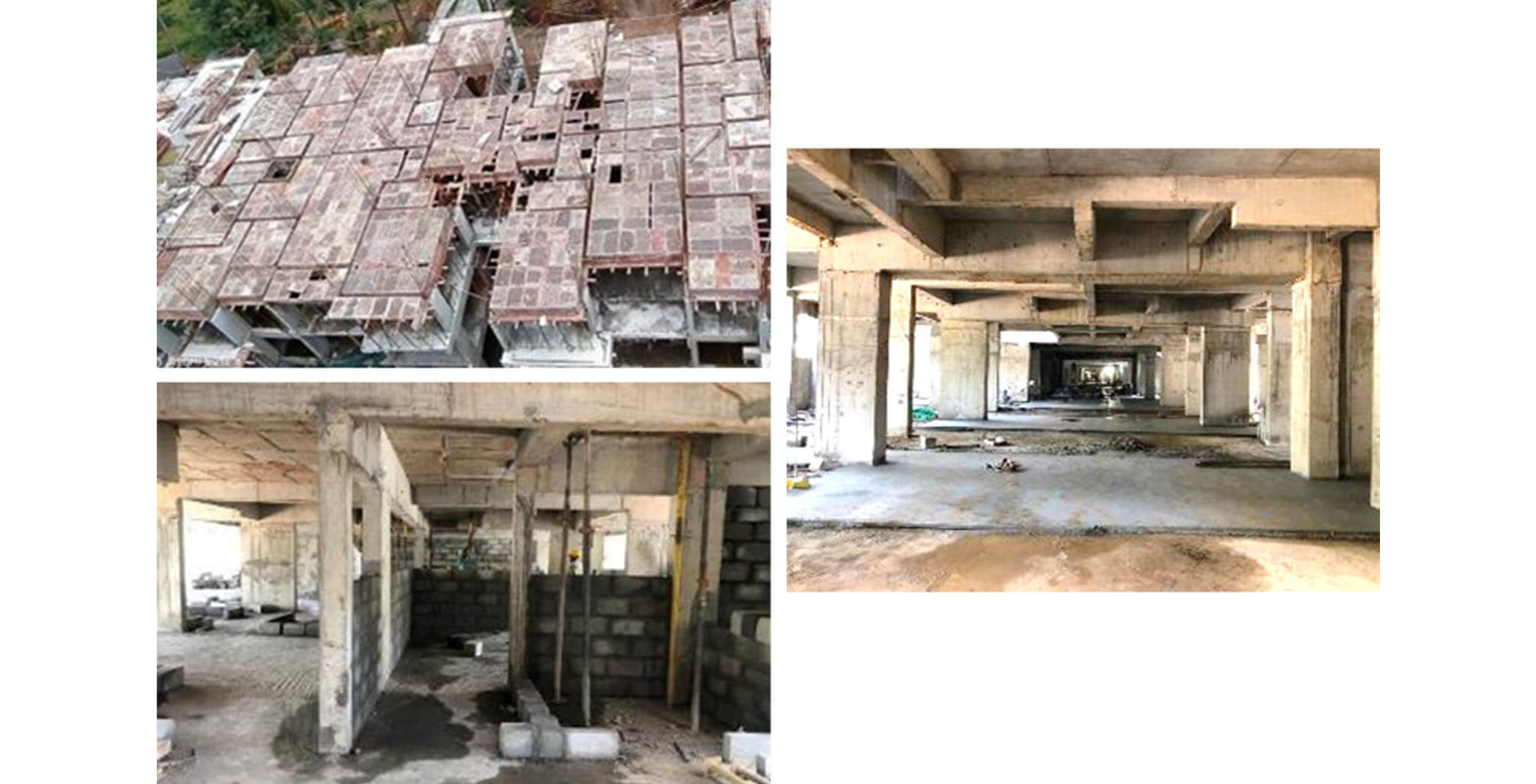

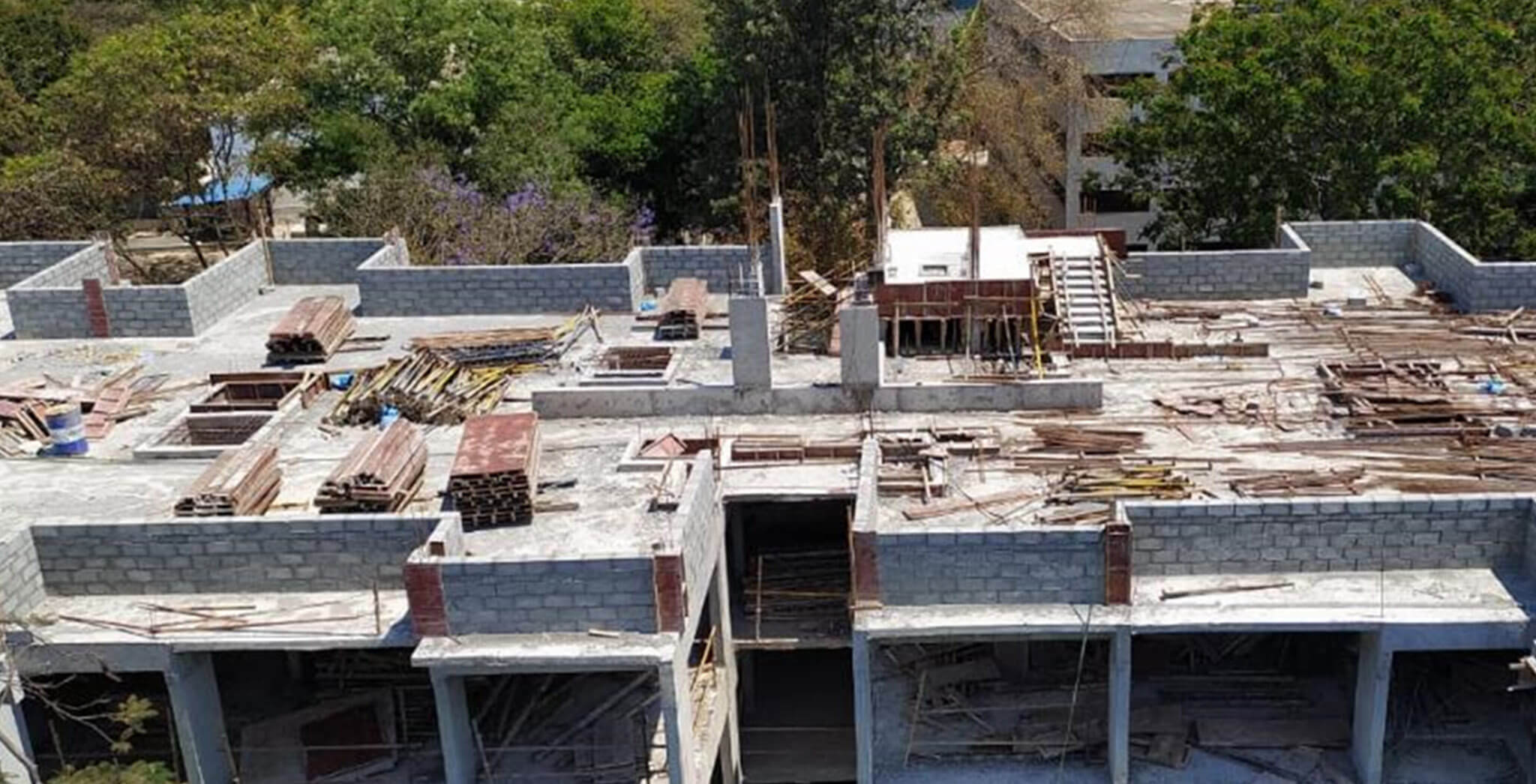

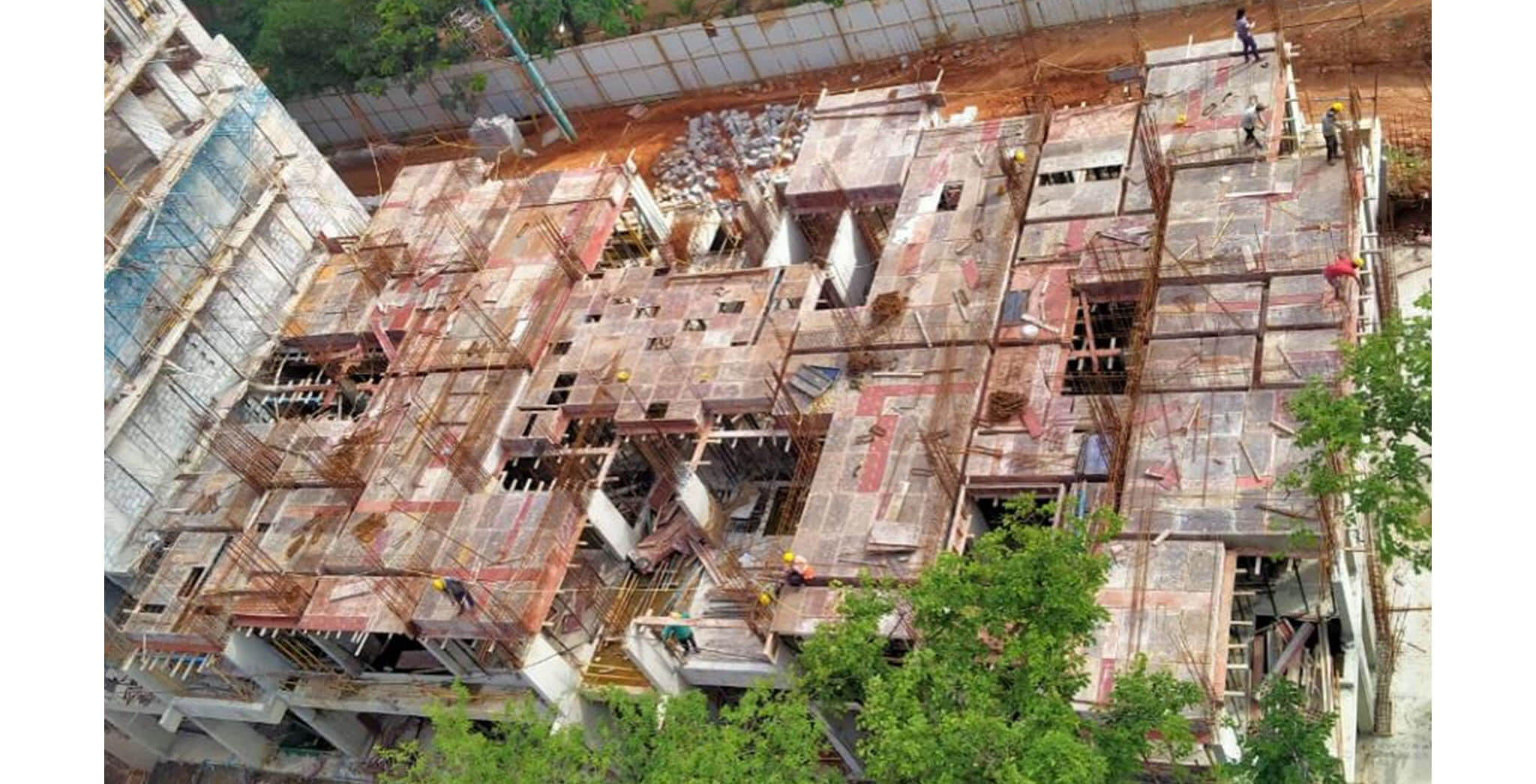

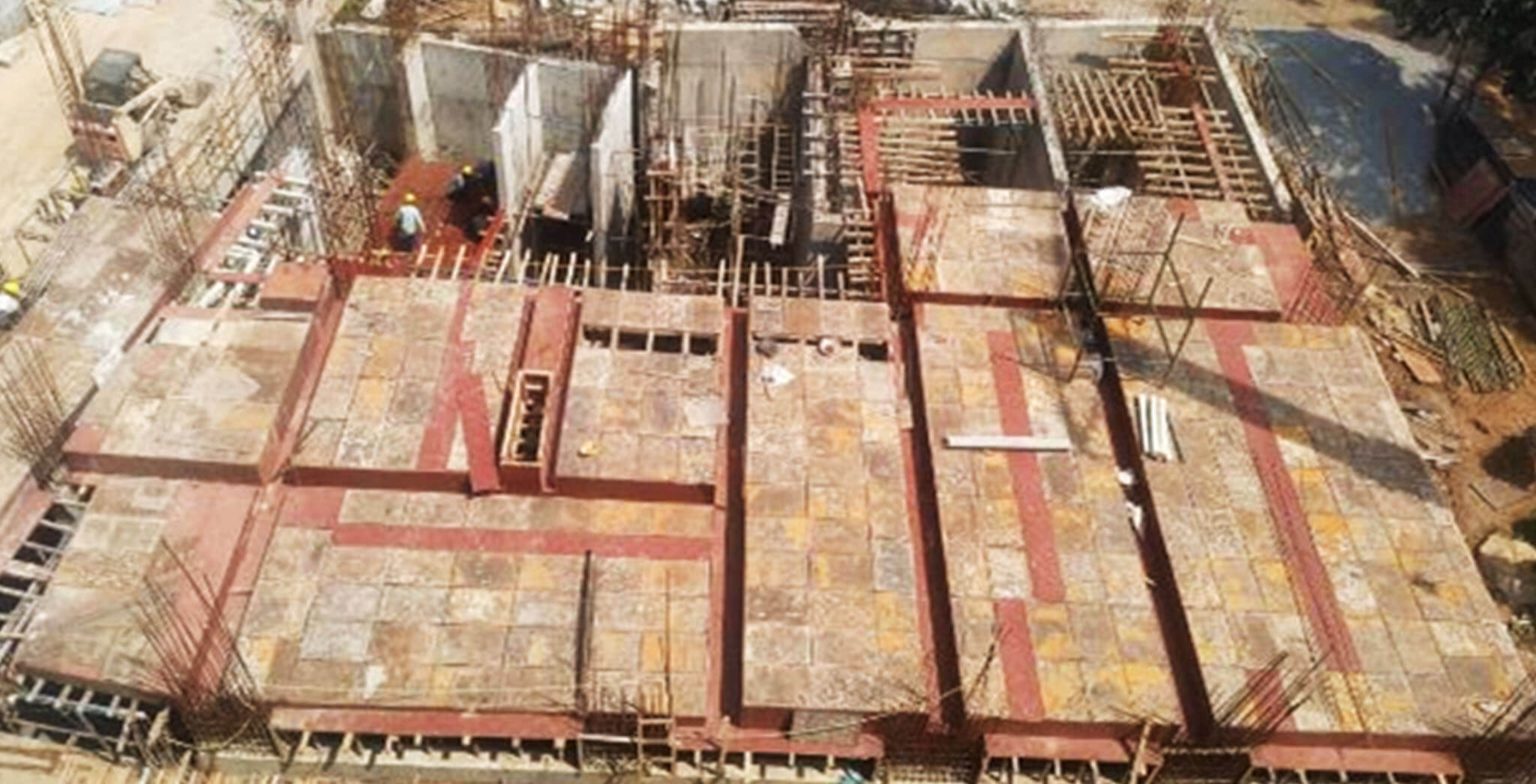

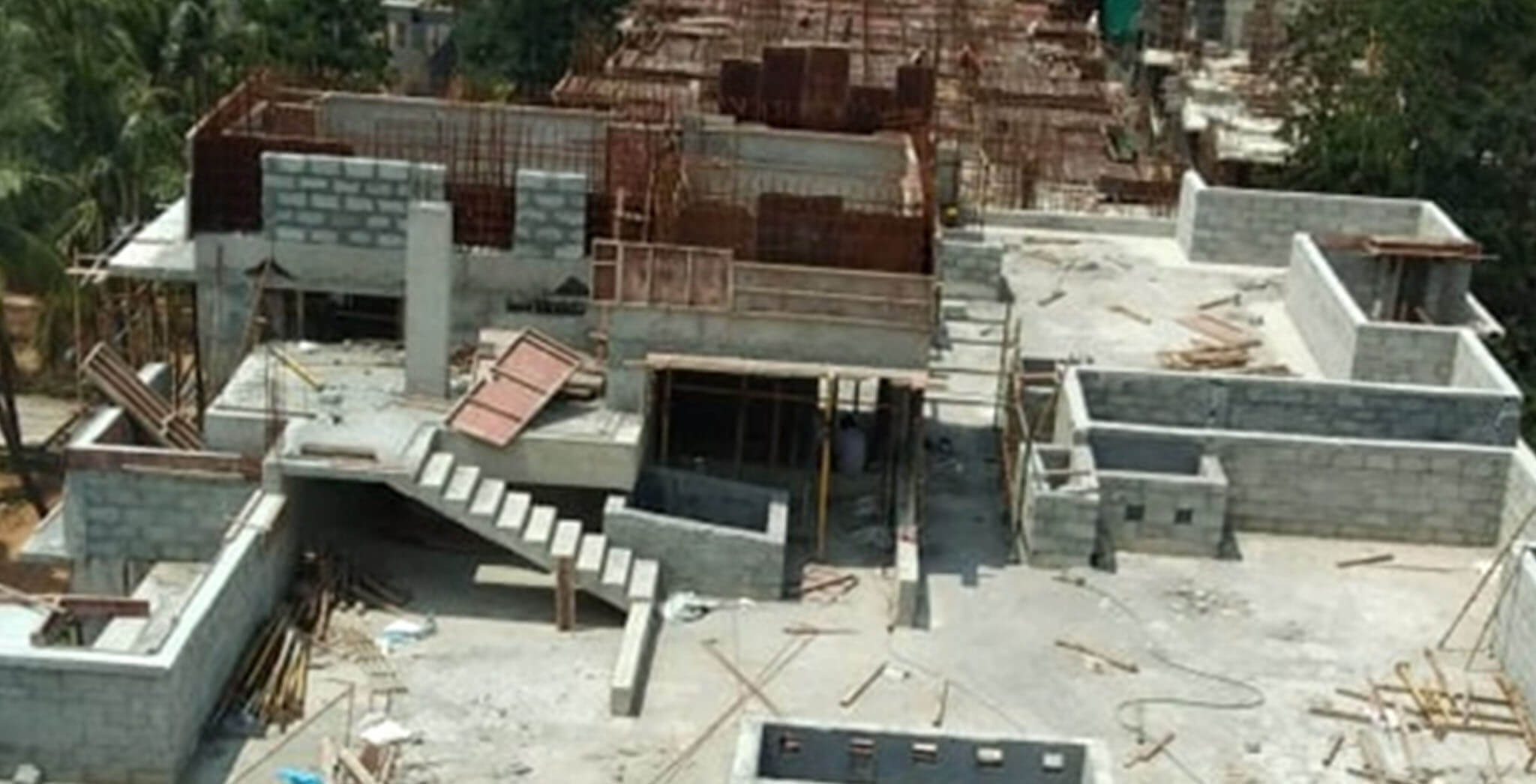

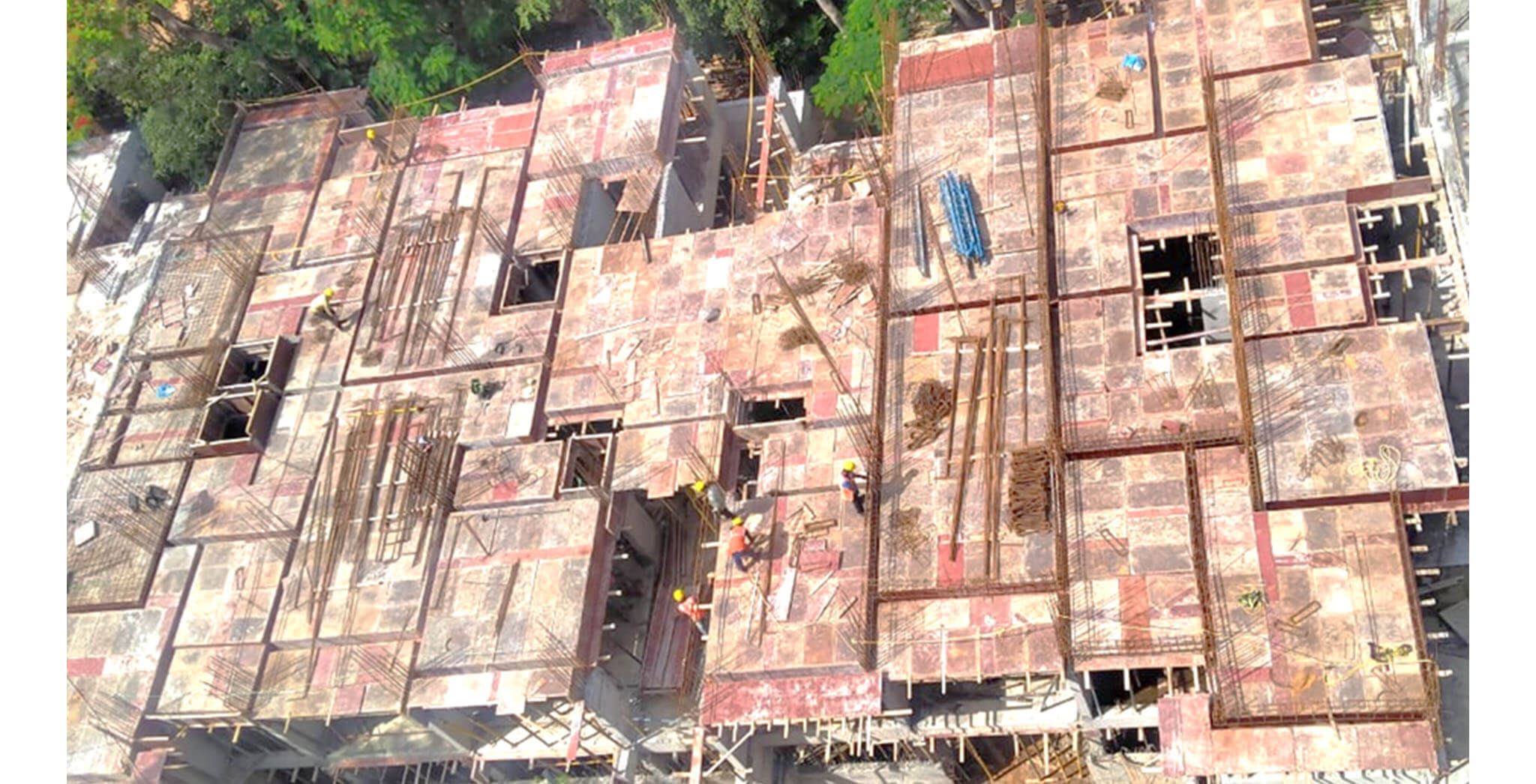

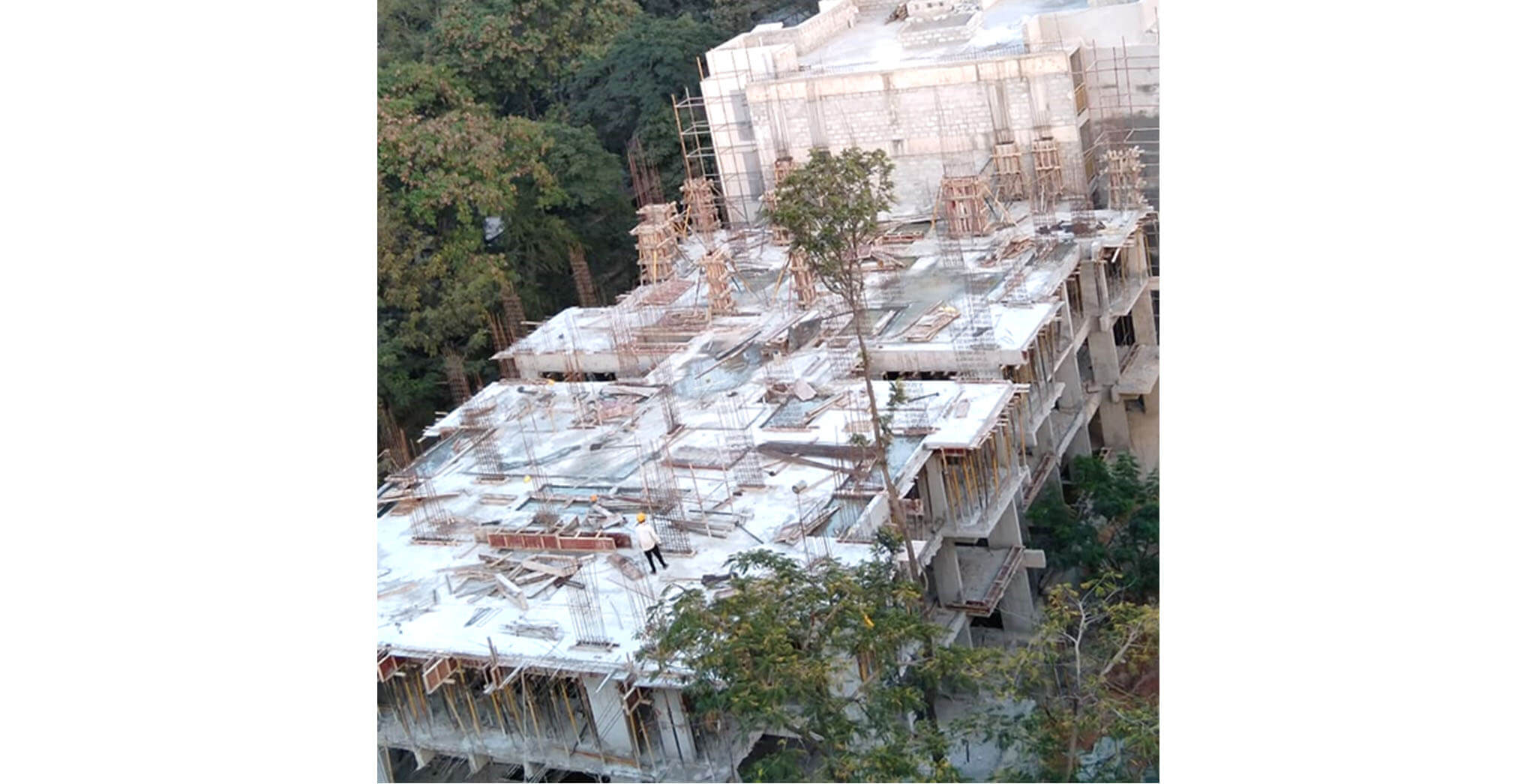

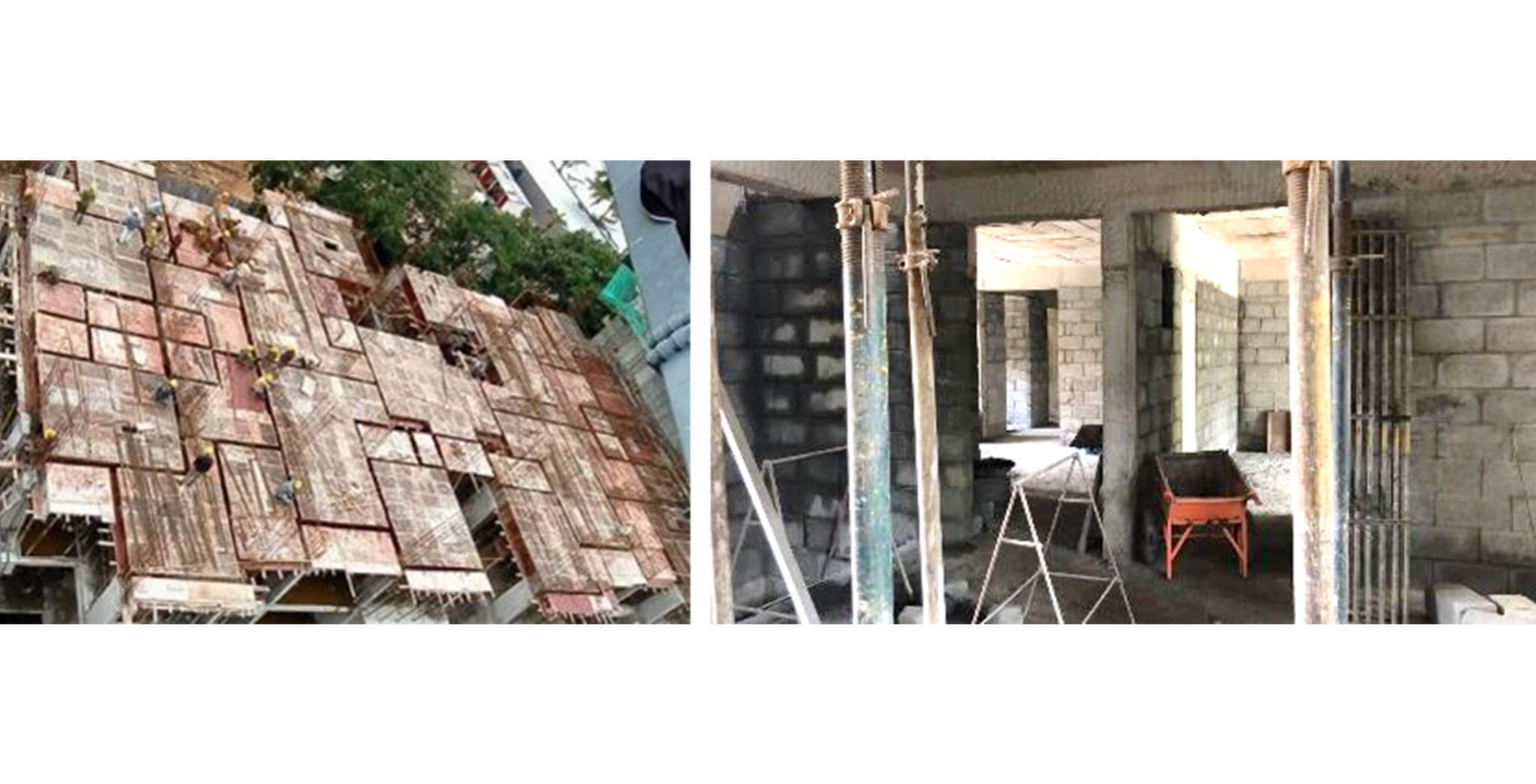

Status Gallery

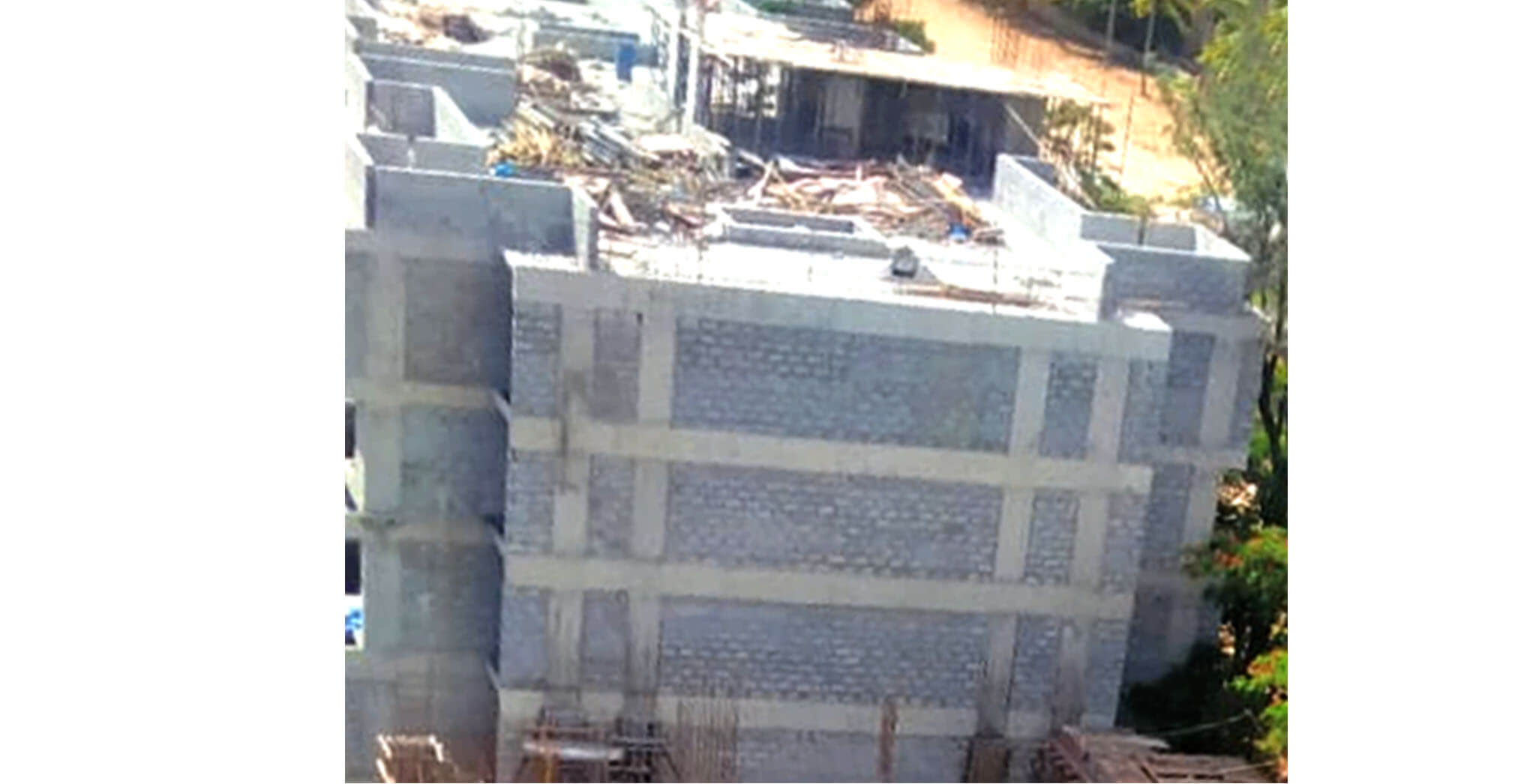

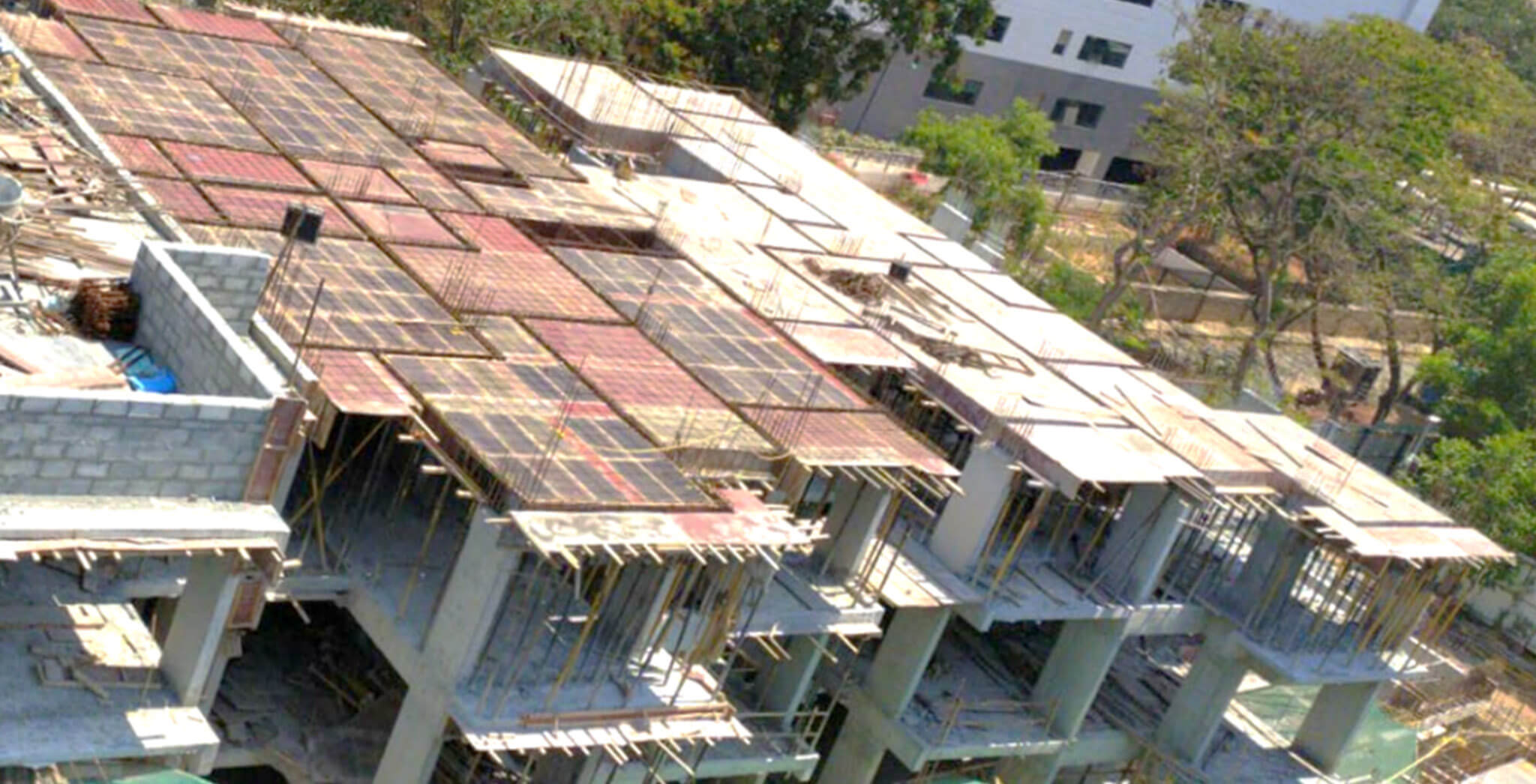

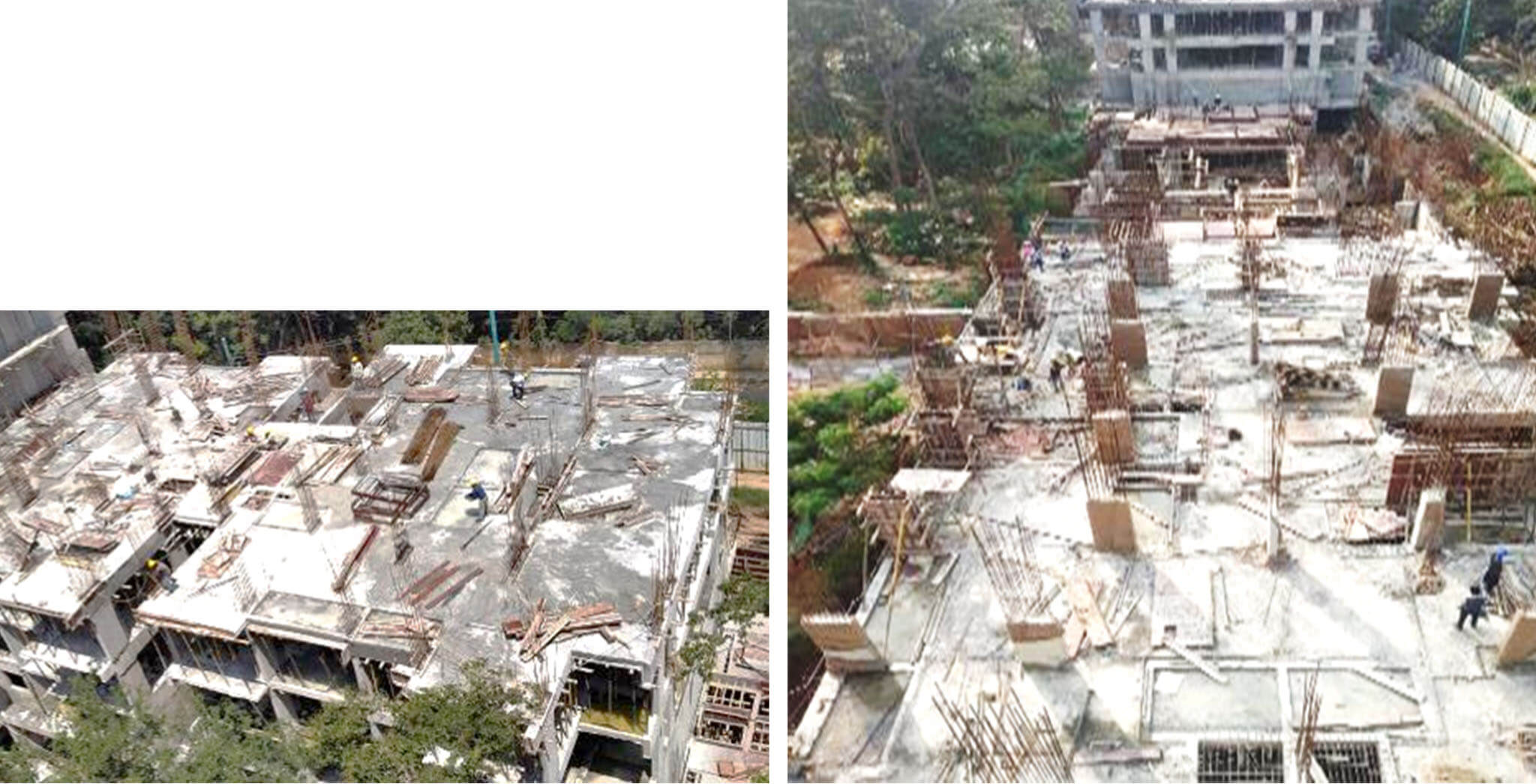

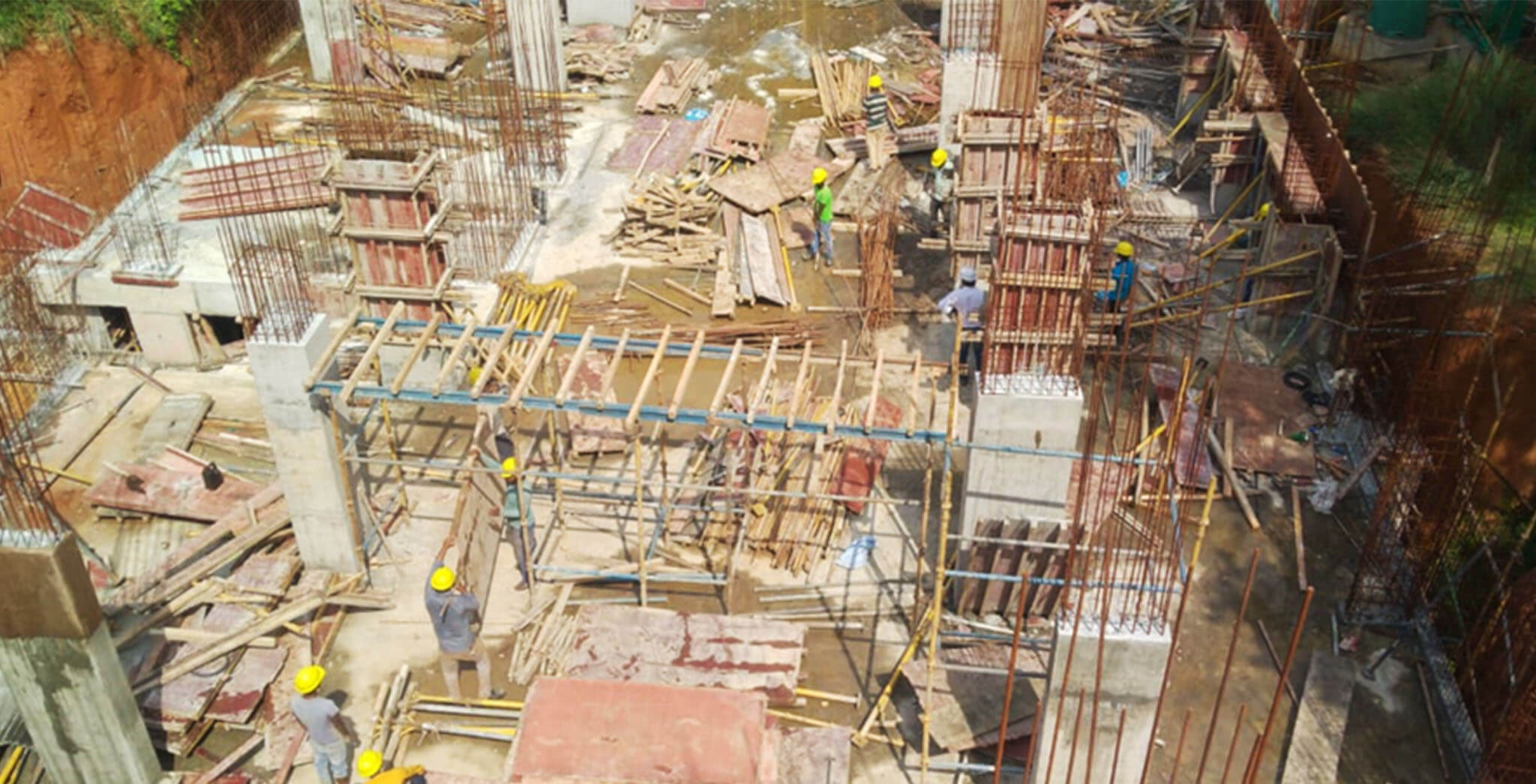

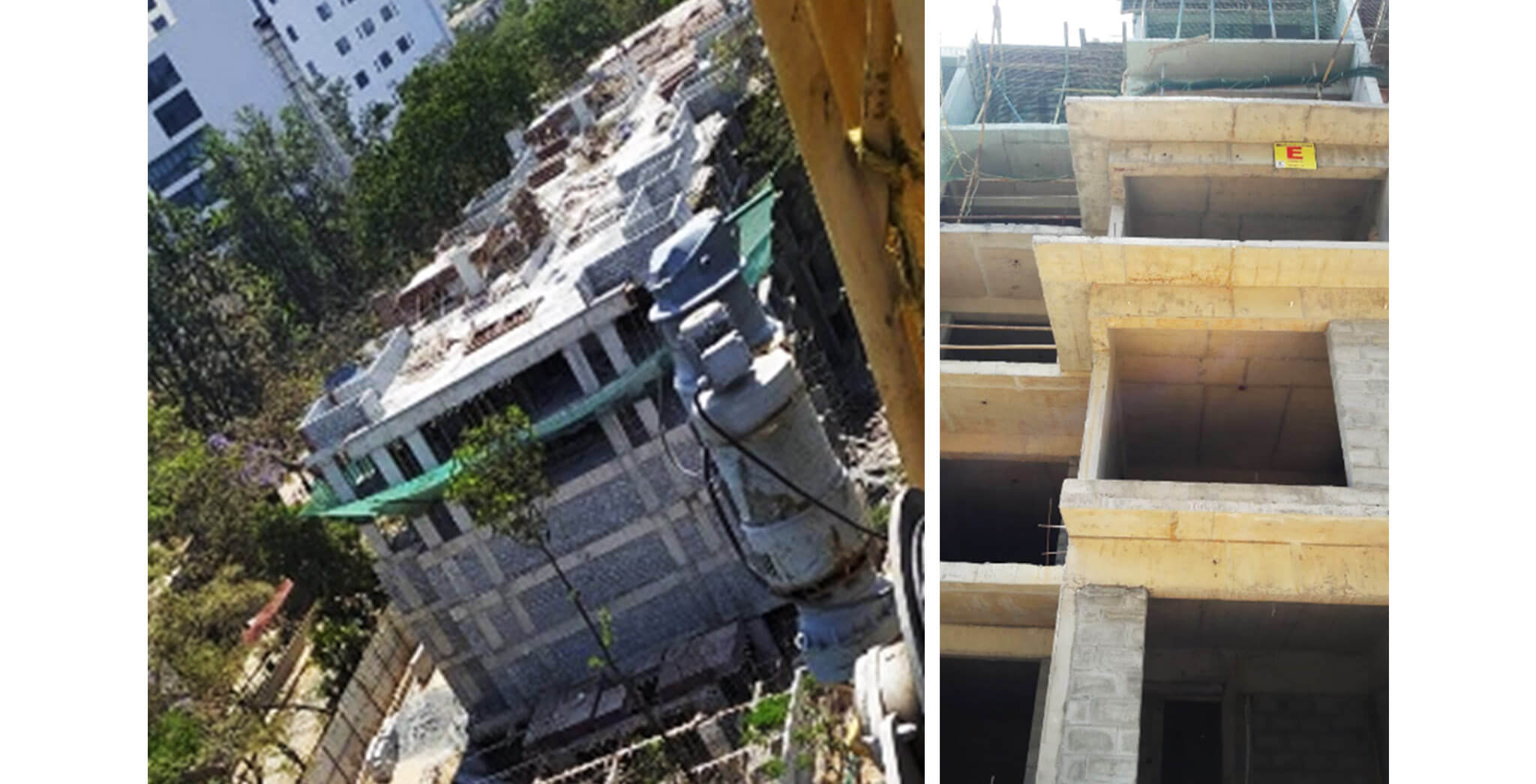

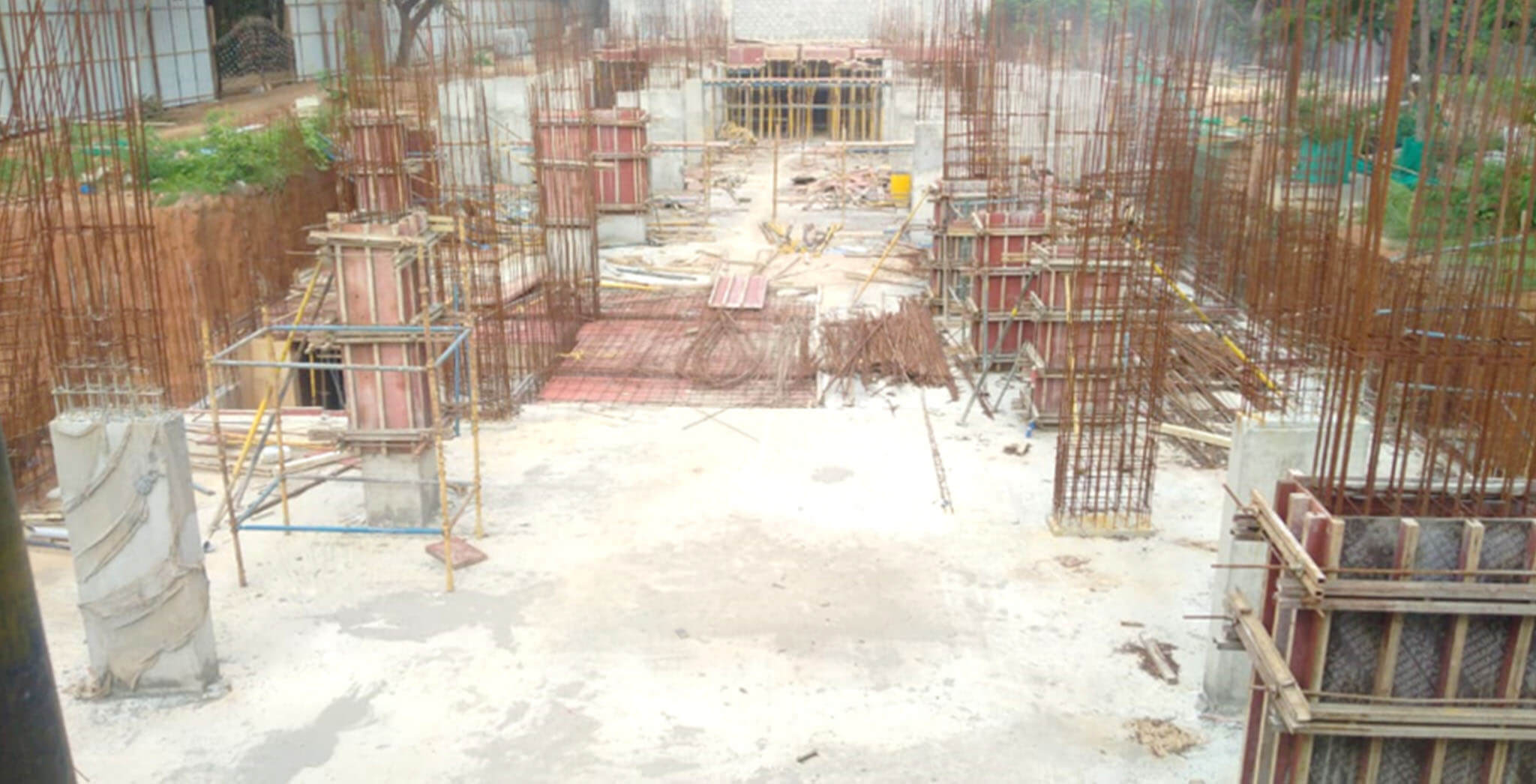

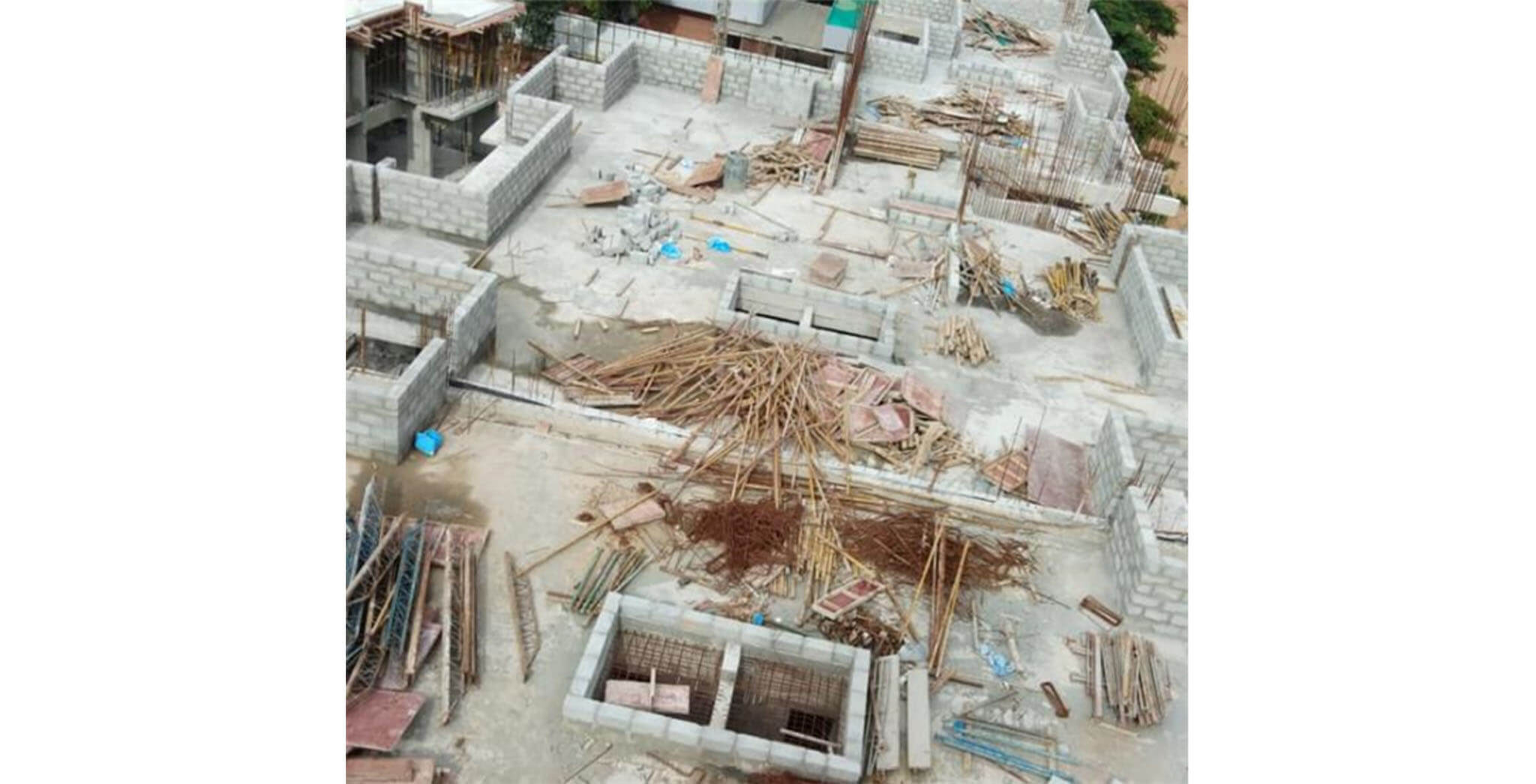

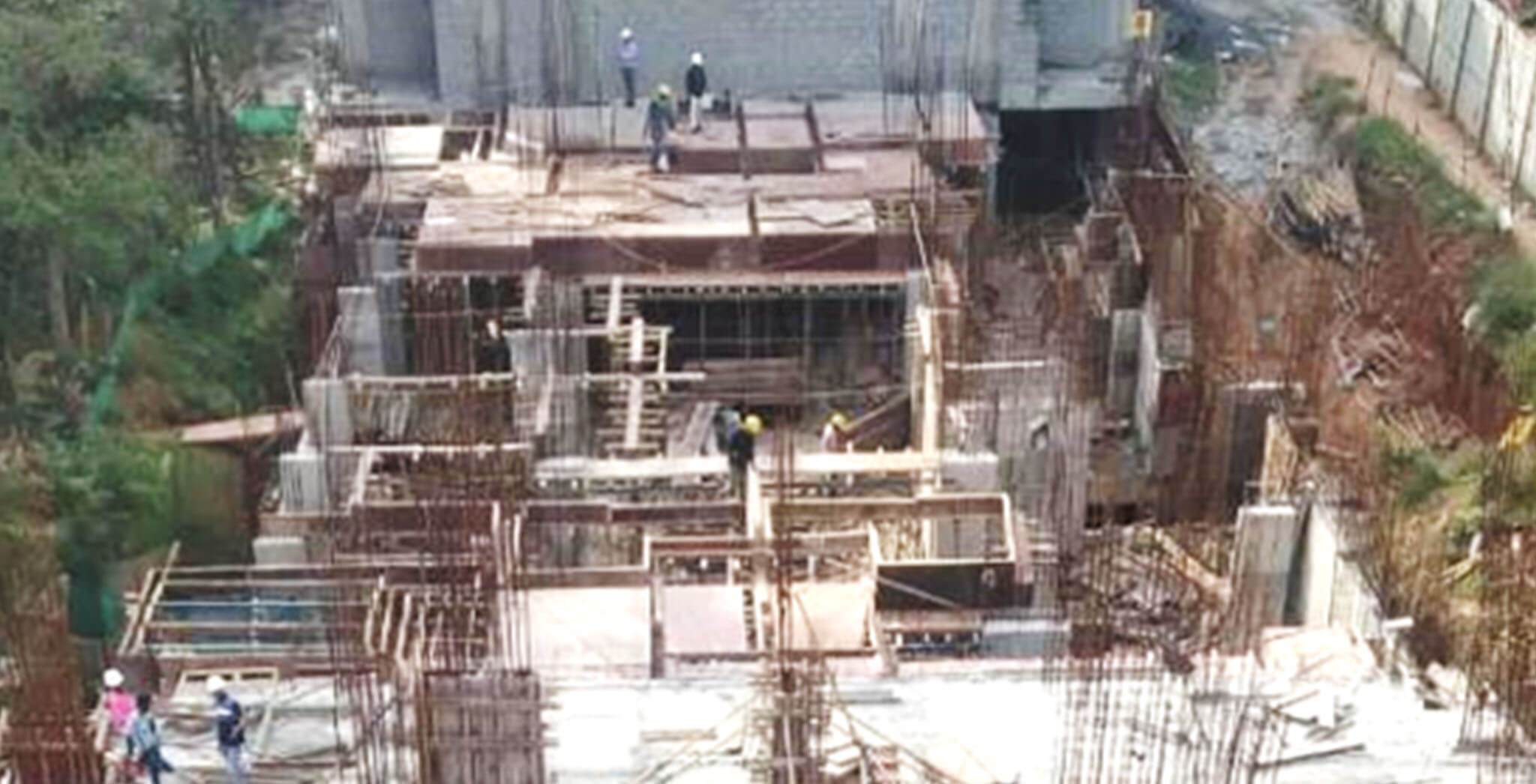

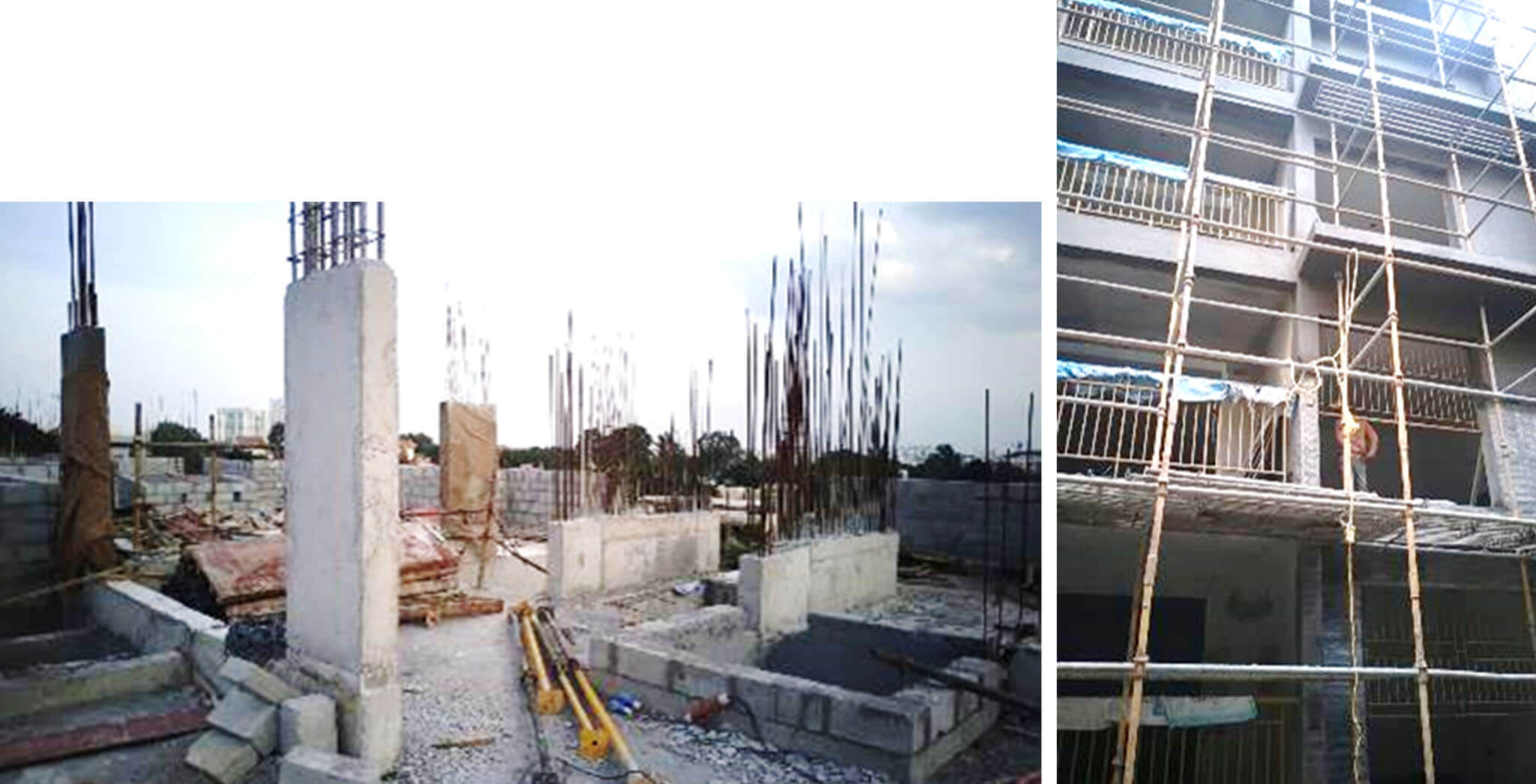

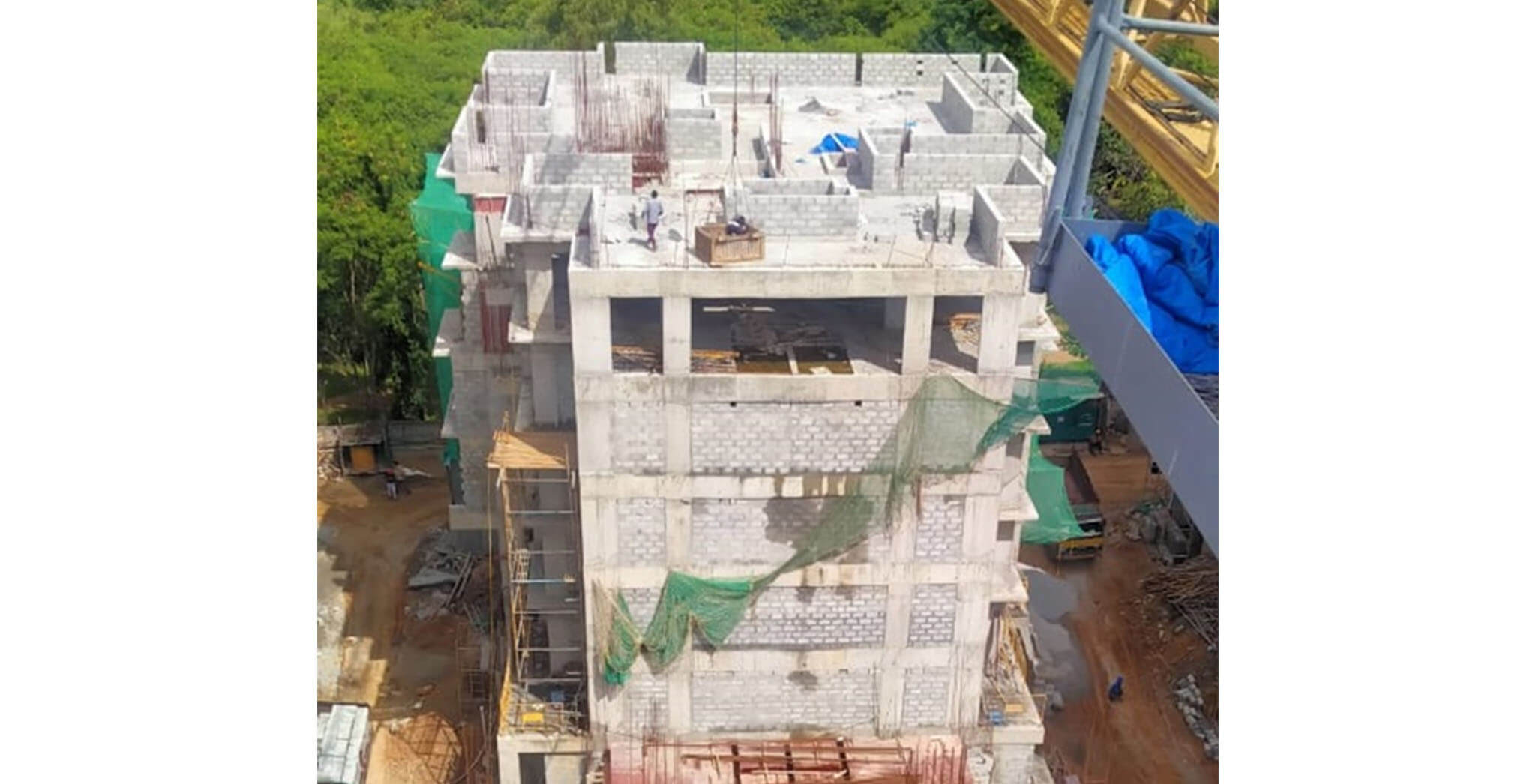

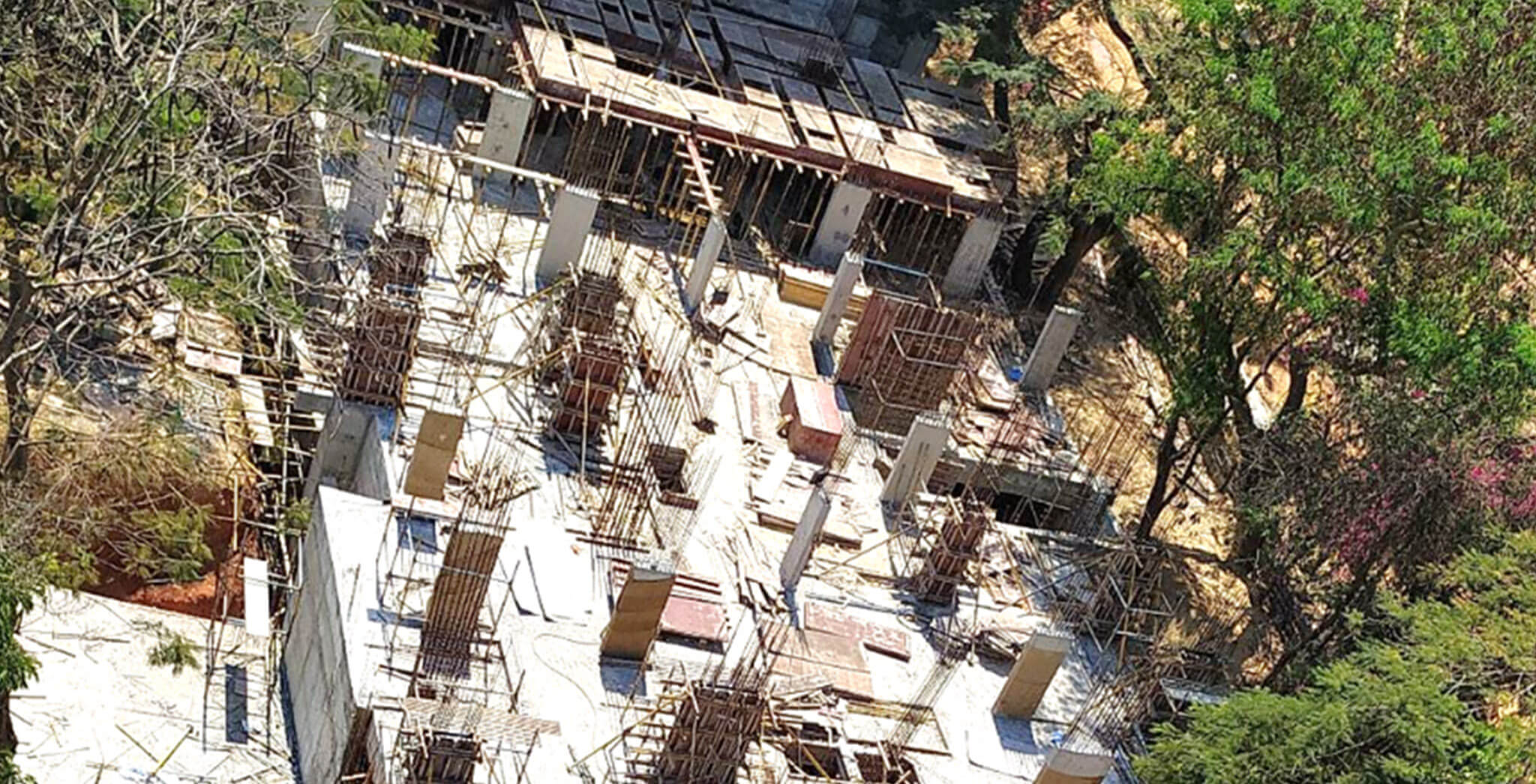

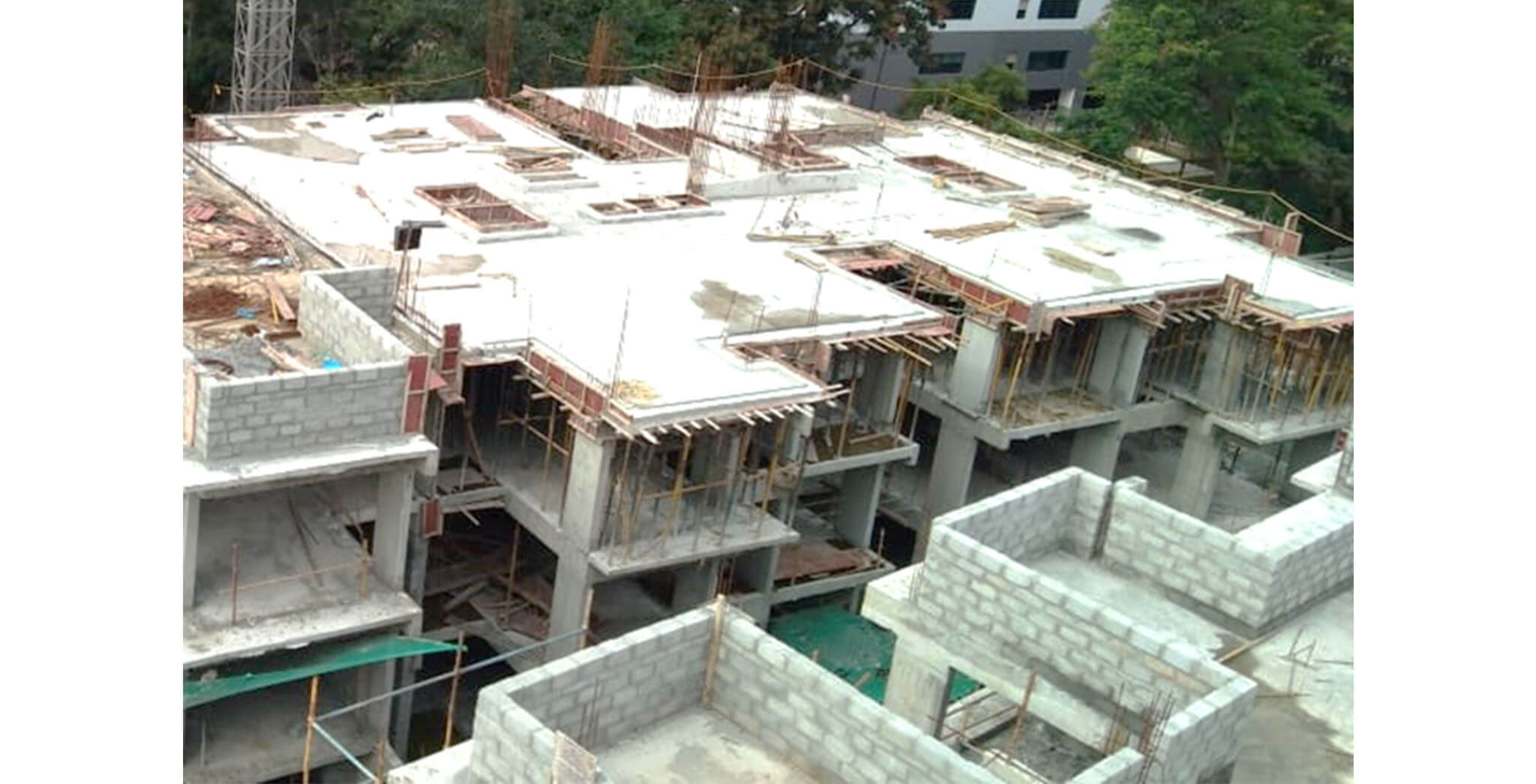

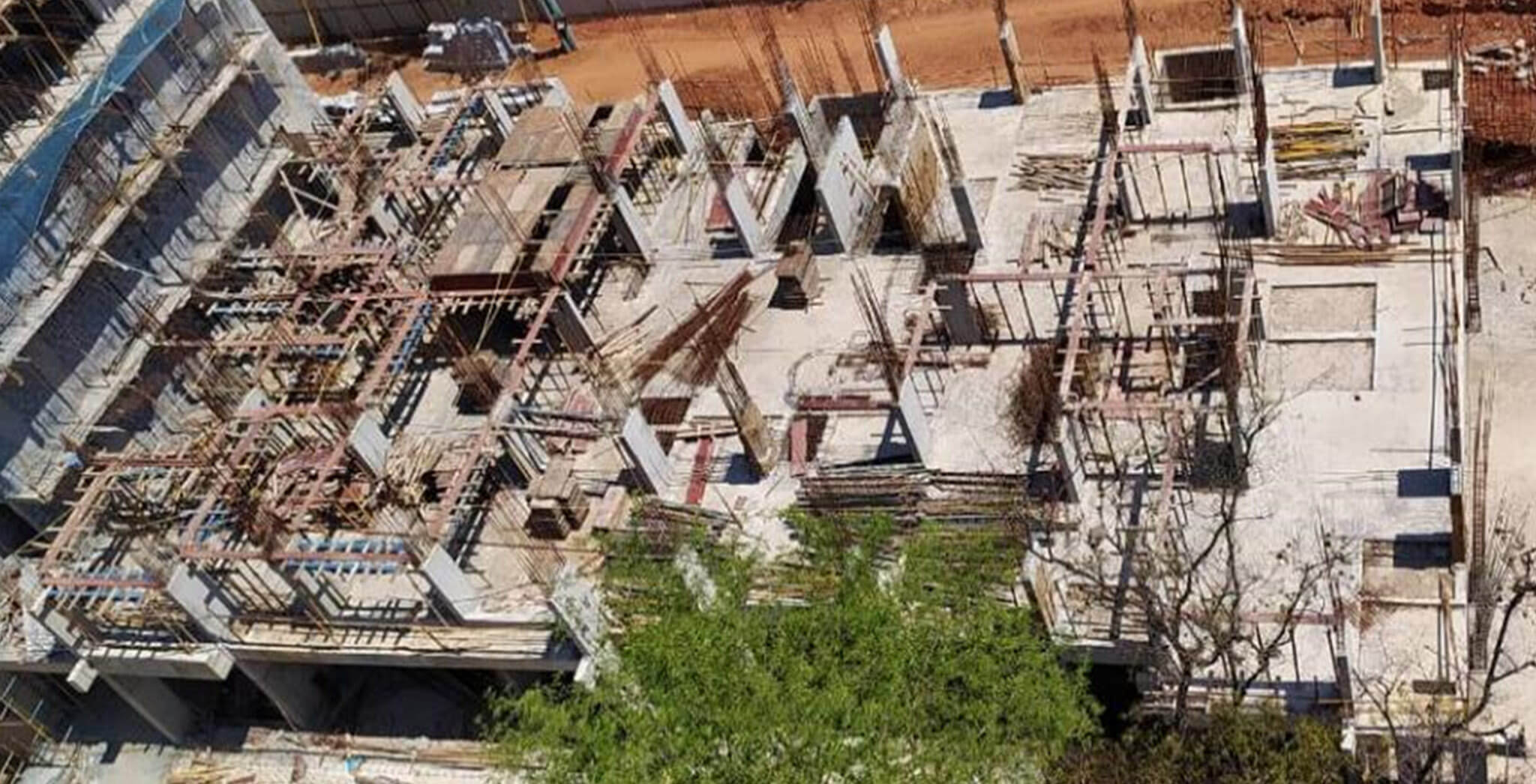

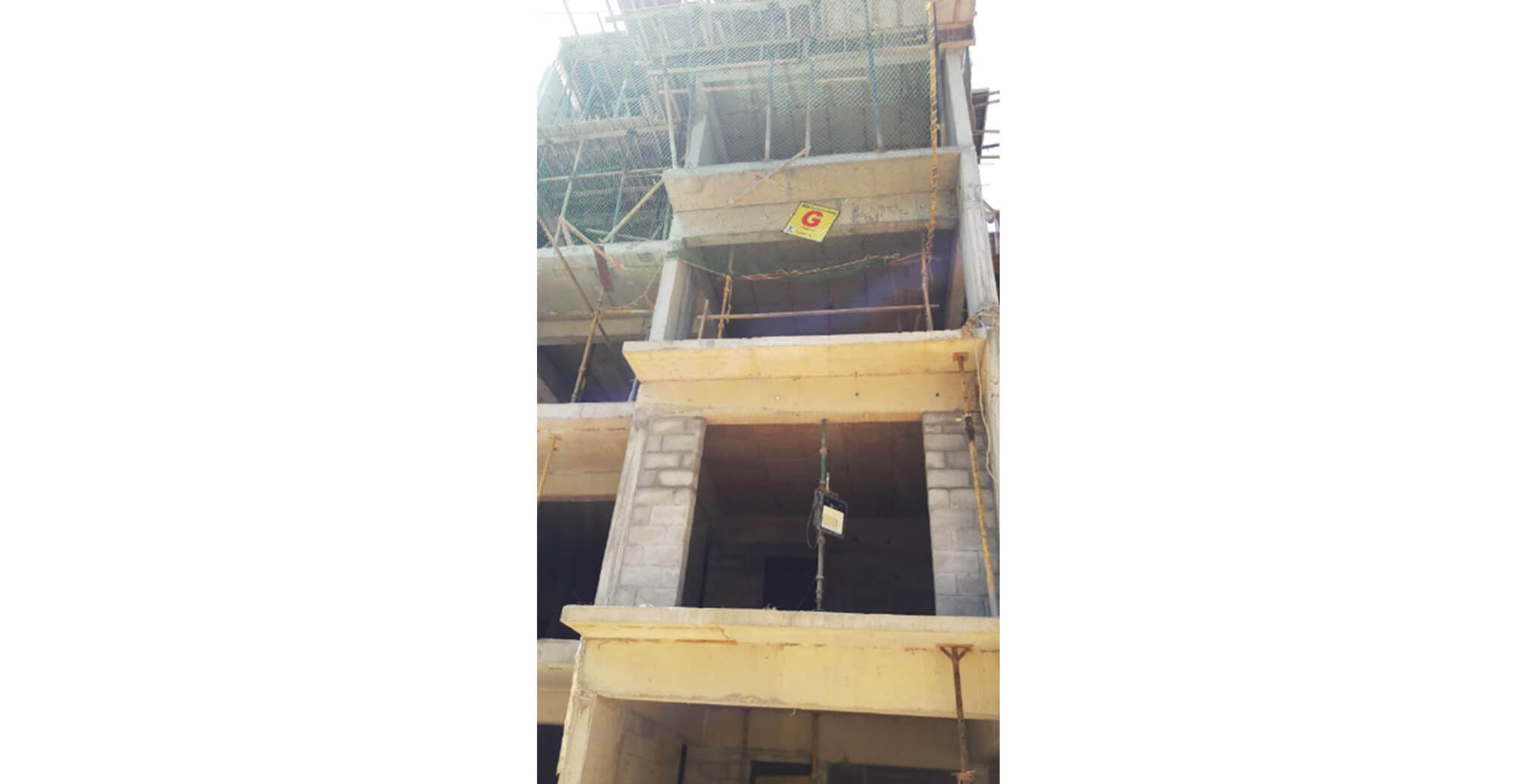

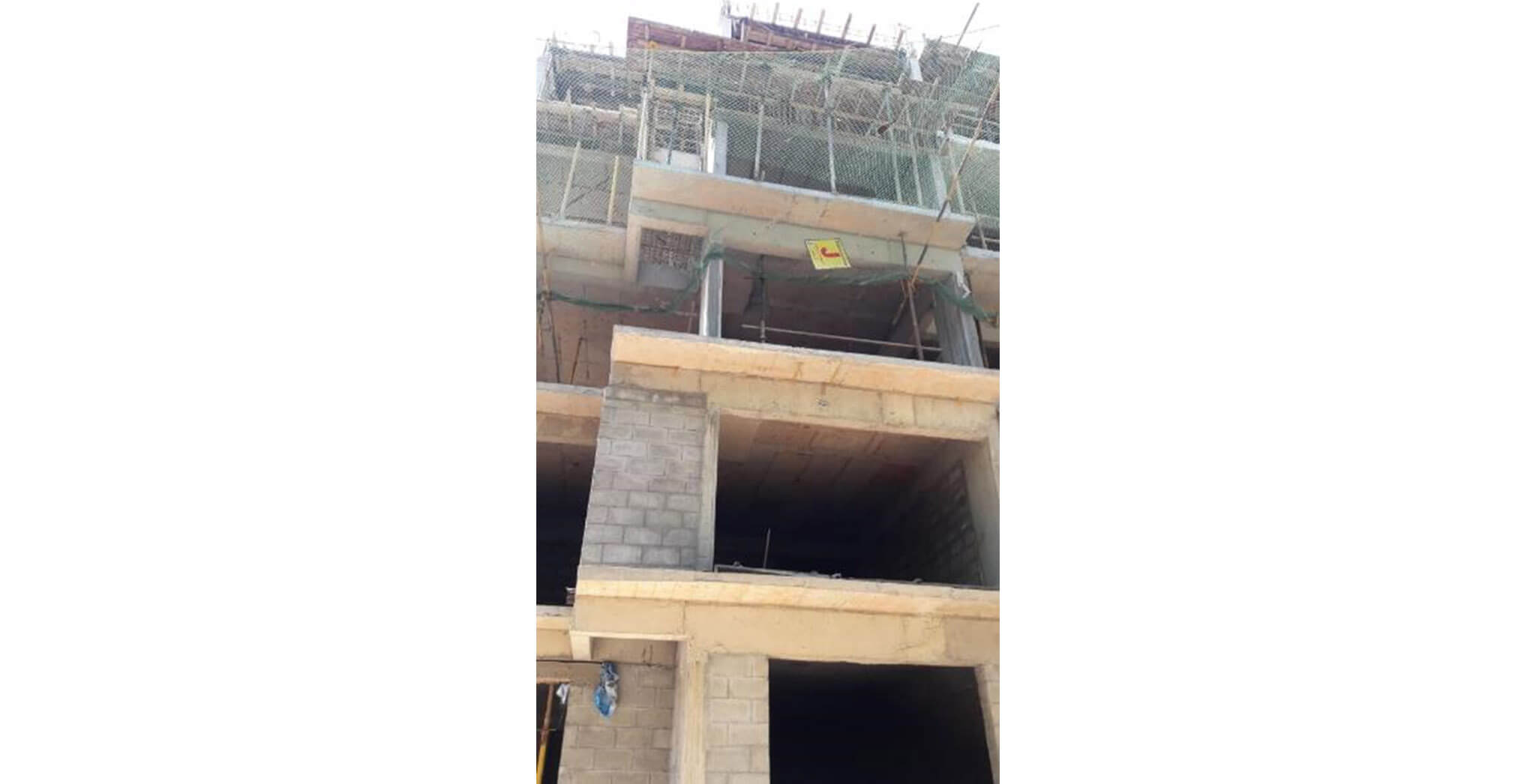

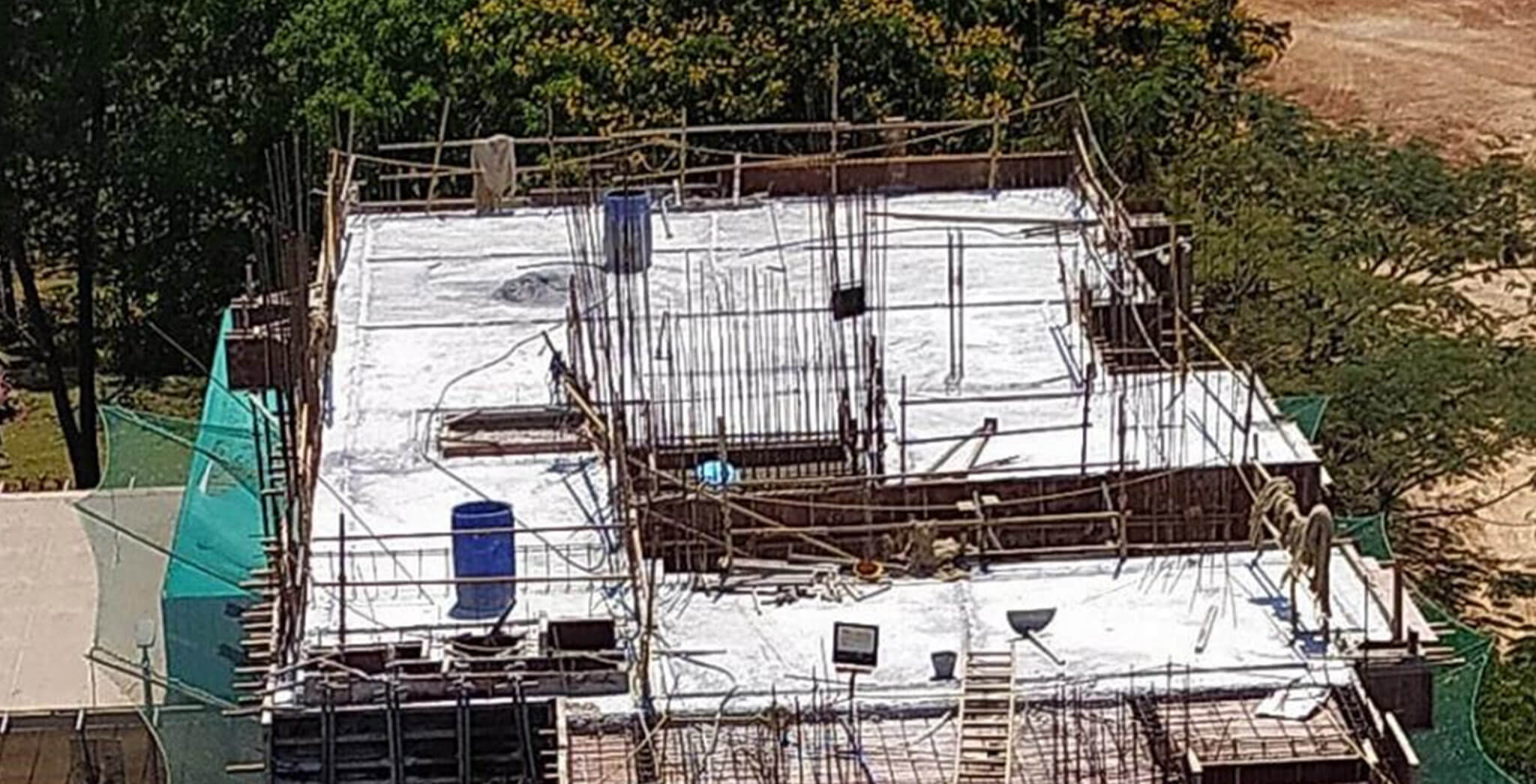

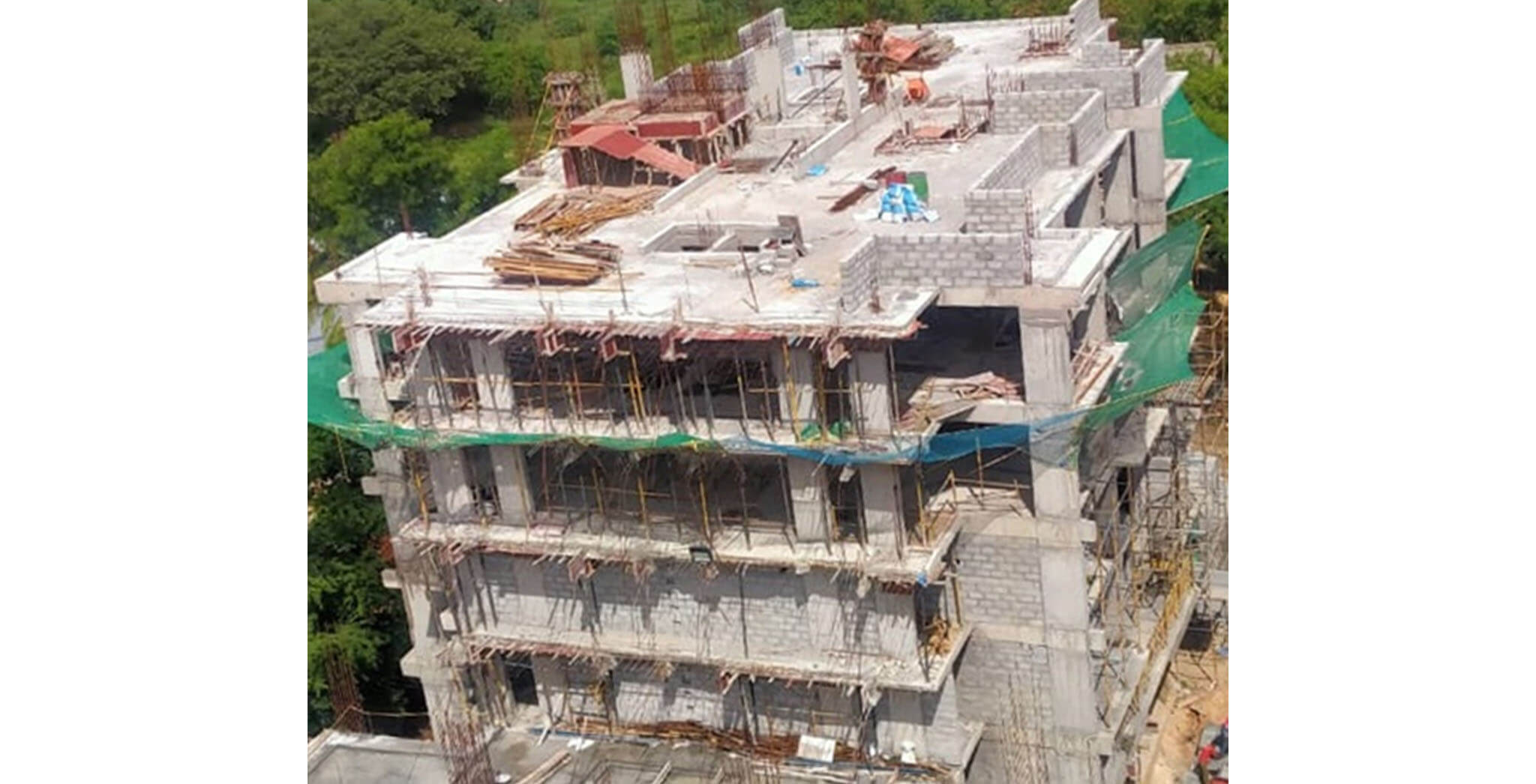

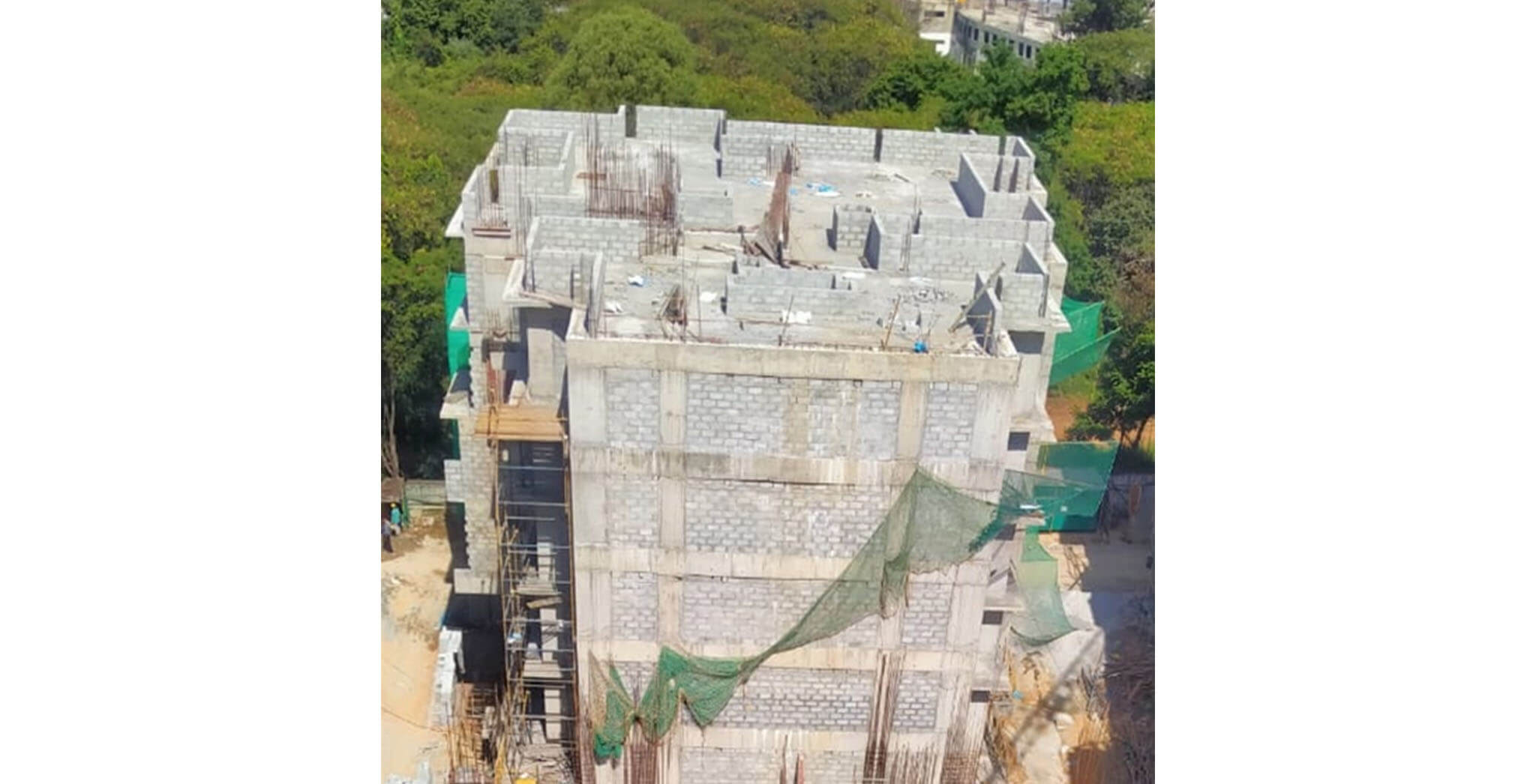

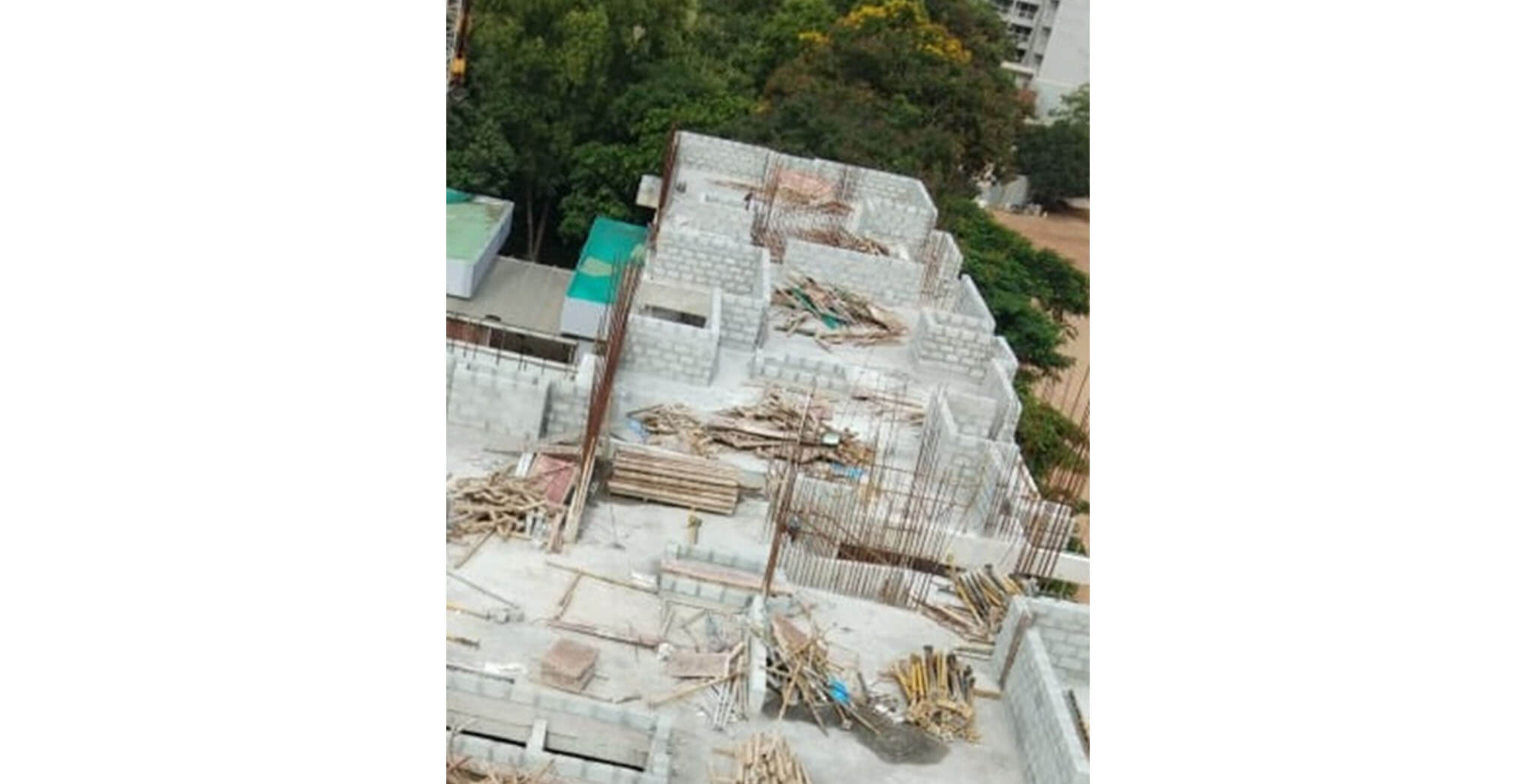

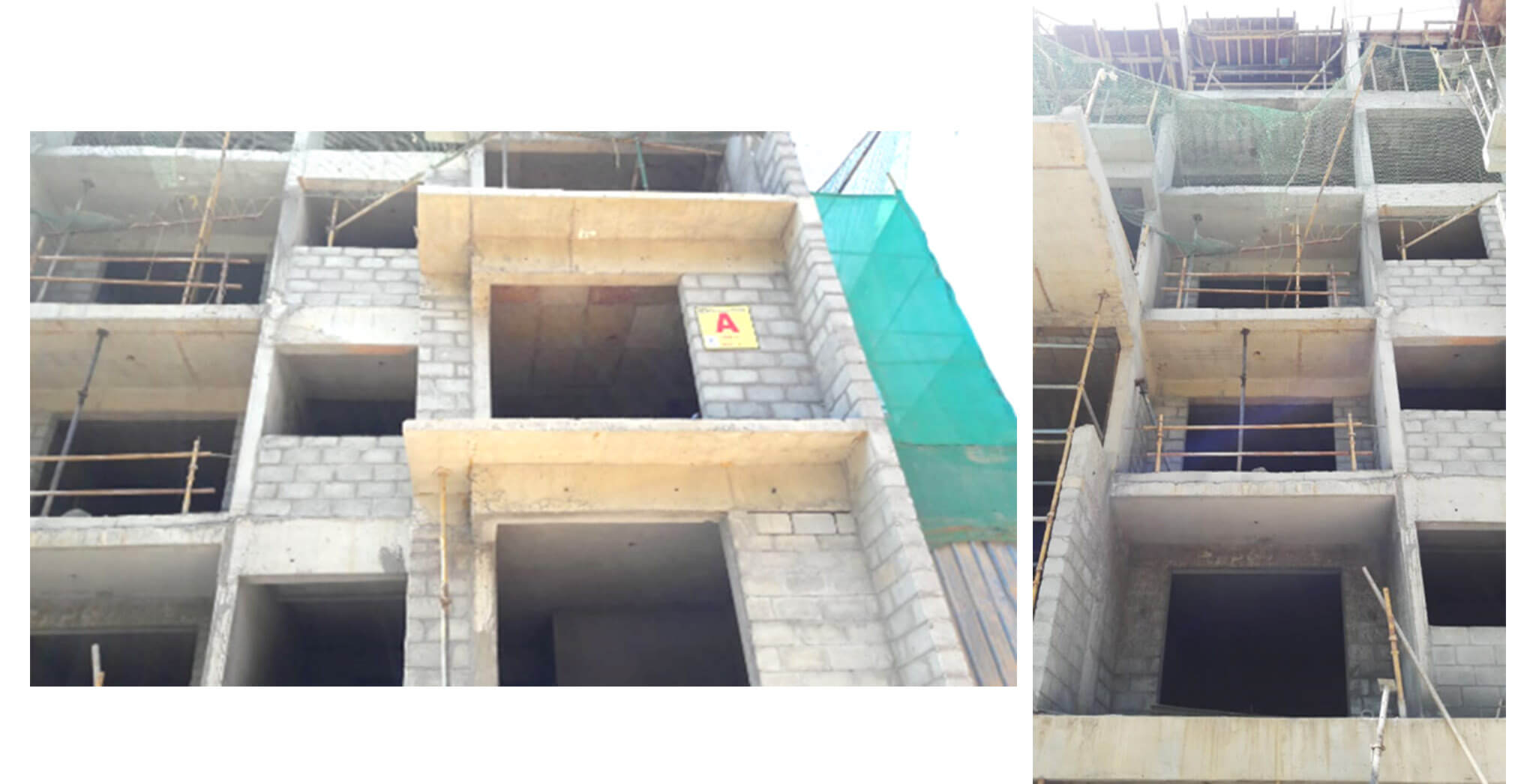

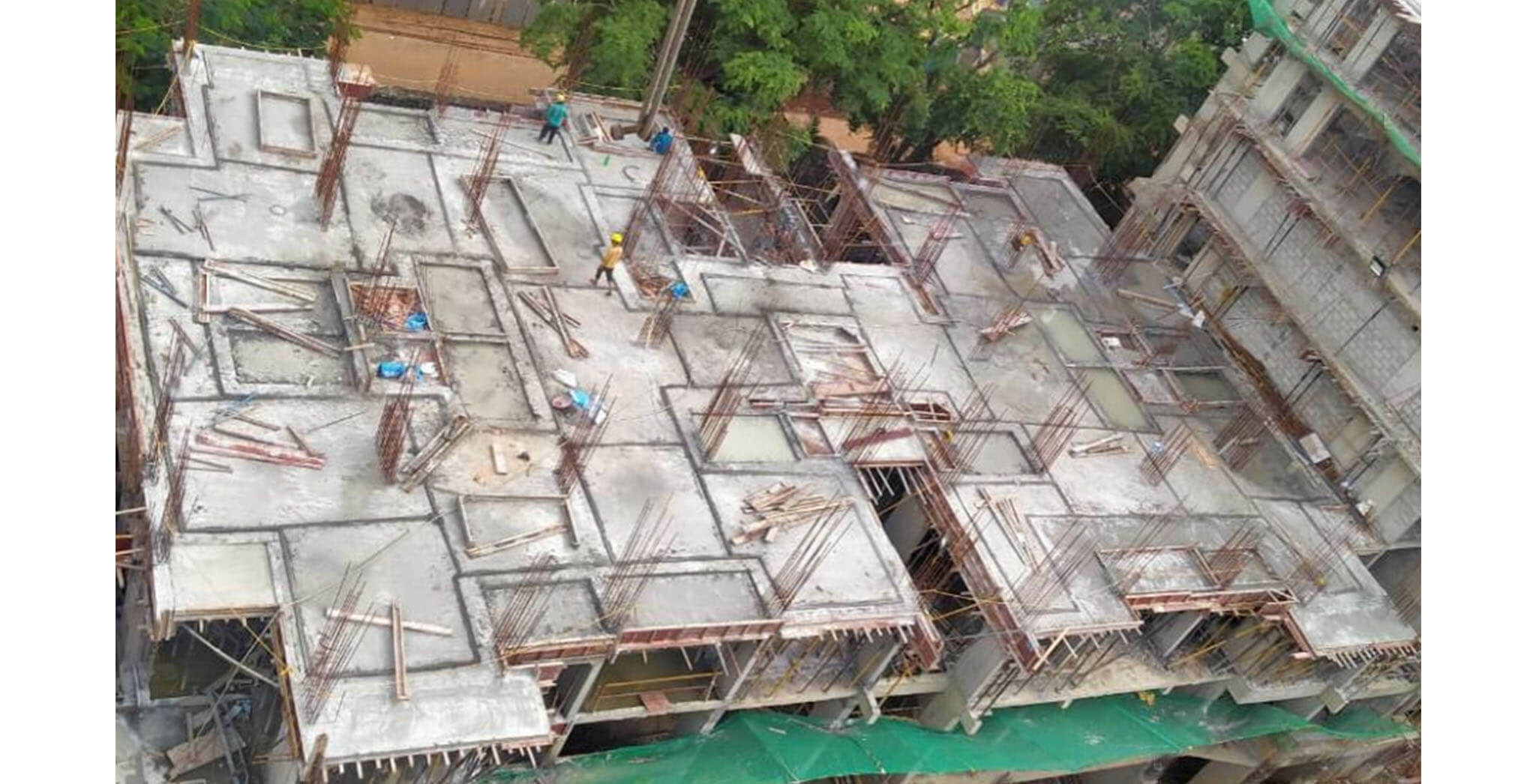

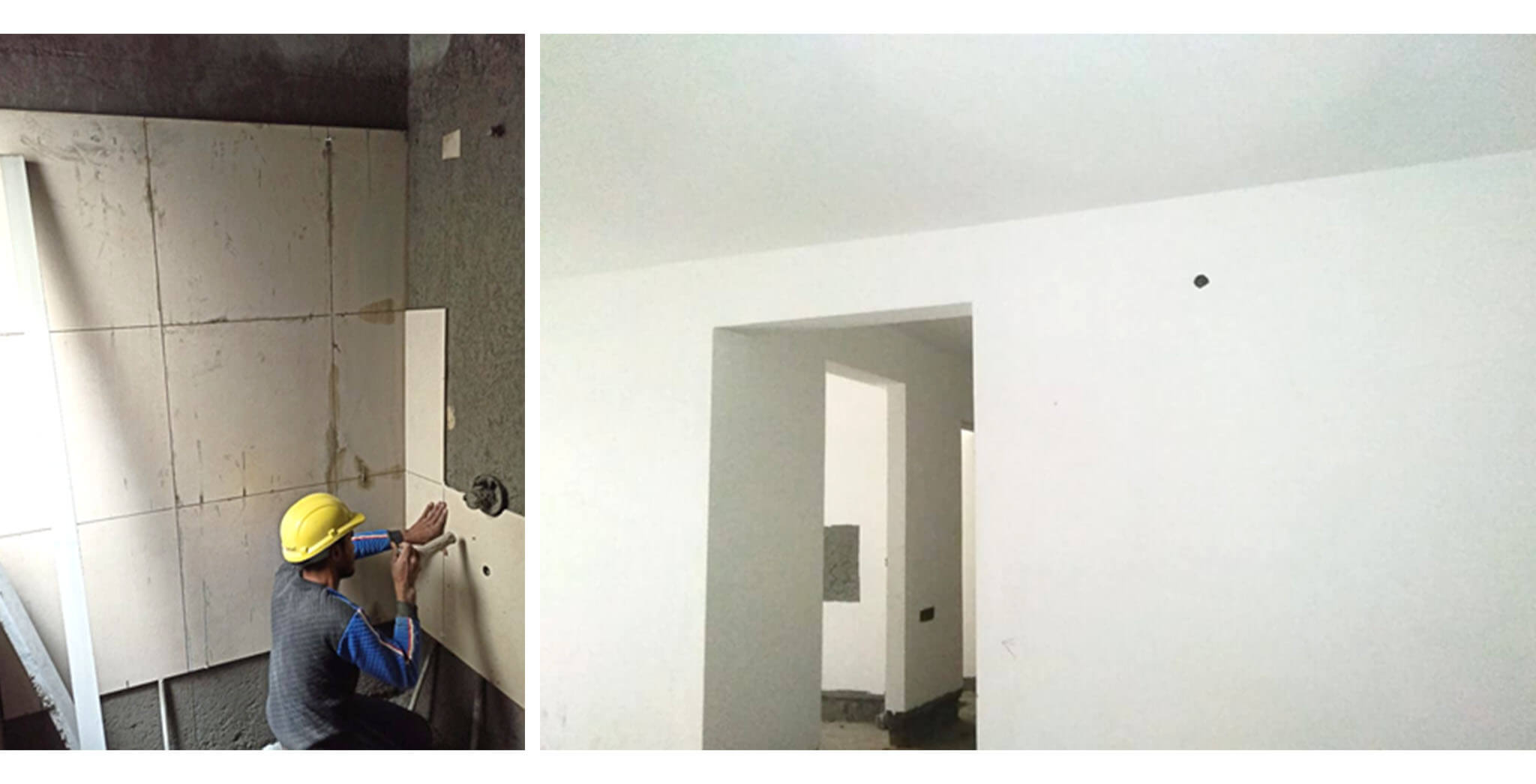

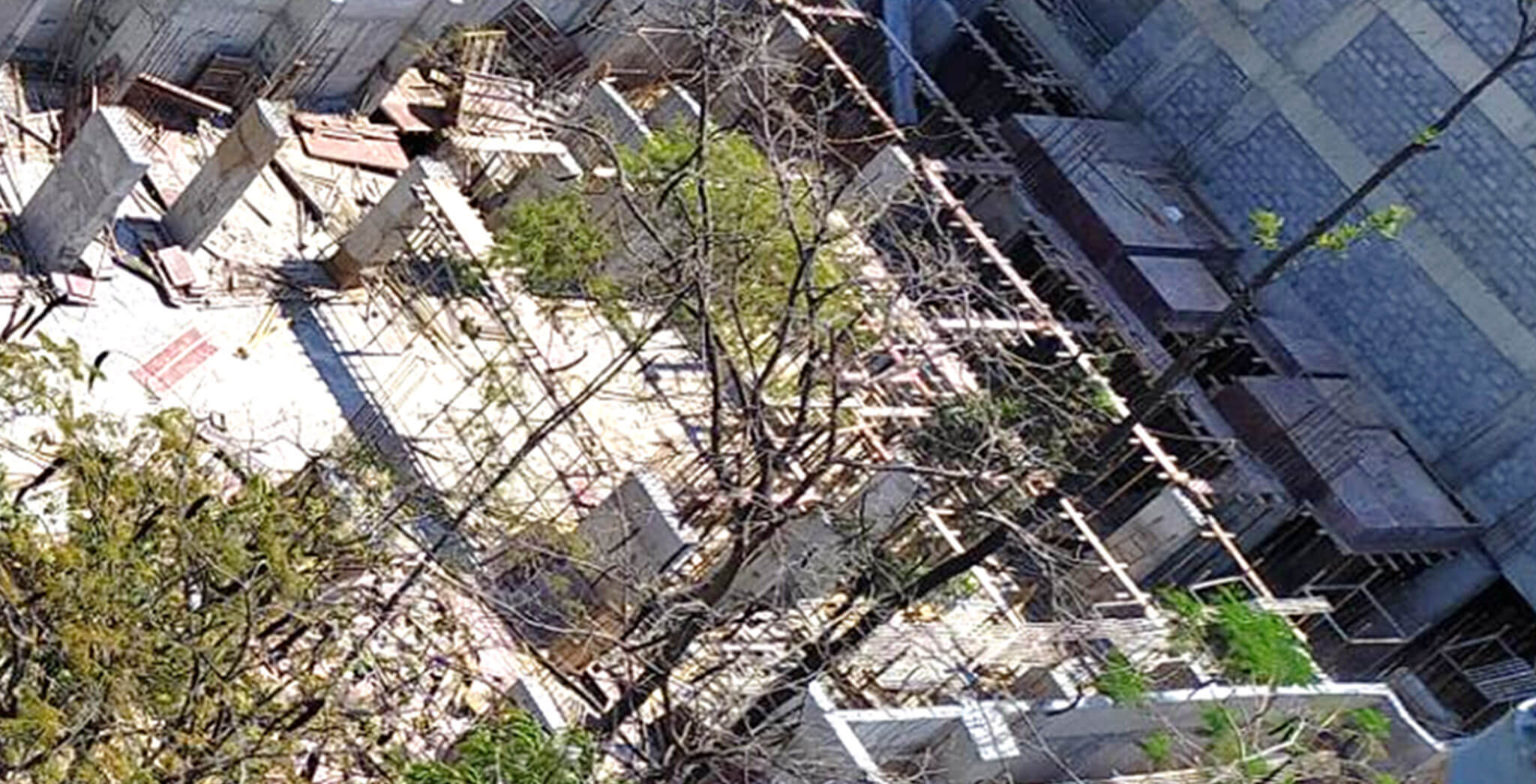

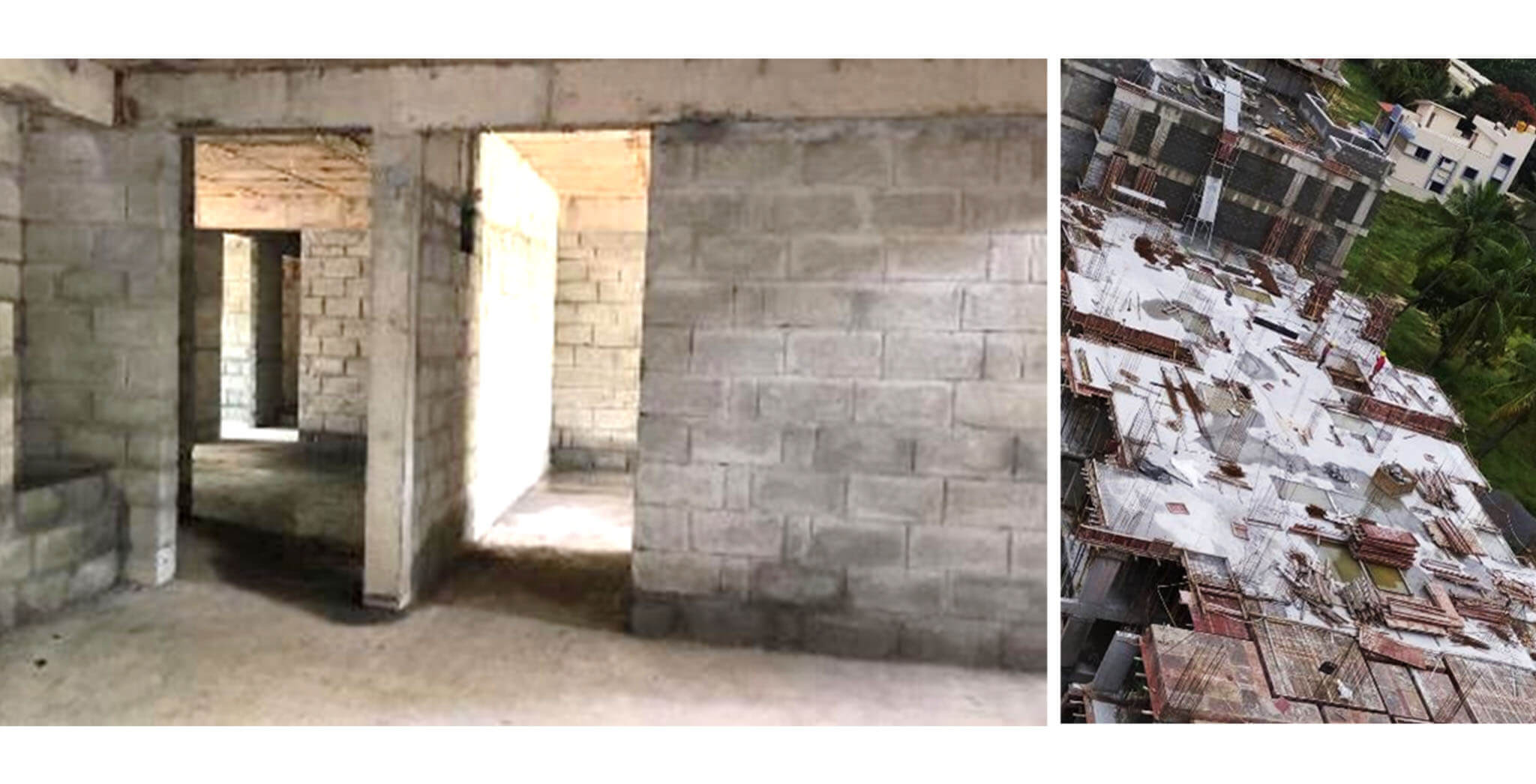

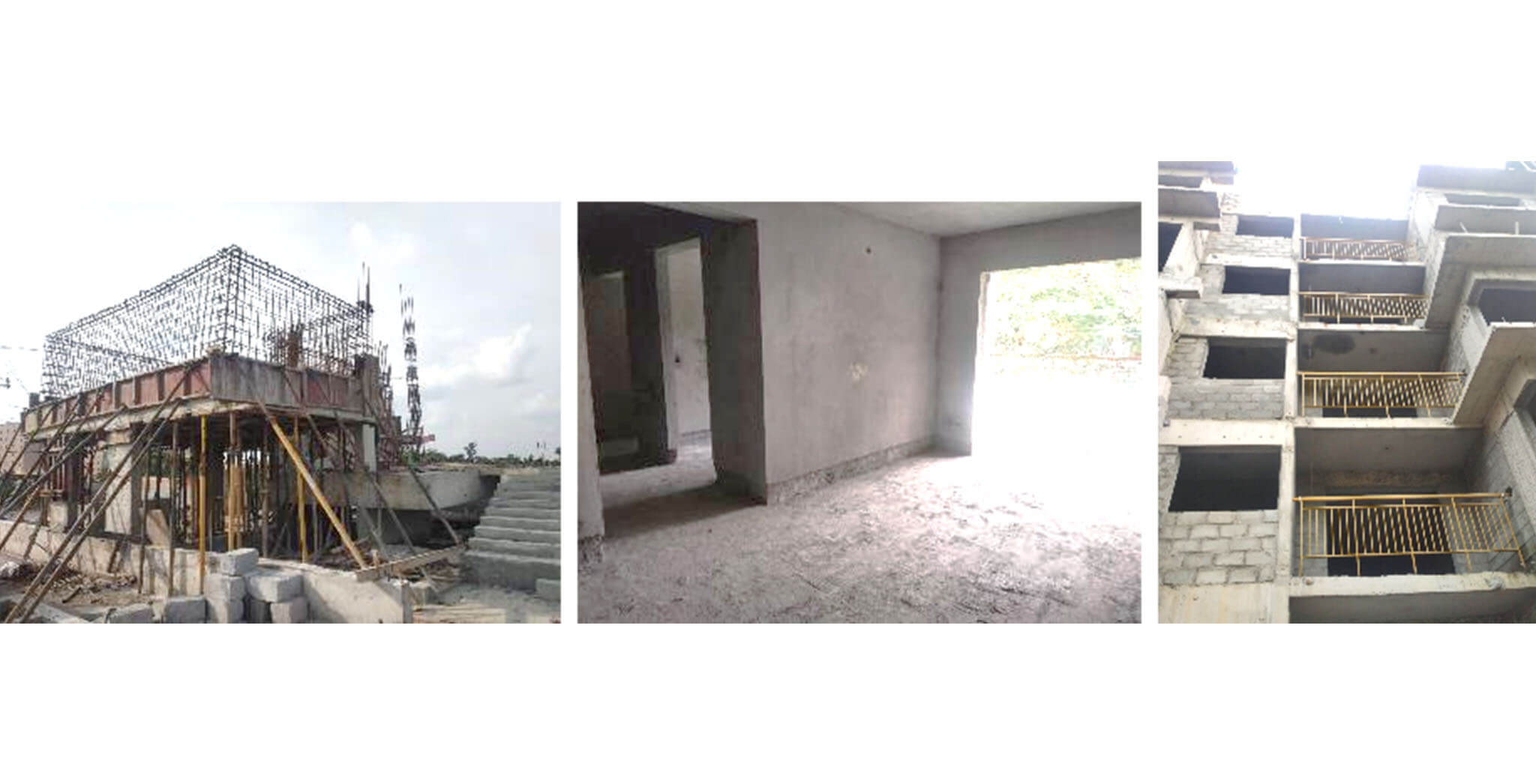

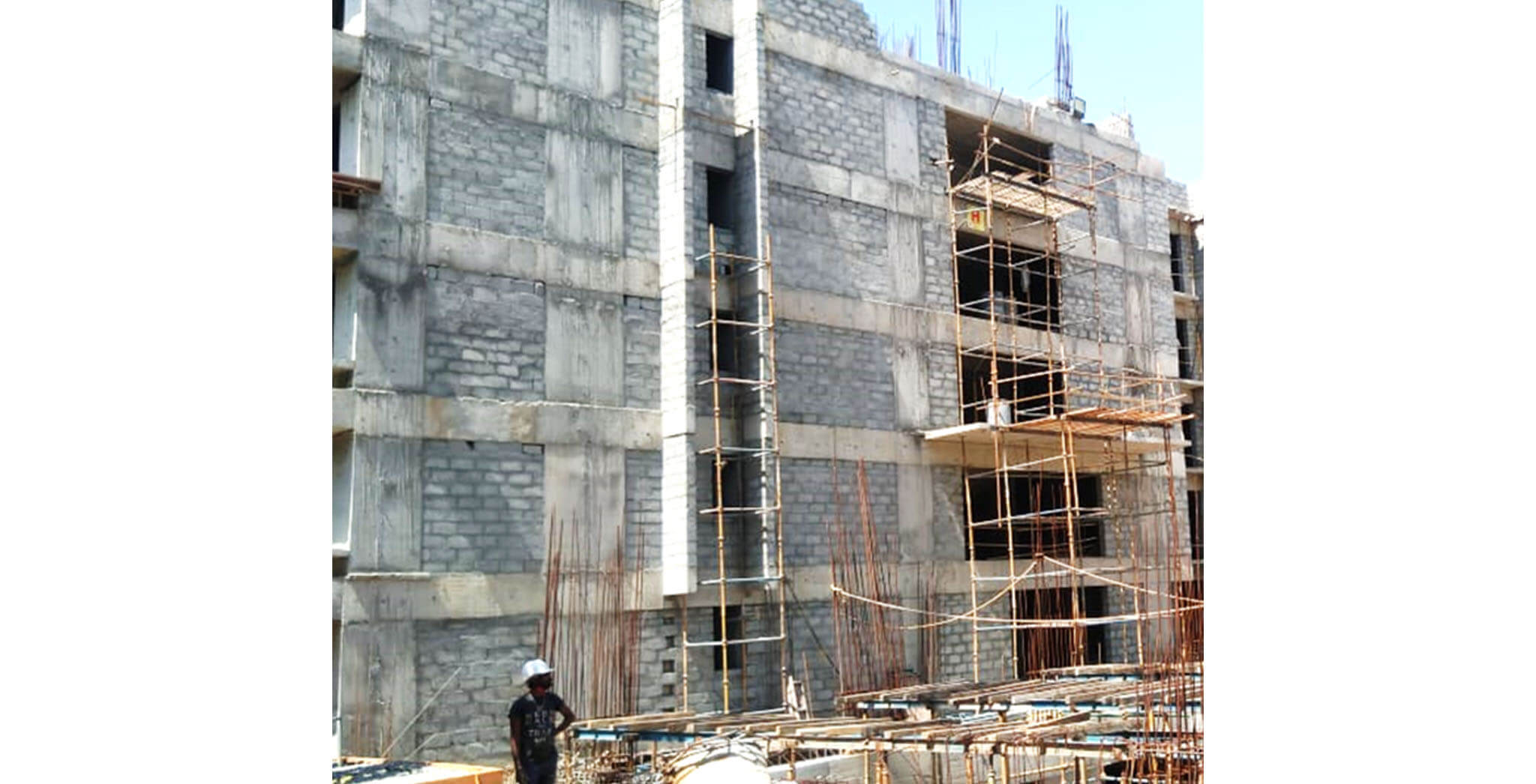

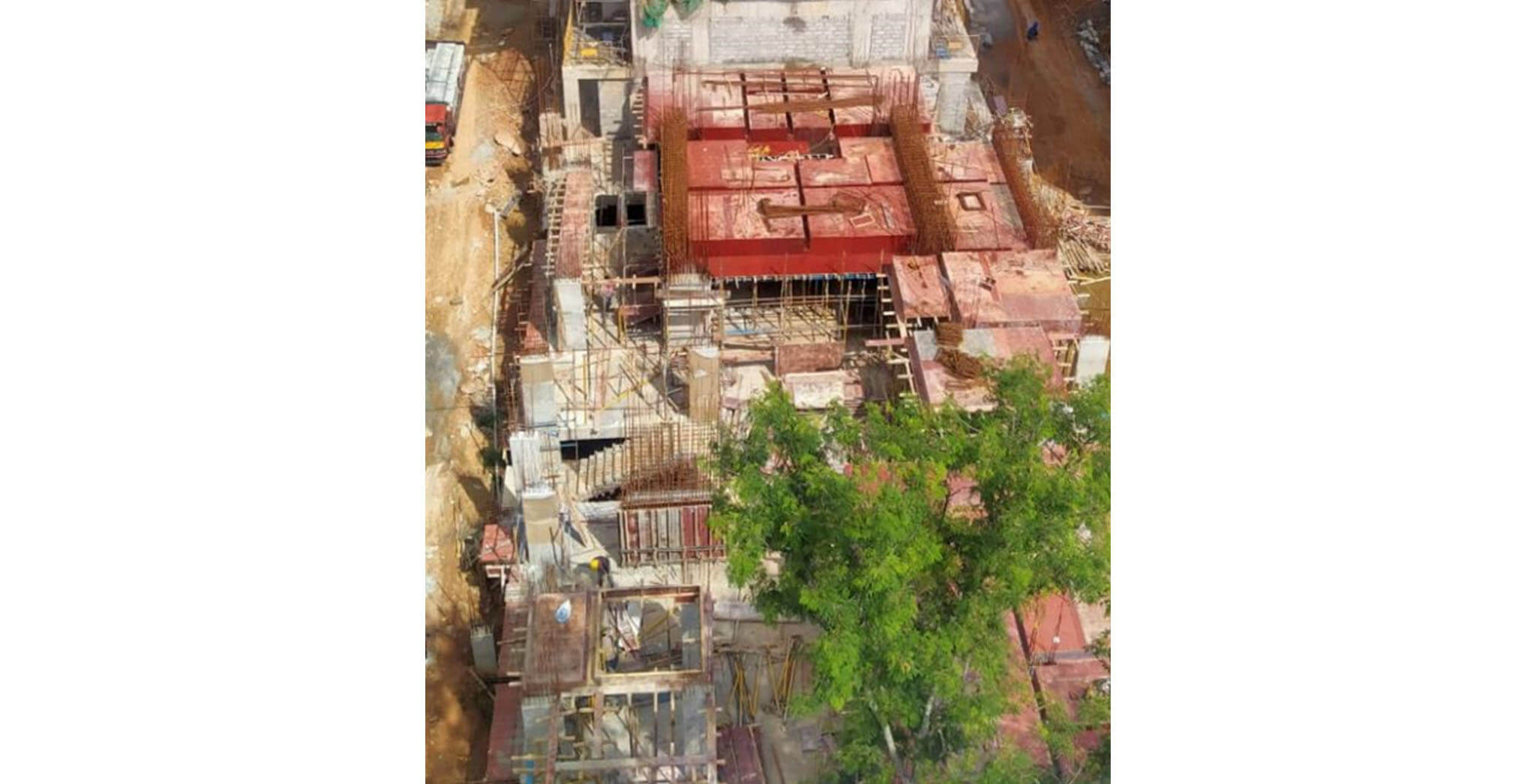

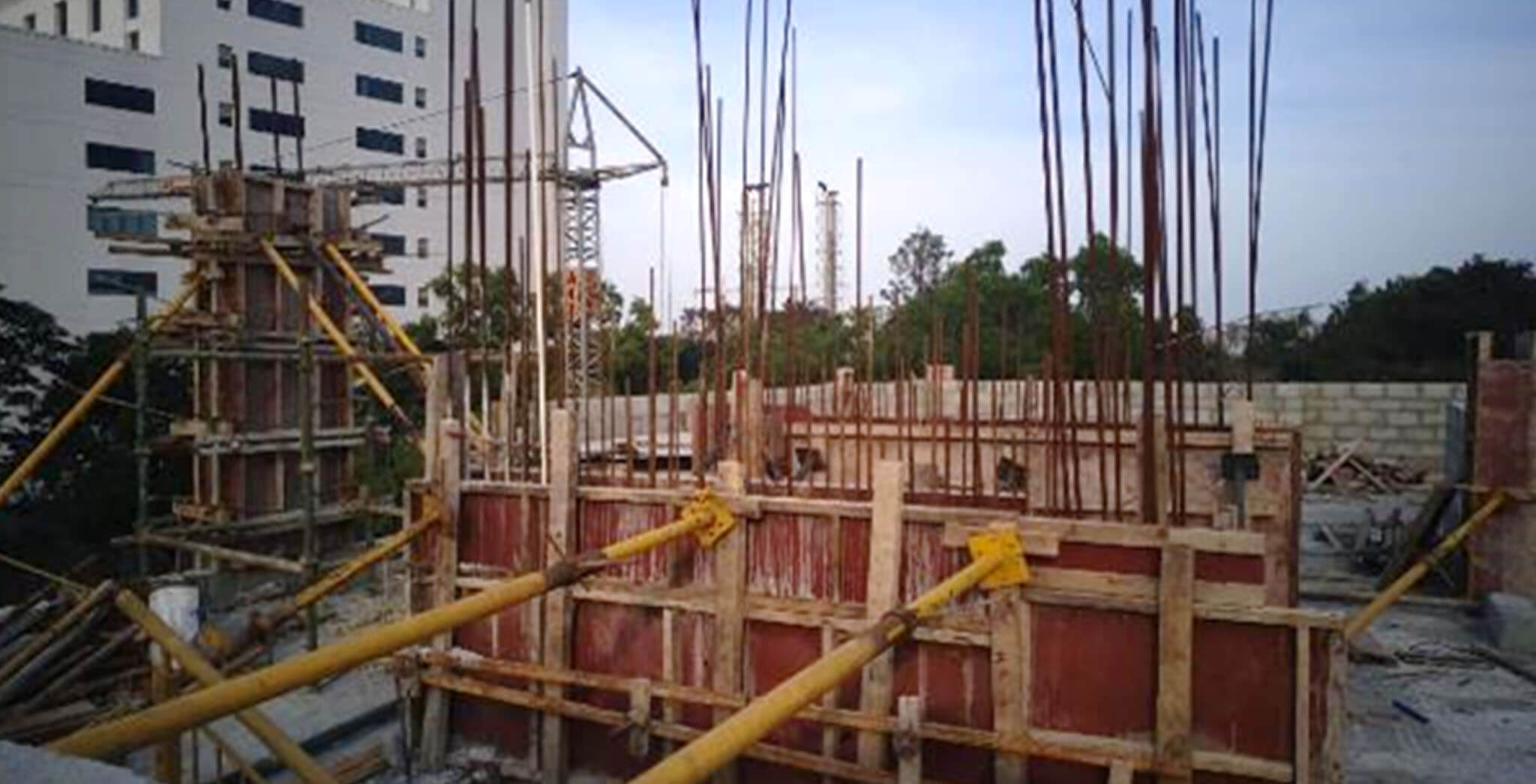

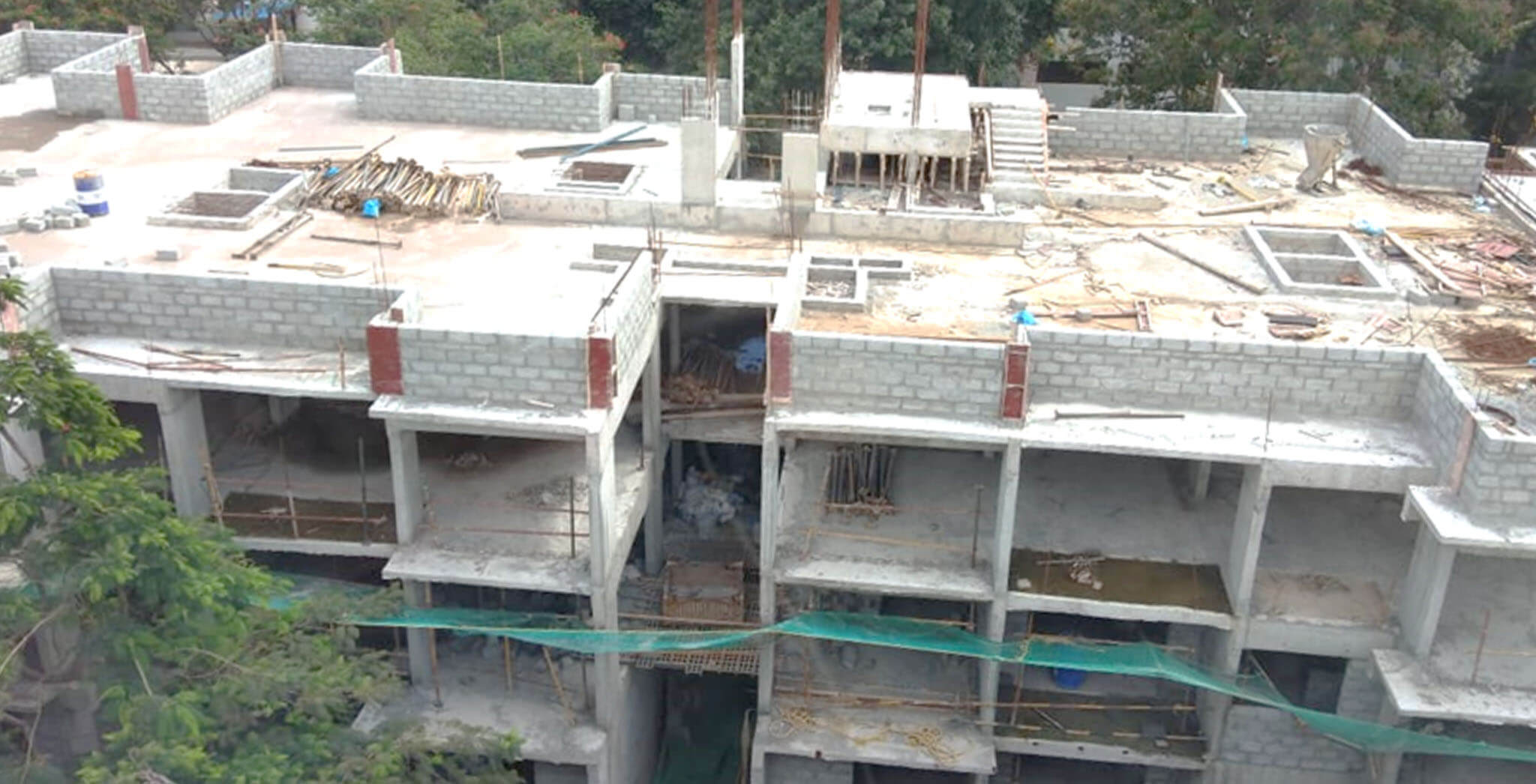

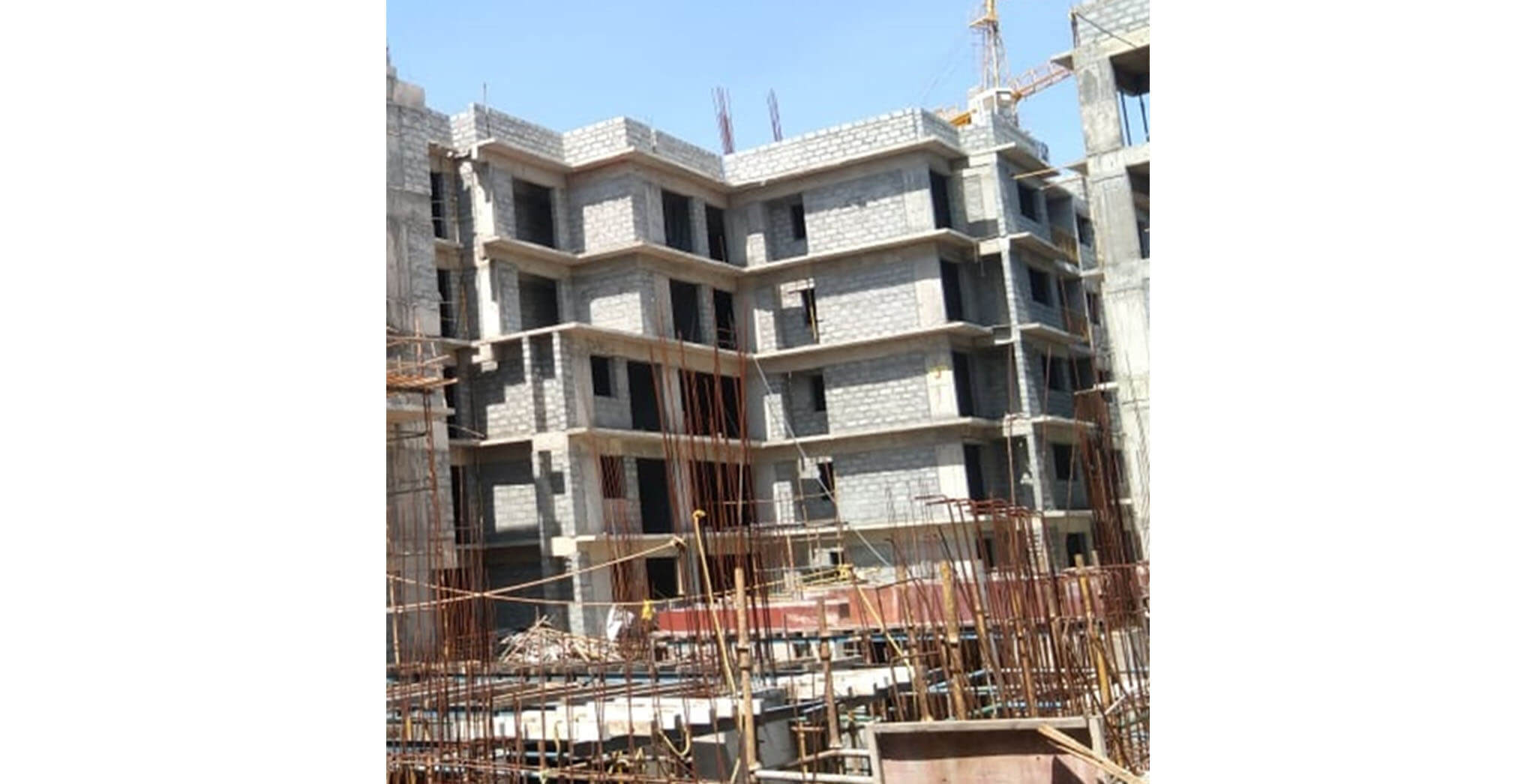

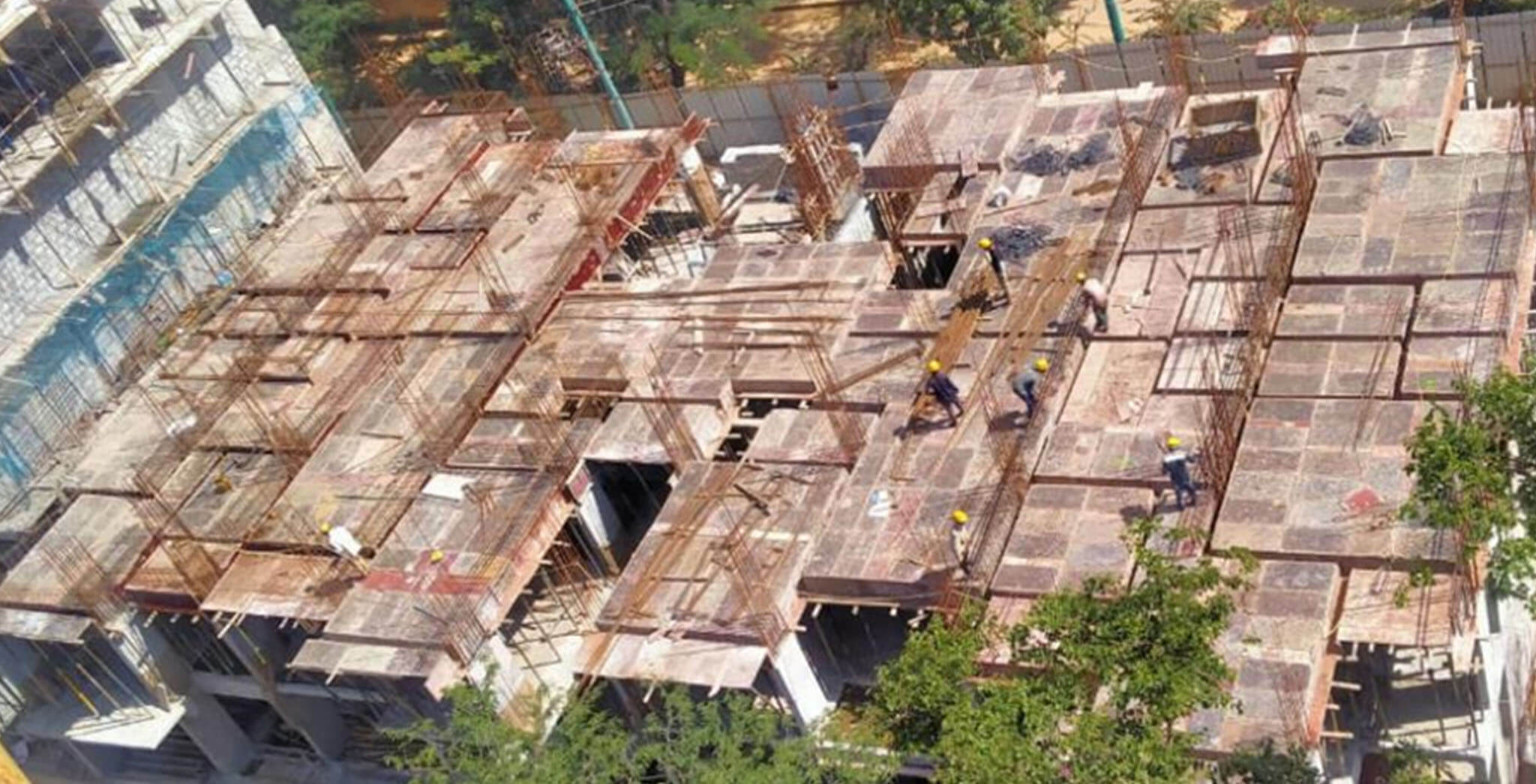

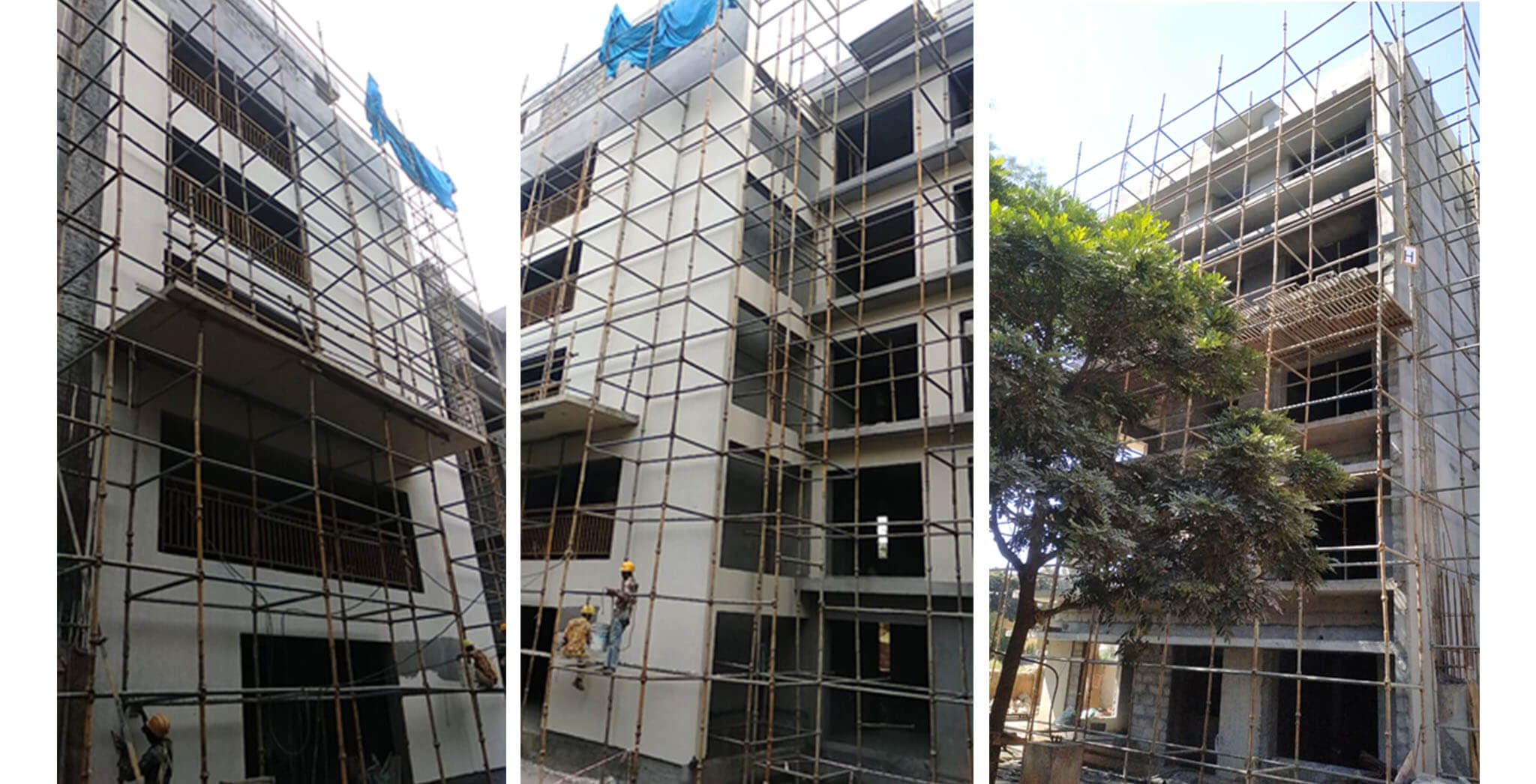

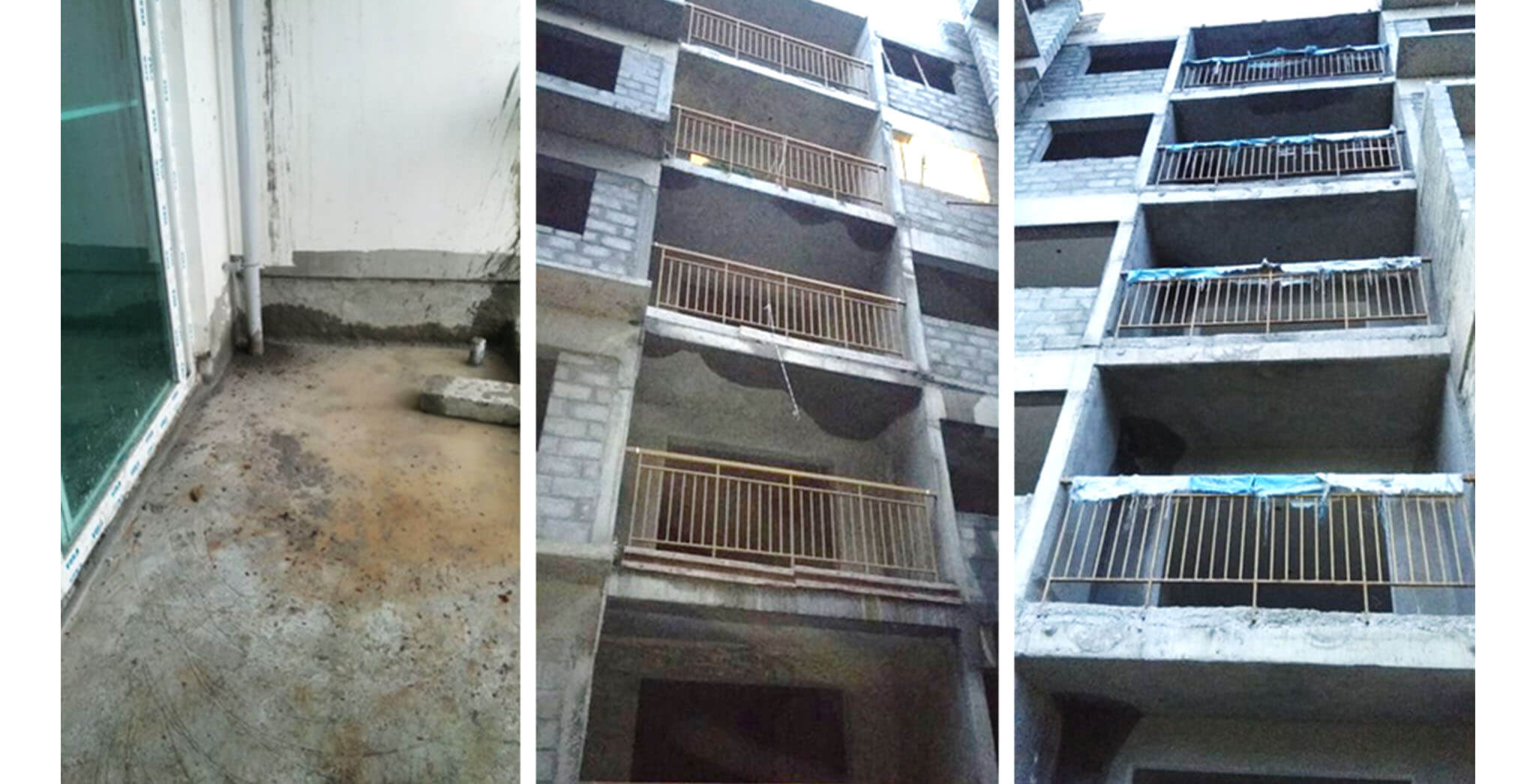

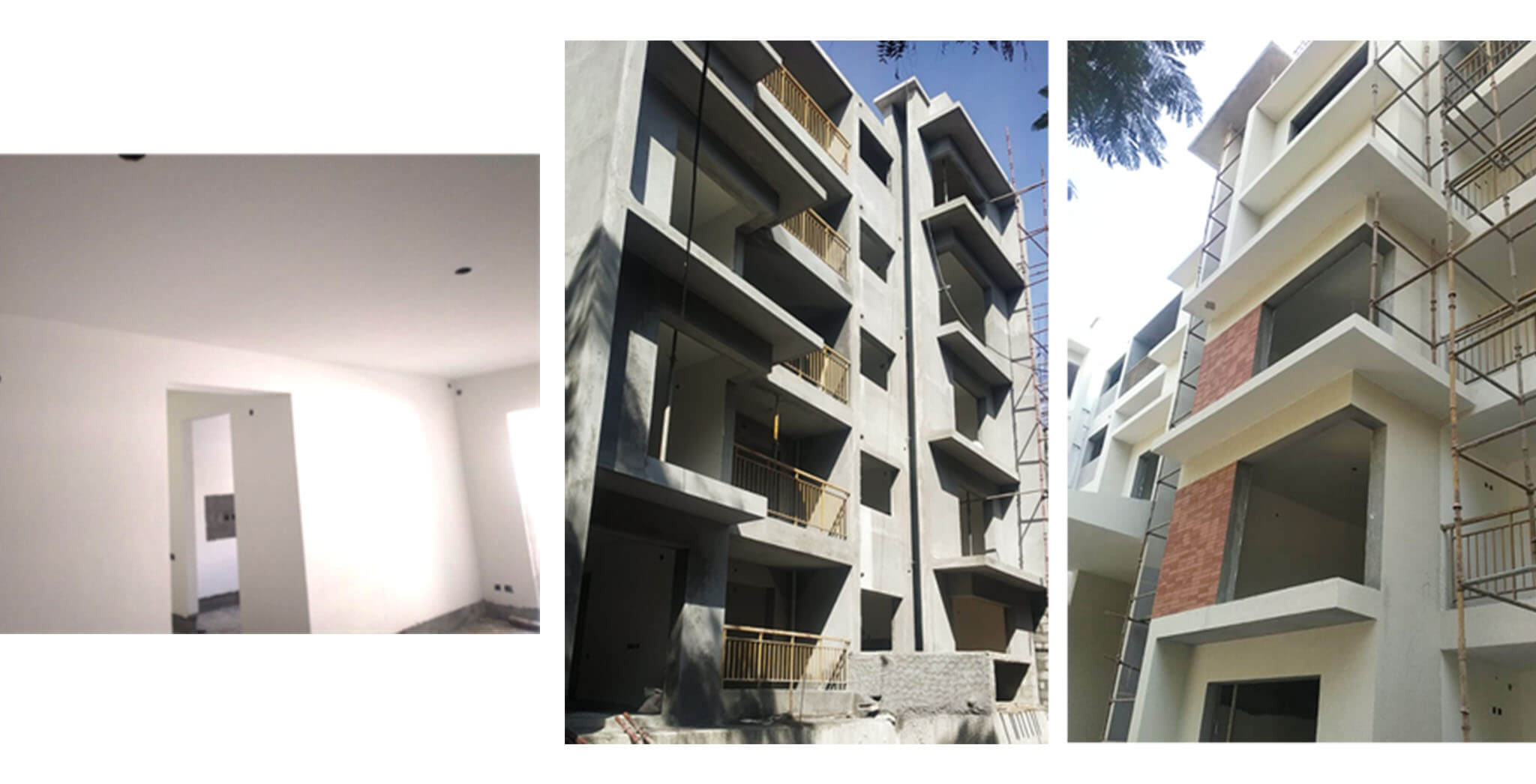

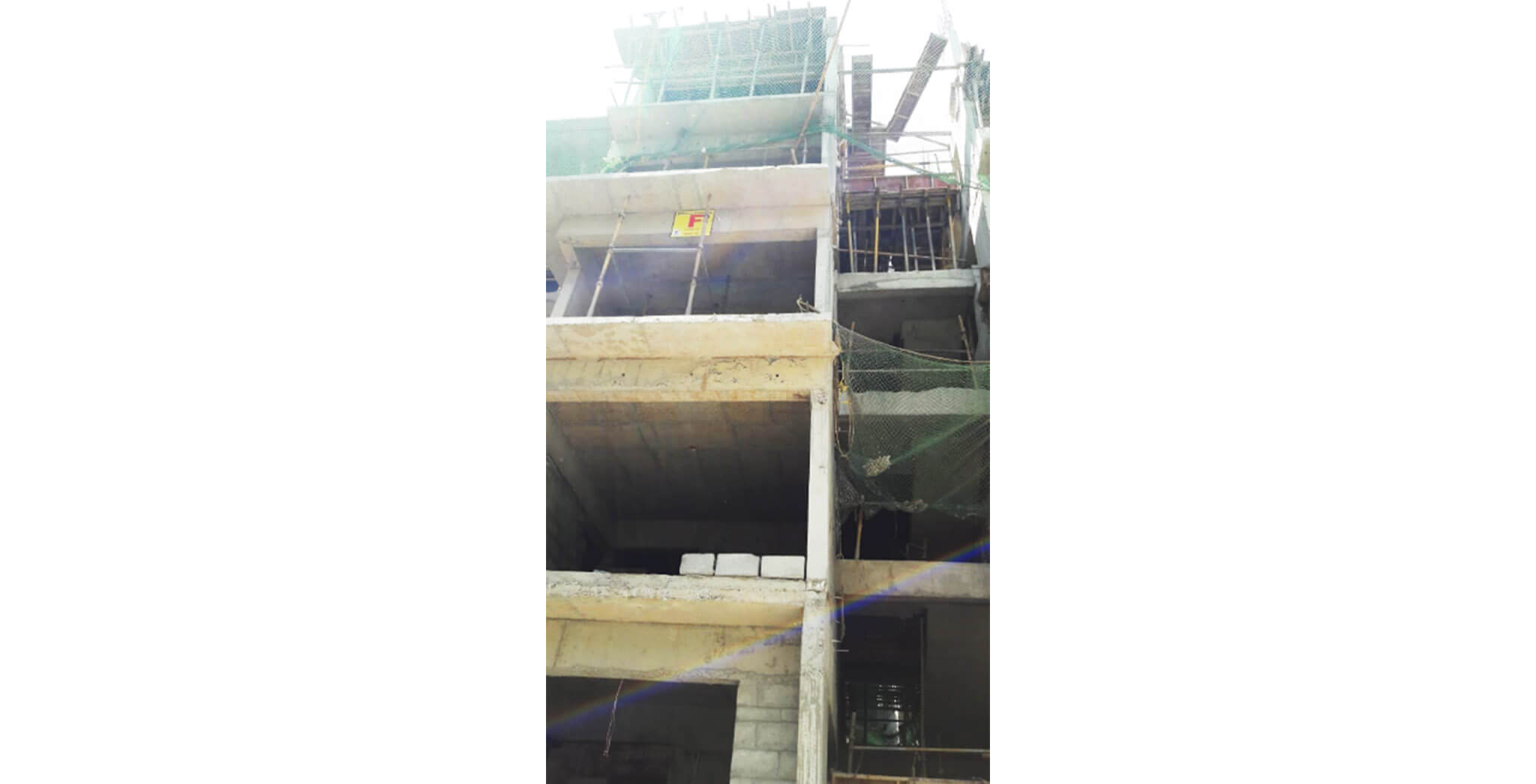

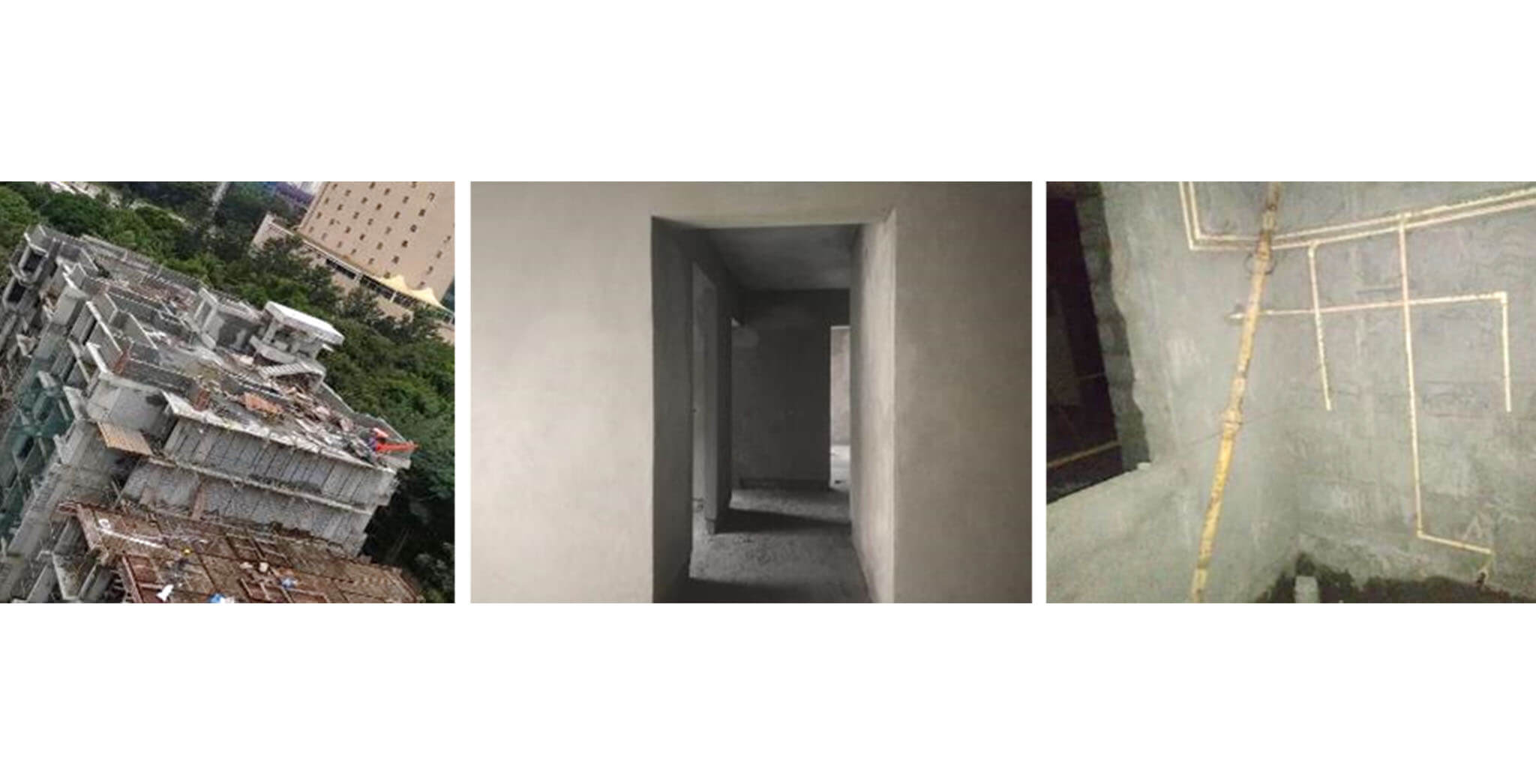

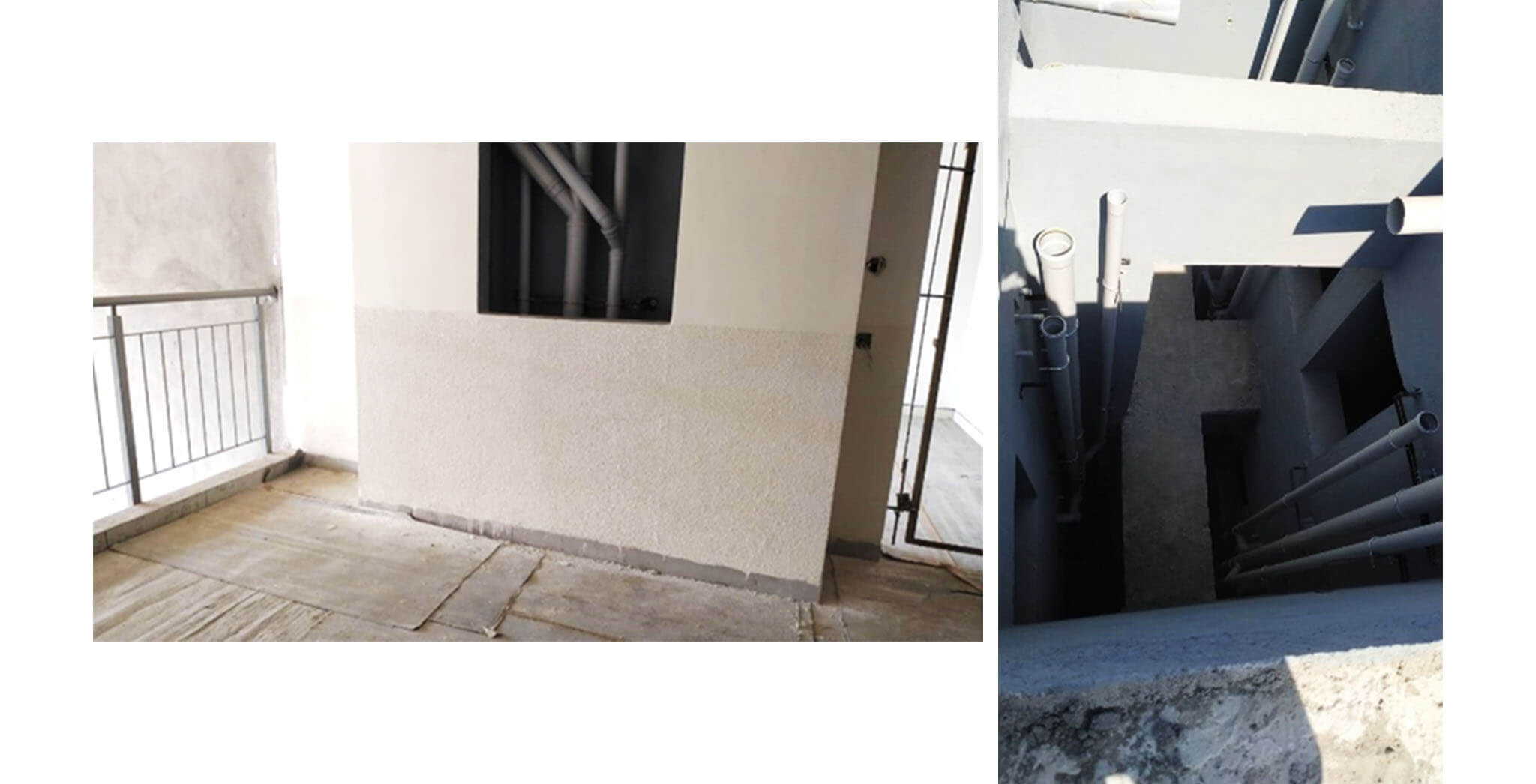

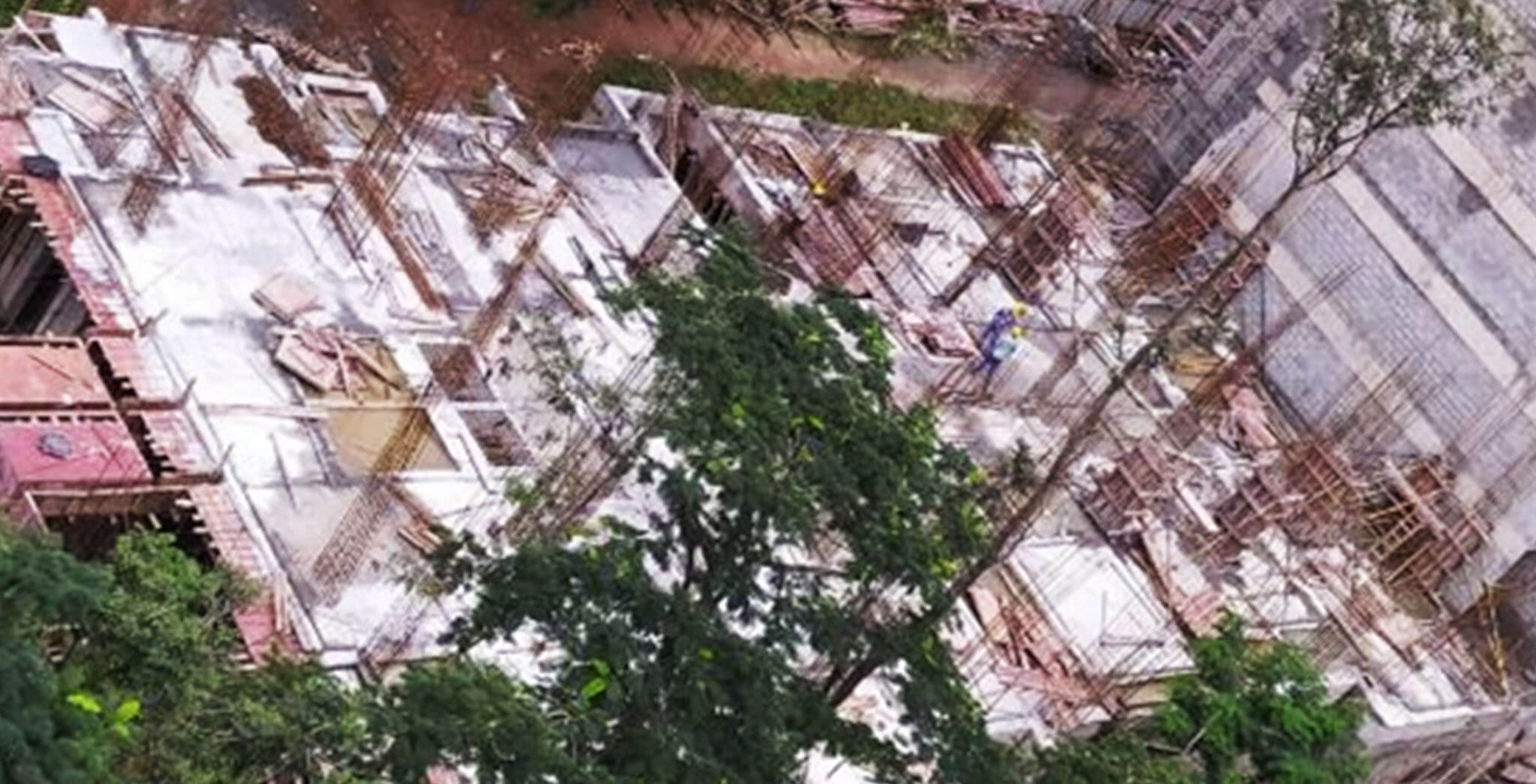

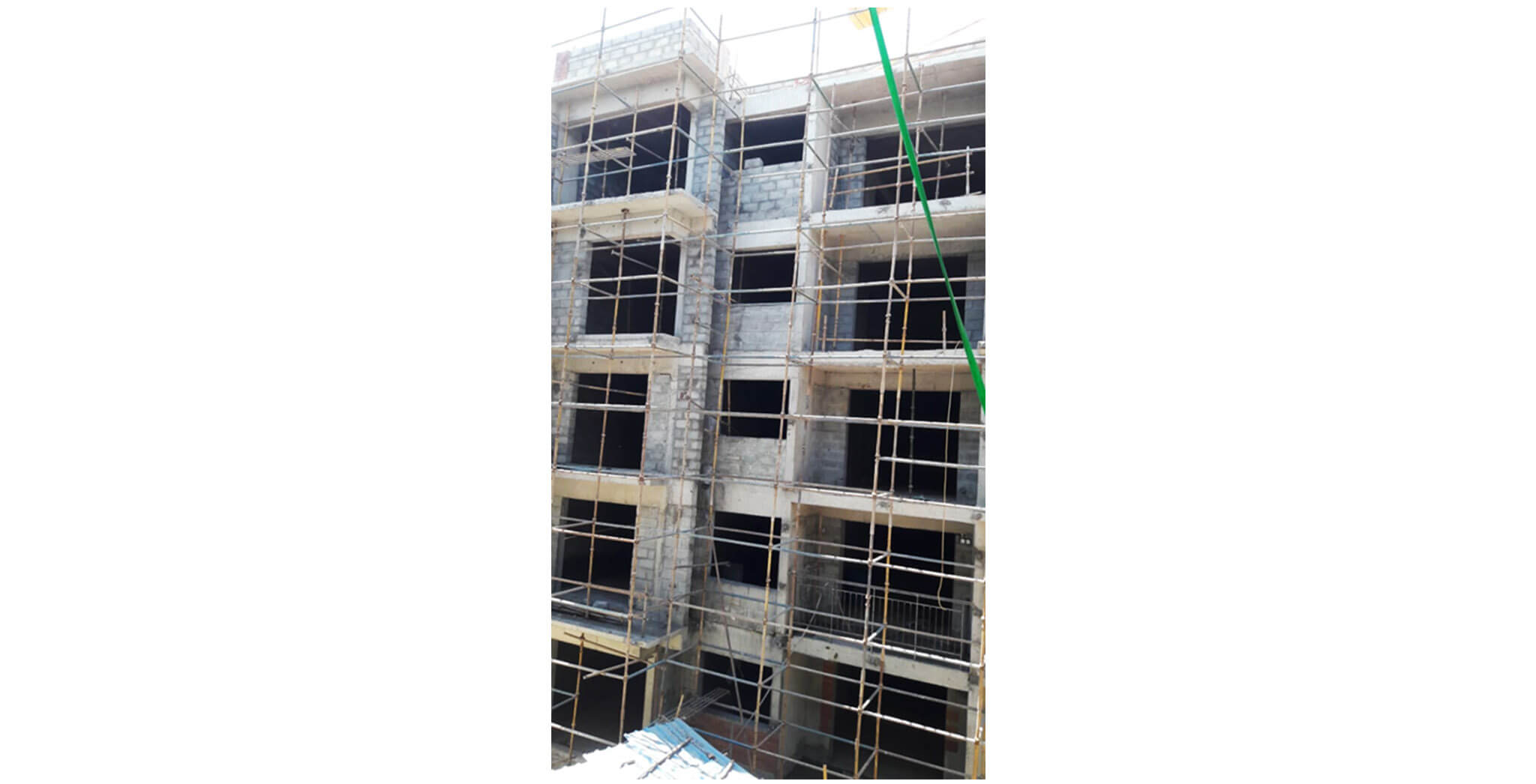

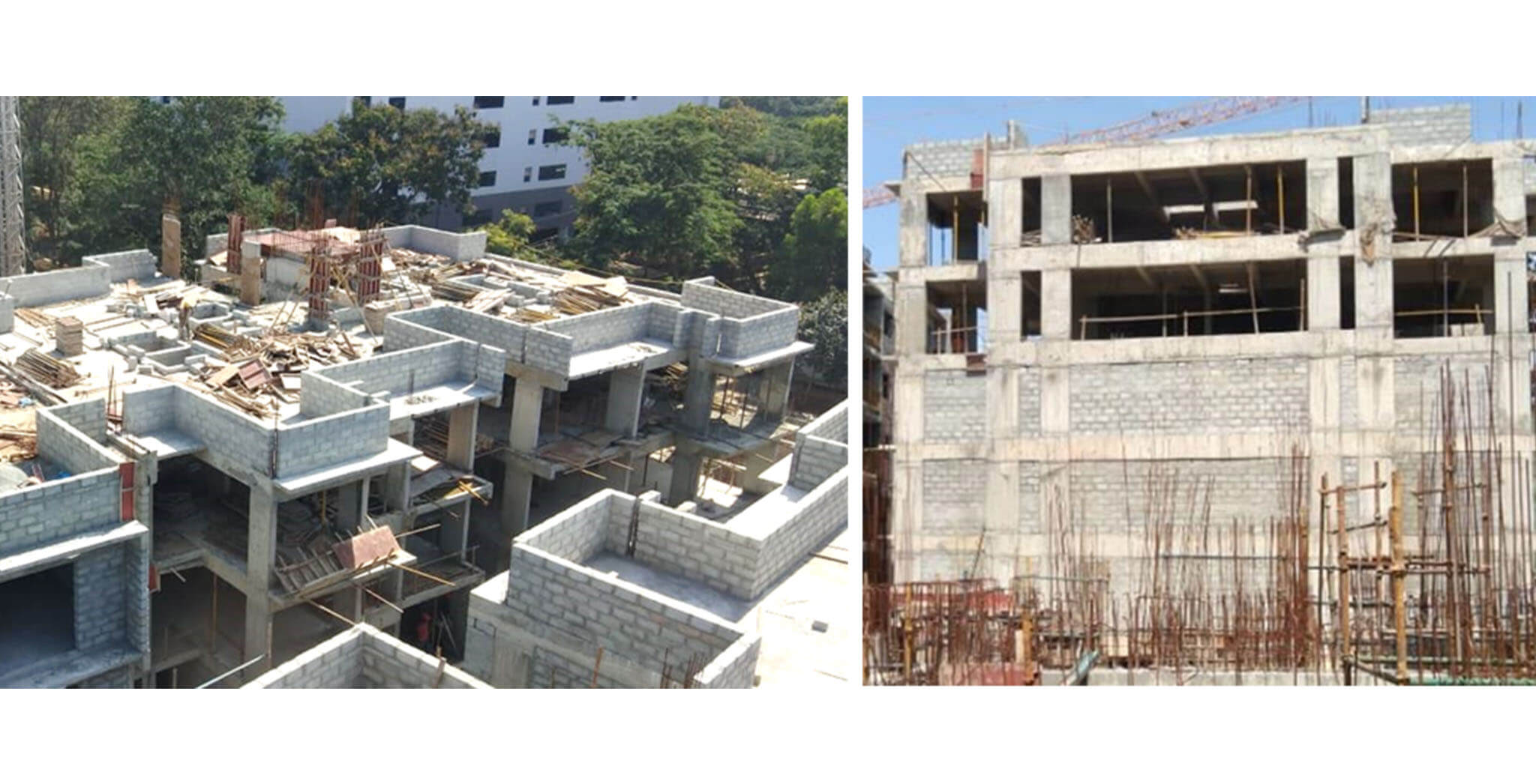

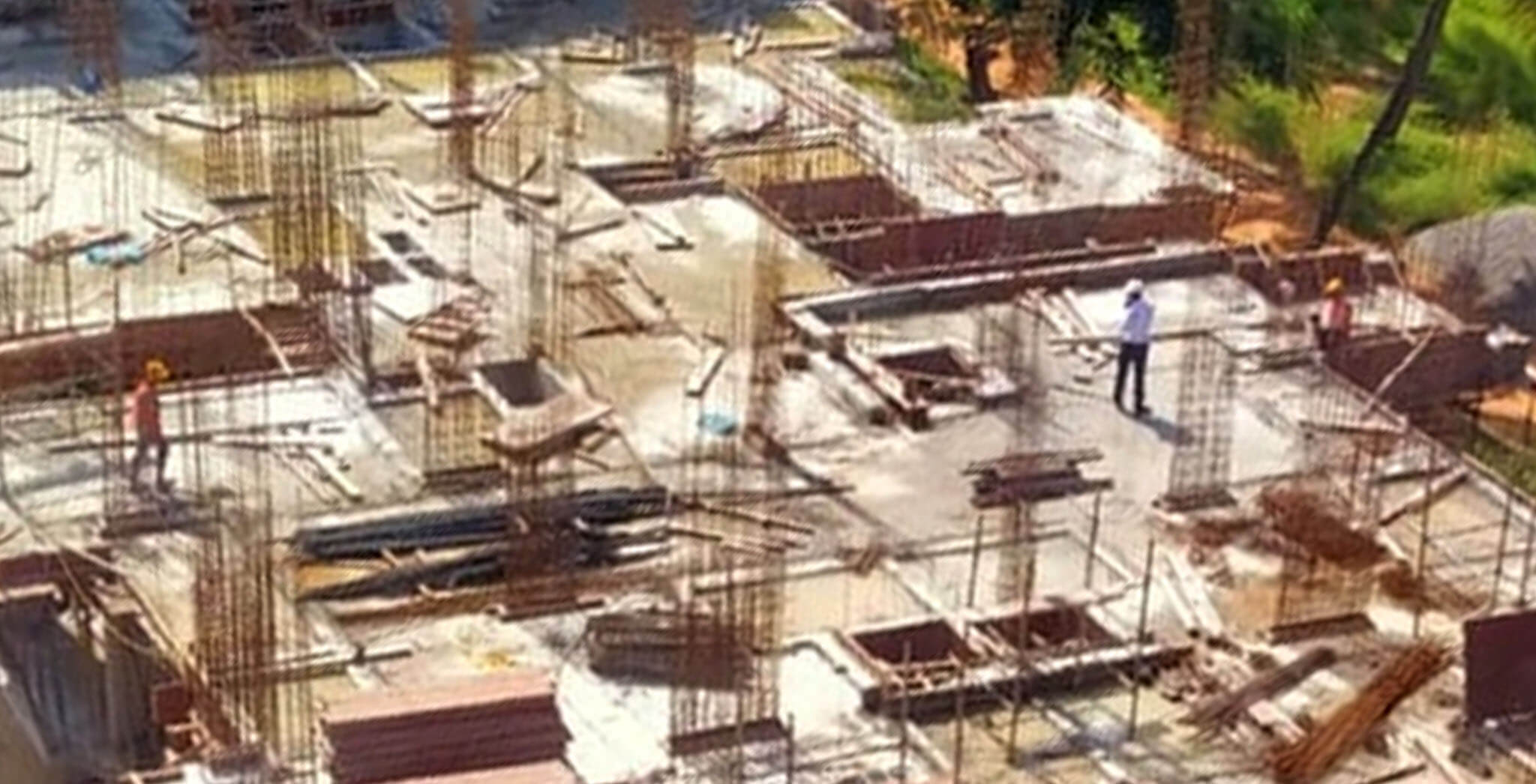

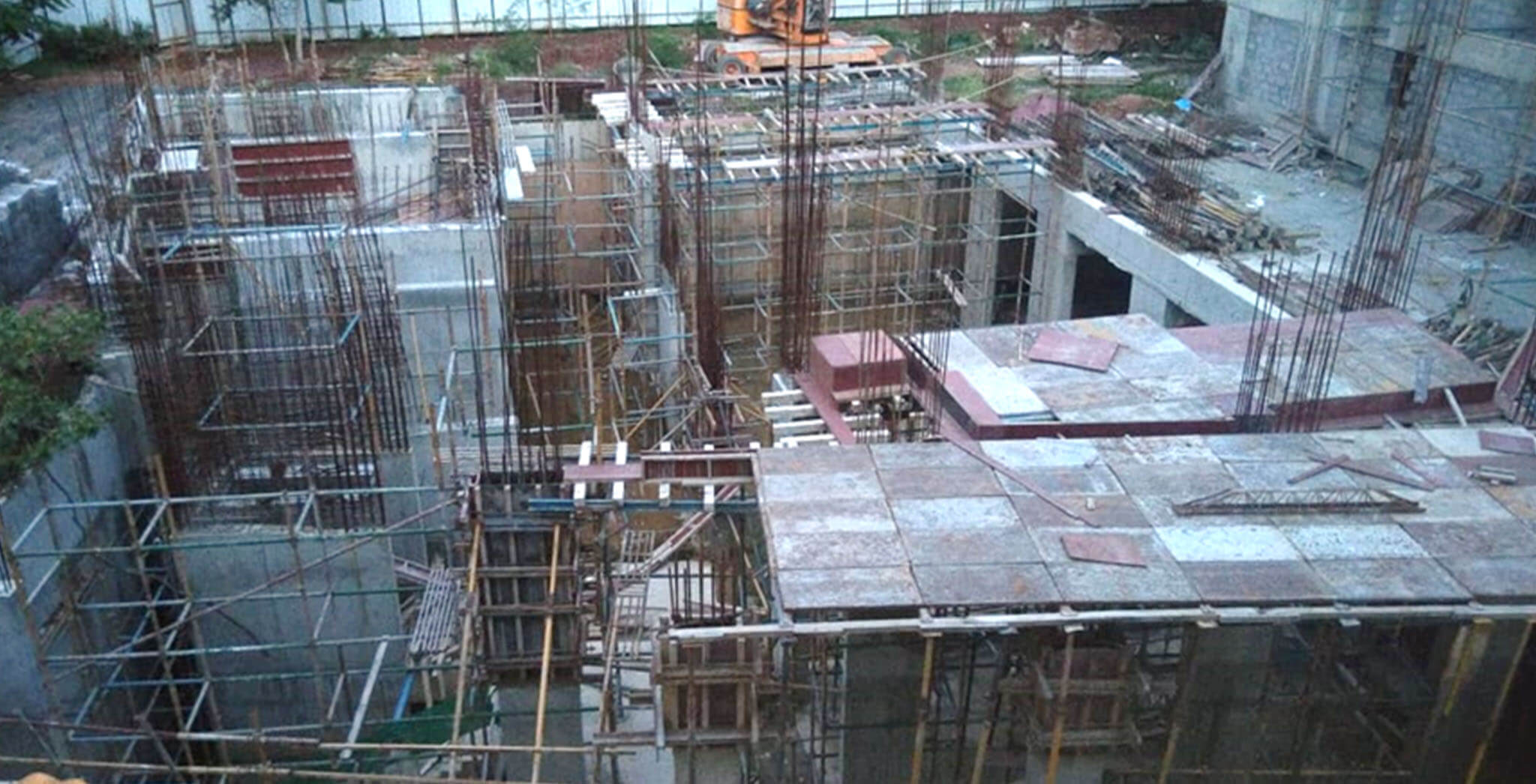

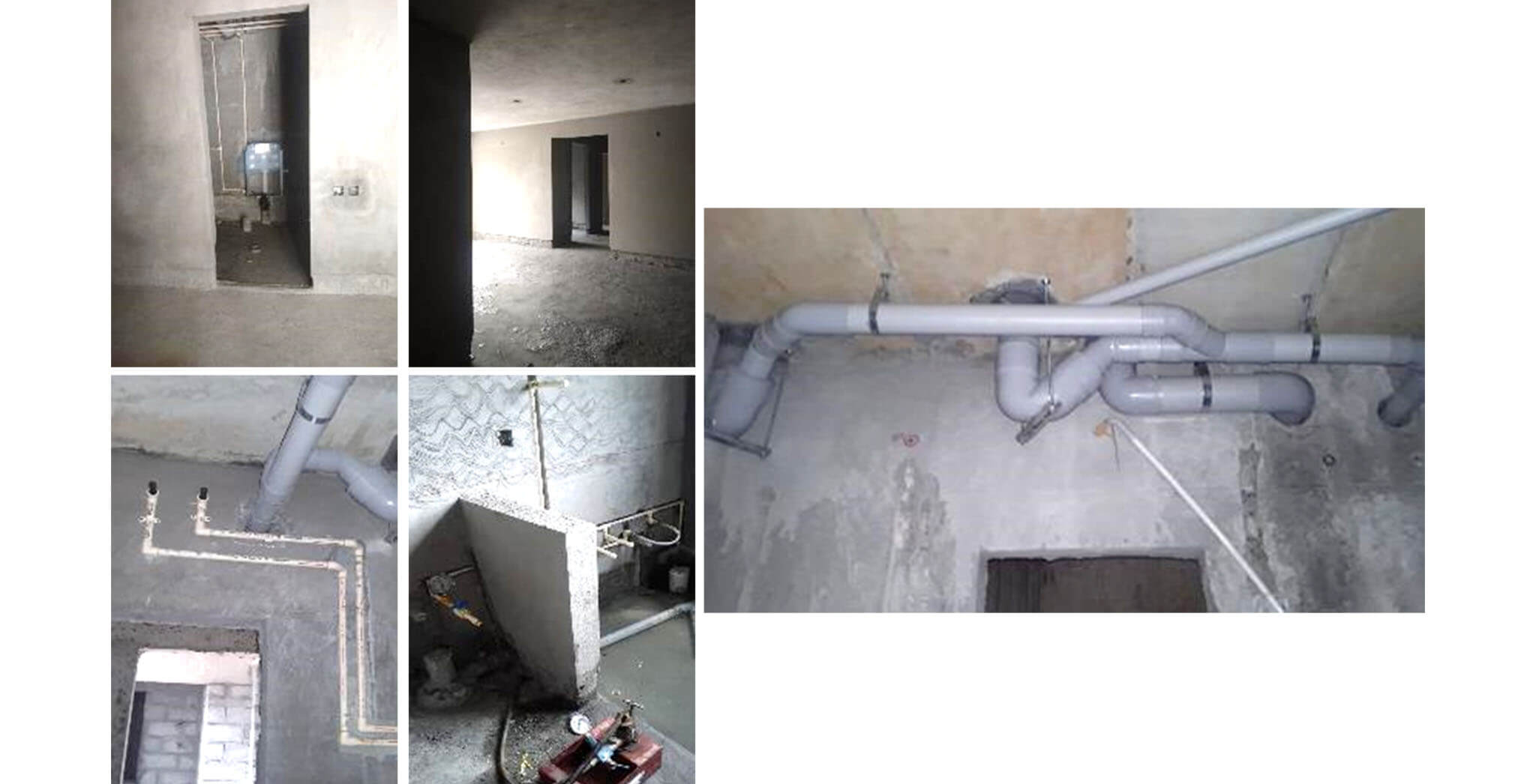

Nov 2021 - Club House: External painting and cladding works in progress. Internal painting, flooring and other interior works in progress
Nov 2021 - Club House: External painting and cladding works in progress. Internal painting, flooring and other interior works in progress

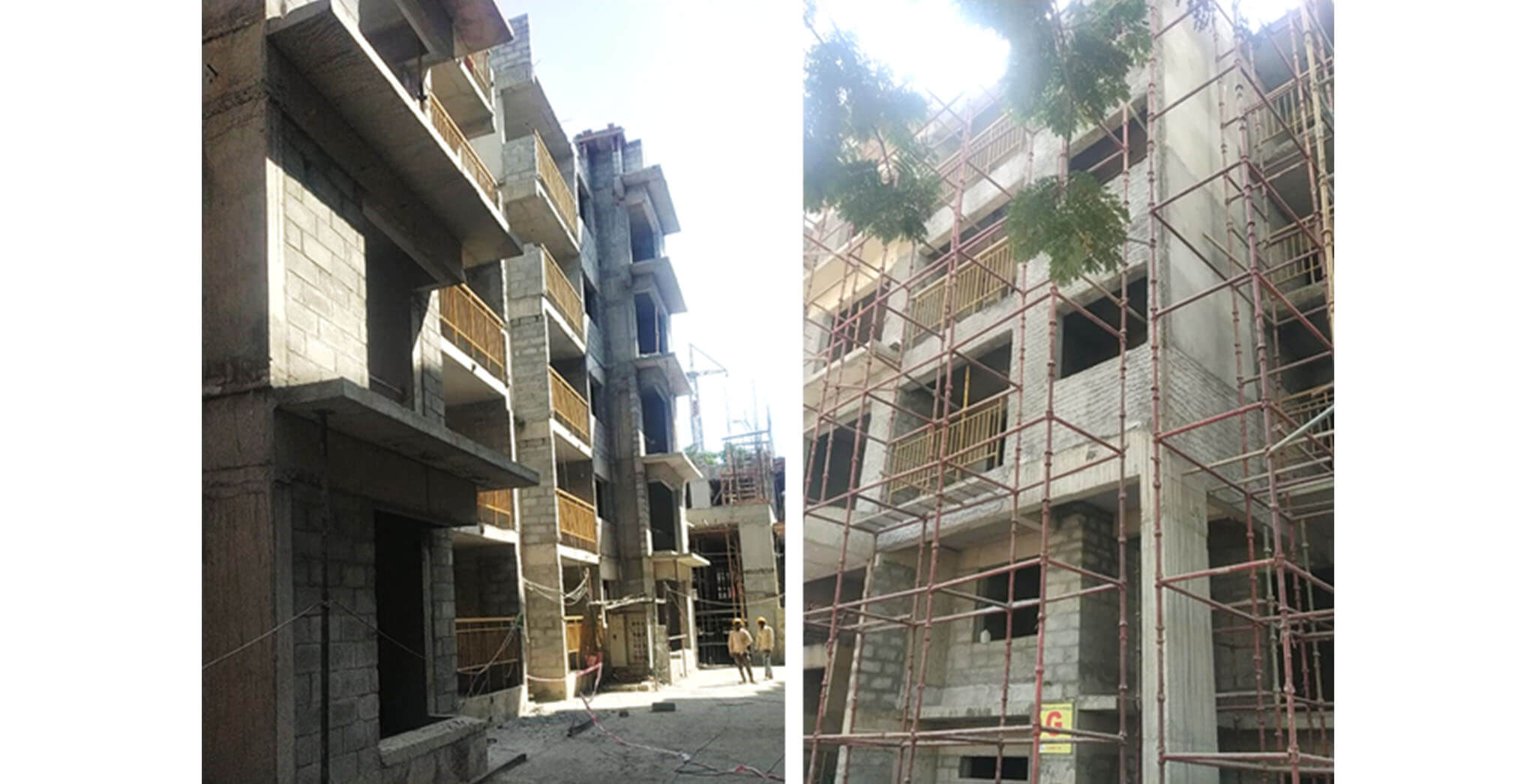

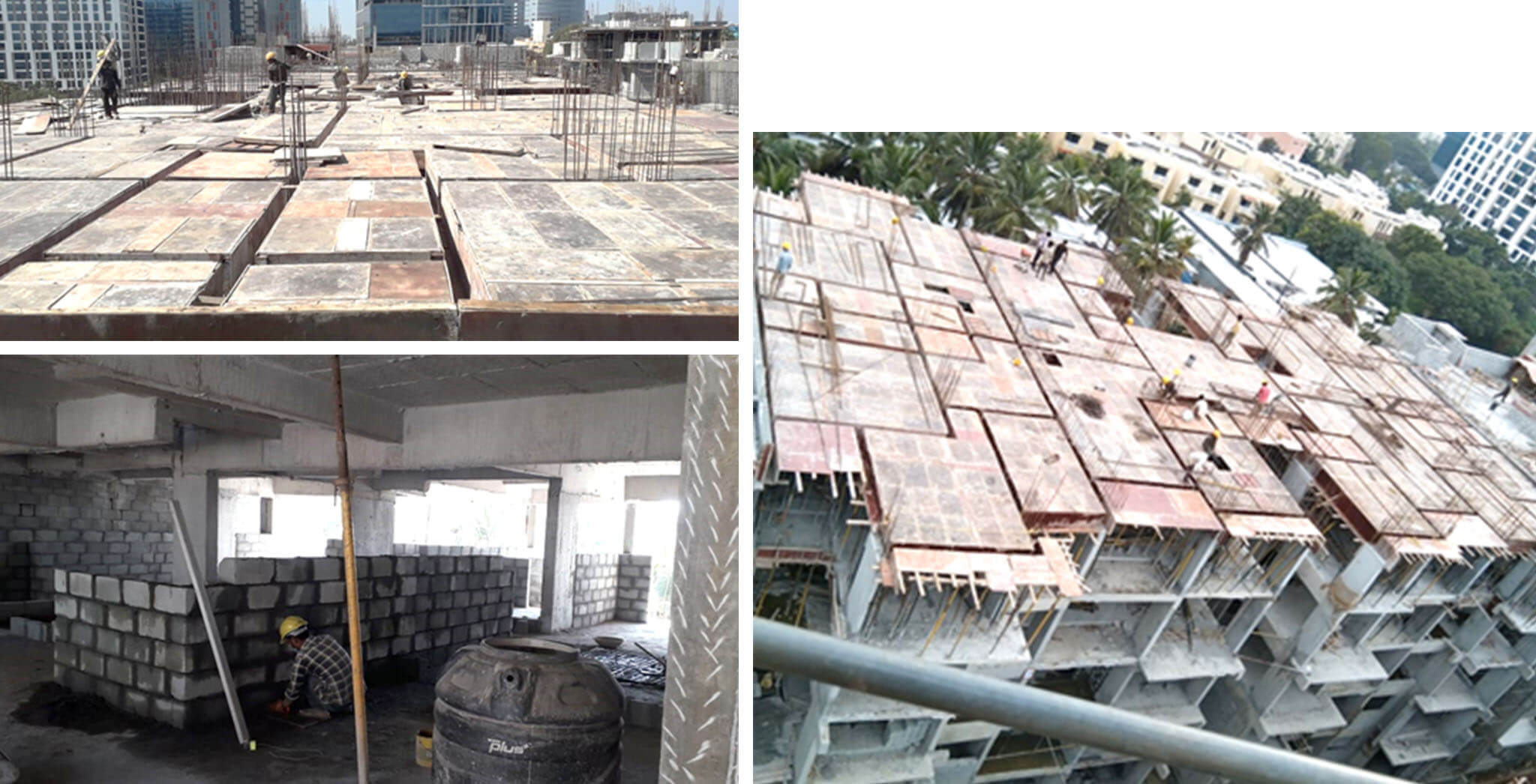

Nov 2021 - S Block: External painting works in progress. Internal flat flooring works in progress
Nov 2021 - S Block: External painting works in progress. Internal flat flooring works in progress

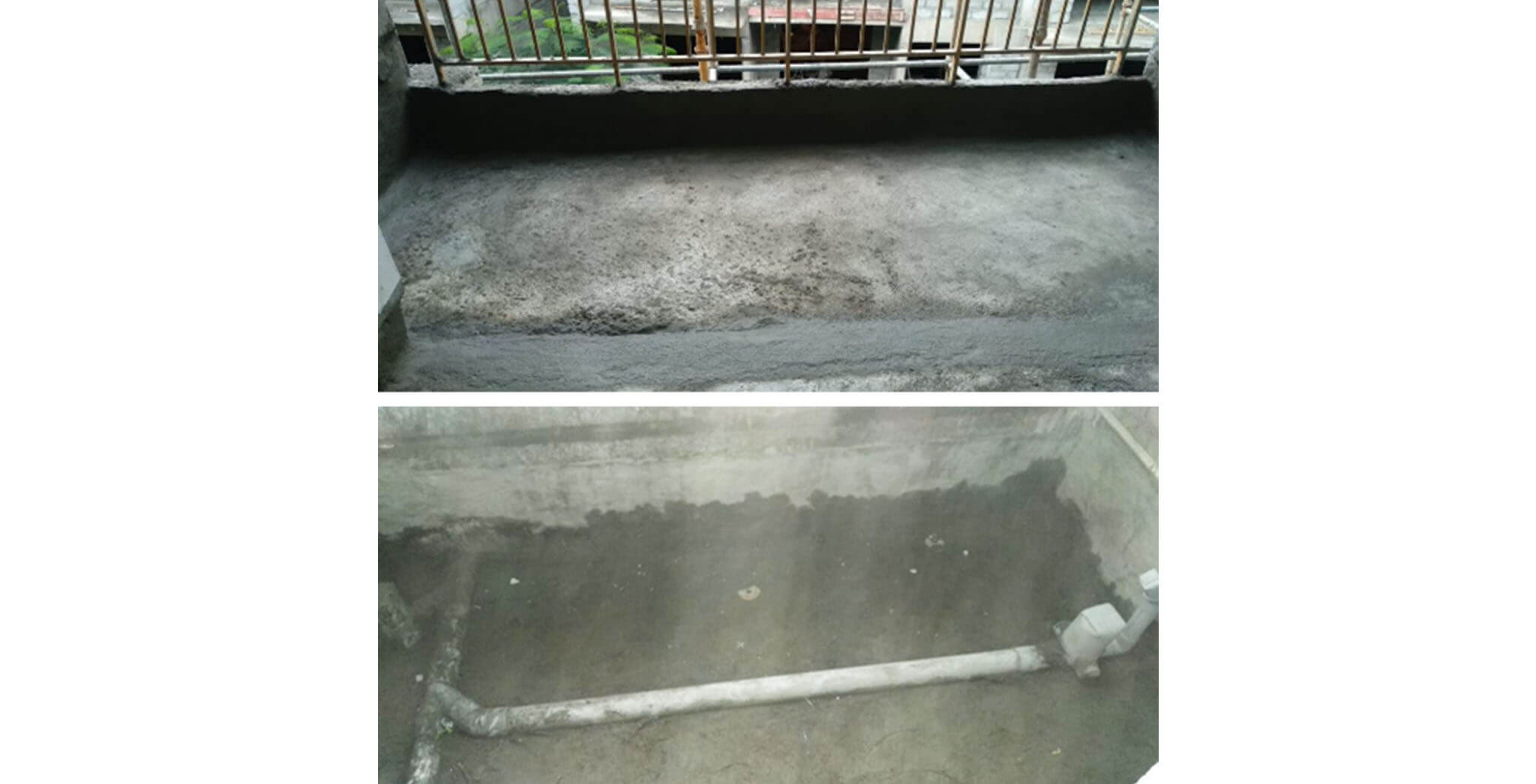

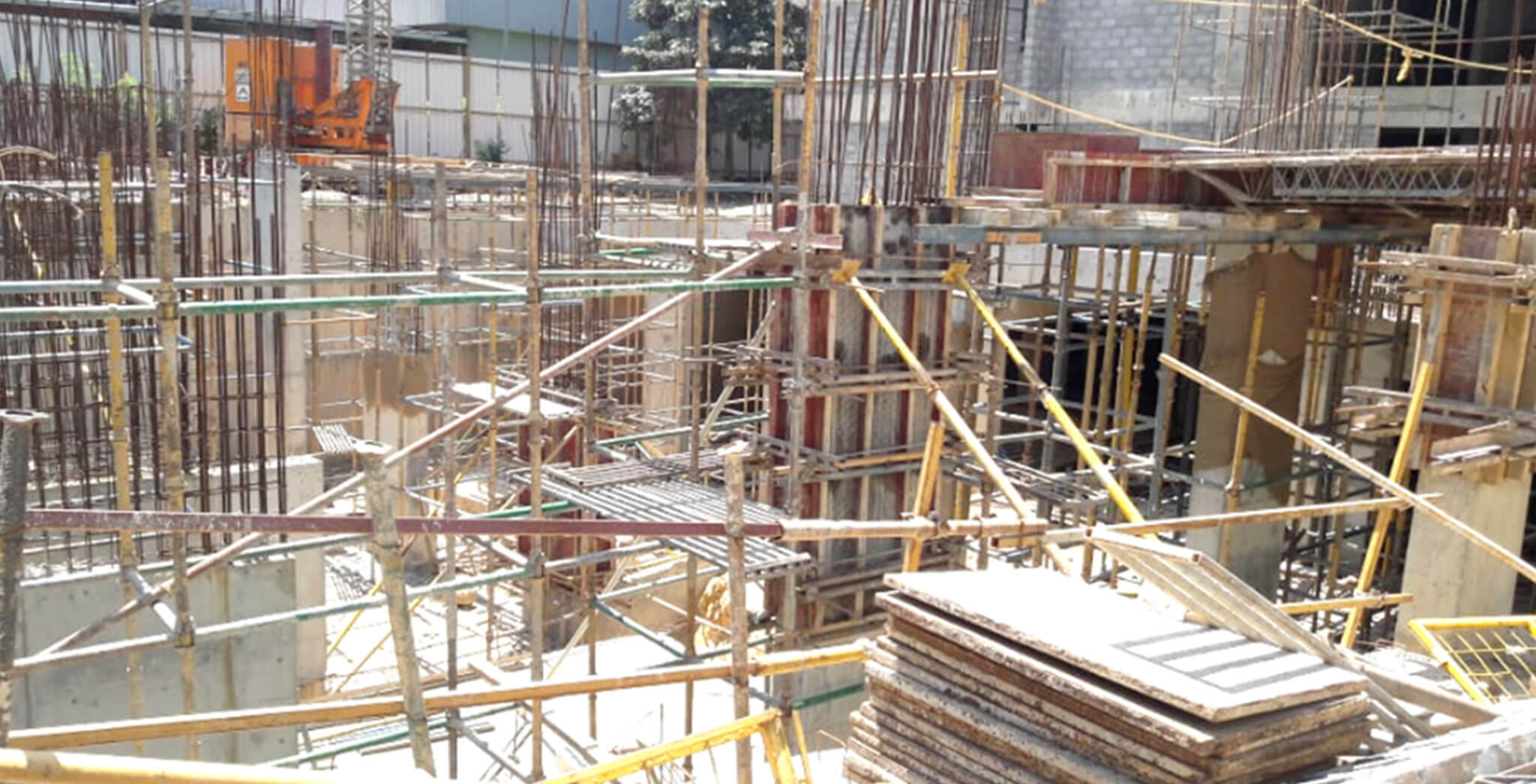

Nov 2021 - R Block: Internal flat flooring, UPVC window installation works completed. Internal flat wooden door installation, painting works in progress
Nov 2021 - R Block: Internal flat flooring, UPVC window installation works completed. Internal flat wooden door installation, painting works in progress

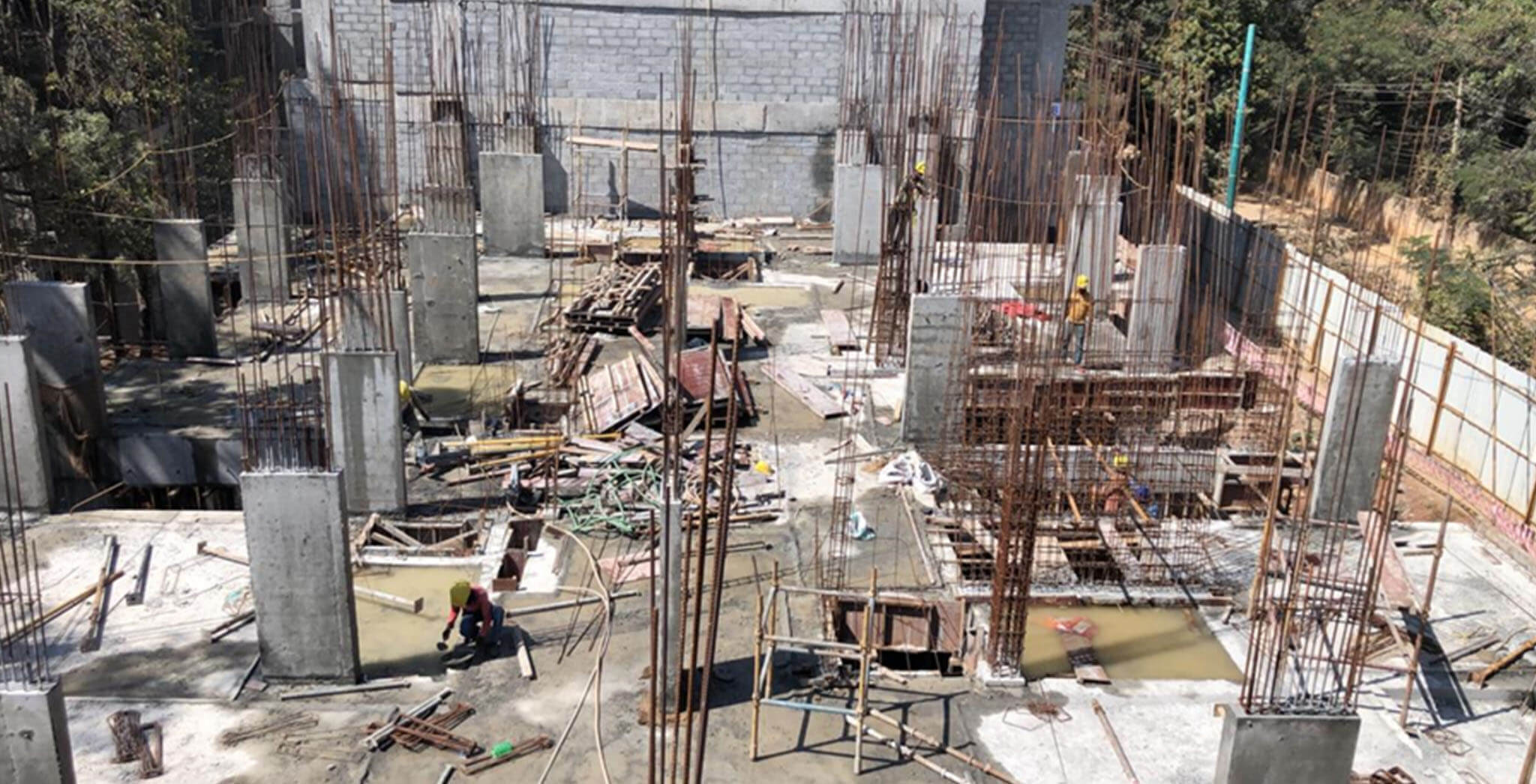

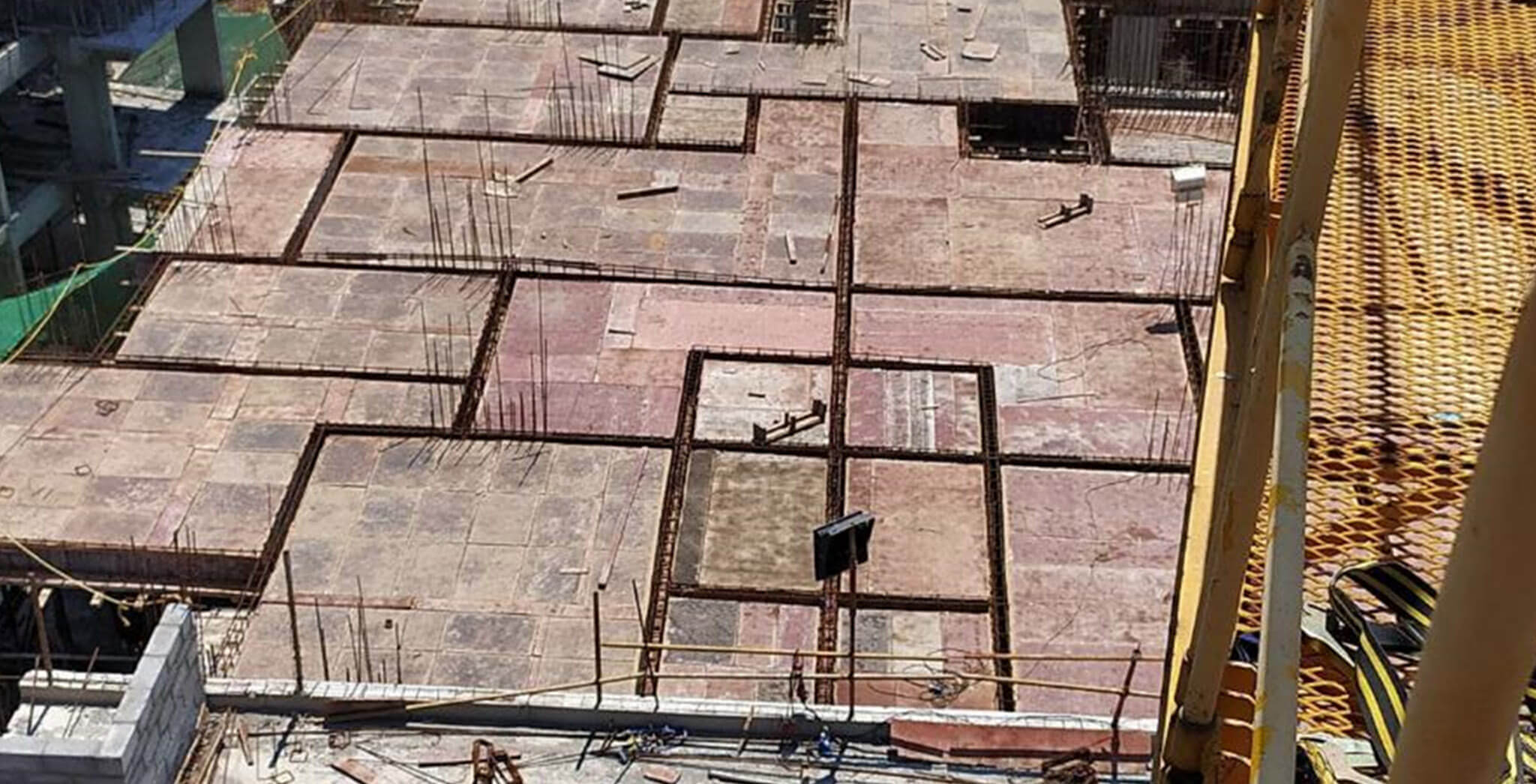

Nov 2021 - Q Block: Lift commissioning works in progress. Internal flat flooring and putty works completed
Nov 2021 - Q Block: Lift commissioning works in progress. Internal flat flooring and putty works completed

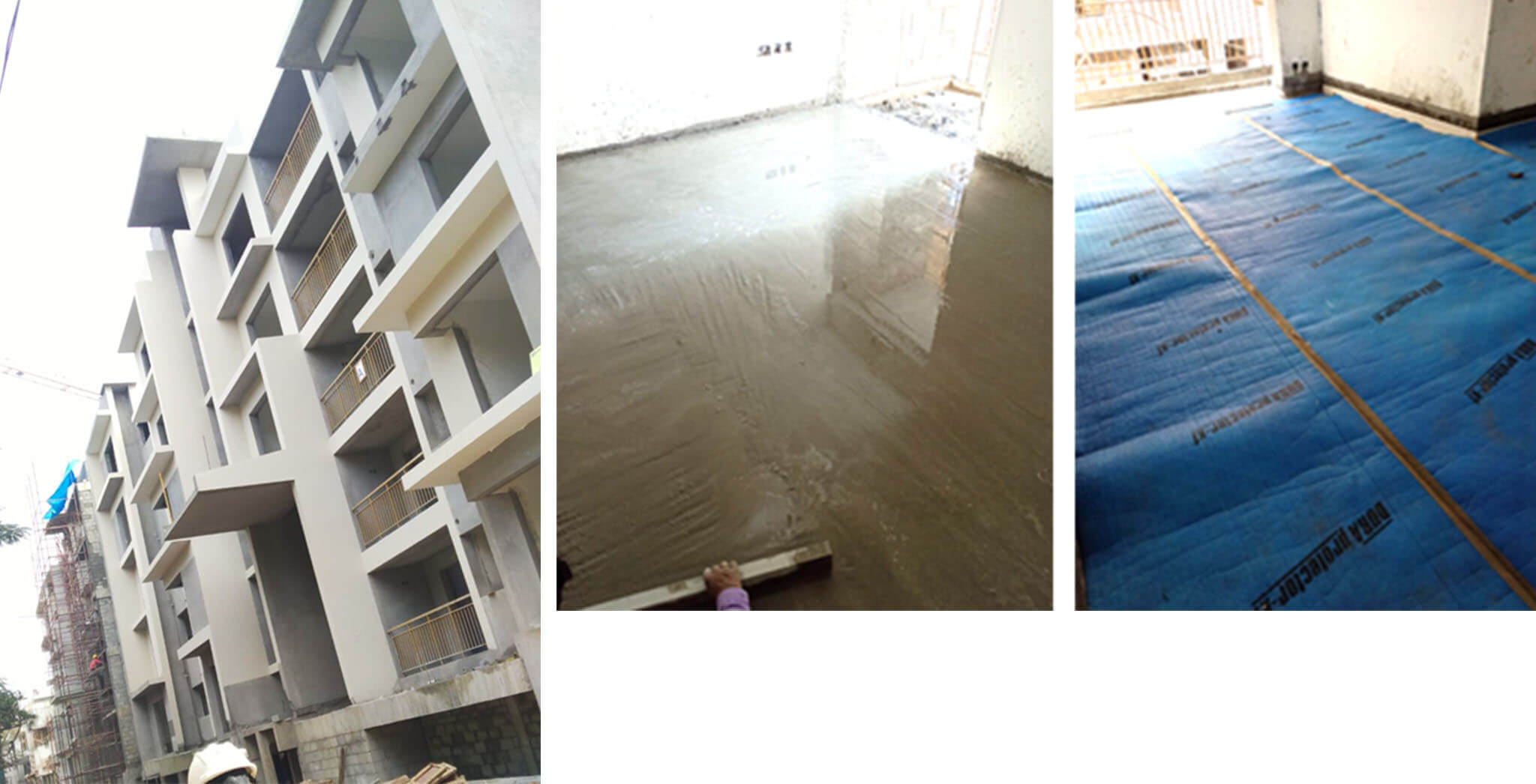

Nov 2021 - P Block: External elevation Painting works in progress. UPVC window installation works in progress
Nov 2021 - P Block: External elevation Painting works in progress. UPVC window installation works in progress

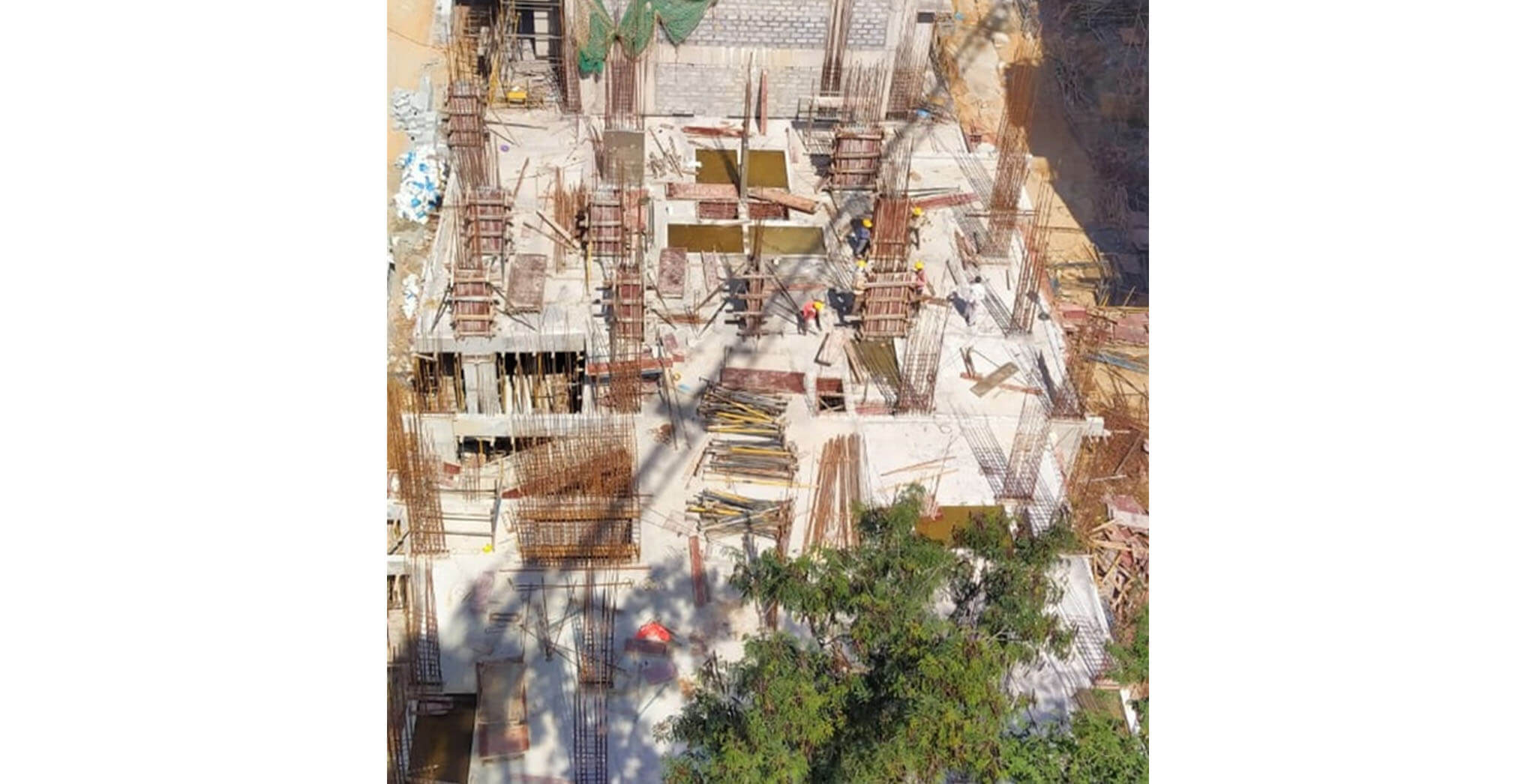

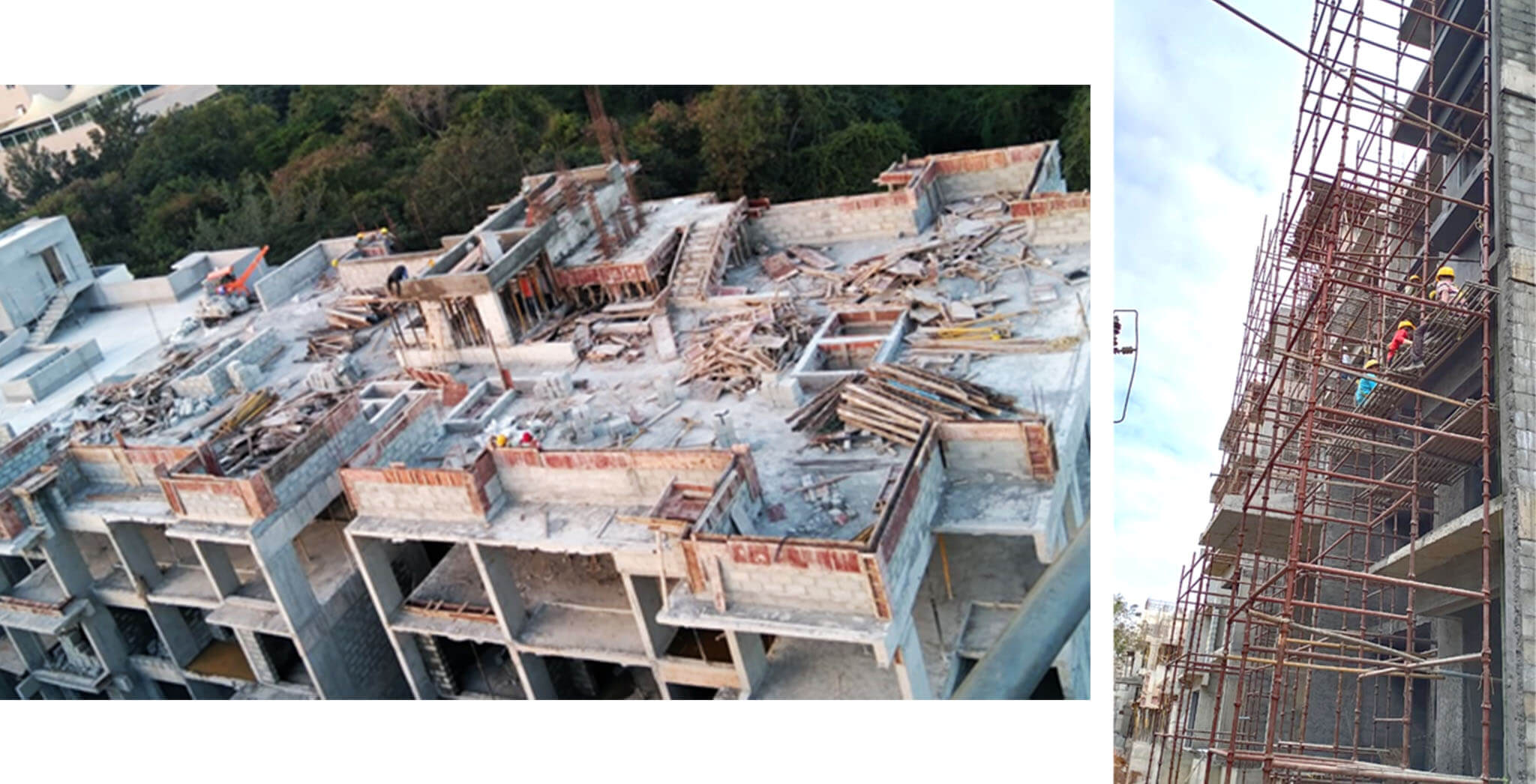

Nov 2021 - N Block: Lobby false ceiling works in progress. Internal flat flooring and painting works in progress. Wooden door installation works in progress
Nov 2021 - N Block: Lobby false ceiling works in progress. Internal flat flooring and painting works in progress. Wooden door installation works in progress

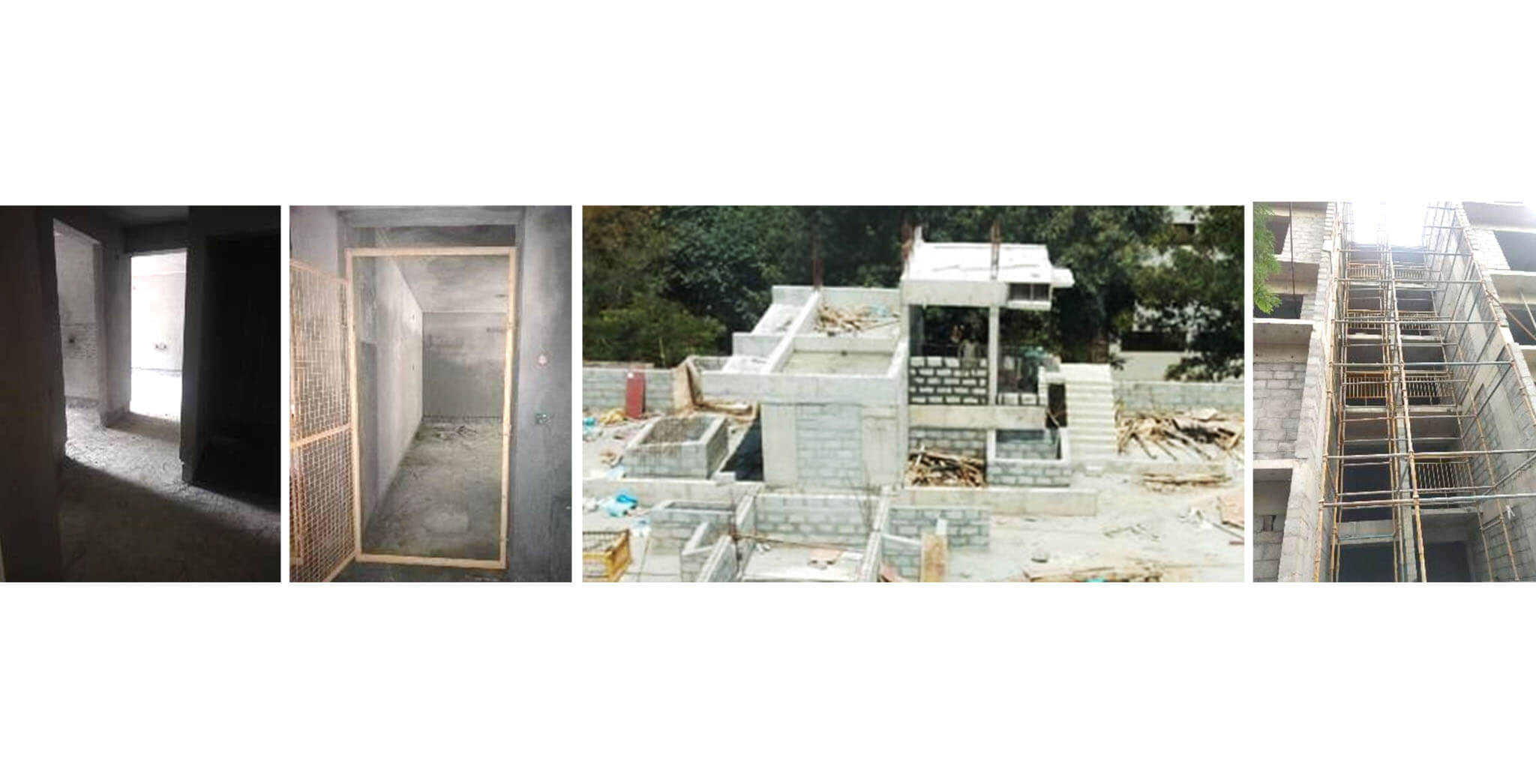

Nov 2021 - M Block: Entrance façade works in progress. Internal flat painting and flooring works in progress
Nov 2021 - M Block: Entrance façade works in progress. Internal flat painting and flooring works in progress

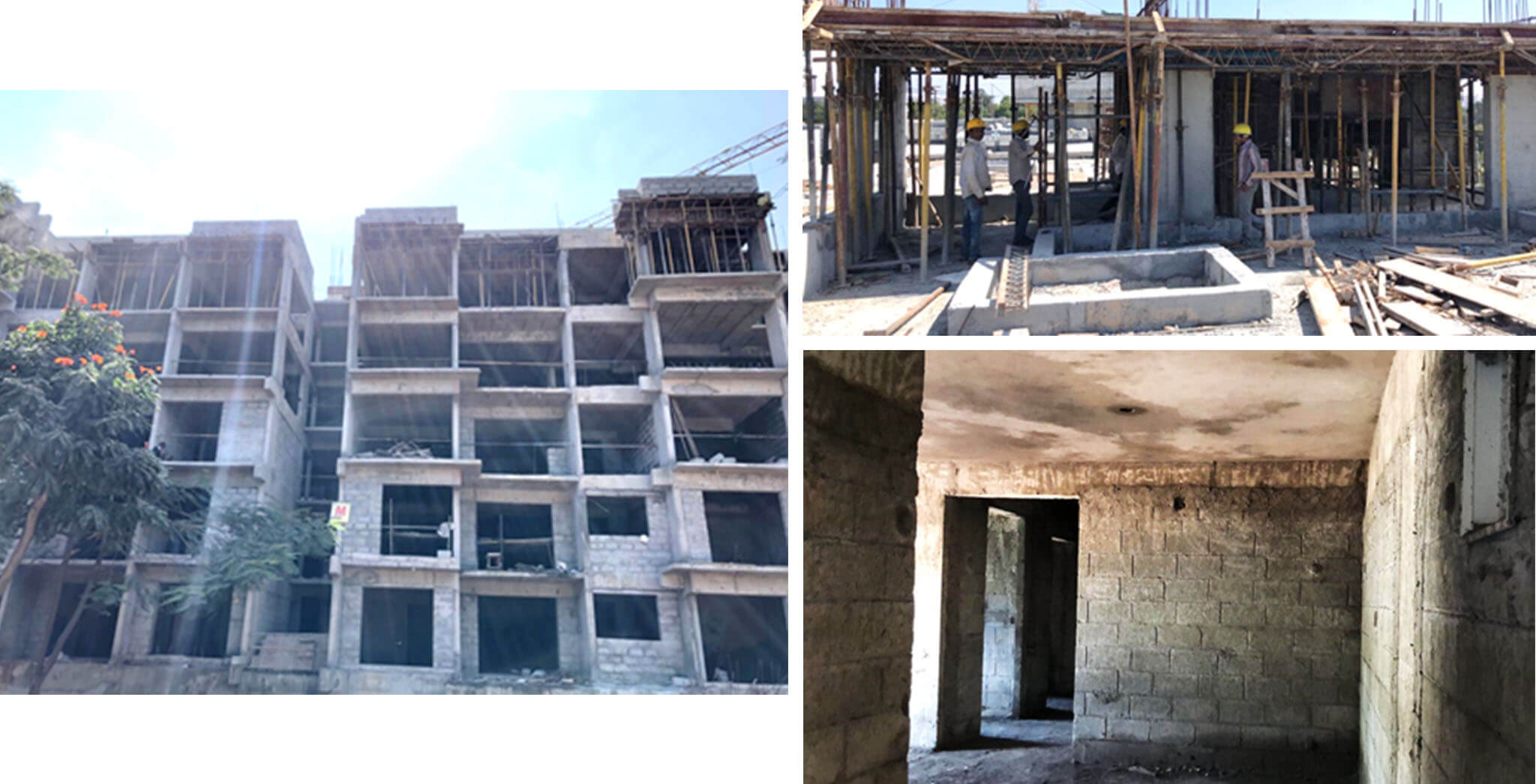

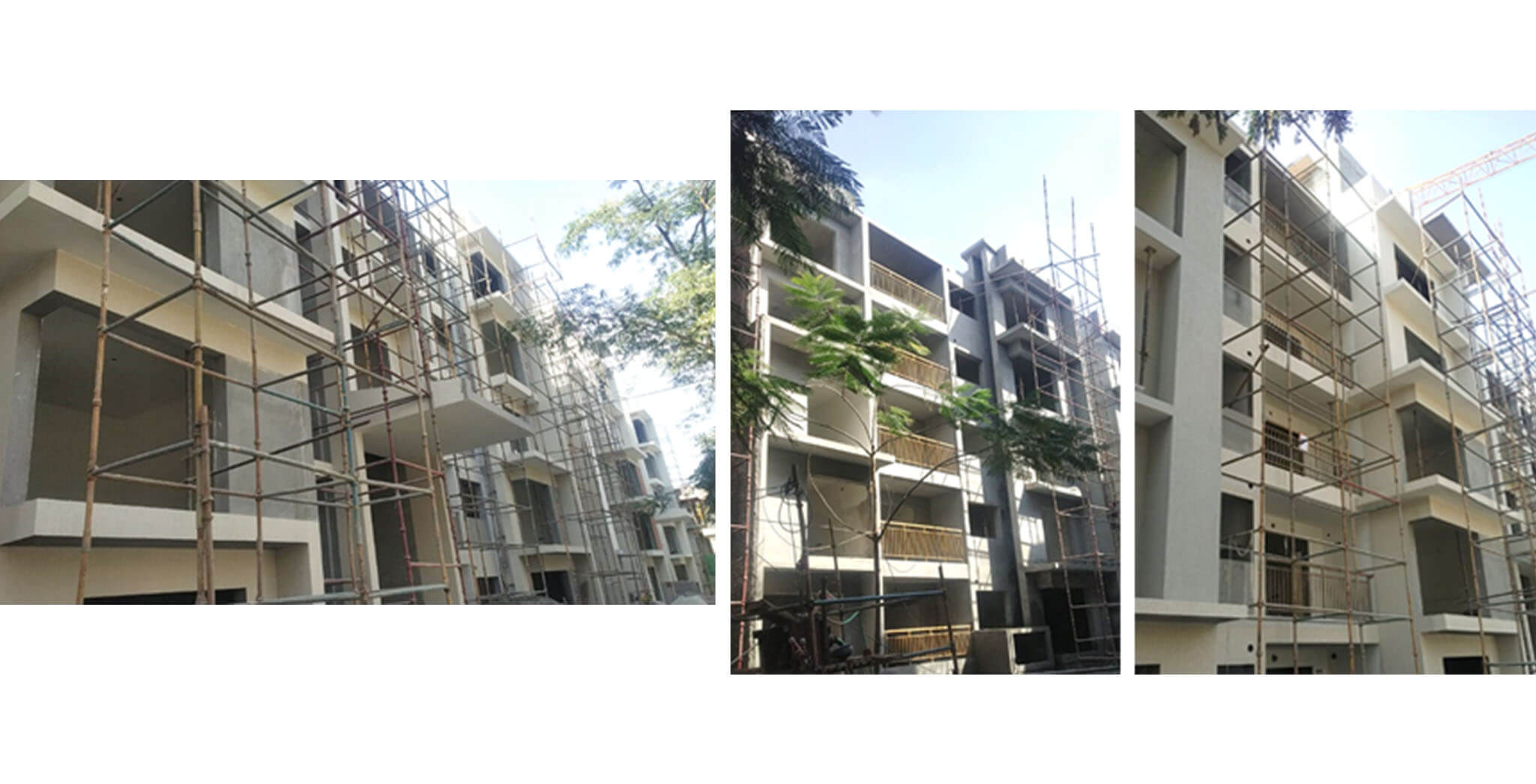

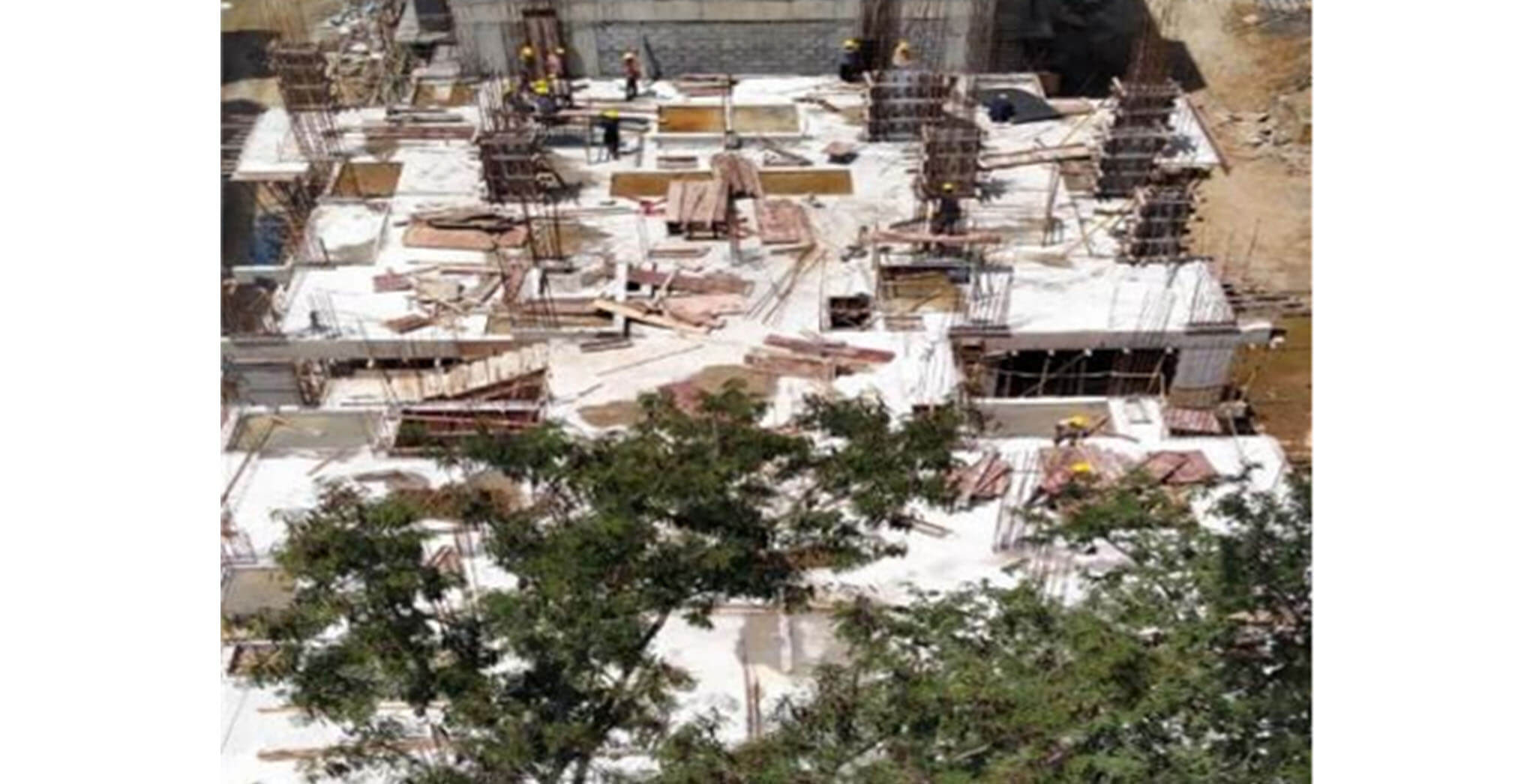

Nov 2021 - L Block: Internal flat painting works in progress. External painting works completed. UPVC windows installation works completed
Nov 2021 - L Block: Internal flat painting works in progress. External painting works completed. UPVC windows installation works completed
Nov 2021 - K Block: External painting works completed. External cladding works in progress
Nov 2021 - K Block: External painting works completed. External cladding works in progress
Nov 2021 - J Block: Lobby false ceiling works in progress. Wooden doors installation works in progress
Nov 2021 - J Block: Lobby false ceiling works in progress. Wooden doors installation works in progress
Nov 2021 - H Block:  Internal flat painting works in progress. UPVC windows installation works completed
Nov 2021 - H Block: Internal flat painting works in progress. UPVC windows installation works completed

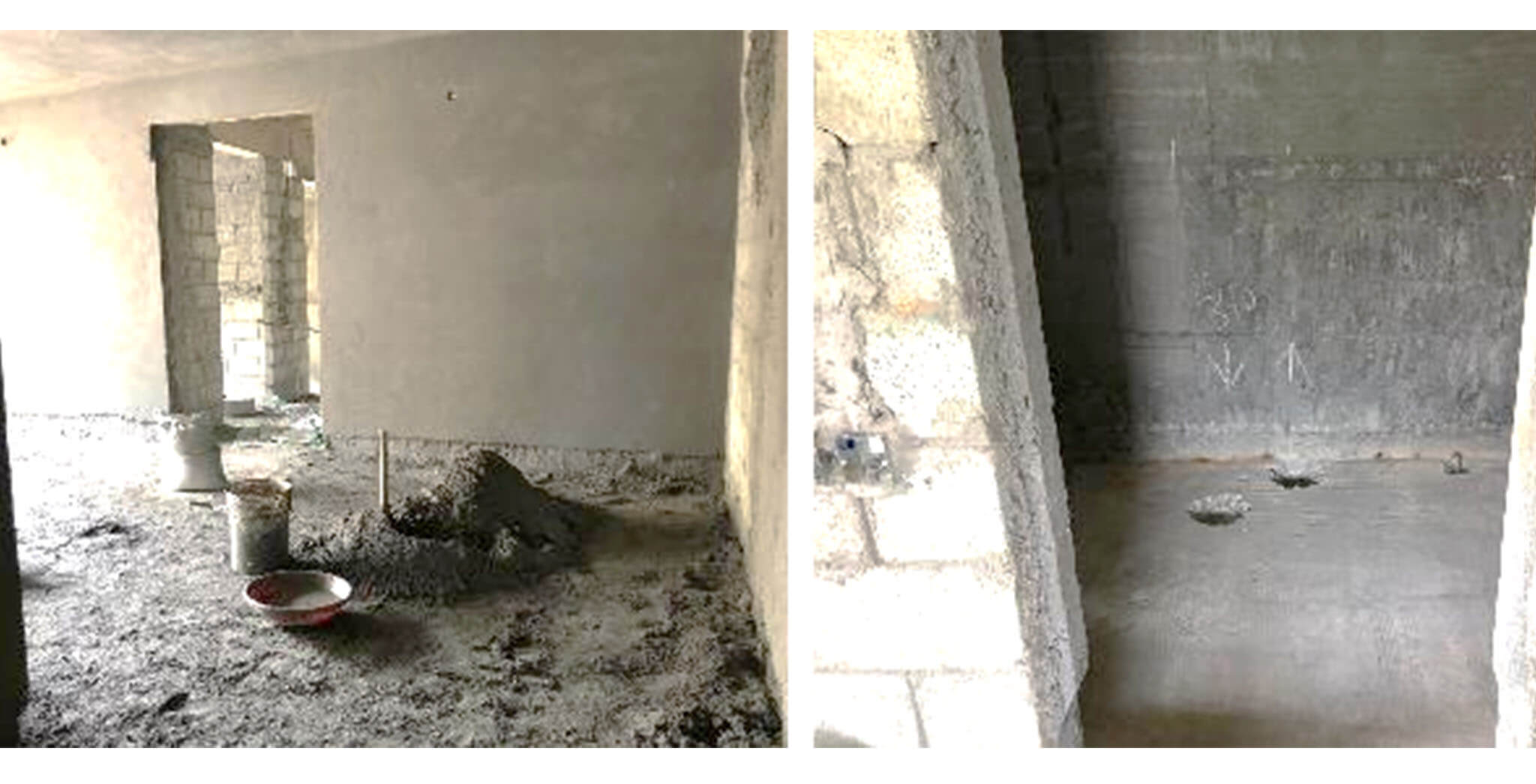

Nov 2021 - G Block: Internal flat flooring, painting, wooden door installation works in progress. External painting works completed
Nov 2021 - G Block: Internal flat flooring, painting, wooden door installation works in progress. External painting works completed

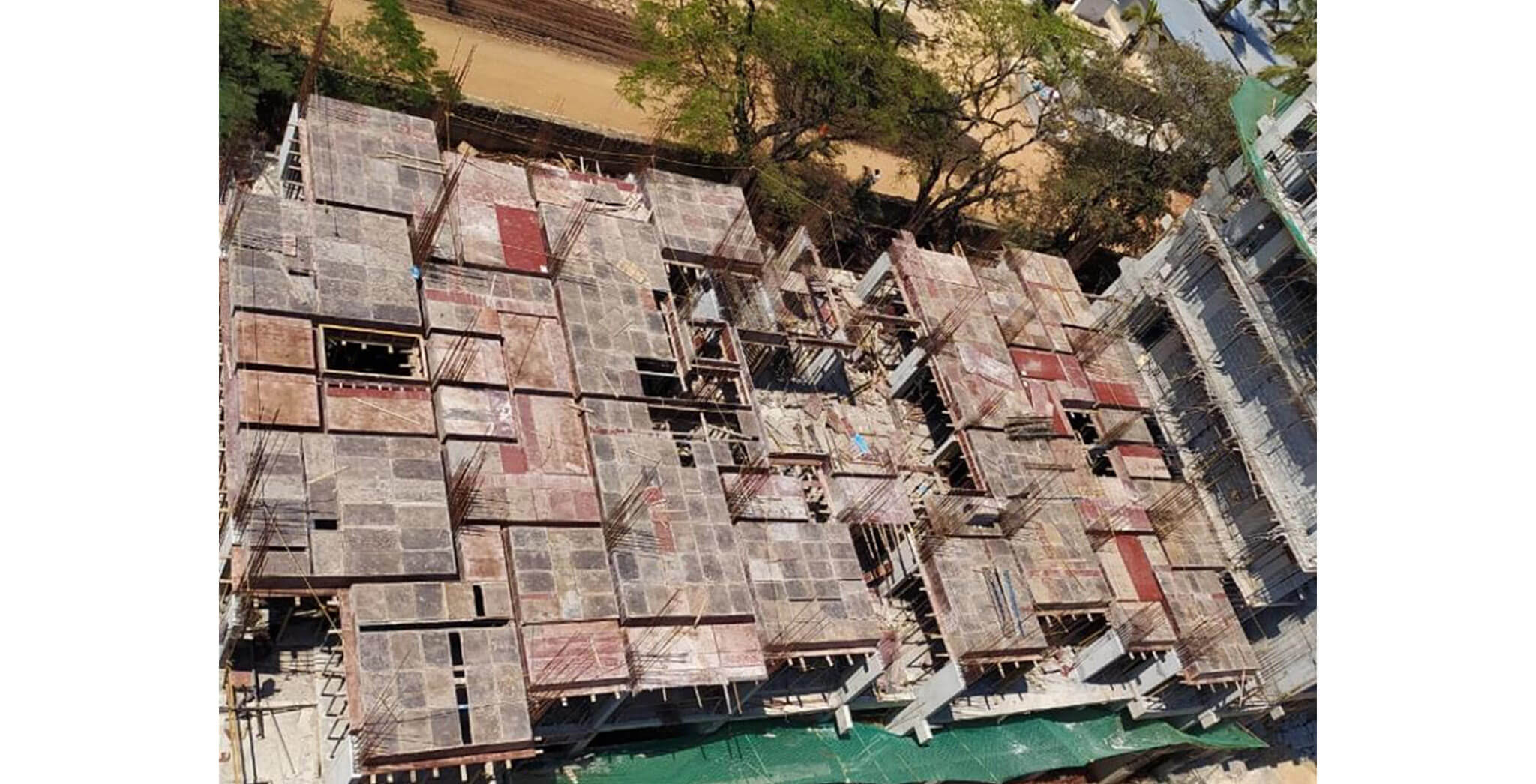

Nov 2021 - F Block: Lobby false ceiling, flooring and painting works completed. External painting and cladding works completed. Internal flat flooring and UPVC windows installation works completed
Nov 2021 - F Block: Lobby false ceiling, flooring and painting works completed. External painting and cladding works completed. Internal flat flooring and UPVC windows installation works completed

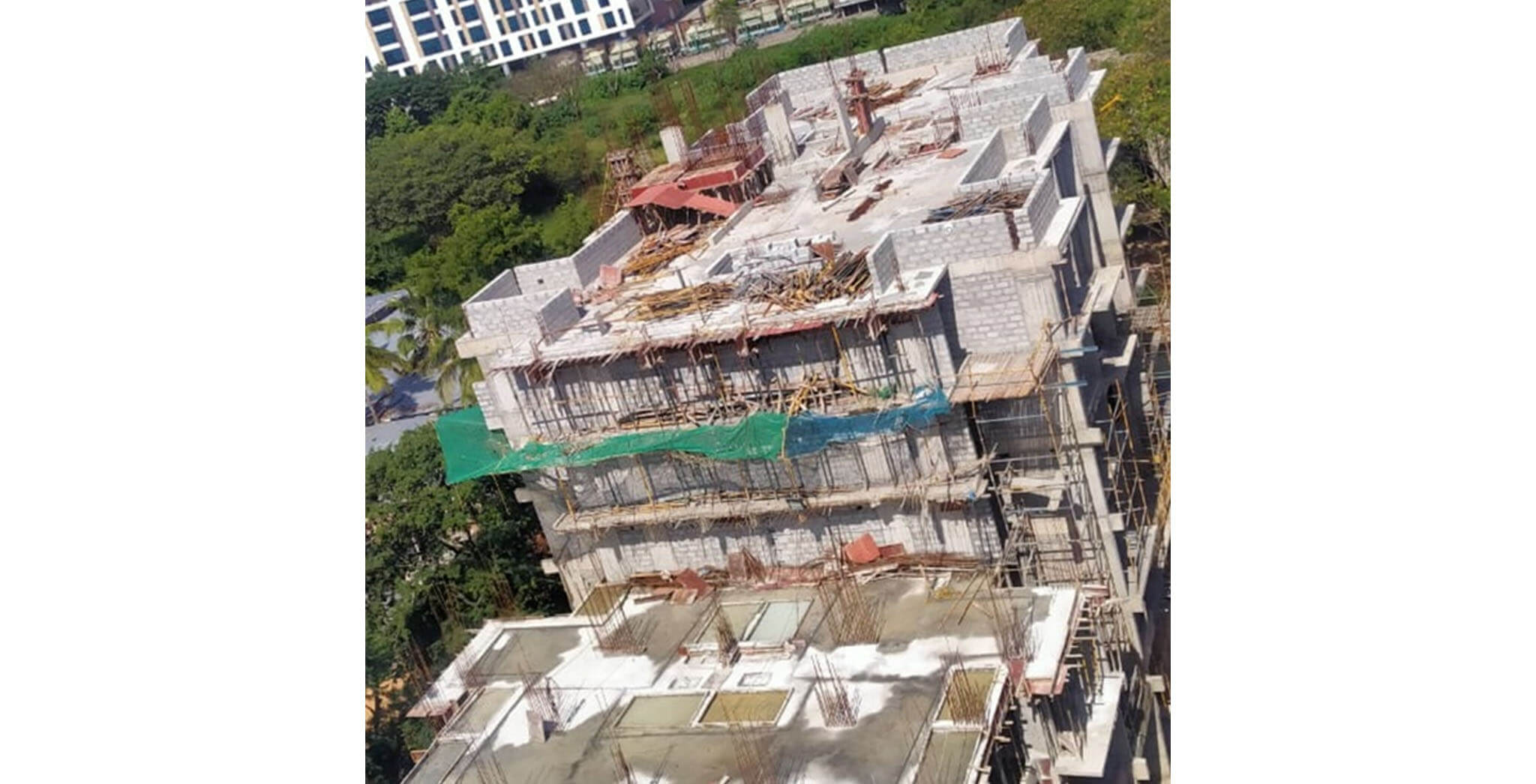

Nov 2021 - E Block: External painting and cladding works completed. Entrance façade work completed. Internal flat painting works in progress. Internal flat flooring works completed
Nov 2021 - E Block: External painting and cladding works completed. Entrance façade work completed. Internal flat painting works in progress. Internal flat flooring works completed
Nov 2021 - D Block: External elevation texture works completed, painting work in progress. UPVC window installation works in progress. Internal flat putty works in progress
Nov 2021 - D Block: External elevation texture works completed, painting work in progress. UPVC window installation works in progress. Internal flat putty works in progress
Nov 2021 - C Block: External painting works in progress. Internal flat putty and flooring works in progress. UPVC window installation works in progress
Nov 2021 - C Block: External painting works in progress. Internal flat putty and flooring works in progress. UPVC window installation works in progress
Nov 2021 - B Block: External painting, cladding works in progress. Internal flat flooring, painting, UPVC window installation works in progress
Nov 2021 - B Block: External painting, cladding works in progress. Internal flat flooring, painting, UPVC window installation works in progress
Nov 2021 - A Block: External painting works in progress. UPVC windows and door installation works in progress. Wooden door installation works in progress
Nov 2021 - A Block: External painting works in progress. UPVC windows and door installation works in progress. Wooden door installation works in progress
Nov 2021 - S Block: On commencement of painting milestone
Nov 2021 - S Block: On commencement of painting milestone
Nov 2021 - D Block: On commencement of painting milestone
Nov 2021 - D Block: On commencement of painting milestone
Nov 2021 - C Block: On commencement of painting milestone
Nov 2021 - C Block: On commencement of painting milestone
Nov 2021 - B Block: On installation of Lifts milestone
Nov 2021 - B Block: On installation of Lifts milestone
Nov 2021 - P Block: On installation of Lifts milestone
Nov 2021 - P Block: On installation of Lifts milestone
Nov 2021 - N Block: On installation of Lifts milestone
Nov 2021 - N Block: On installation of Lifts milestone
Nov 2021 - M Block: On installation of Lifts milestone
Nov 2021 - M Block: On installation of Lifts milestone
1/25

Get In Touch

RERA STATUS:

PRM/KA/RERA/1251/446/PR/180611/001895. Available at www.rera.karnataka.gov.in

PRICE:

Rs. 1.49 Crore onwards*
*Plus Registration.

TYPE:

3 Bedroom apartments

SUPER BUILT-UP AREA:

164 Sq.m

CARPET AREA:

109 Sq.m

Note: (1 Sq.m = 10.764 Sq.ft)

Features

Indoor badminton court, Table tennis room, Multi-purpose hall with pantry space, Snooker room, Indoor kid’s play area, Board & card games area, Terrace party area, Open air theatre, Balinese landscaping, Rainwater harvesting pond, Sandpit area for kids, Multi-purpose open area, Party lawn, Open lawn, Swimming pool, Tennis court, Basketball court, Pavilions with seating, Entrance cascade wall with rock feature
ADDRESS:

Next to Brigade Tech park, Behind GR tech Park, ITPB Main Rd, Pattandur Agrahara, Whitefield, Bengaluru, Karnataka 560066
