Aerial Day
A Lifestyle that Resonates with Elegance and Comfort
A Brigade home is always one of the wisest investments you can make. A home in North Bengaluru, just 15 minutes before the International airport, is nothing short of striking gold. Situated within the Aerospace Park, just minutes away from prominent commercial establishments like Shell Technology Centre, proposed Boeing and Rolls Royce offices, IT Parks and many more, the location is known for its clean wide roads, scenic greenery and impeccable infrastructure.
With Brigade El Dorado, the bar has been further raised, and you are invited to a lifestyle that can well be described as the gold standard of community living!
Read moreLand Area
50 Acres
Type
2 BHK Apartments
Super Built-up Area
49.66 Sq.m. - 128.43 Sq.m. (535 Sq.ft. - 1382 Sq.ft.)
Carpet Area
29.99 Sq.m. - 82.02 Sq.m. (322.81 Sq.ft. - 882.85 Sq.ft.)
Amenities
Discover unparalleled living experiences at these apartments near Aerospace Park, where luxury meets convenience.

*Images are for representation purpose.
Gallery

Community Building

Outdoor Gym

Aerial Night

Toddlers Play Area

Amphitheatre

Central Amenities

Main Entry

Vollyball Court

Tranquil Lawn

Tranquil Lawn

Tranquil Lawn

Tranquil Lawn
*Images are for representation purpose.
Videos
Master Plan
Embark on a visual journey to your dream space! Fill out the form to access the exclusive apartment unit plan and envision your life in a Brigade Home.
View Unit Plans
Price
INR 89 Lakhs Onwards*
*Government Charges, Other Charges and Taxes Applicable
*The prices are subject to change.
EMI Calculator
Price
INR 89 Lakhs Onwards*
*Government Charges, Other Charges and Taxes Applicable
* The prices are subject to change.
Location

Know Your Neighbourhood
ViewKnow Your Neighbourhood
ViewVidyashilp academy
6 km
Delhi Public School
6.9 km
Canadian International School
12.7 km
EKYA School
13.1 km
Chrysalis High School
13.6 km
National Public School
14.4 km
VIBGYOR School
19.1 km
Ryan International School
31 km
CMR University
5.2 km
REVA University
8.1 km
Brindavan College
8.5 km
Presidency College
19.5 km
Vidyashilp academy
6 km
Delhi Public School
6.9 km
Canadian International School
12.7 km
EKYA School
13.1 km
Chrysalis High School
13.6 km
National Public School
14.4 km
VIBGYOR School
19.1 km
Ryan International School
31 km
CMR University
5.2 km
REVA University
8.1 km
Brindavan College
8.5 km
Presidency College
19.5 km
Motherhood Hospital
14 km
Rainbow Children Hospital
16 km
Columbia Asia
17.8 km
Aster Hospital
23.2 km
Motherhood Hospital
14 km
Rainbow Children Hospital
16 km
Columbia Asia
17.8 km
Aster Hospital
23.2 km
Shell Technology Centre
3 km
Boeing
6 km
Dynamatics
8 km
Hinduja Ecopolis
12 km
North Gate Office Park
15 km
L and T Tech Park
17 km
Manyata Tech Park (Nagavara)
17 km
Shell Technology Centre
3 km
Boeing
6 km
Dynamatics
8 km
Hinduja Ecopolis
12 km
North Gate Office Park
15 km
L and T Tech Park
17 km
Manyata Tech Park (Nagavara)
17 km
Decathlon (Anubhava)
9 km
Byg Brewsky
10.6 km
LULU Value Mart
11.3 km
Galleria Mall (RMZ)
13.1 km
Esteem Mall
18 km
Elements Mall
18.4 km
Decathlon (Anubhava)
9 km
Byg Brewsky
10.6 km
LULU Value Mart
11.3 km
Galleria Mall (RMZ)
13.1 km
Esteem Mall
18 km
Elements Mall
18.4 km

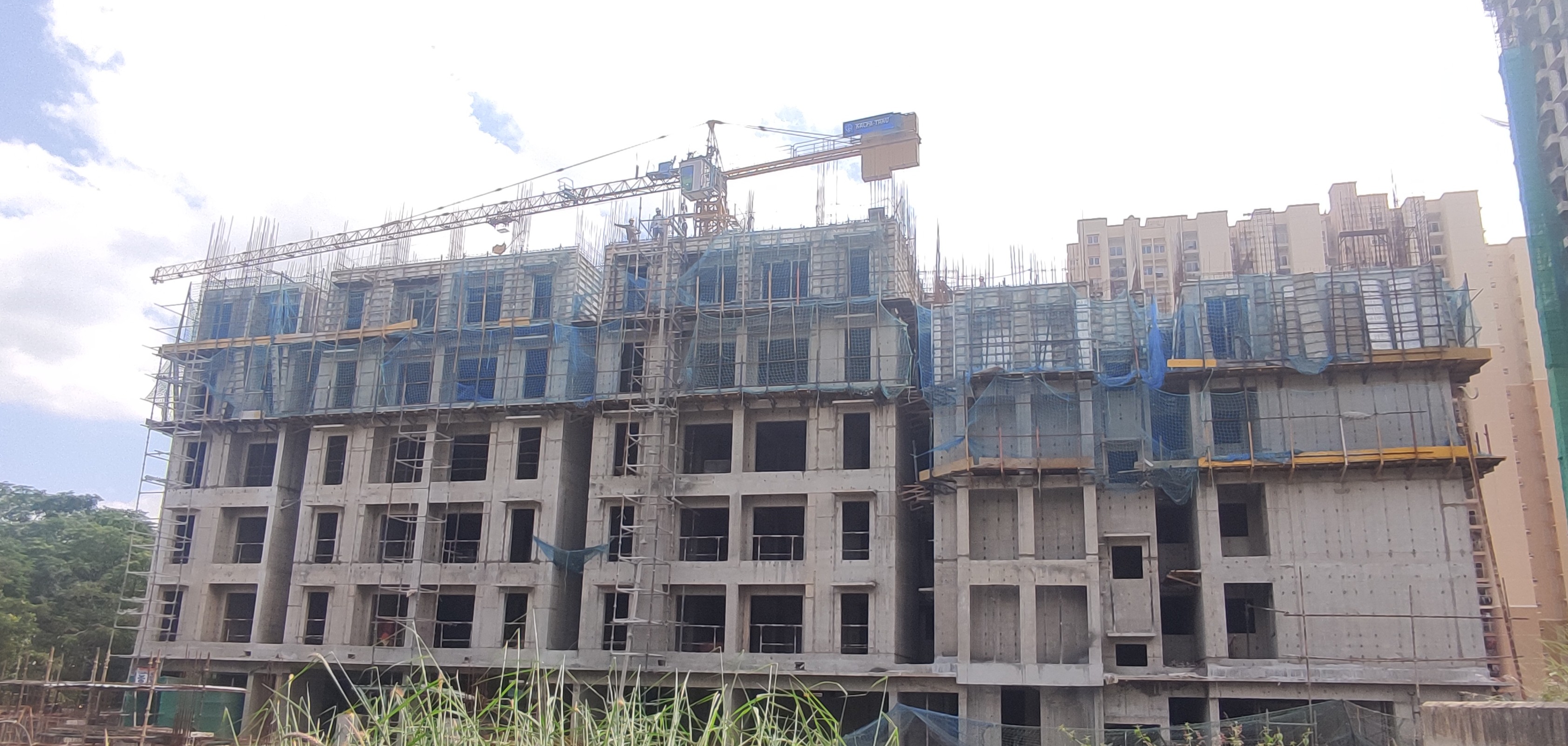

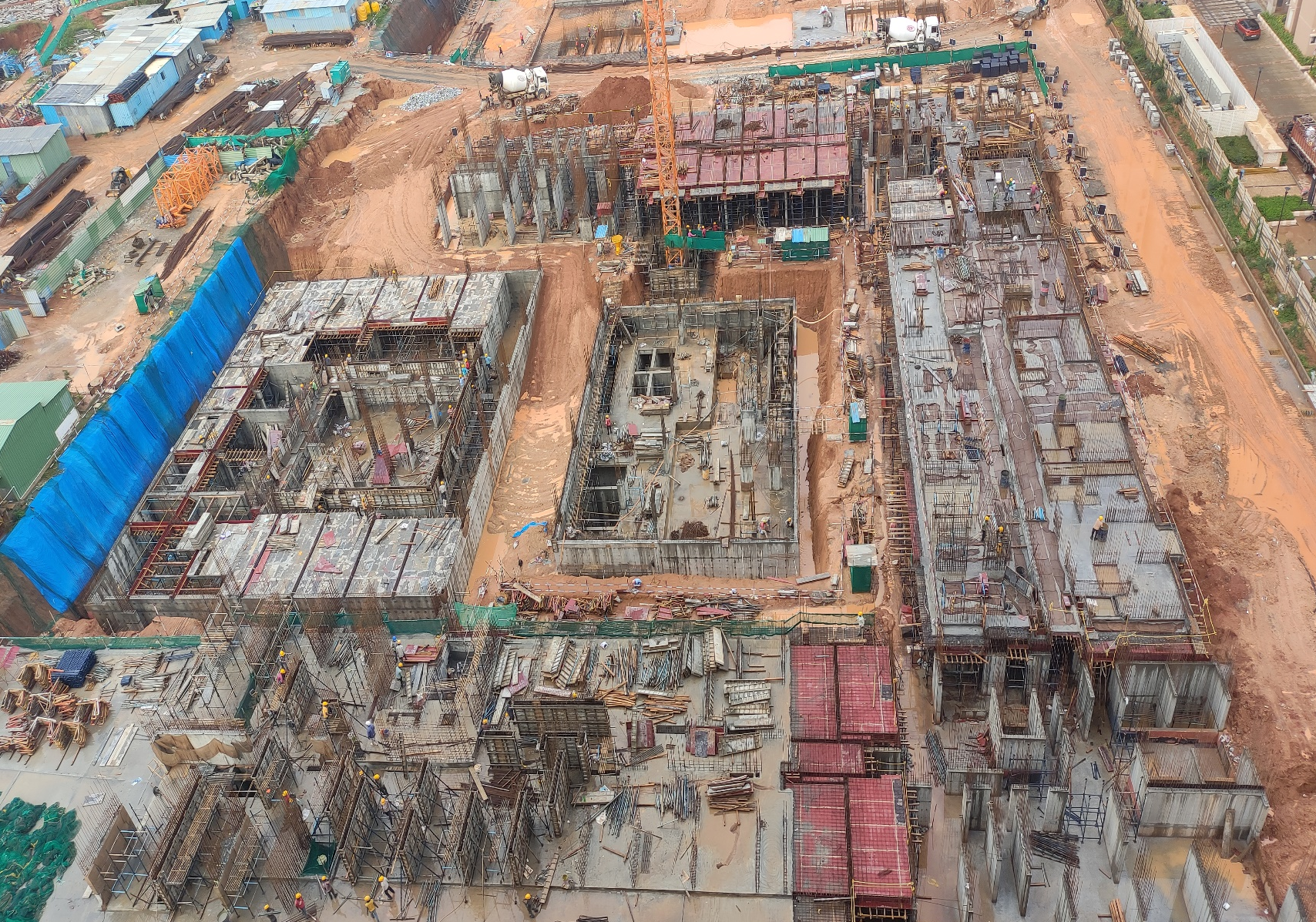

Project Status

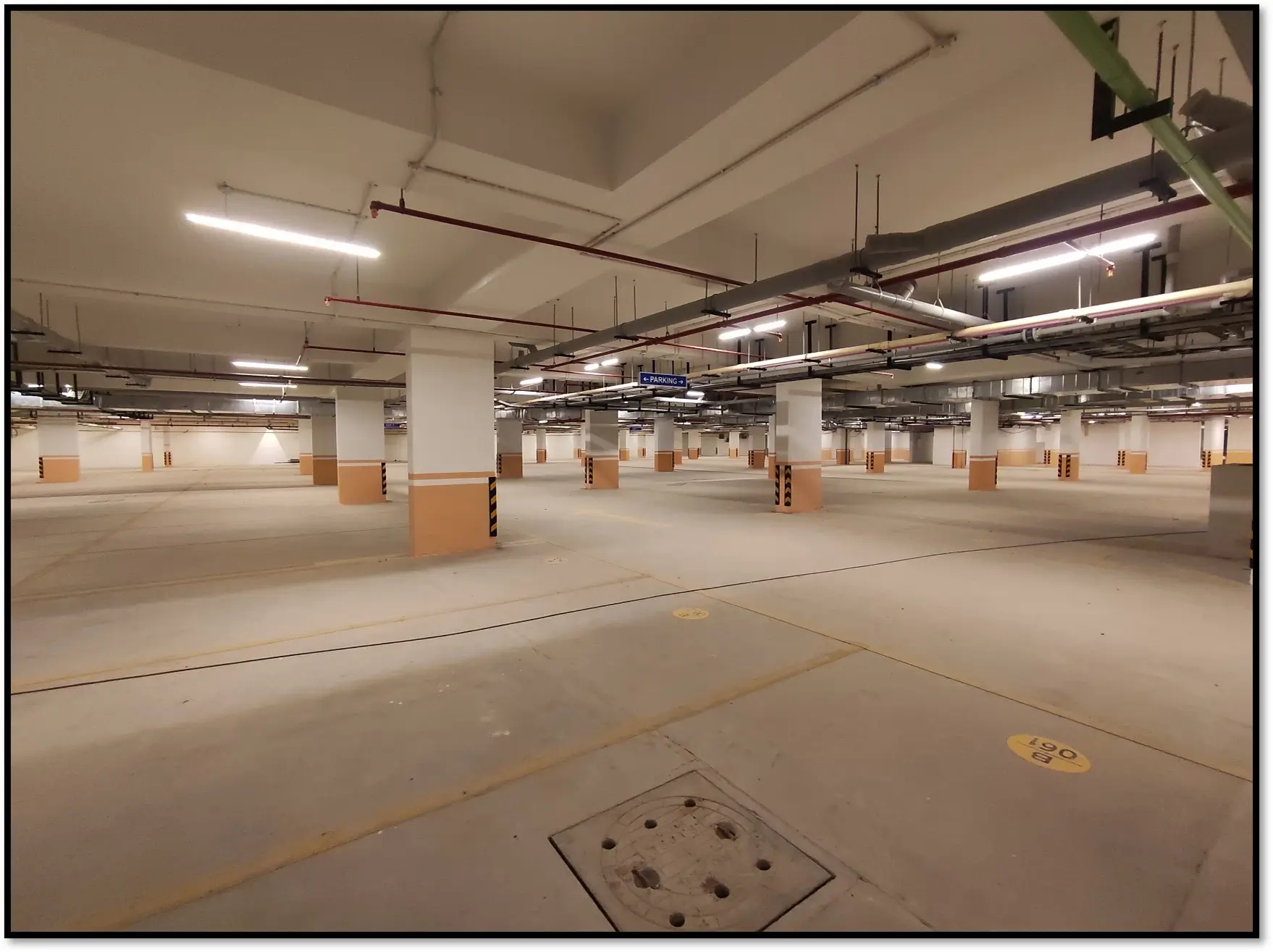

The entire project exudes a rare sense of completeness.

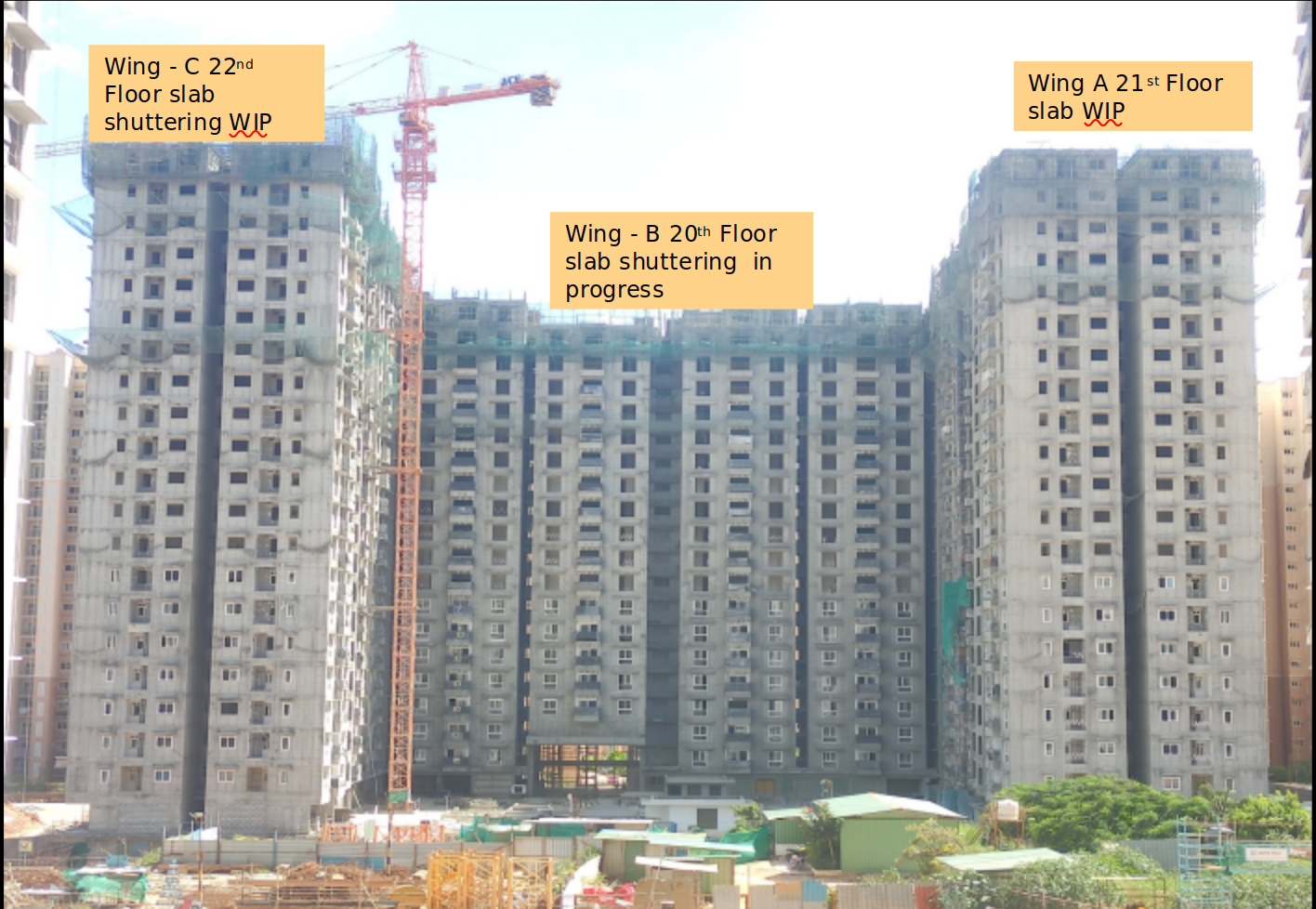

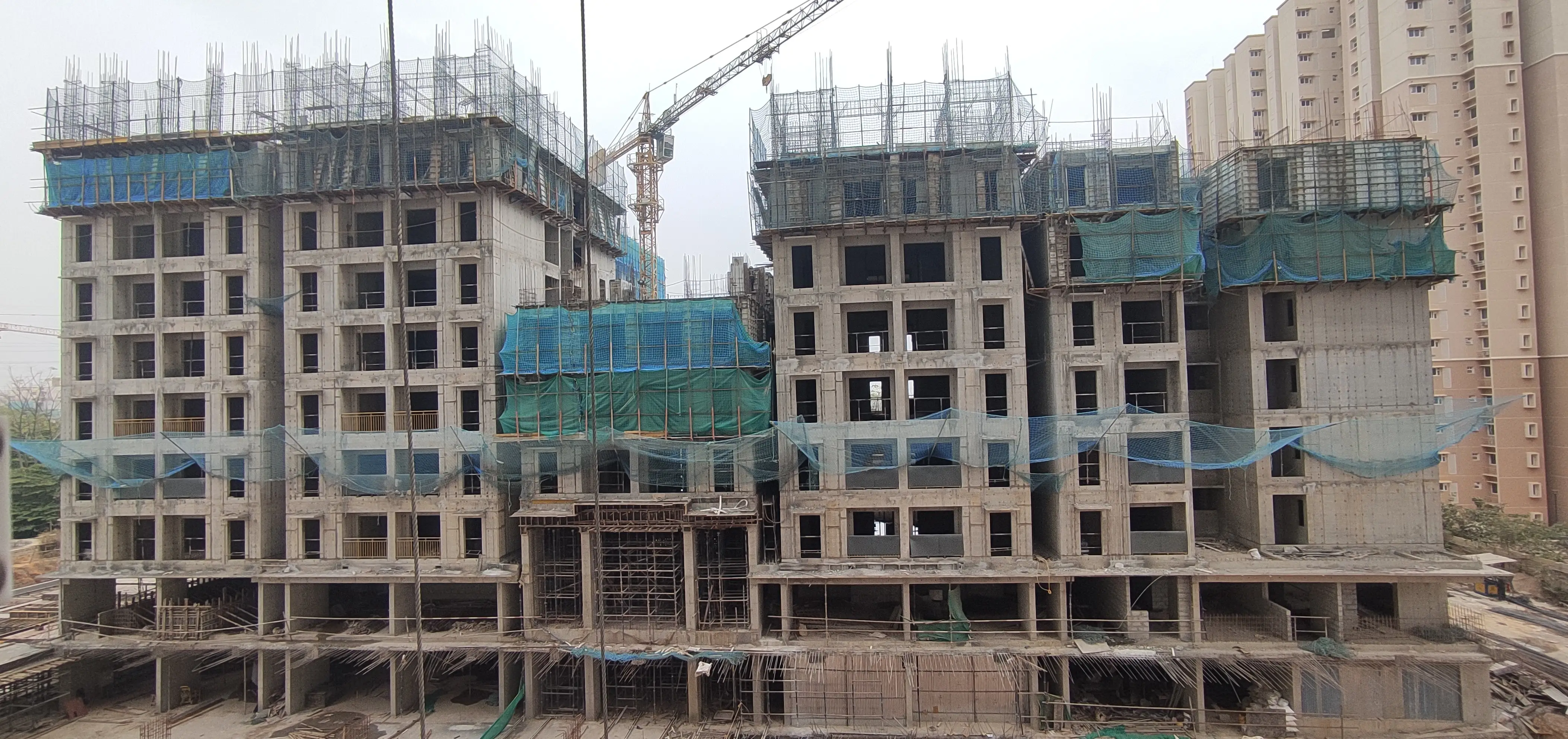

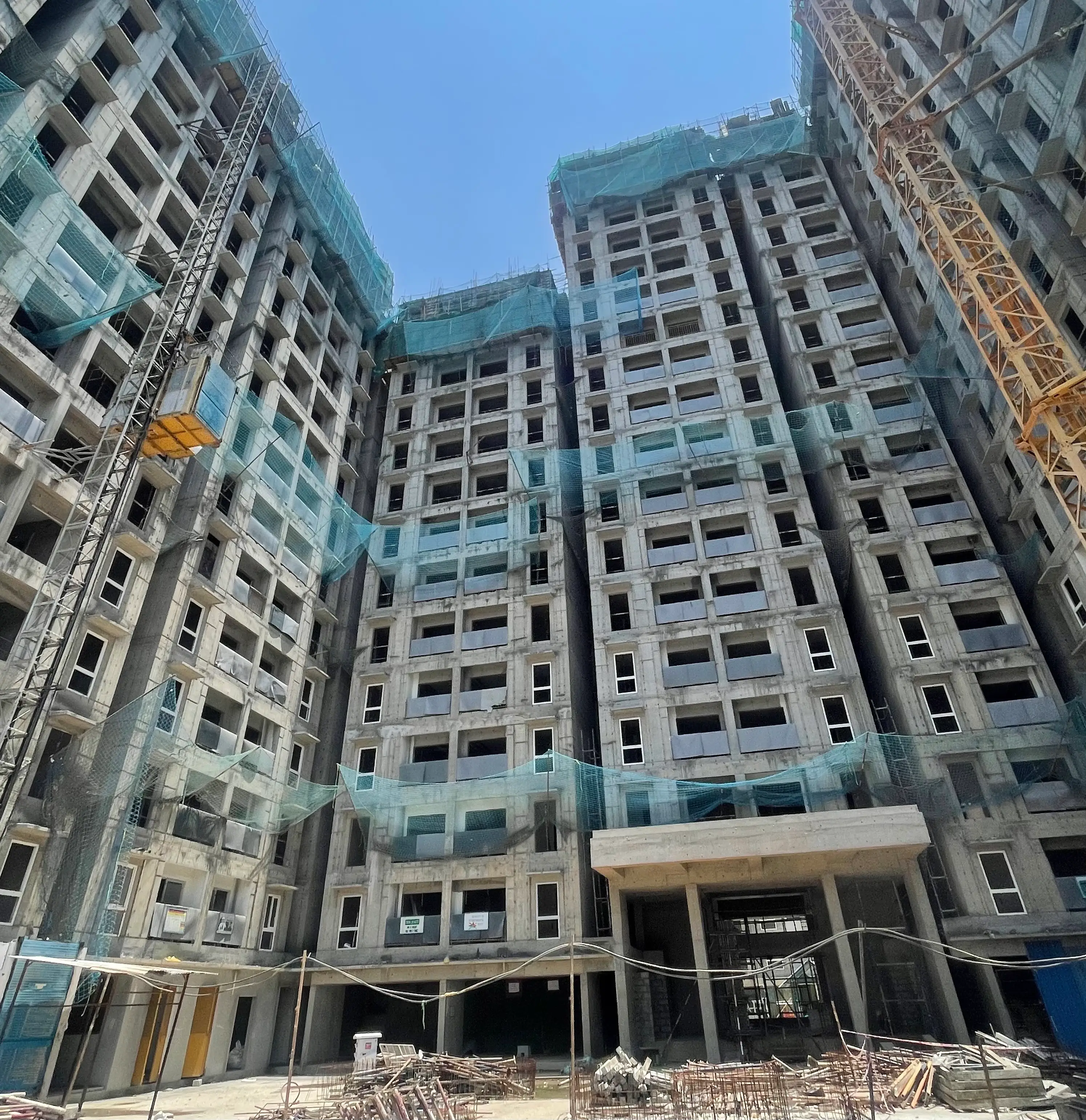

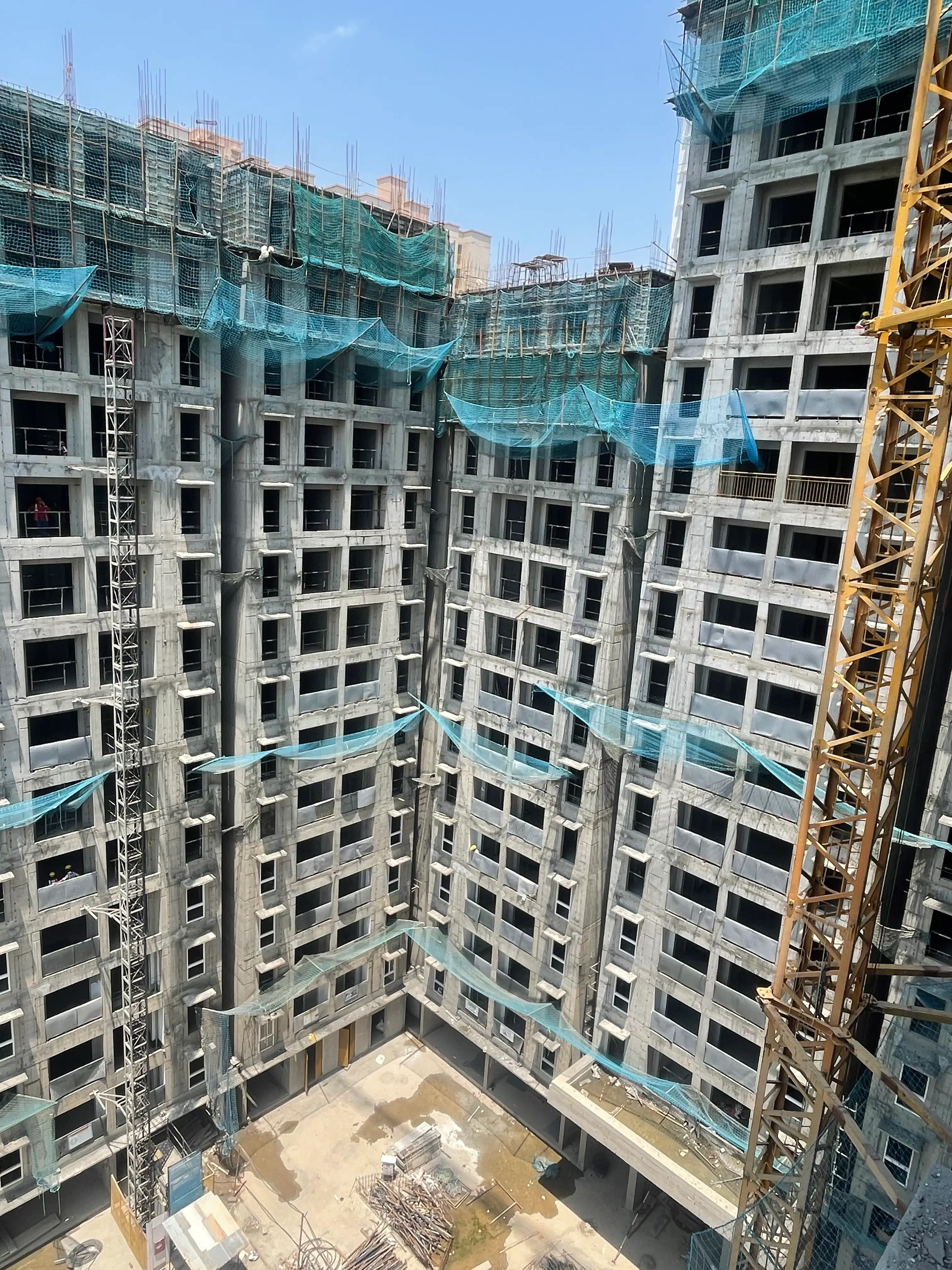

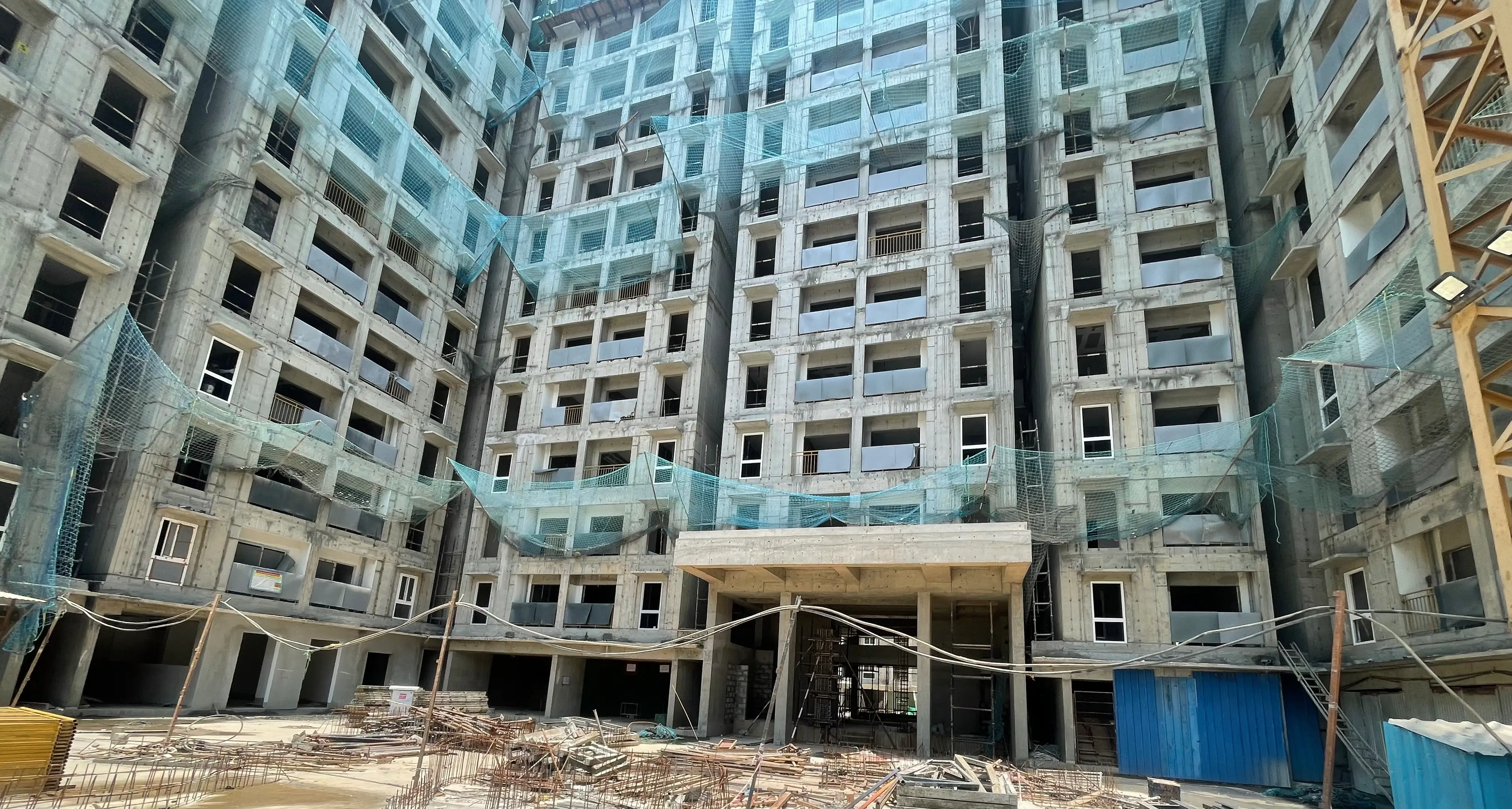

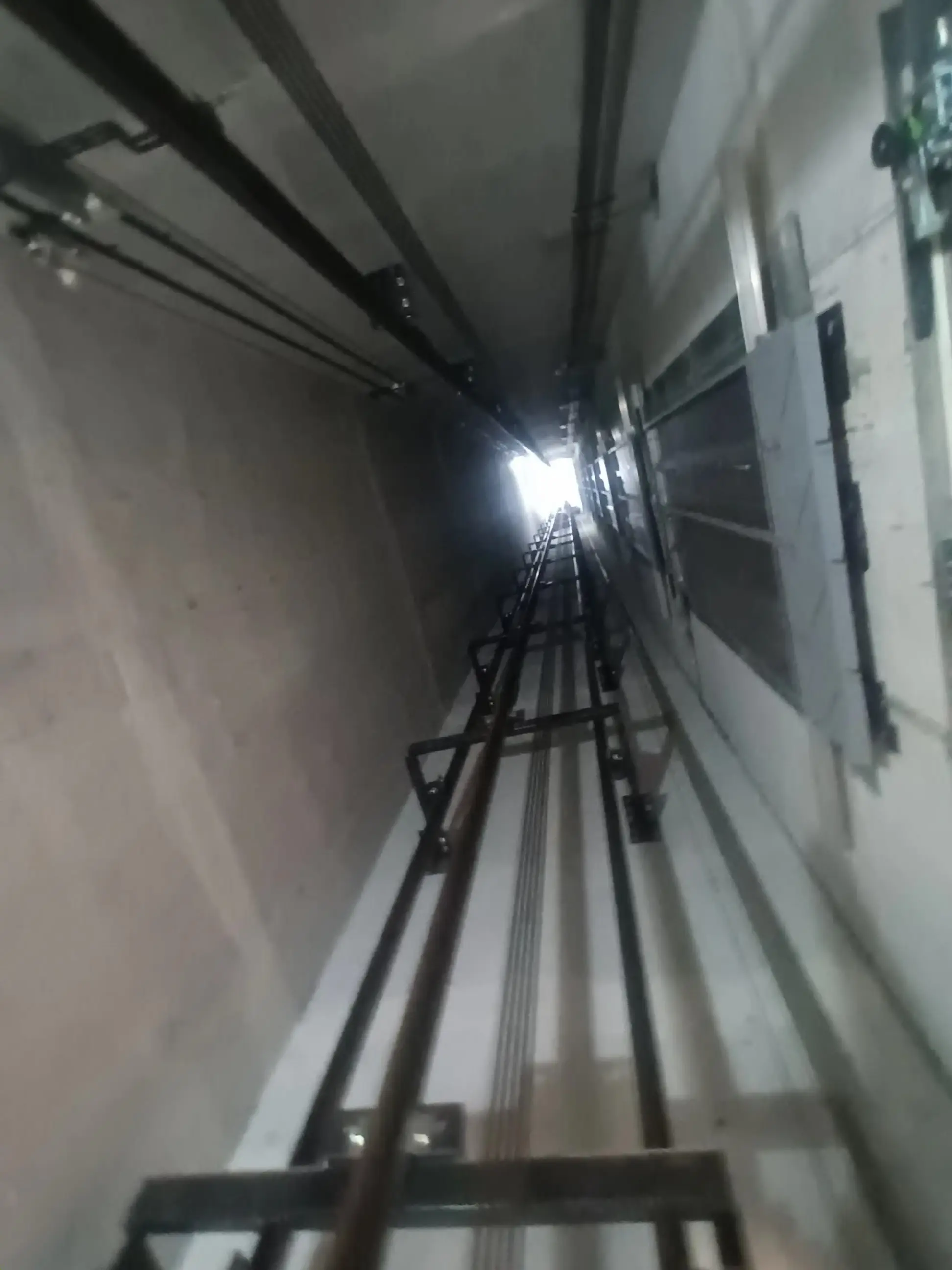

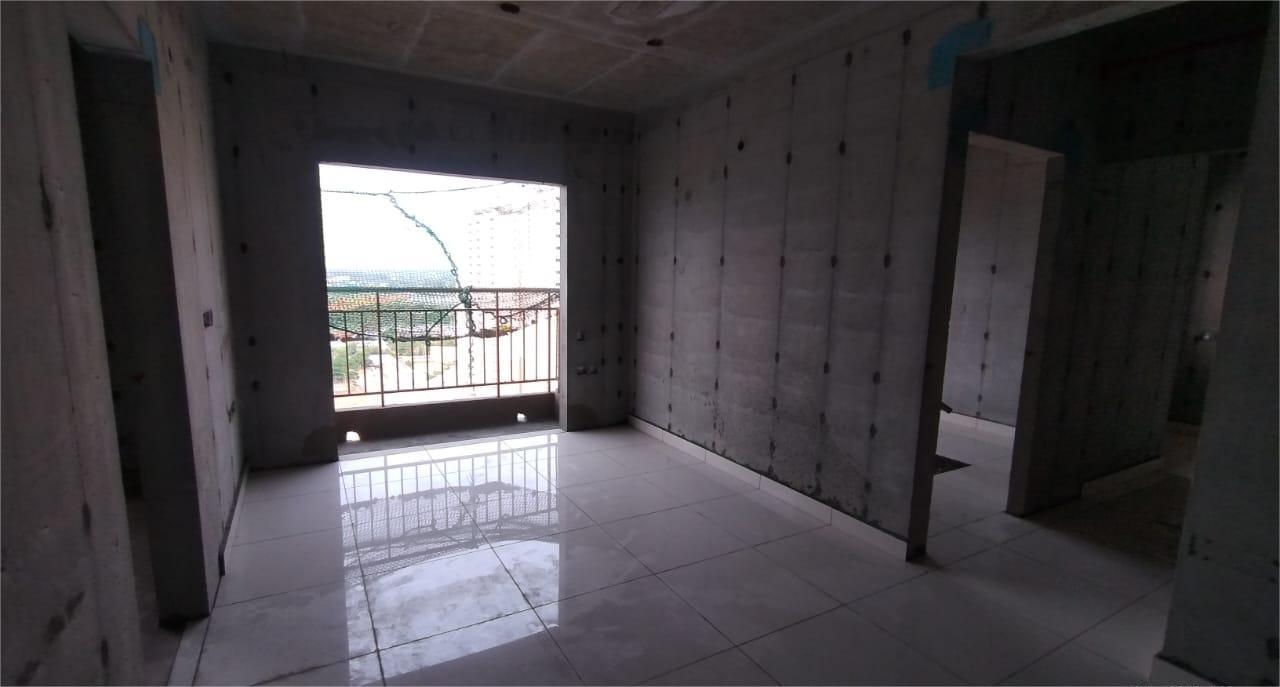

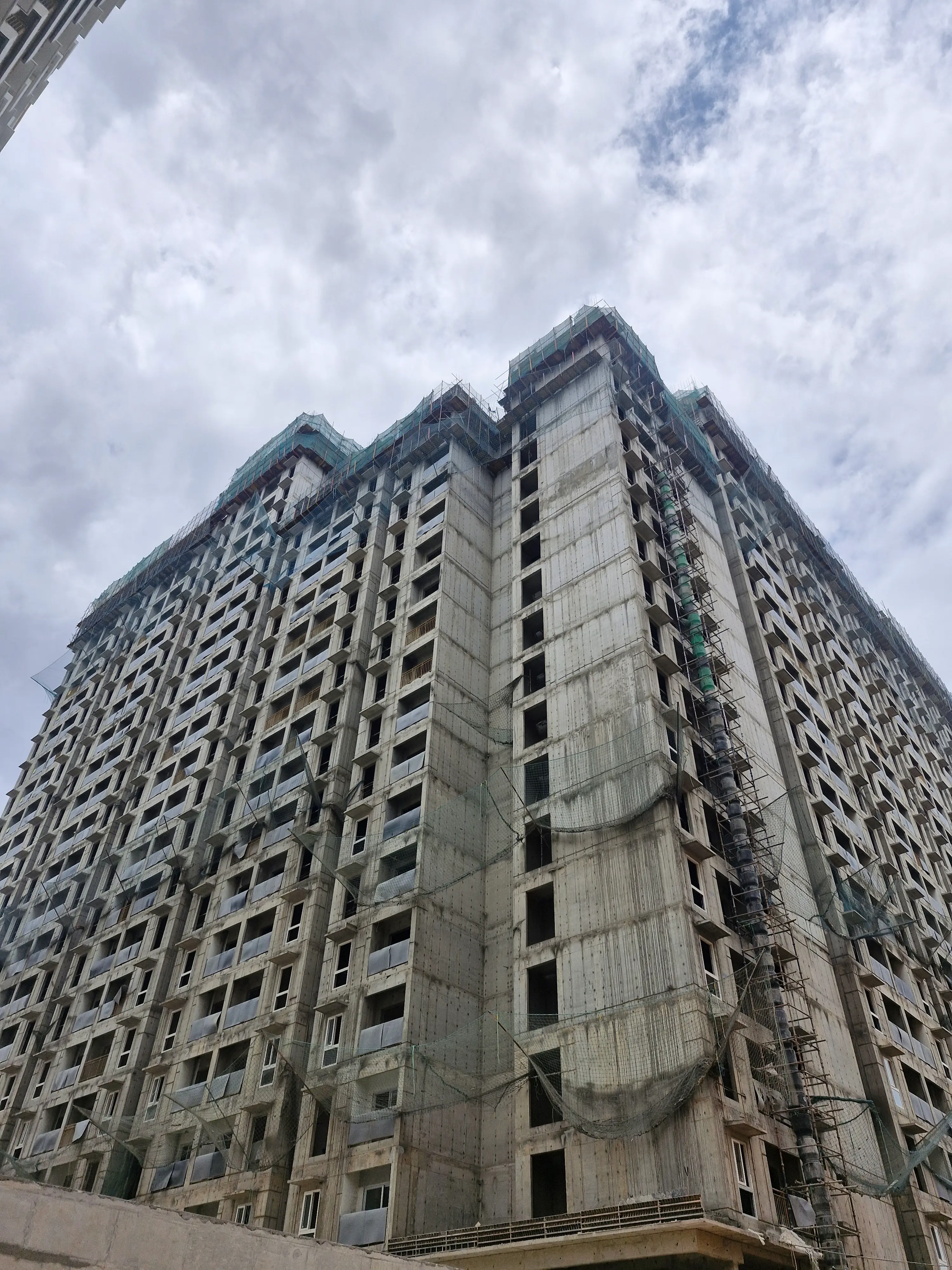

Dioro – Wing B – Milestone Release –“On commencement of fixing of windows – GF to 6F” Status as on 18th - Jul 2025

Dioro – Wing B – Milestone Release –“On commencement of fixing of windows – GF to 6F” Status as on 18th - Jul 2025

Dioro – Wing B – Milestone Release –“On commencement of fixing of windows – GF to 6F” Status as on 18th - Jul 2025

Dioro – Wing B – Milestone Release –“On commencement of fixing of windows – GF to 6F” Status as on 18th - Jul 2025

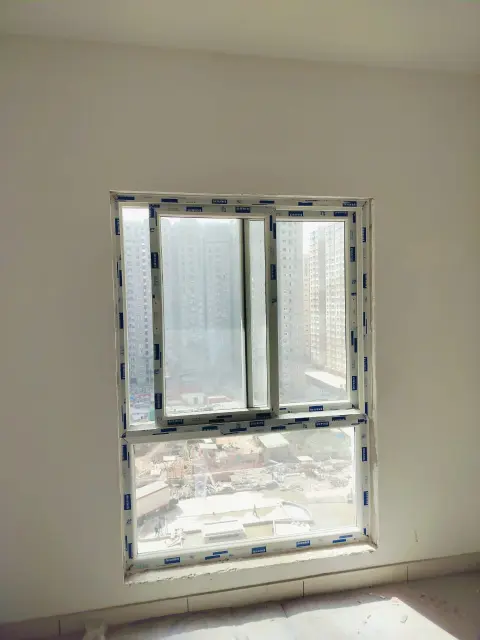

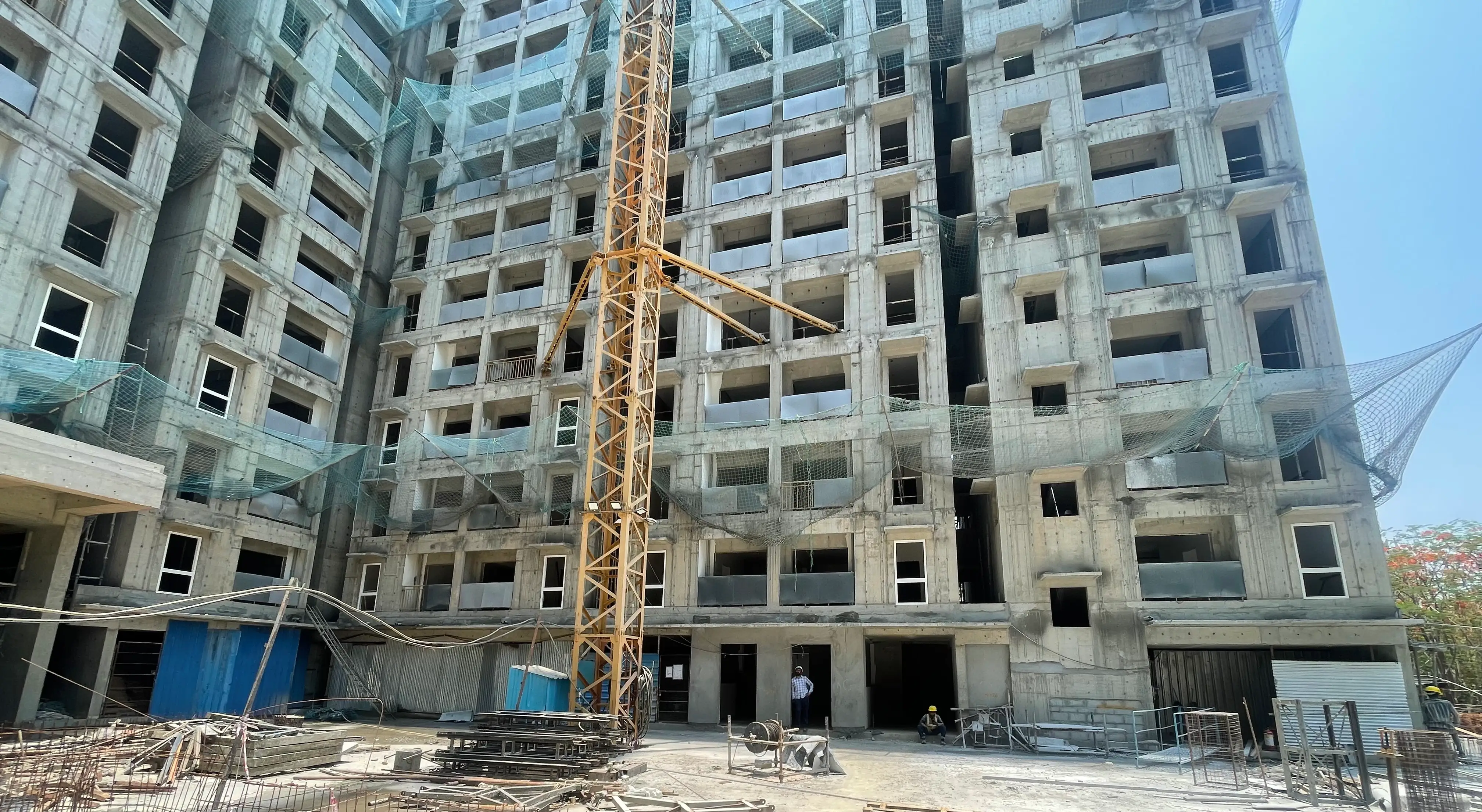

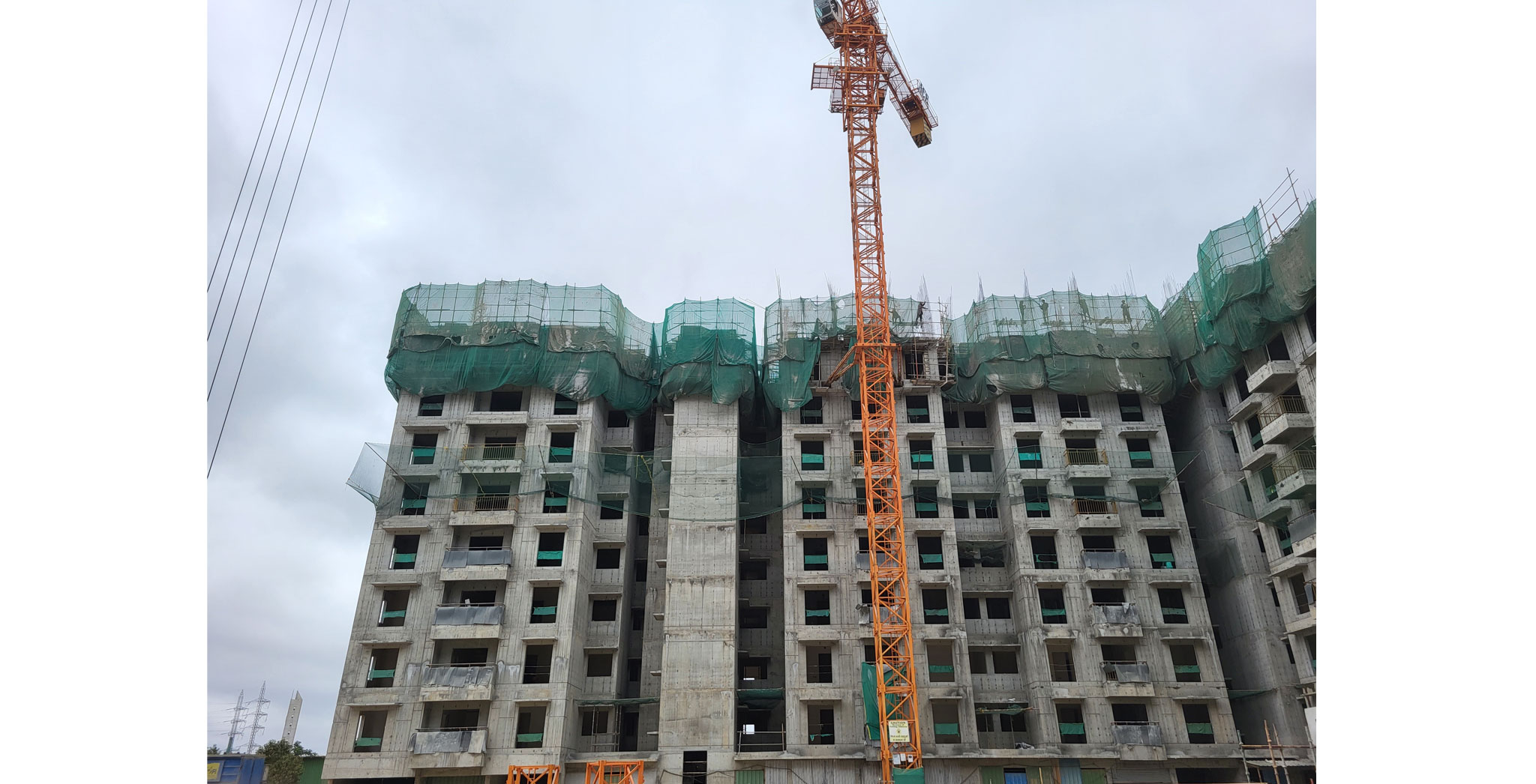

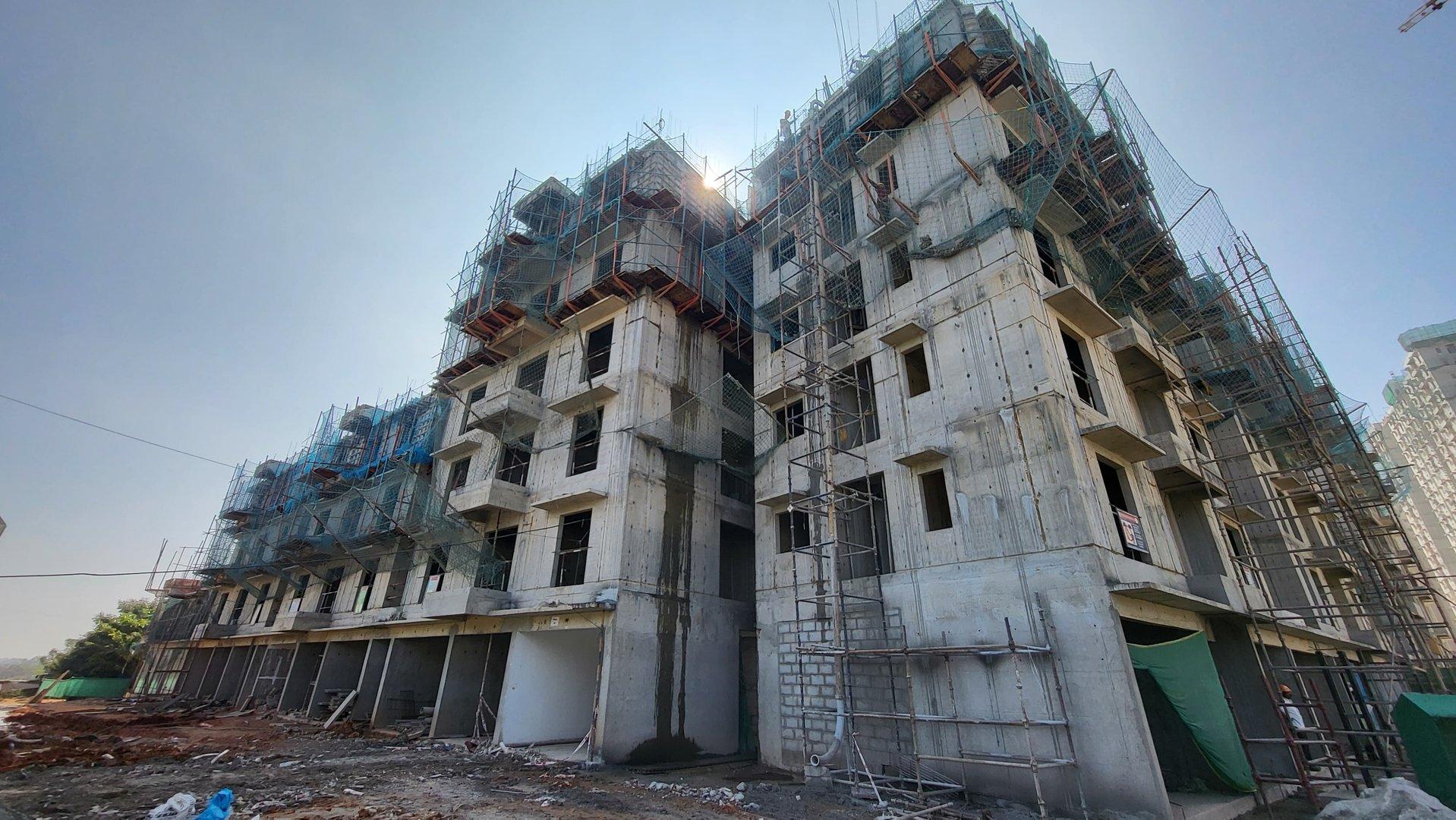

AURUM -Wing A – Milestone Release –“ On Commencement Installation of Lift” – Status as on 14th - Jul 2025

AURUM -Wing A – Milestone Release –“ On Commencement Installation of Lift” – Status as on 14th - Jul 2025

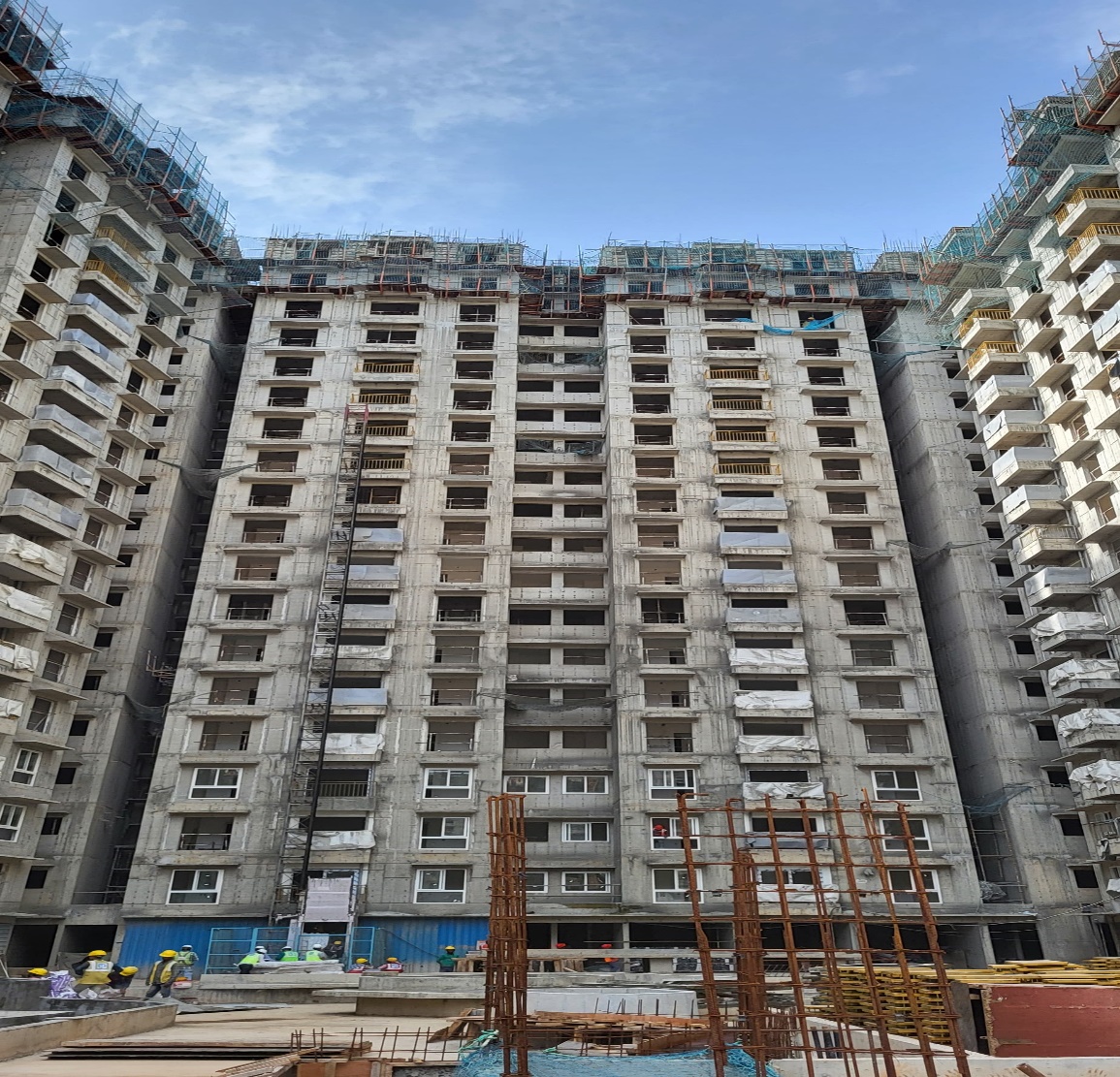

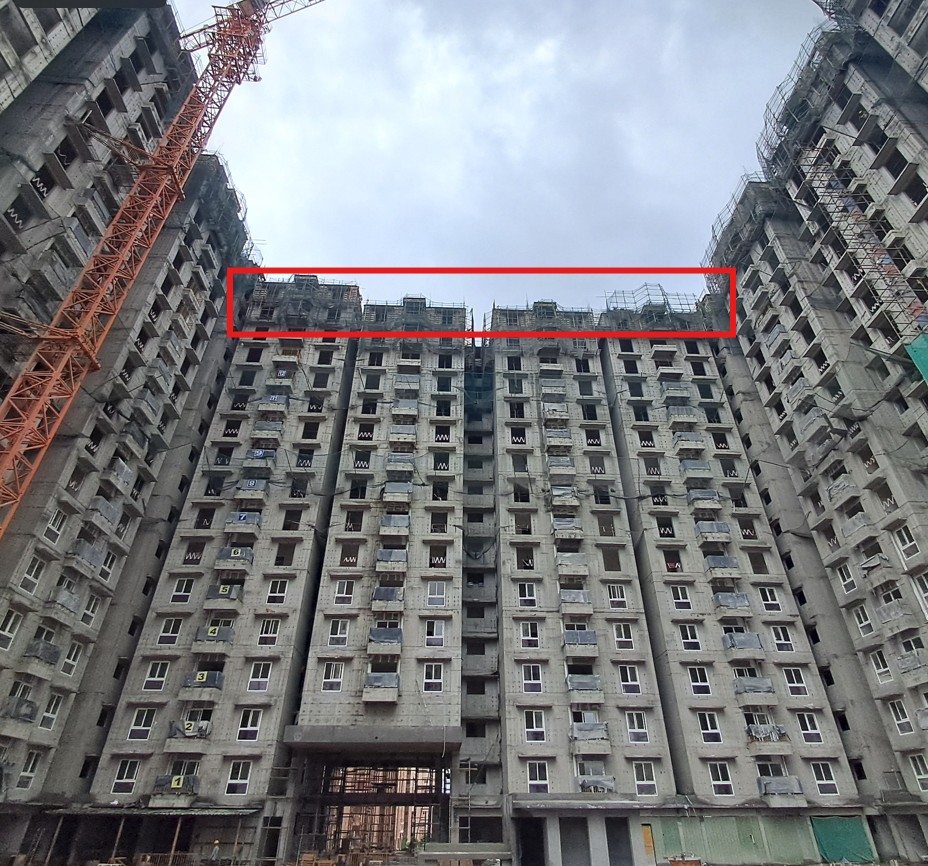

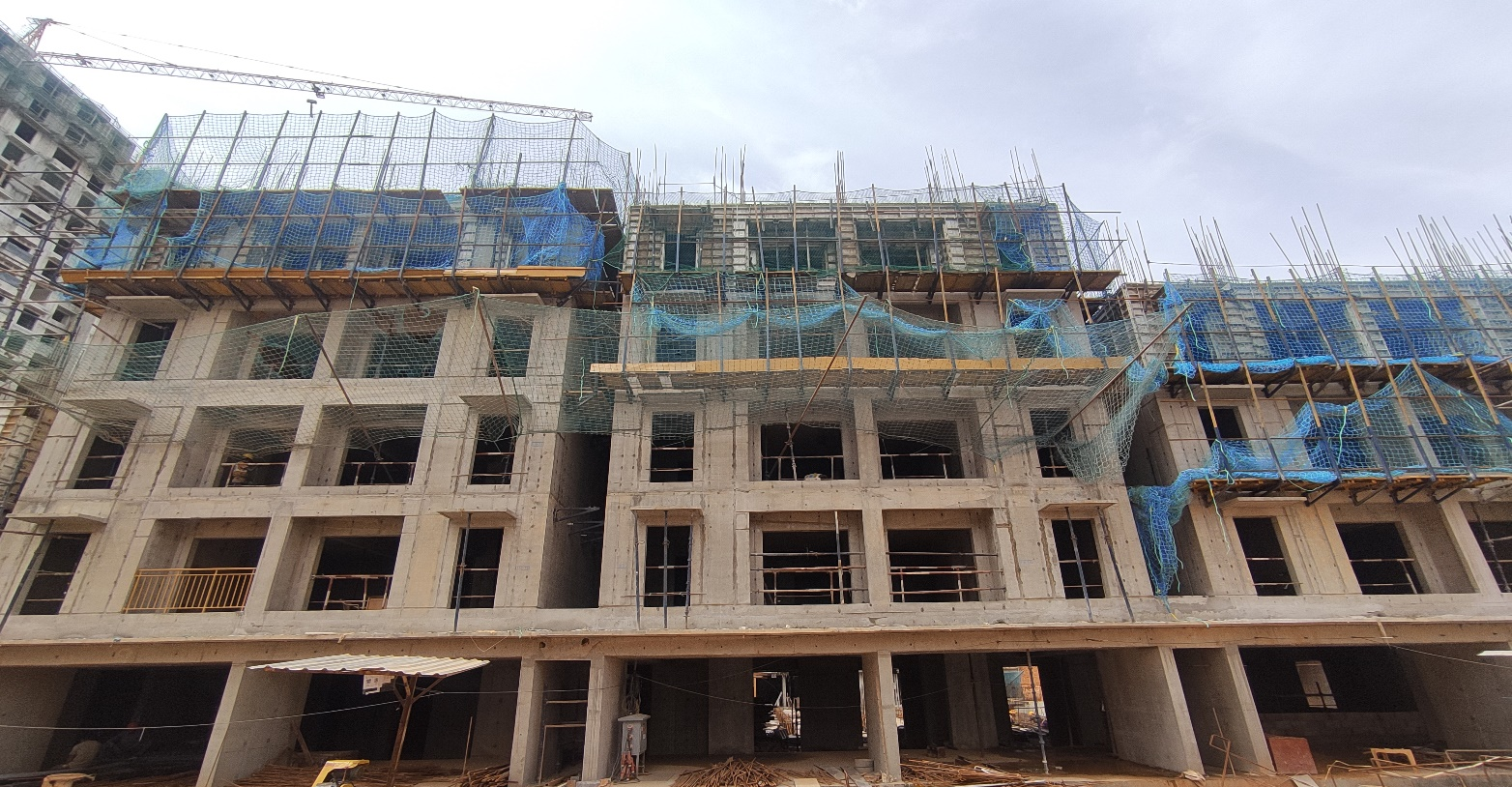

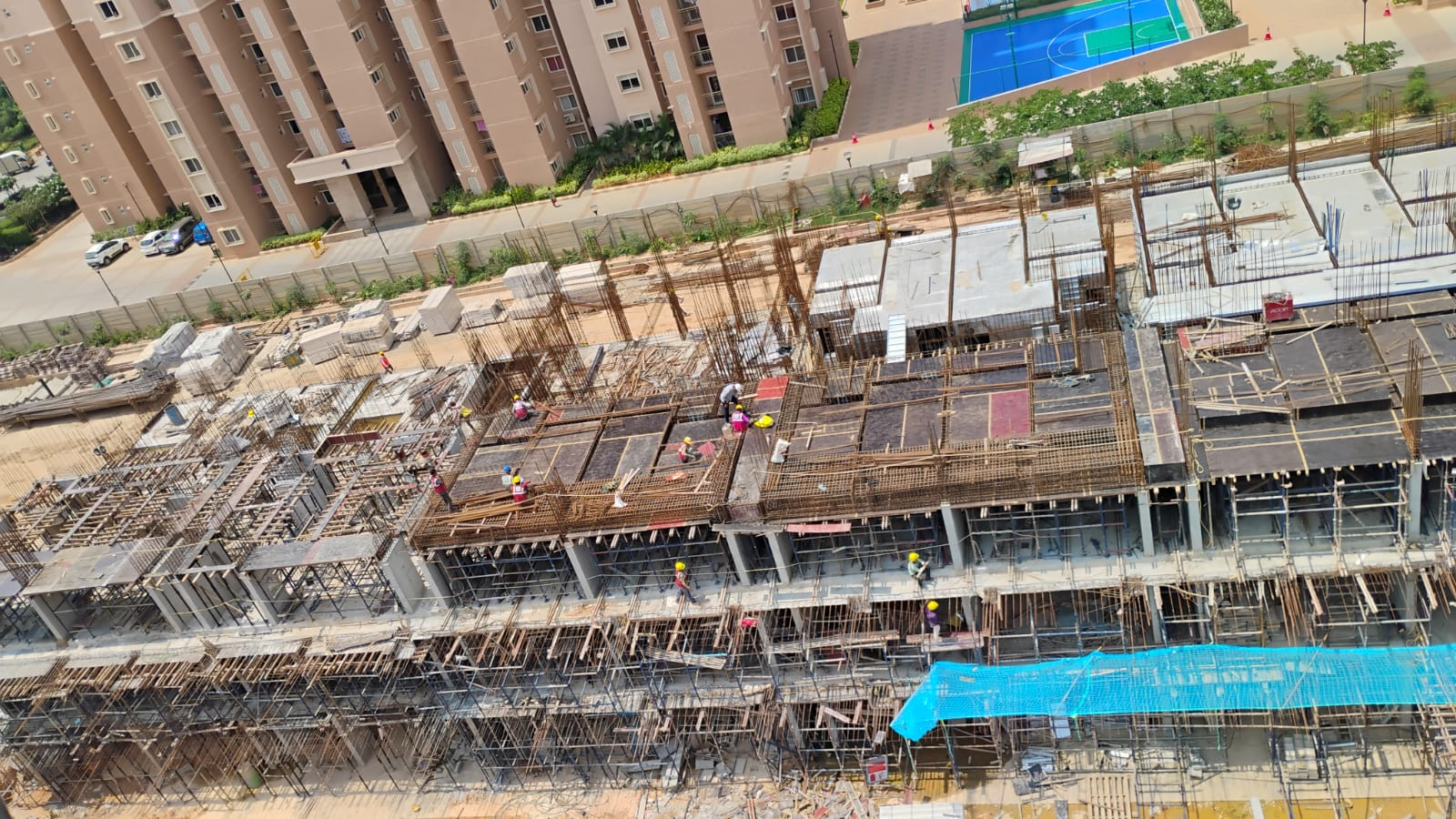

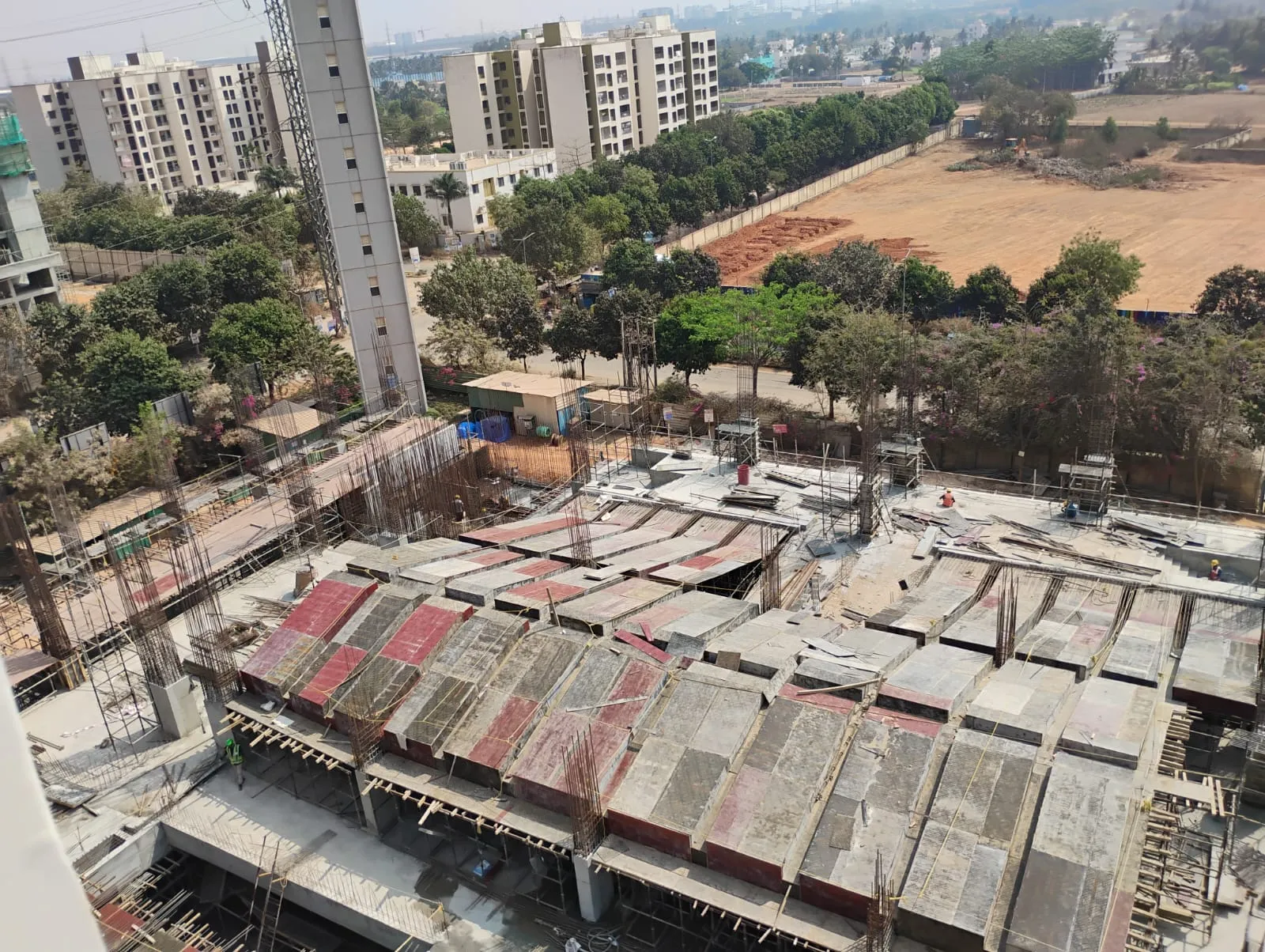

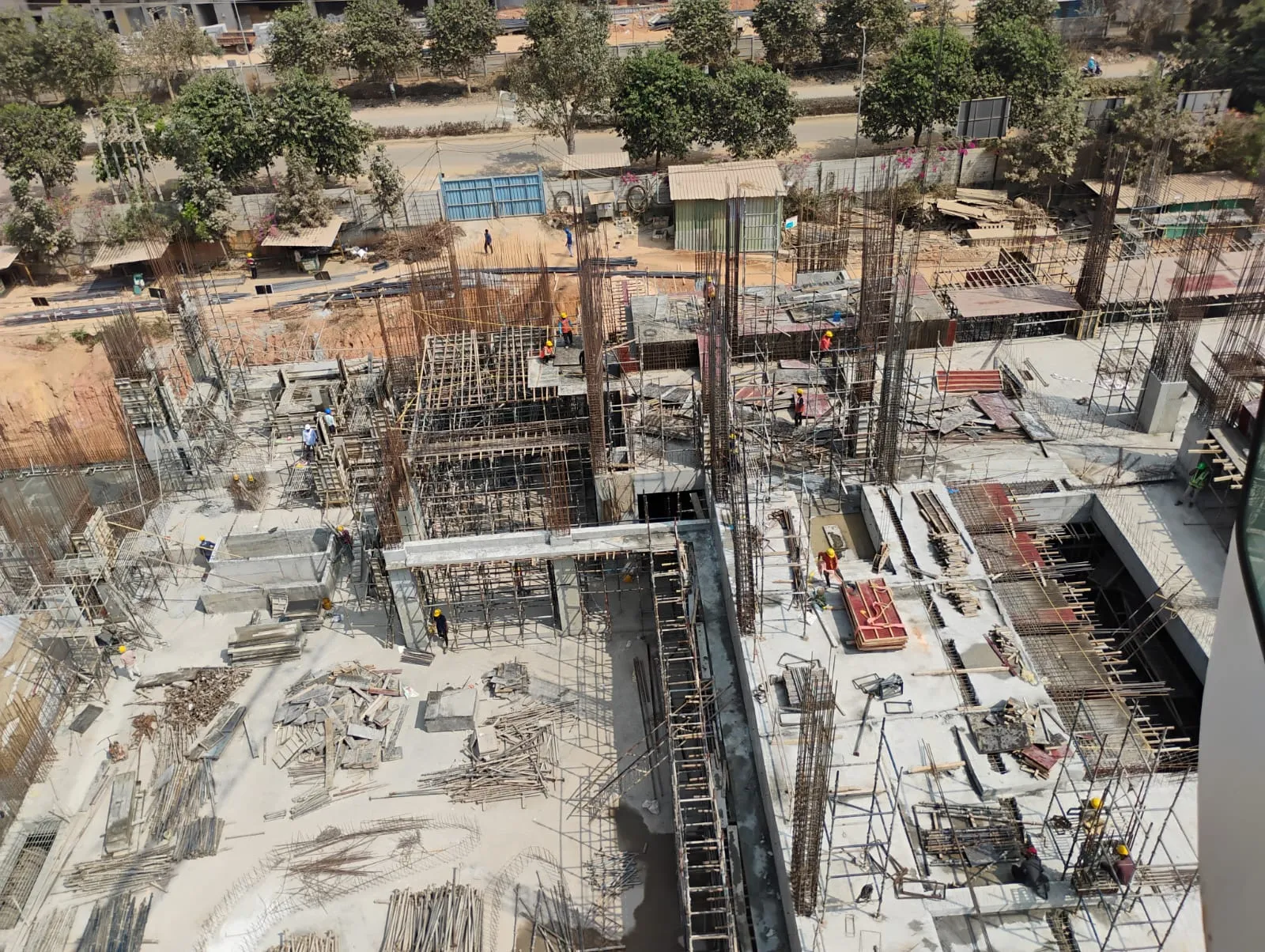

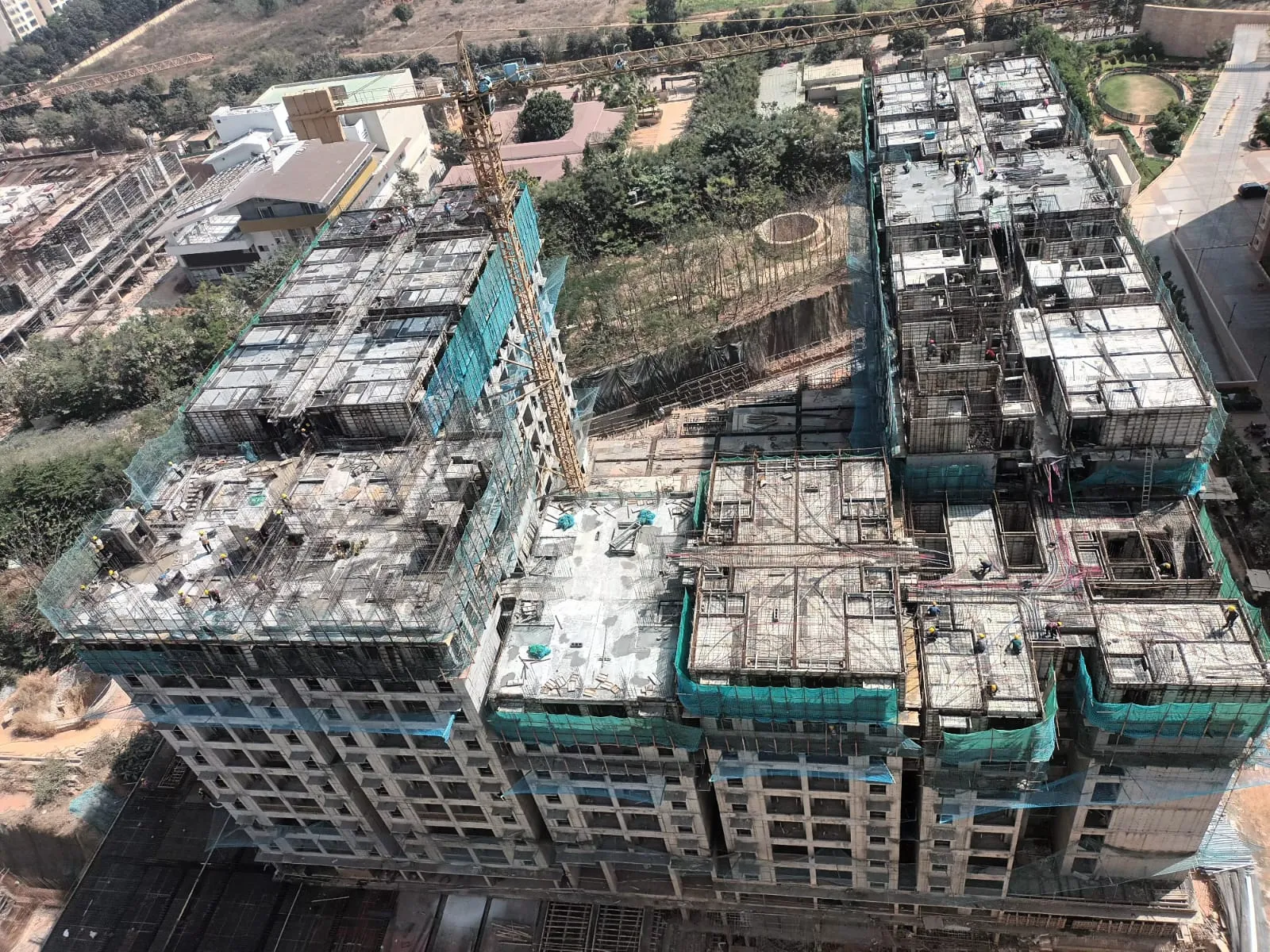

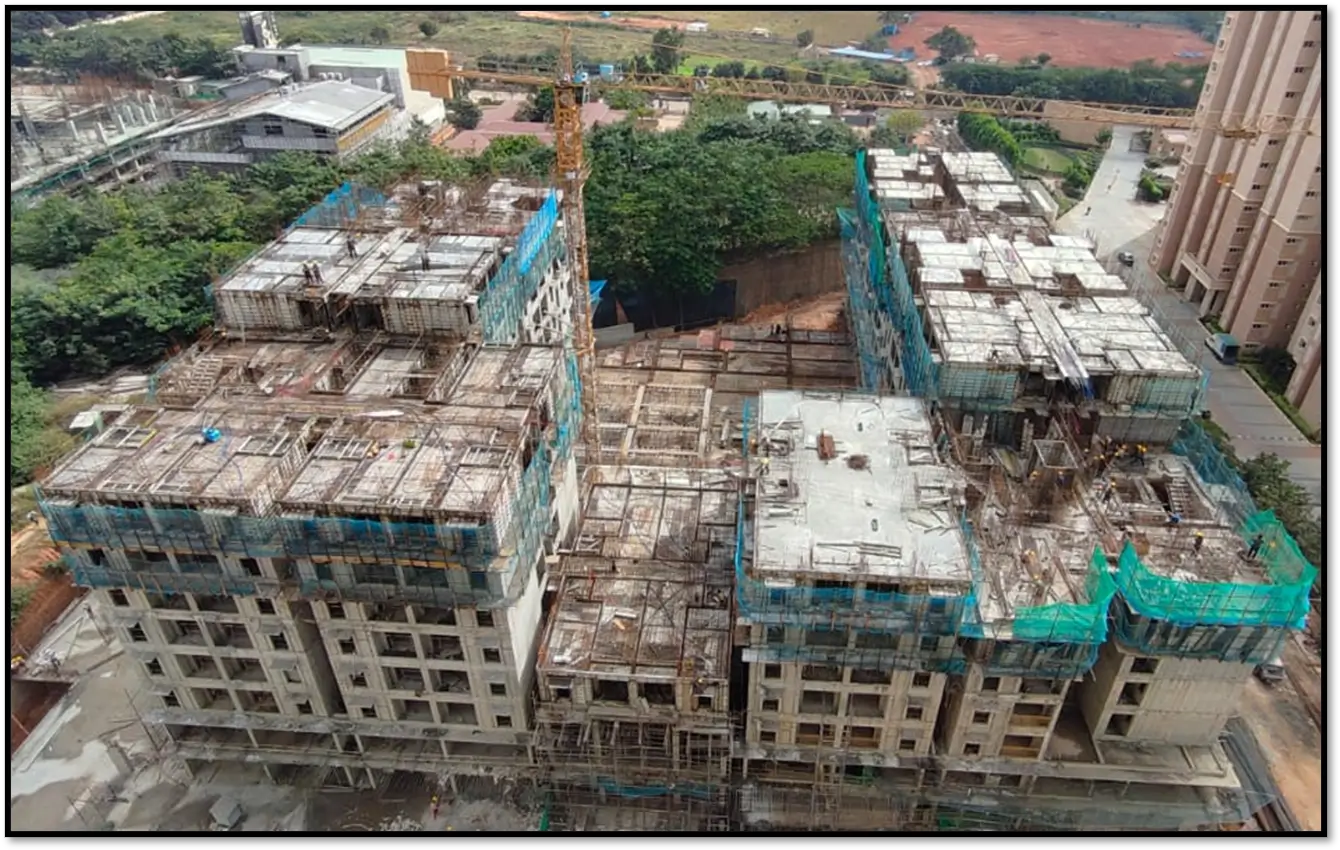

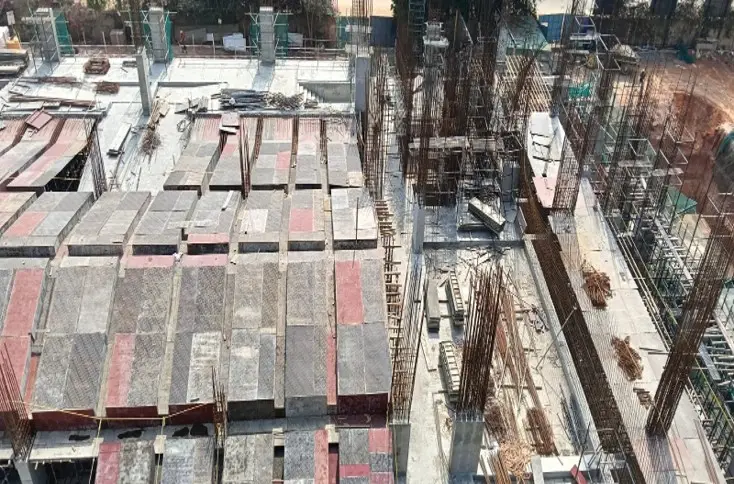

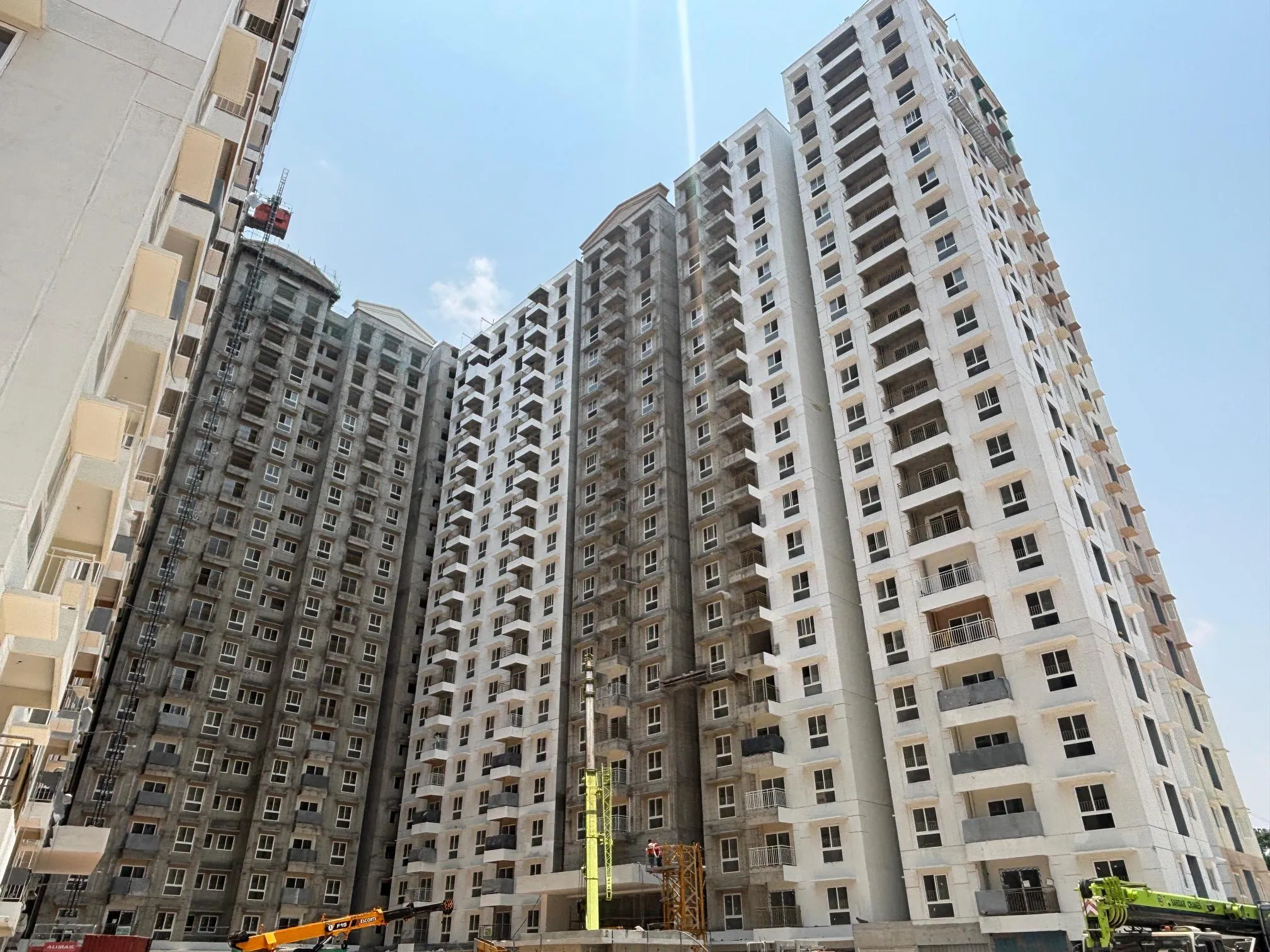

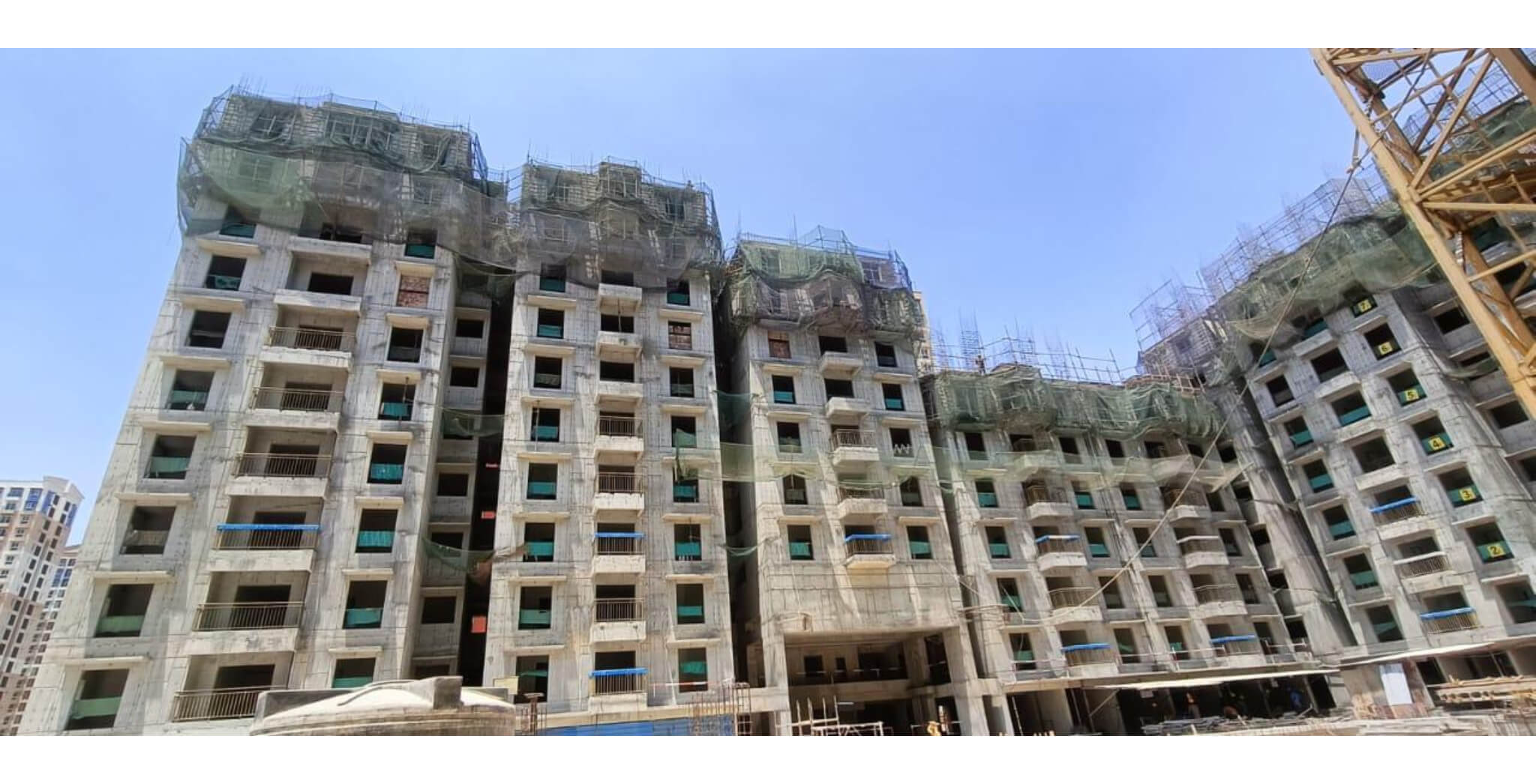

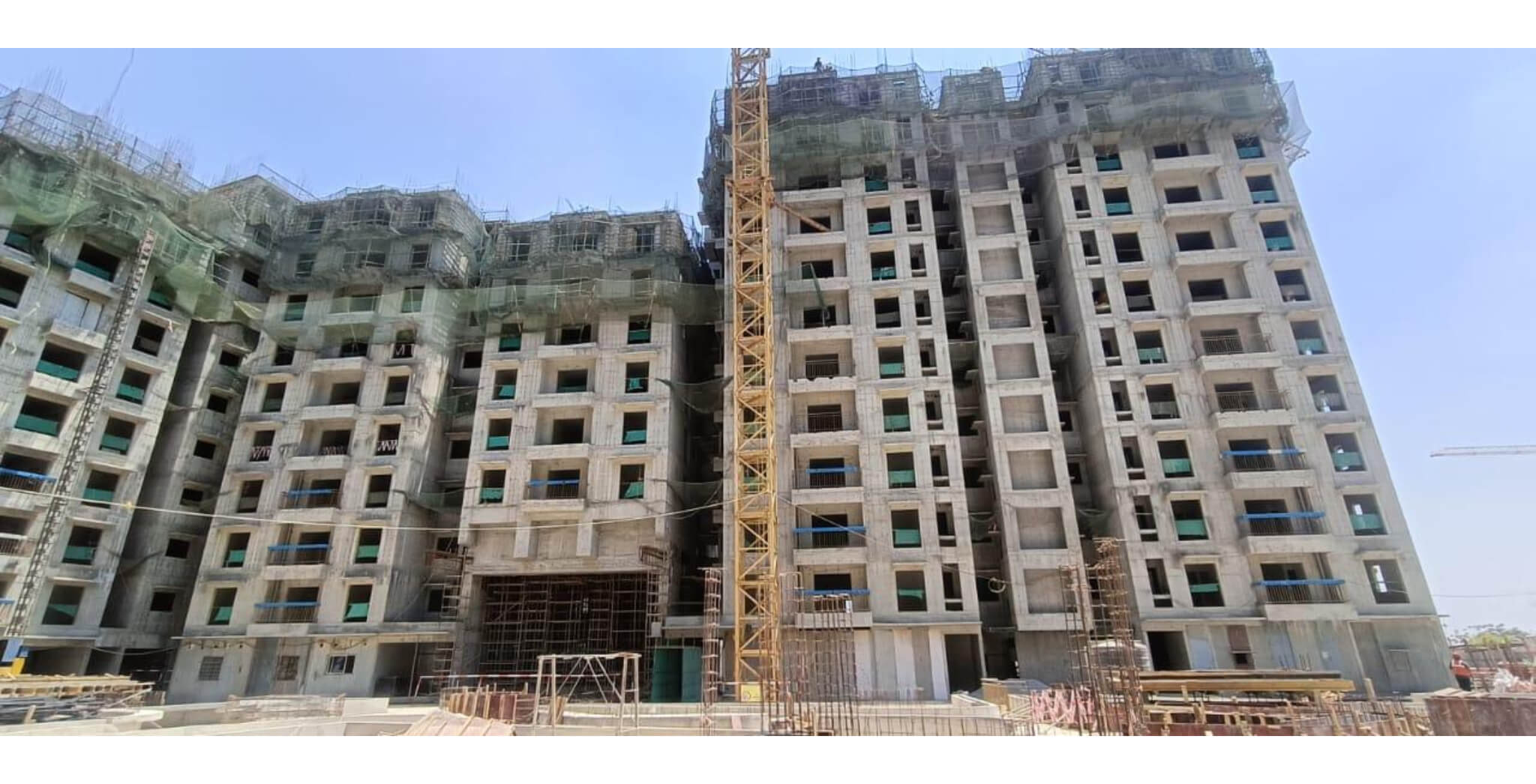

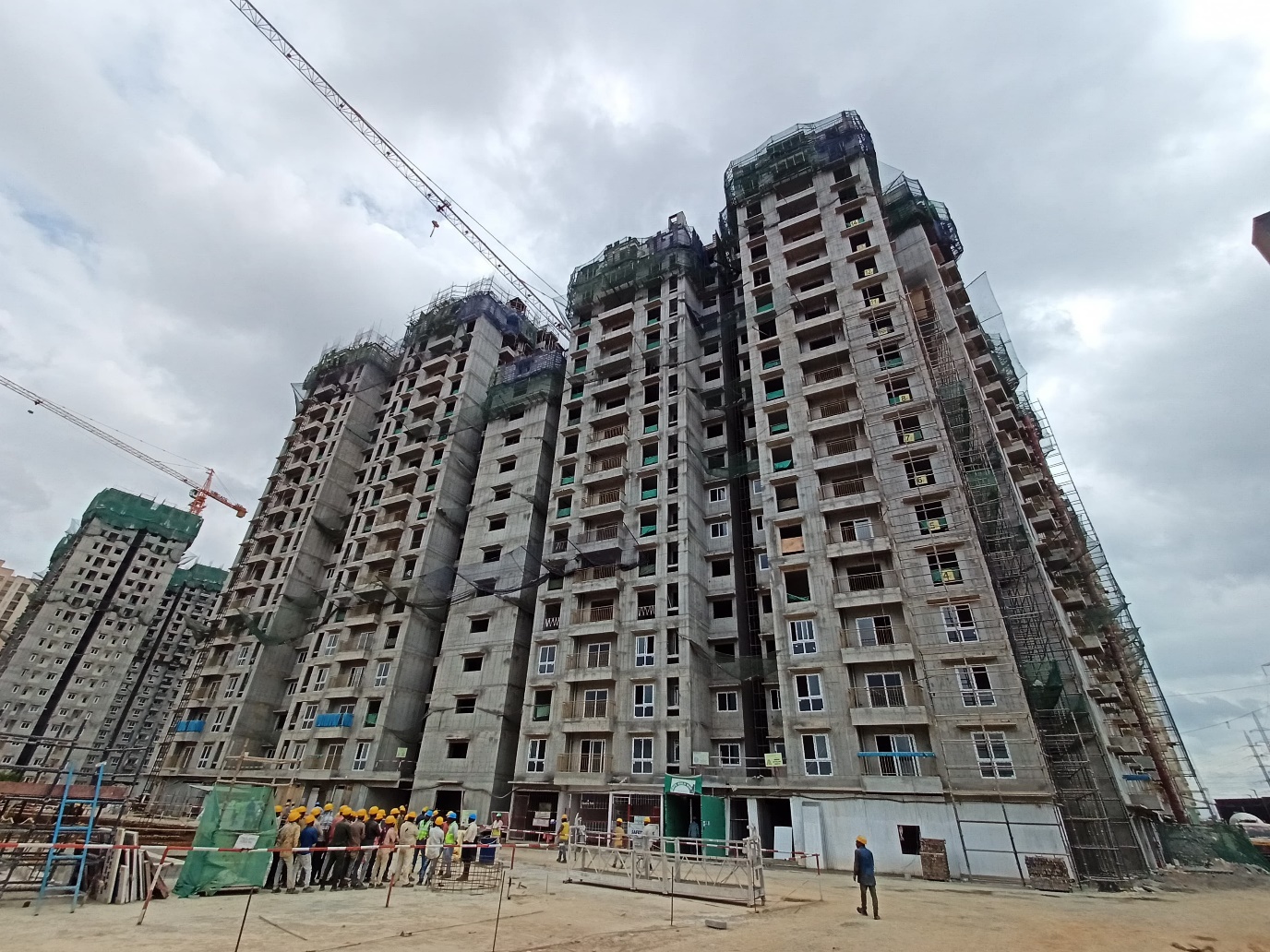

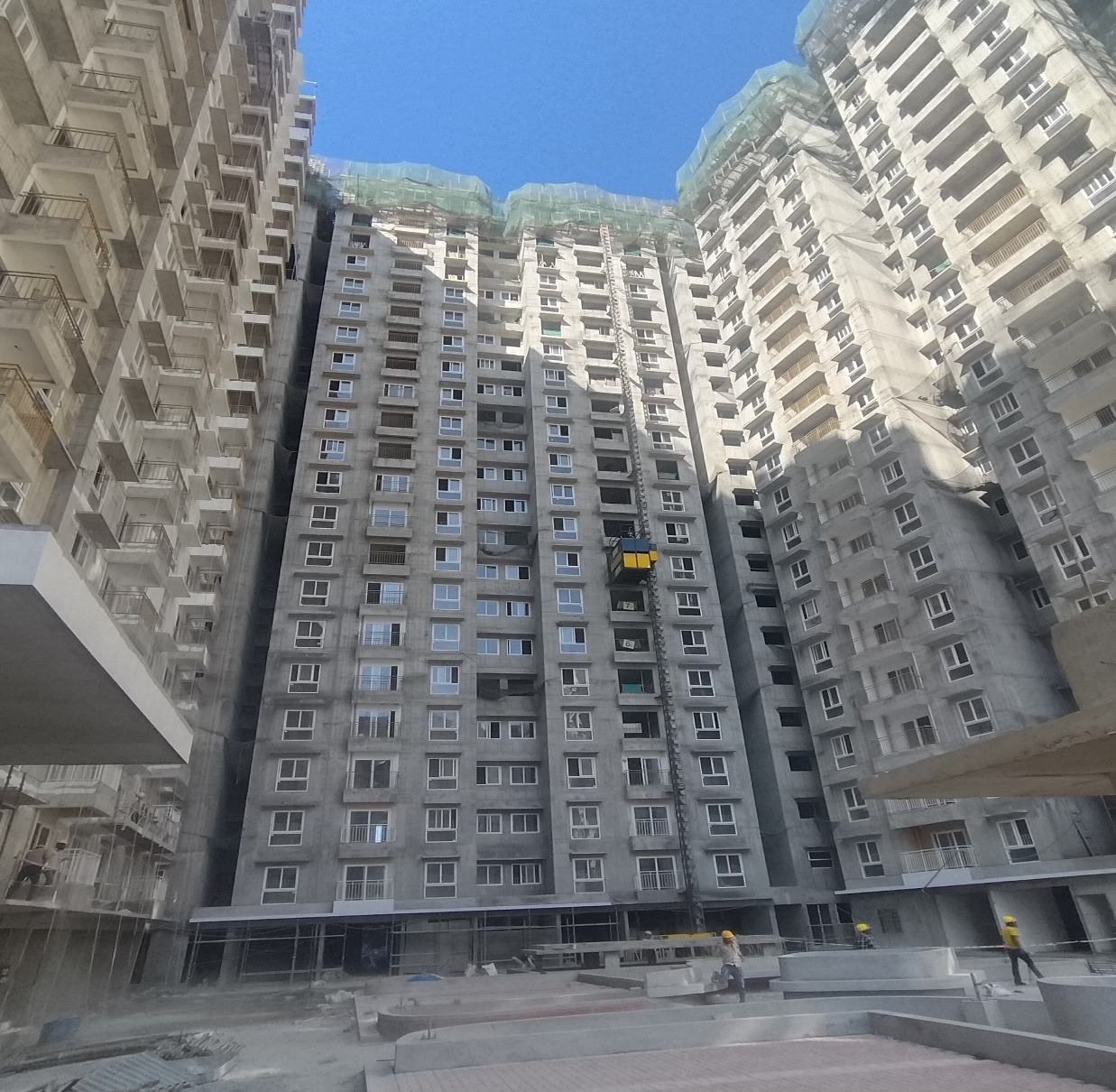

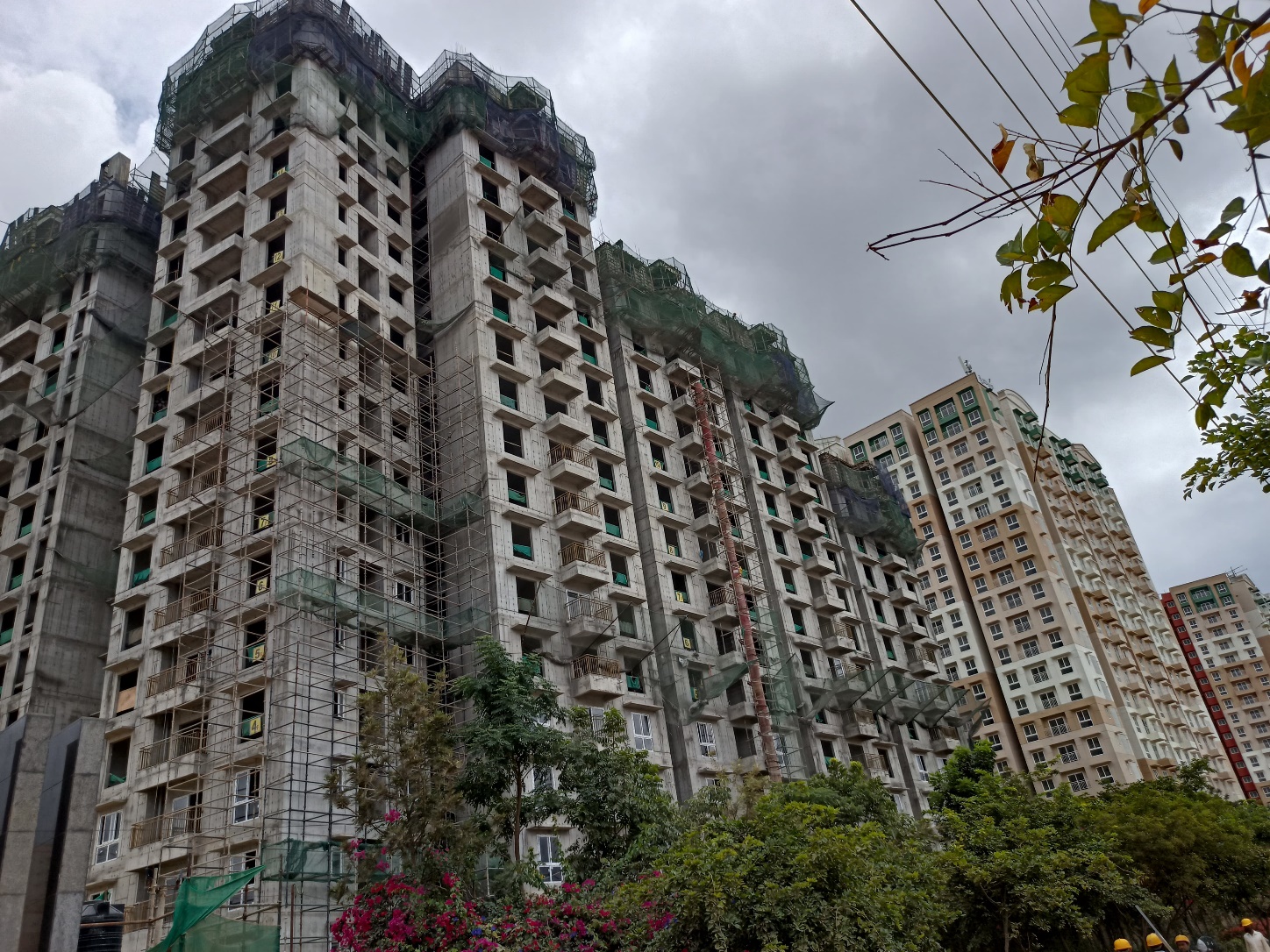

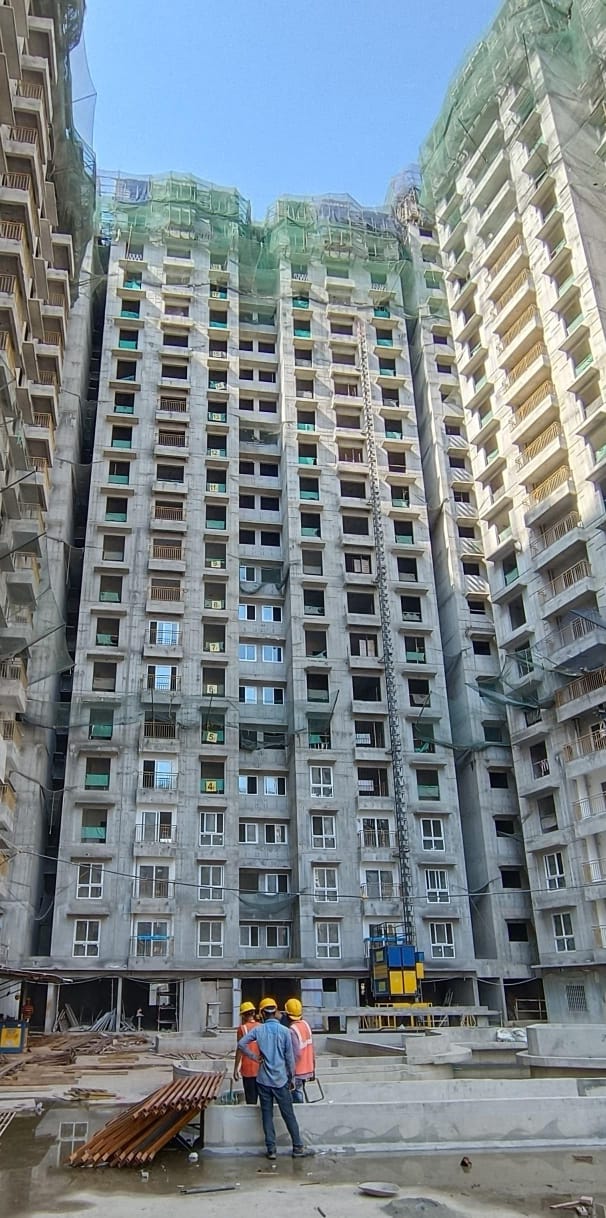

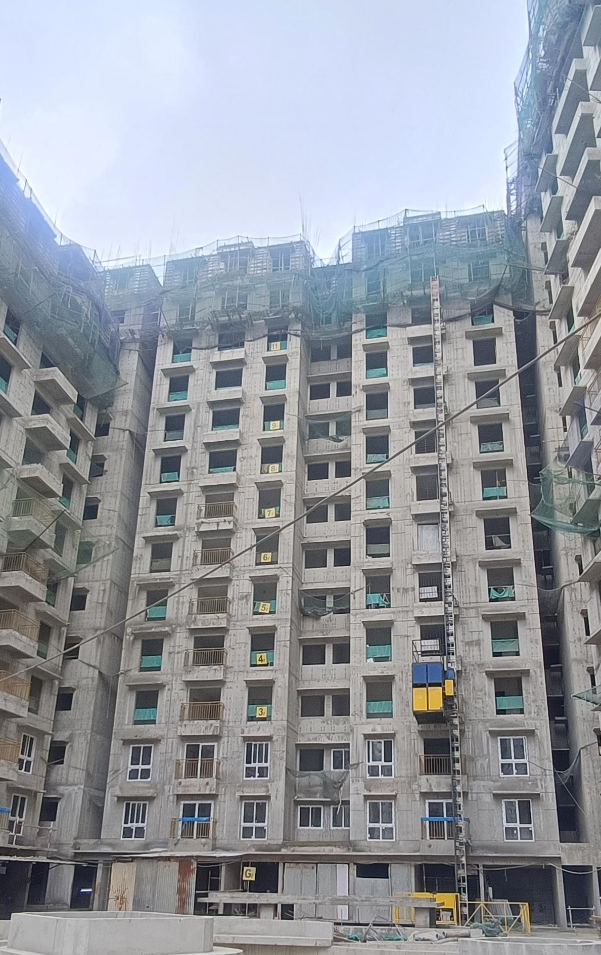

Wing B – Part of 18th floor slab concrete work in progress Part of 18th floor wall reinforcement work in progress - Jun 2025

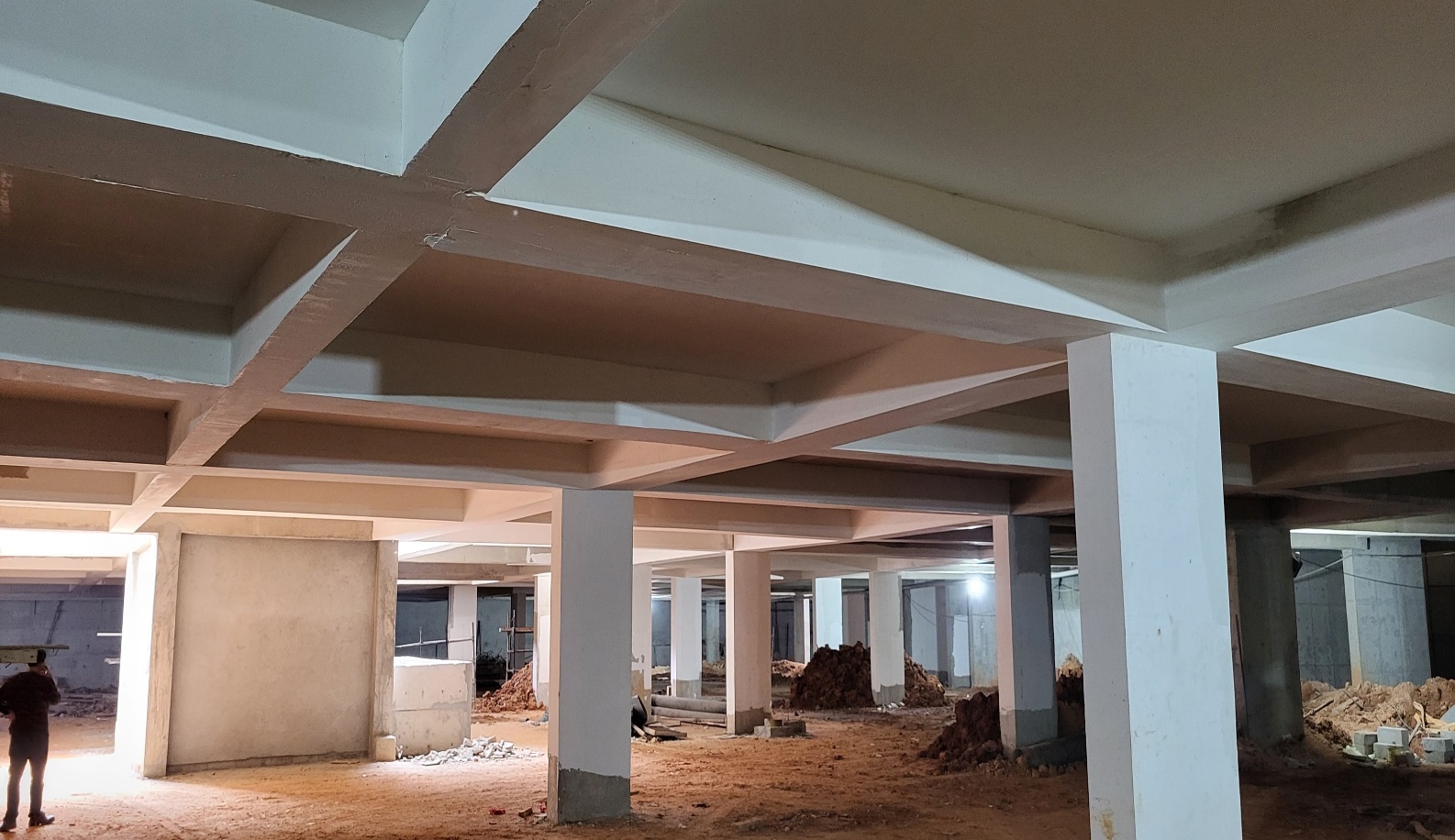

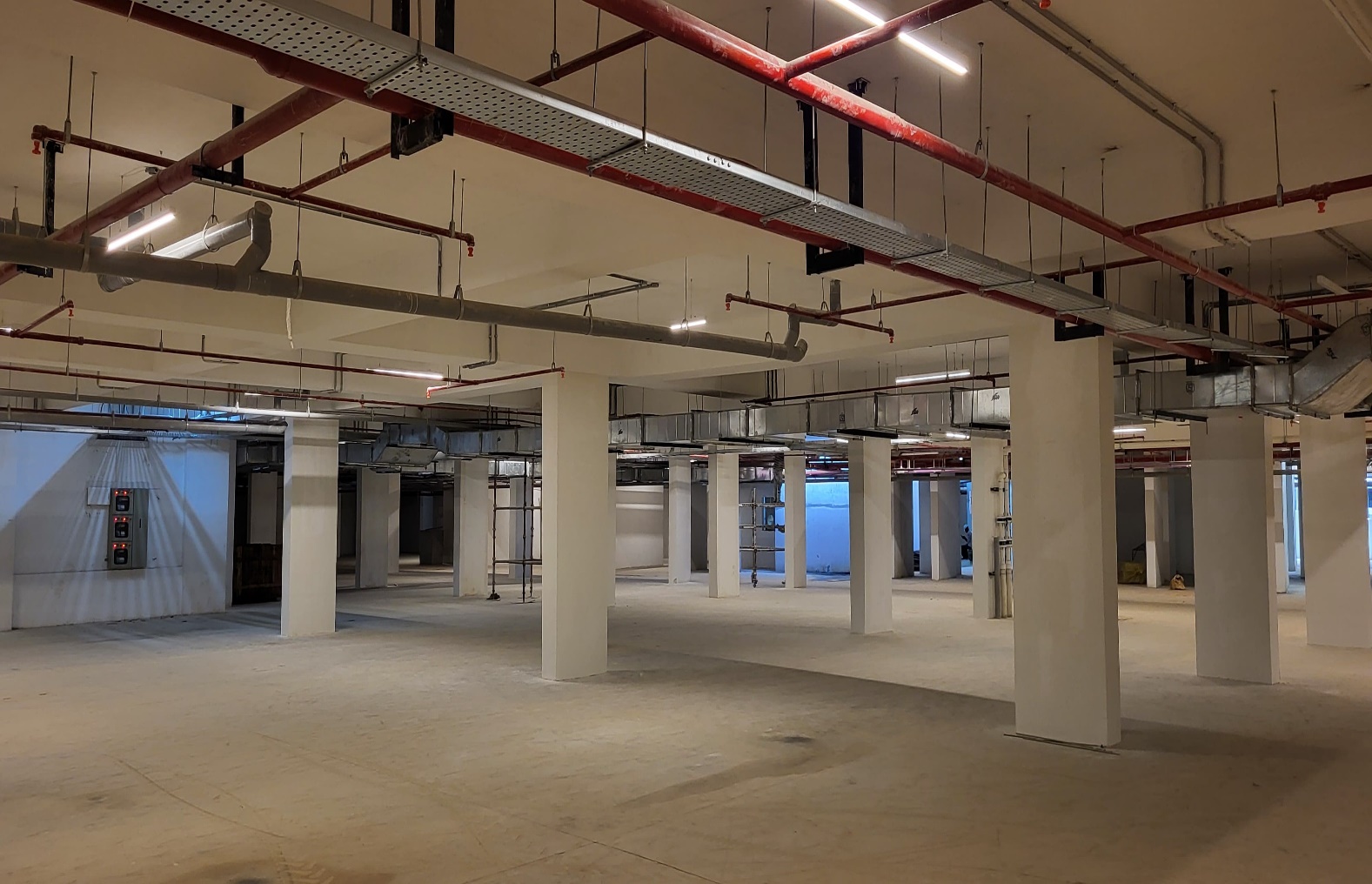

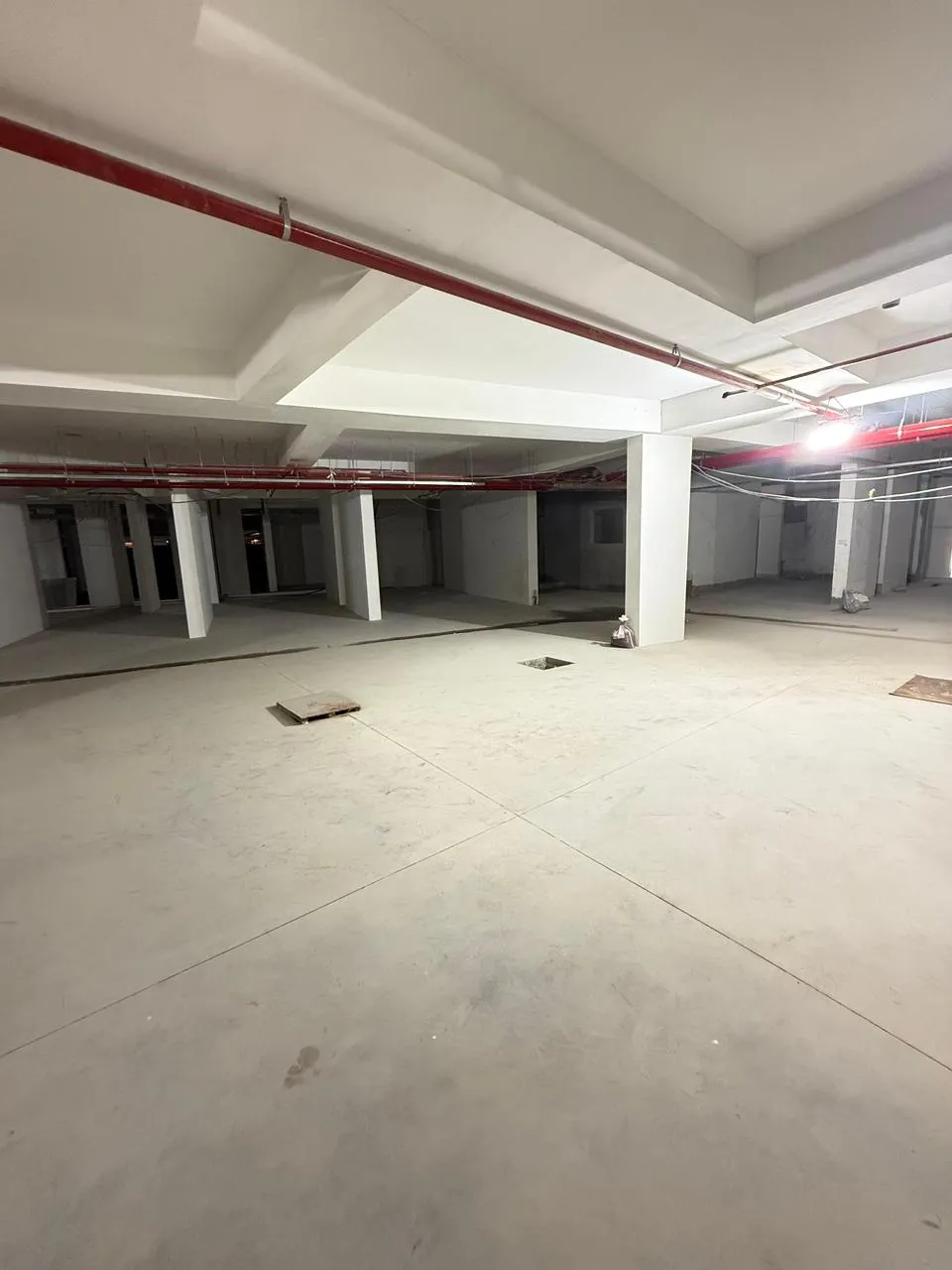

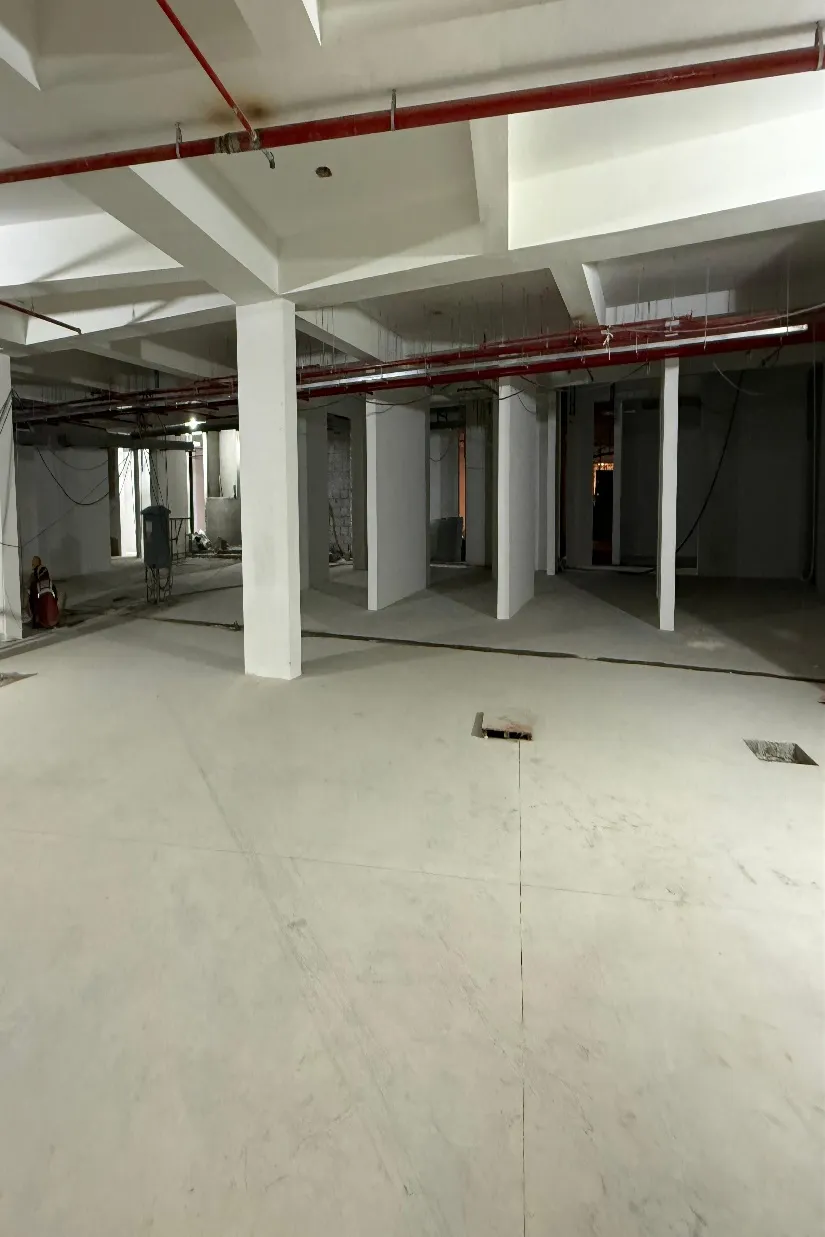

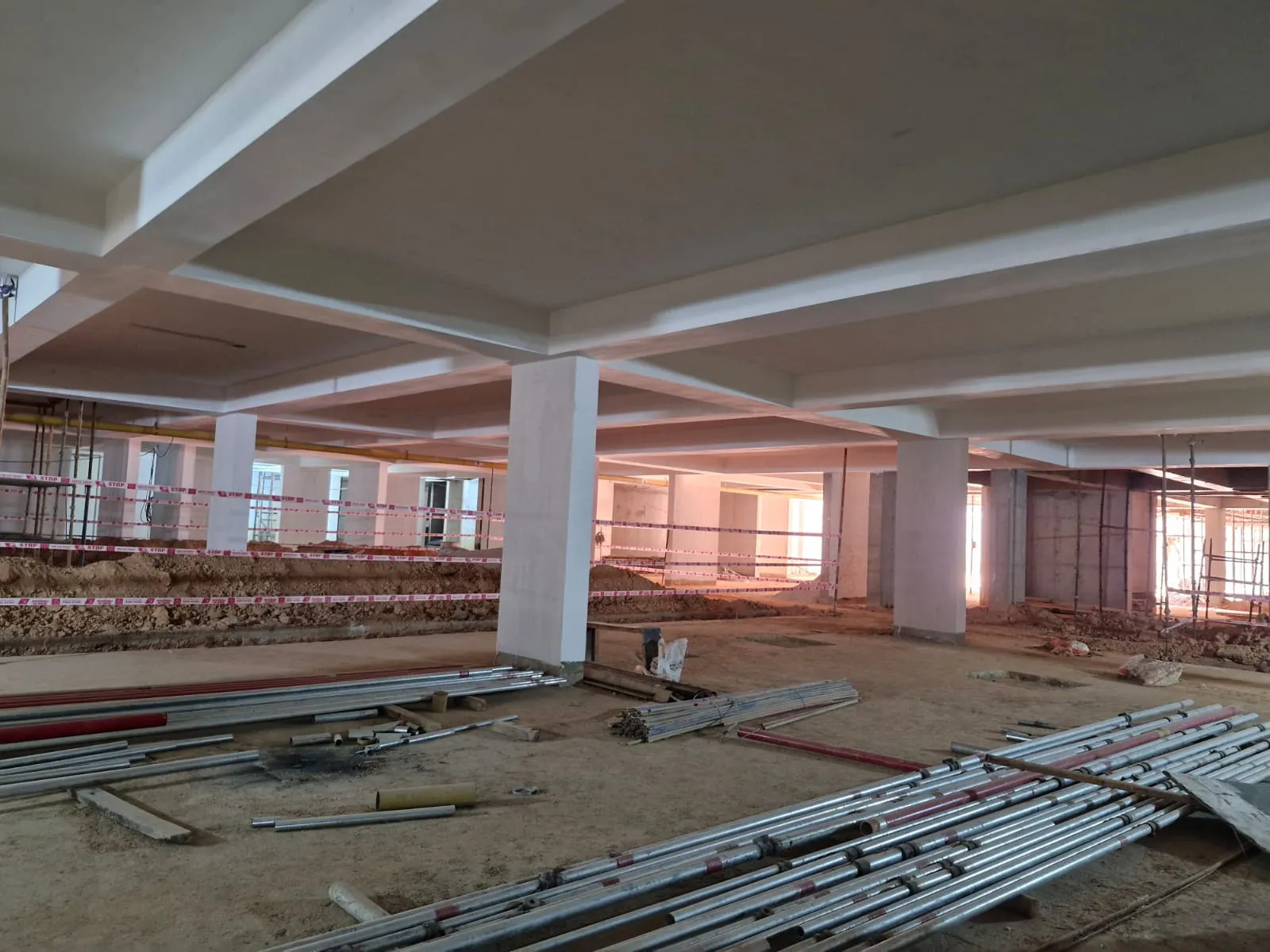

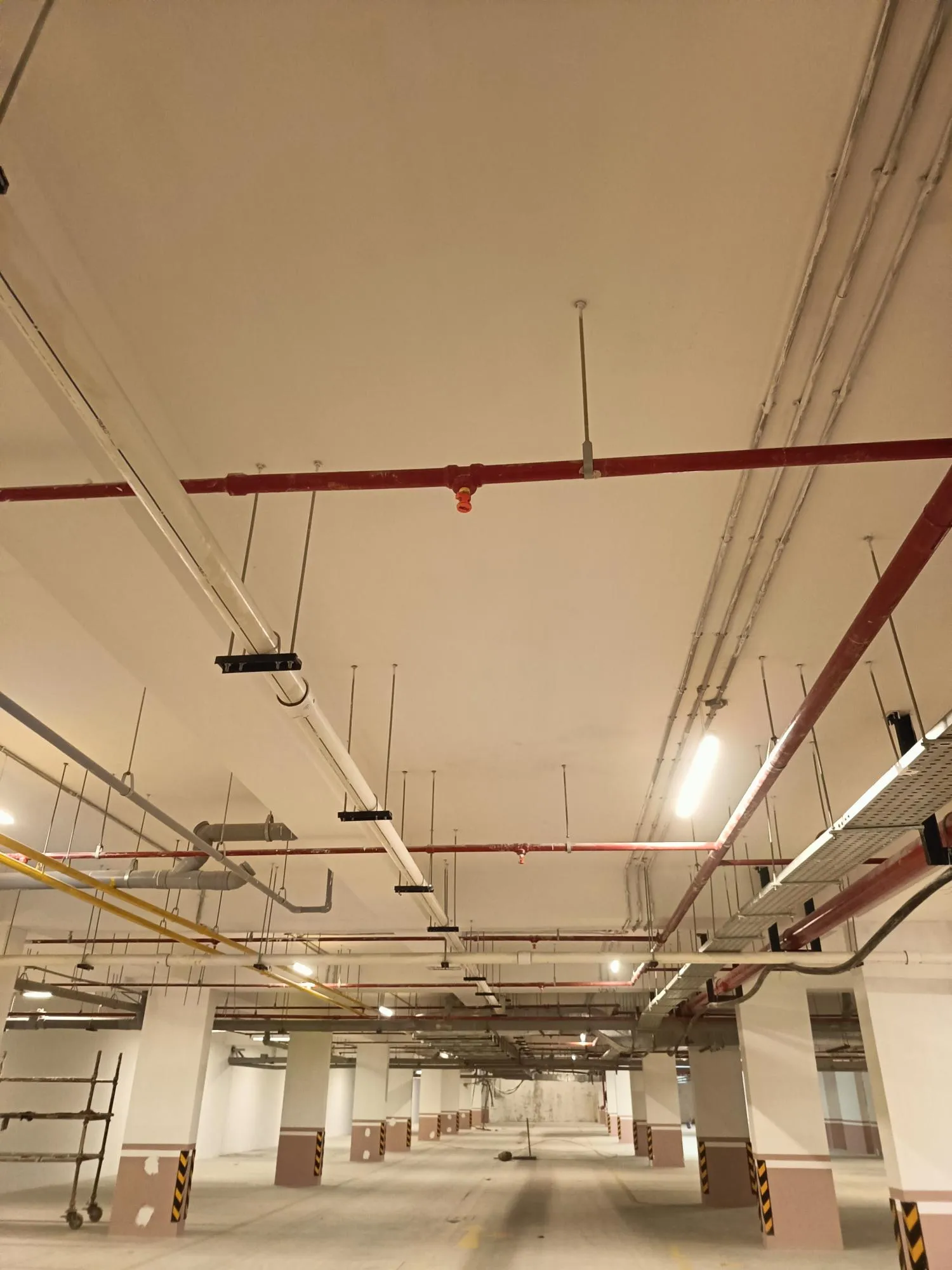

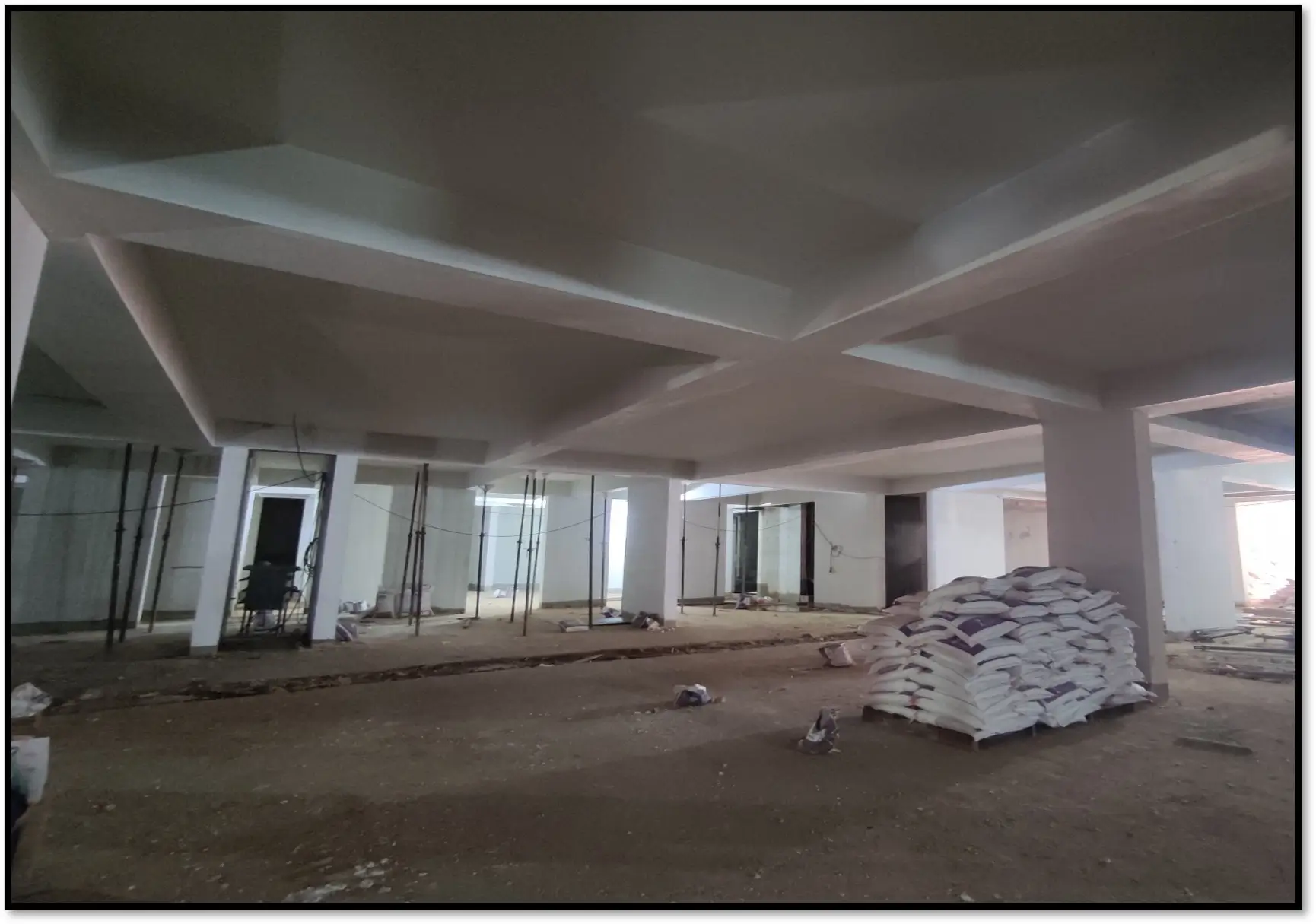

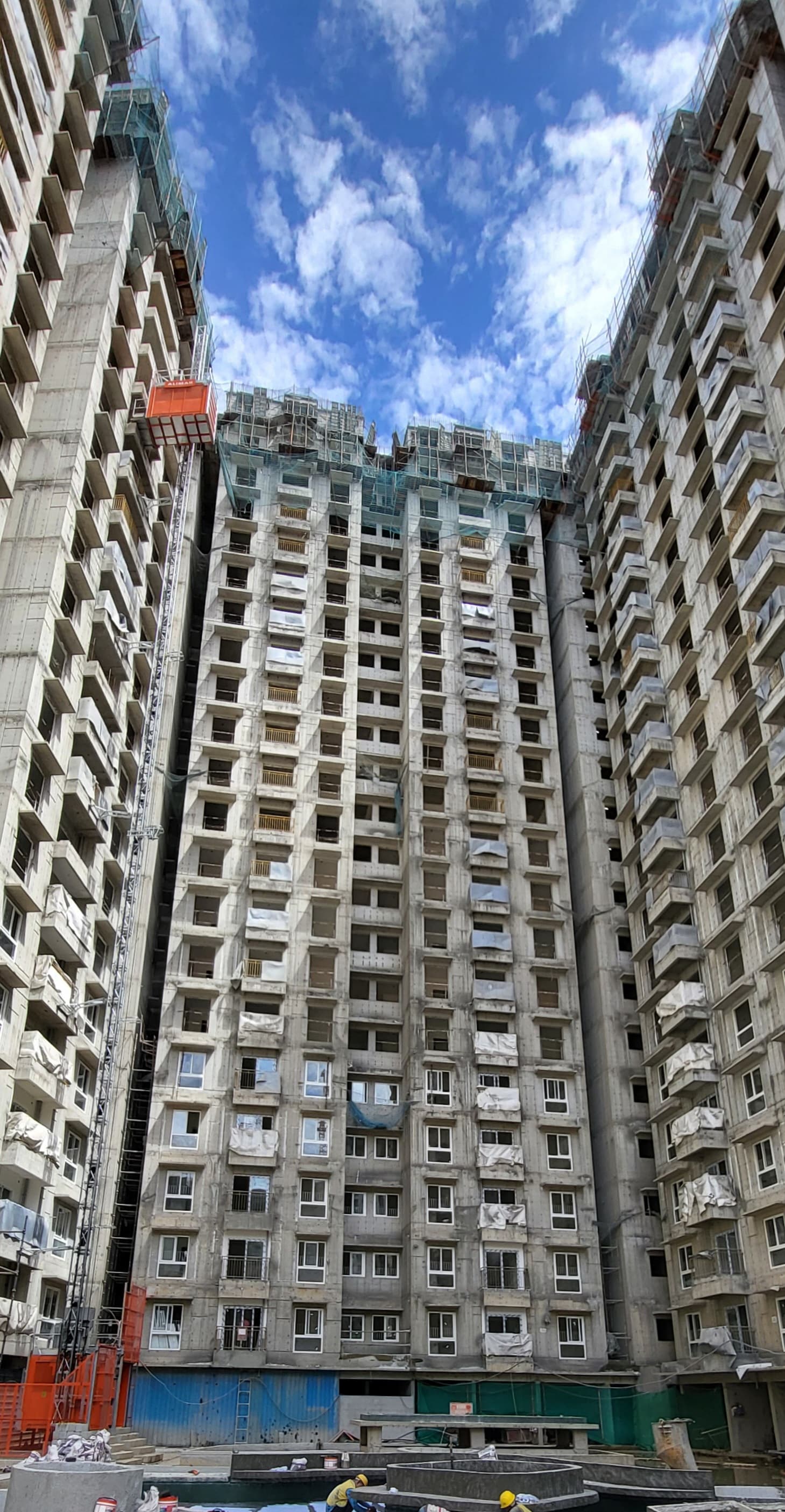

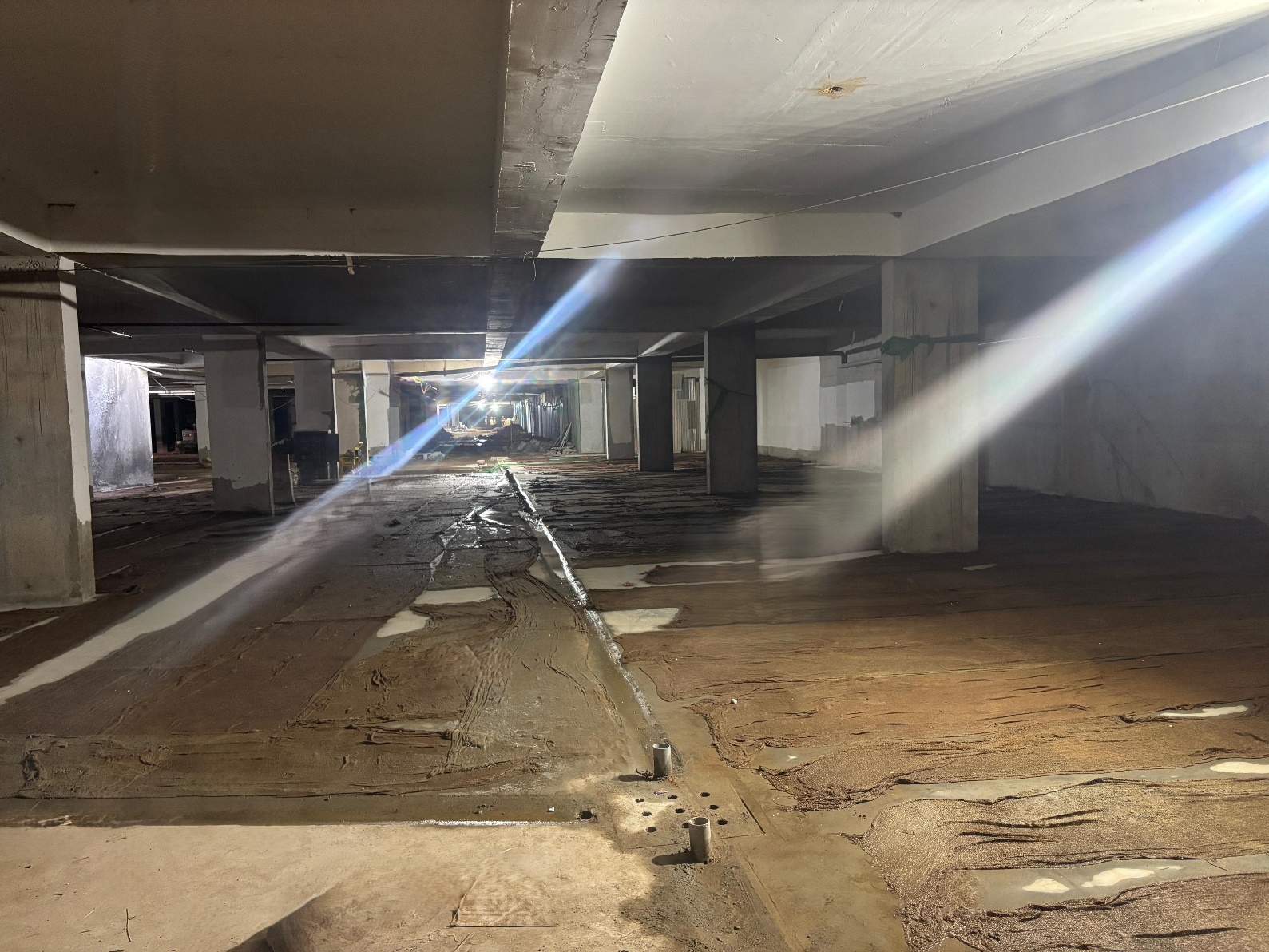

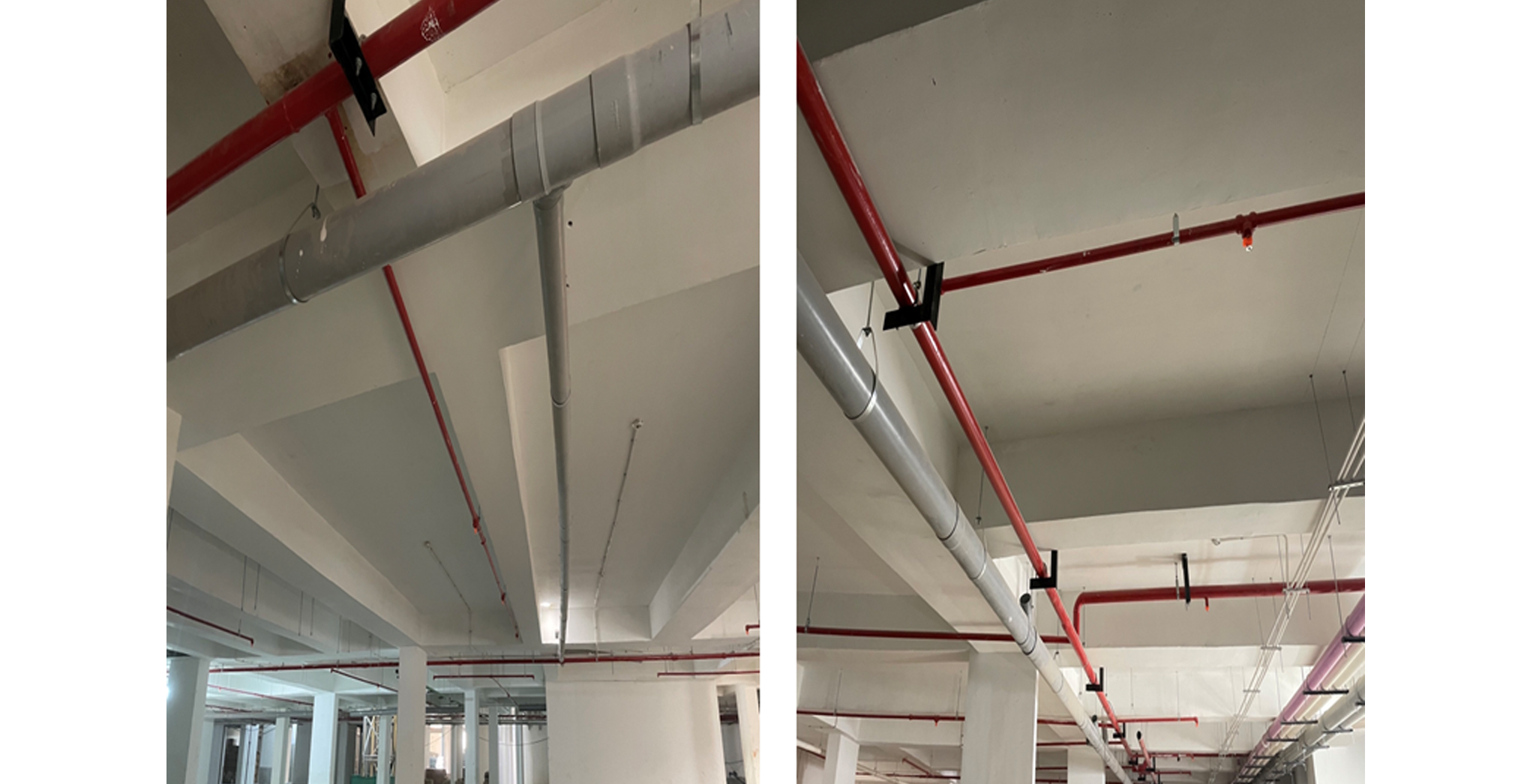

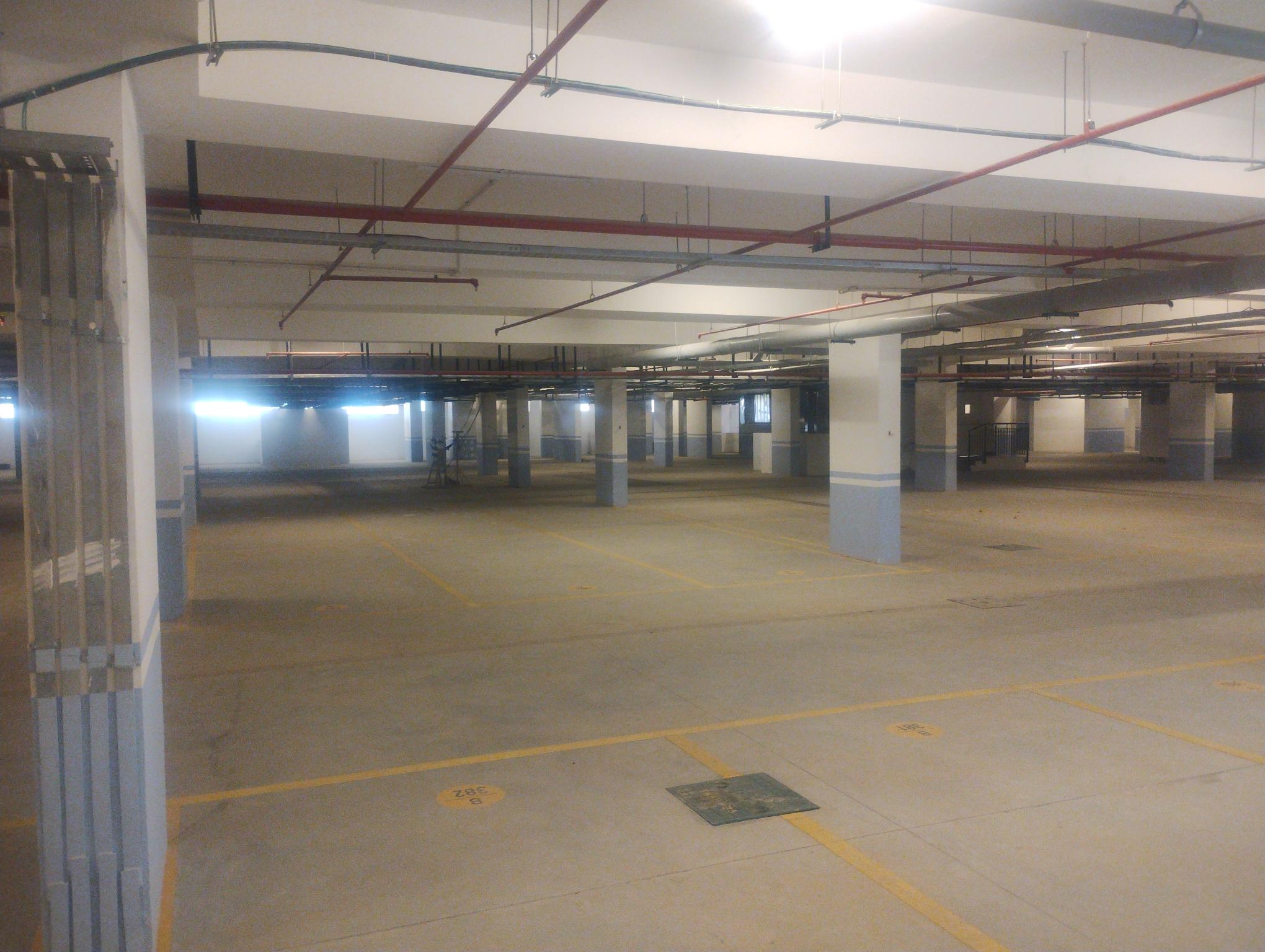

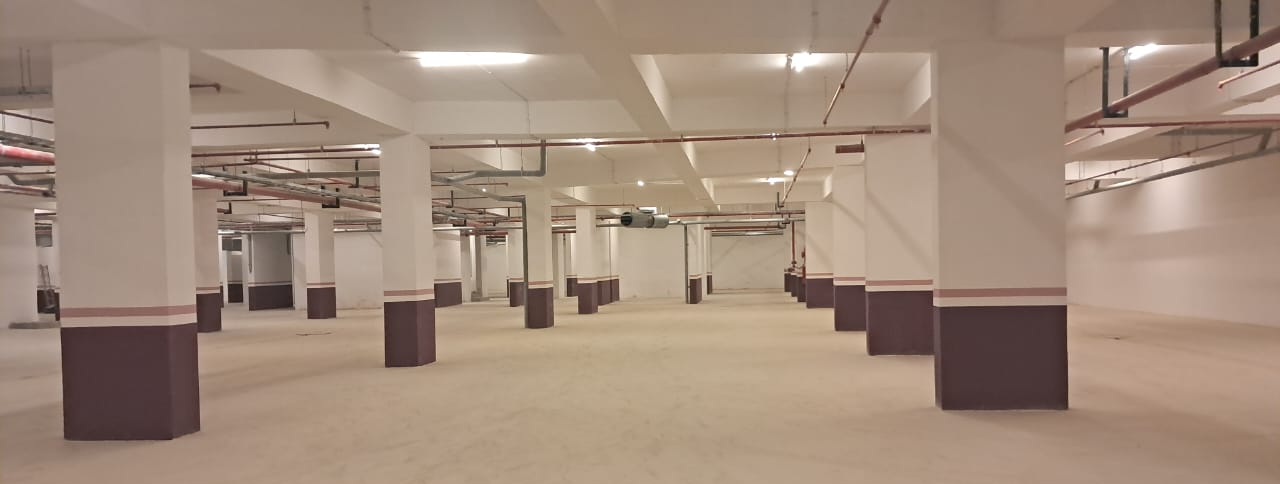

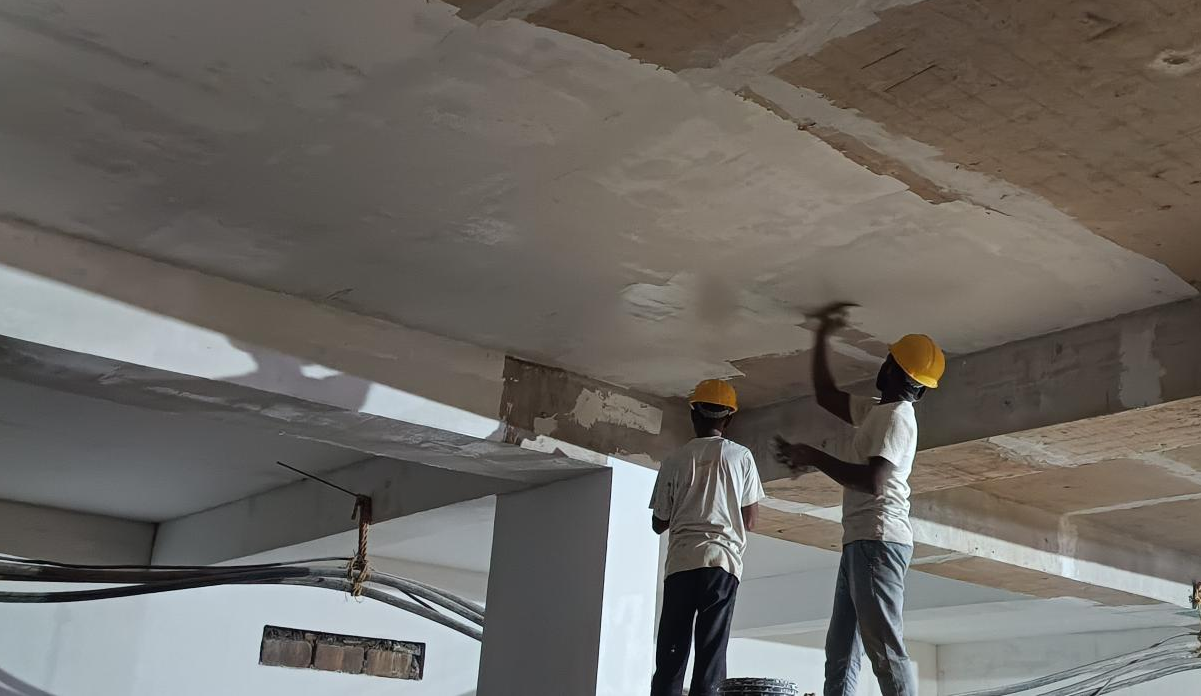

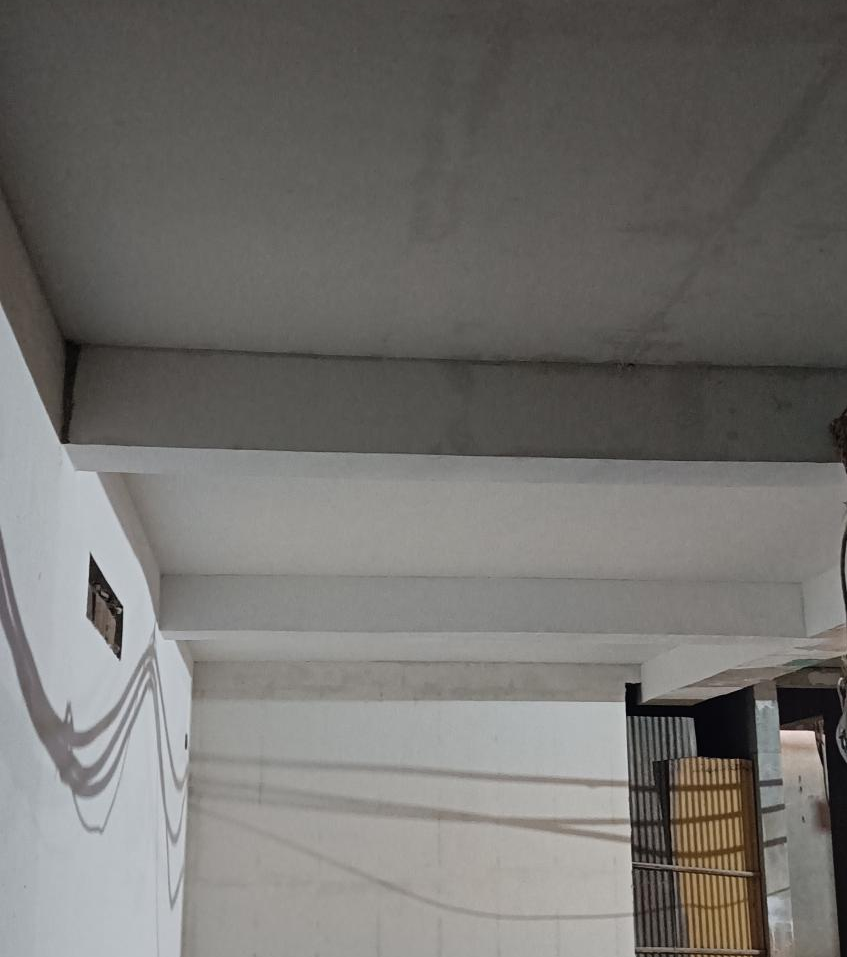

Basement painting work in progress. - Jun 2025

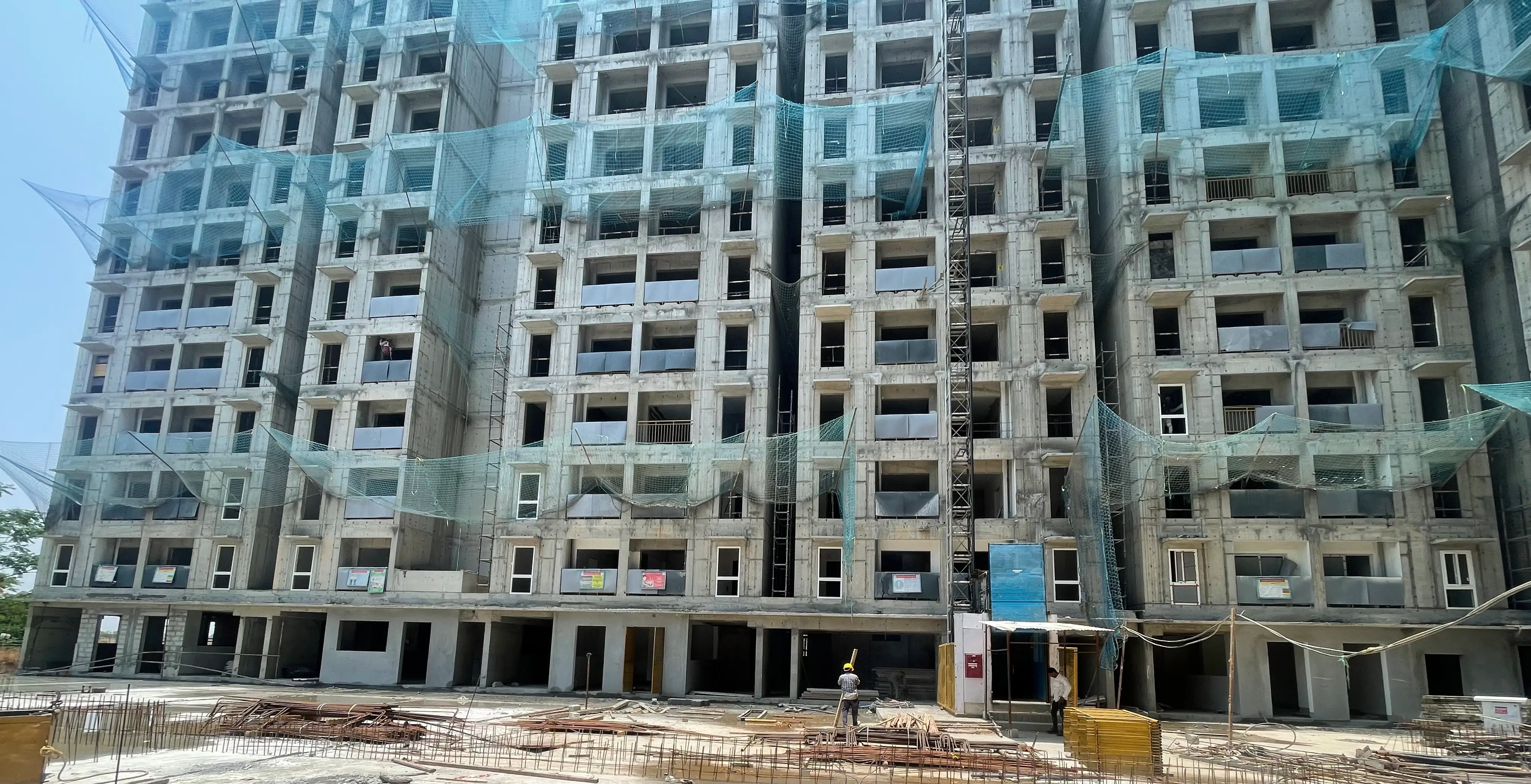

AURUM – Wing B – Milestone Release “On Commencement of Window fixing-1st to 6th Floor” – Status as on 28th - Jun 2025

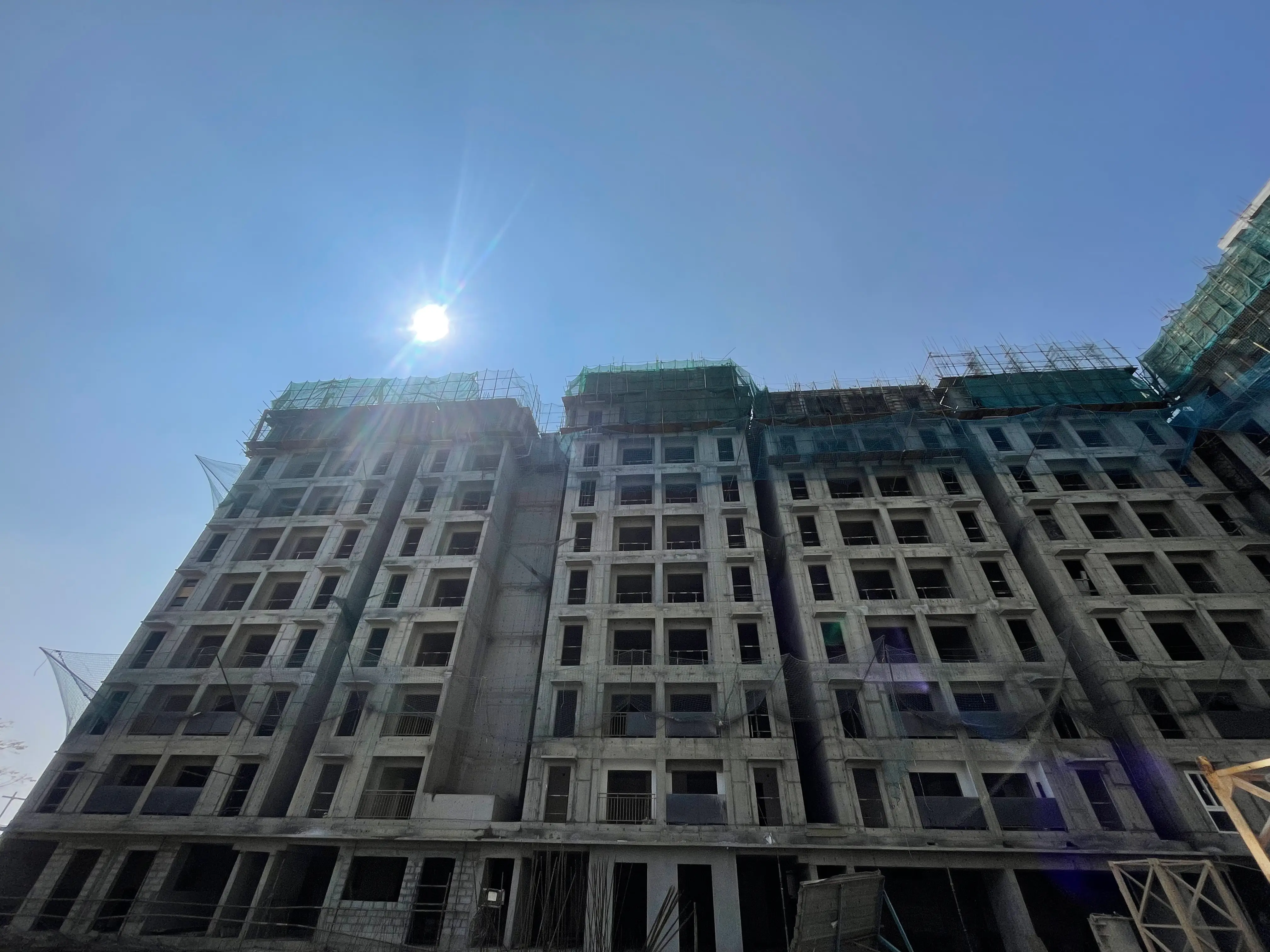

AURUM – Wing C -Milestone Release –“On Casting of Sixteenth Floor Slab” - Status as on 30th - Jun 2025

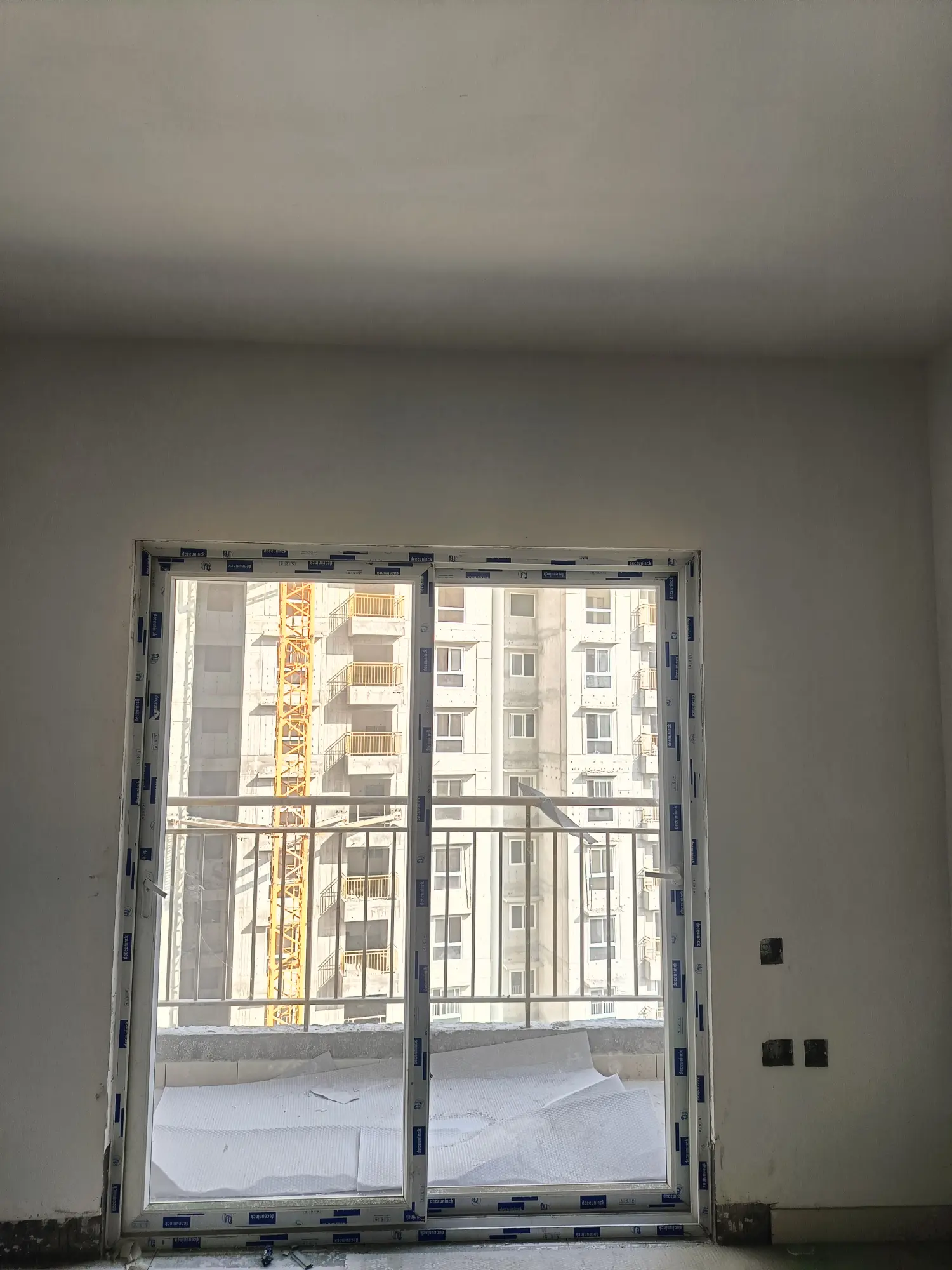

AURUM – Wing B – Milestone Release “On Commencement of Window fixing-1st to 6th Floor” – Status as on 28th - Jun 2025

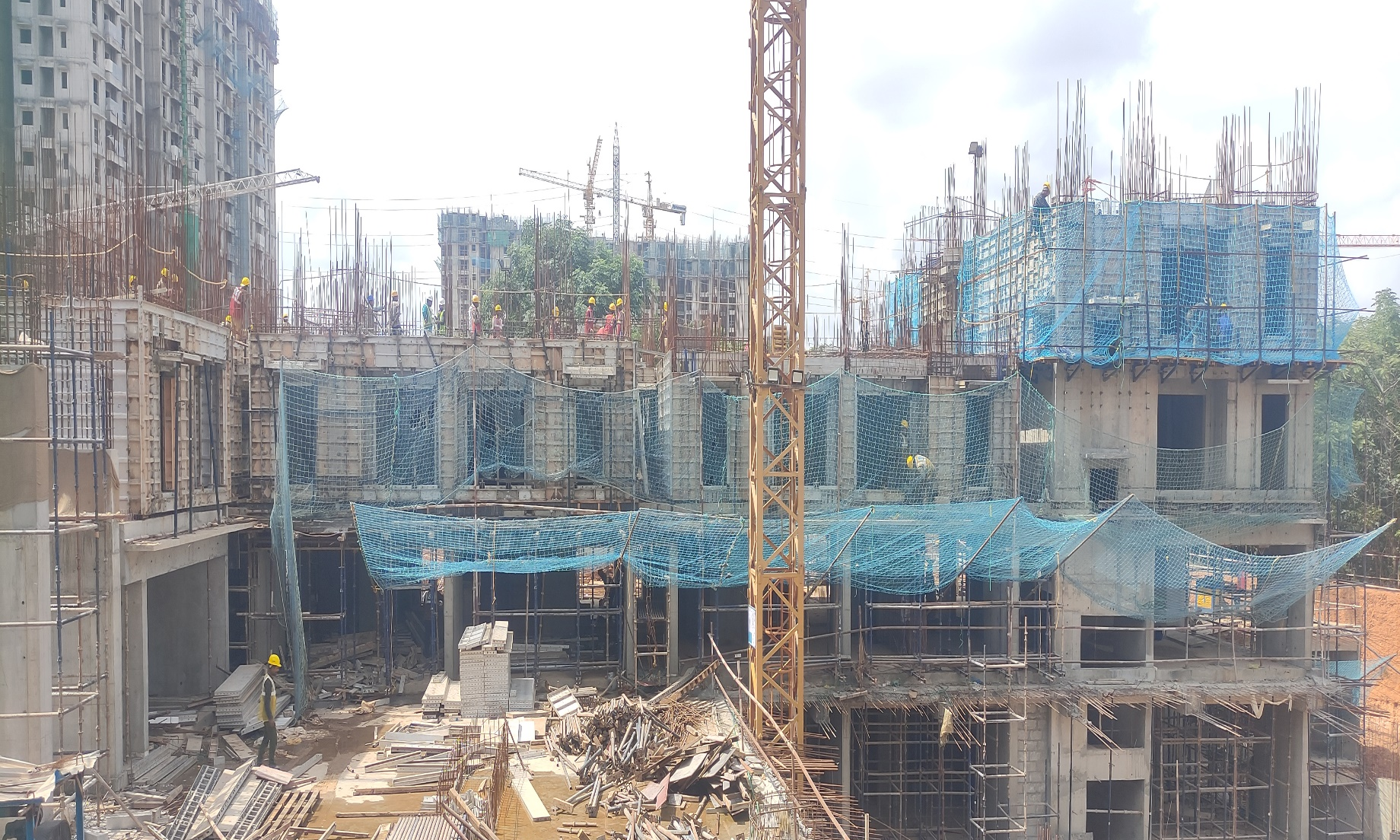

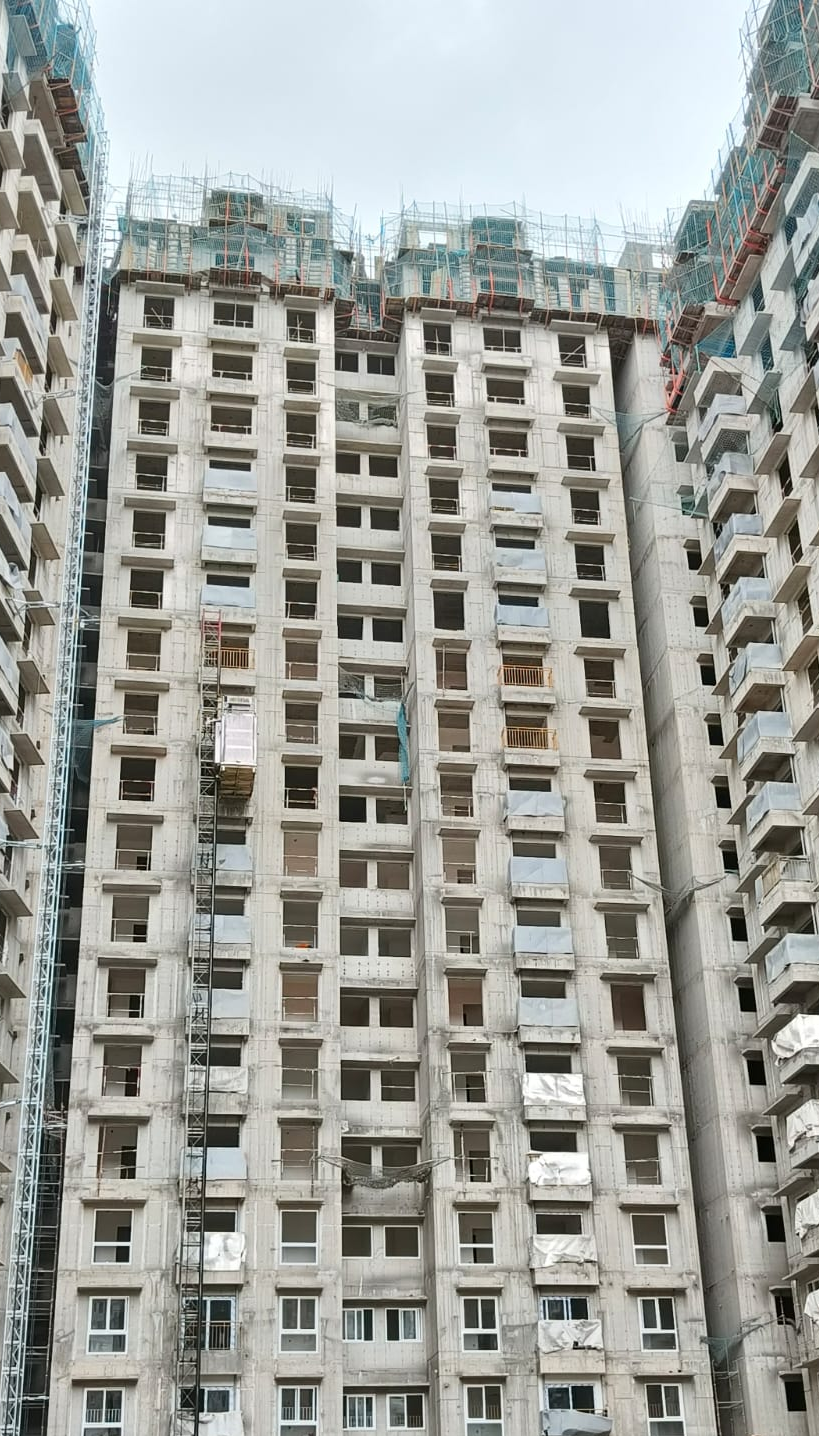

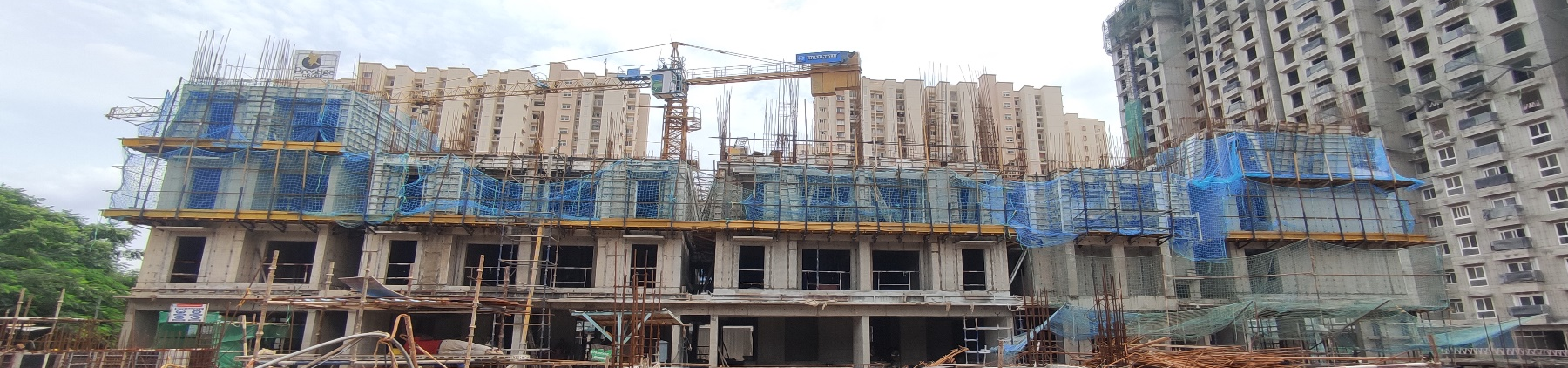

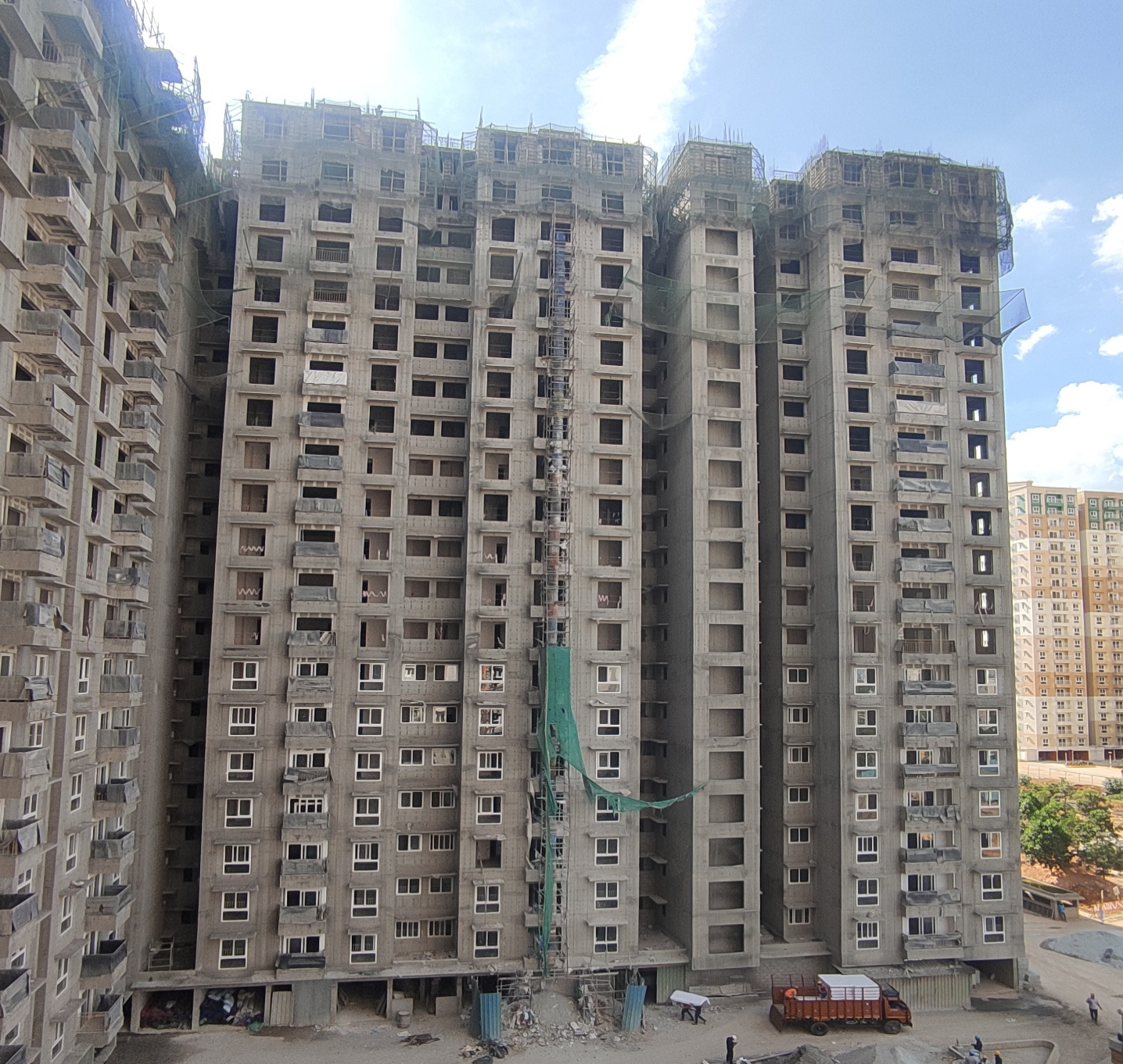

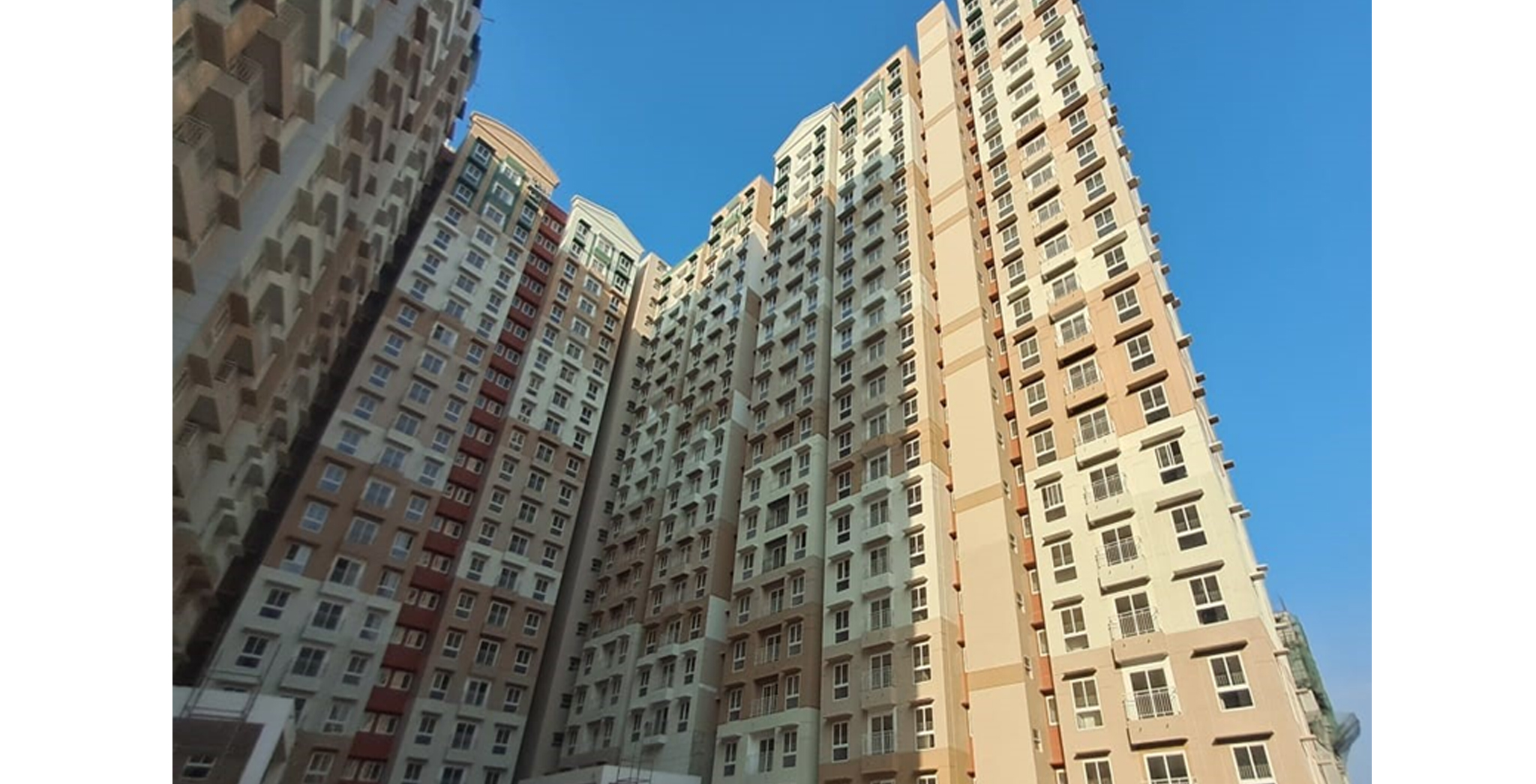

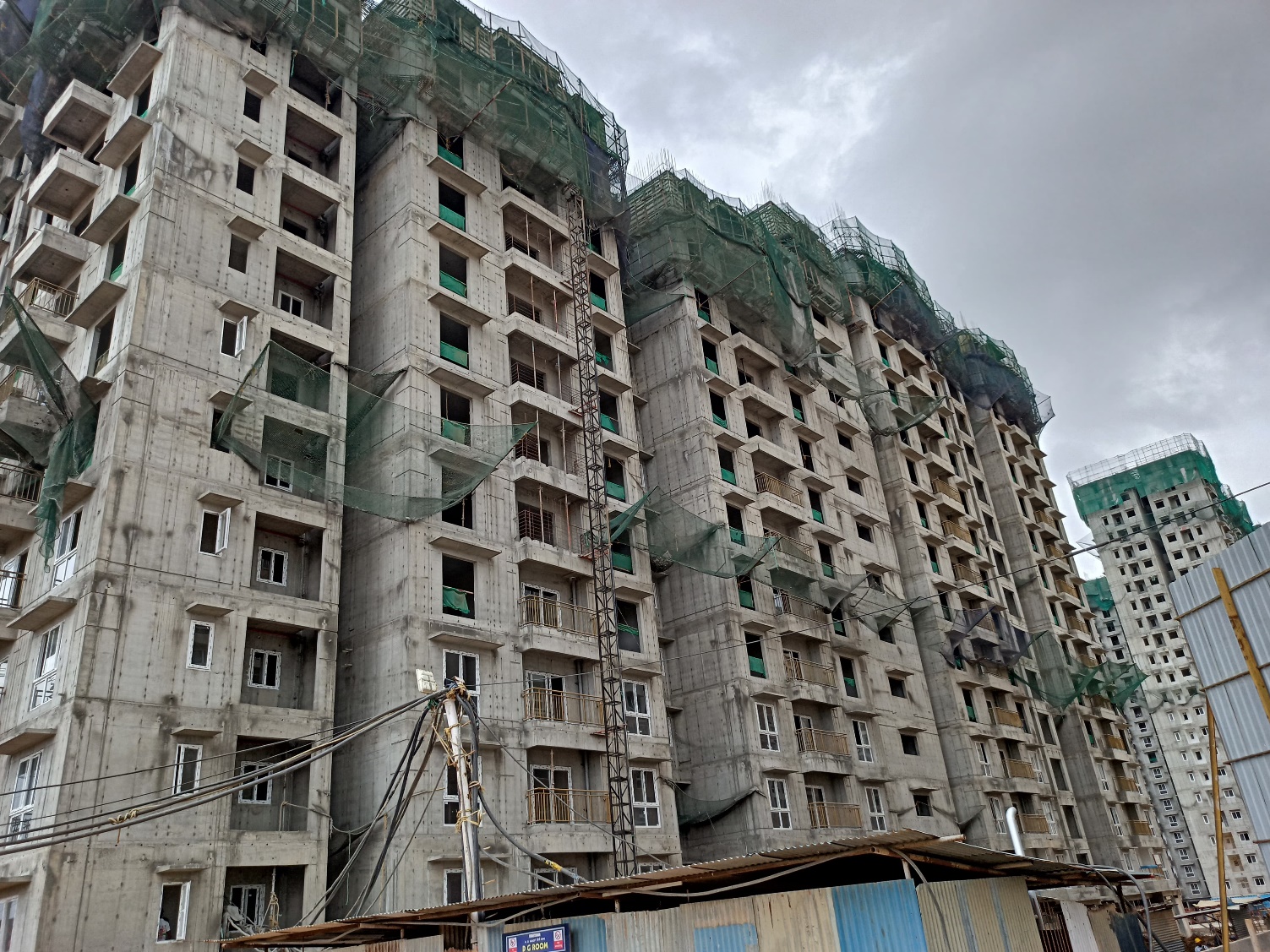

Wing A - Part of 20th floor wall reinforcement work in progress. Part of 18th floor wall reinforcement work in progress. - Jun 2025

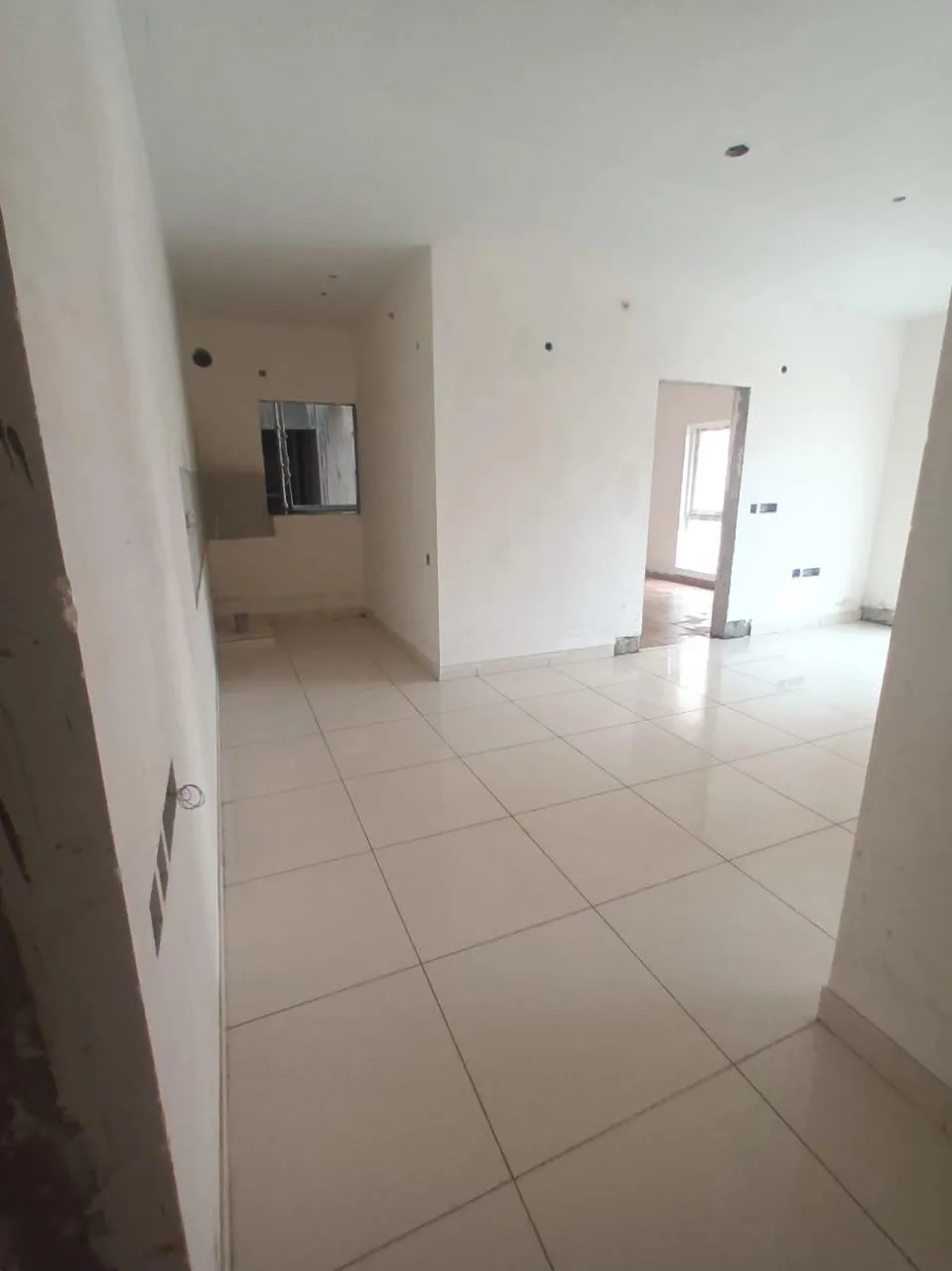

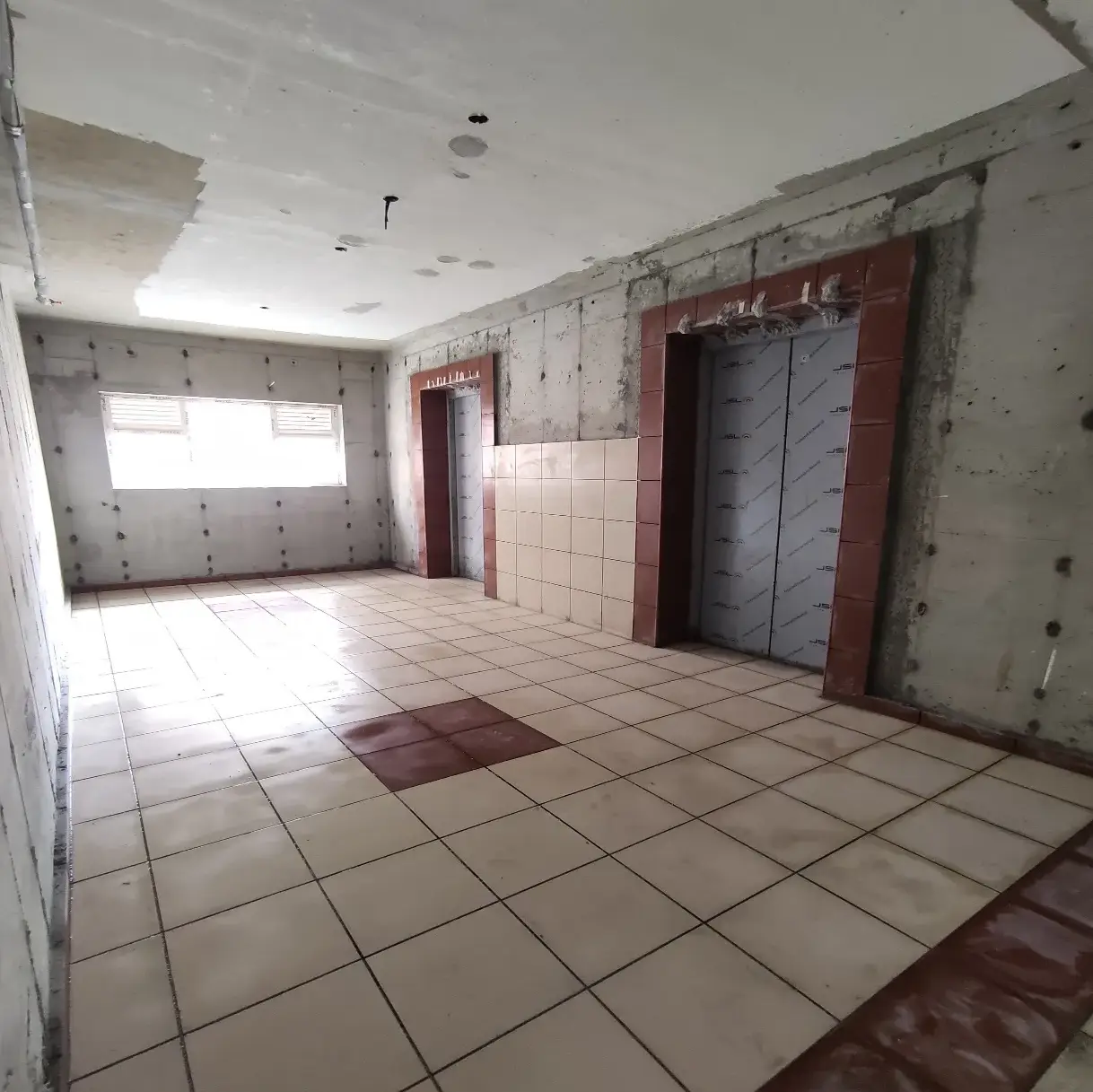

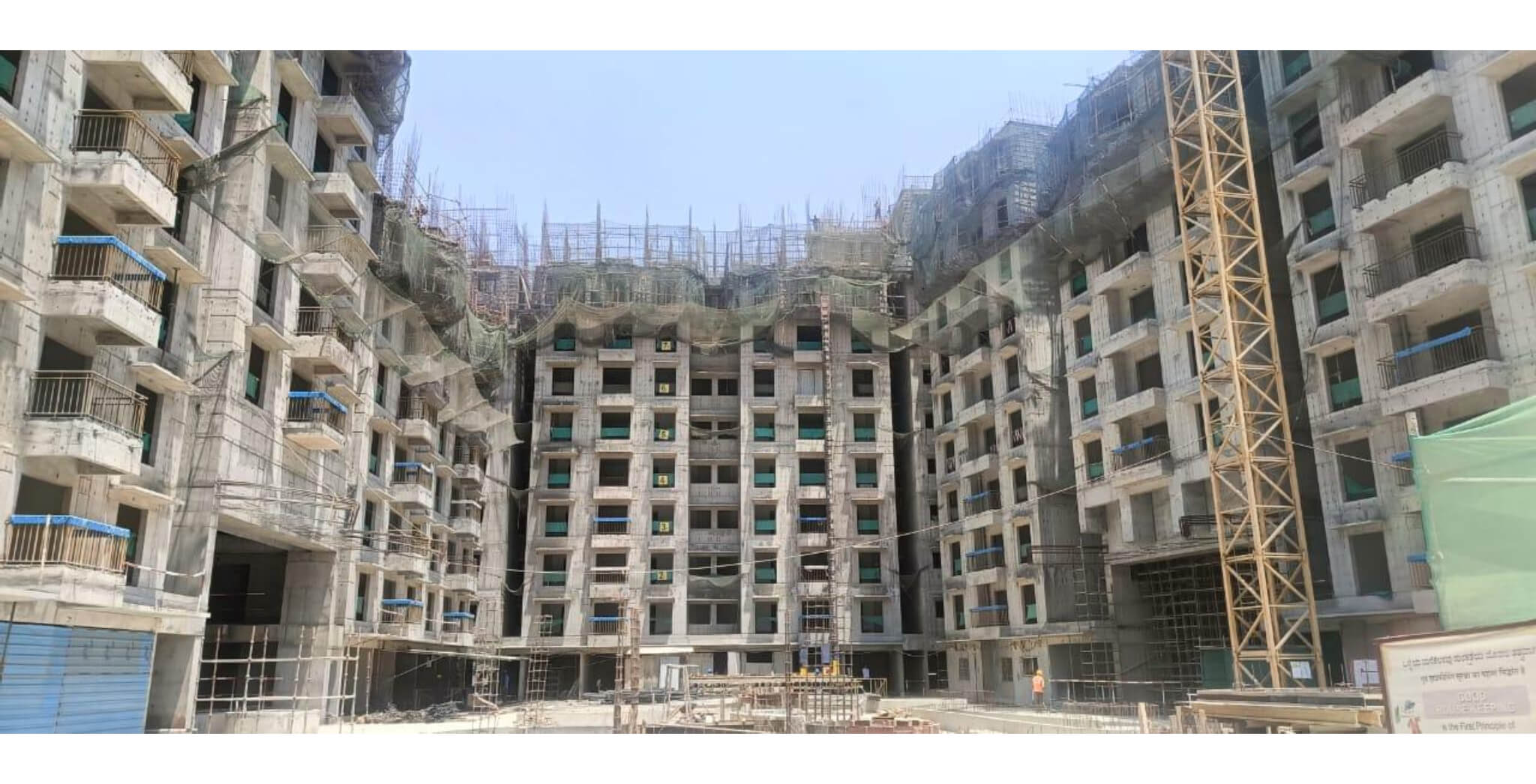

Tiling works Wing A: 9th floor work in progress Wing B: 9th floor work in progress Wing C: 9th floor work in progress - Jun 2025

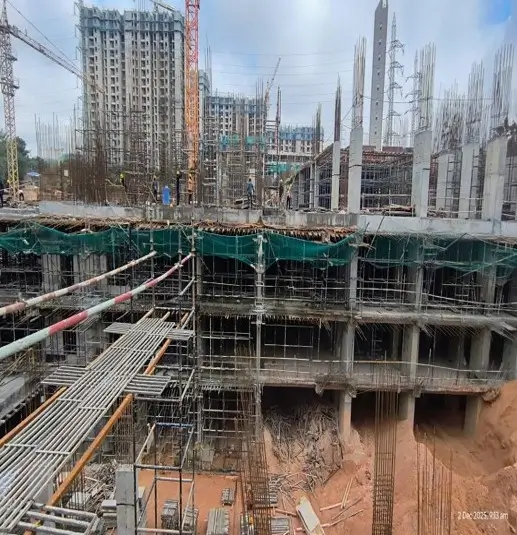

Wing C – Part of 16th floor wall shuttering work in progress. Part of 19th floor slab concrete work in progress. - Jun 2025

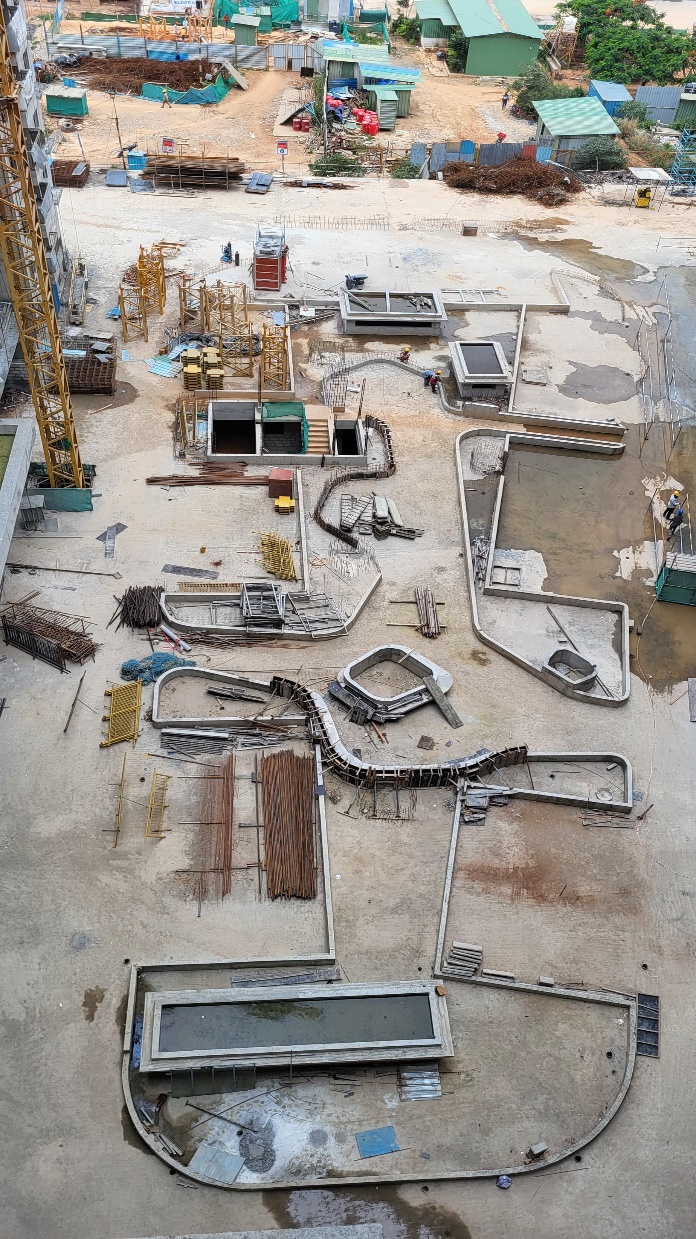

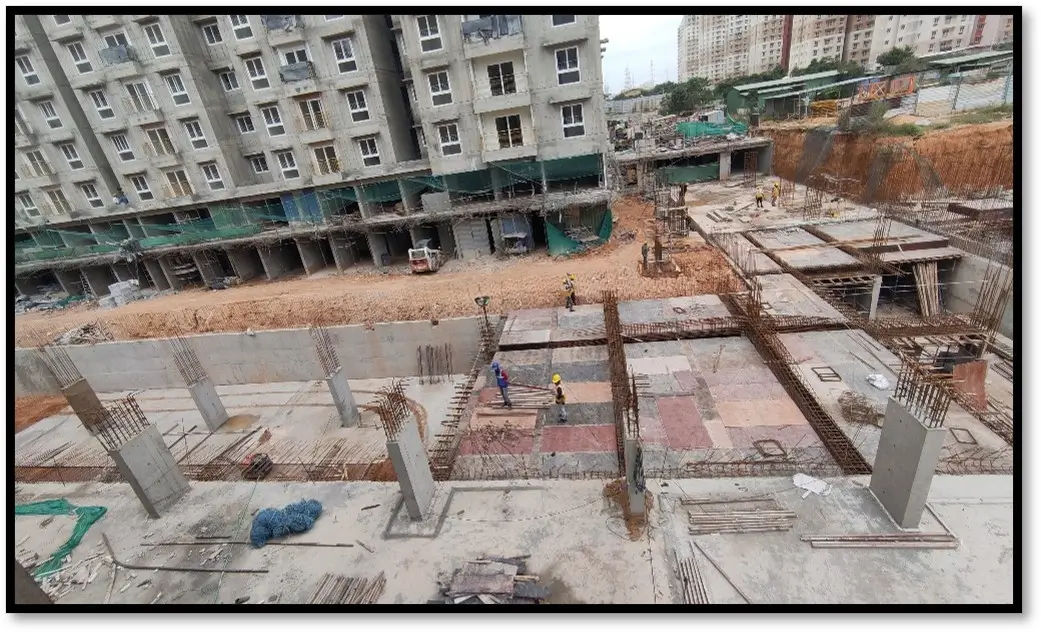

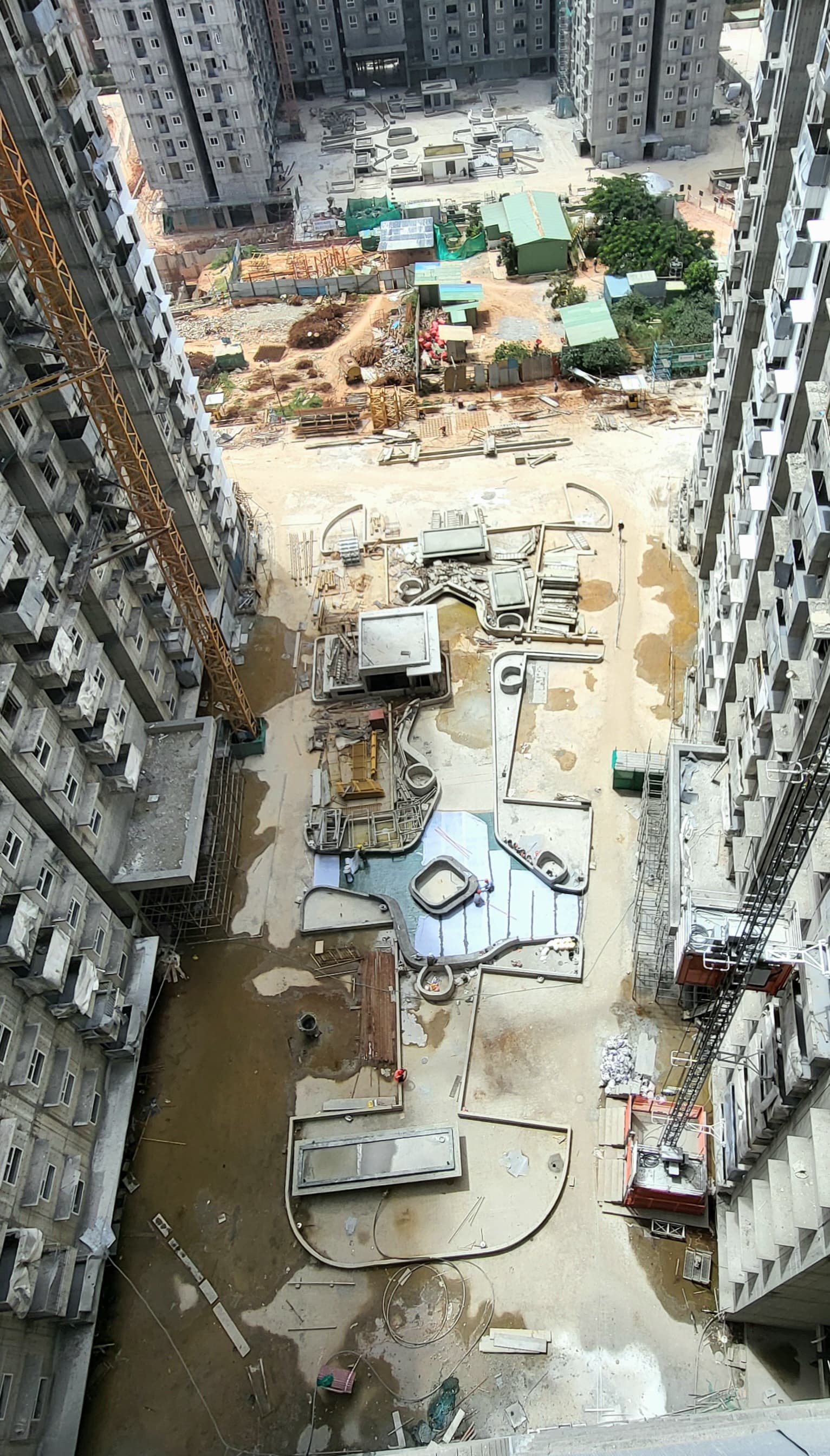

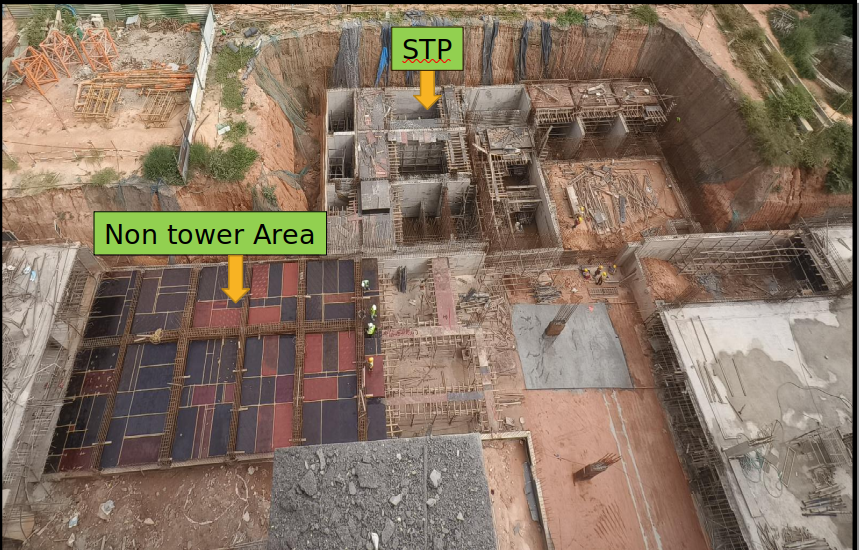

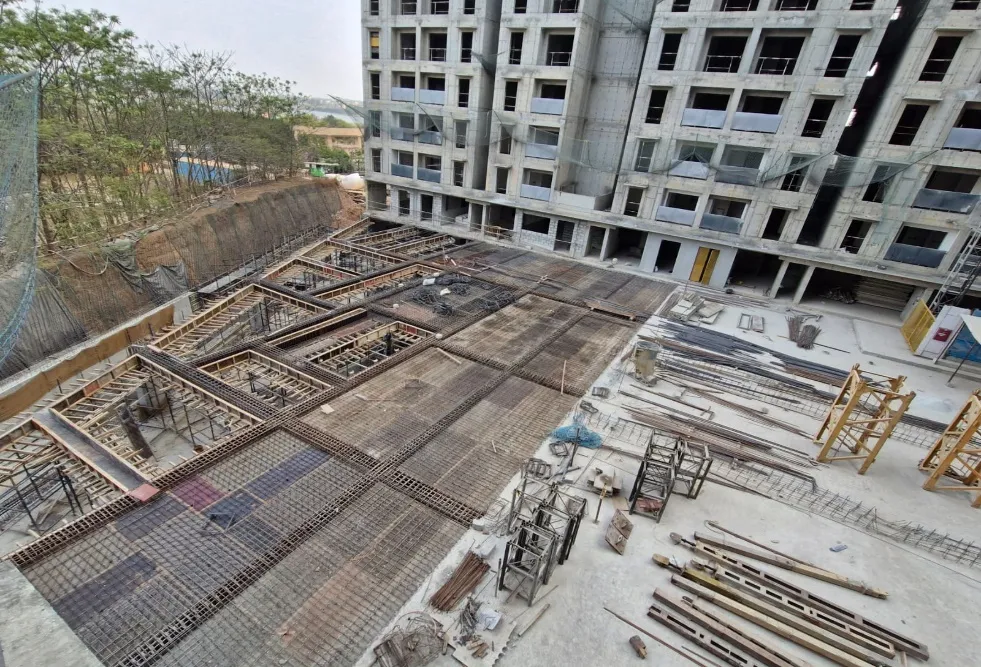

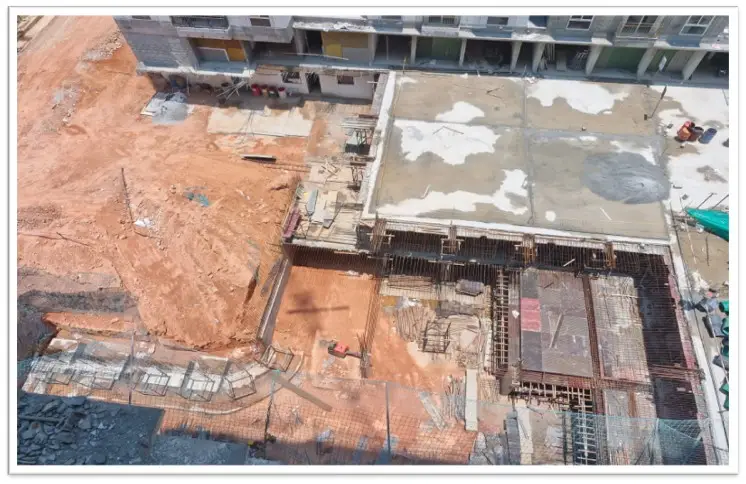

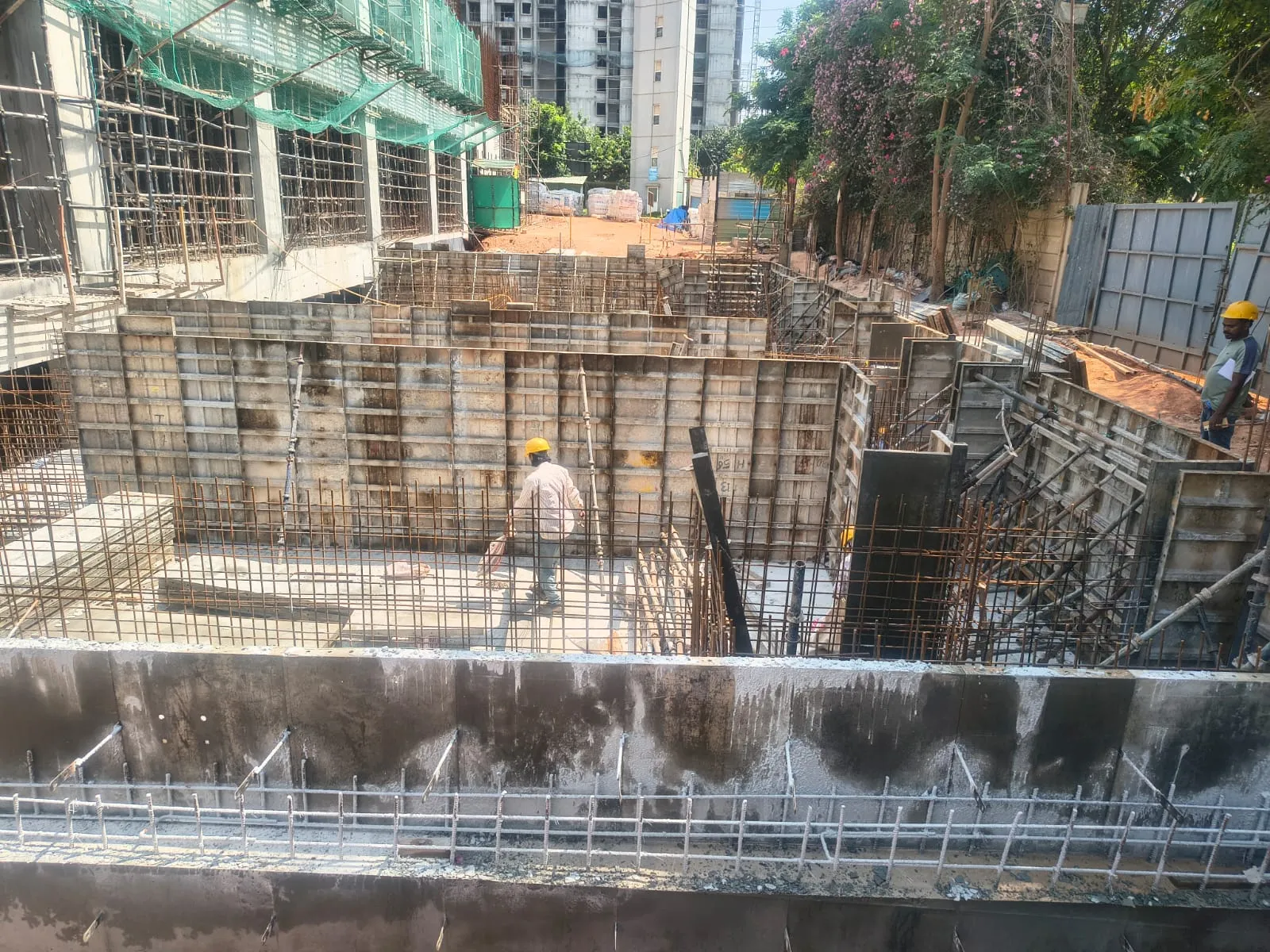

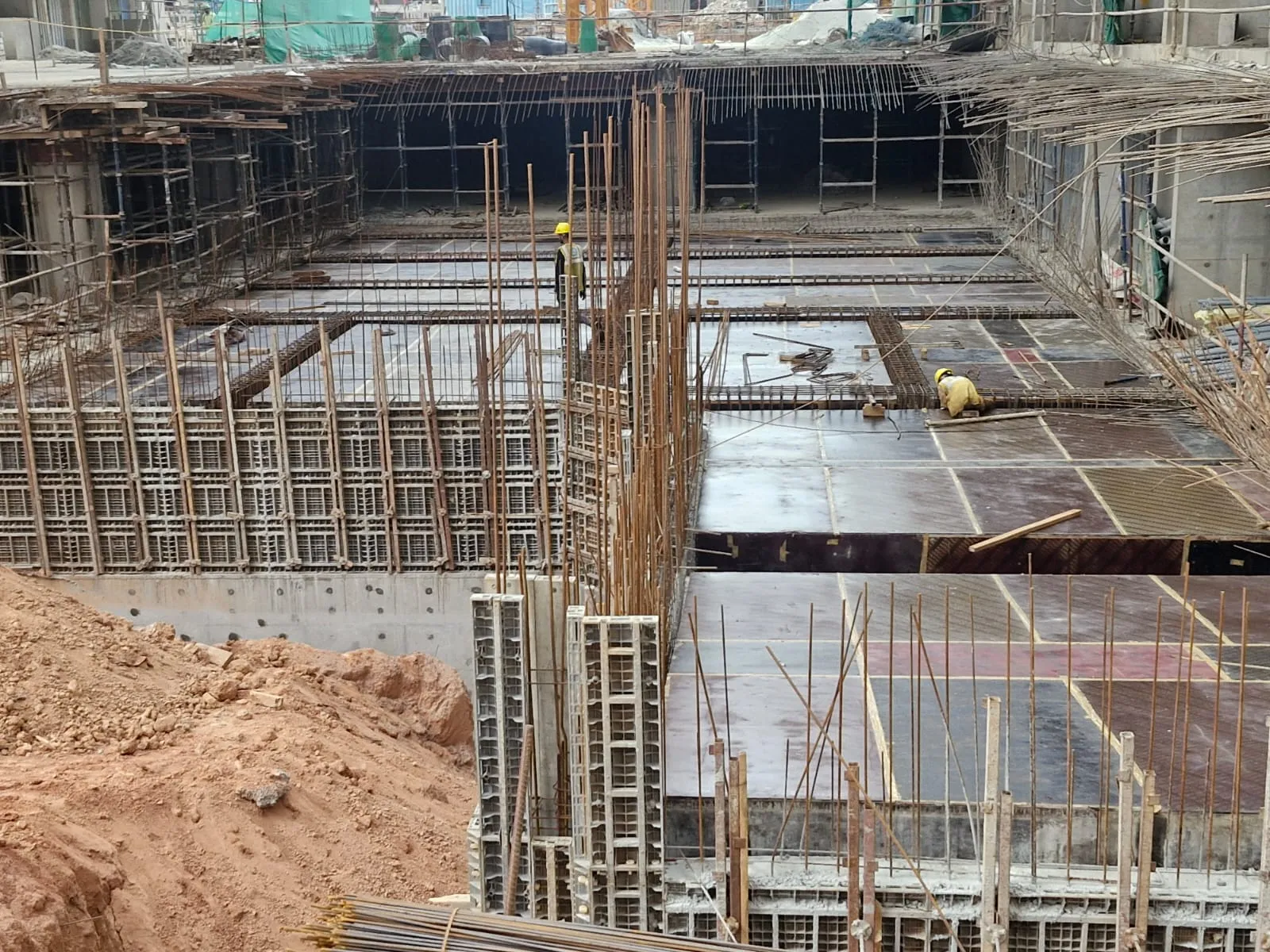

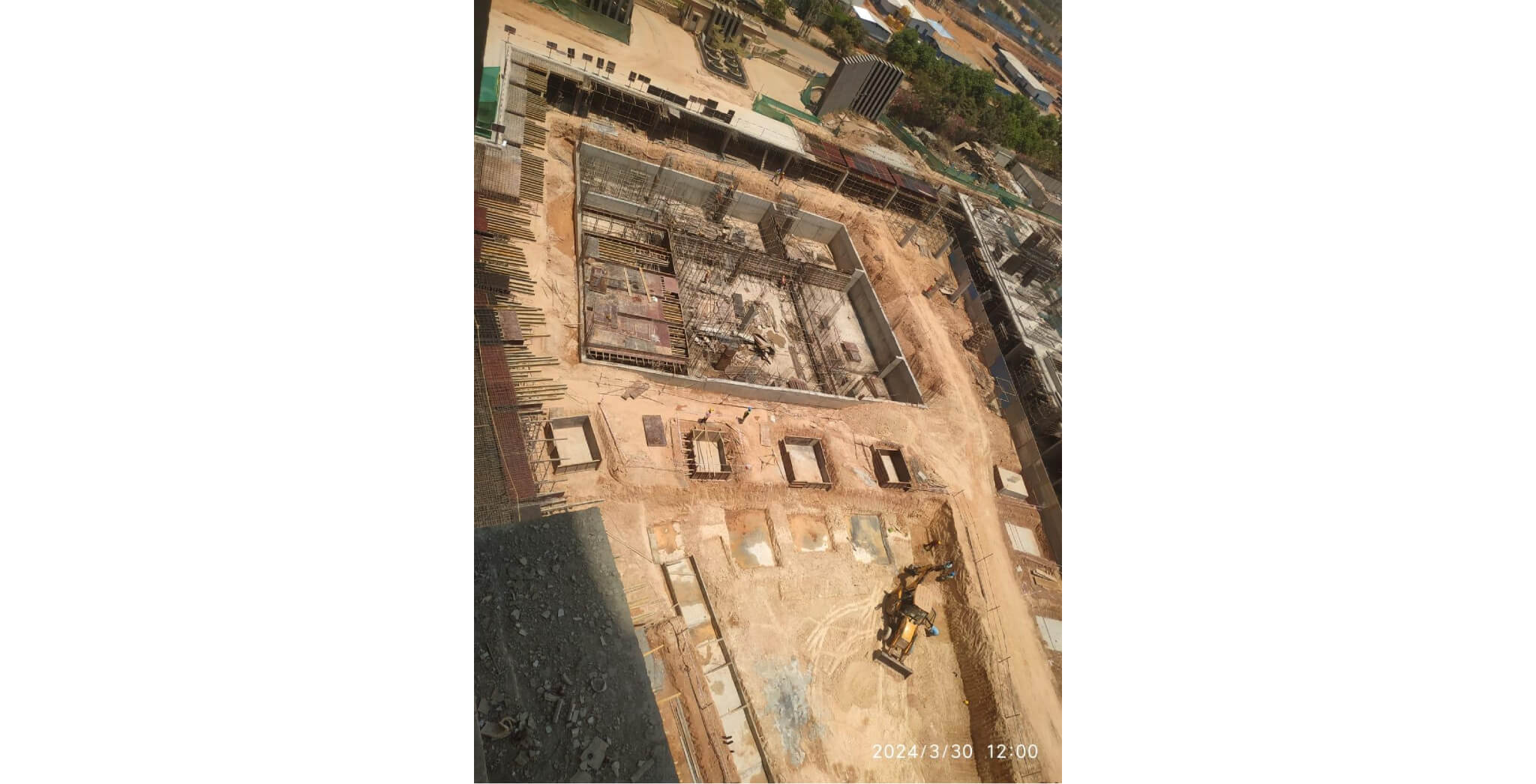

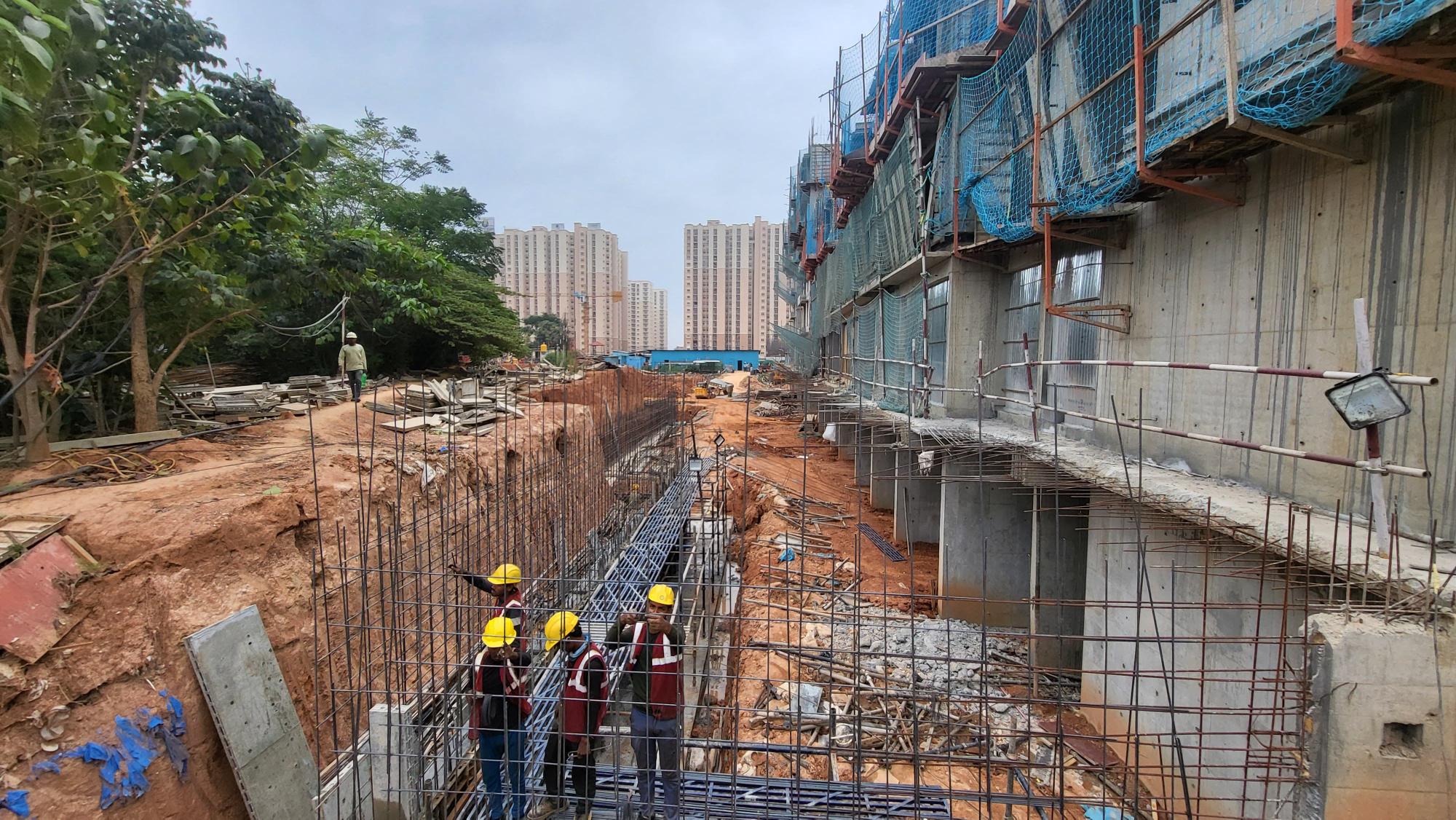

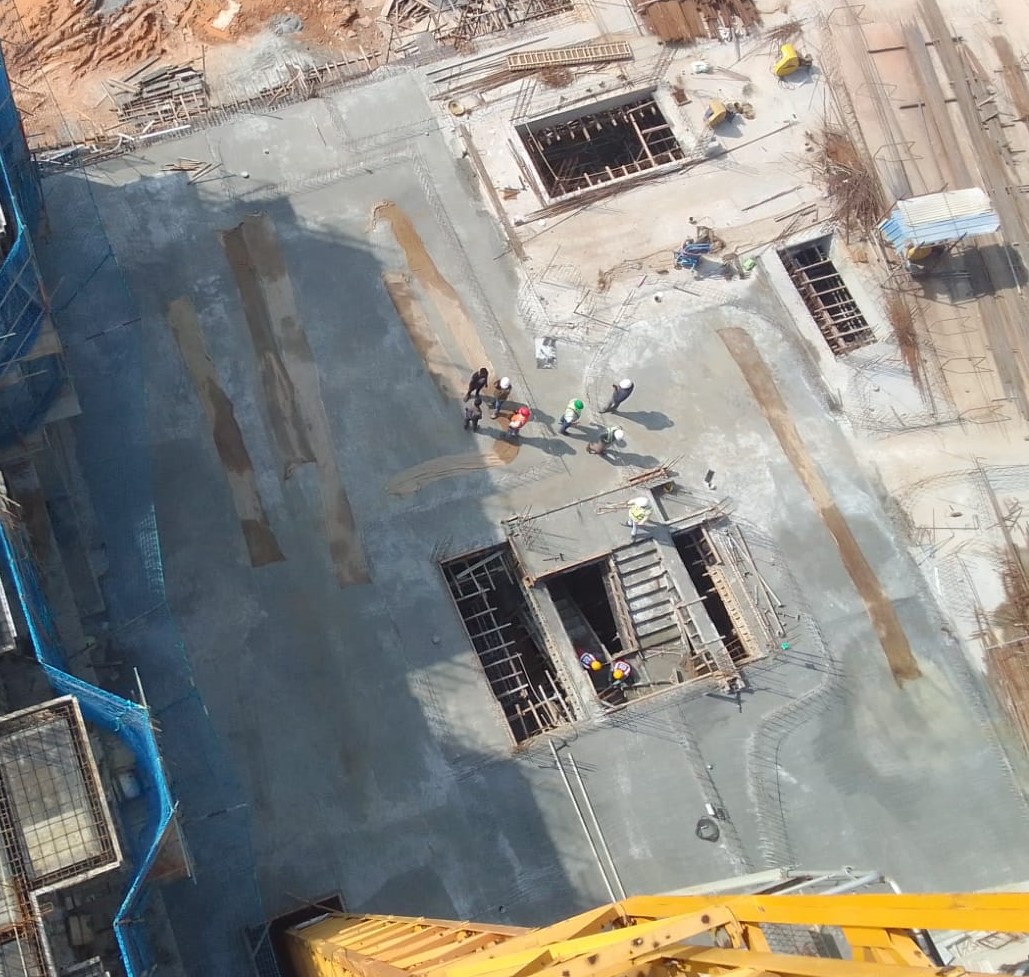

Non tower Area –Planter wall concrete work in progress. - Jun 2025

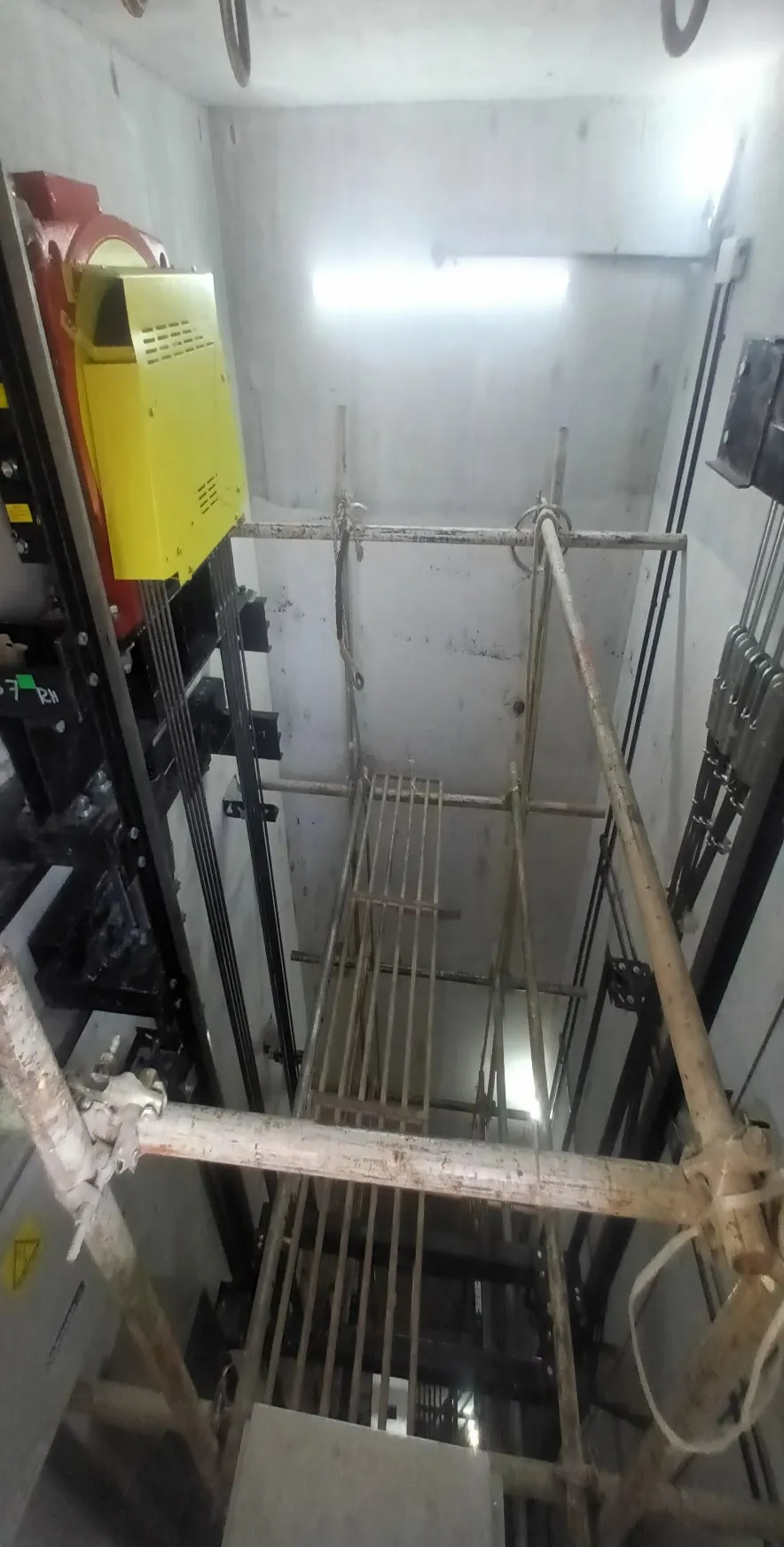

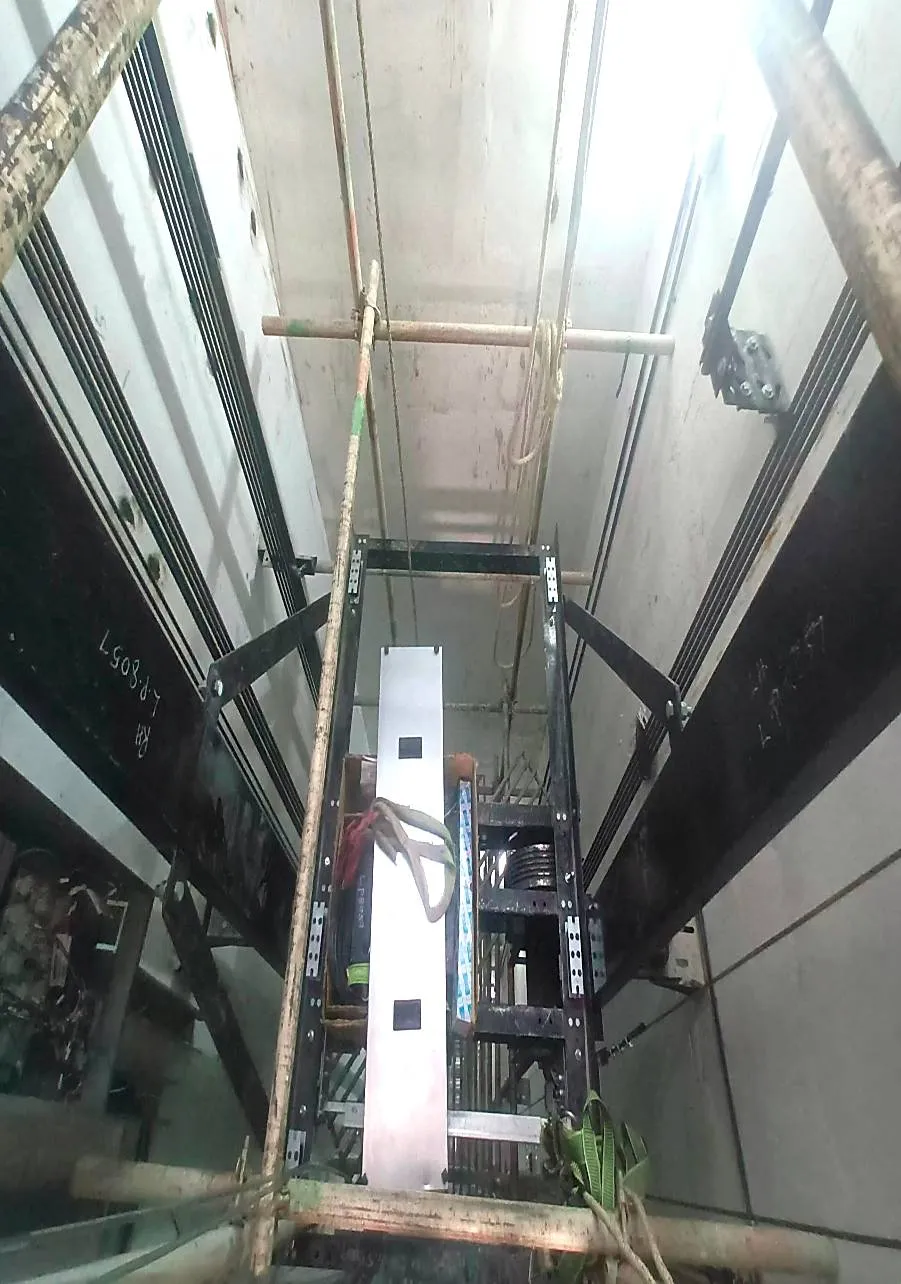

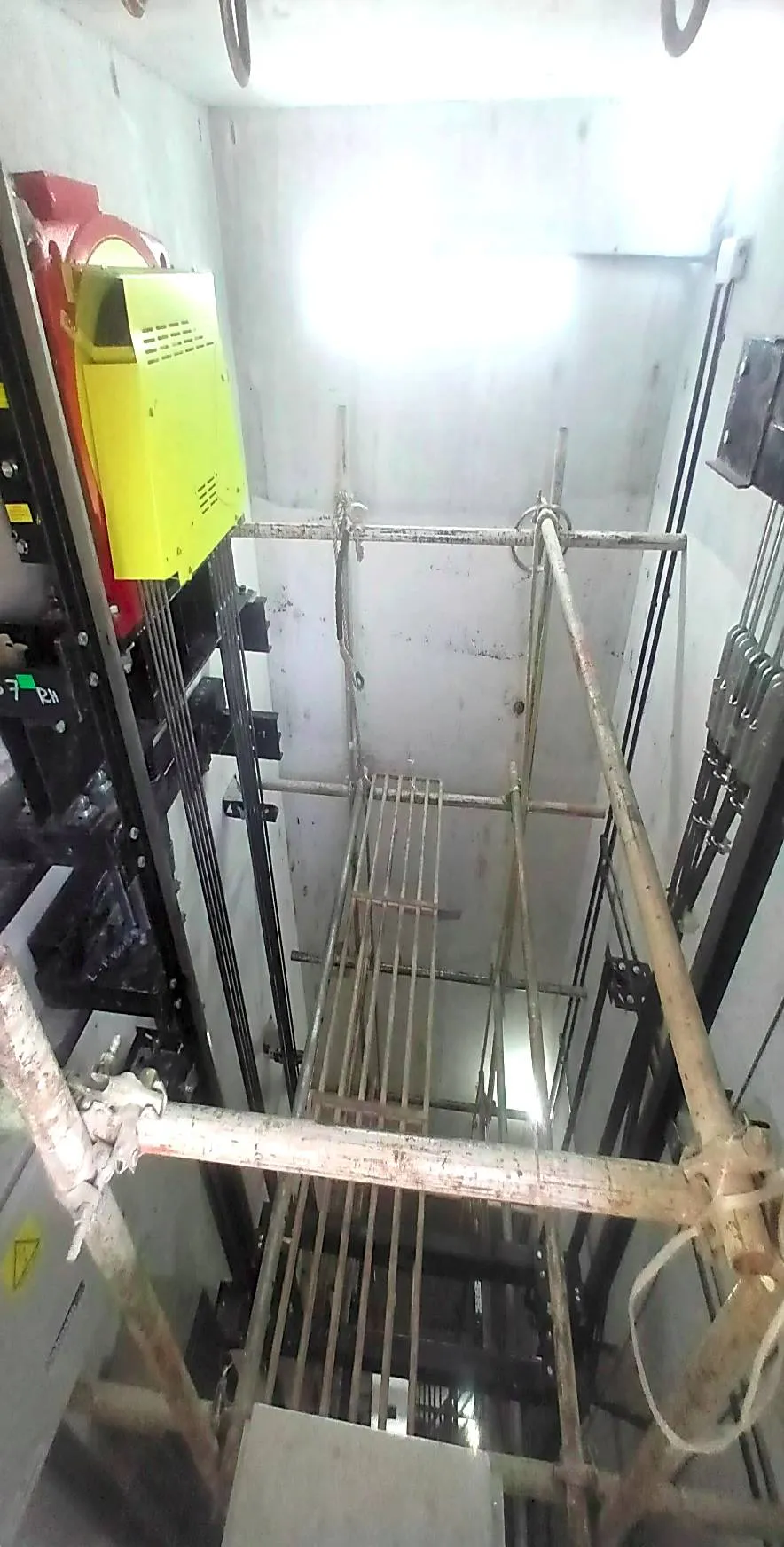

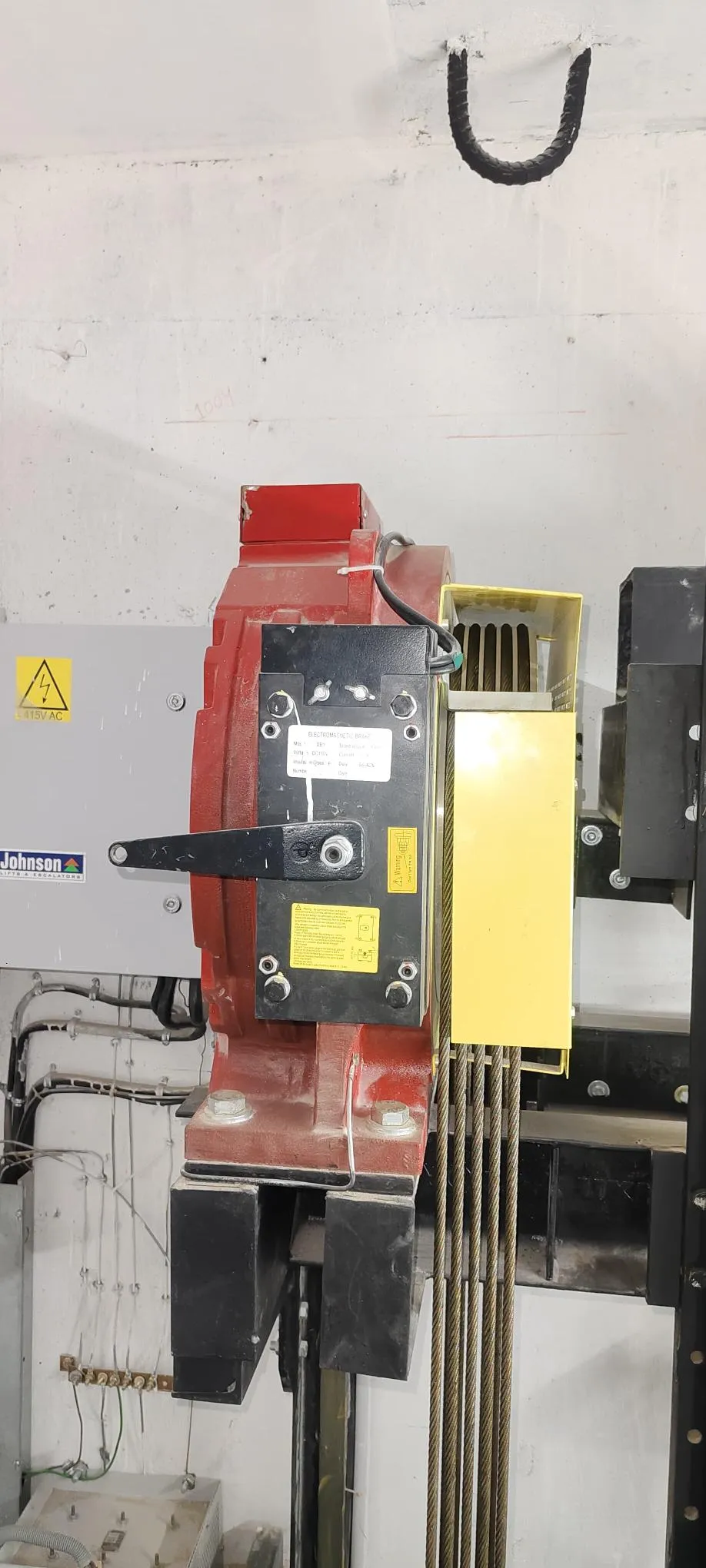

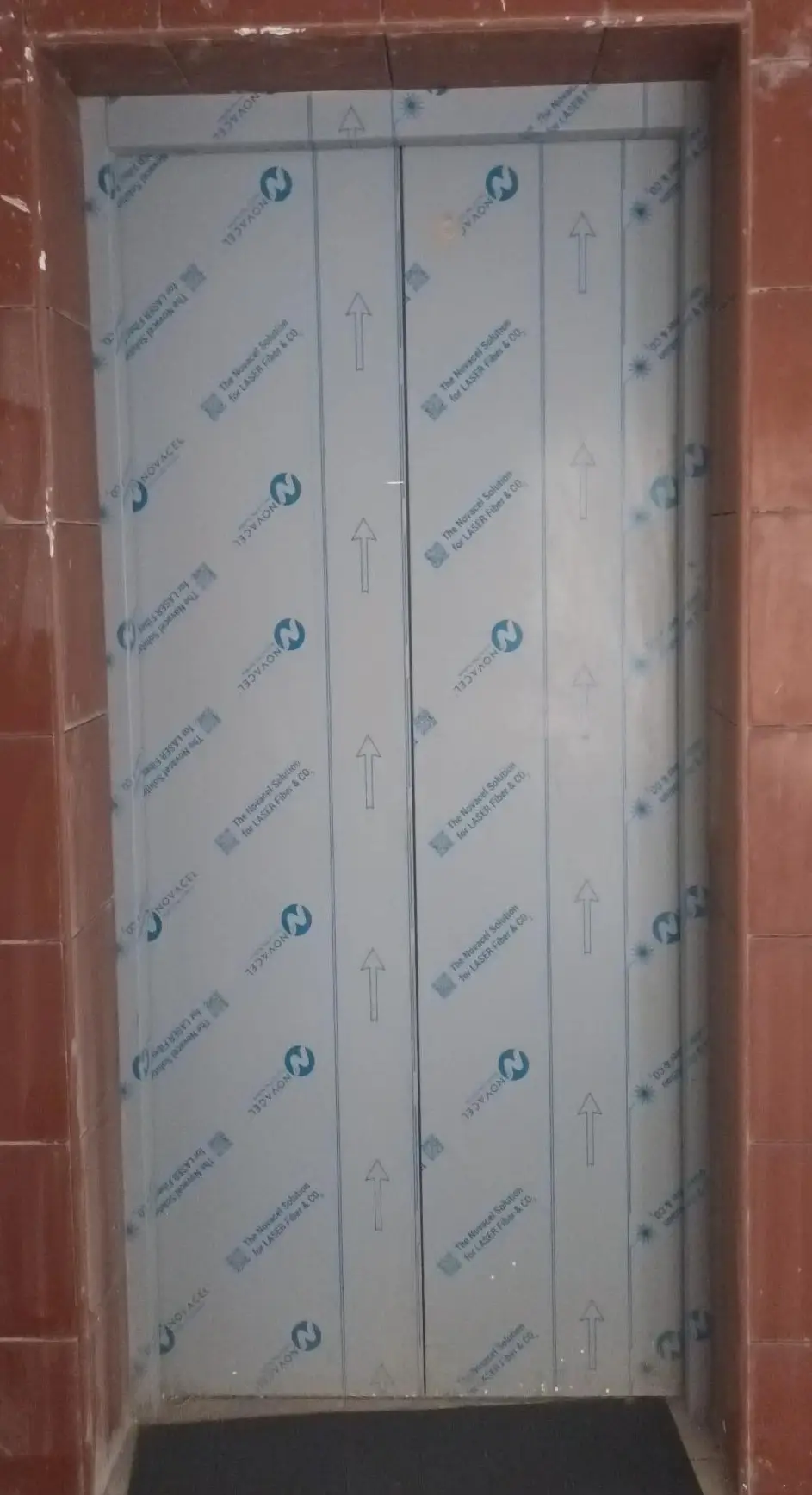

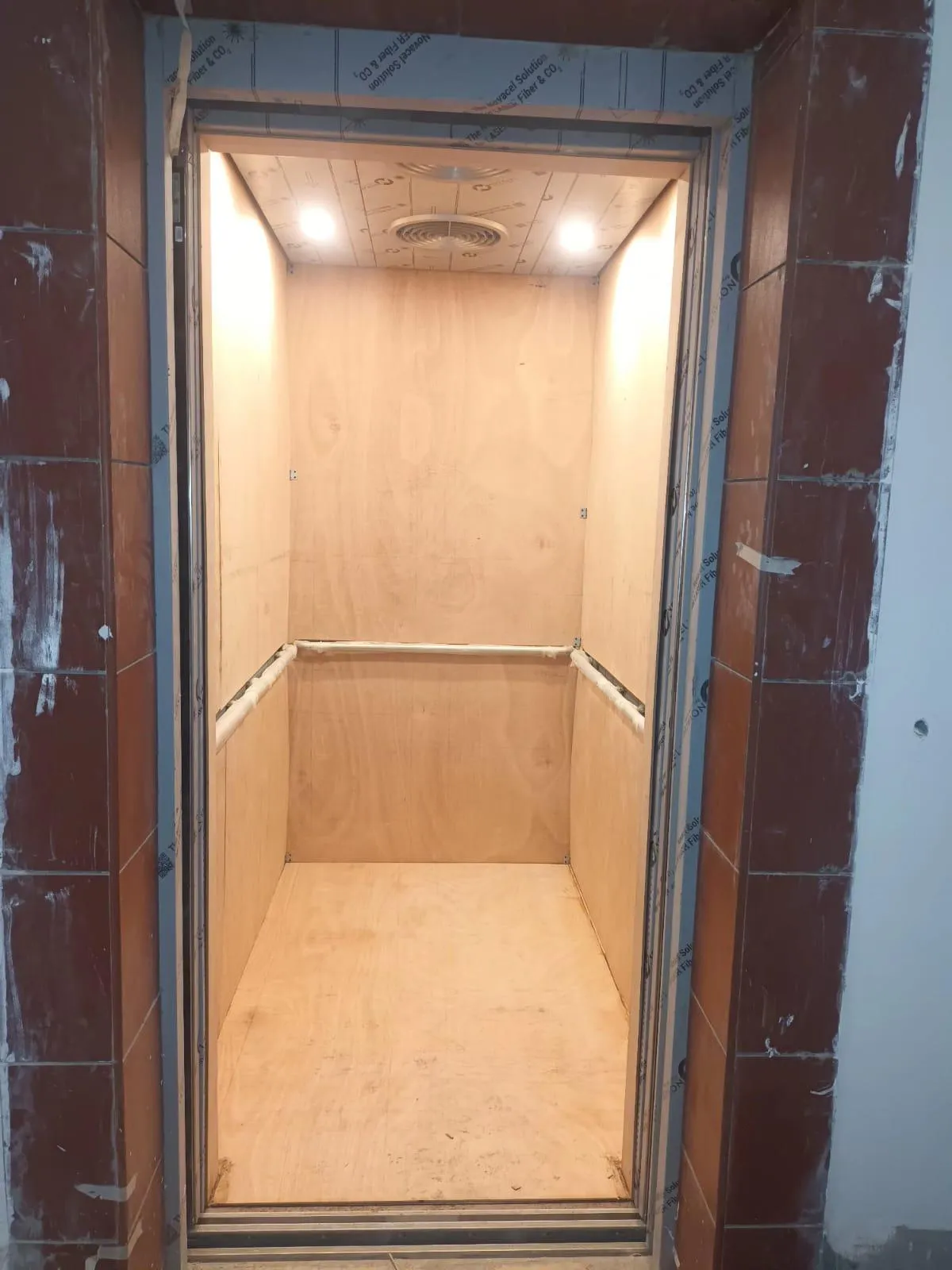

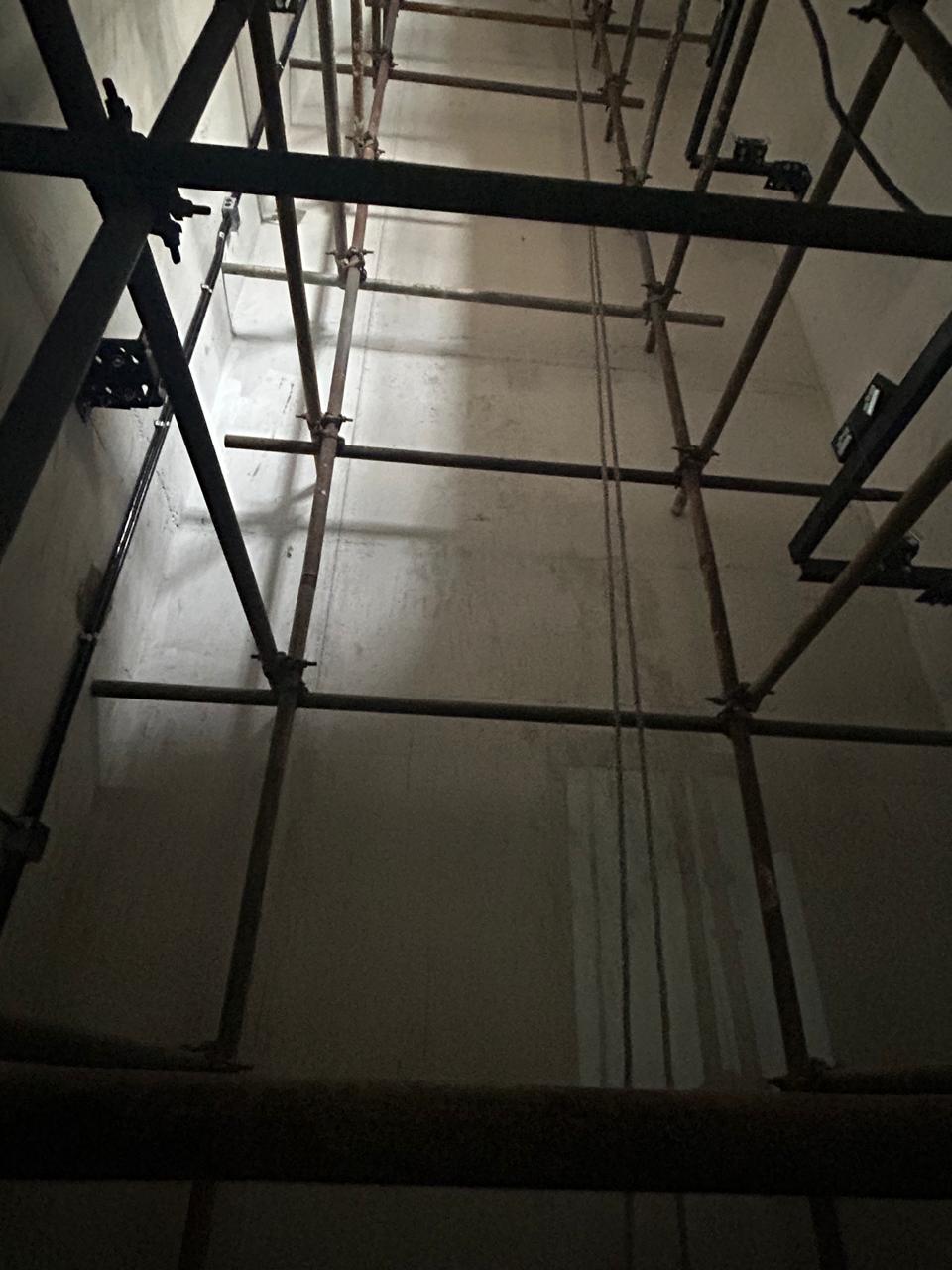

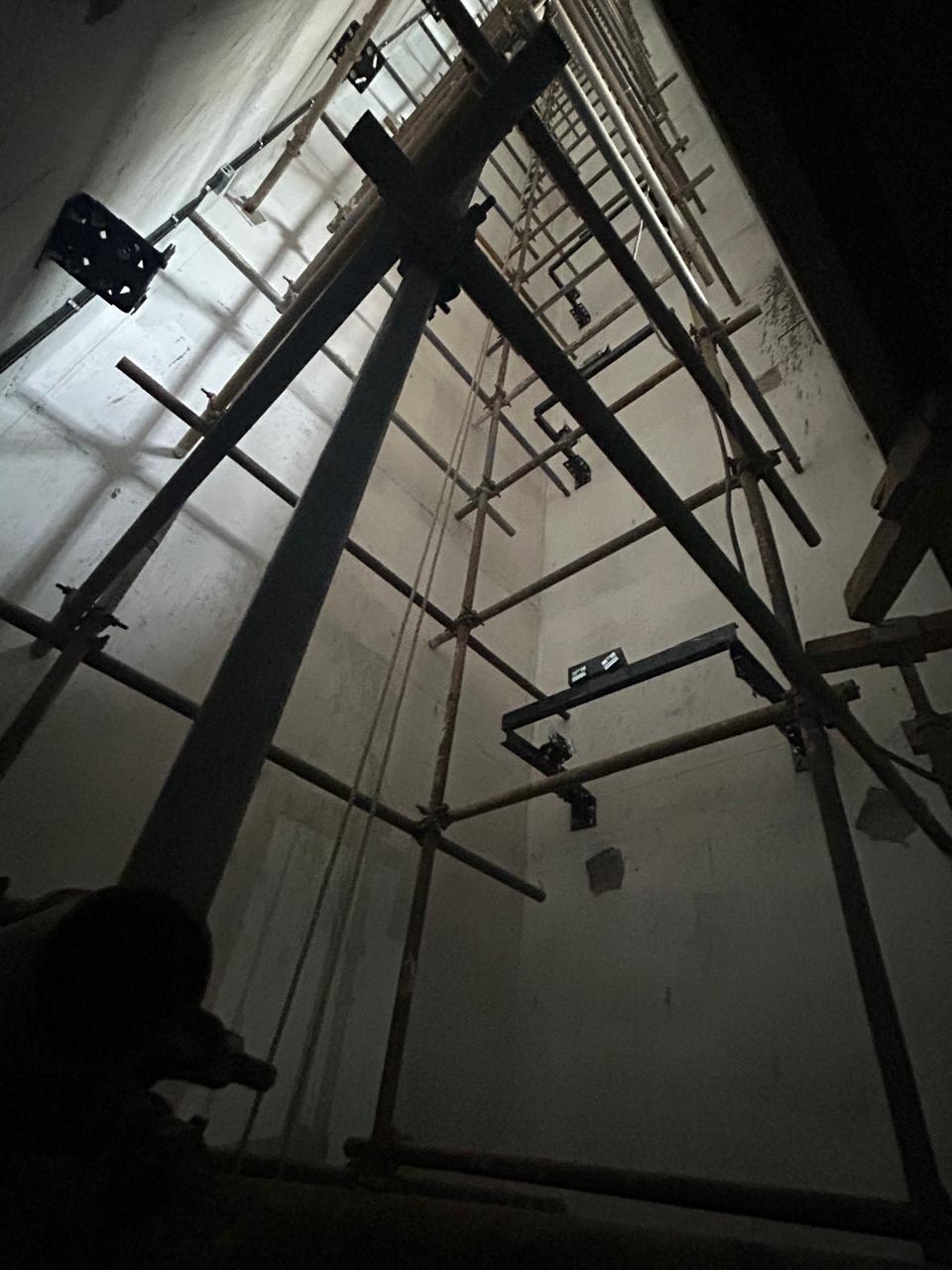

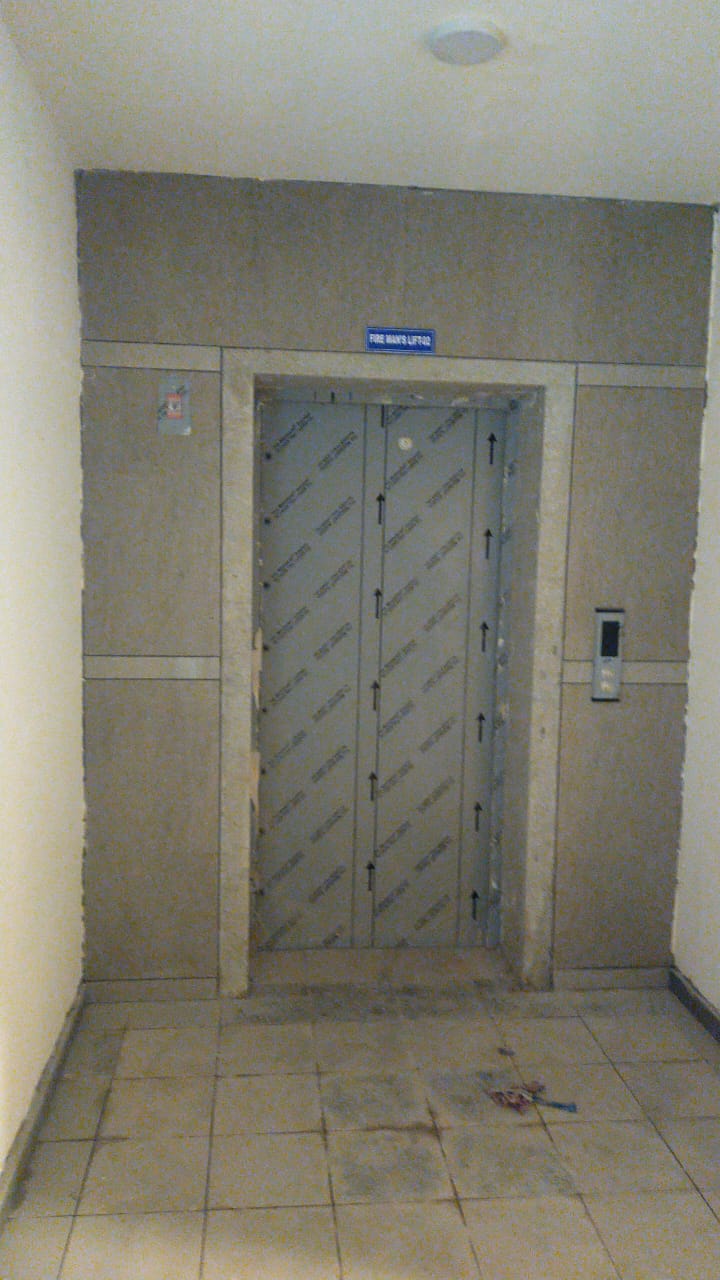

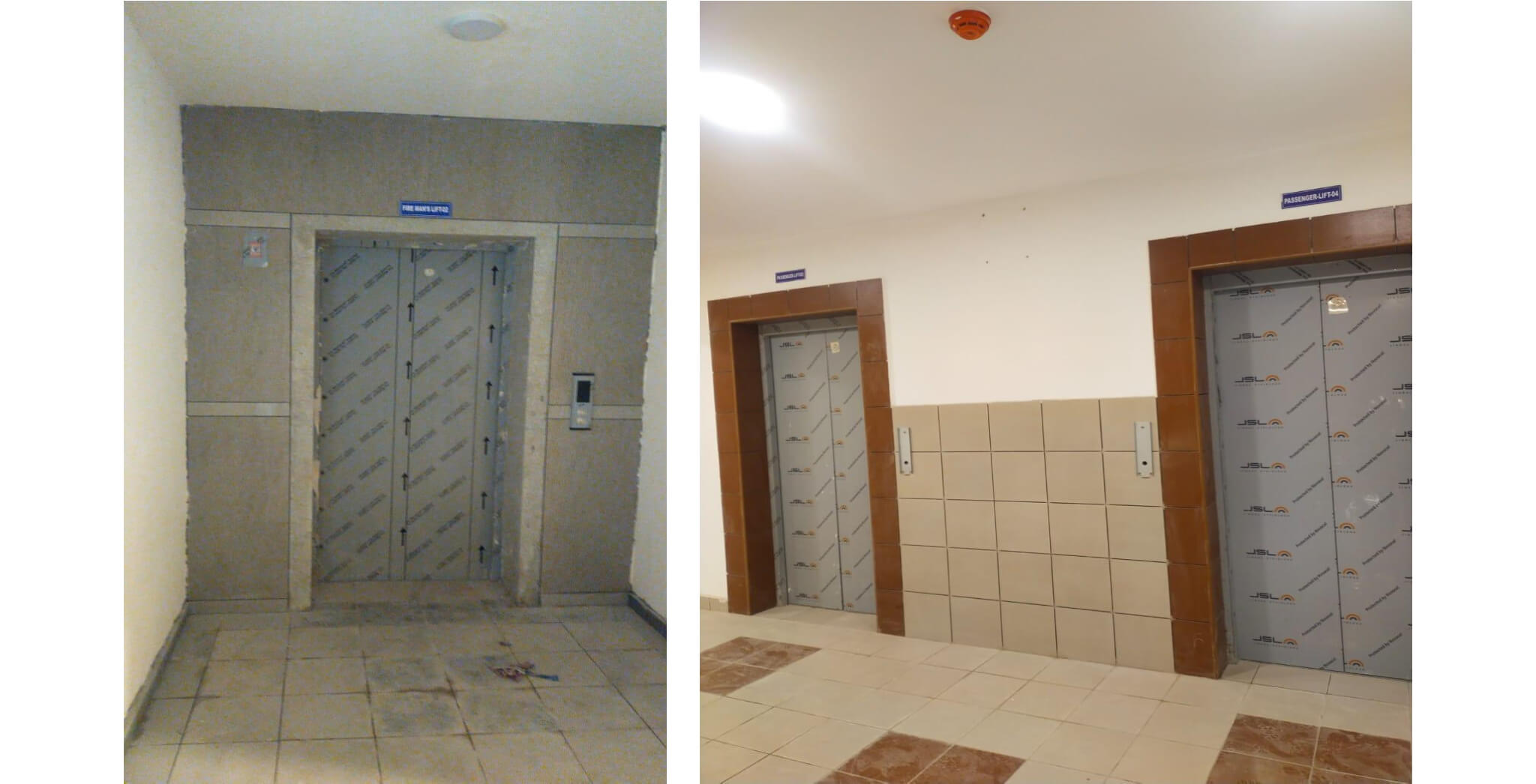

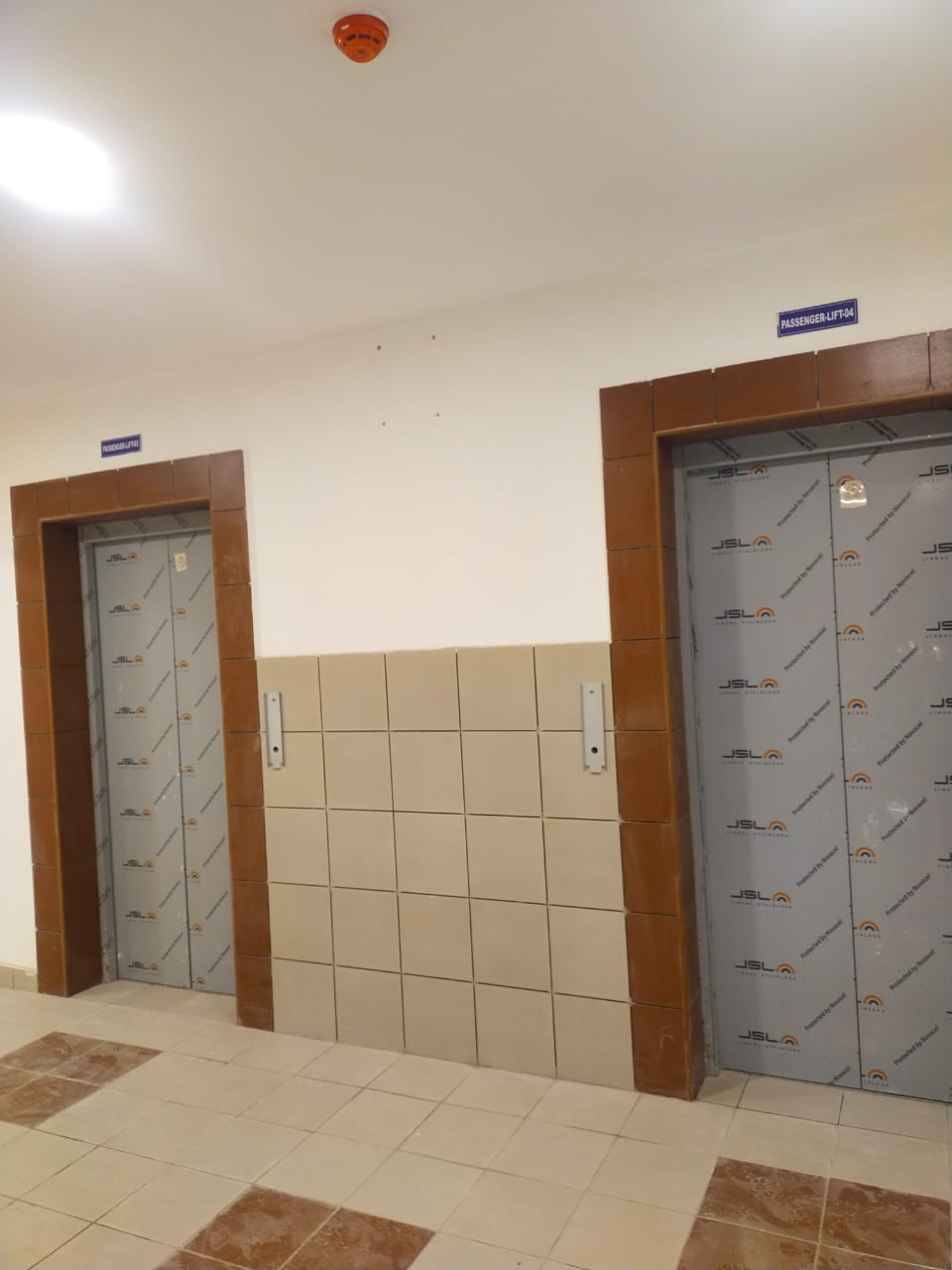

Passenger lift installation work in progress - Jun 2025

Passenger lift installation work in progress - Jun 2025

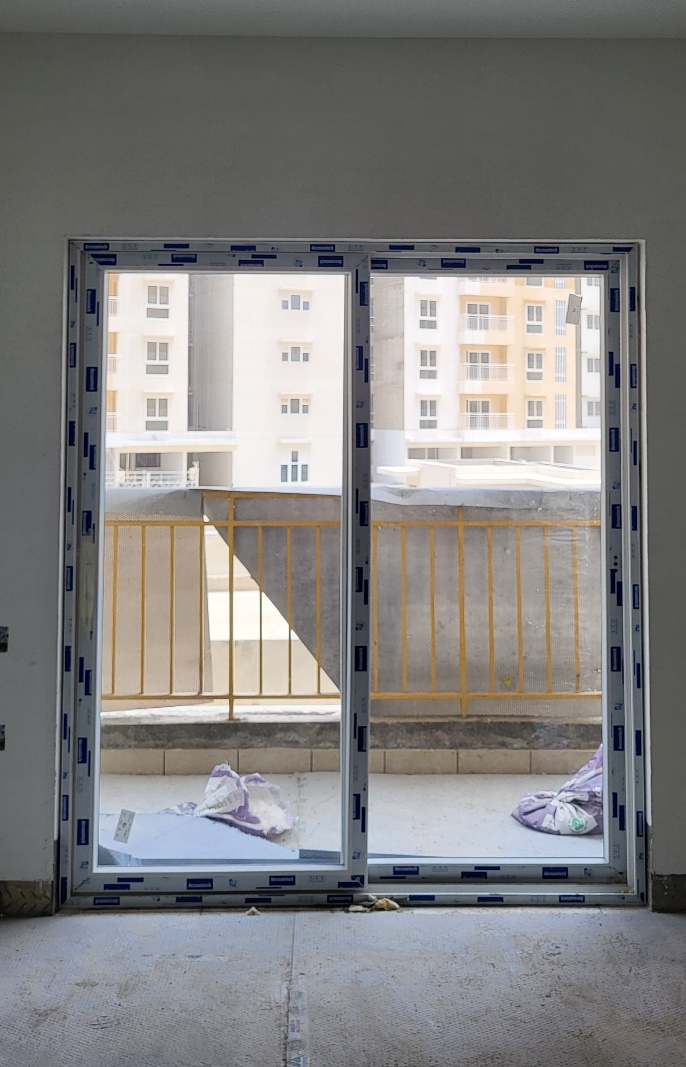

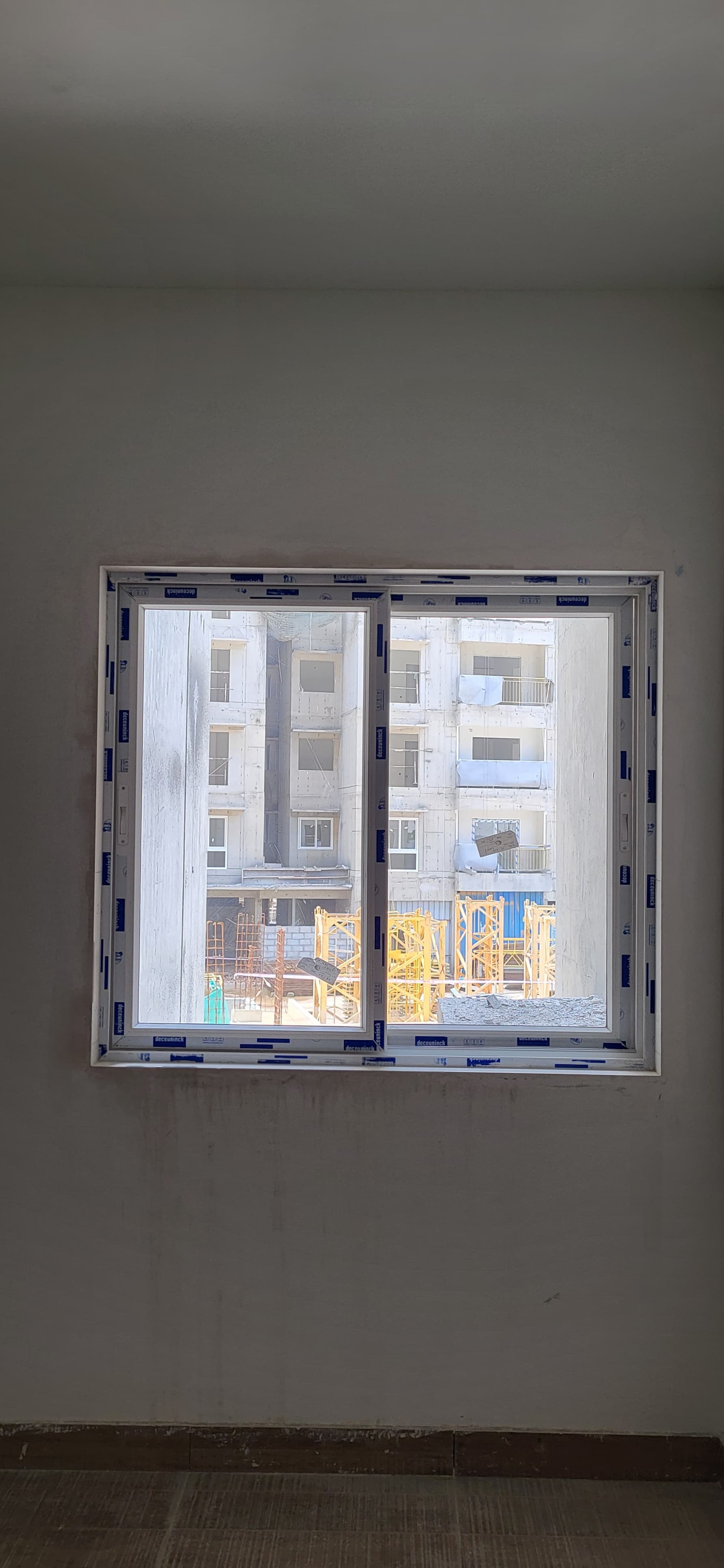

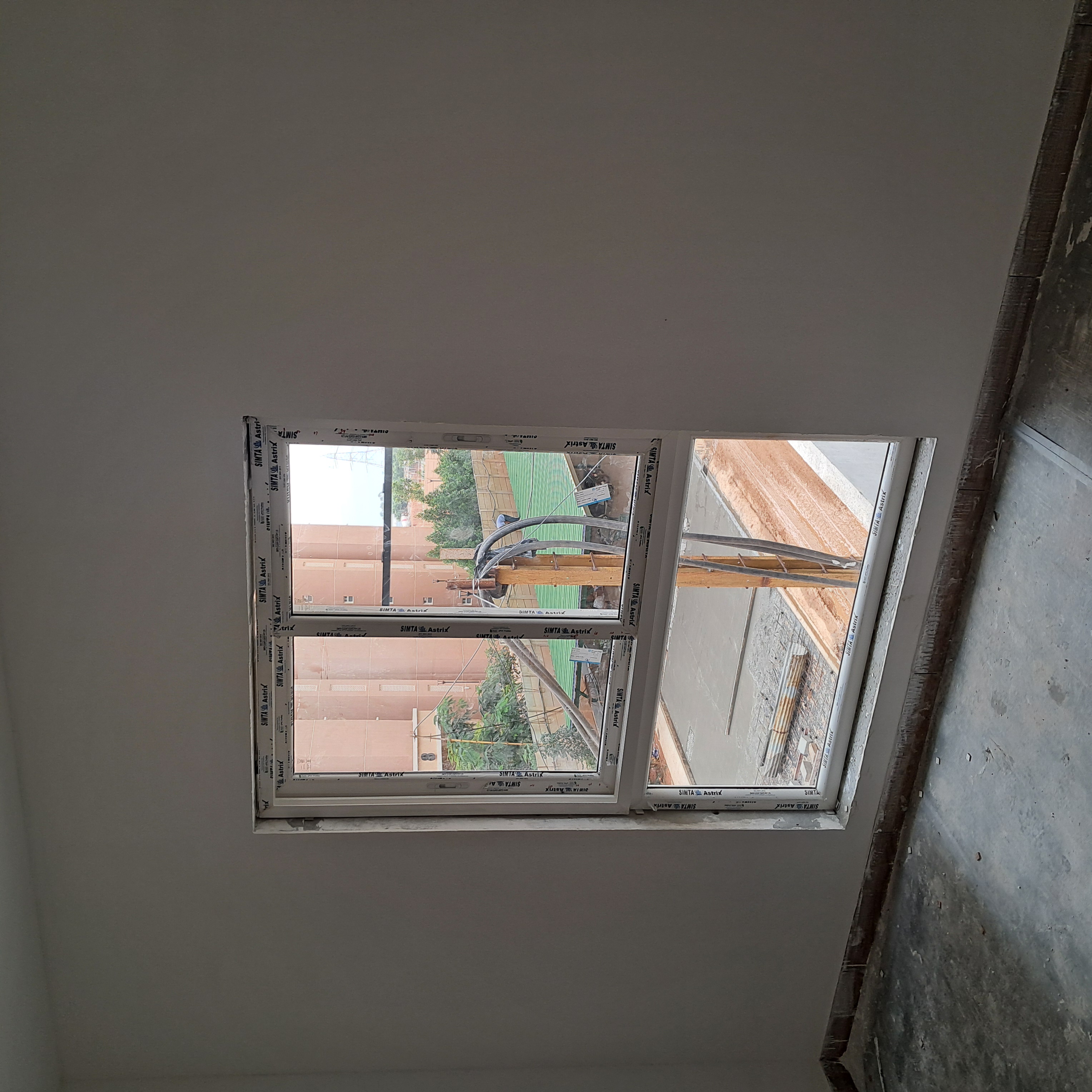

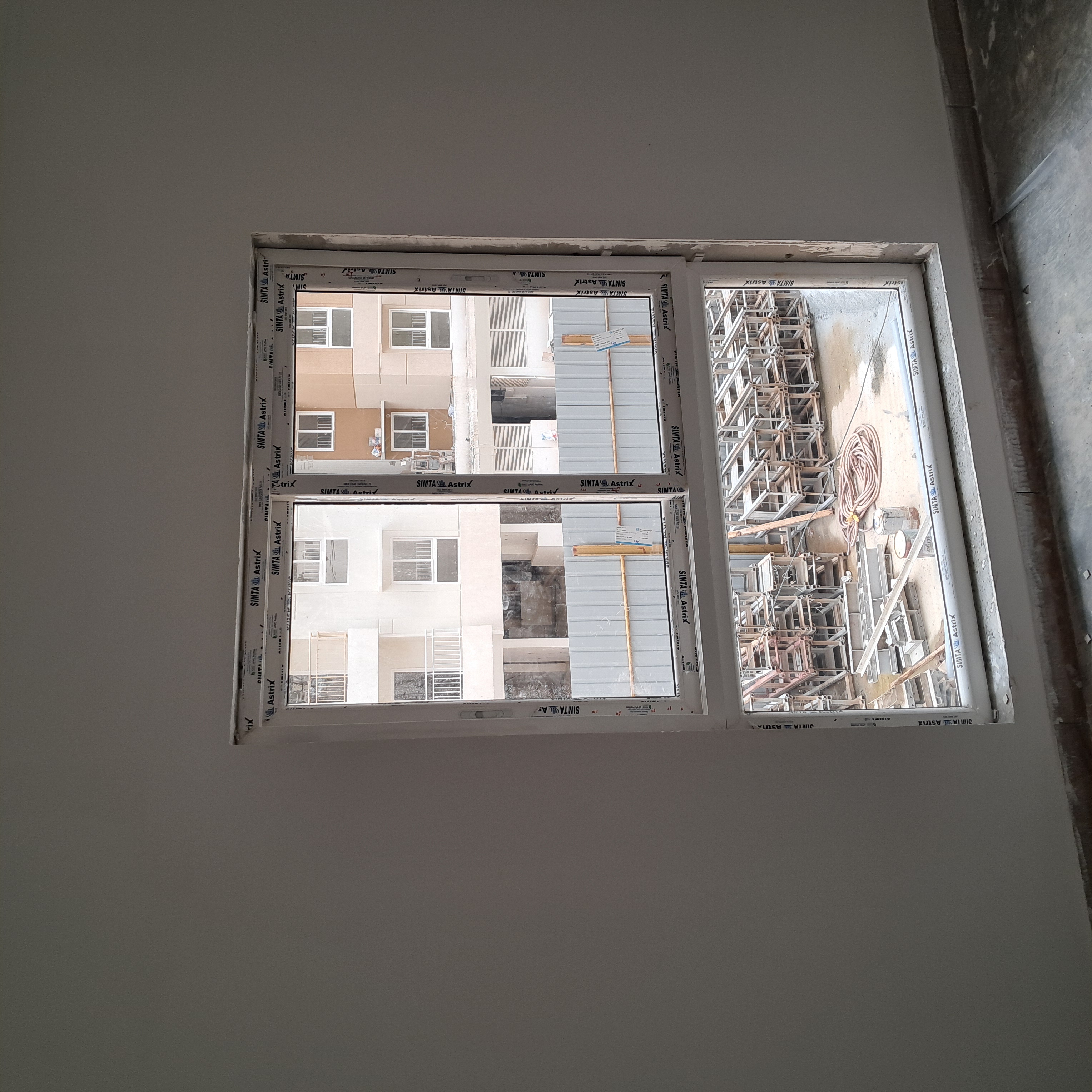

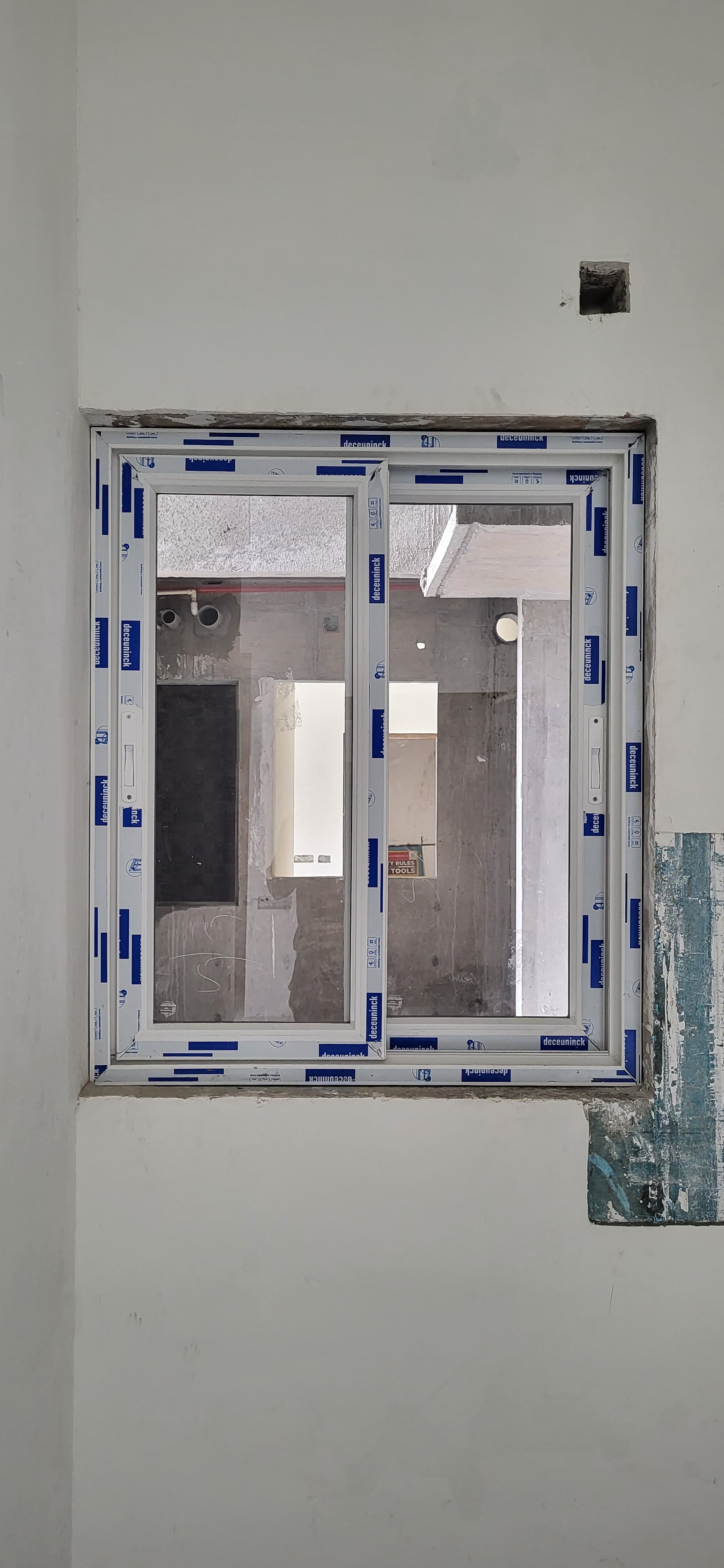

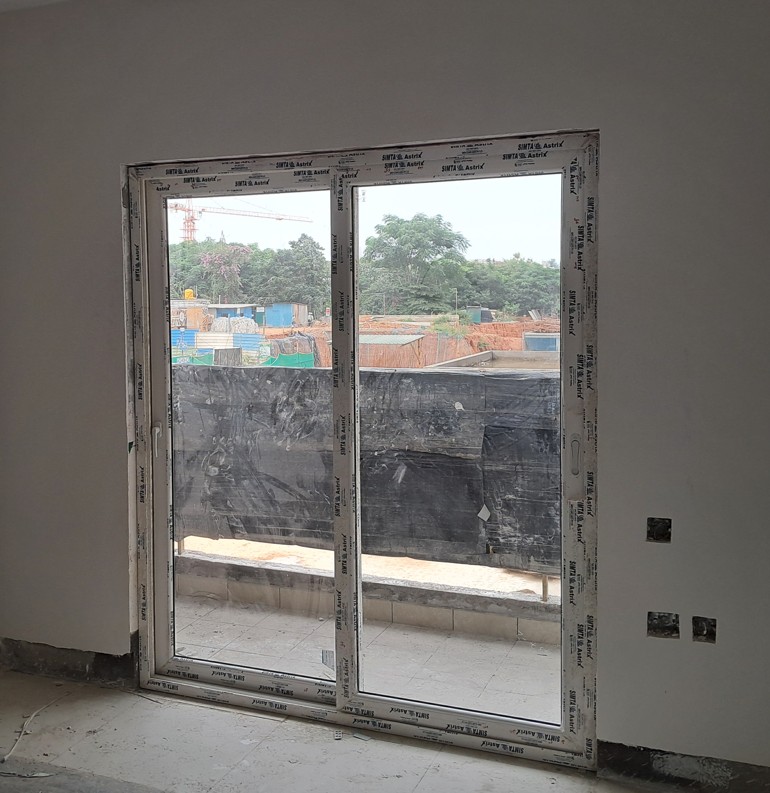

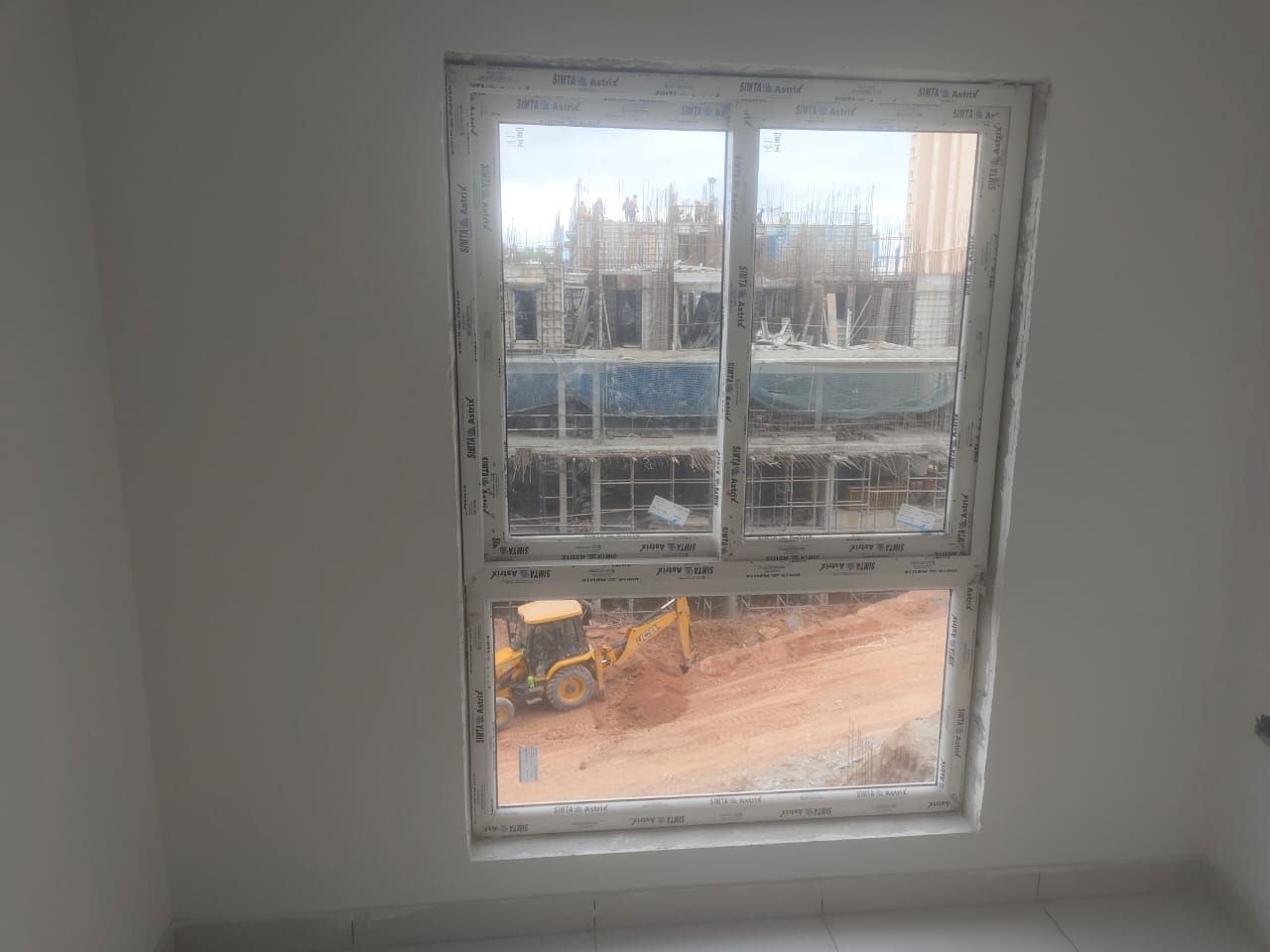

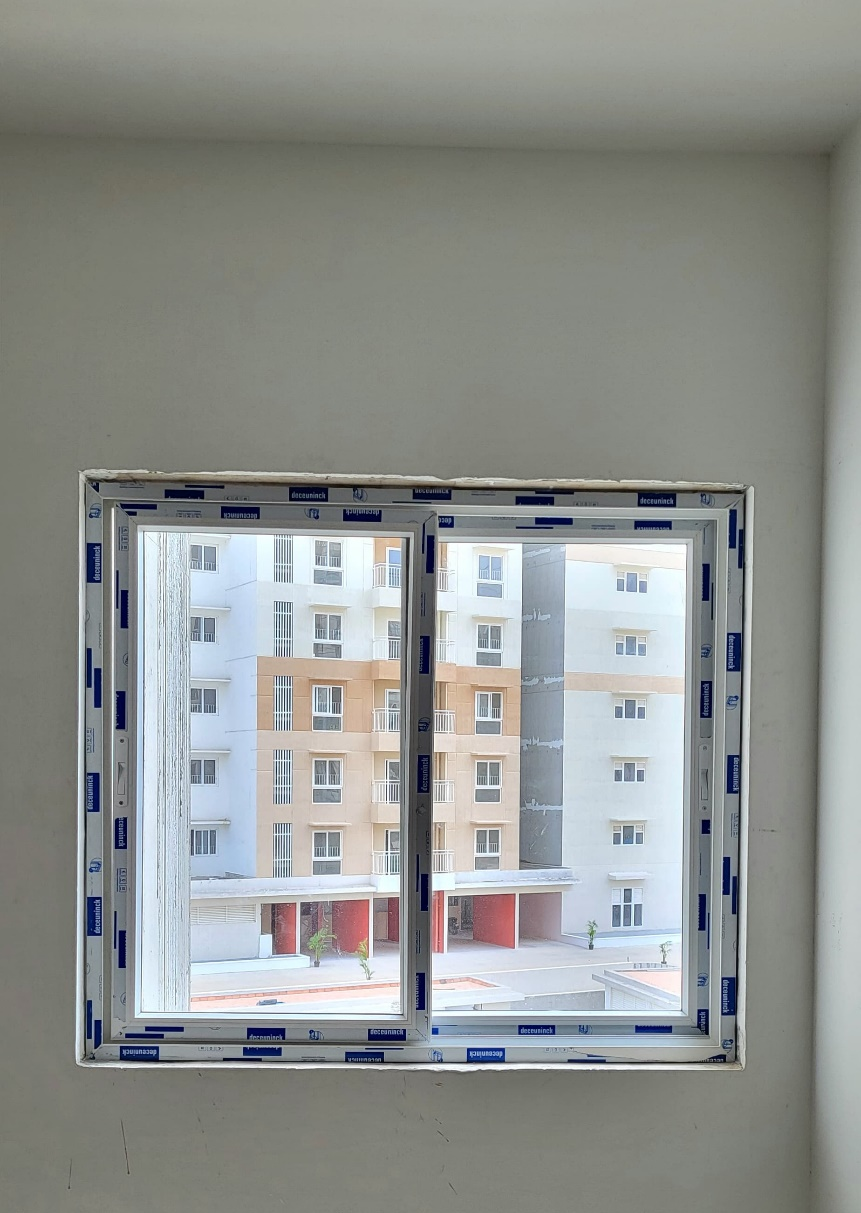

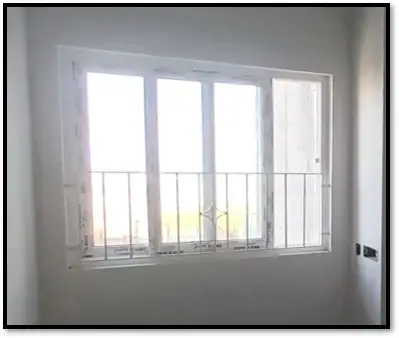

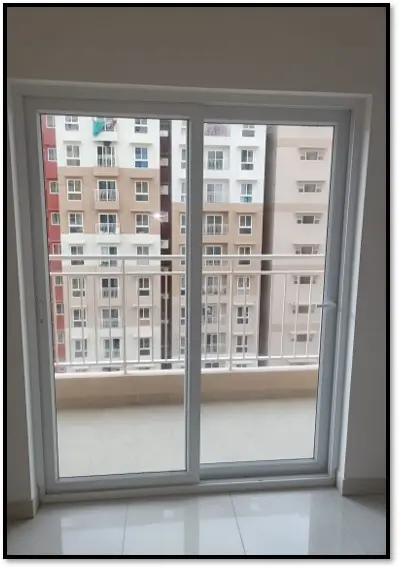

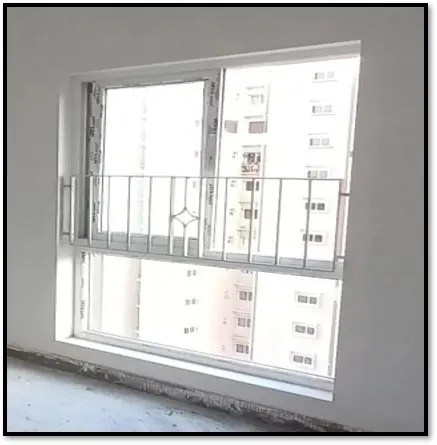

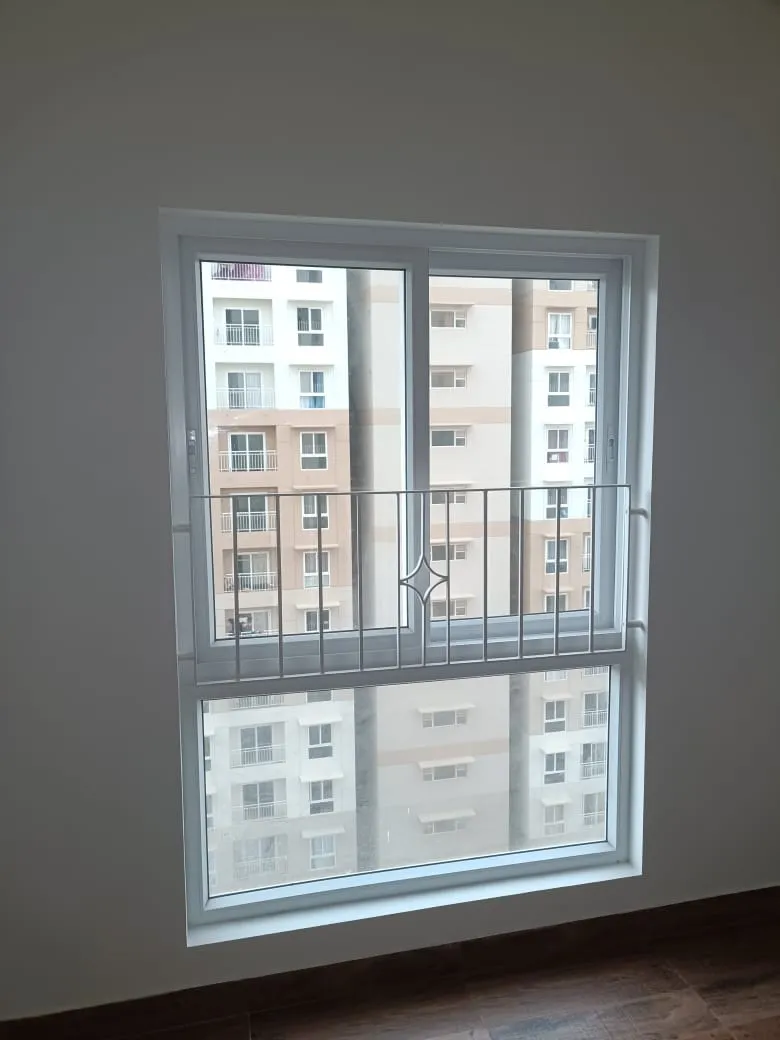

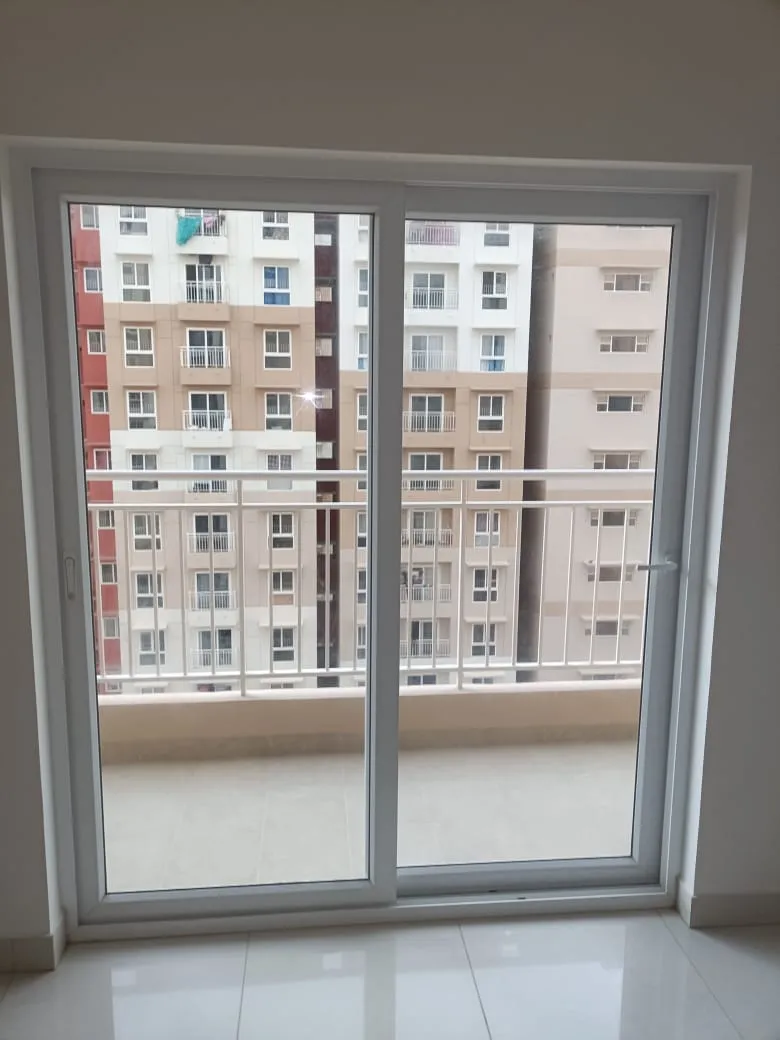

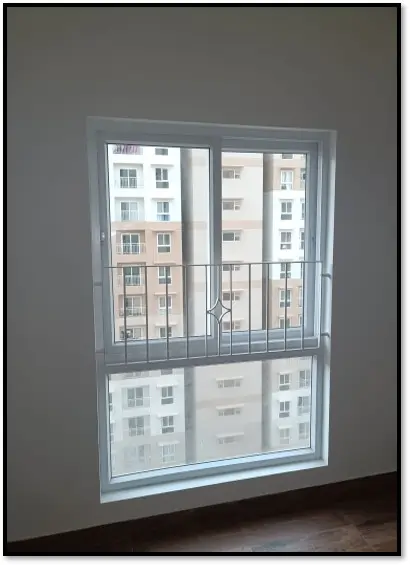

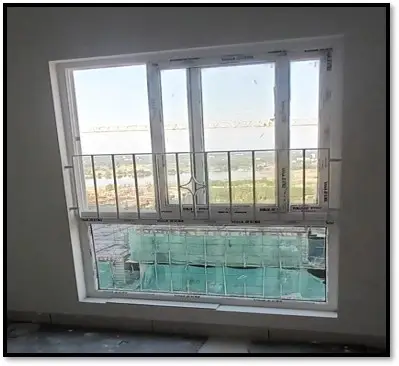

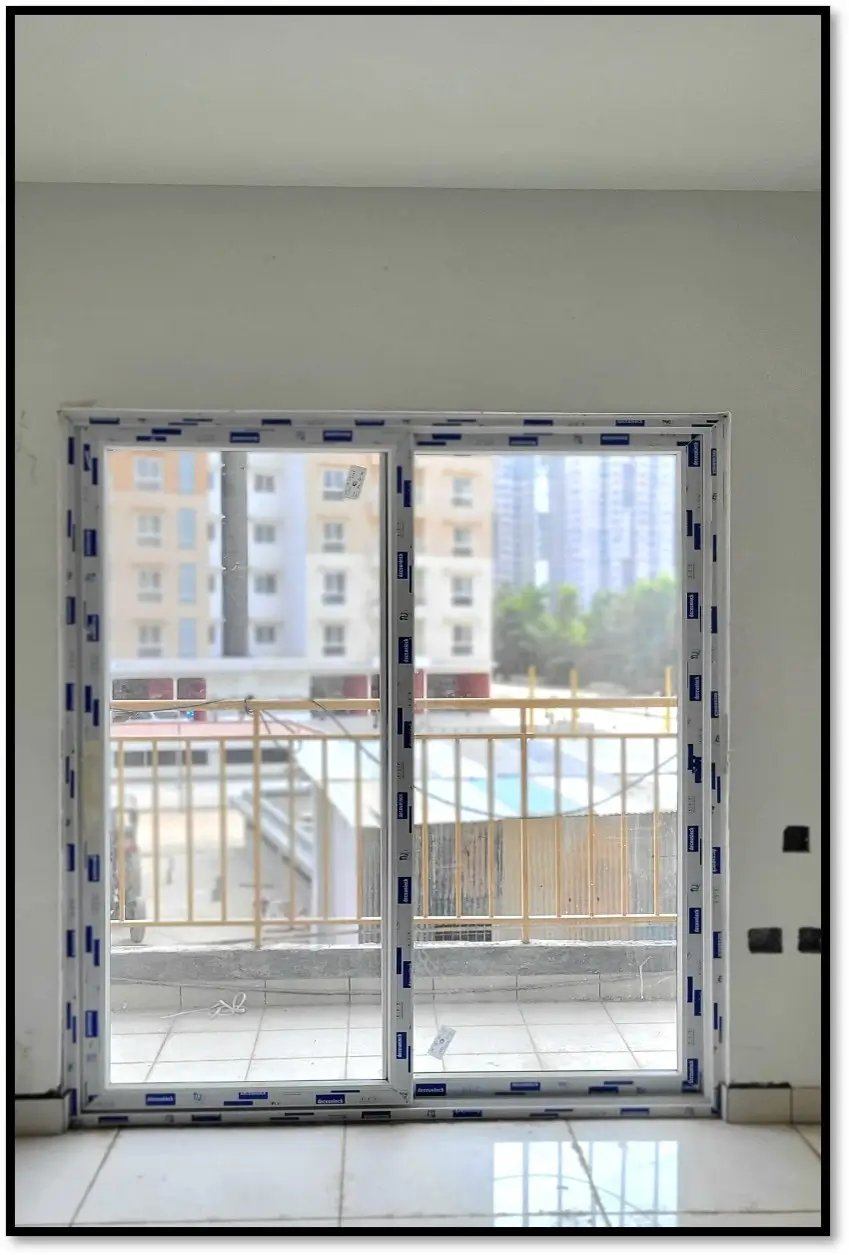

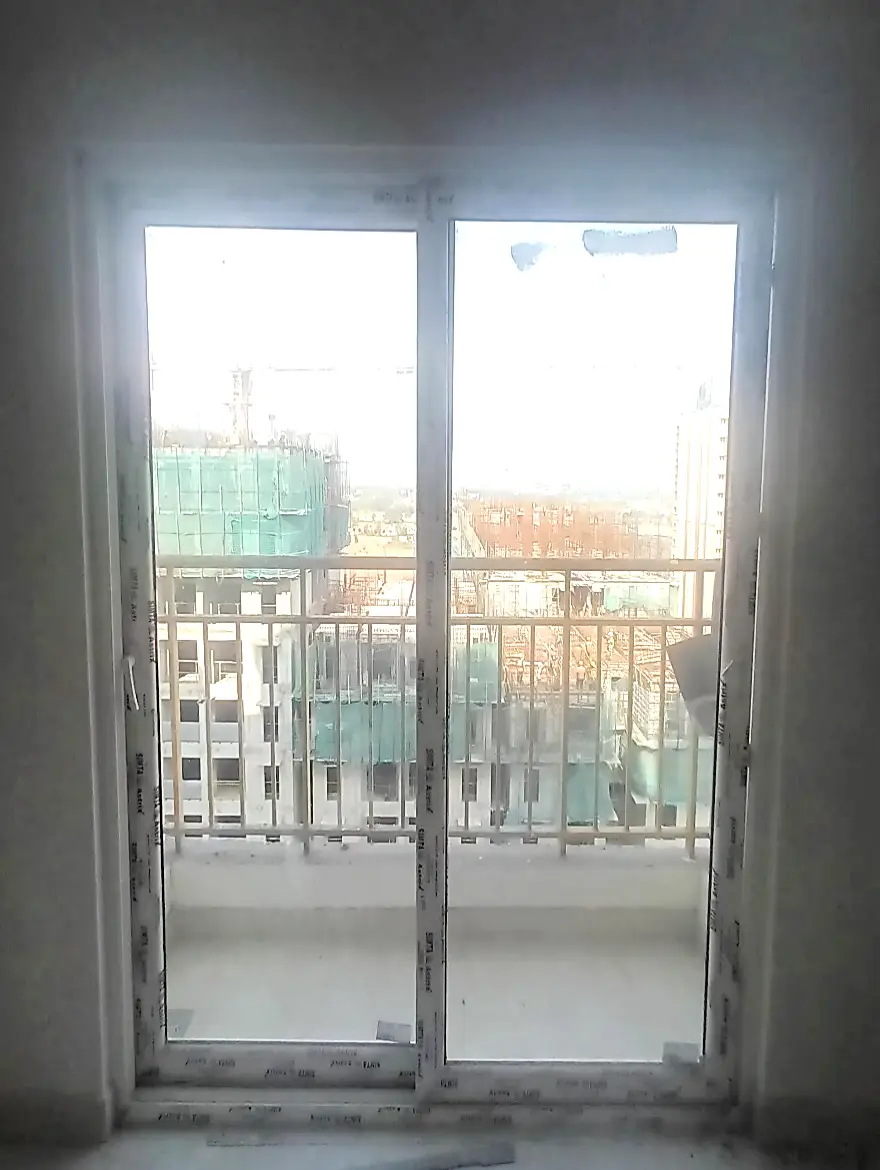

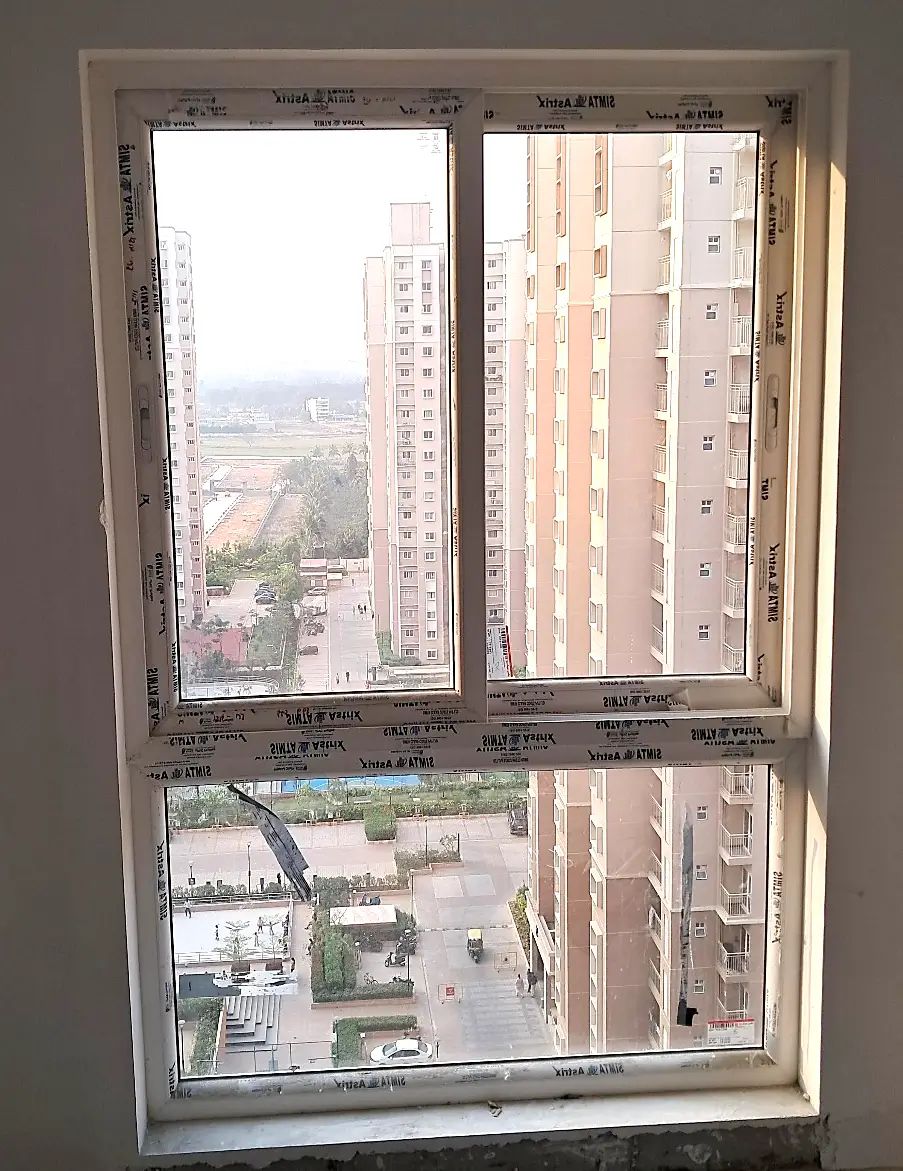

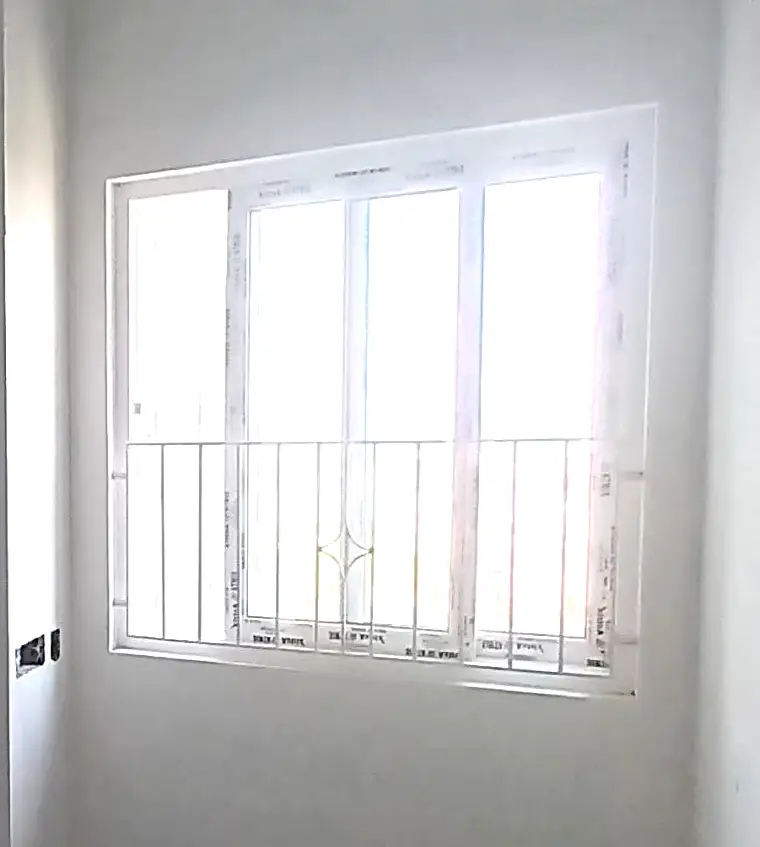

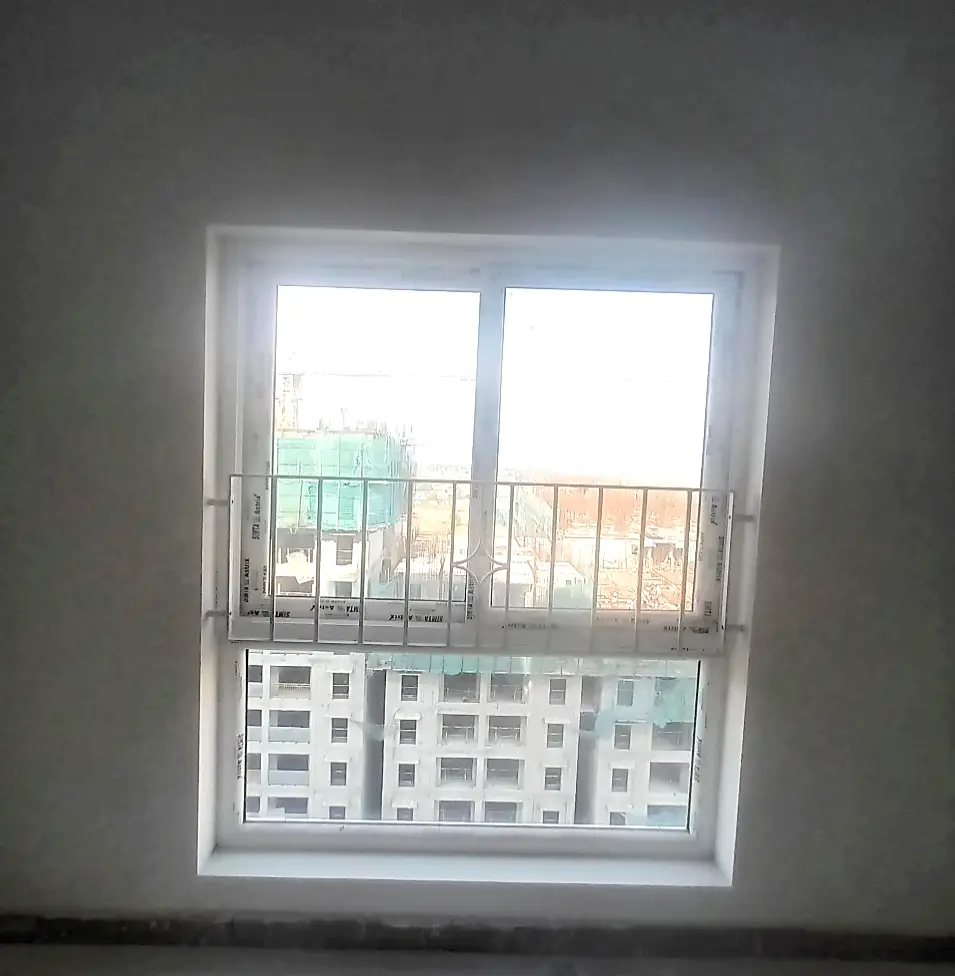

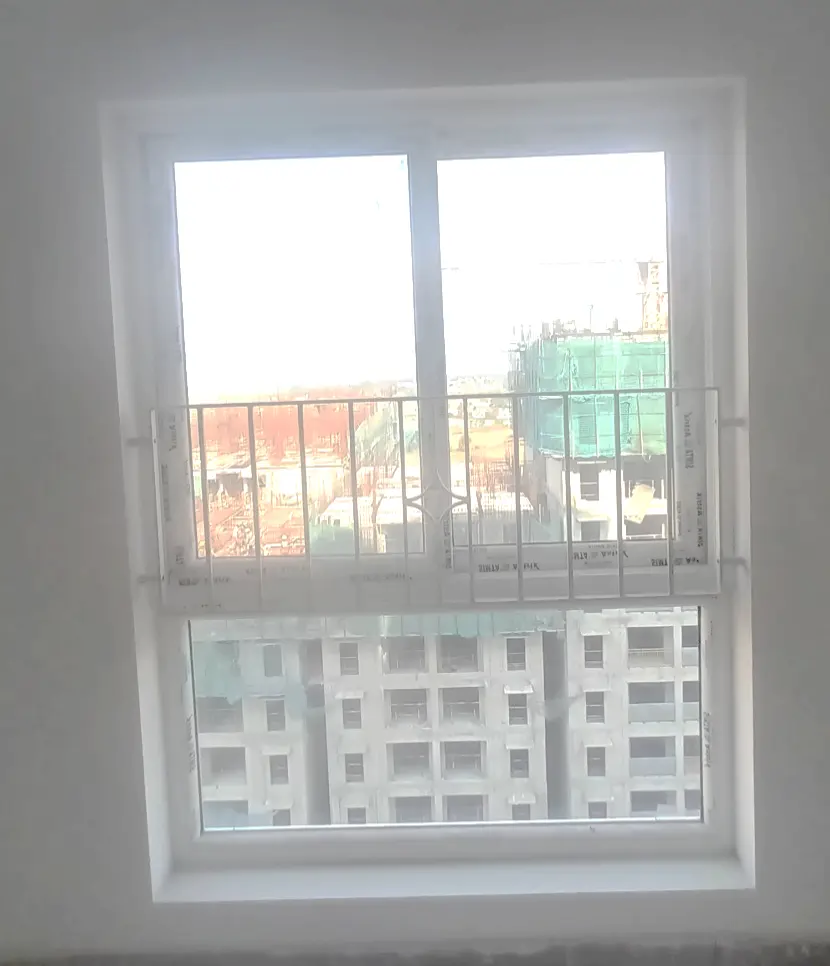

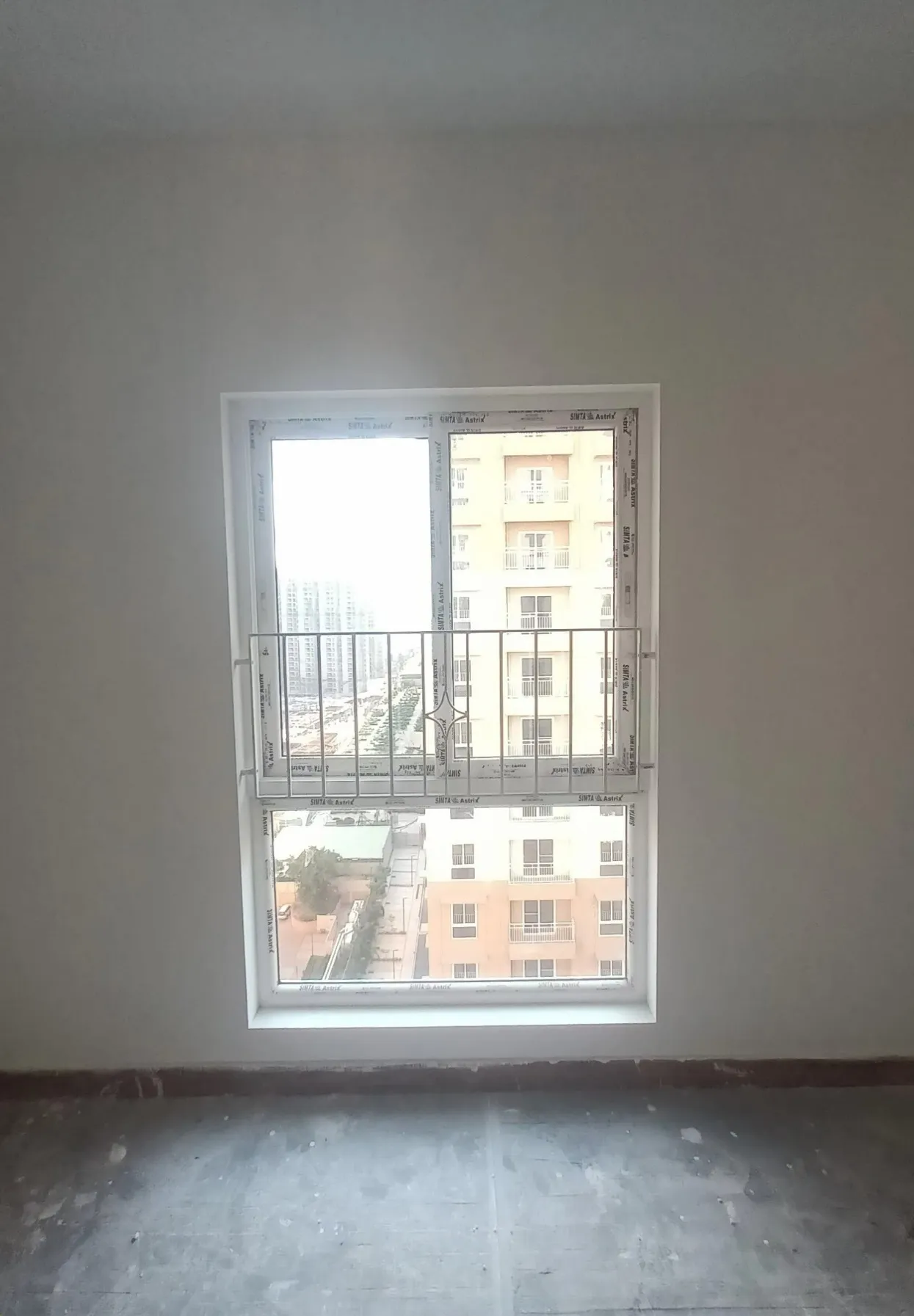

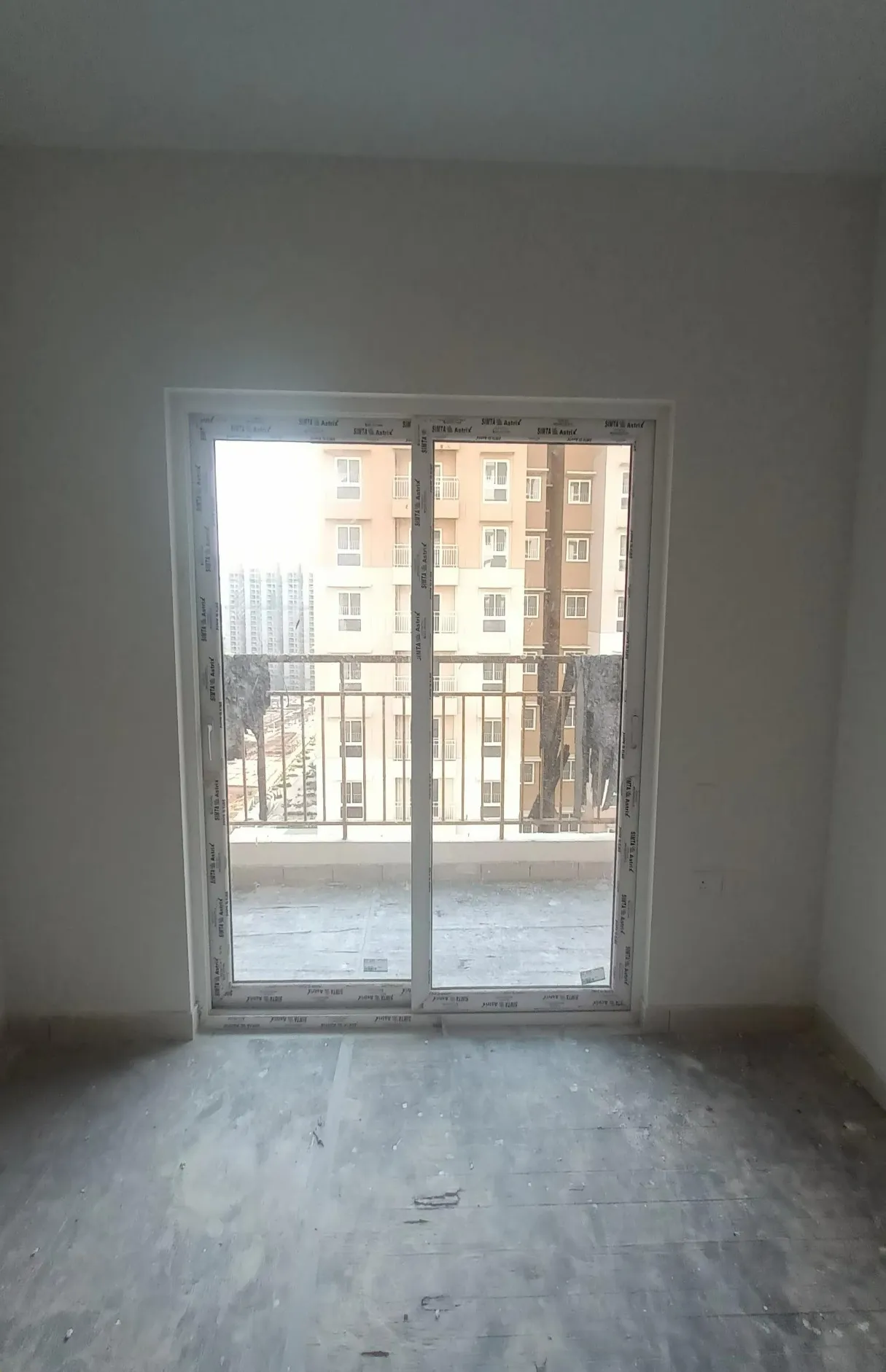

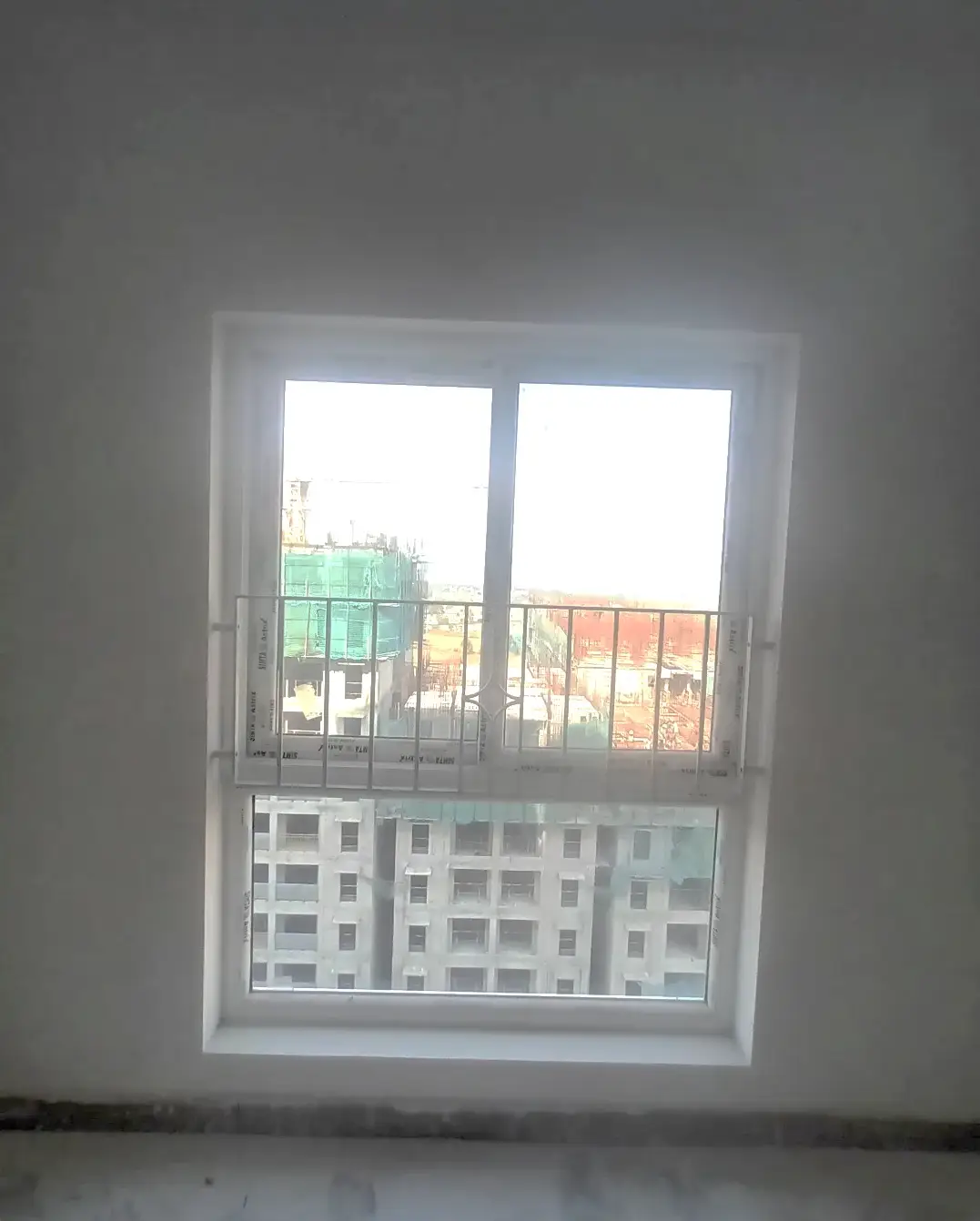

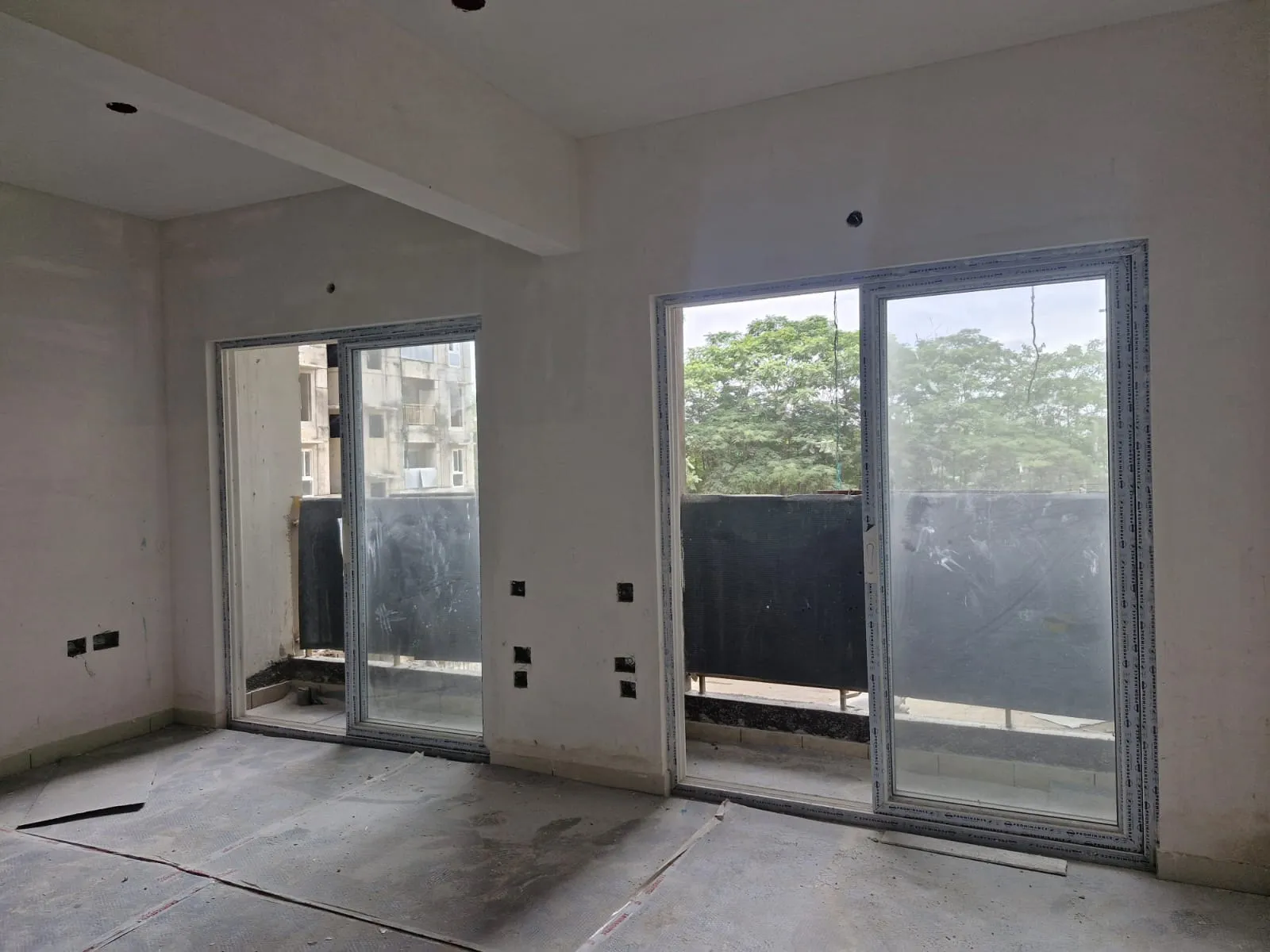

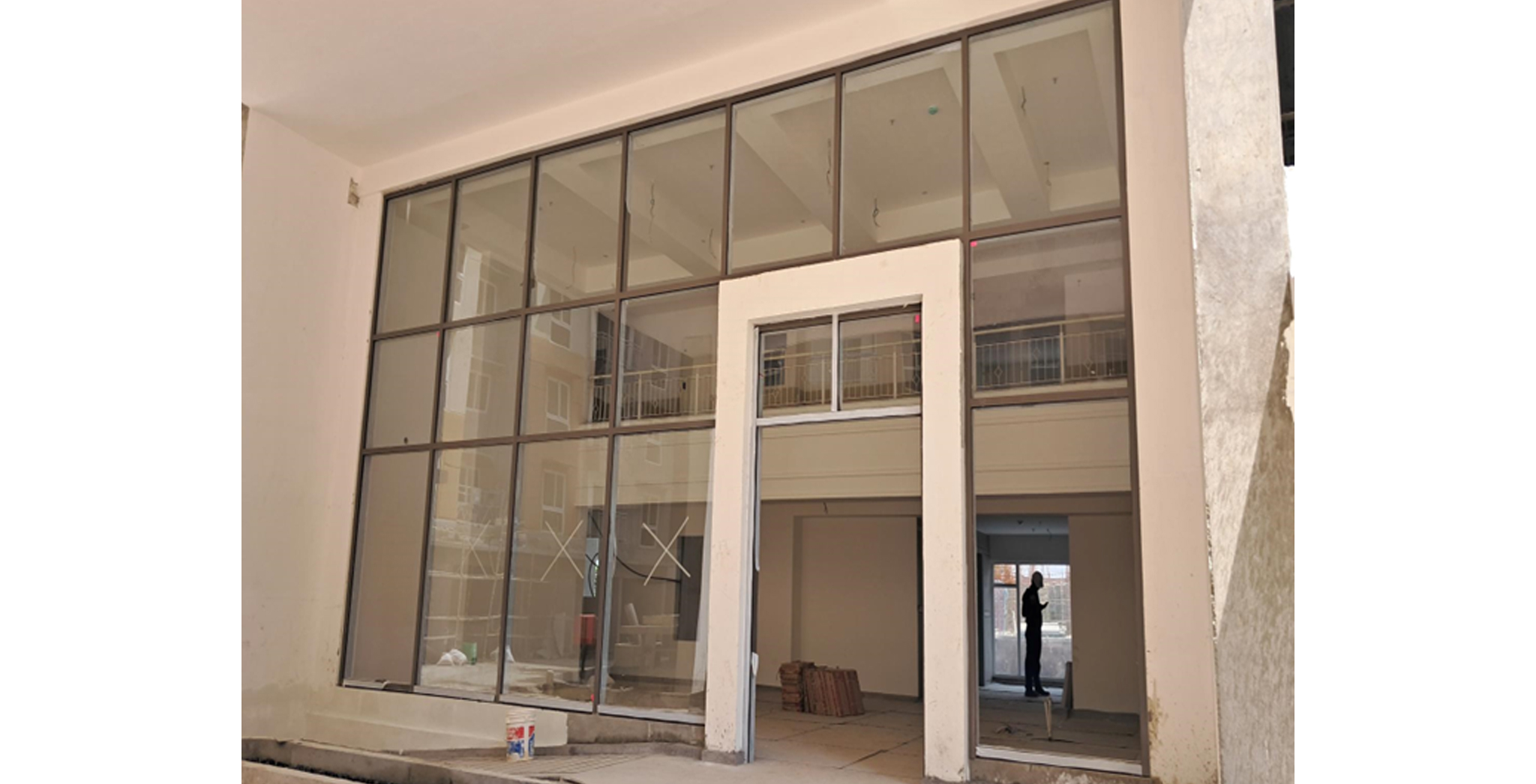

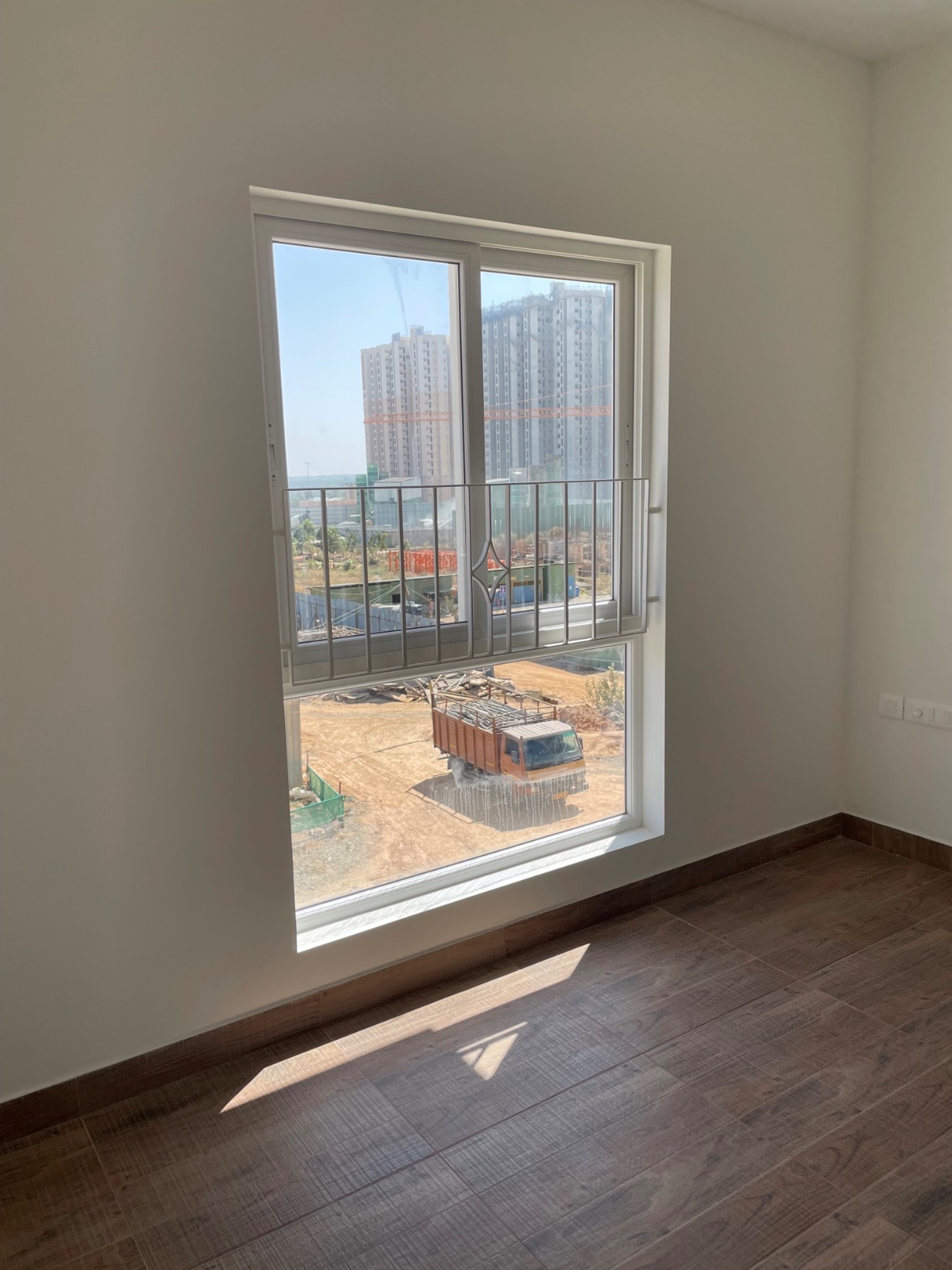

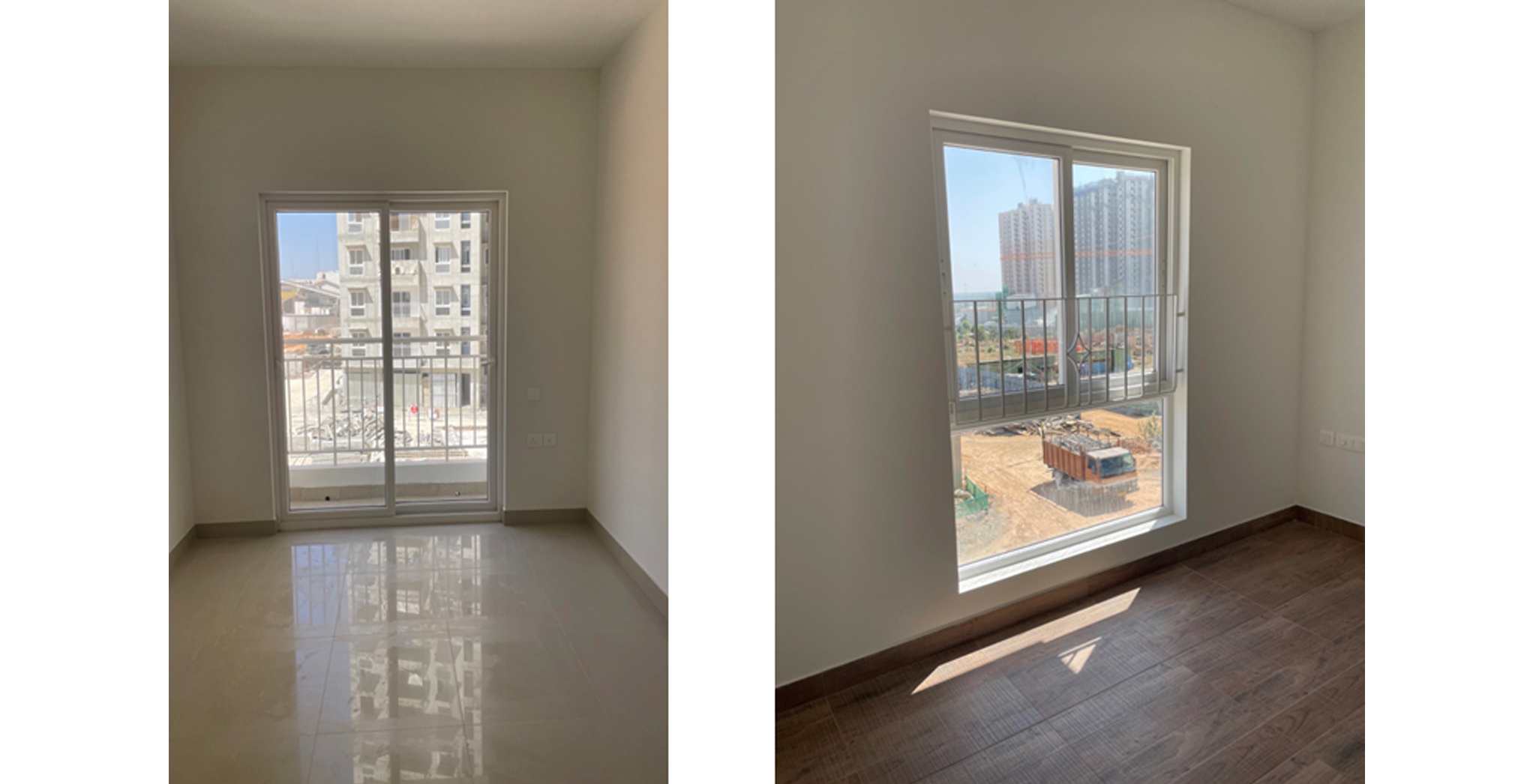

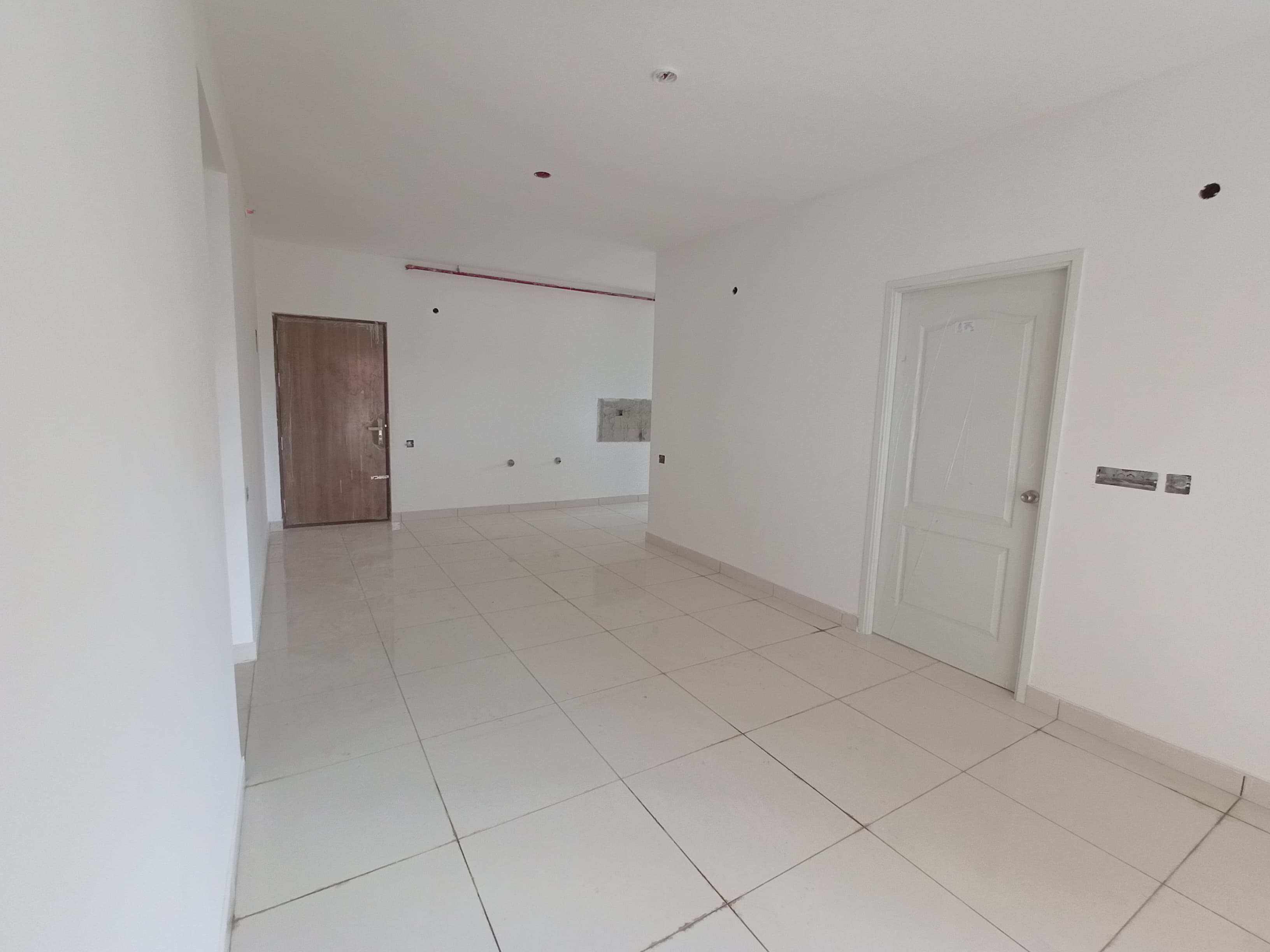

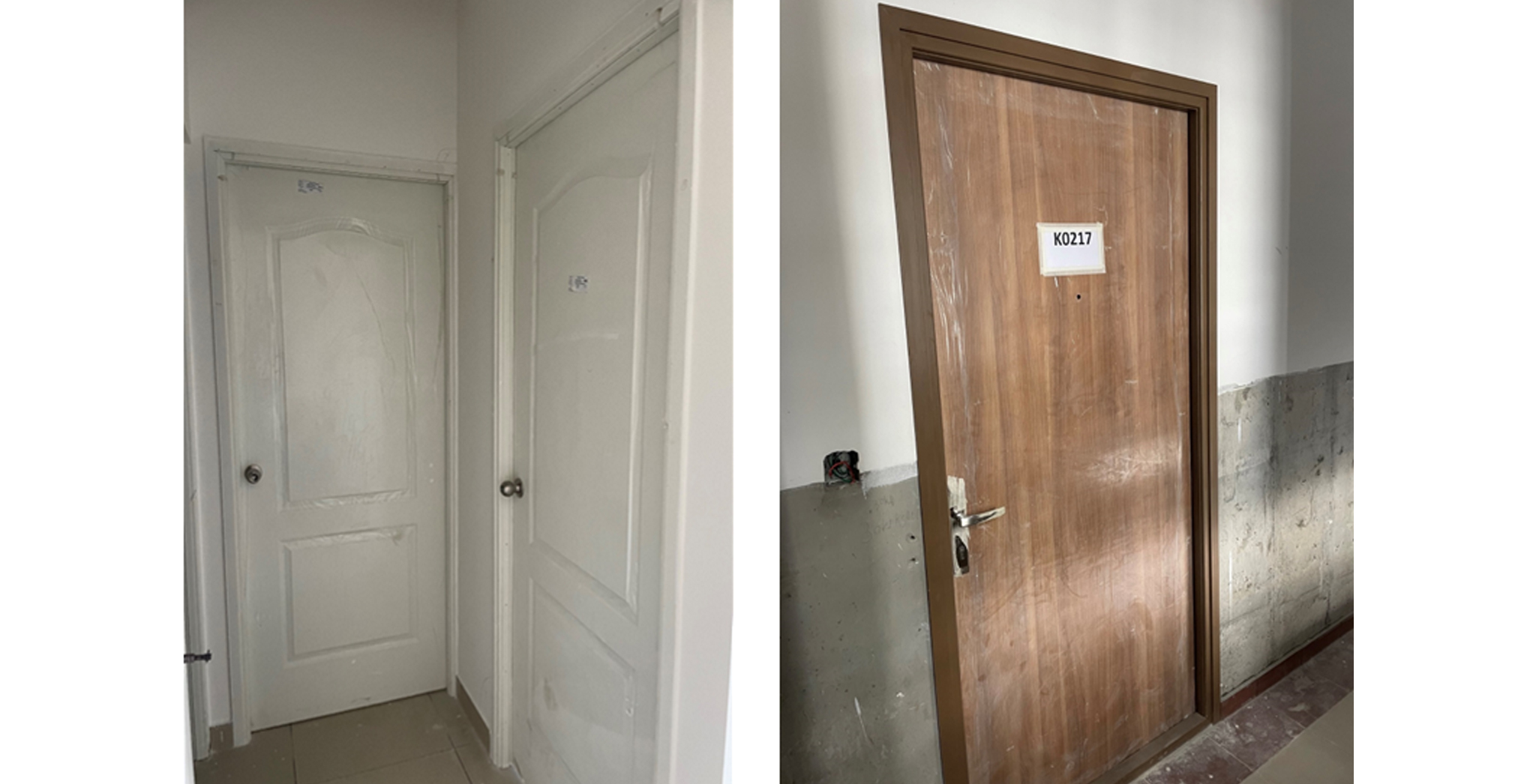

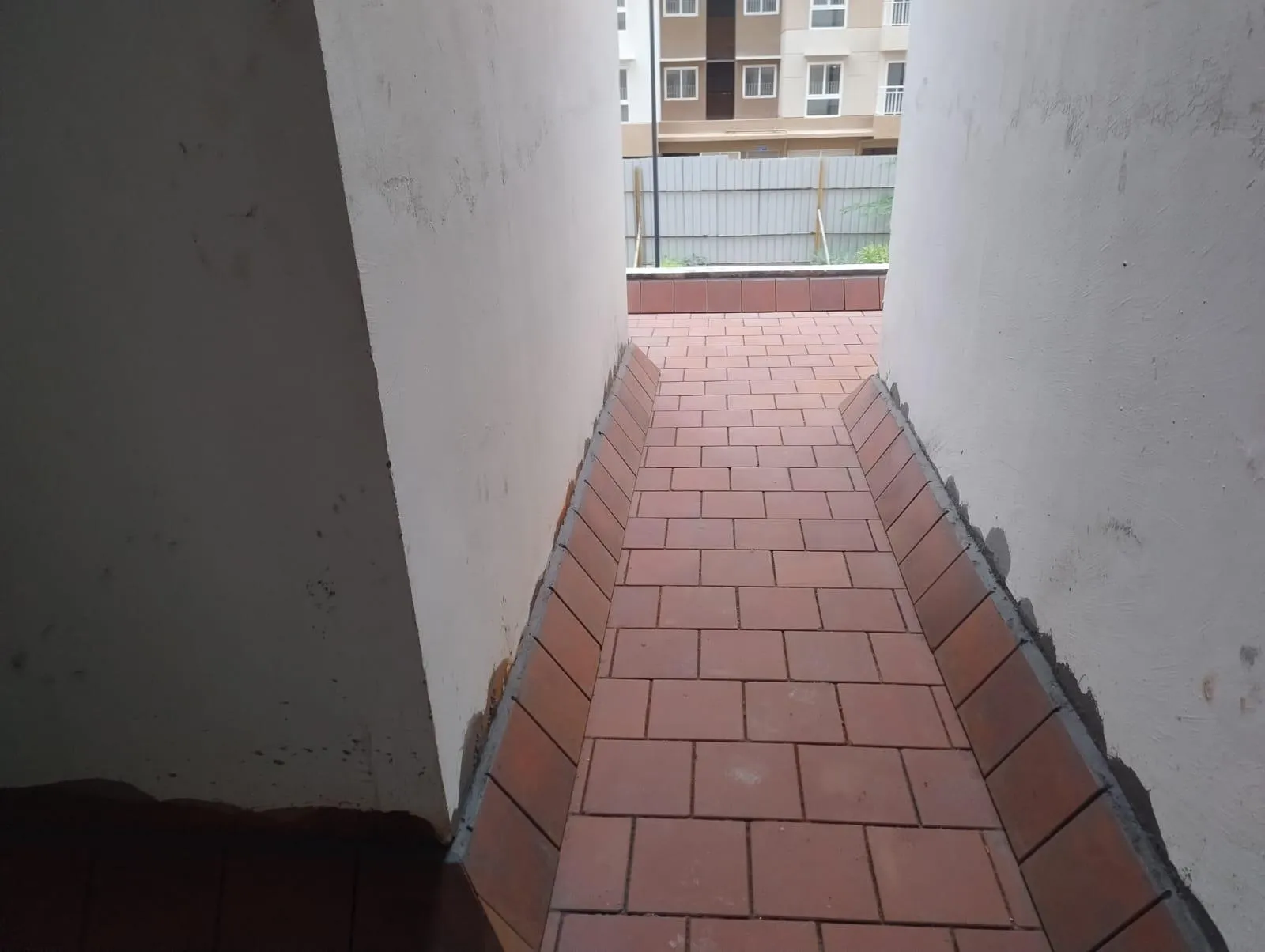

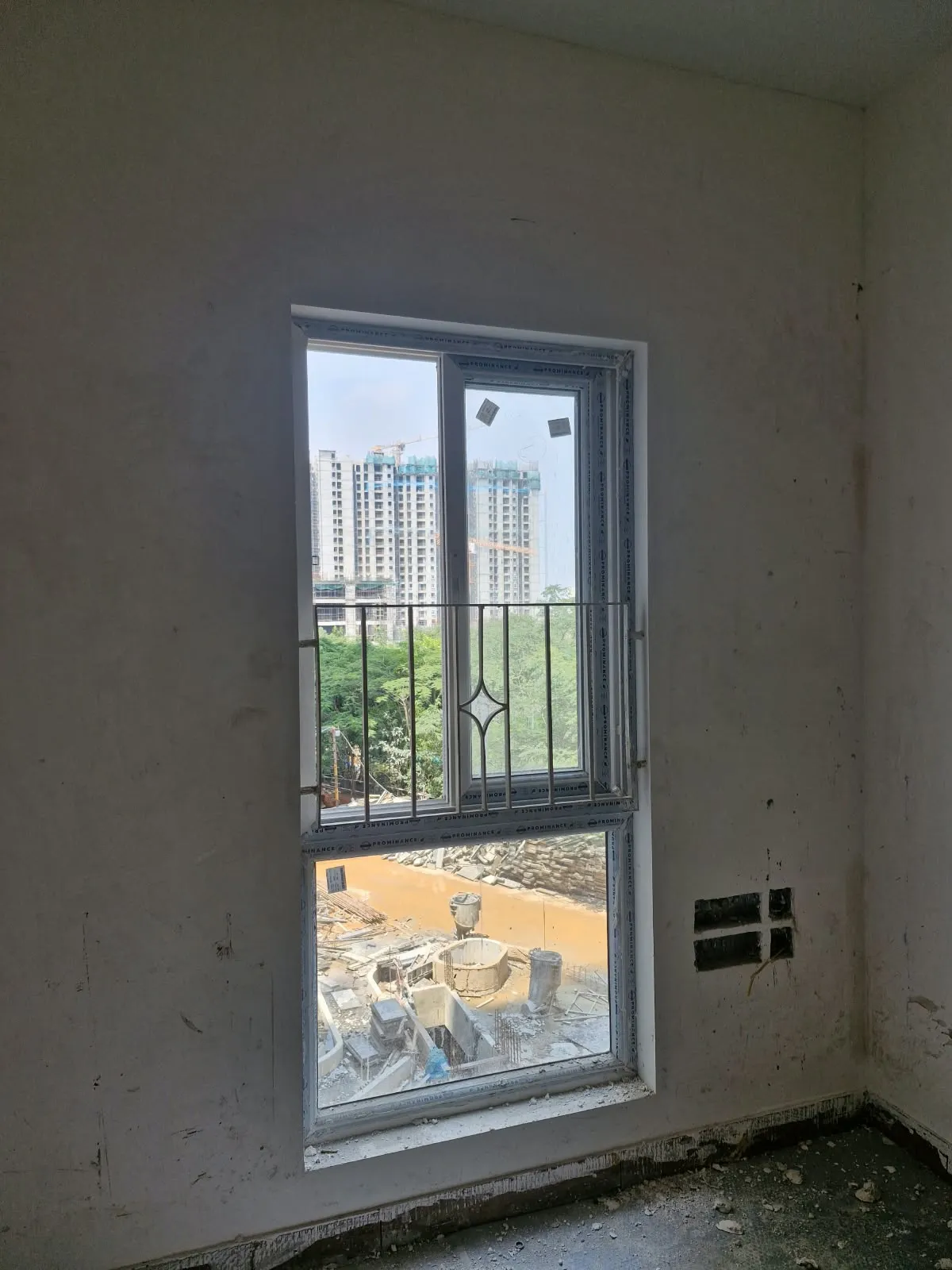

UPVC windows, doors installation work in progress- 1st floor - Jun 2025

UPVC windows, doors installation work in progress- 1st floor - Jun 2025

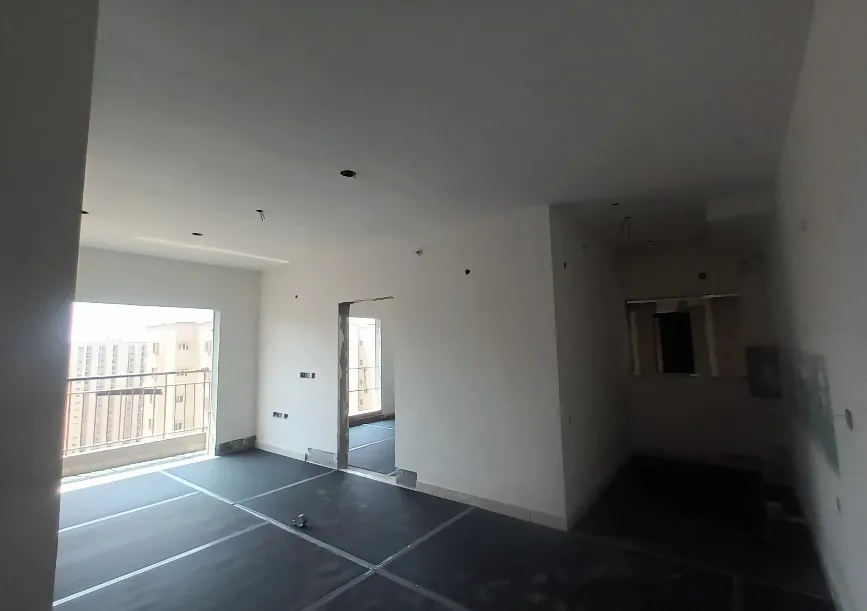

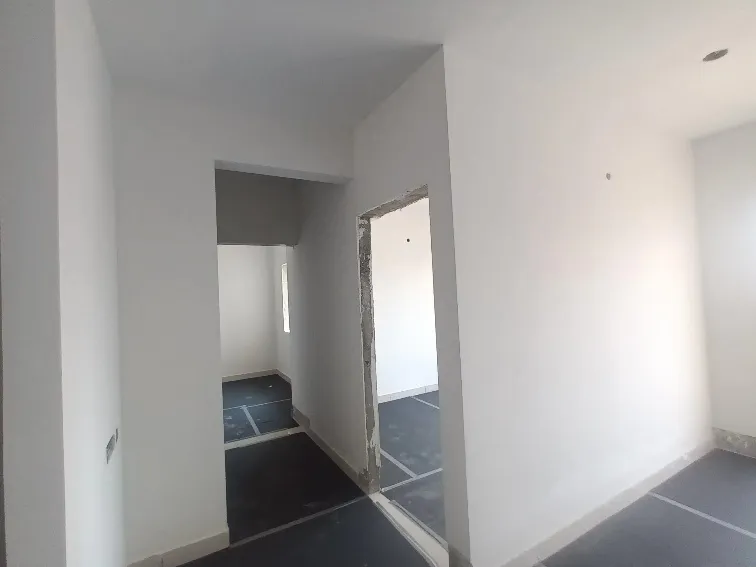

Painting works Wing A: 10th floor work in progress Wing B: 10th floor work in progress Wing C: 10th floor work in progress - Jun 2025

Tiling works Wing A: 9th floor work in progress Wing B: 9th floor work in progress Wing C: 9th floor work in progress - Jun 2025

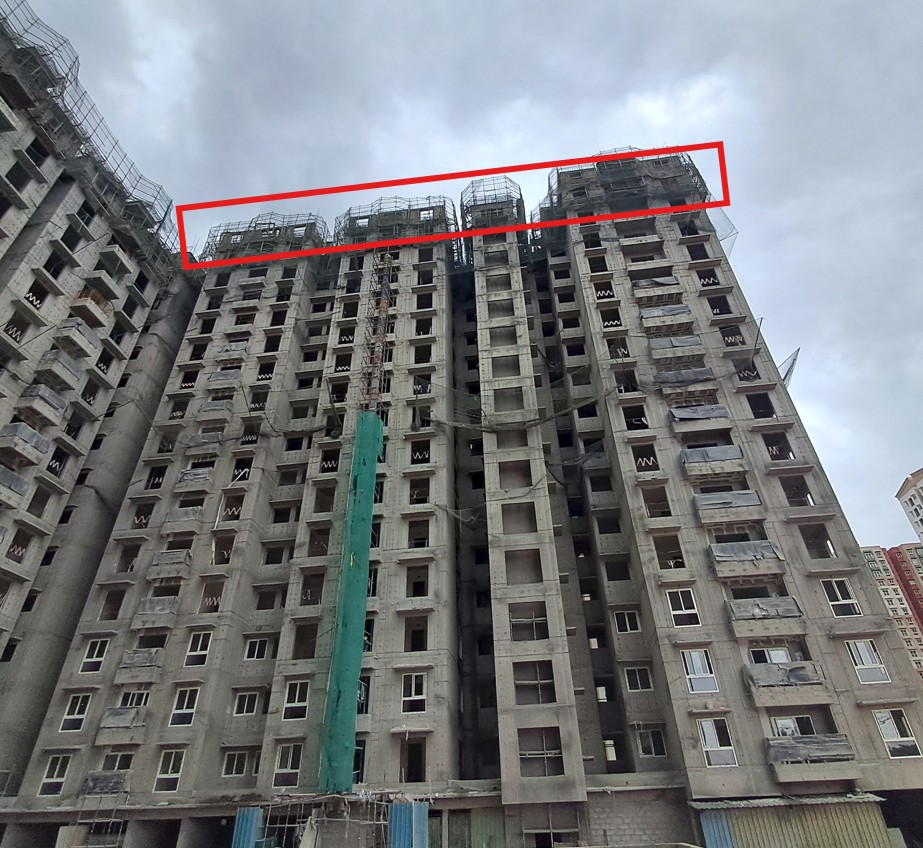

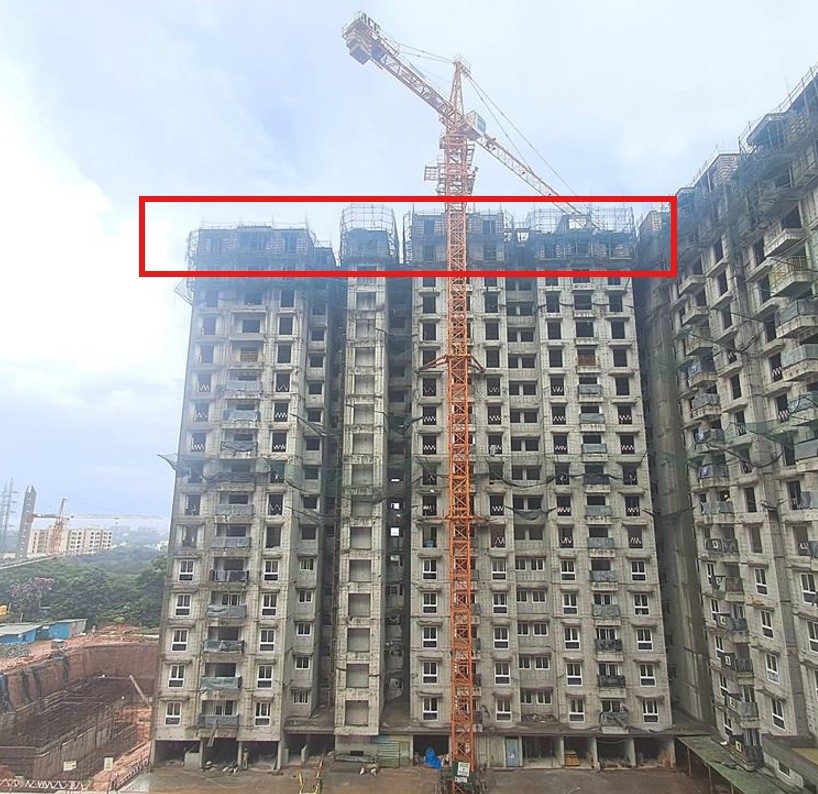

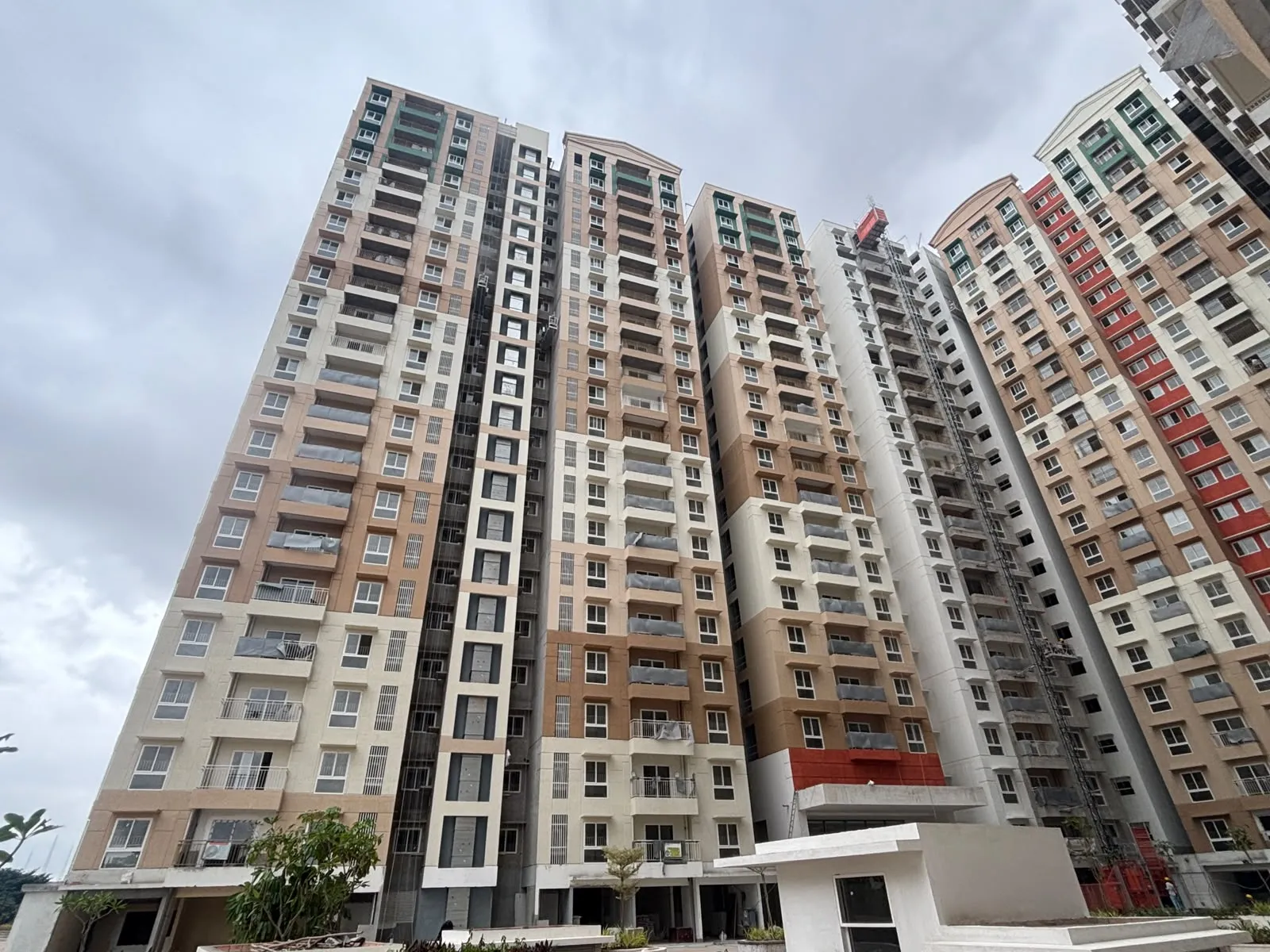

AURUM – Wing A – Milestone Release “On Commencement of Window fixing-1st to 6th Floor” – Status as on 28th - Jun 2025

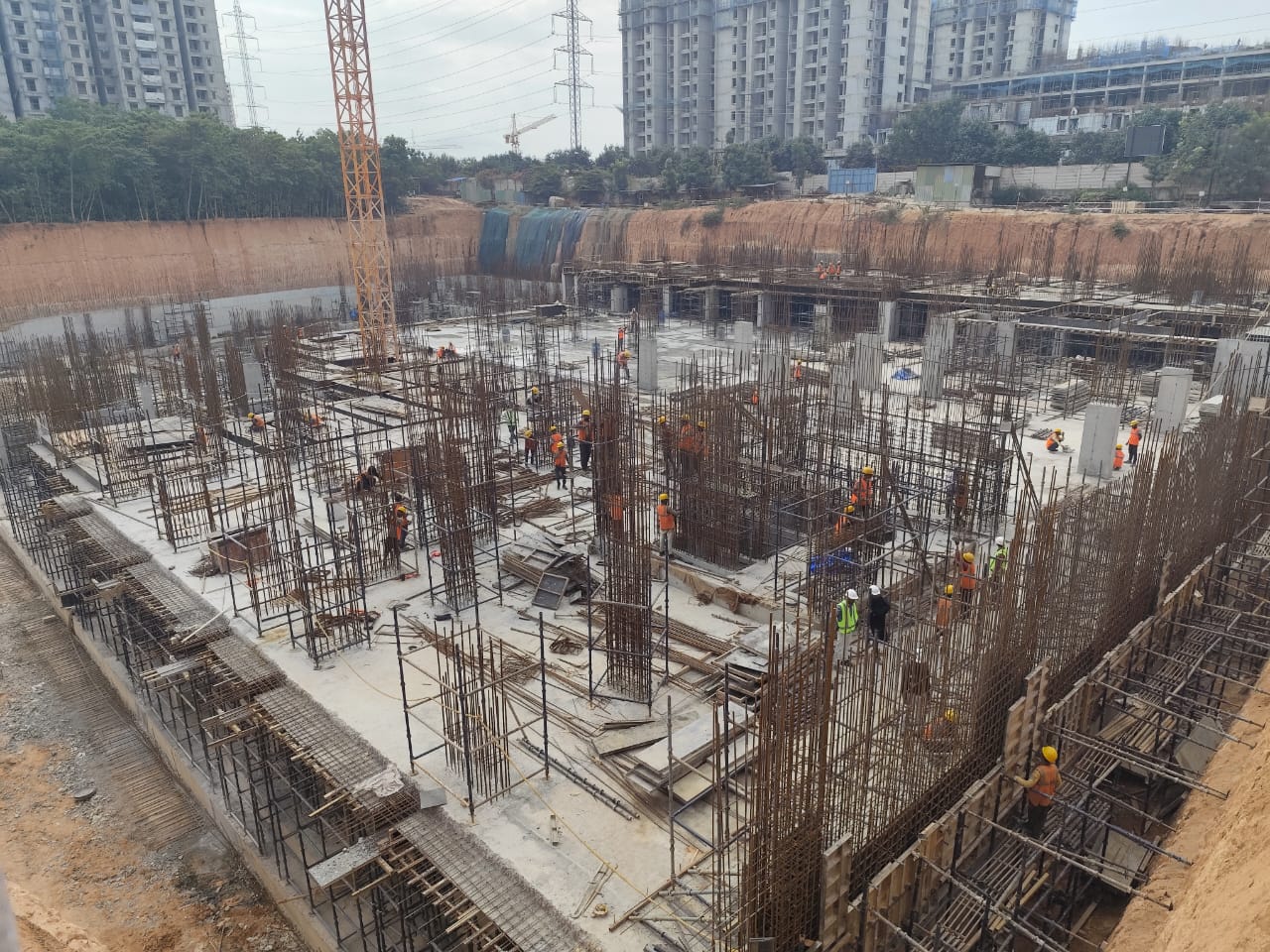

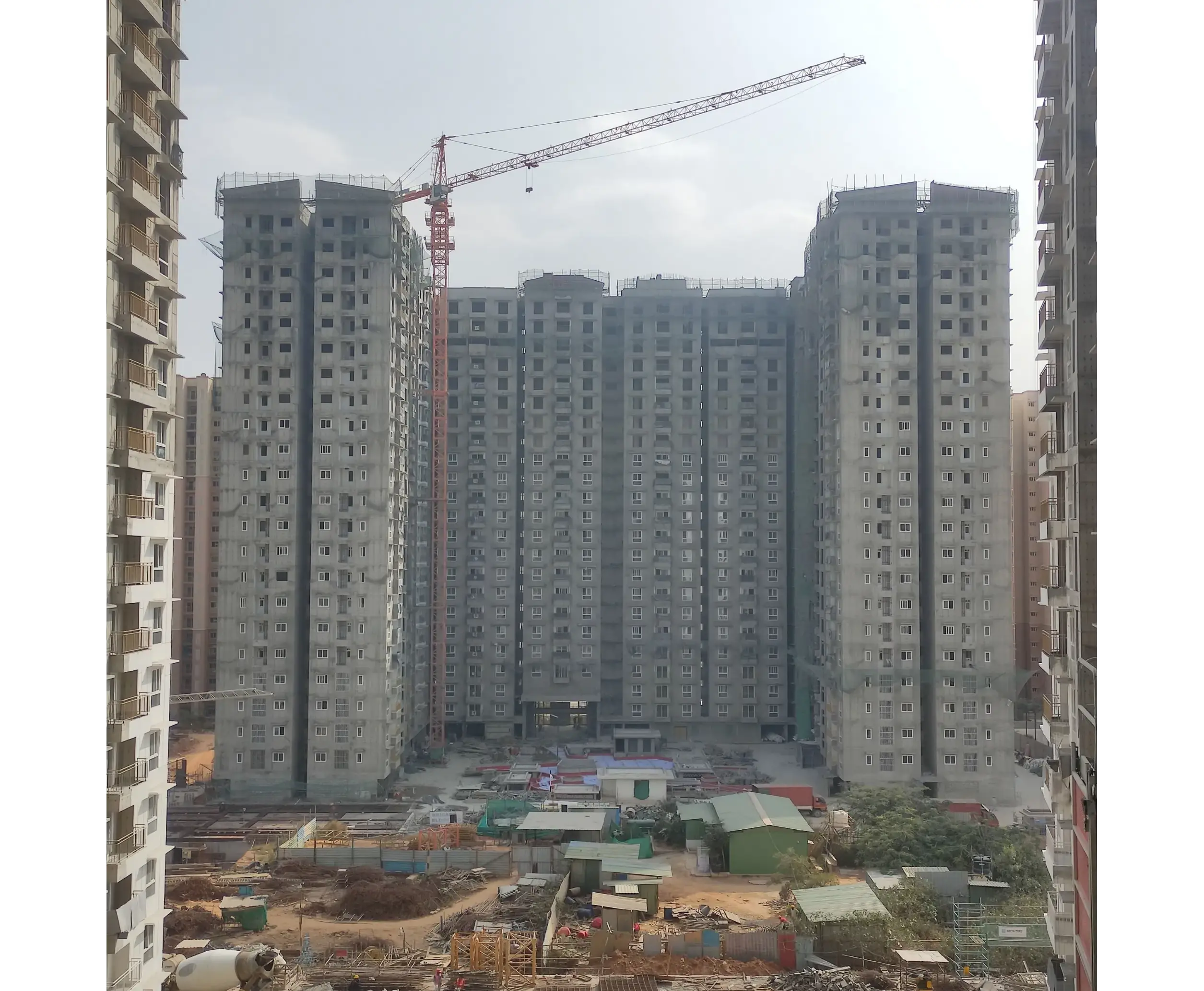

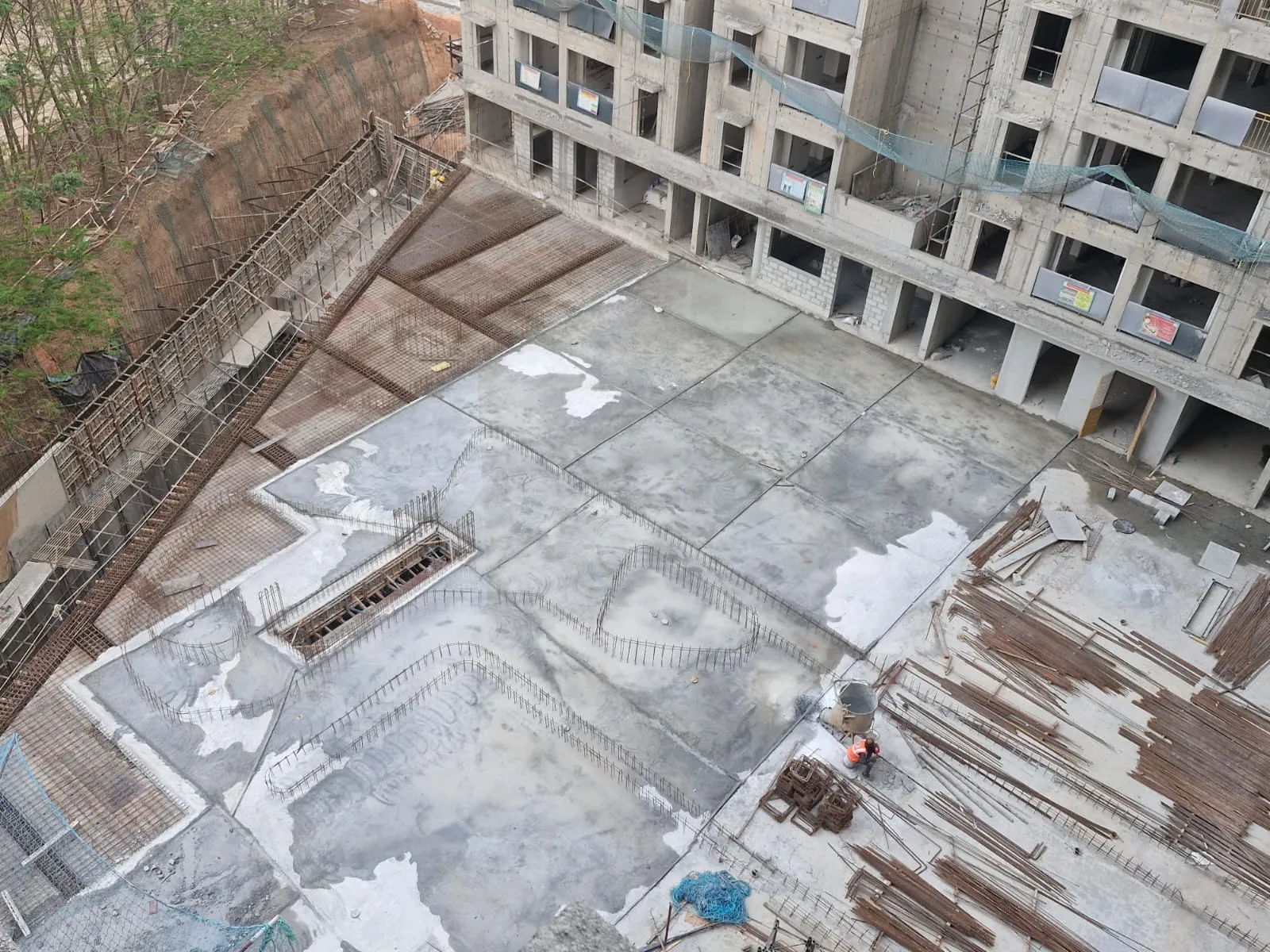

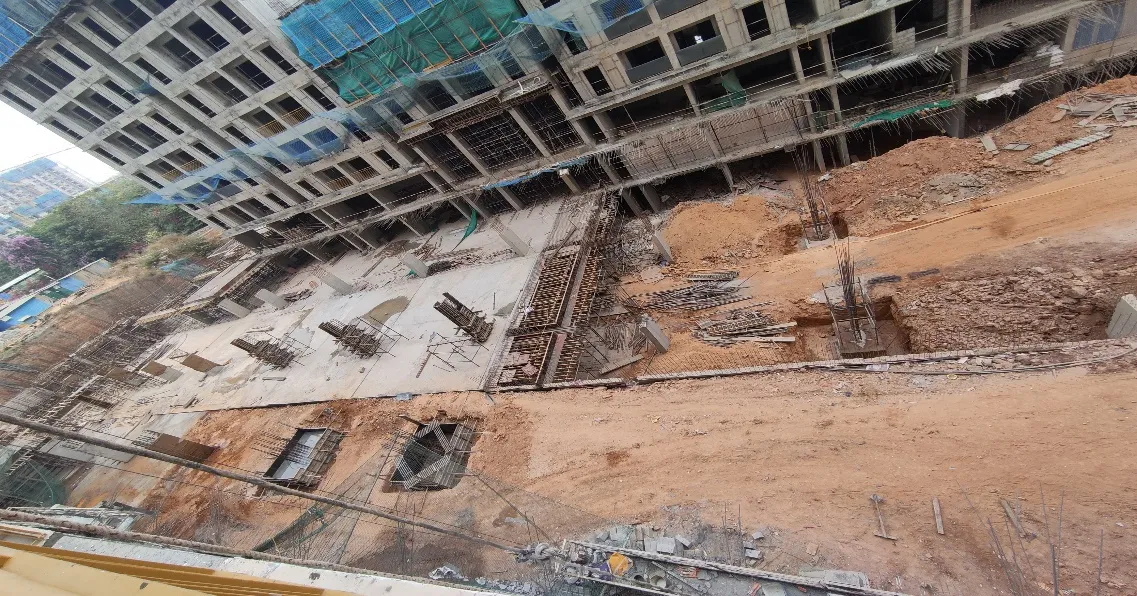

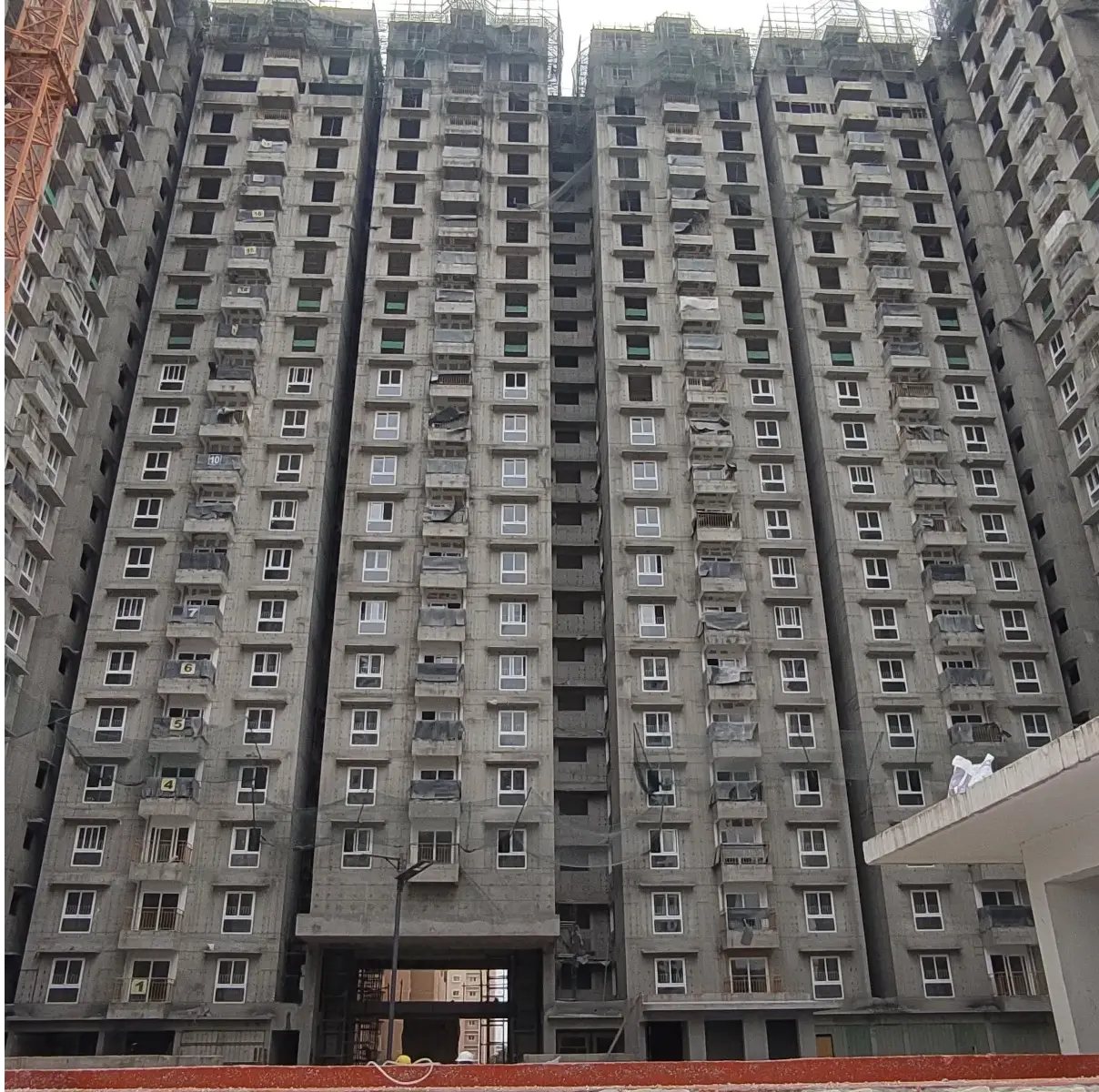

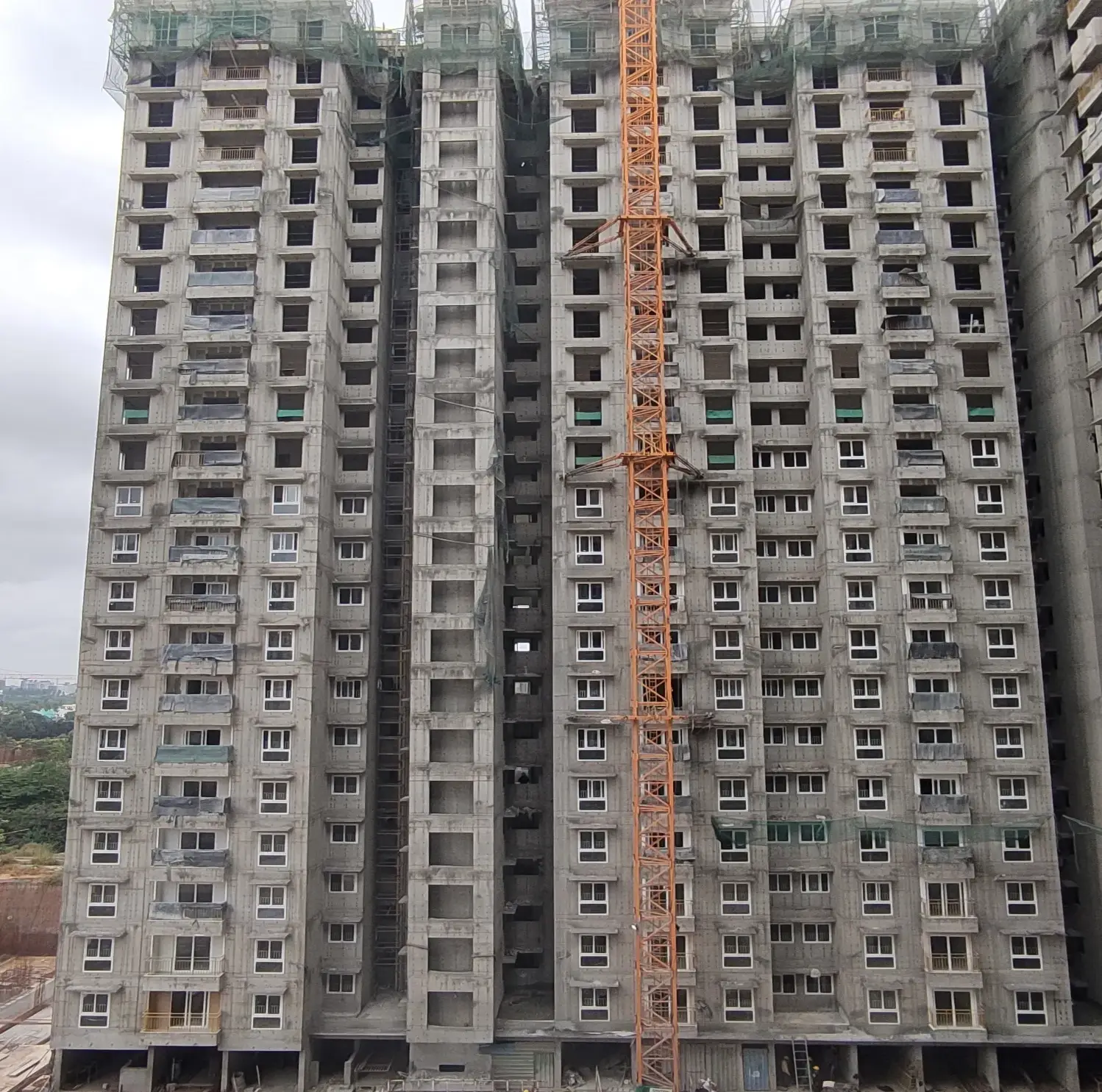

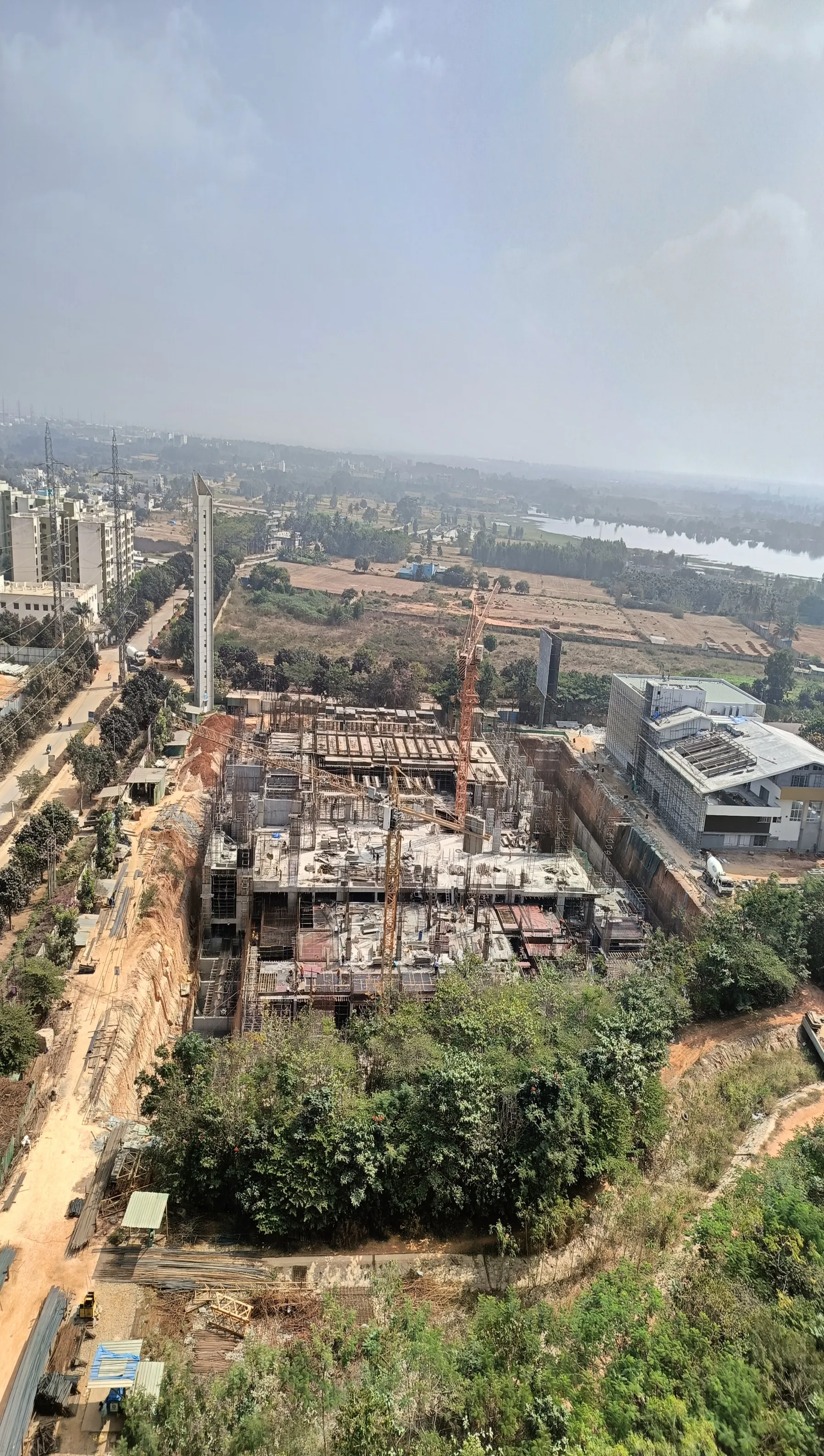

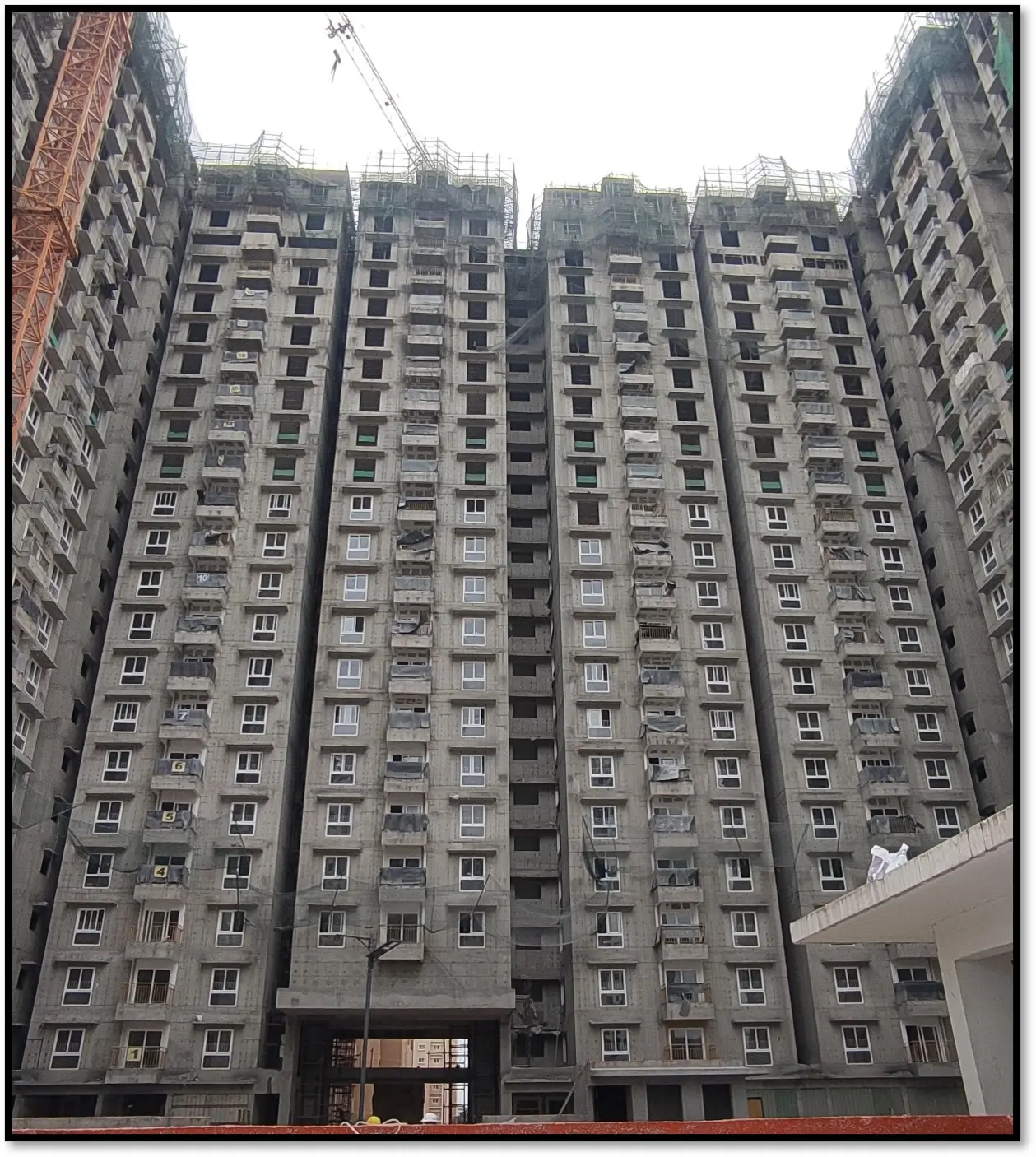

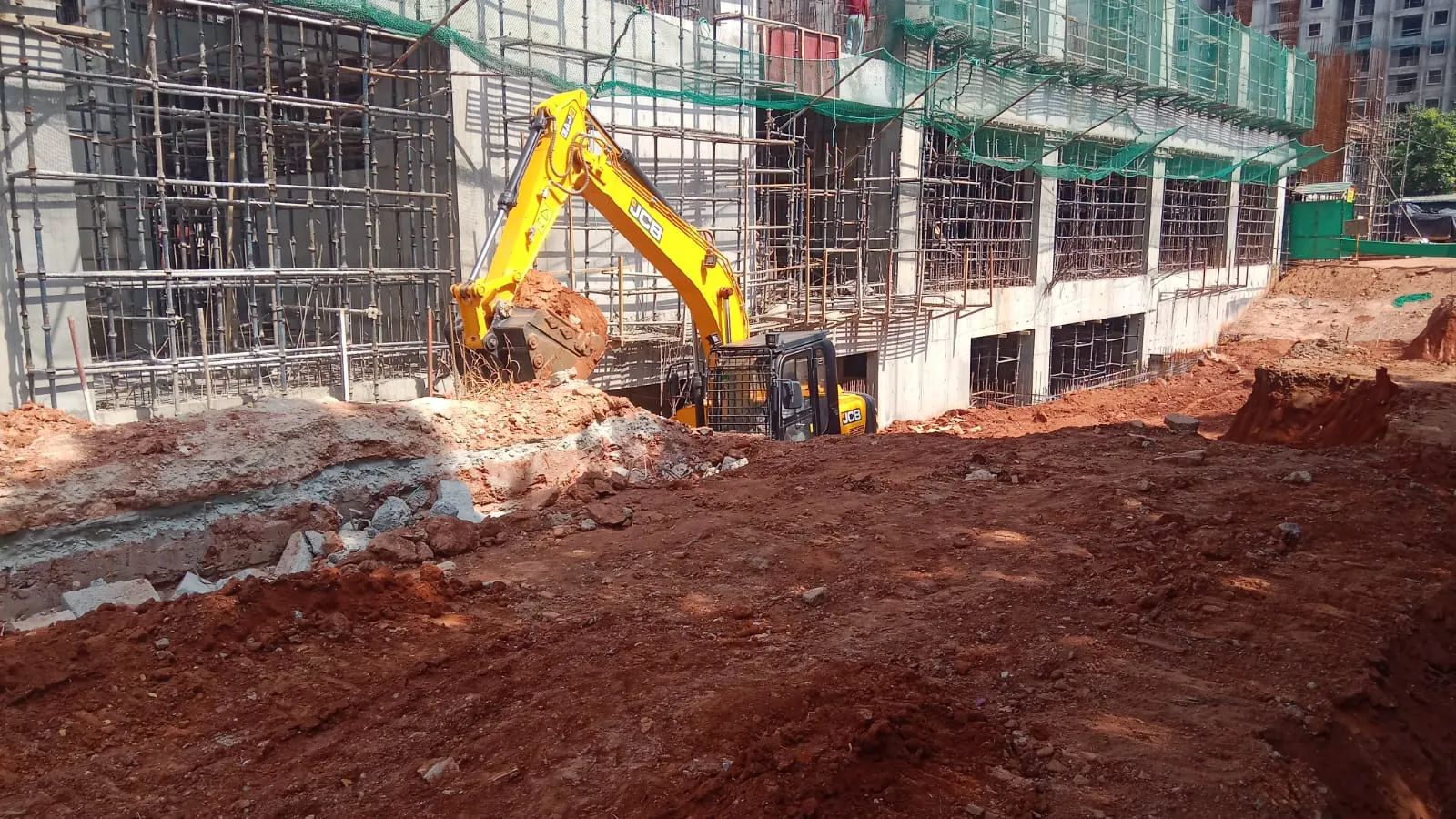

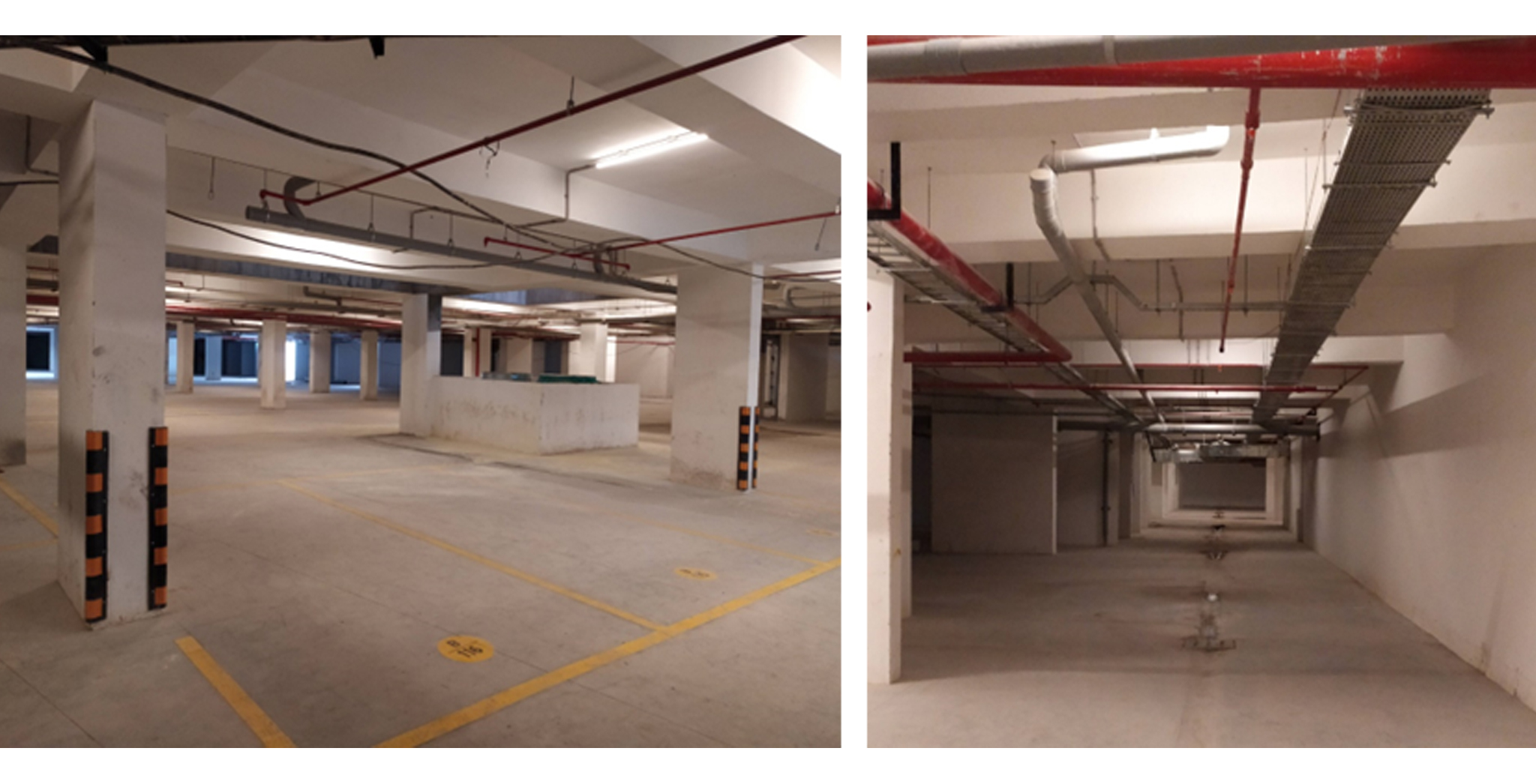

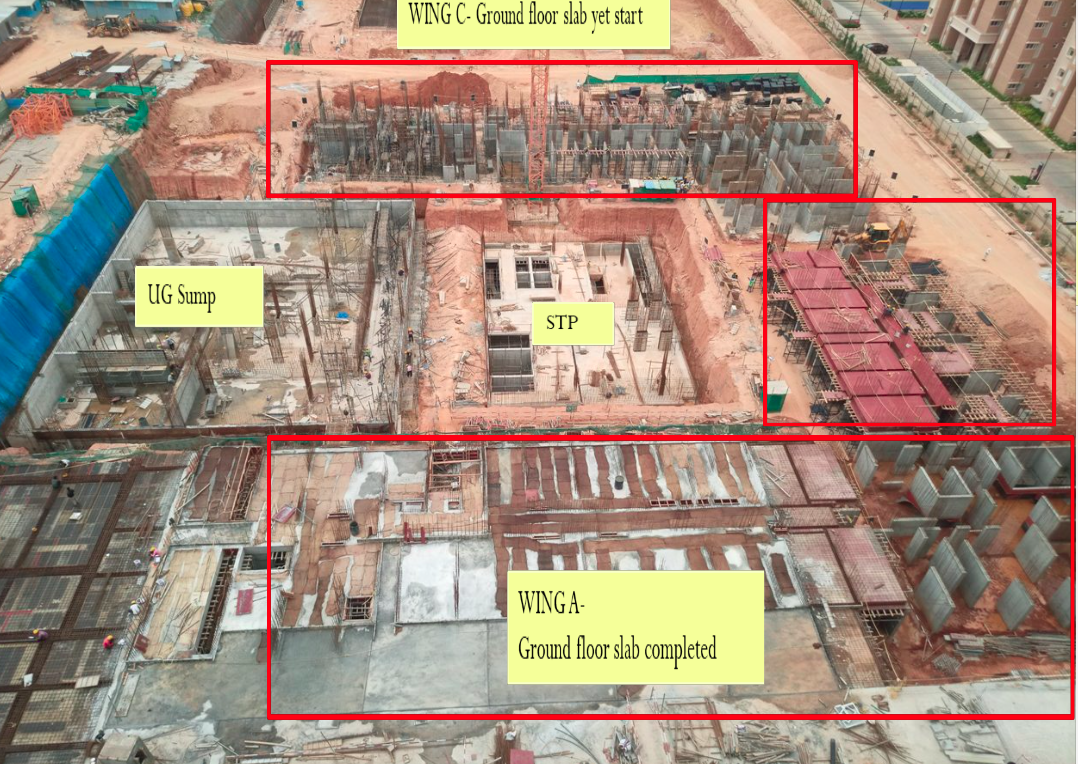

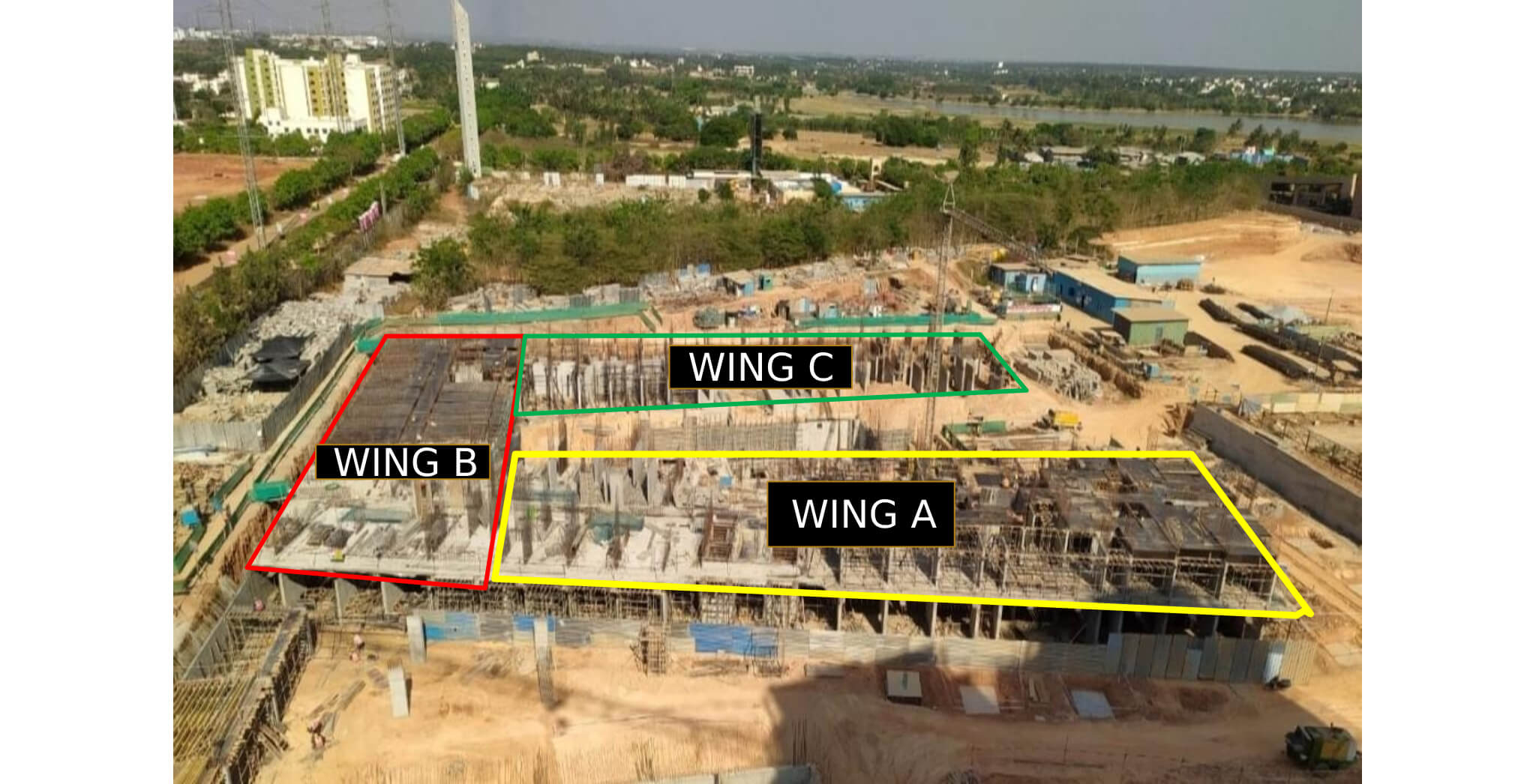

Mass excavation work completed Tower area Raft - work completed Hospital area Raft concreting work in progress Tower A – Basement column shuttering work in progress Tower B – Basement slab shuttering work in progress - Jun 2025

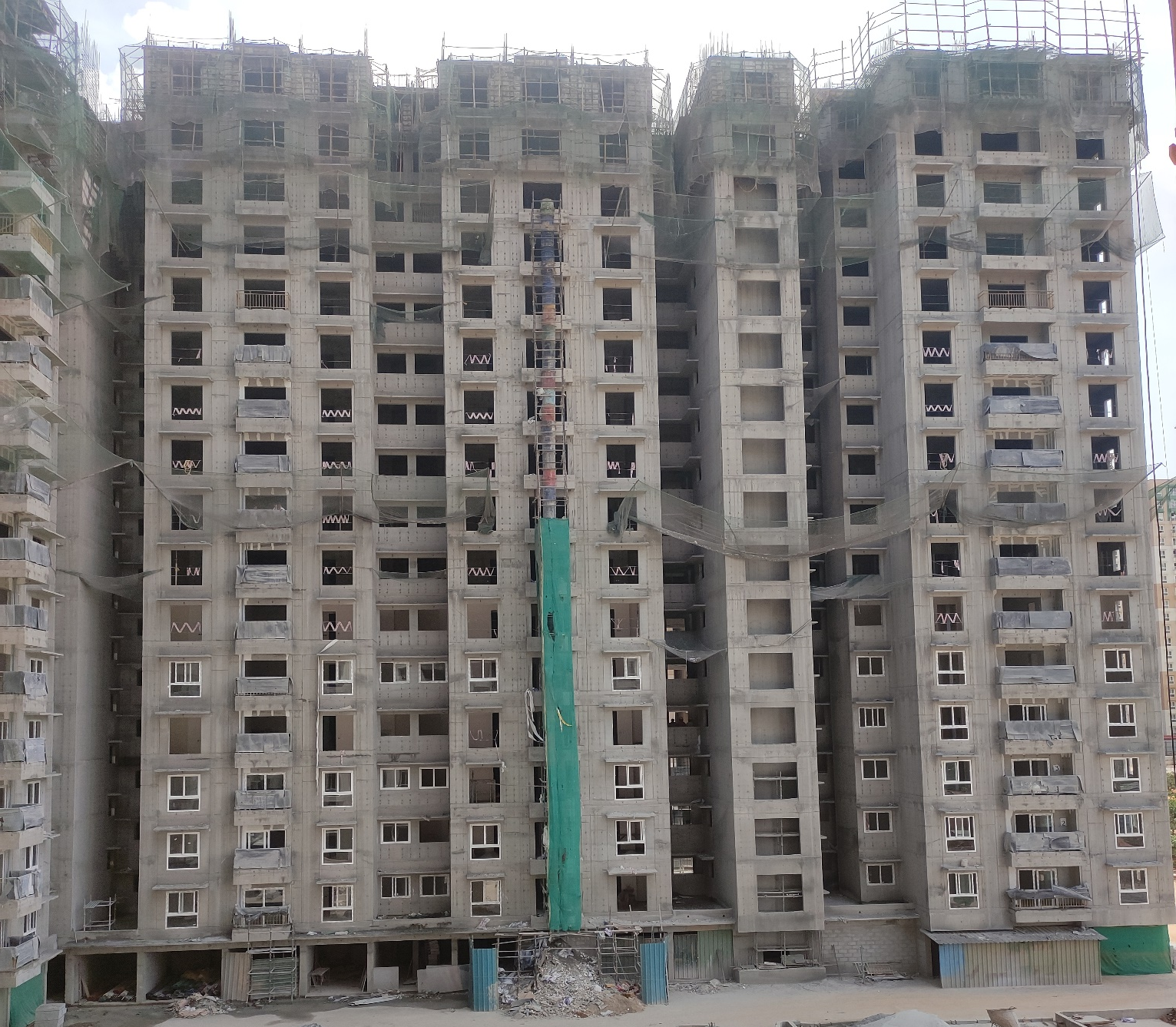

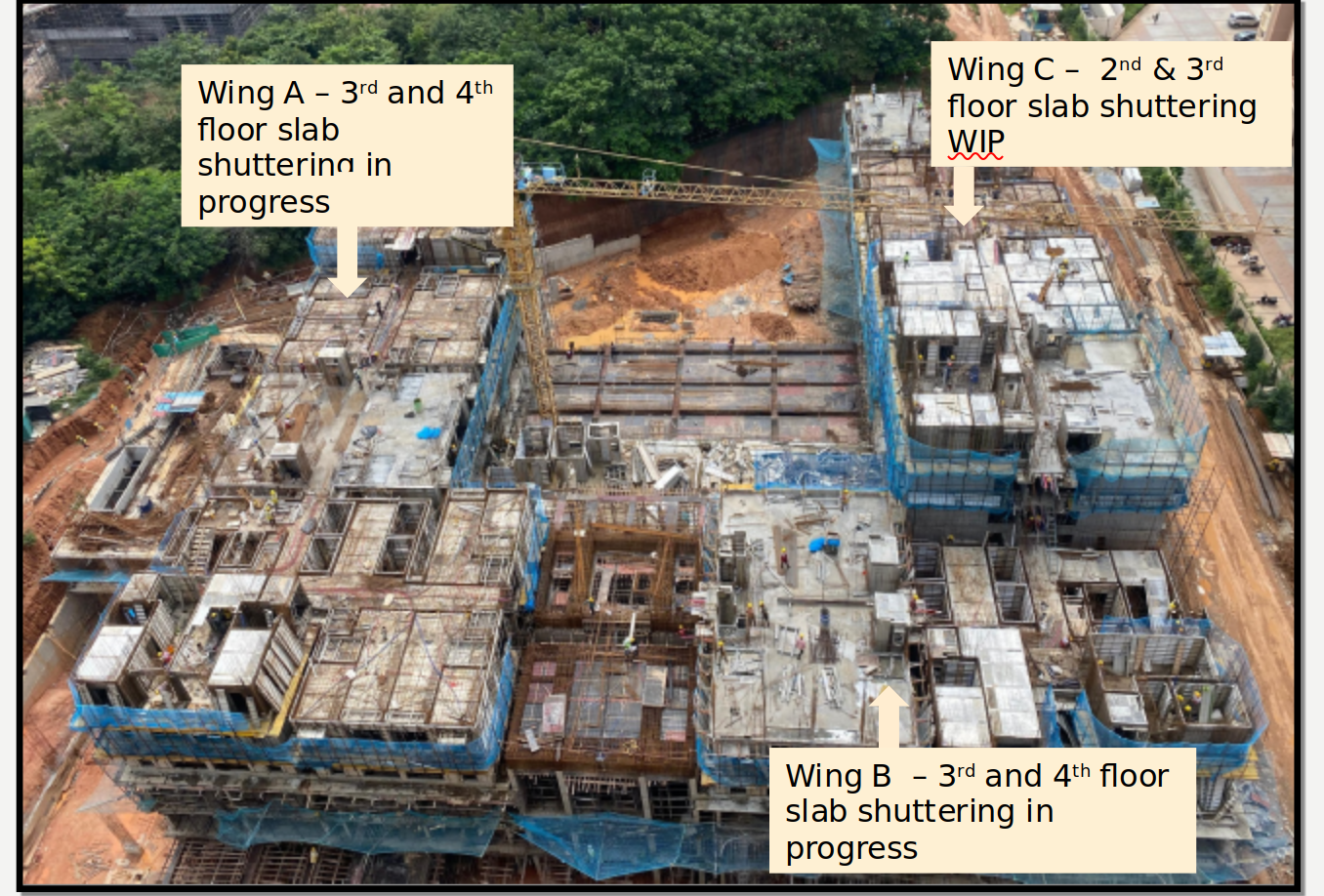

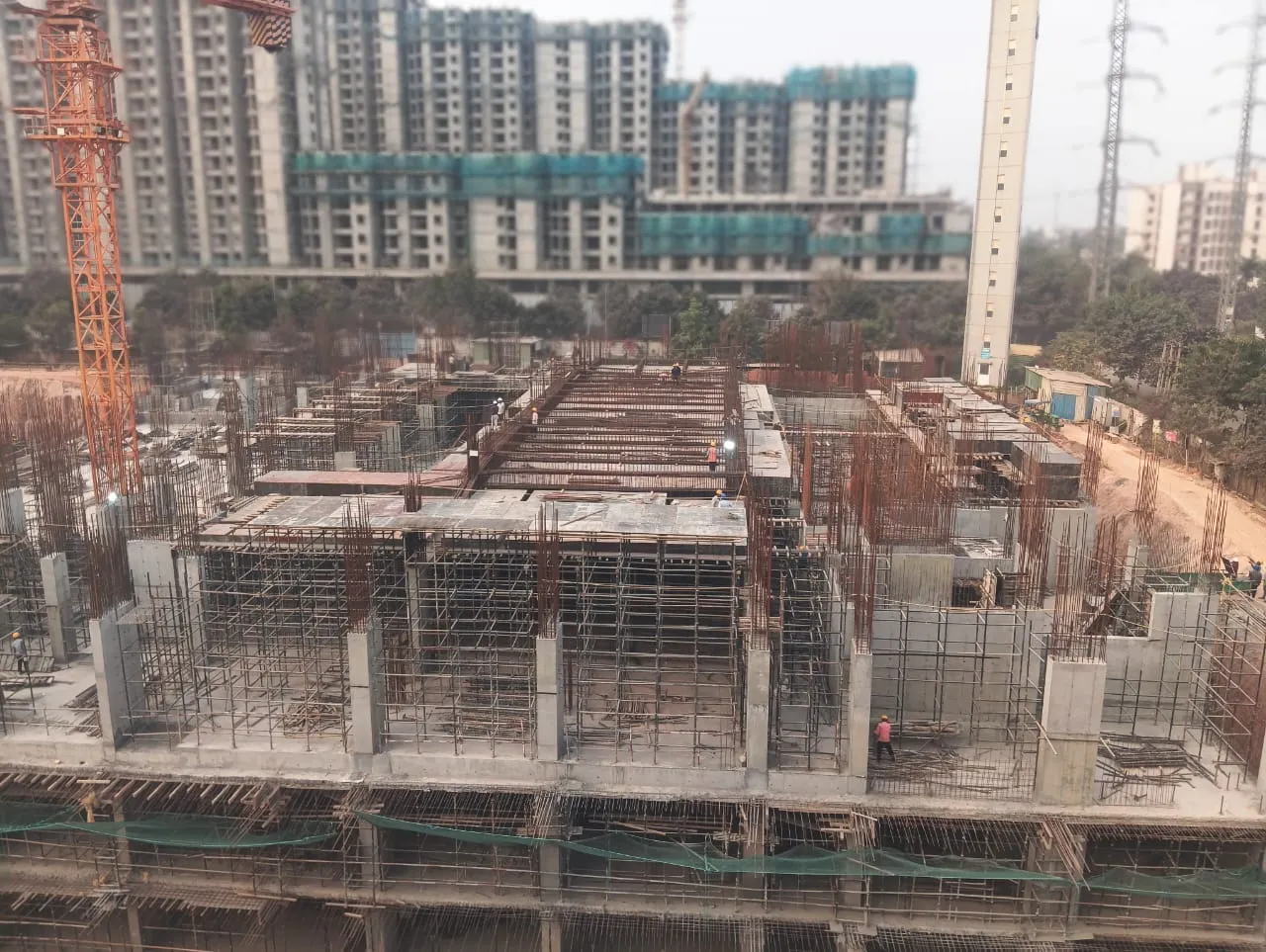

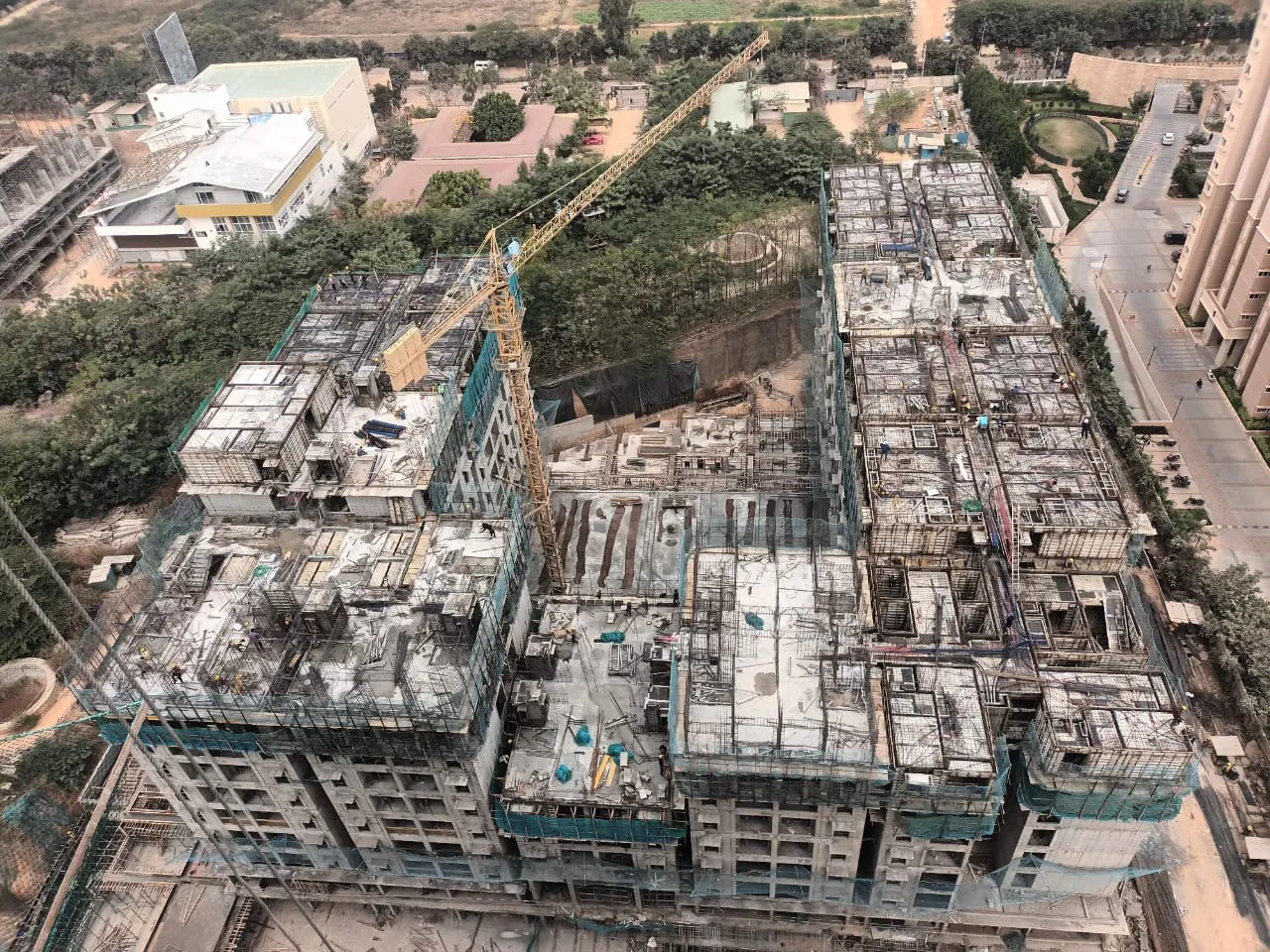

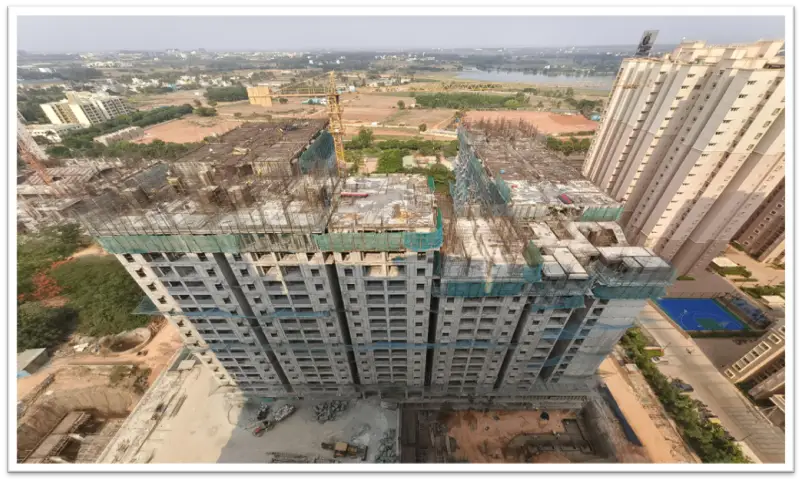

1.Wing A&B – Second floor slab Aluminium initial setting WIP 2. Wing – C – First floor Slab 50% completed. - Jun 2025

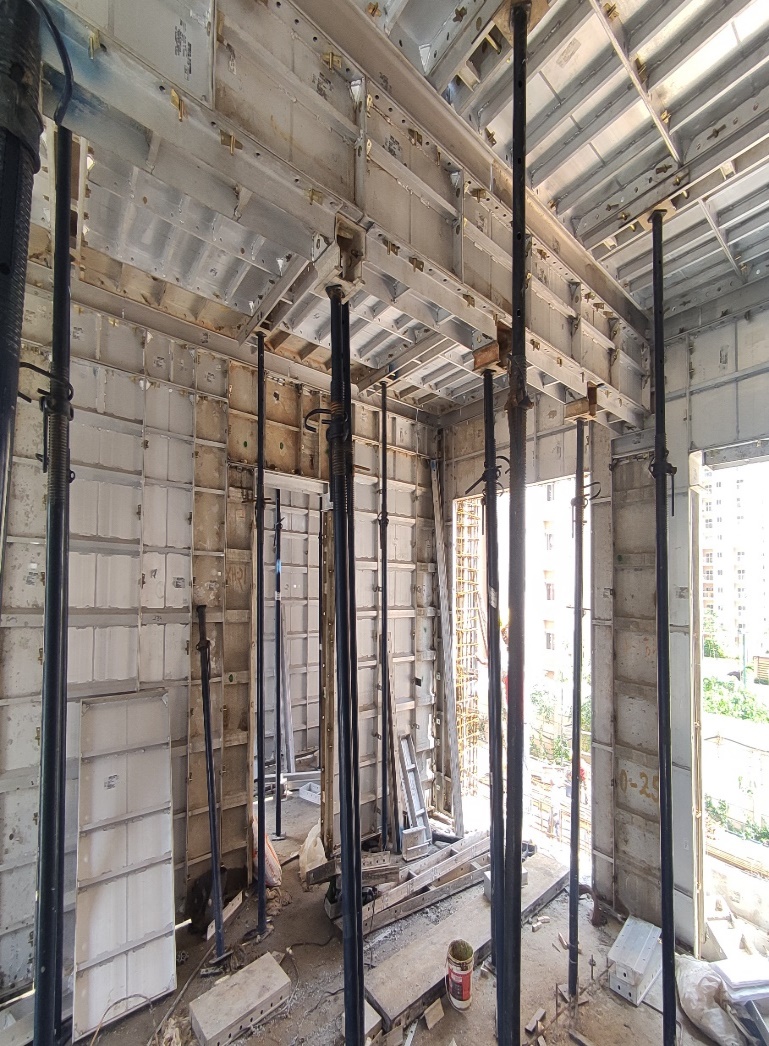

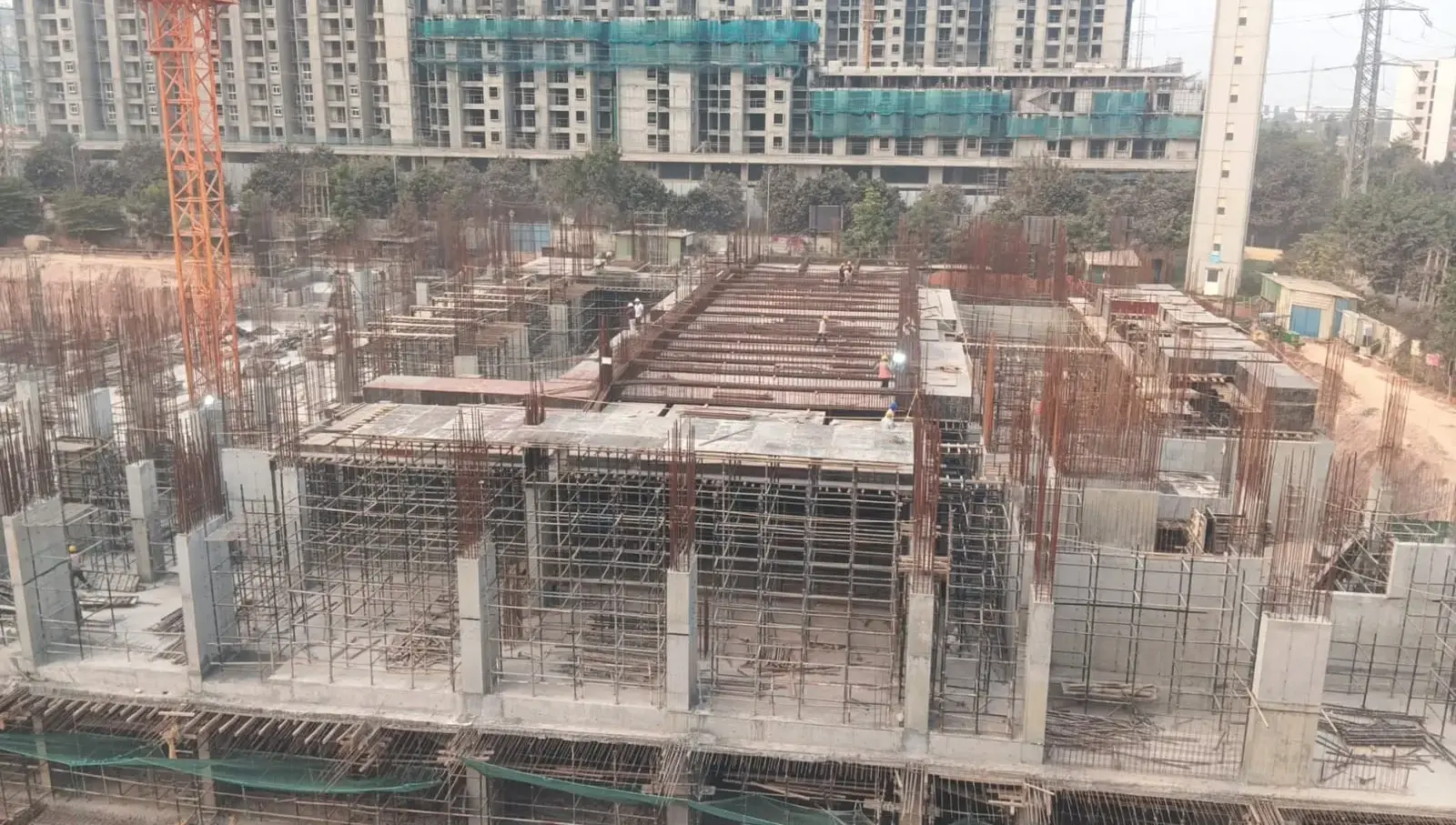

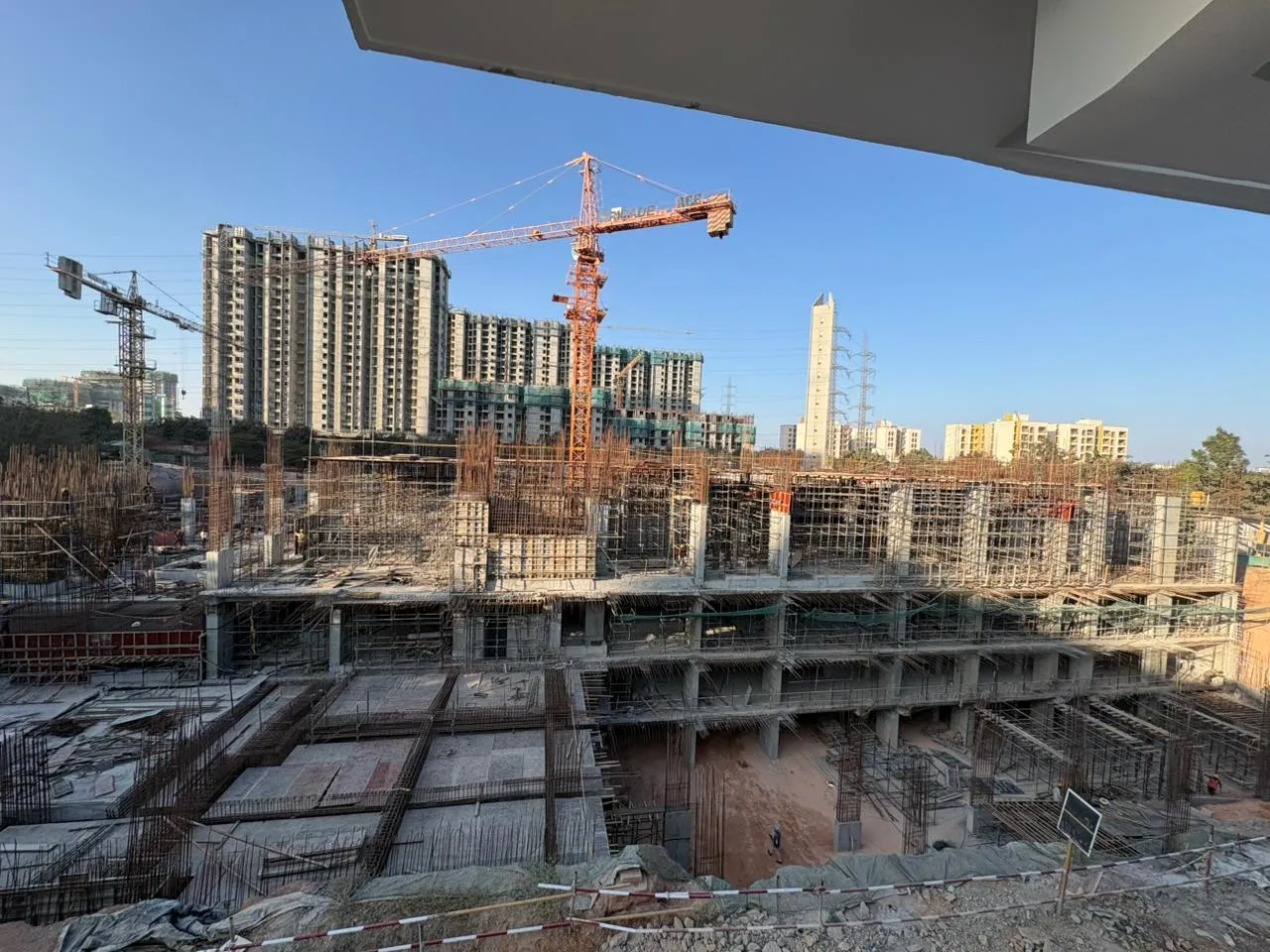

Wing C – First floor slab Aluminium - Jun 2025

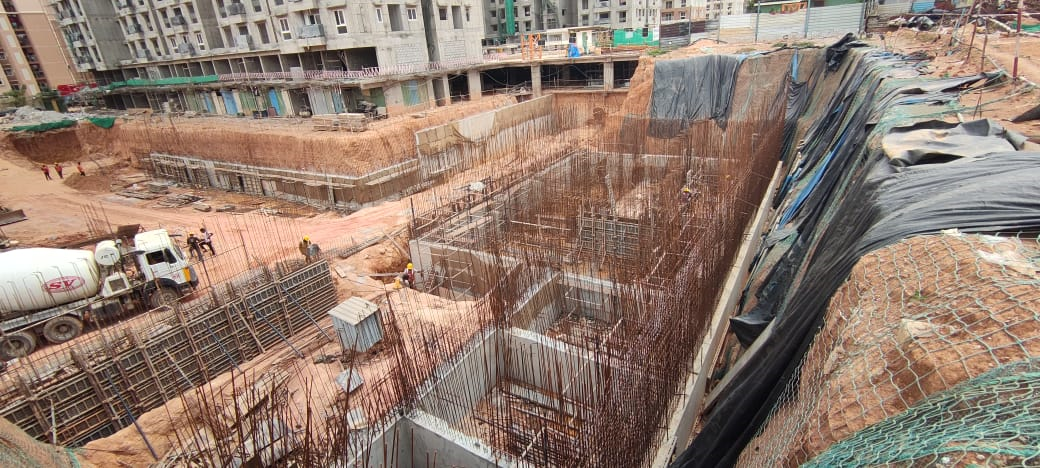

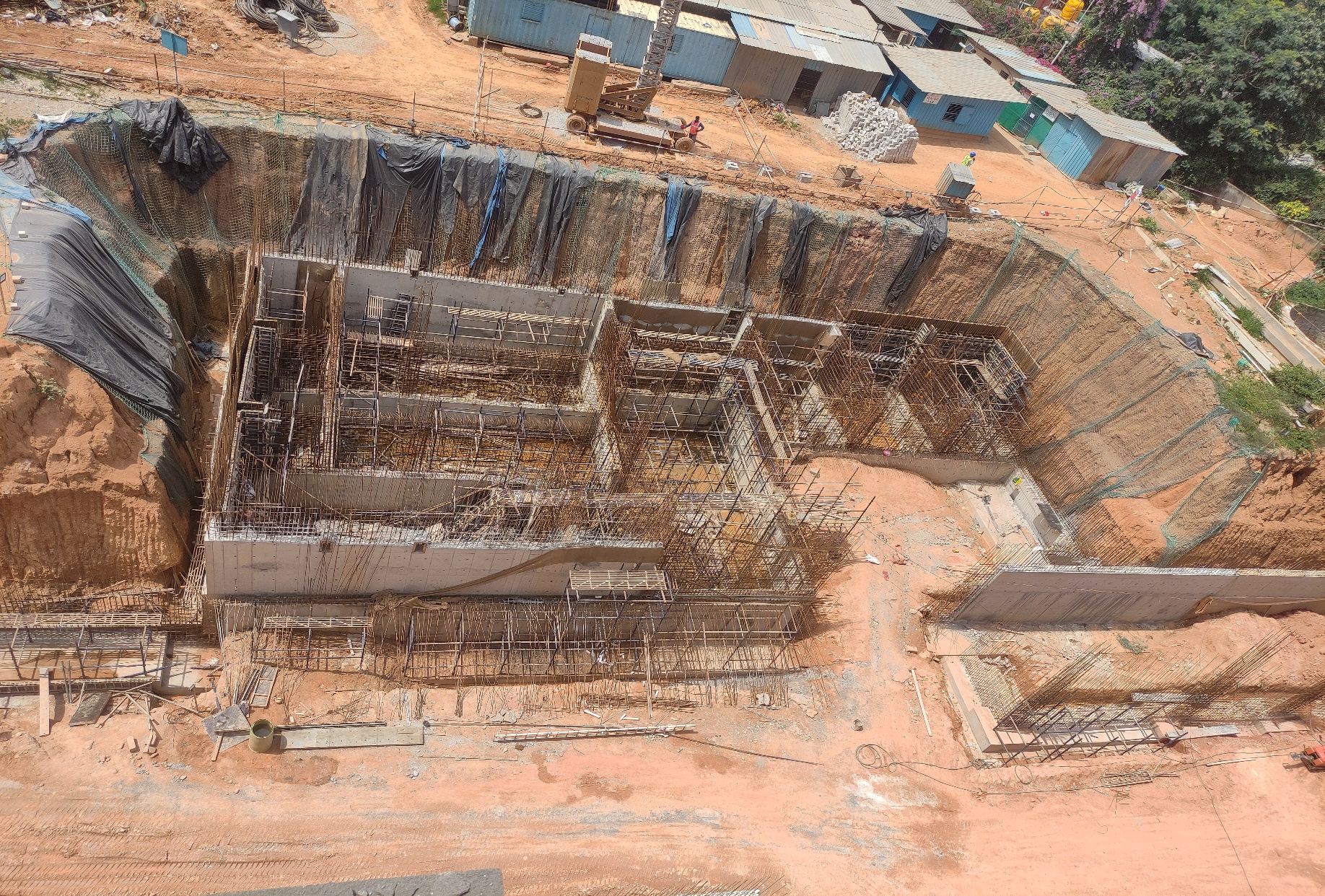

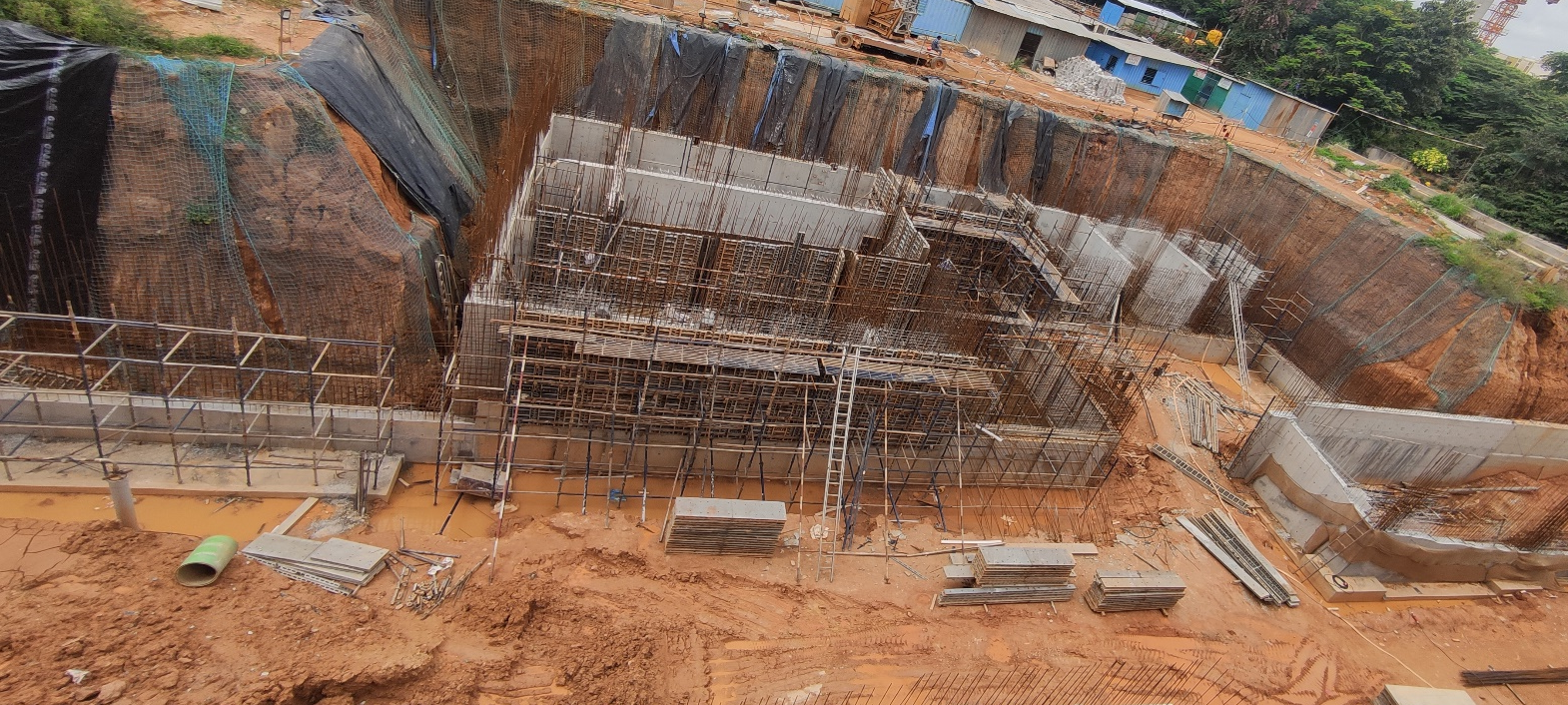

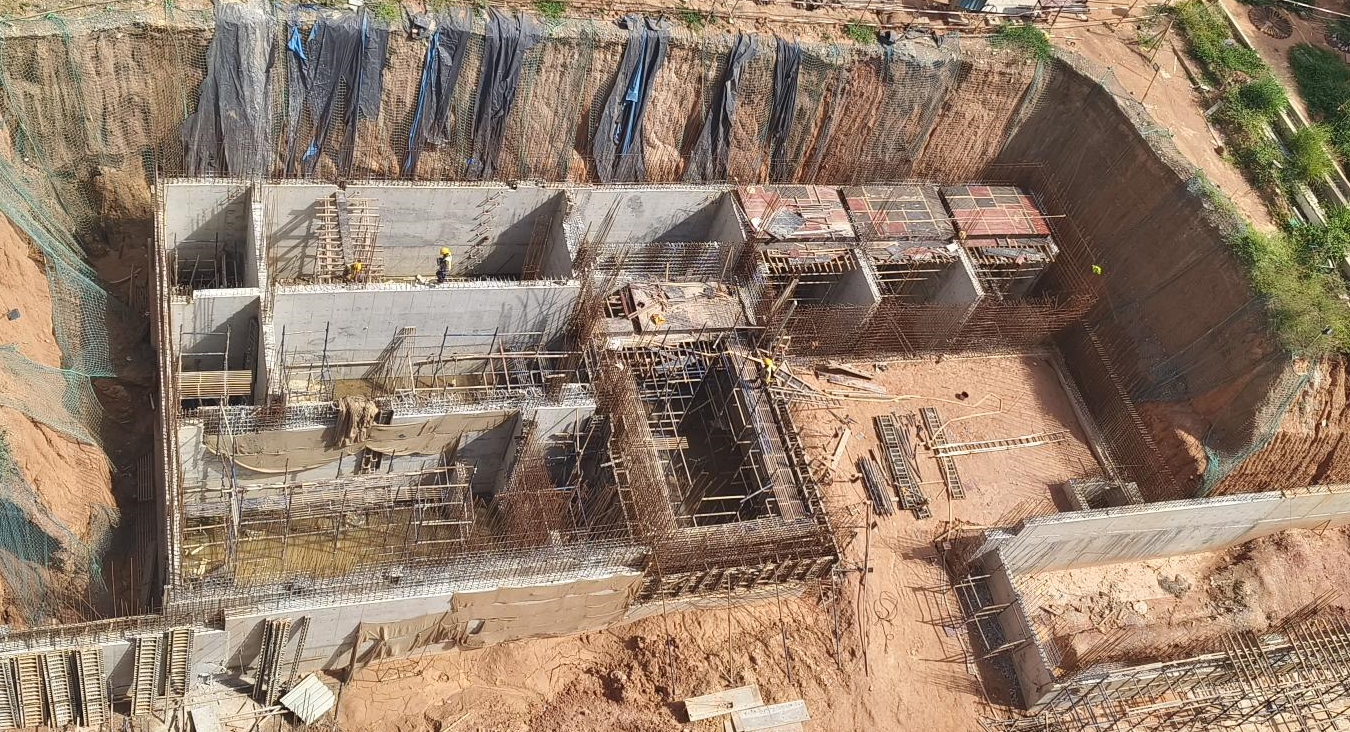

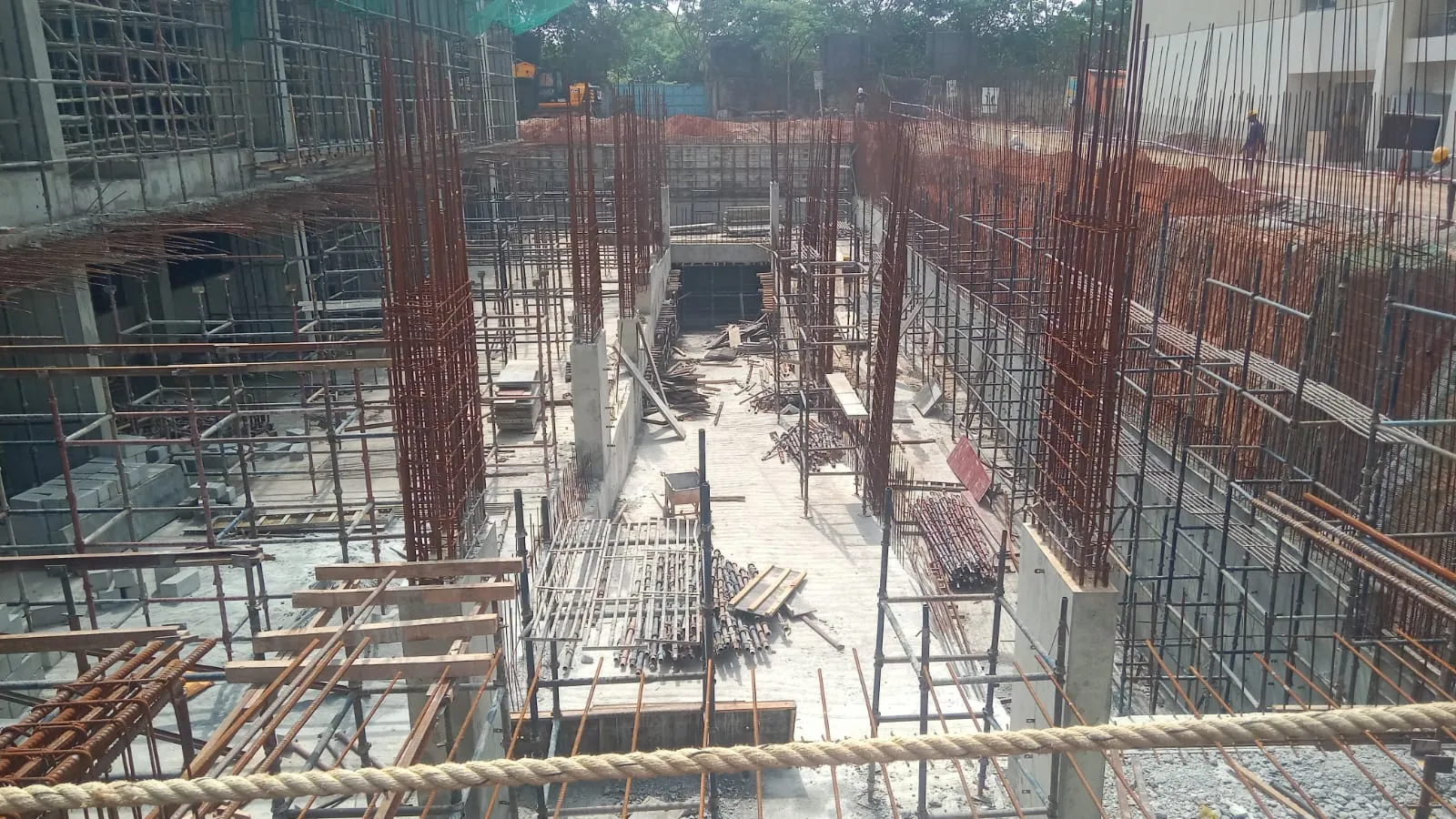

STP – Raft completed, Wall concrete in progress - Jun 2025

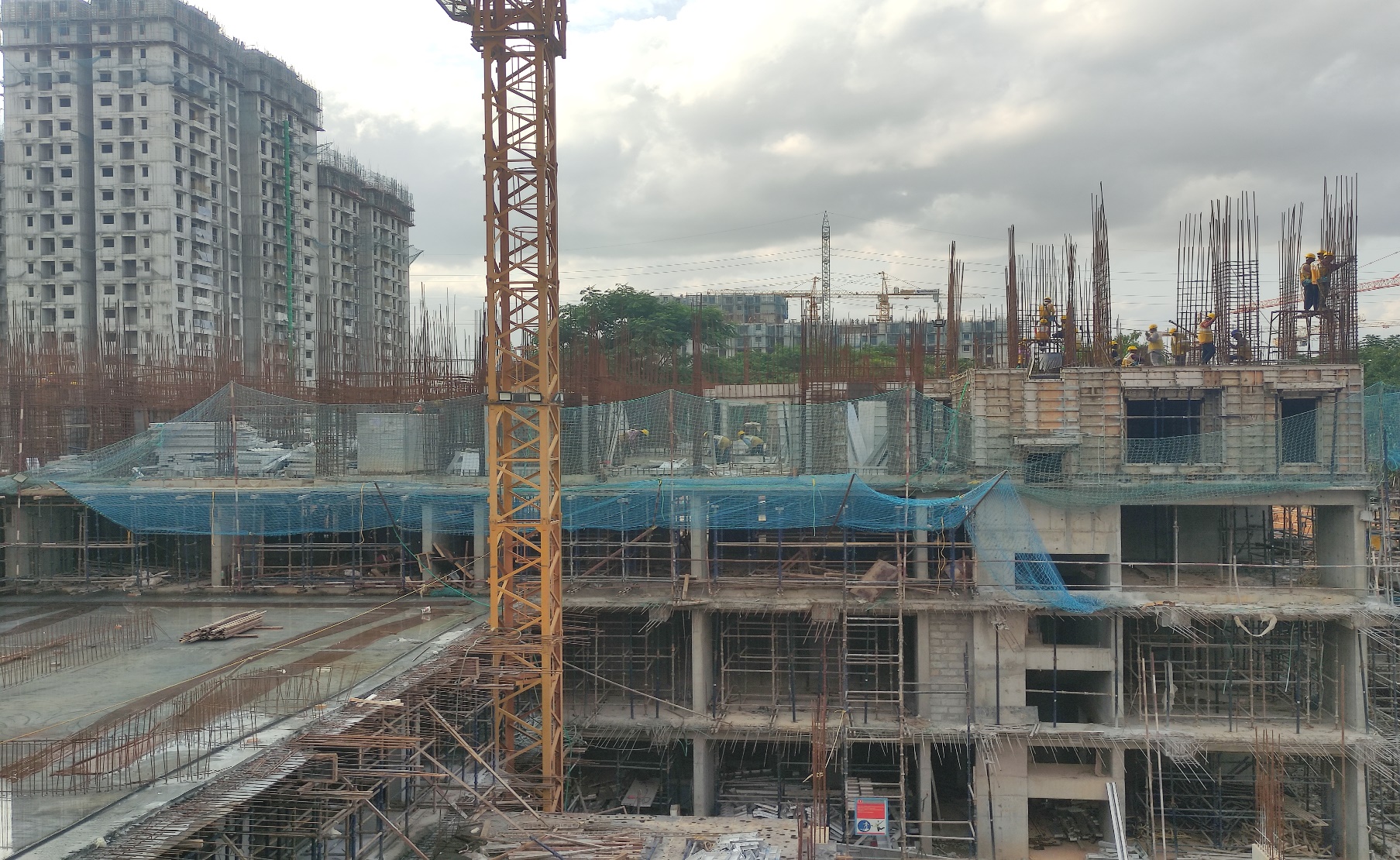

Wing A – Second floor slab shuttering in progress - Jun 2025

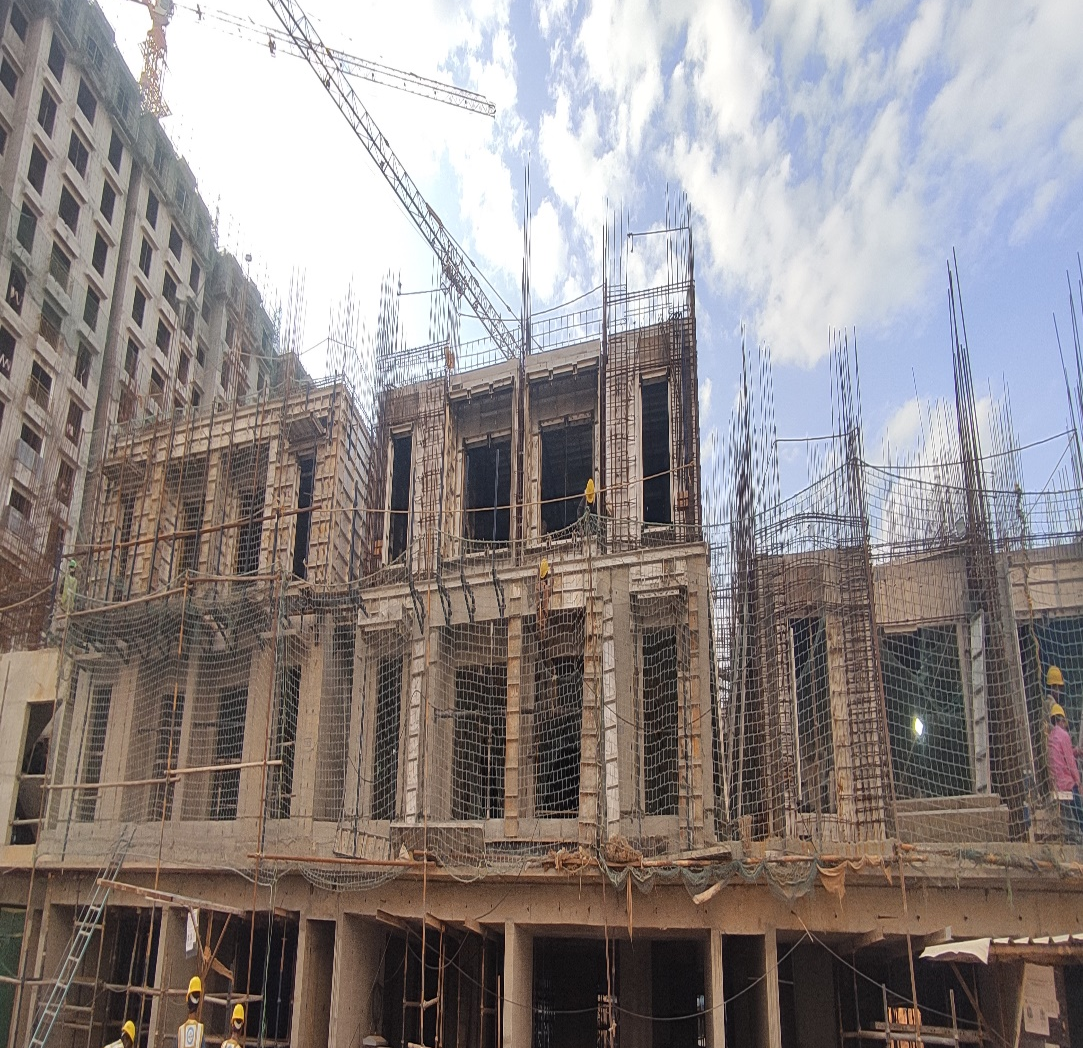

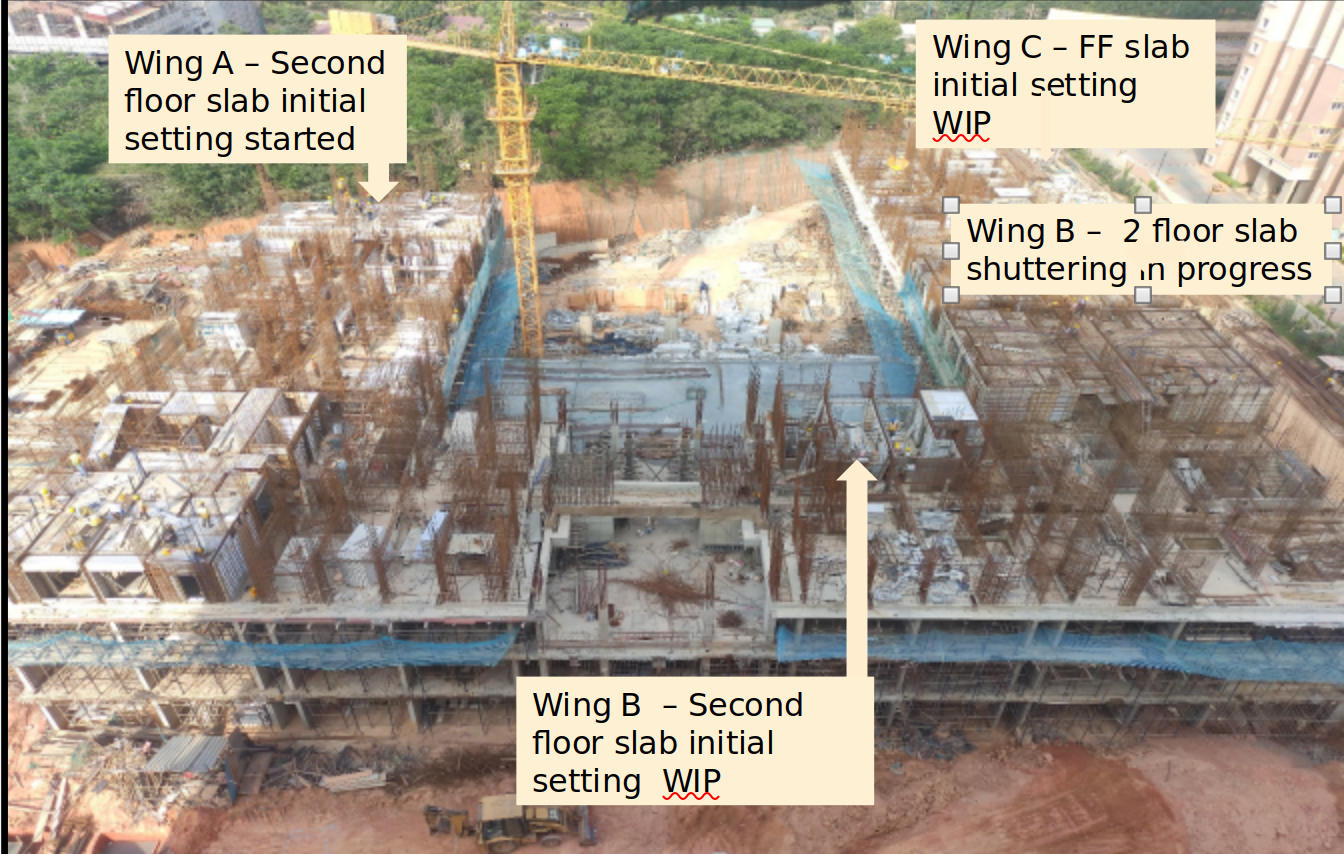

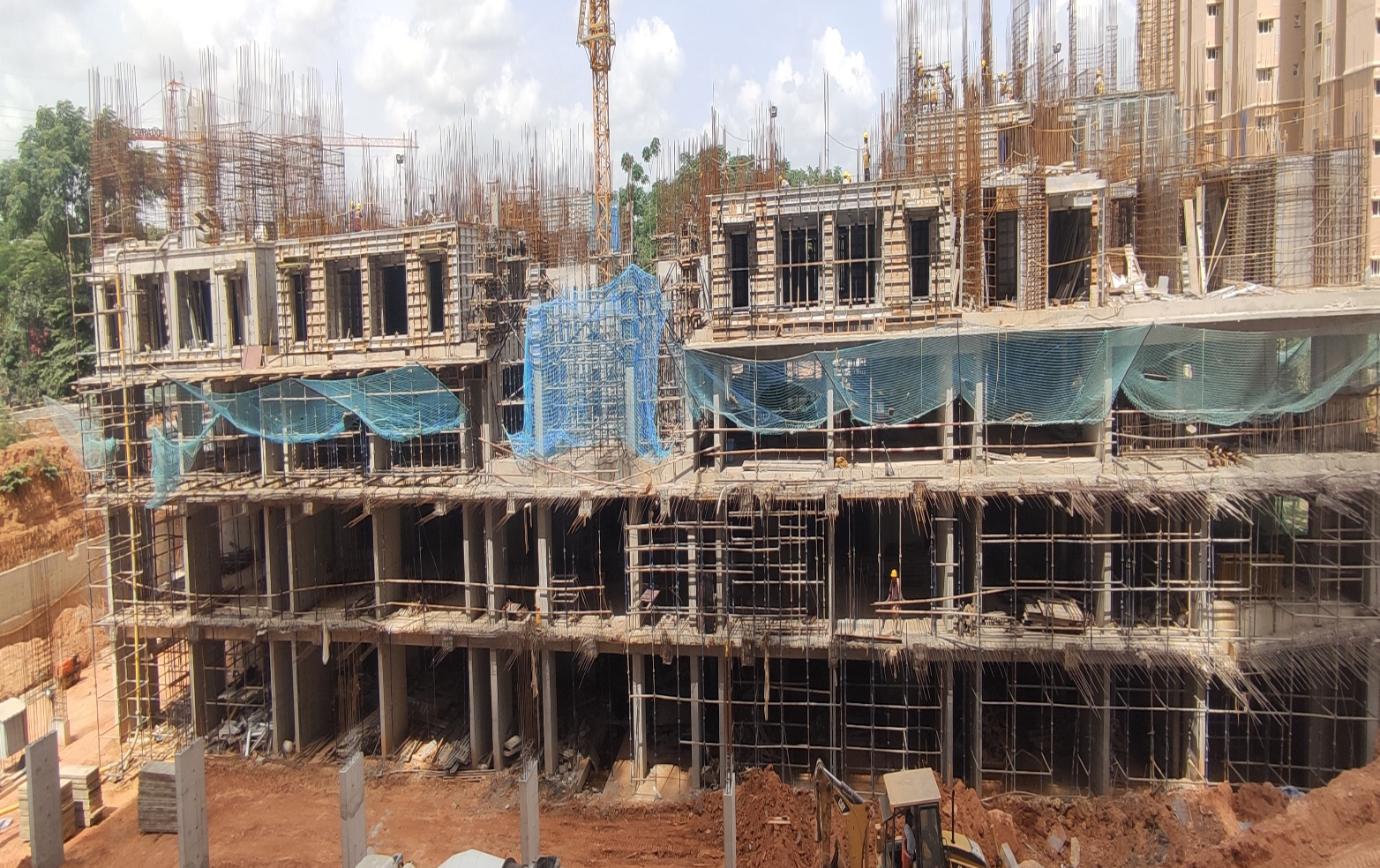

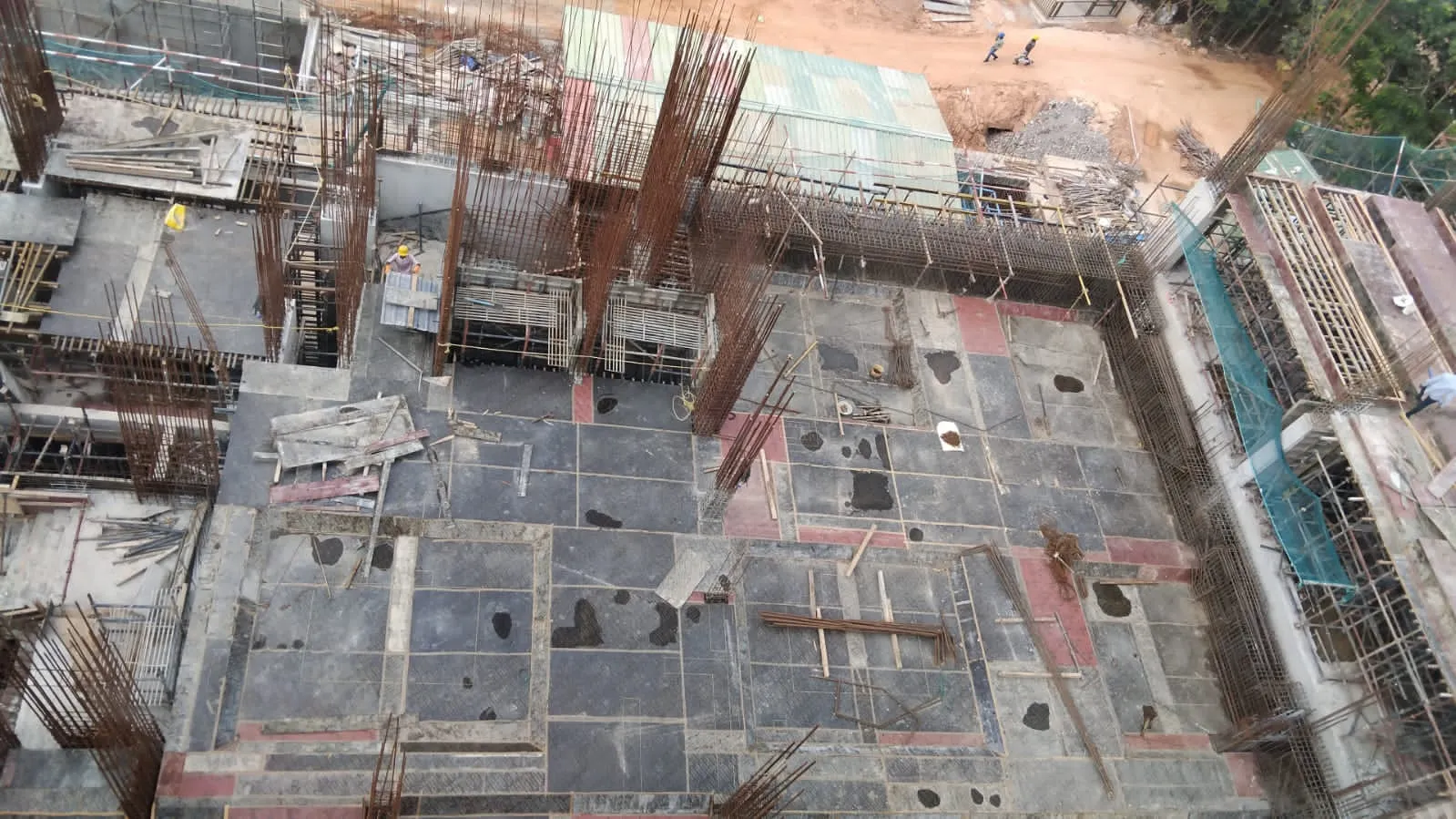

Wing B –Second floor slab aluminium shuttering WIP - Jun 2025

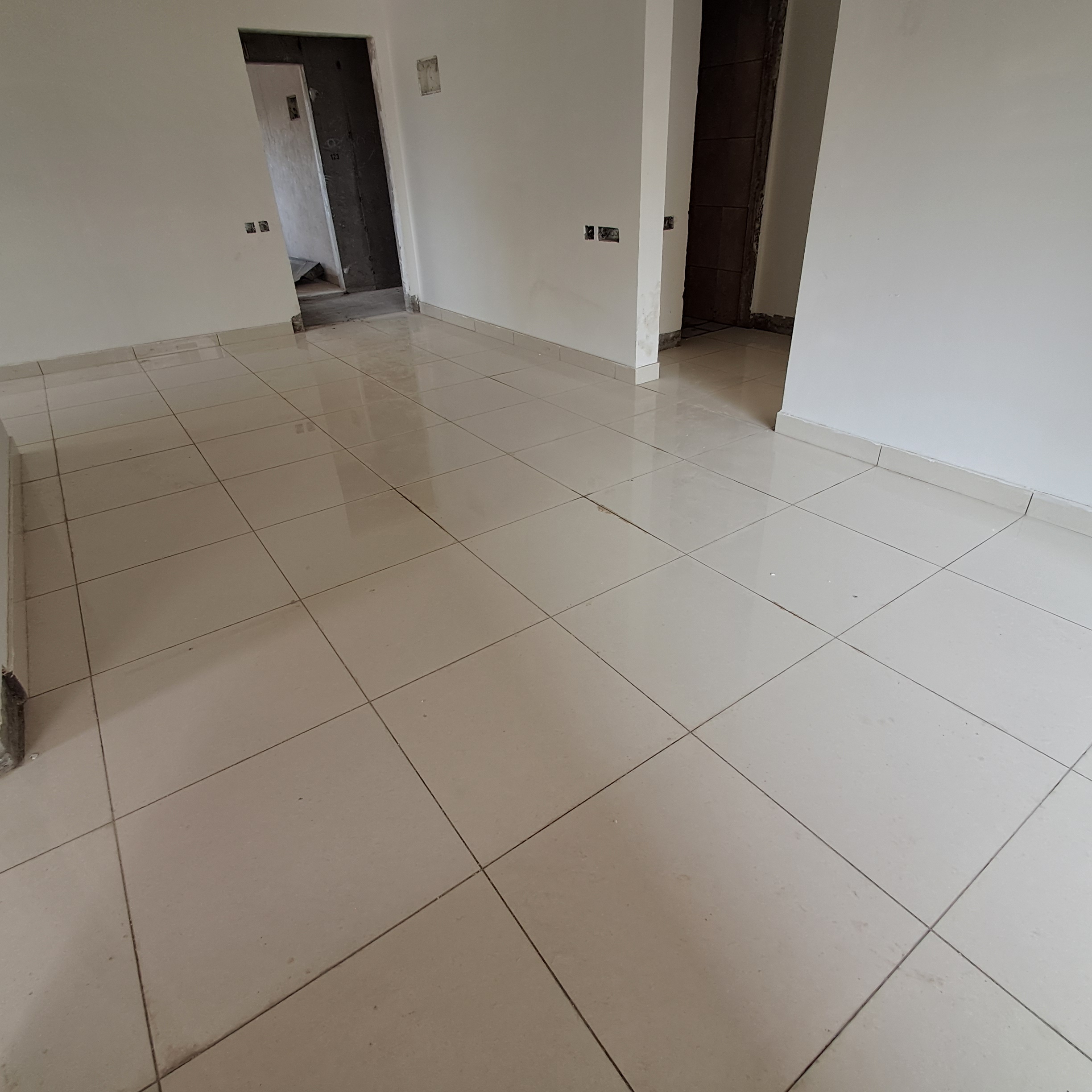

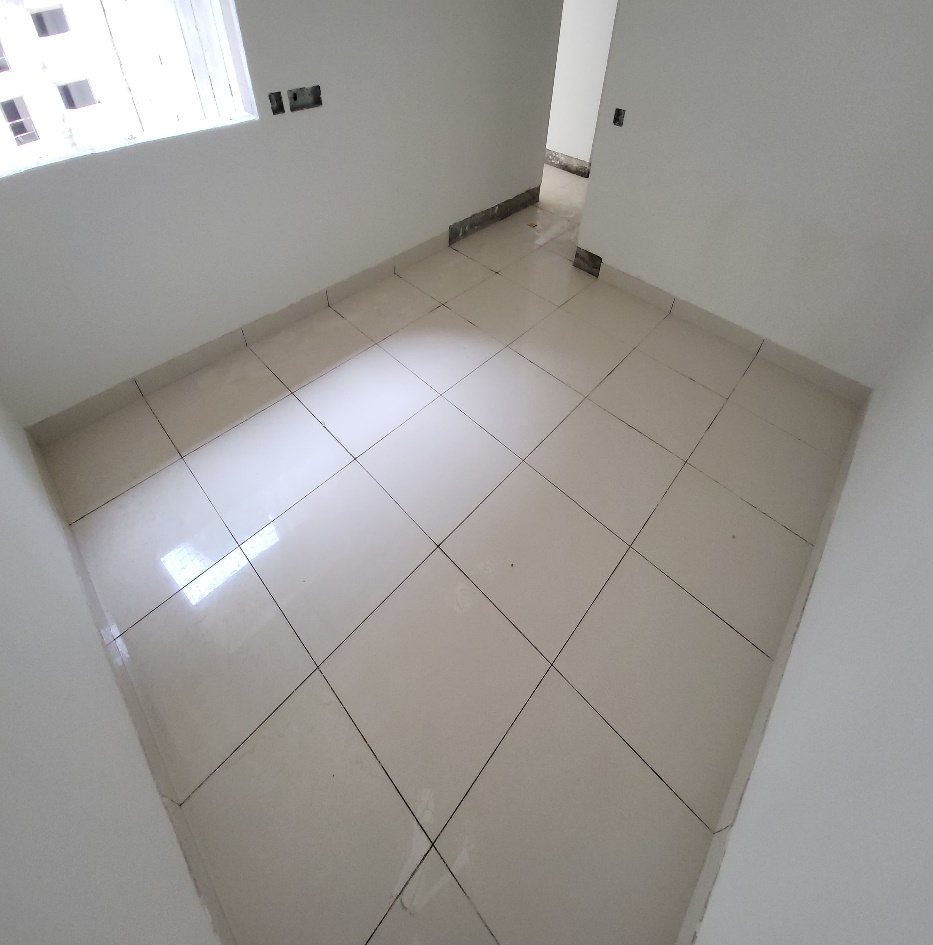

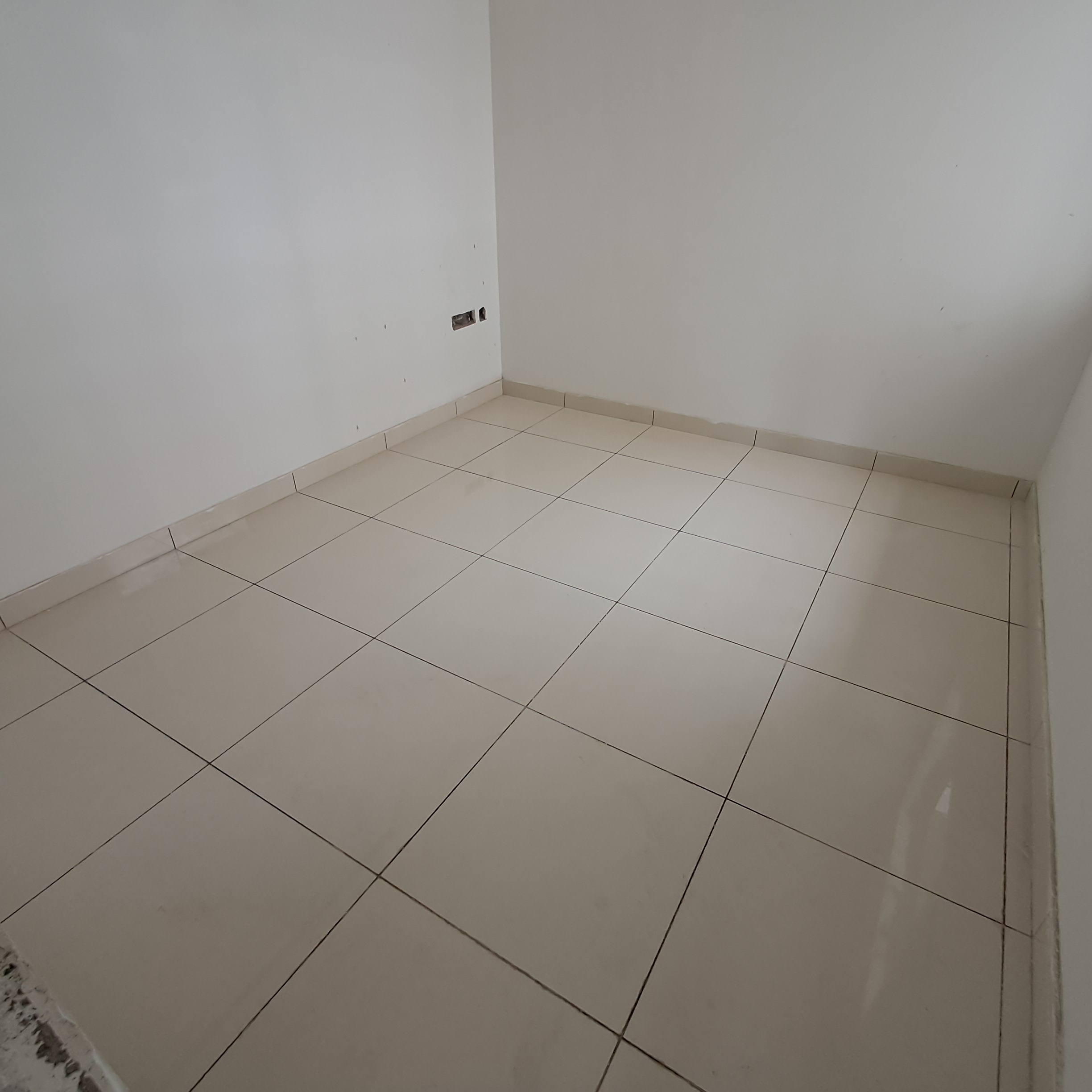

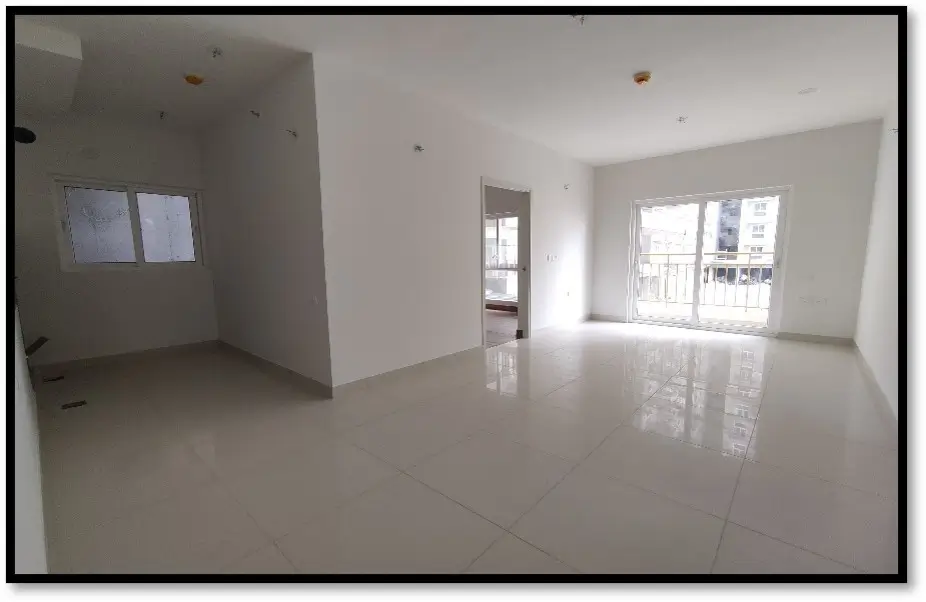

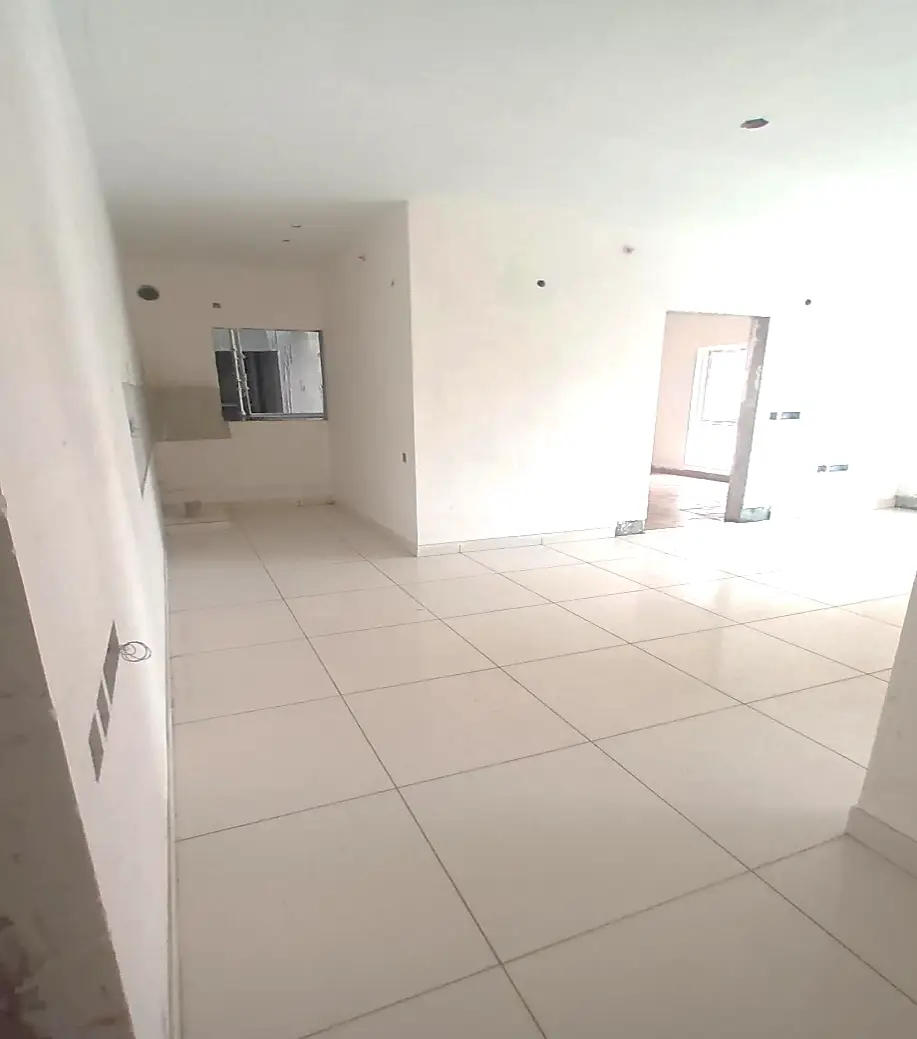

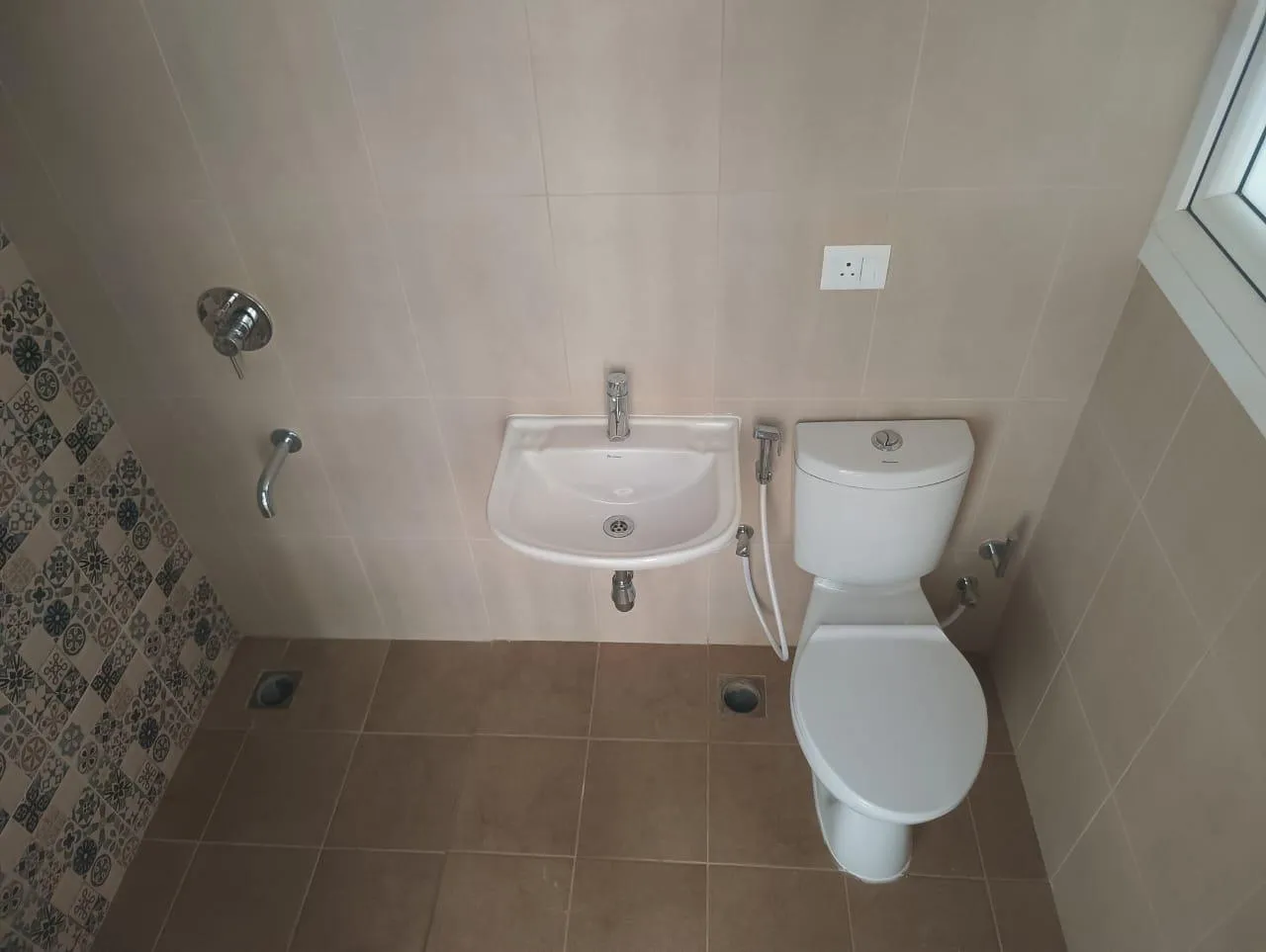

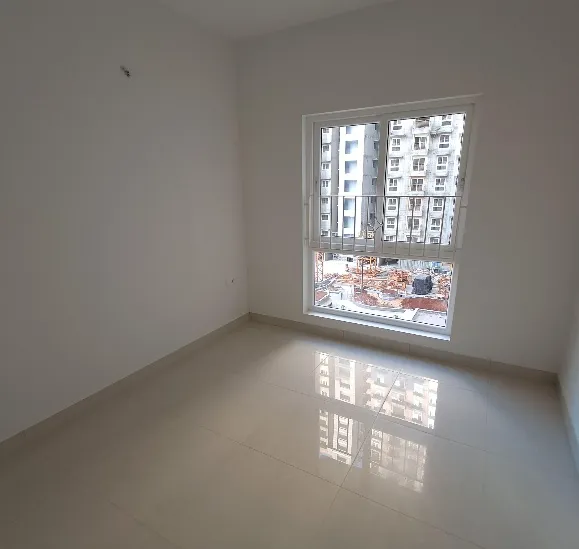

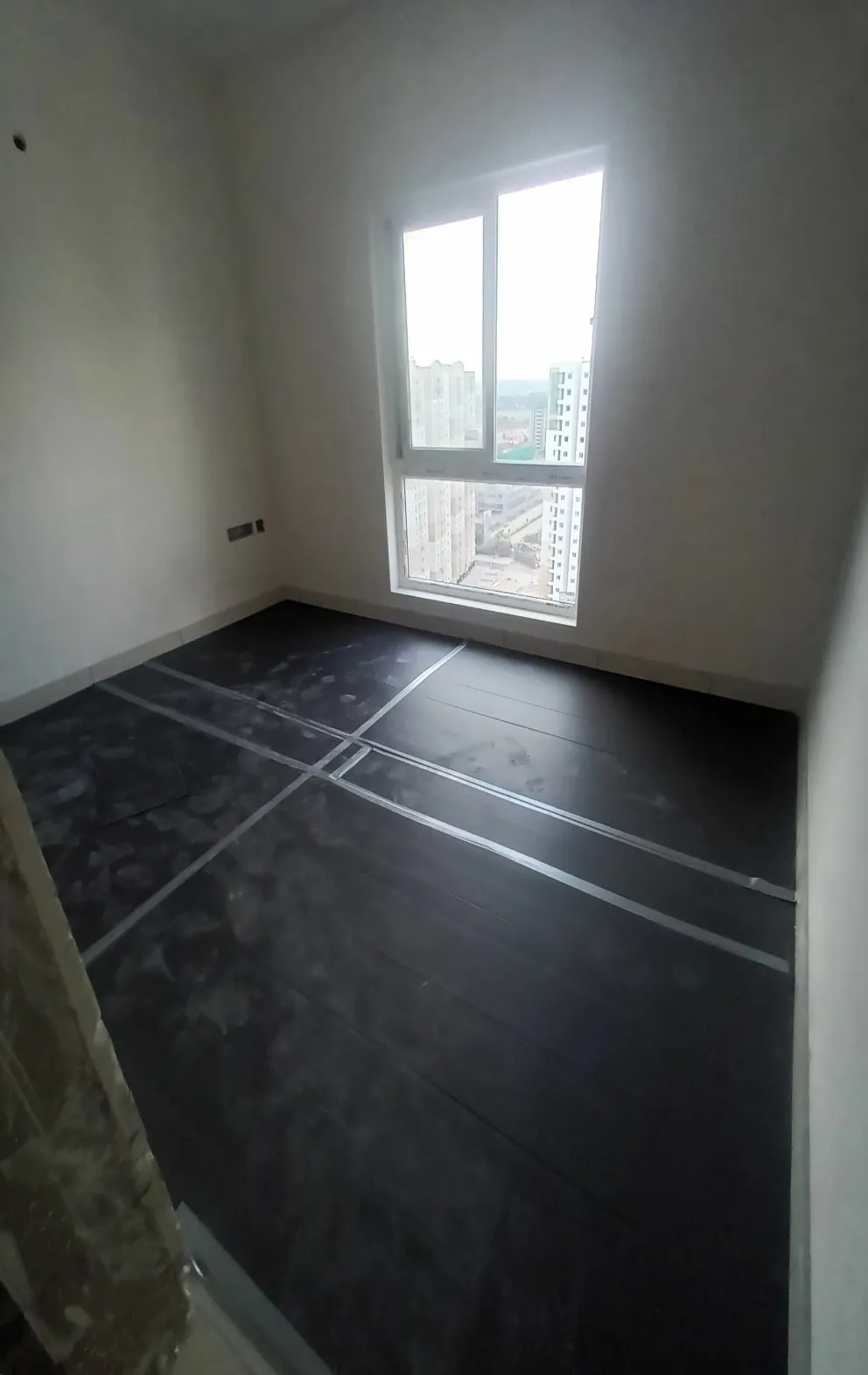

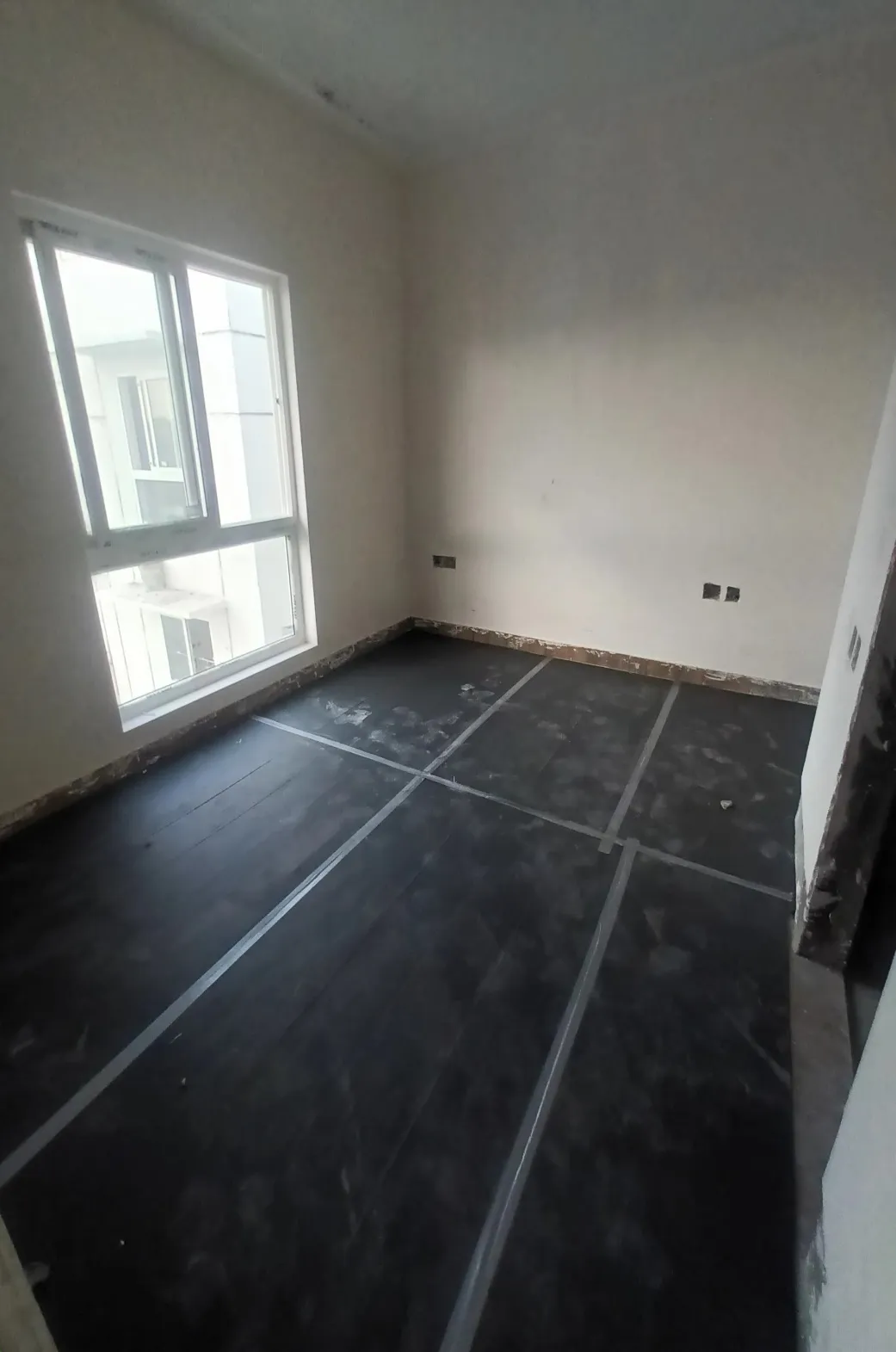

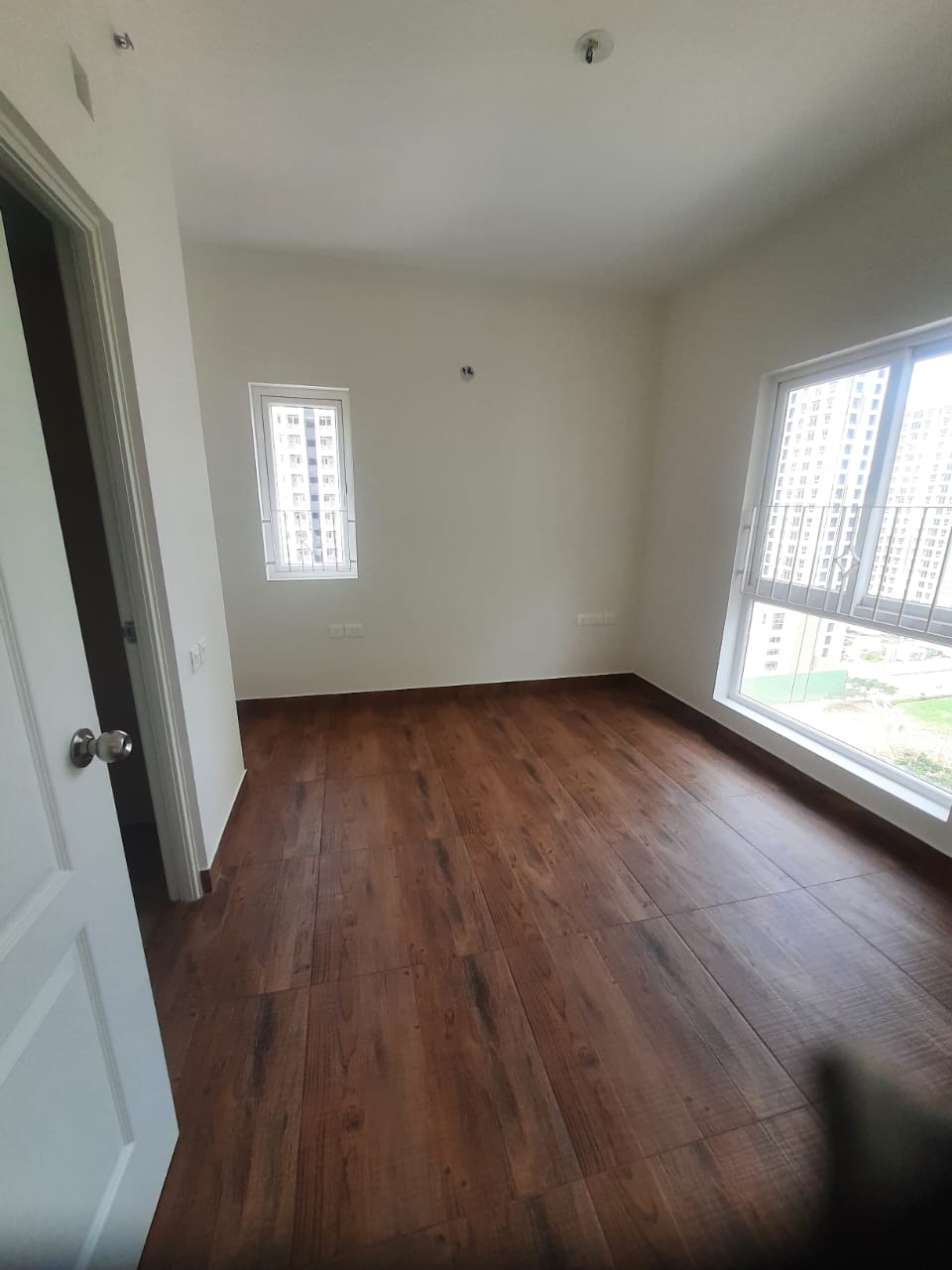

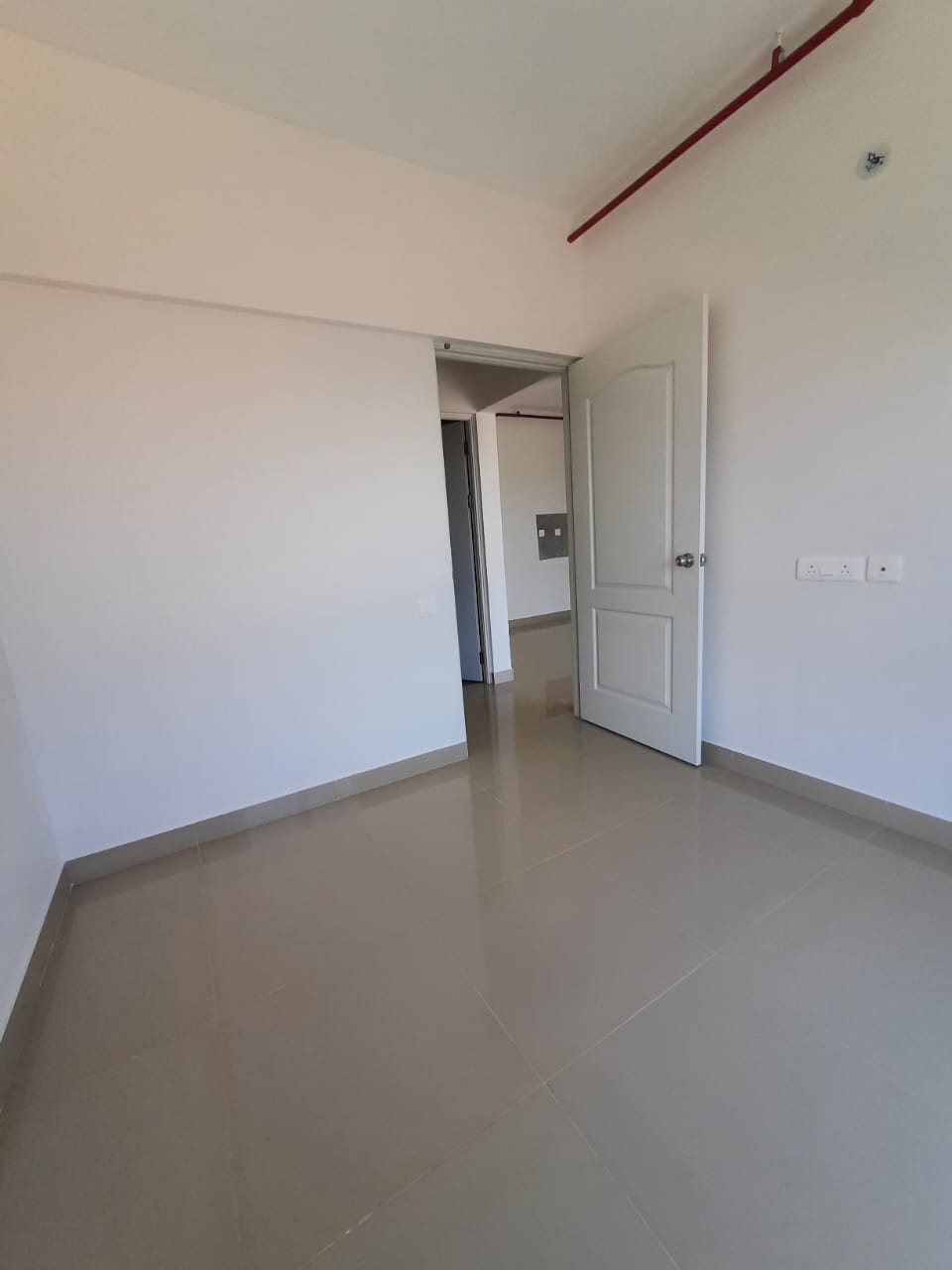

Internal flats Tiling flats completed 3rd floor tiling in progress - Jun 2025

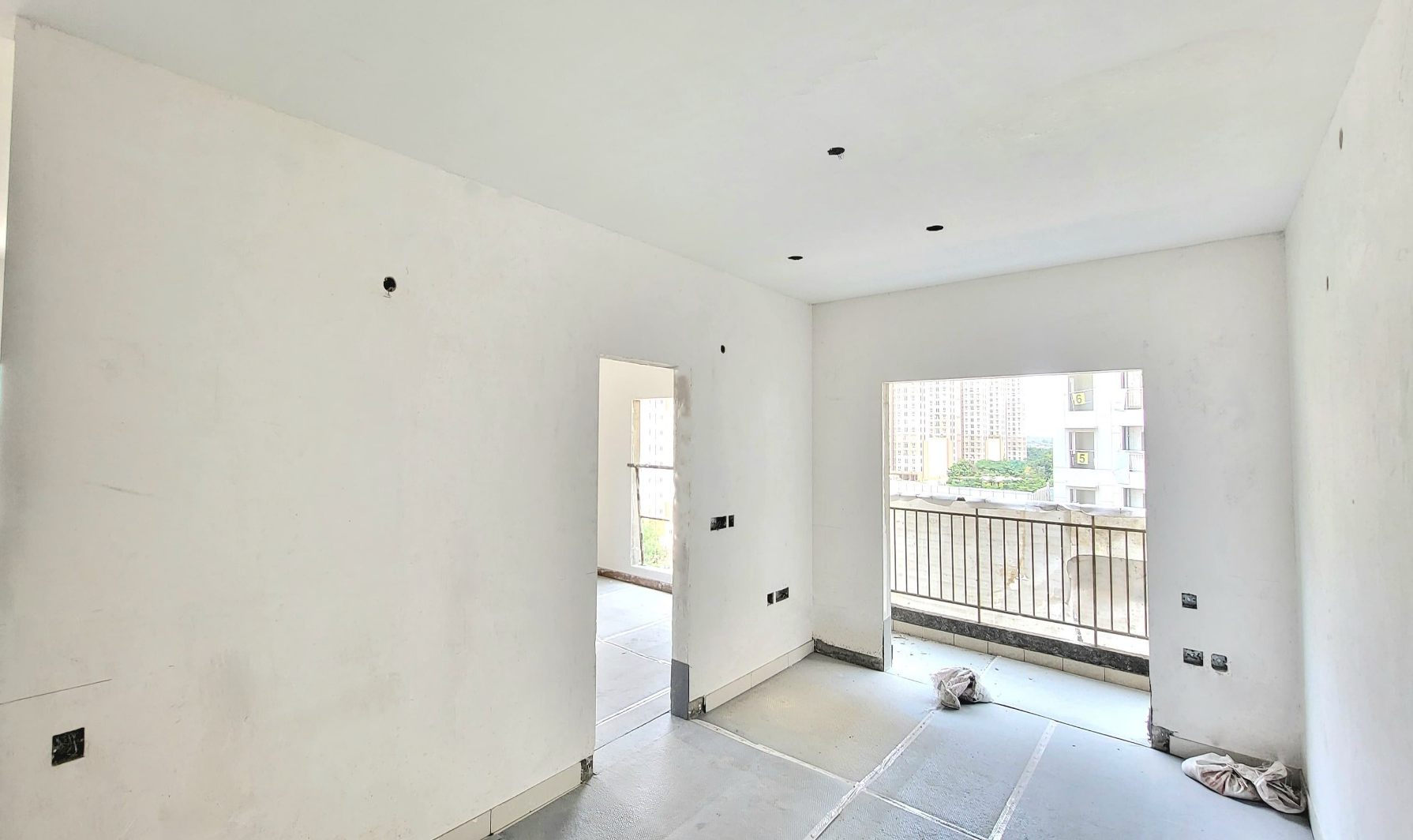

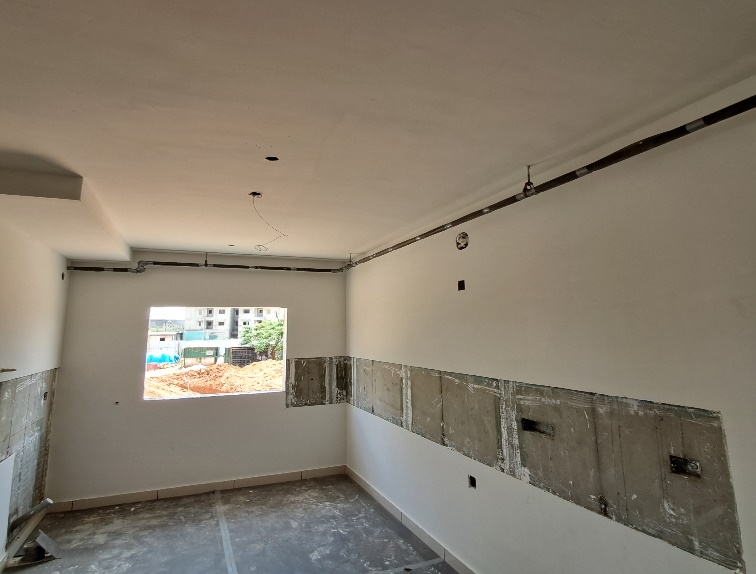

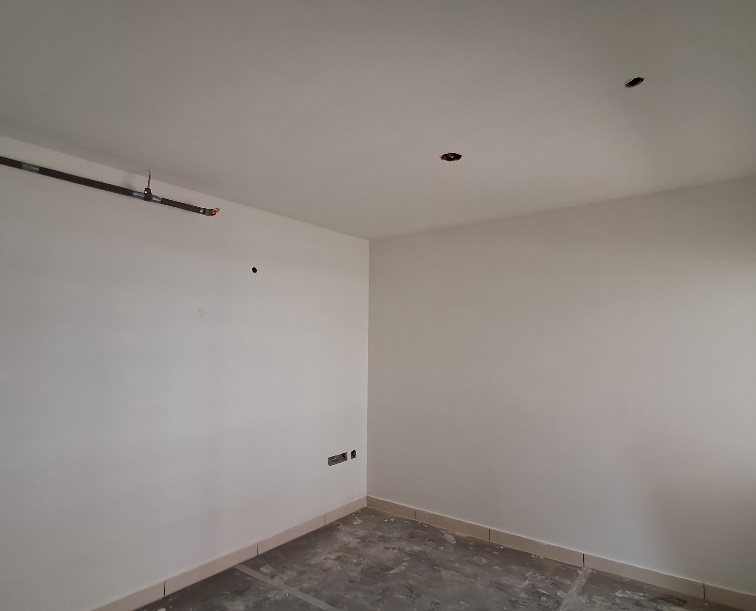

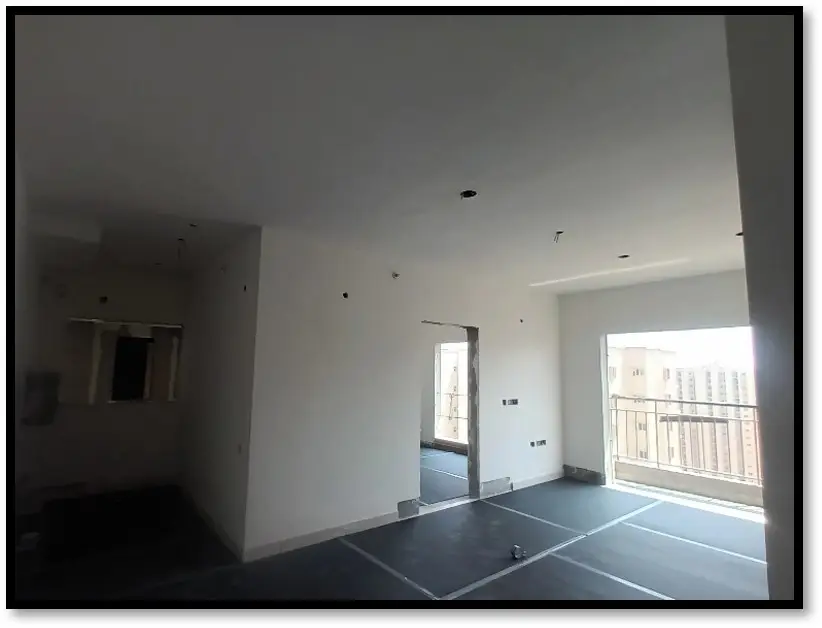

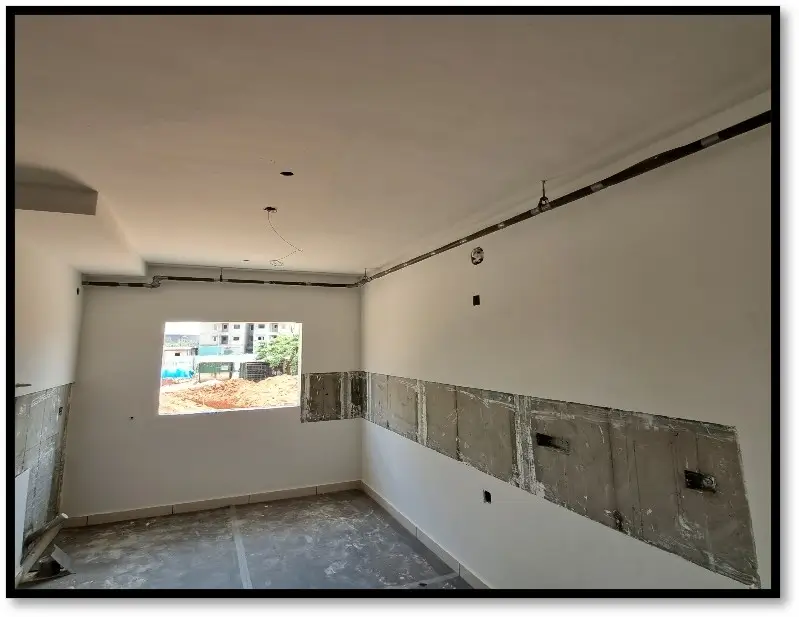

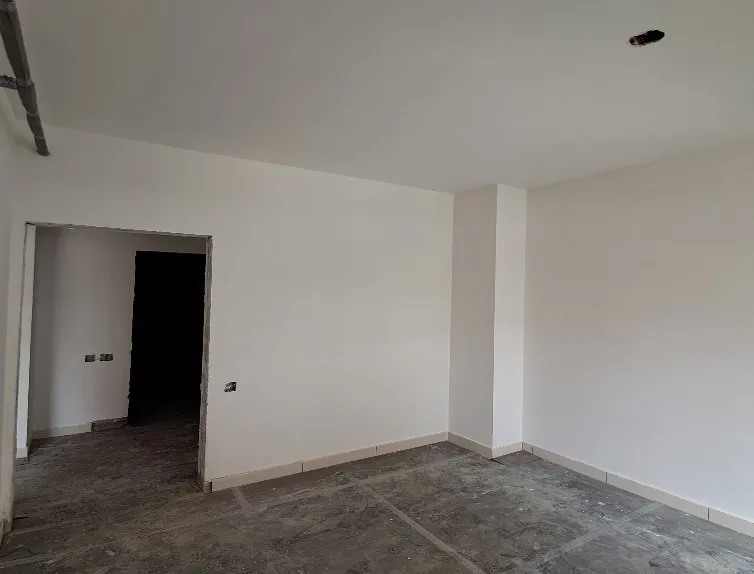

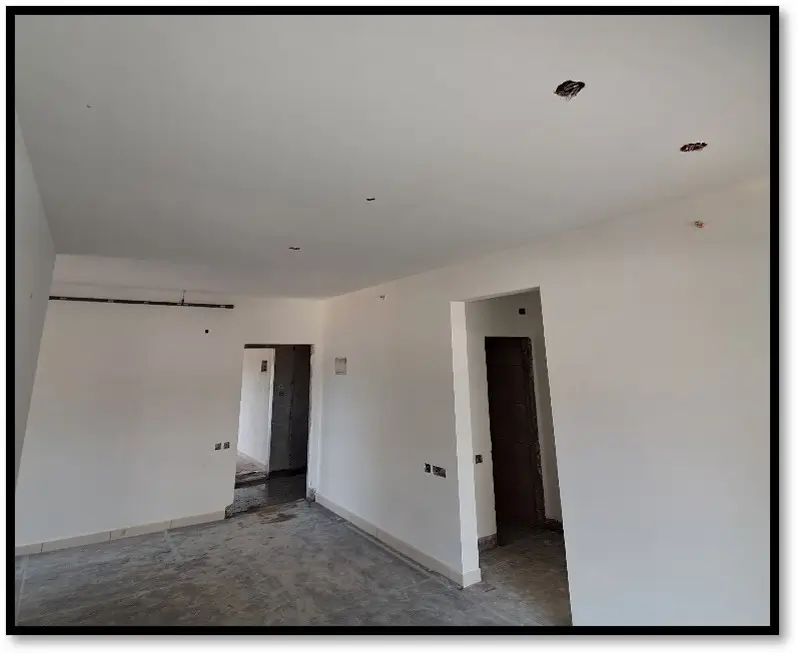

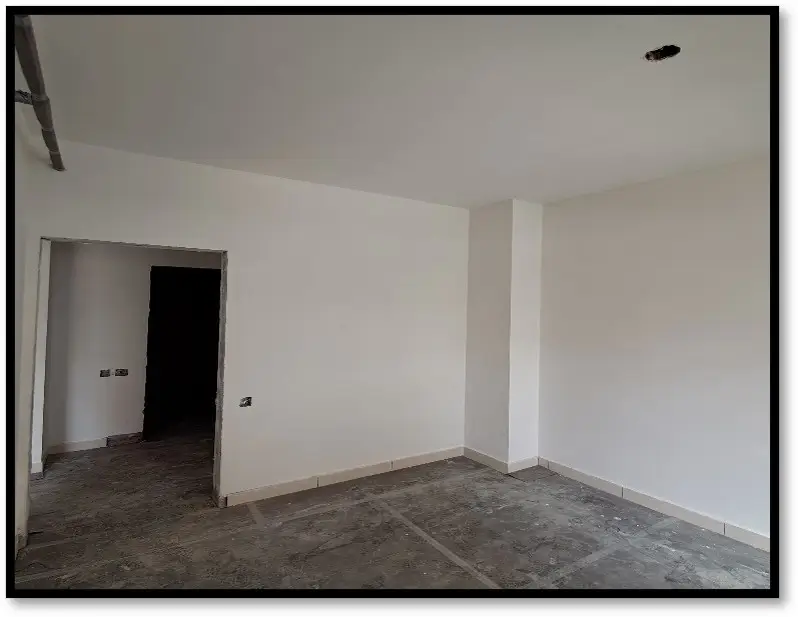

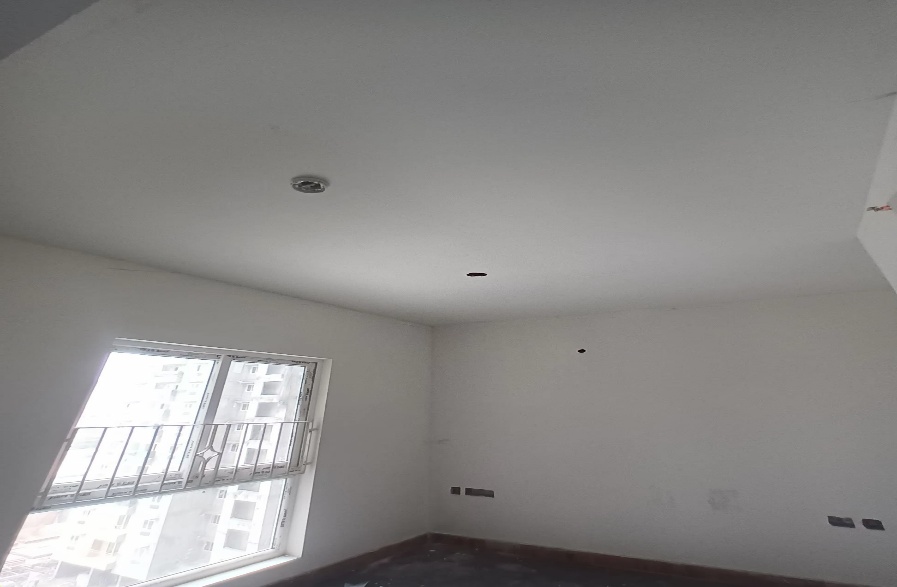

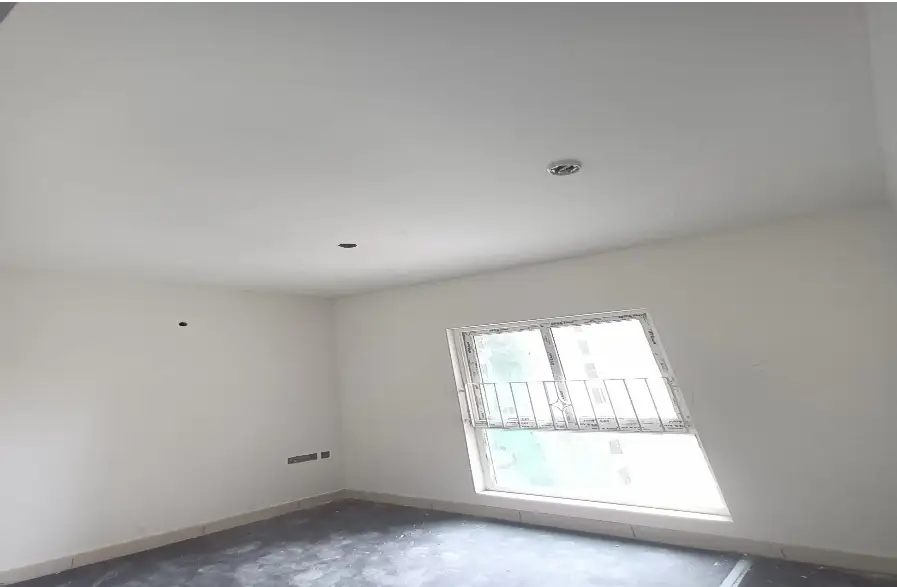

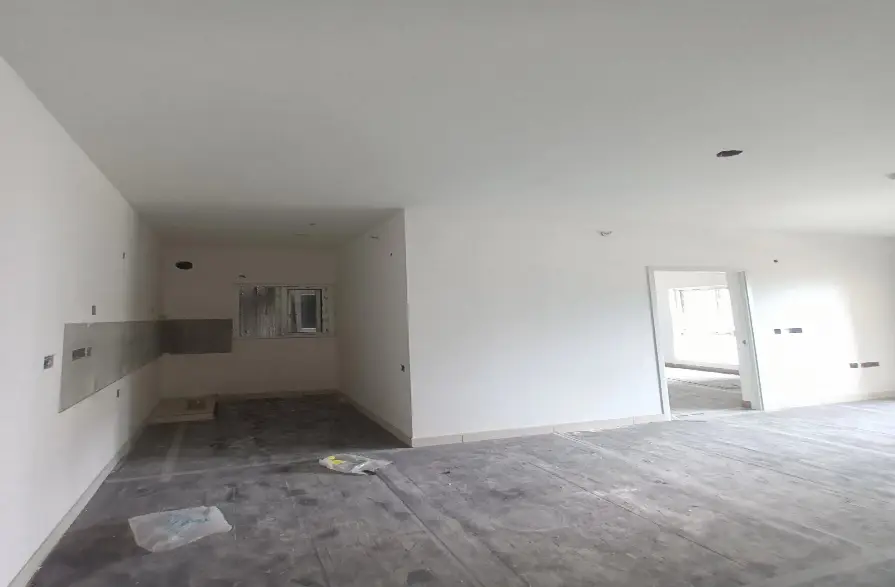

Internal flats Painting (Up to Primer) - flats started - Jun 2025

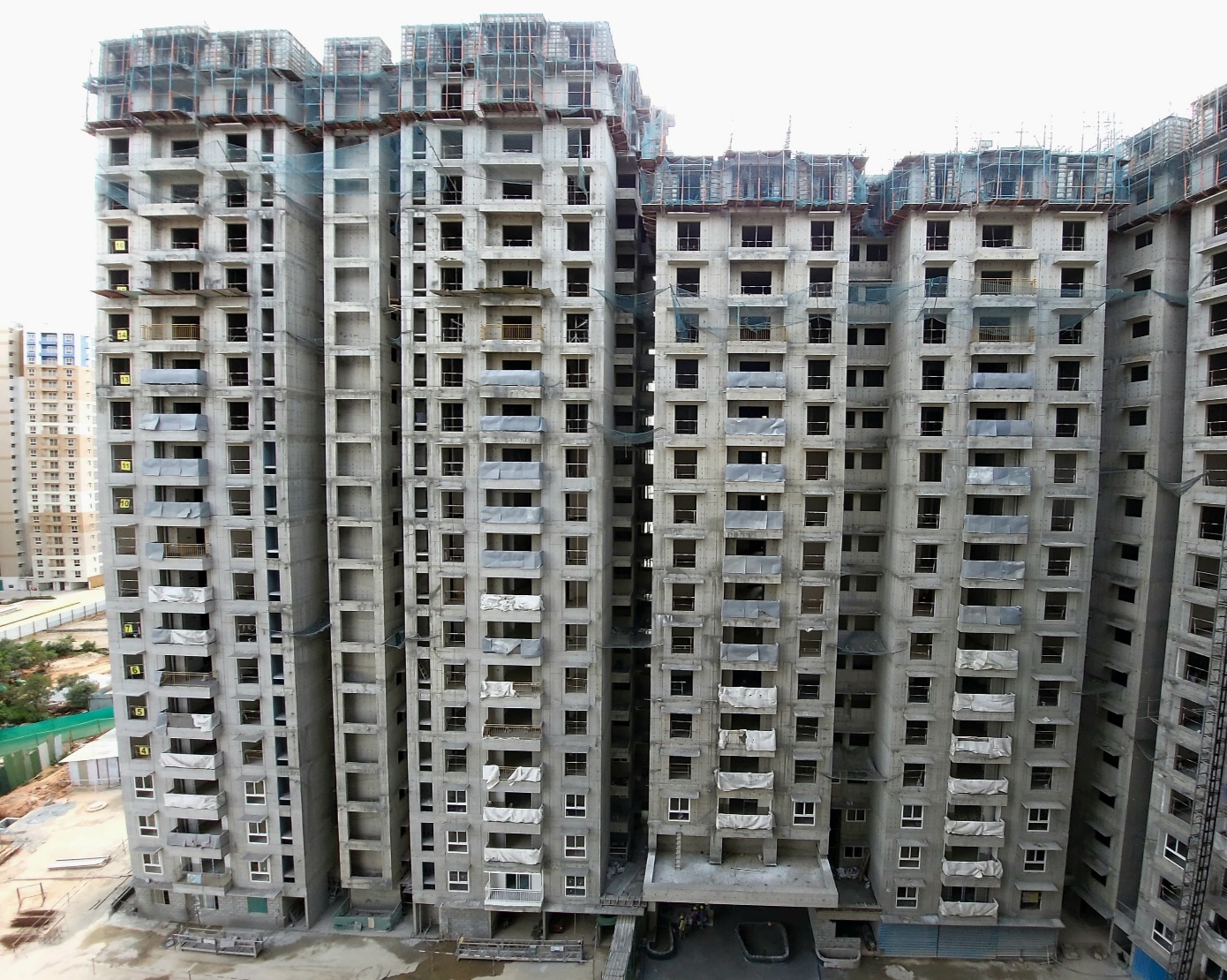

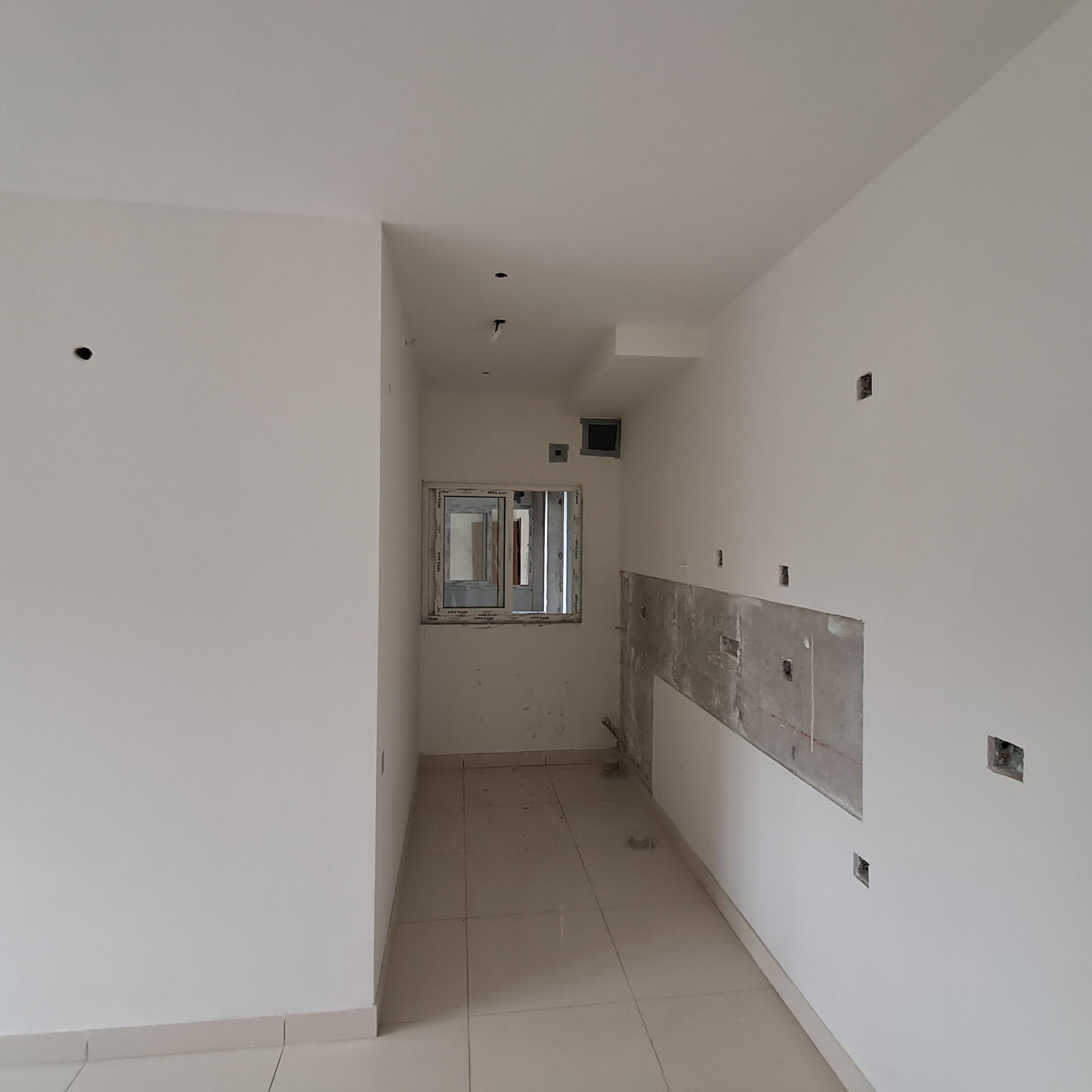

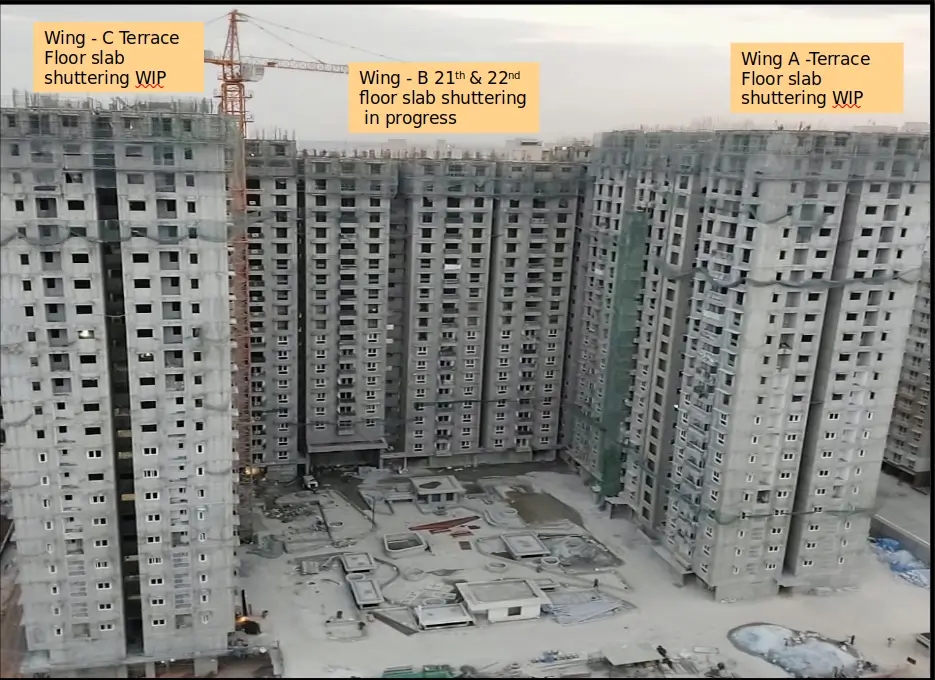

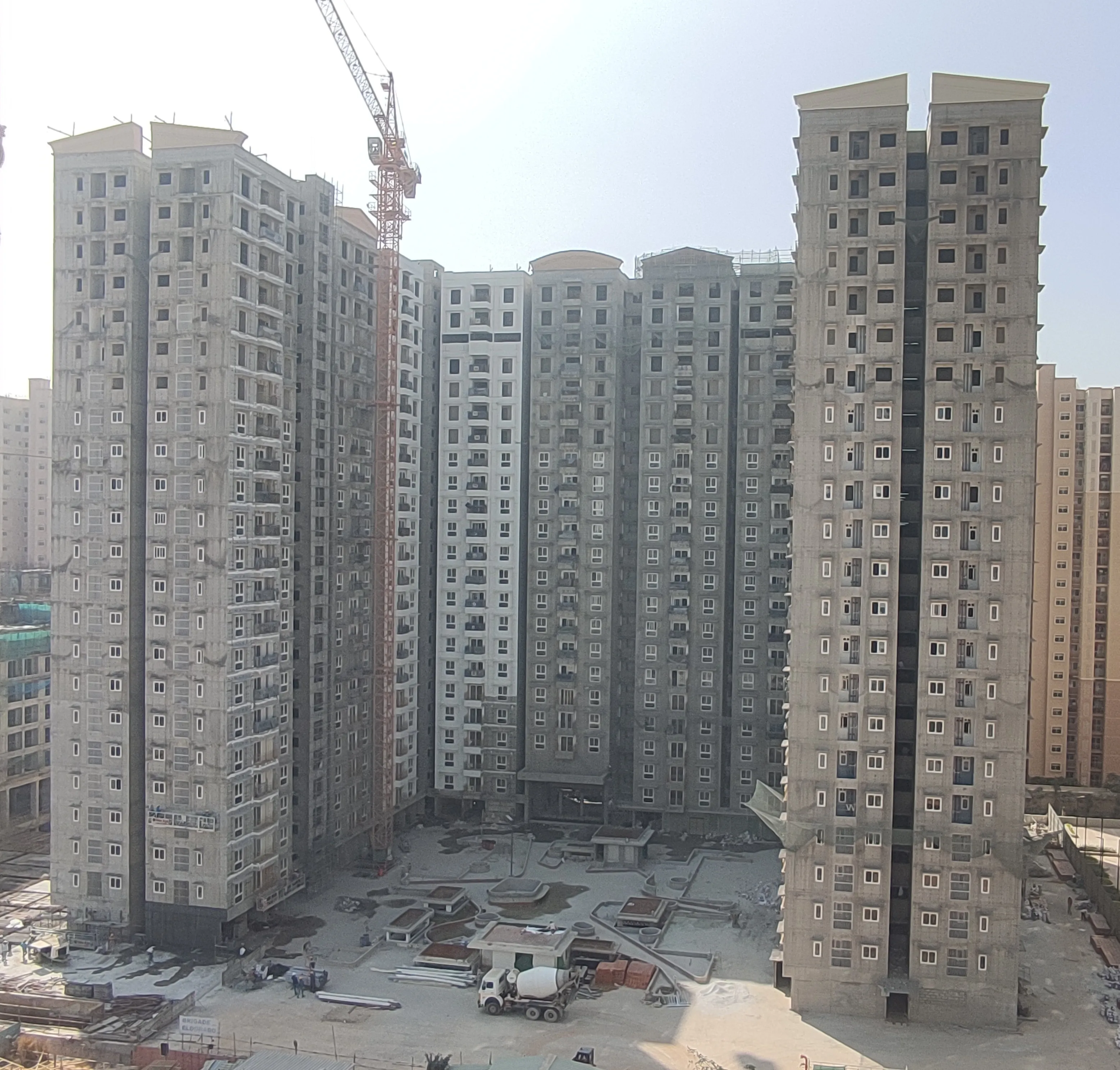

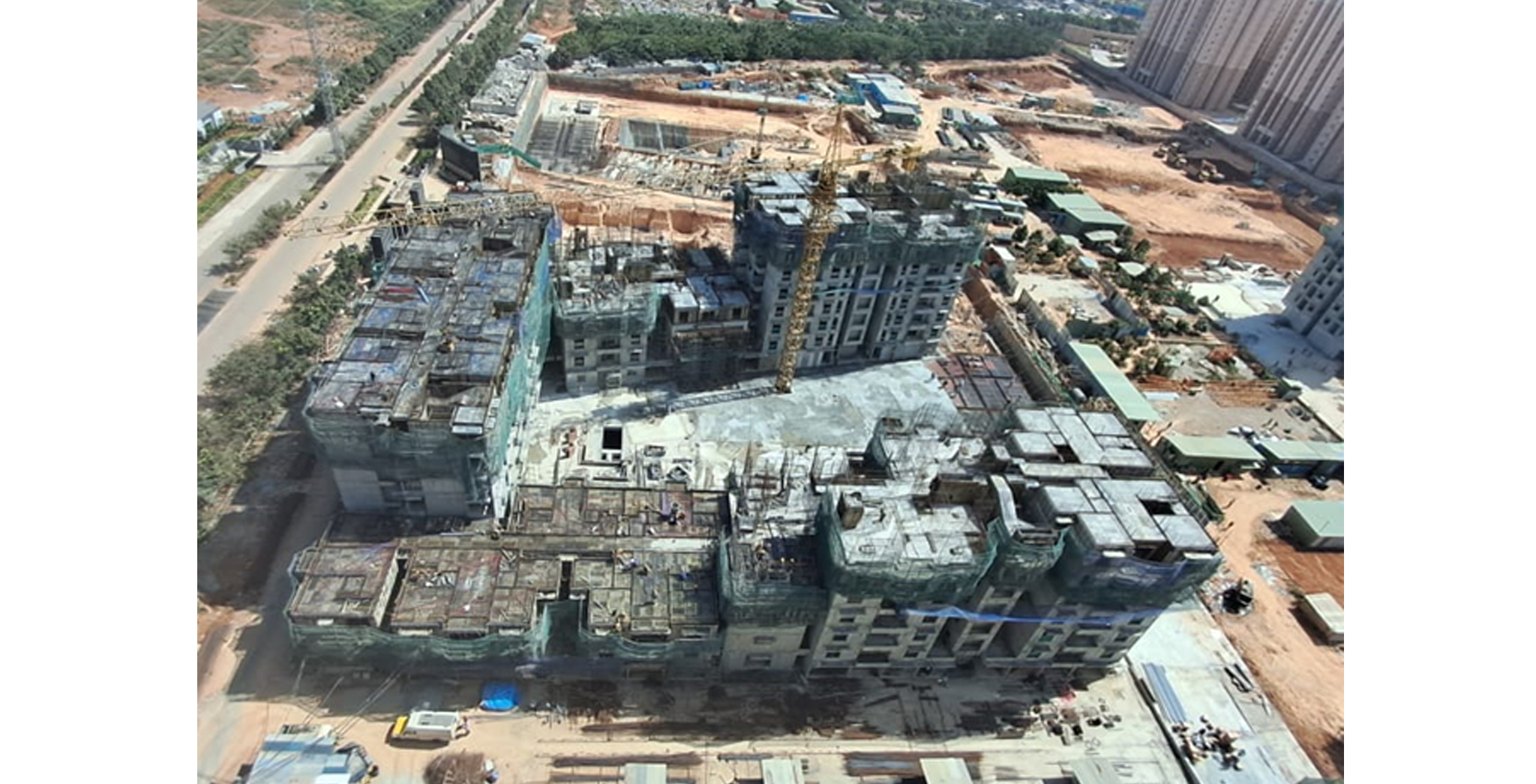

Project Progress Photos - Jun 2025

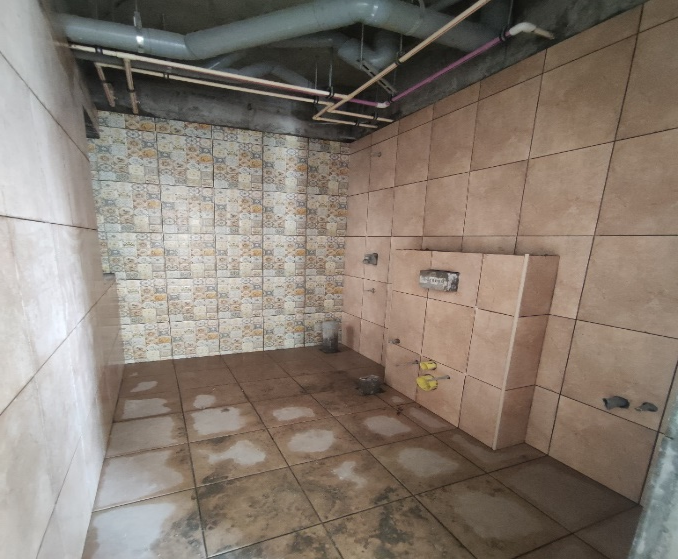

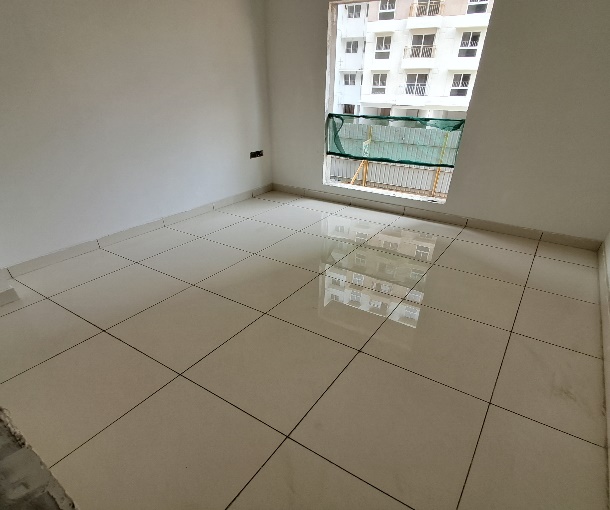

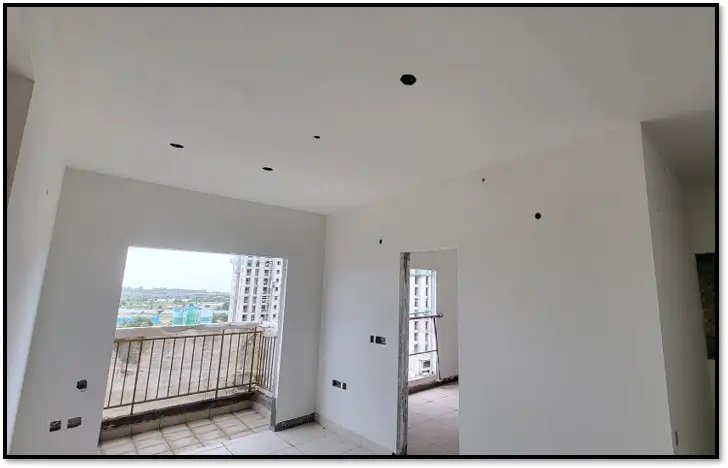

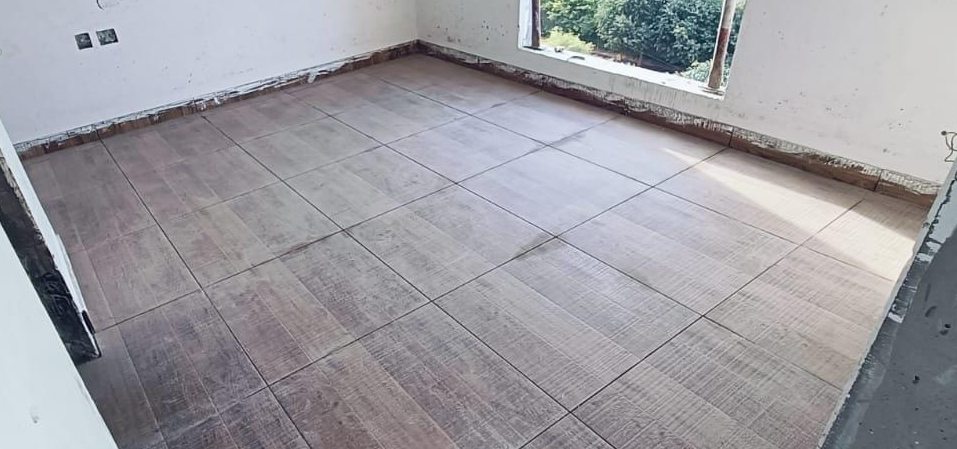

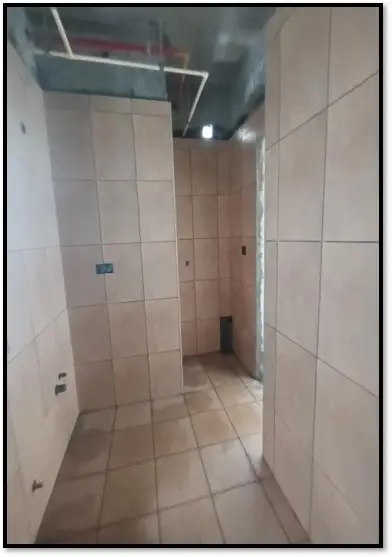

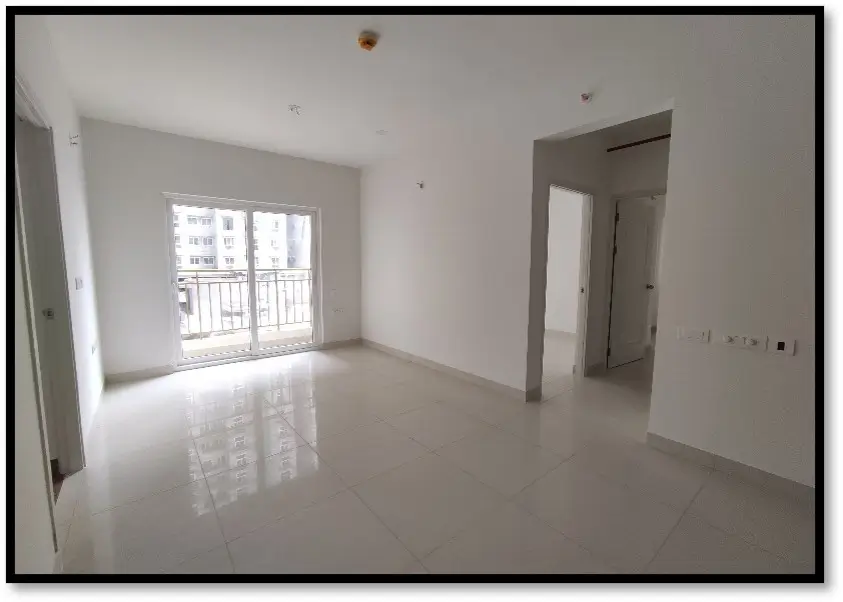

Internal flats Tiling flats completed 3rd floor tiling in progress - Jun 2025

Internal flats Tiling flats completed 3rd floor tiling in progress - Jun 2025

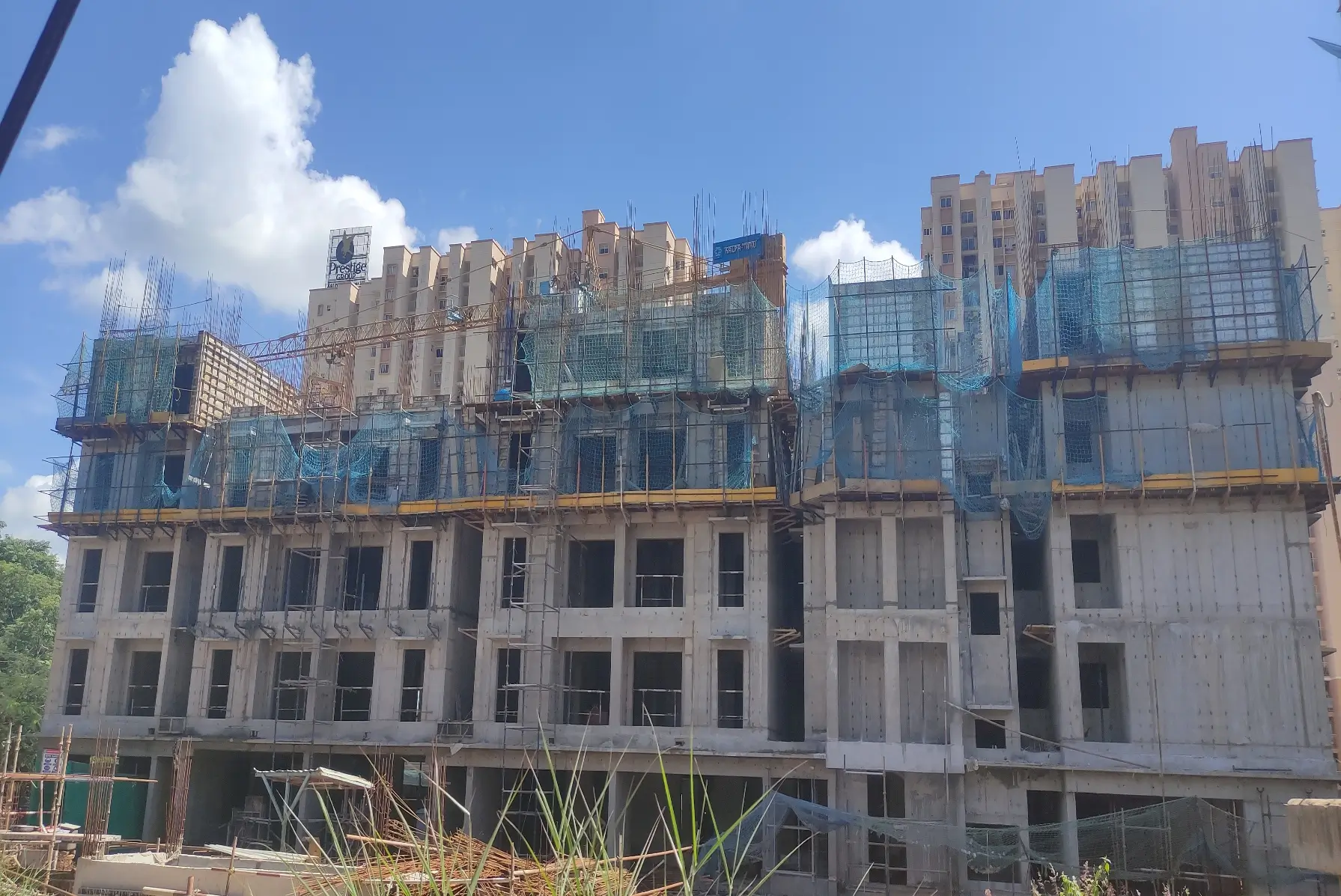

5th floor Internal flats Gypsum punning work in progress - Jun 2025

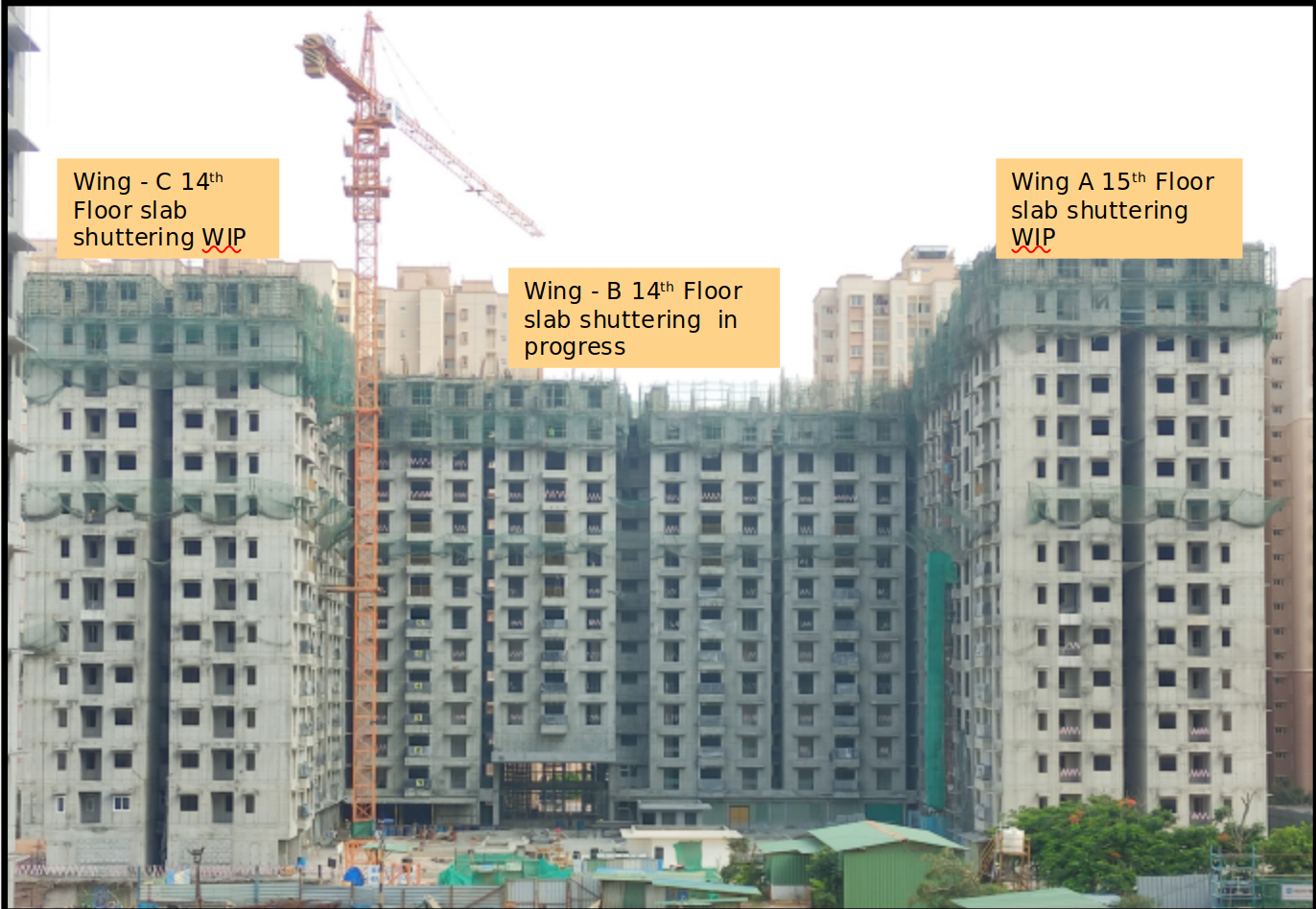

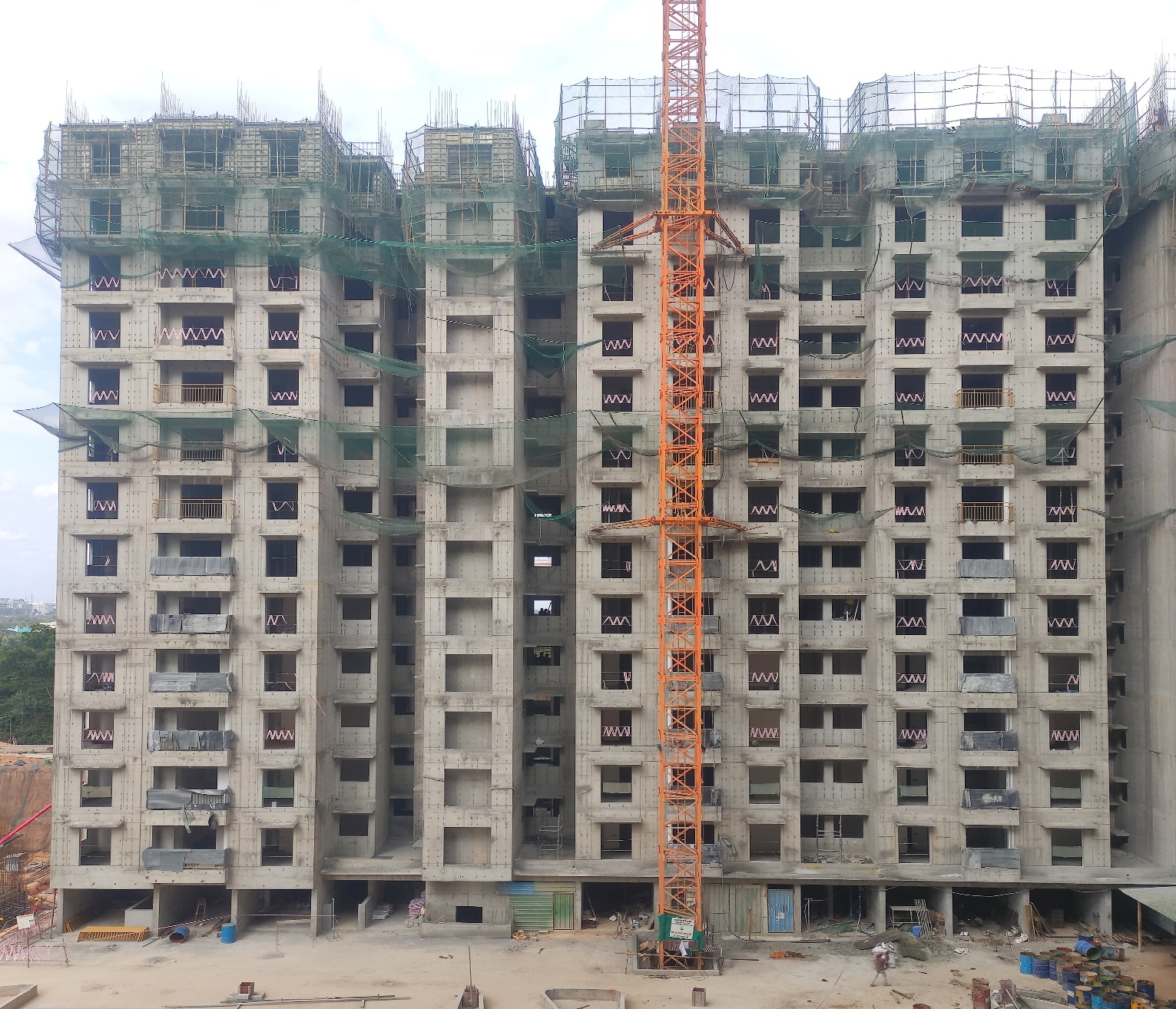

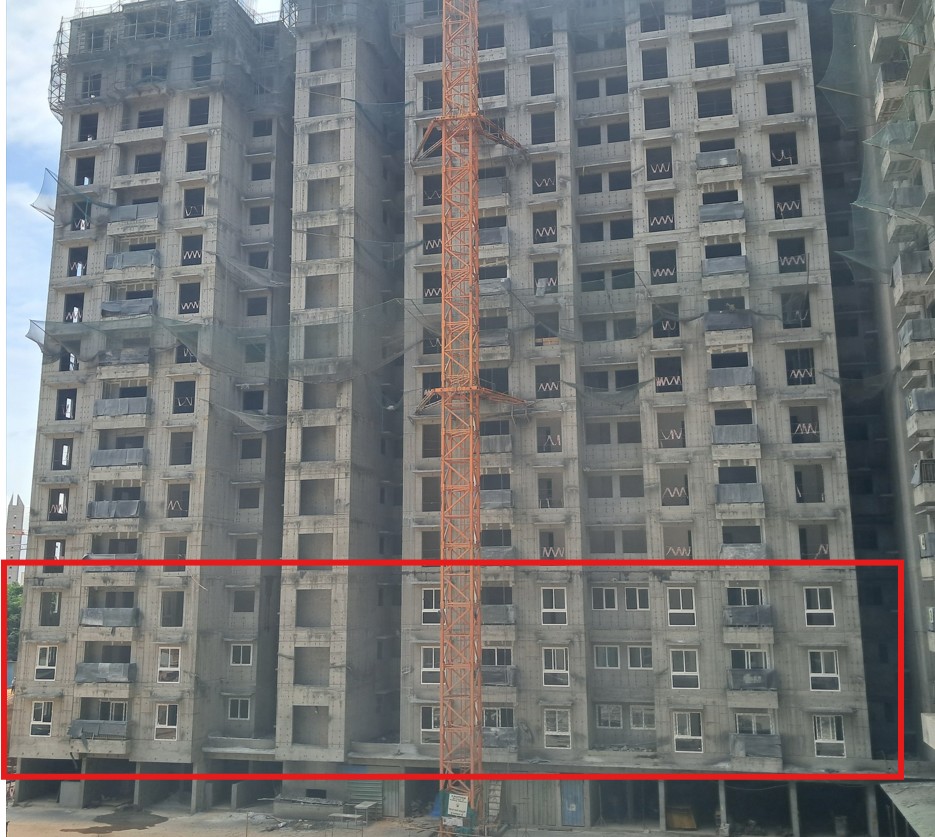

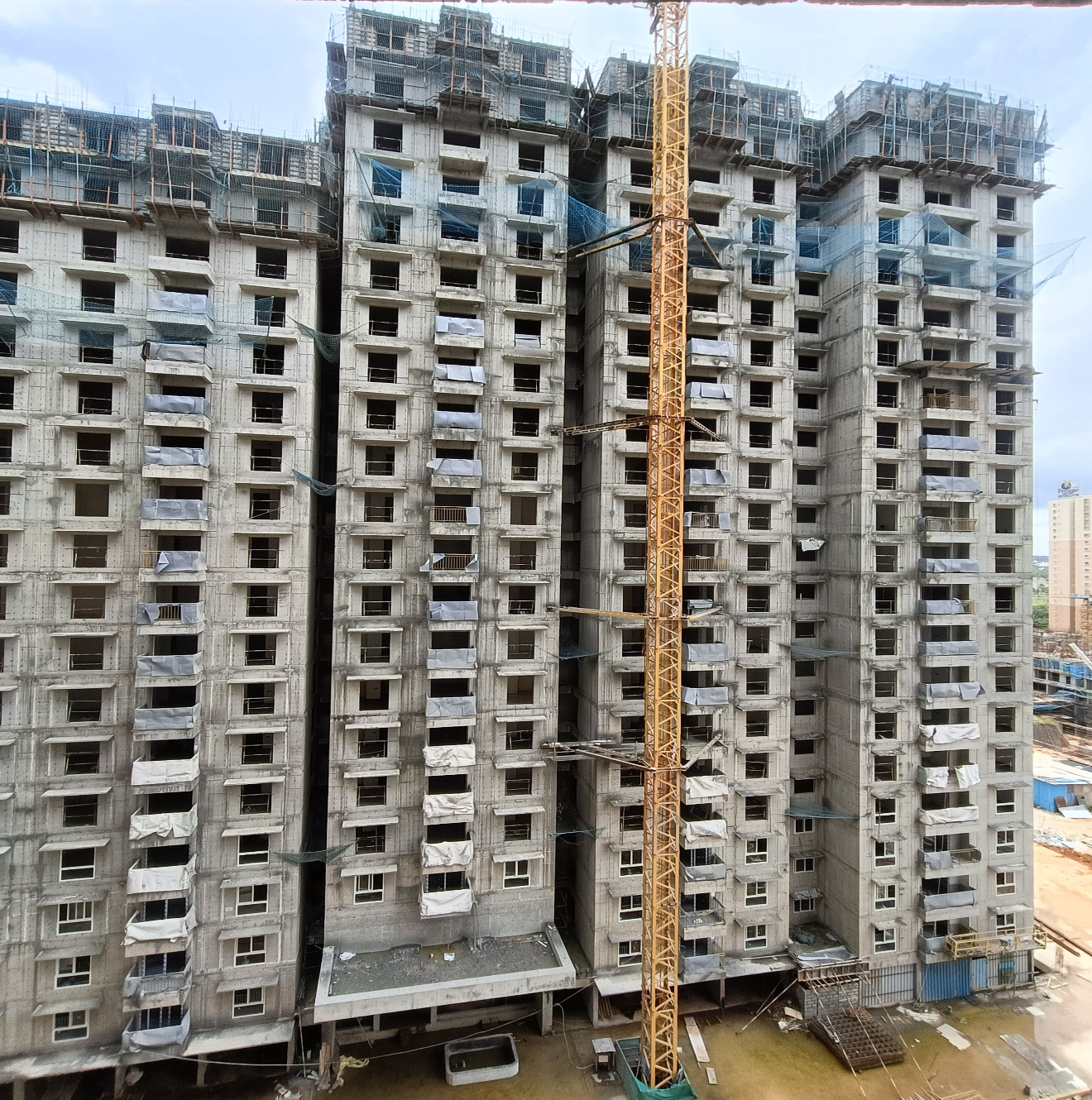

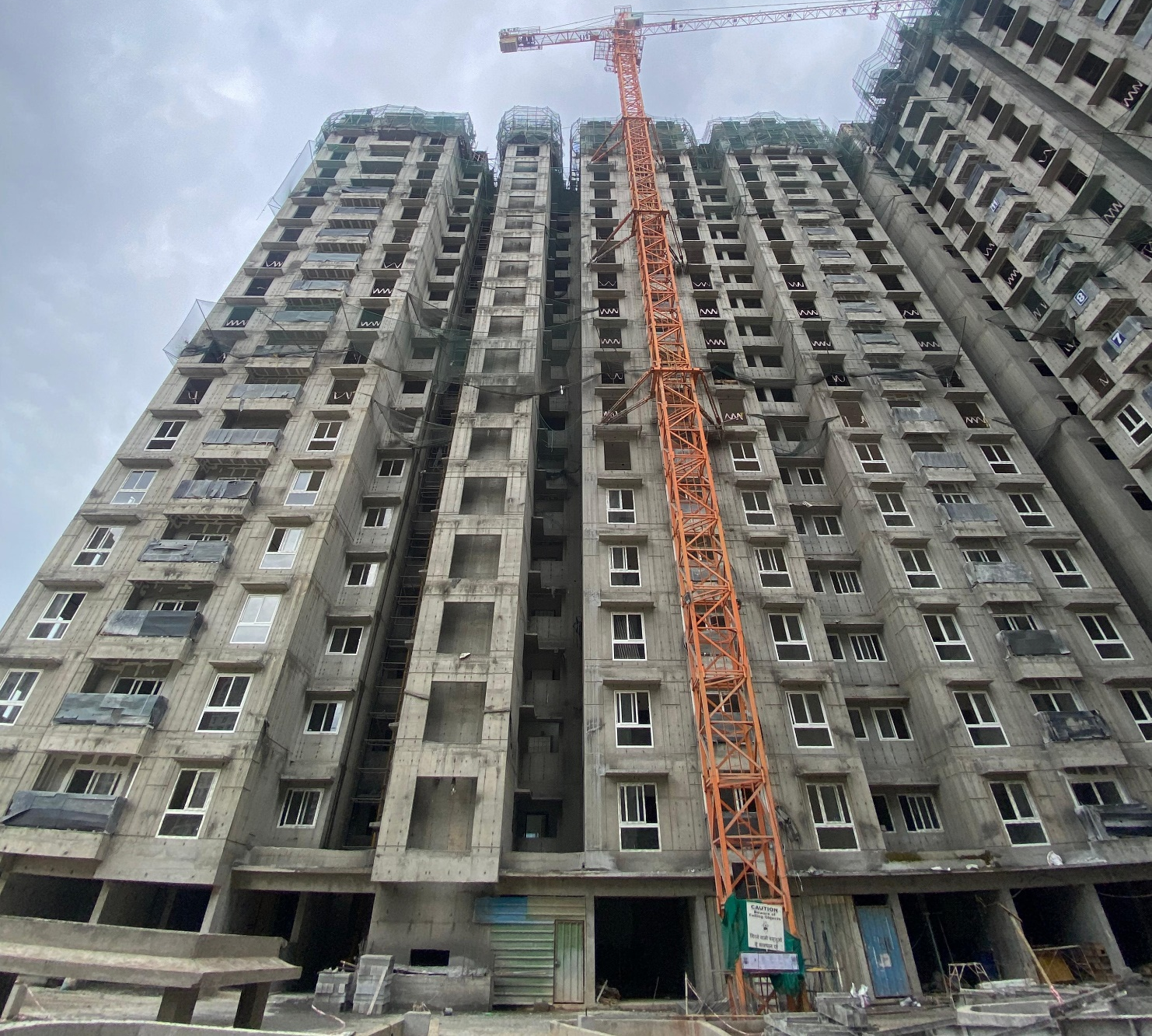

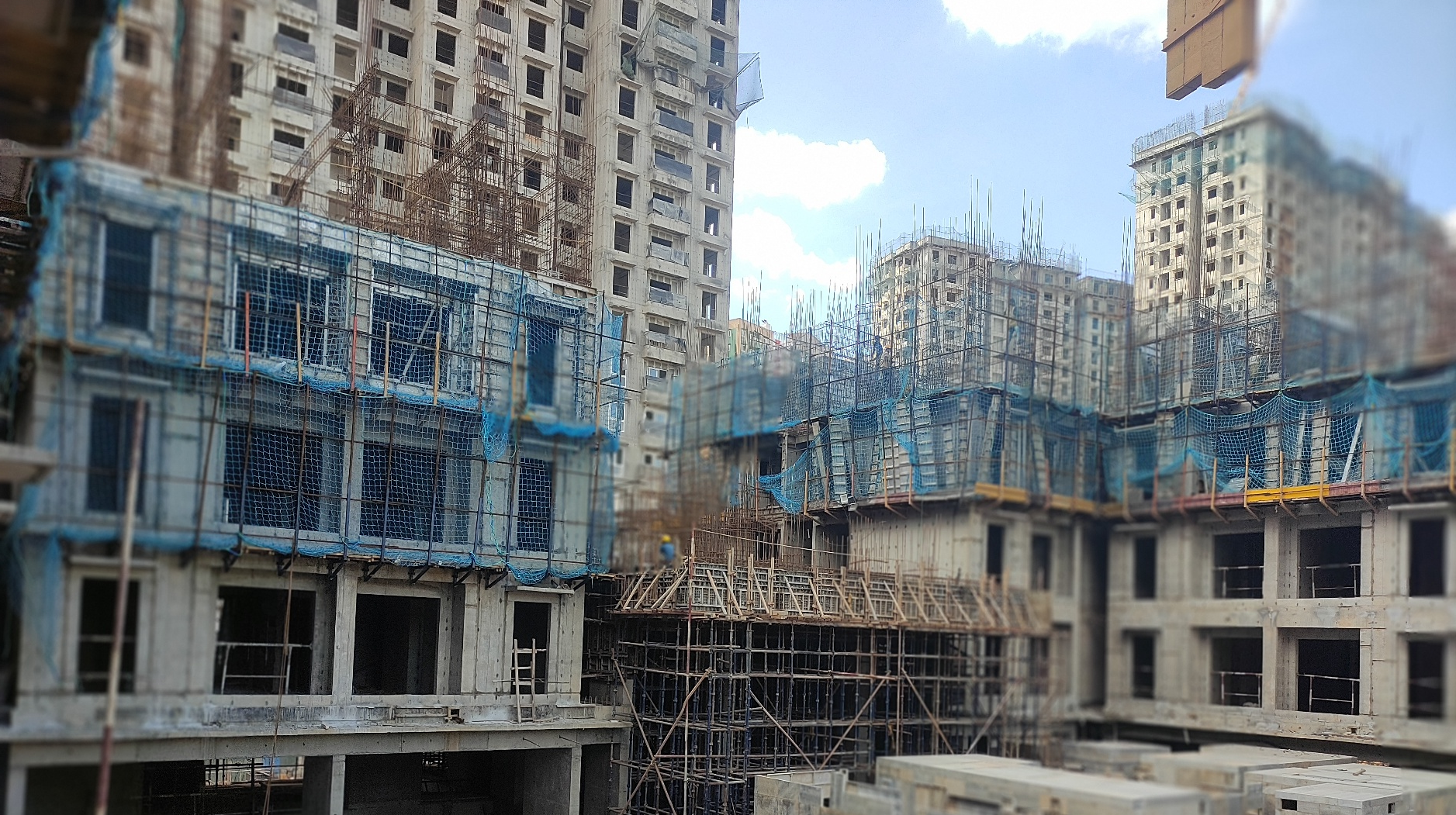

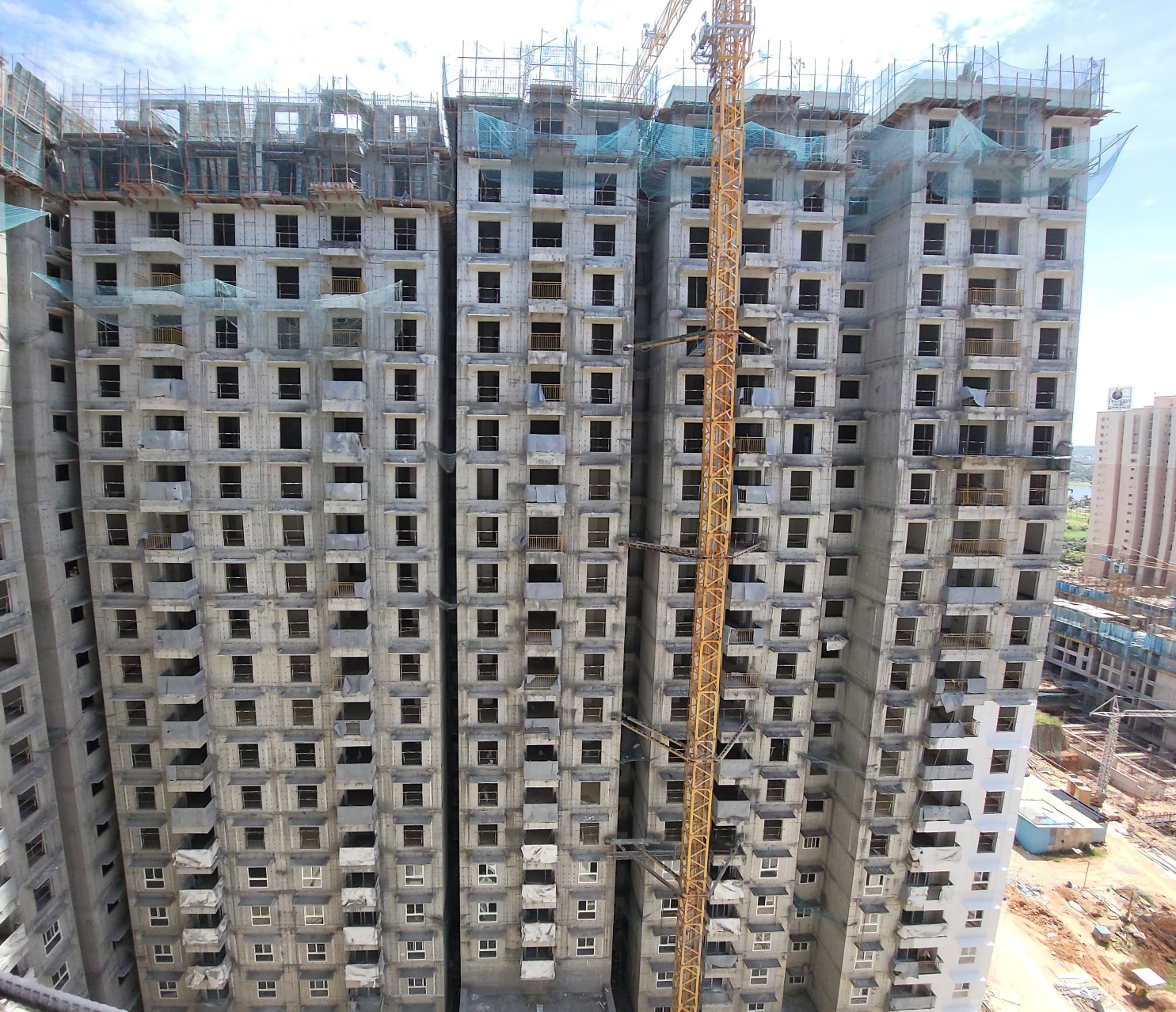

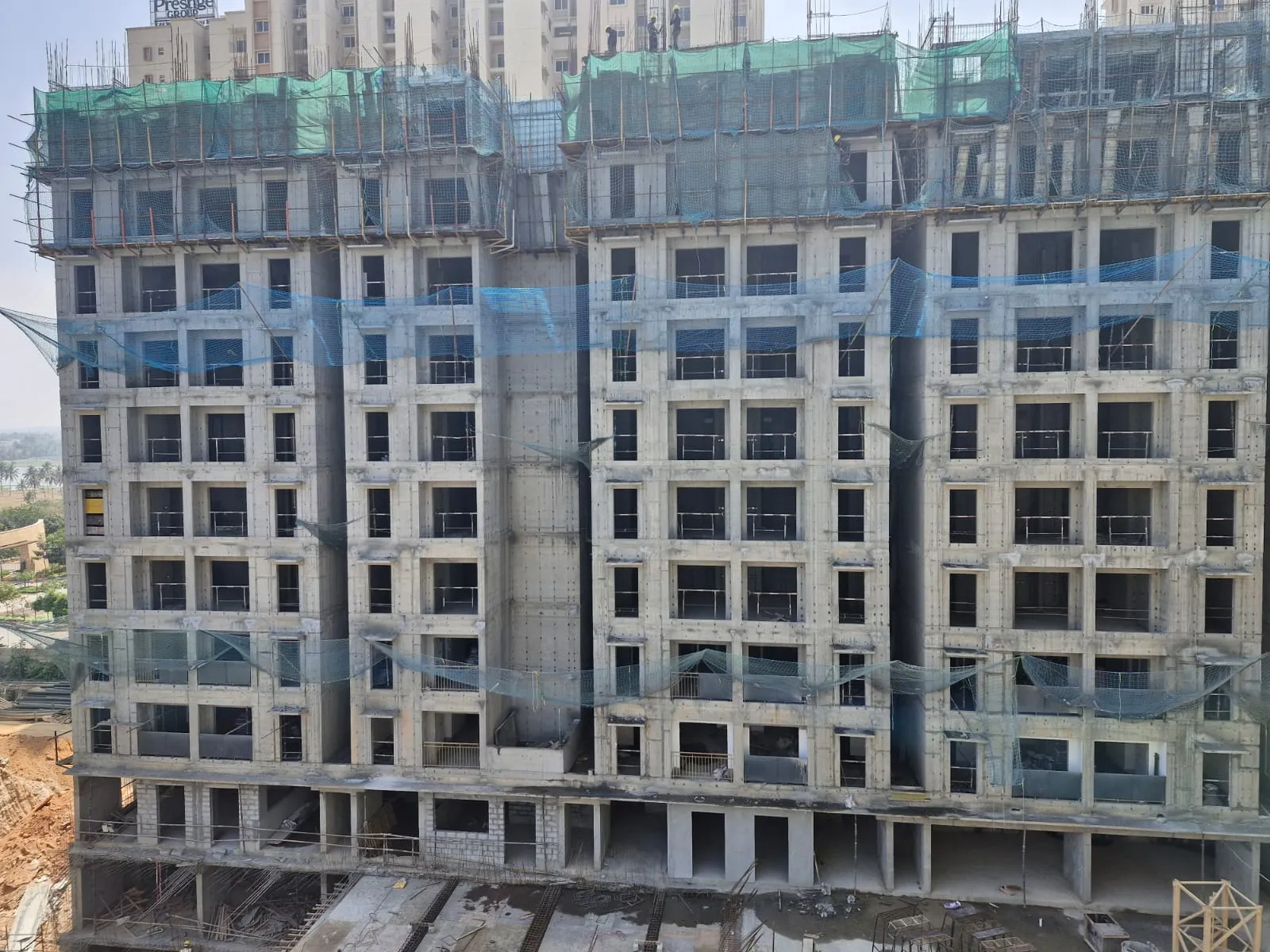

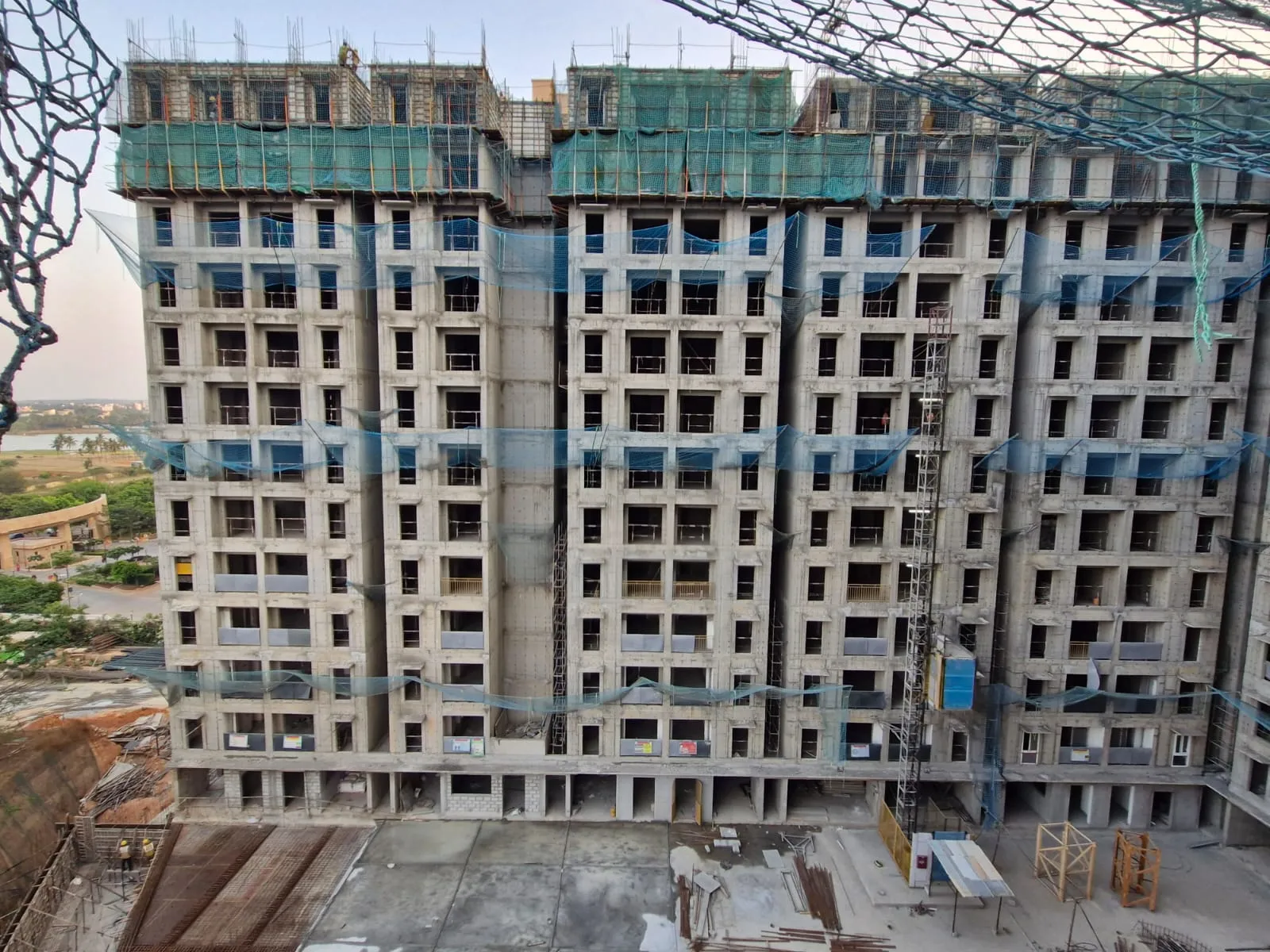

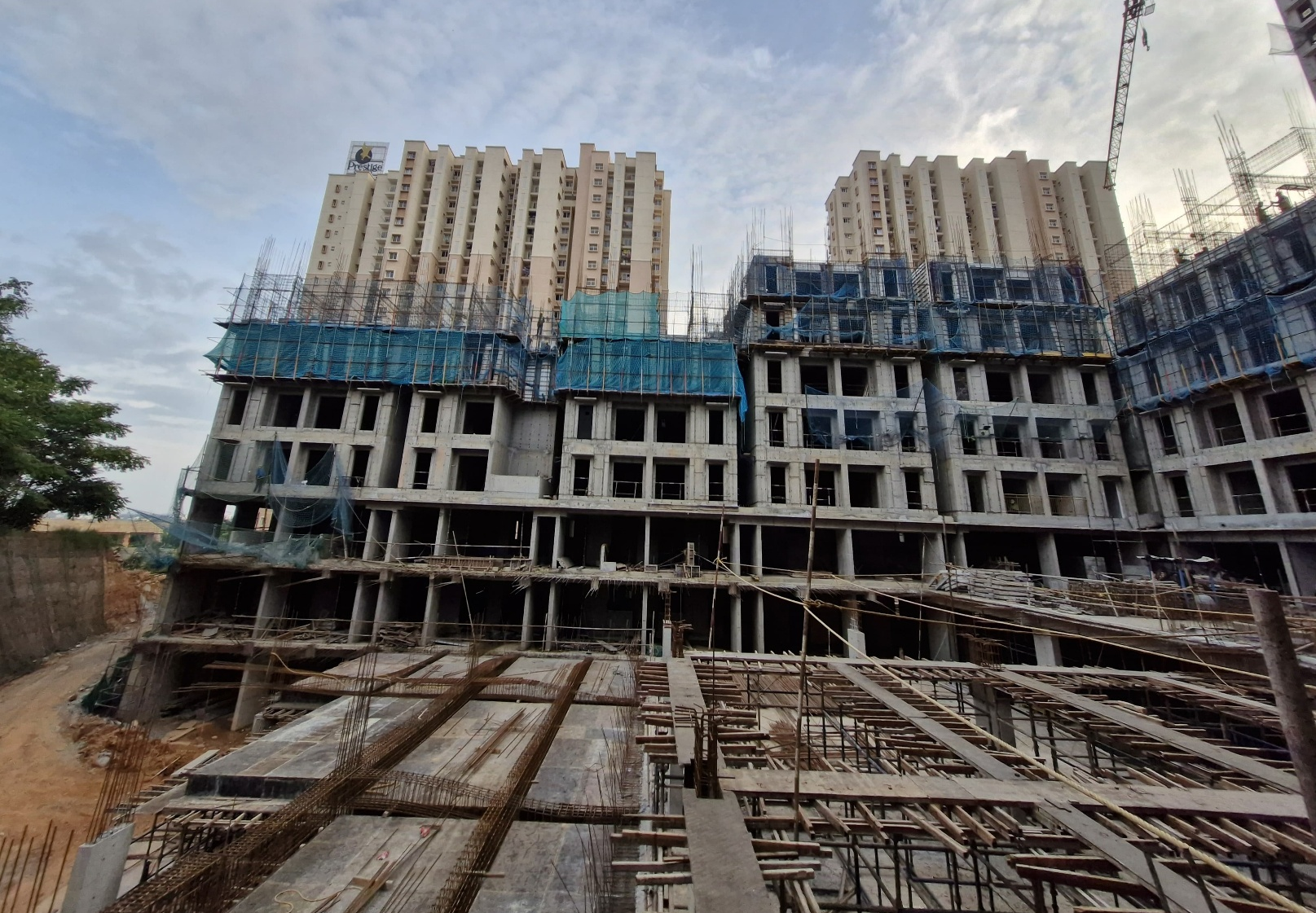

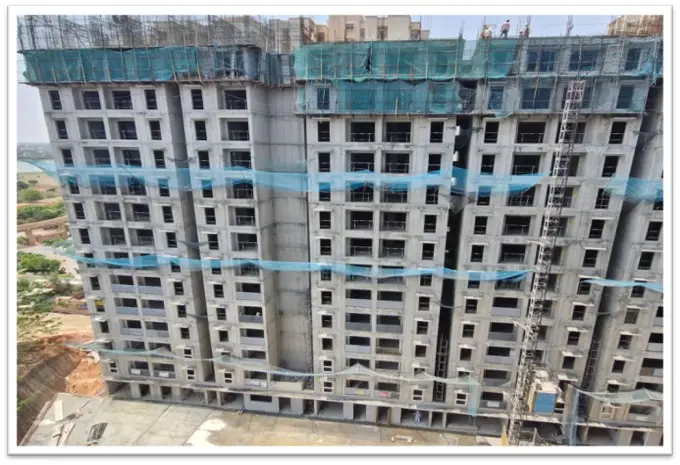

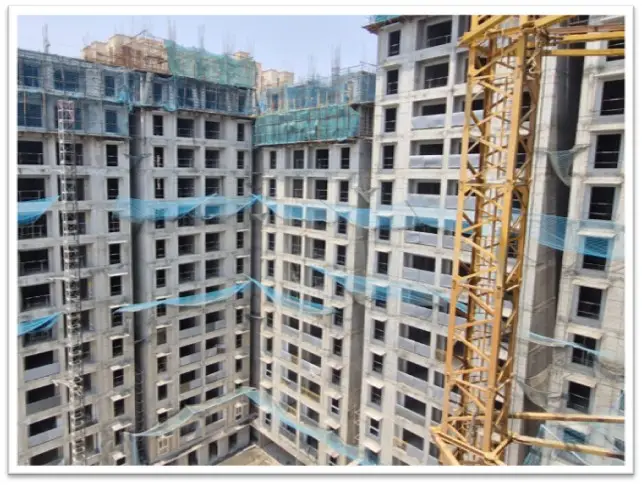

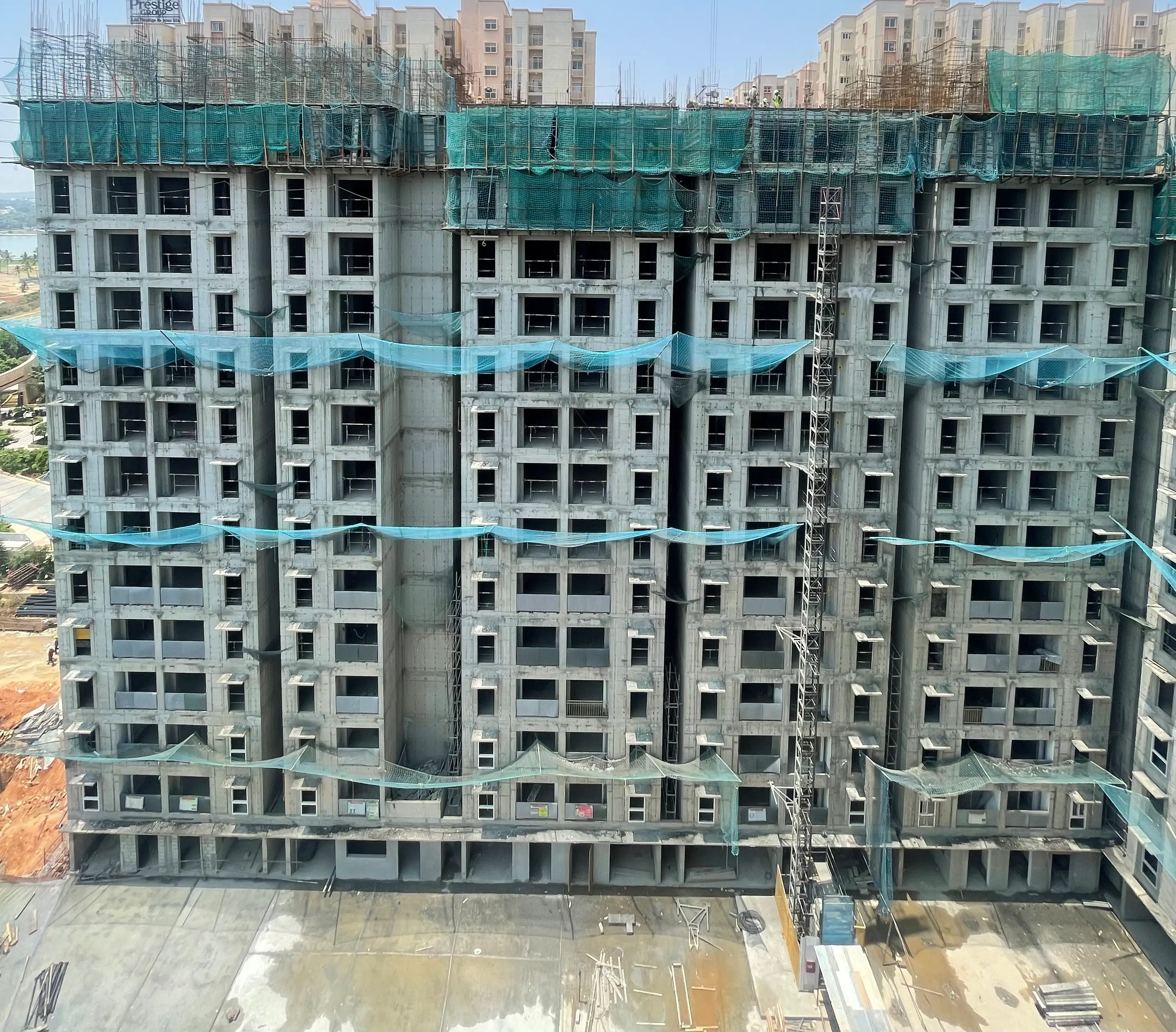

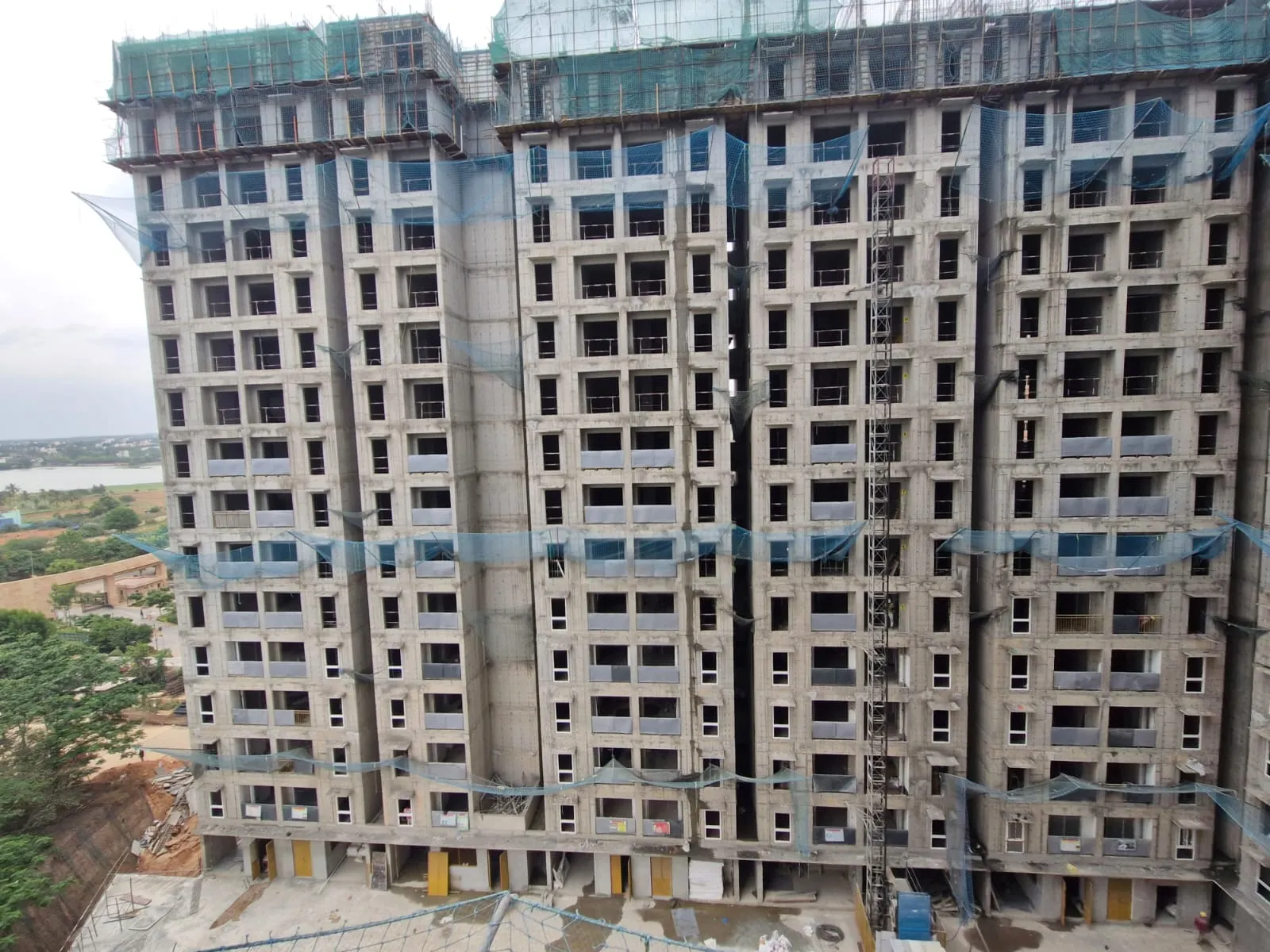

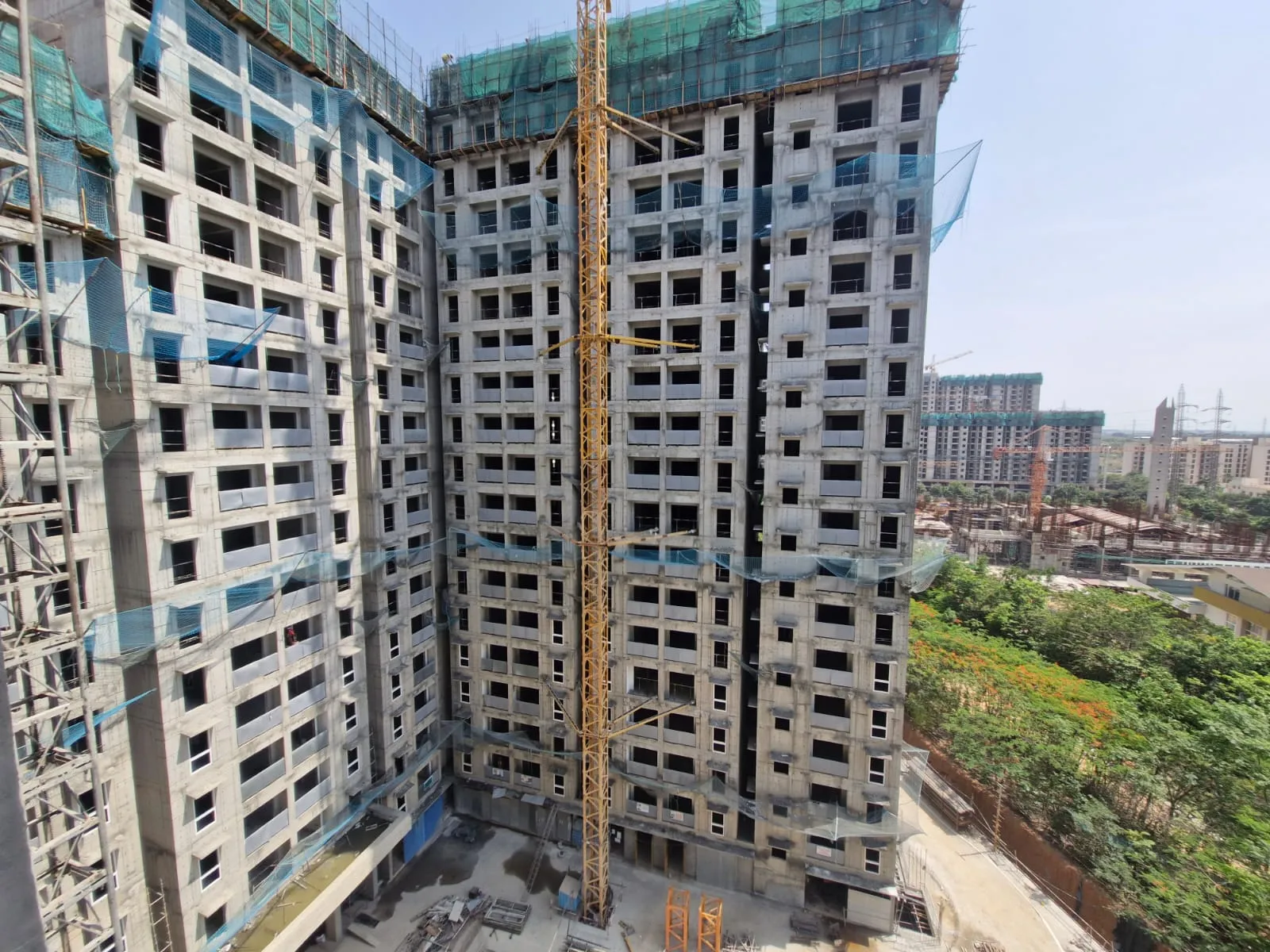

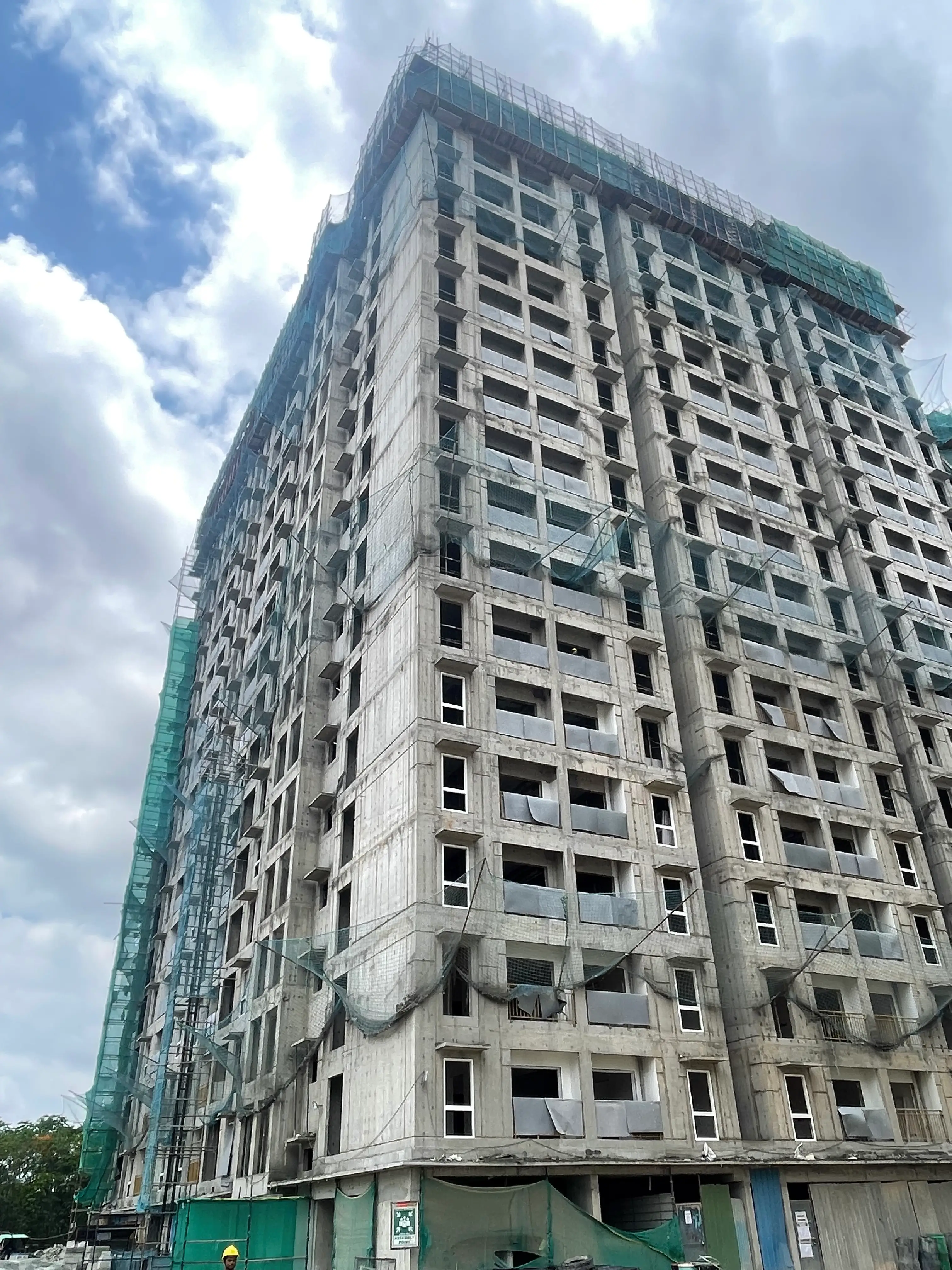

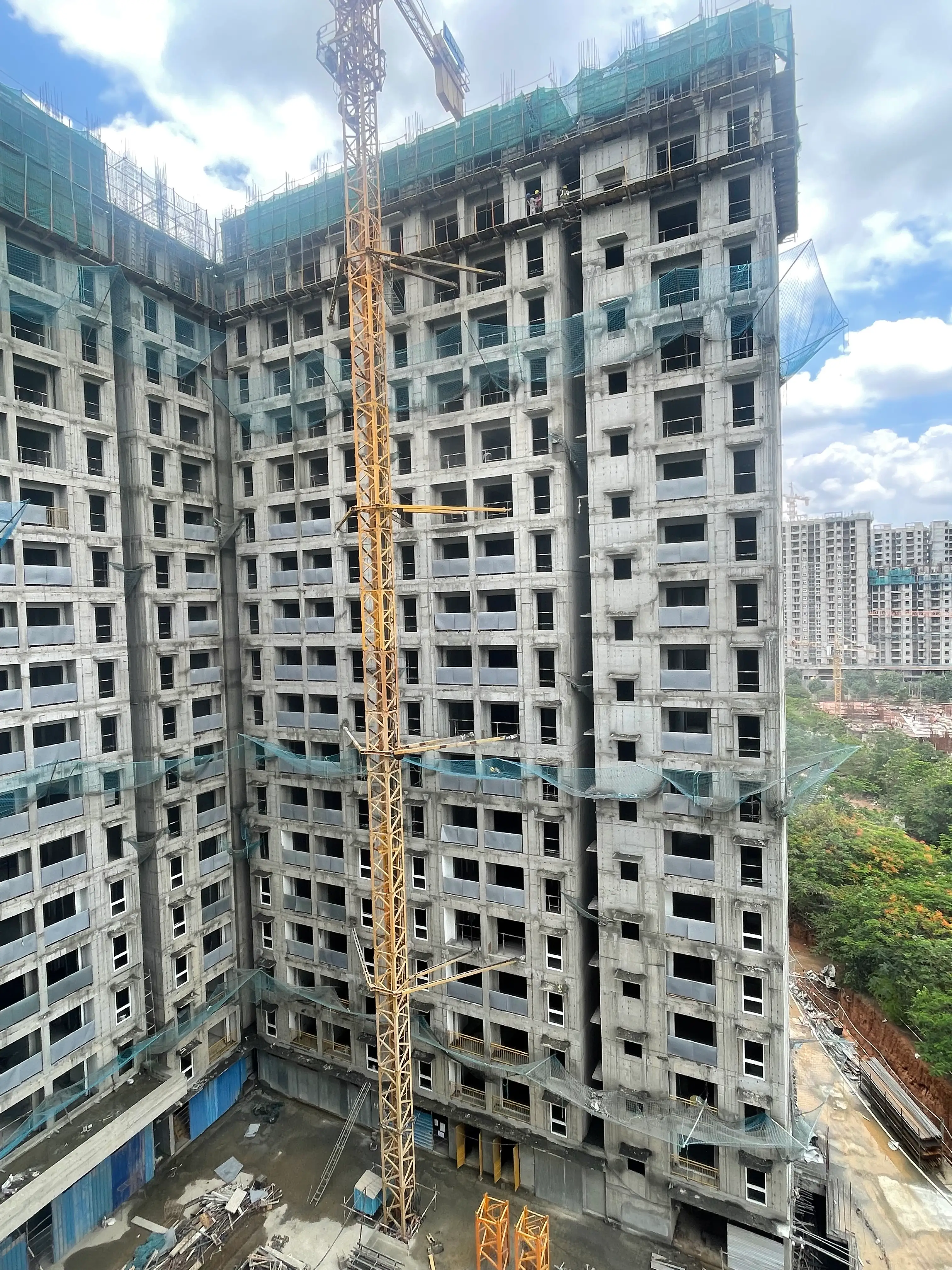

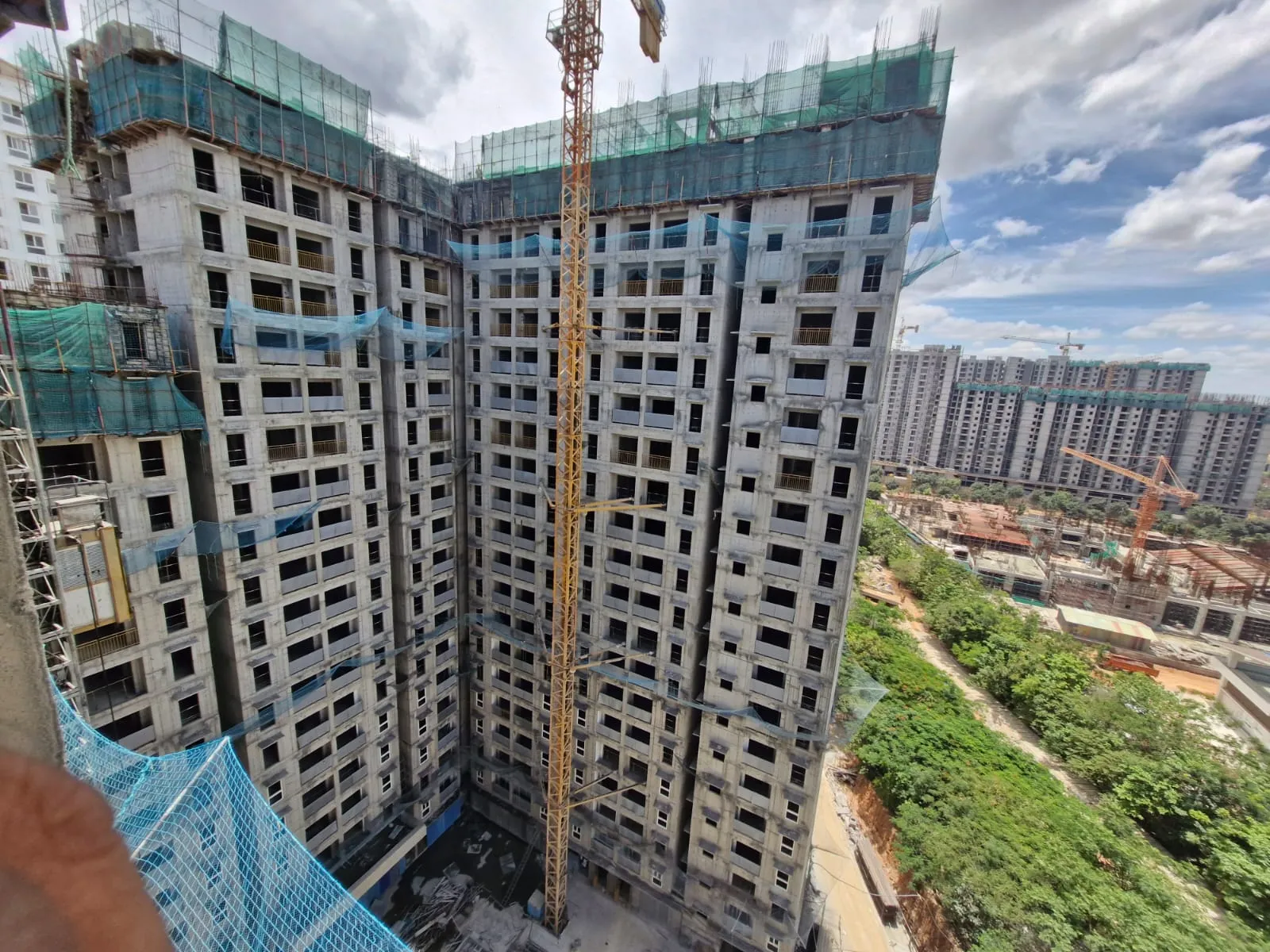

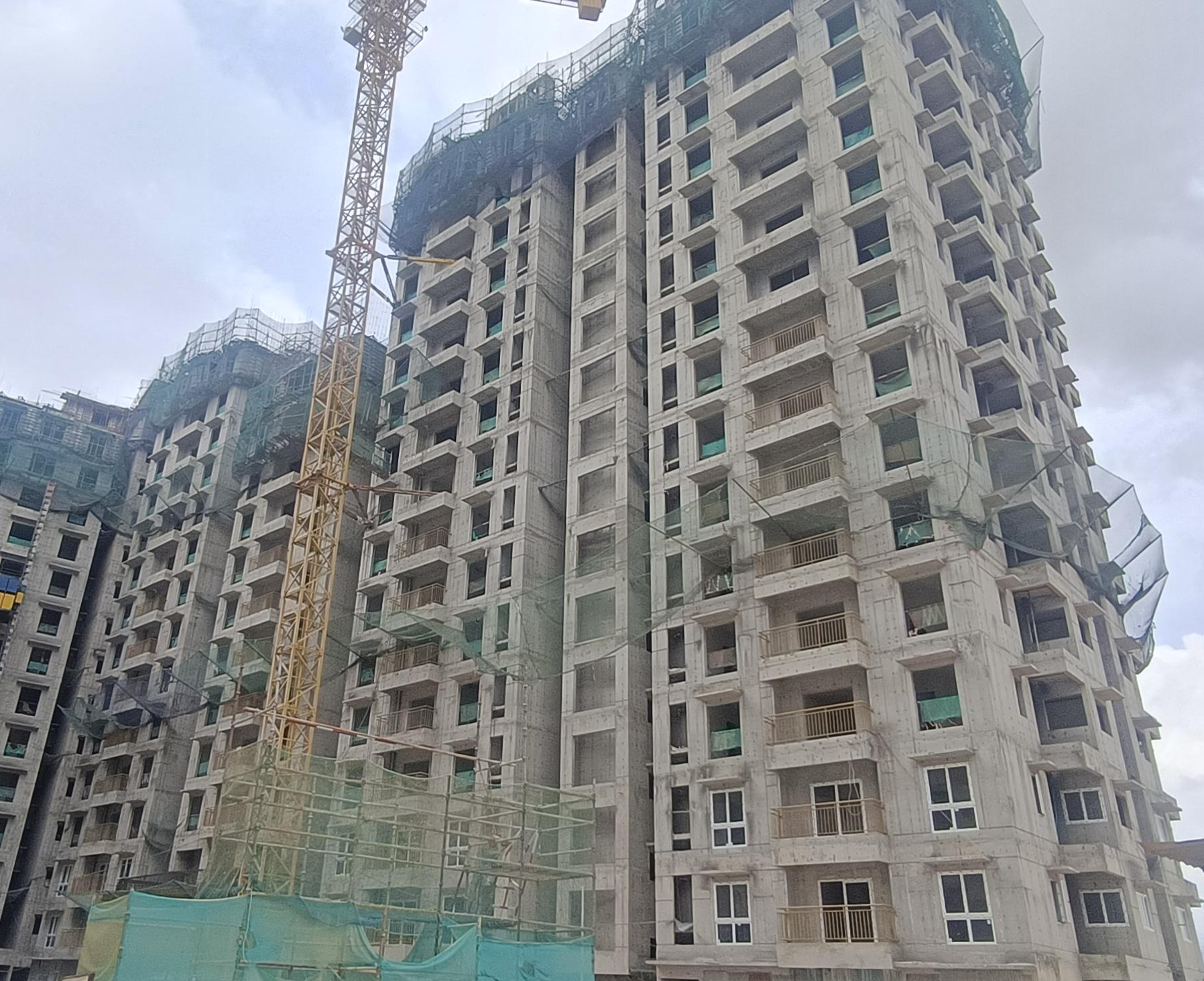

Wing C- 14th Floor slab shuttering WIP - Jun 2025

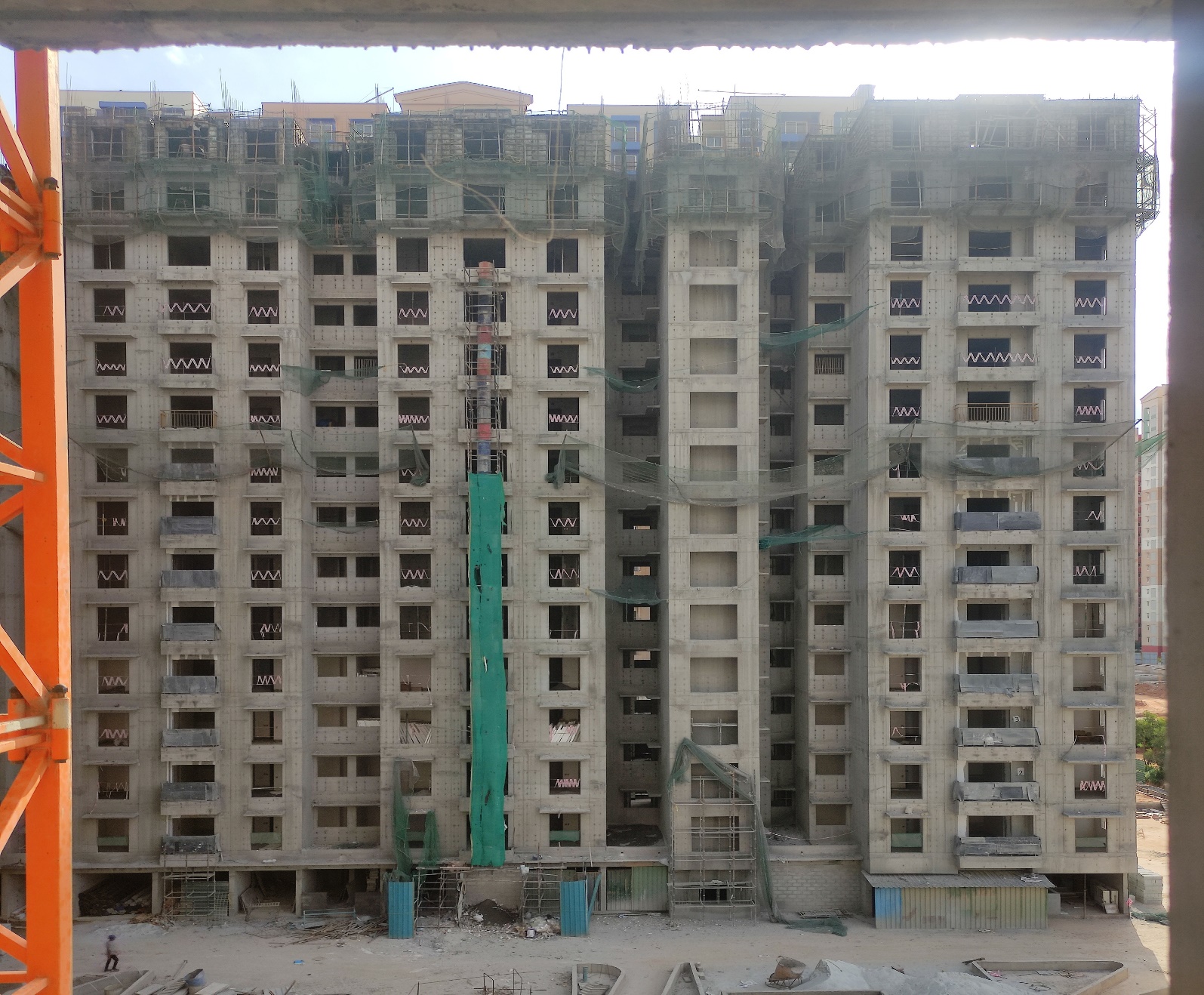

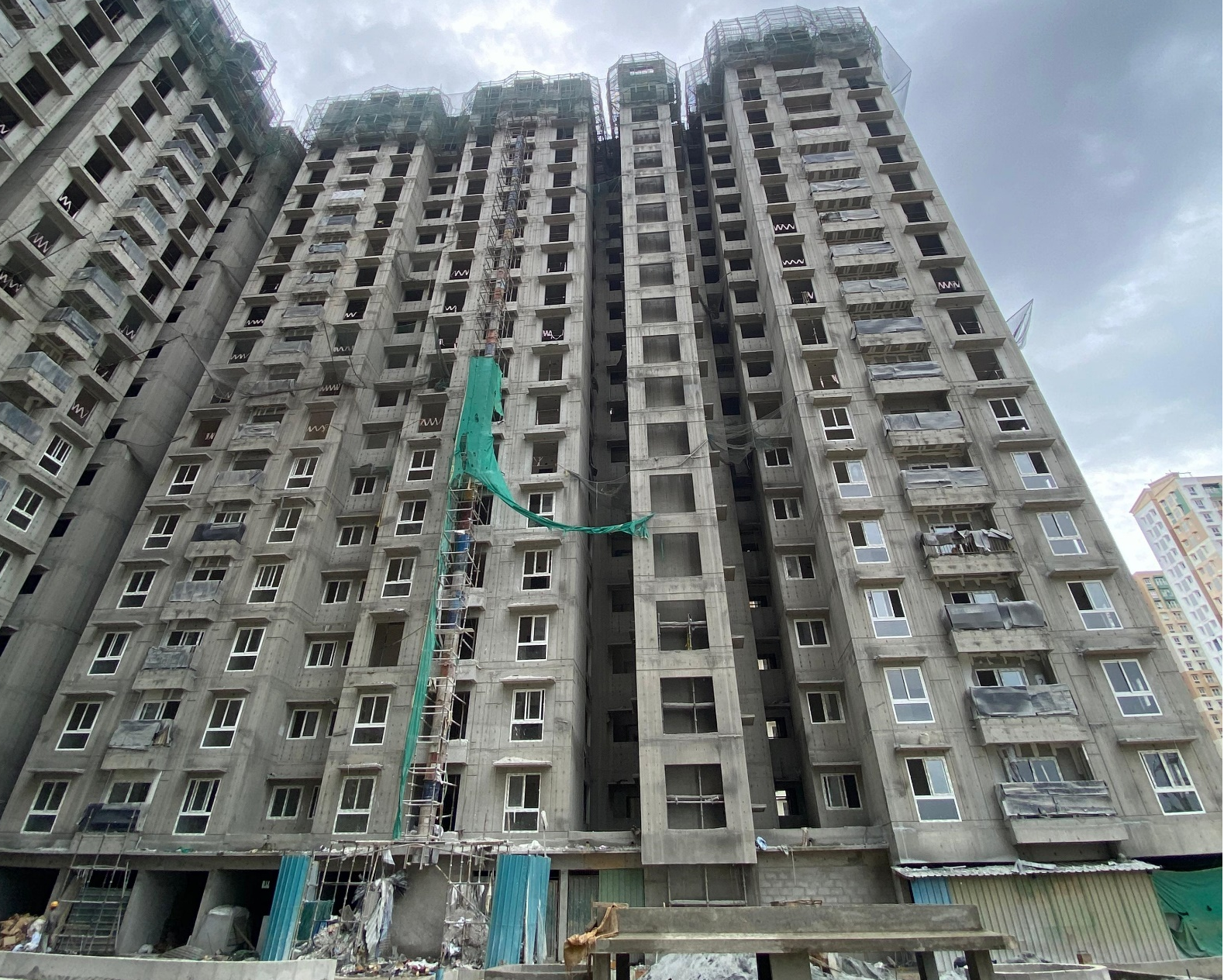

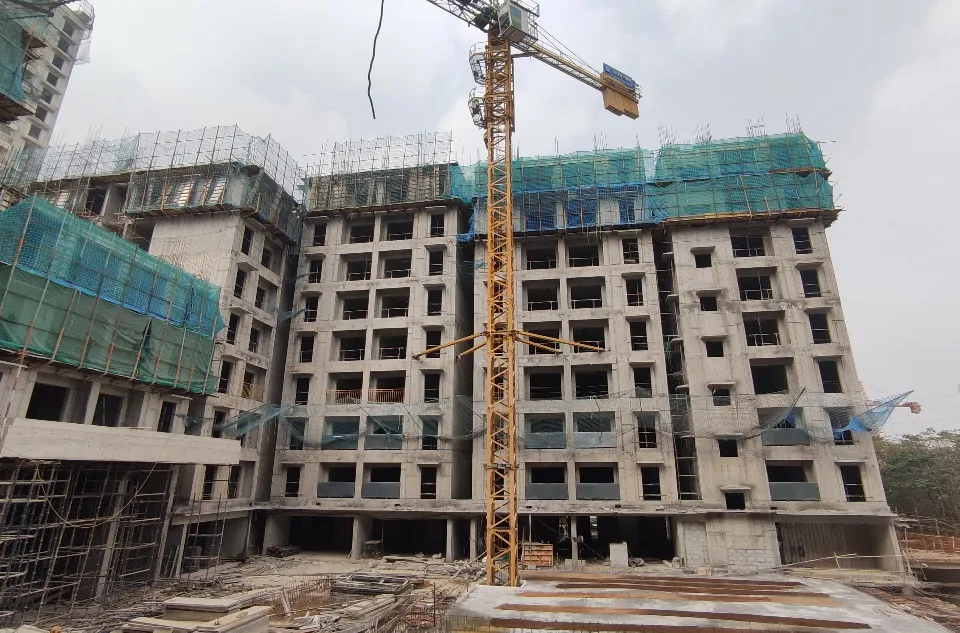

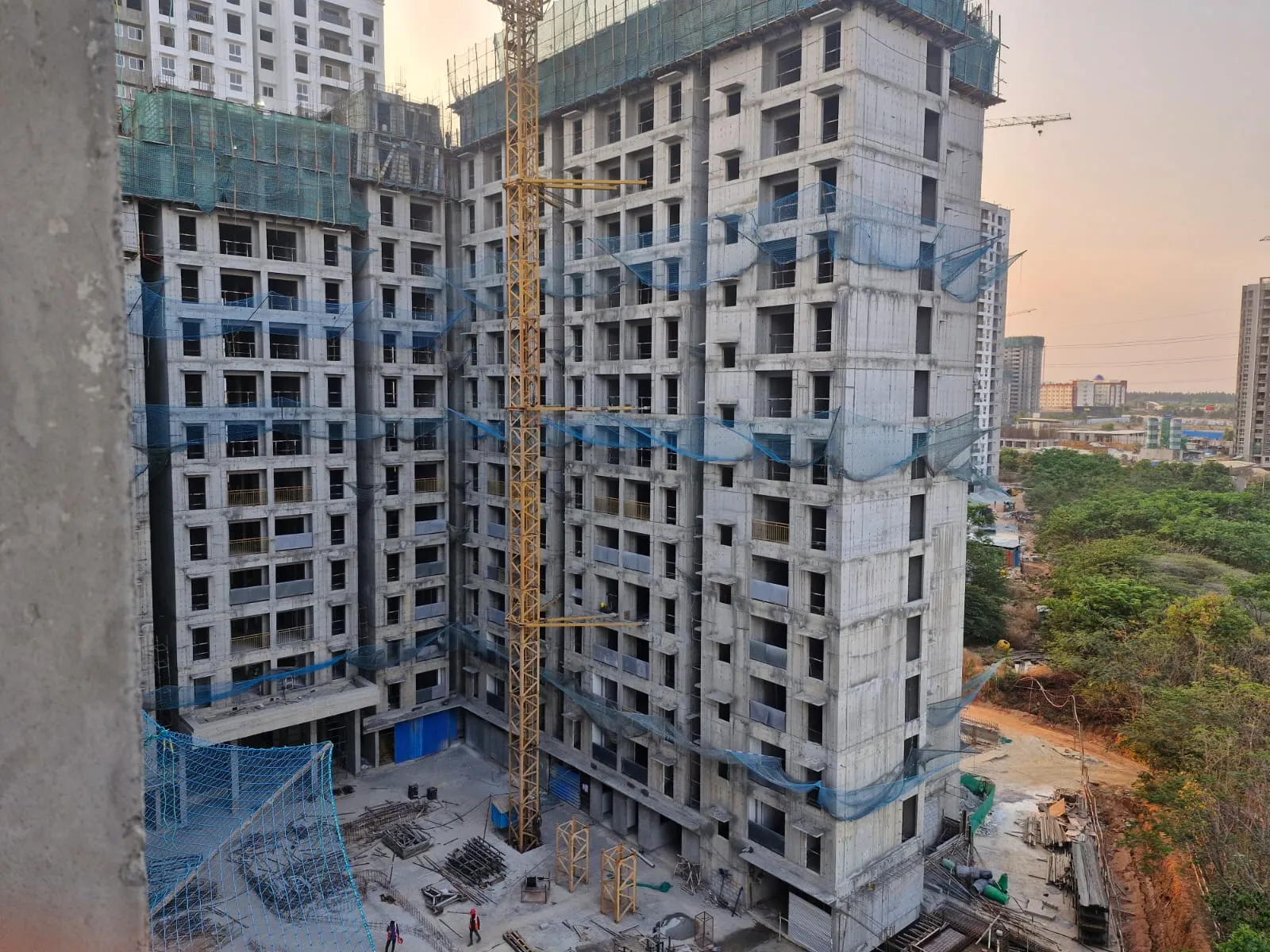

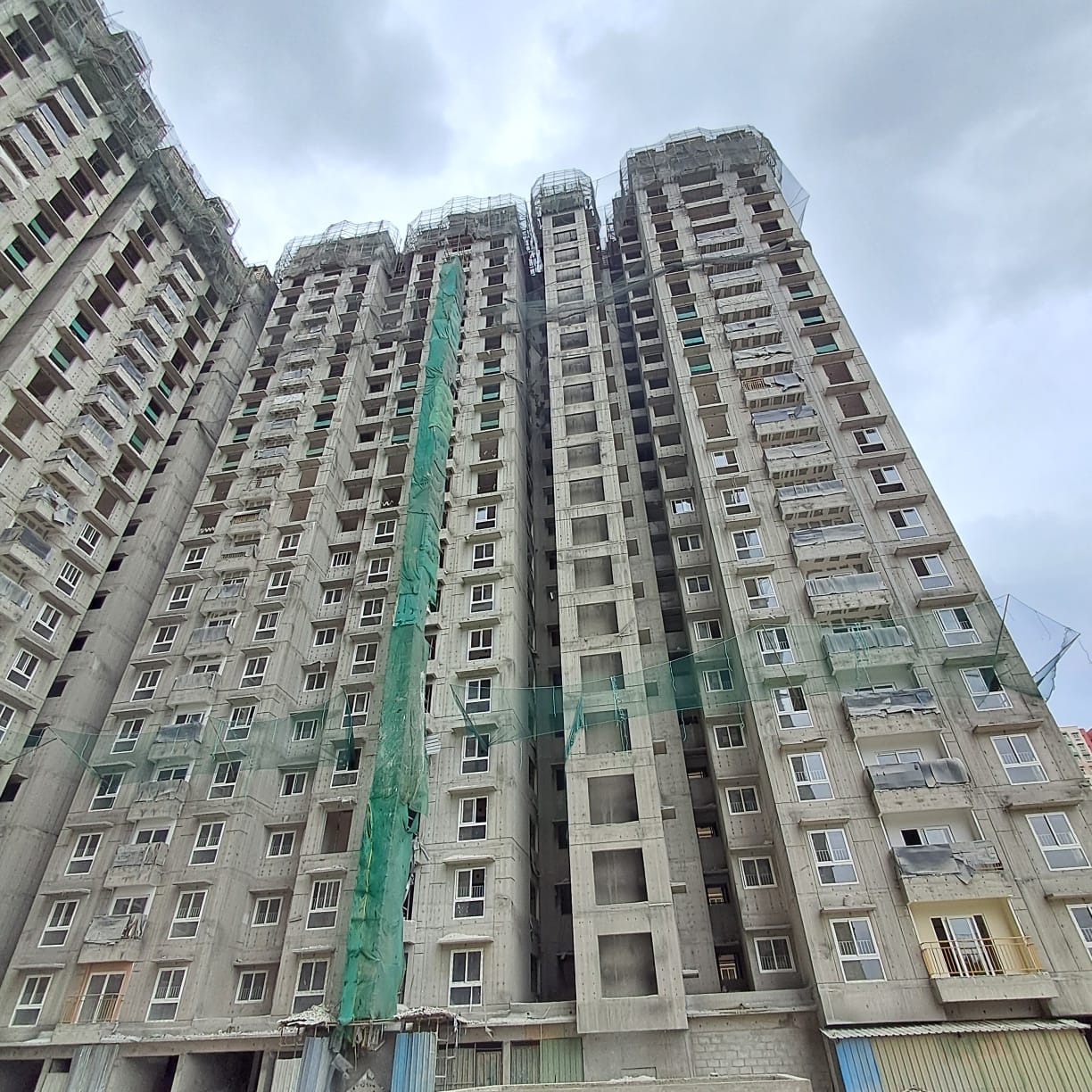

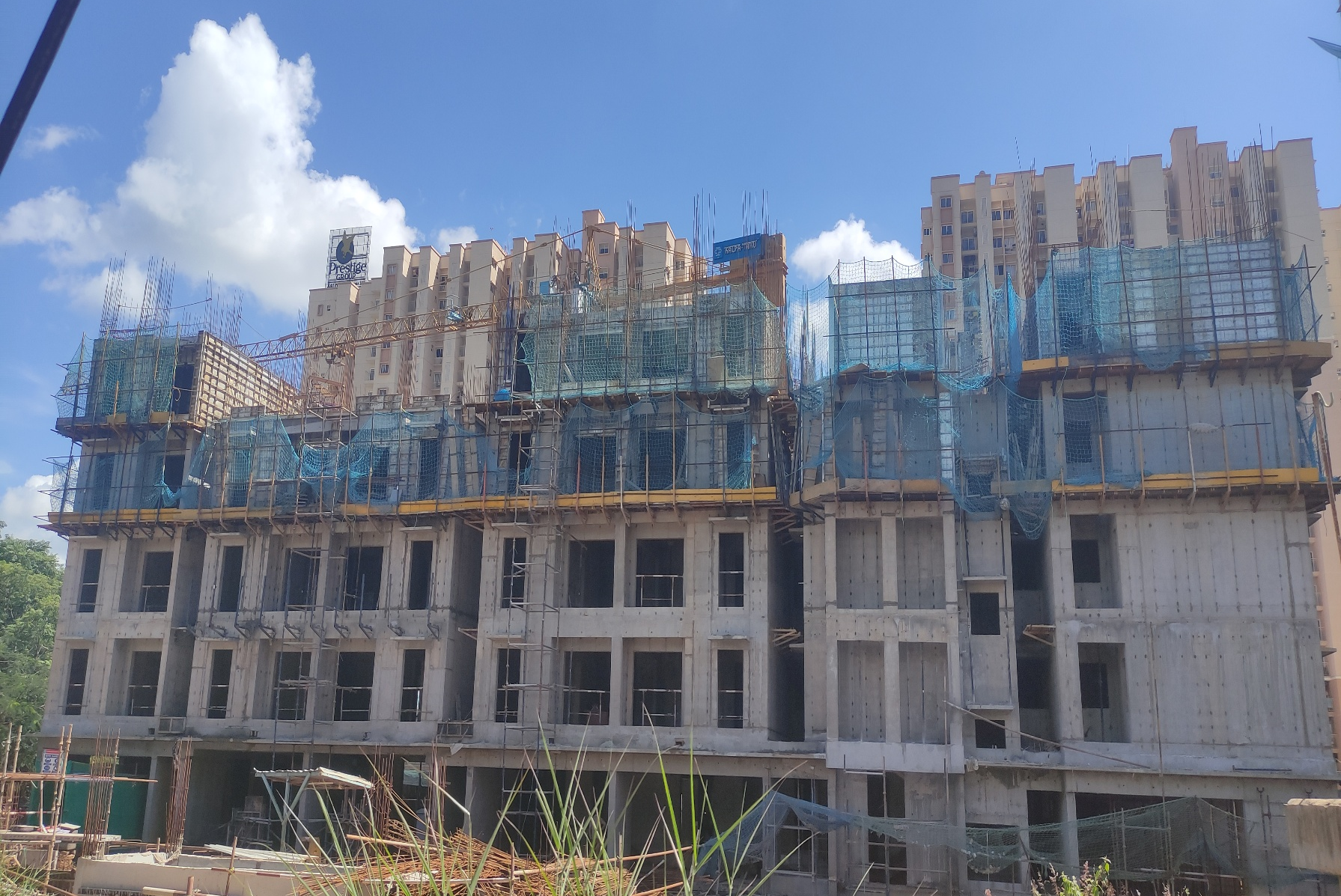

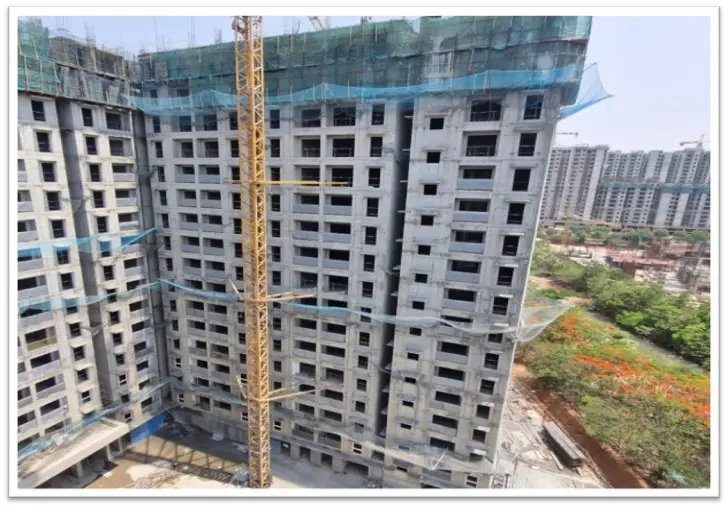

Wing A - 15th Floor slab shuttering WIP - Jun 2025

Internal flats Tiling flats completed 3rd floor tiling in progress - Jun 2025

Internal flats Tiling flats completed 3rd floor tiling in progress - Jun 2025

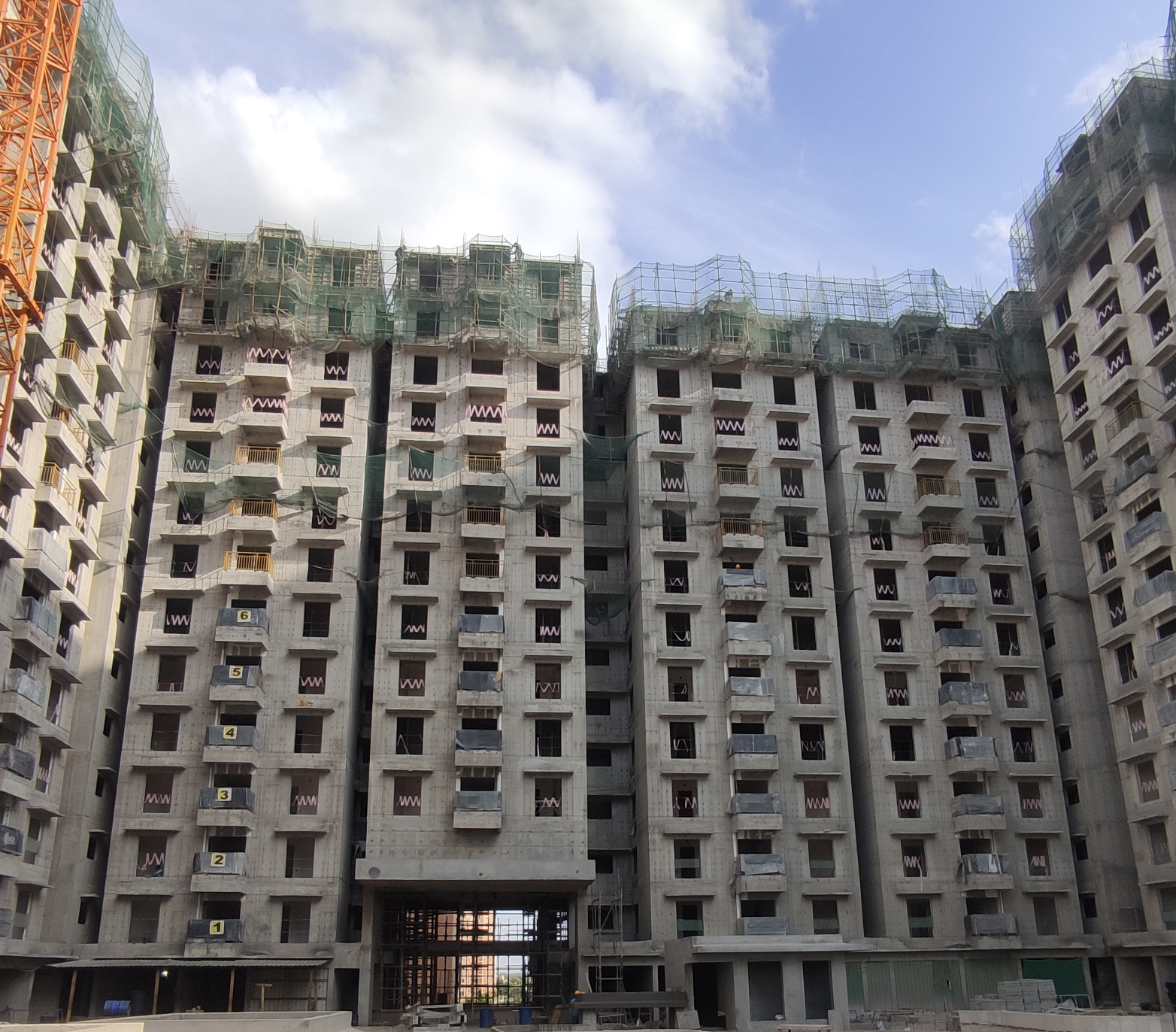

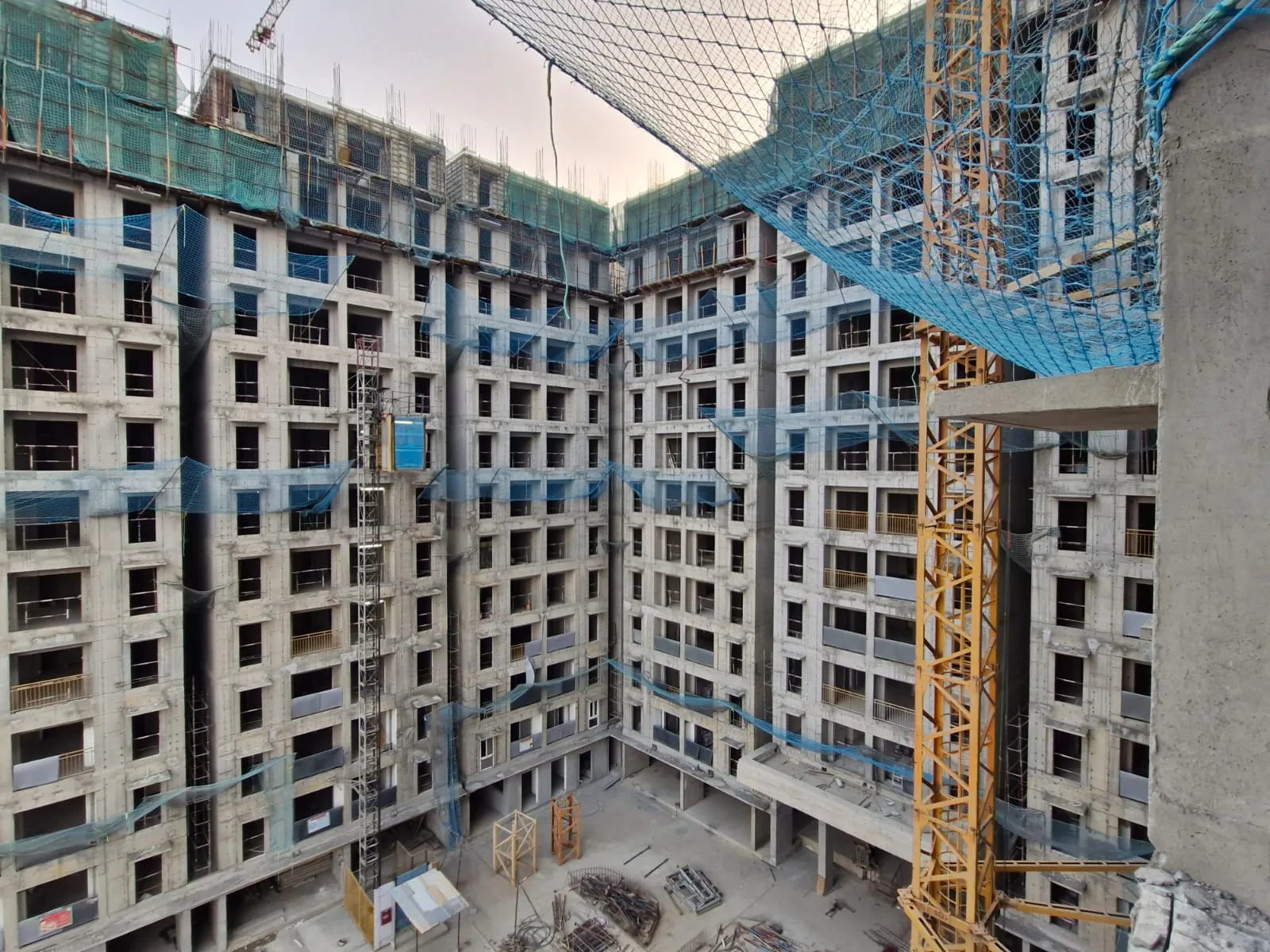

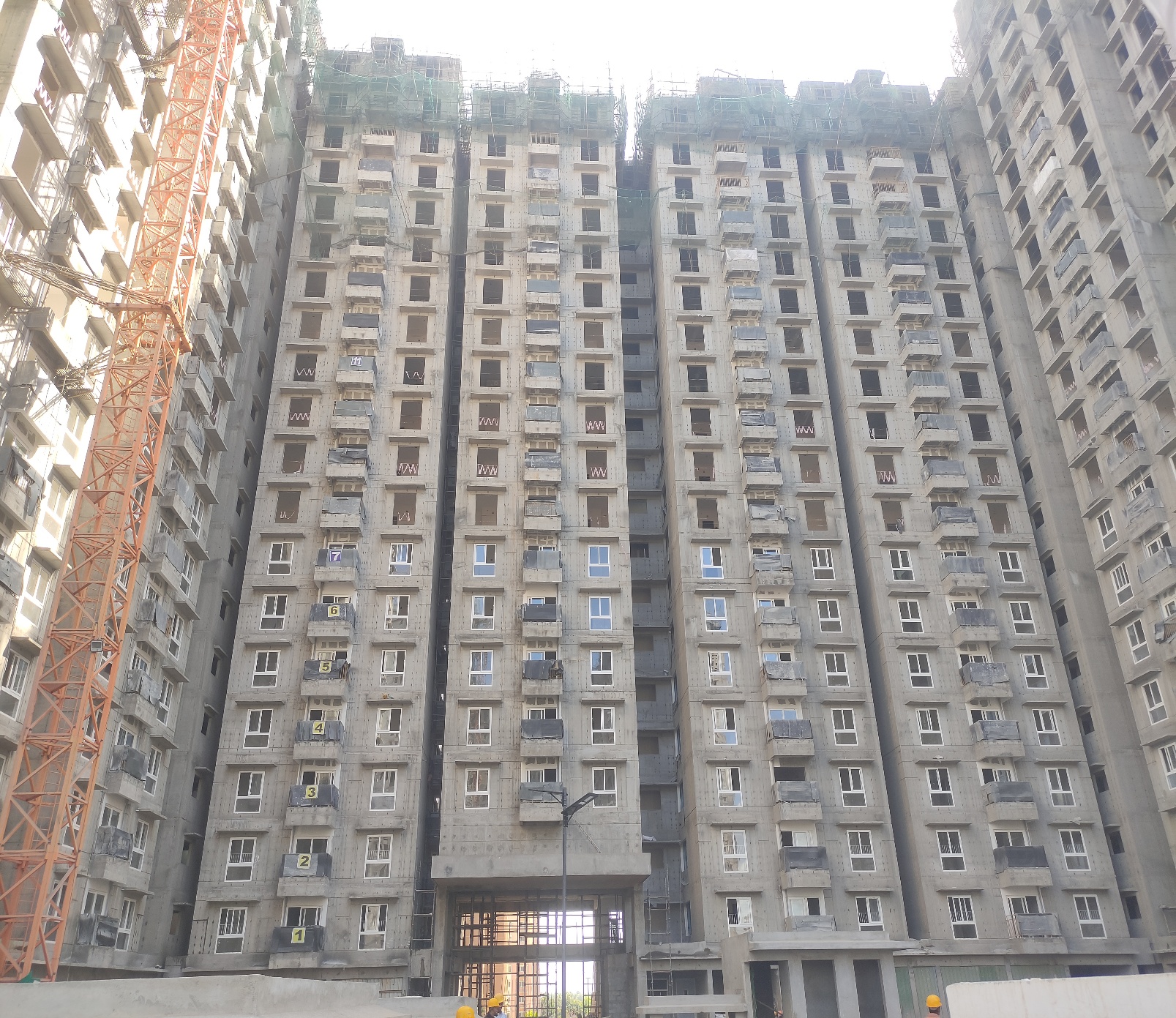

Wing B – 14 th Floor slab shuttering in progress - Jun 2025

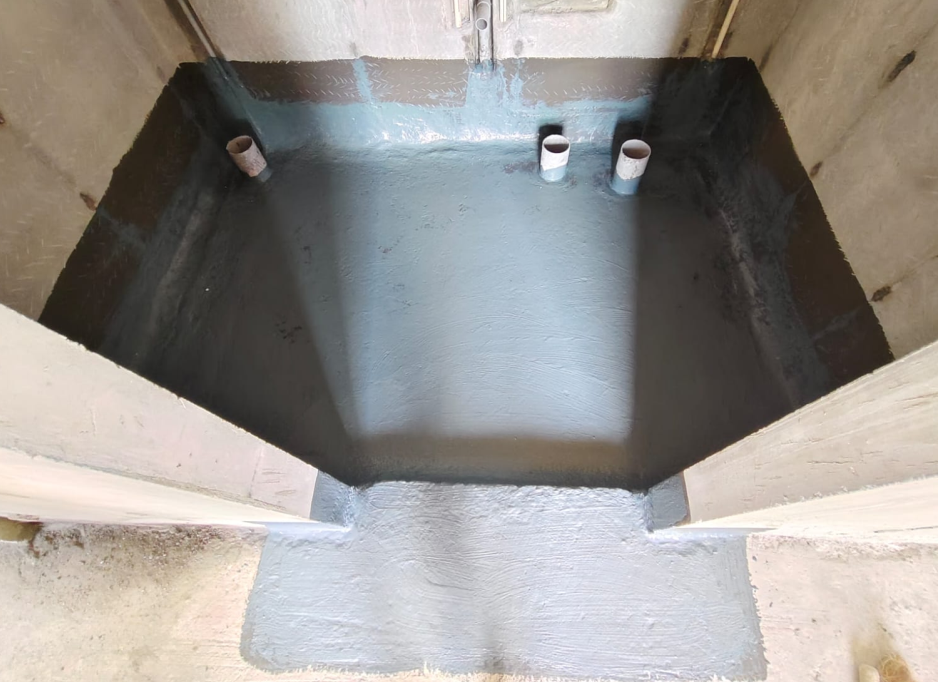

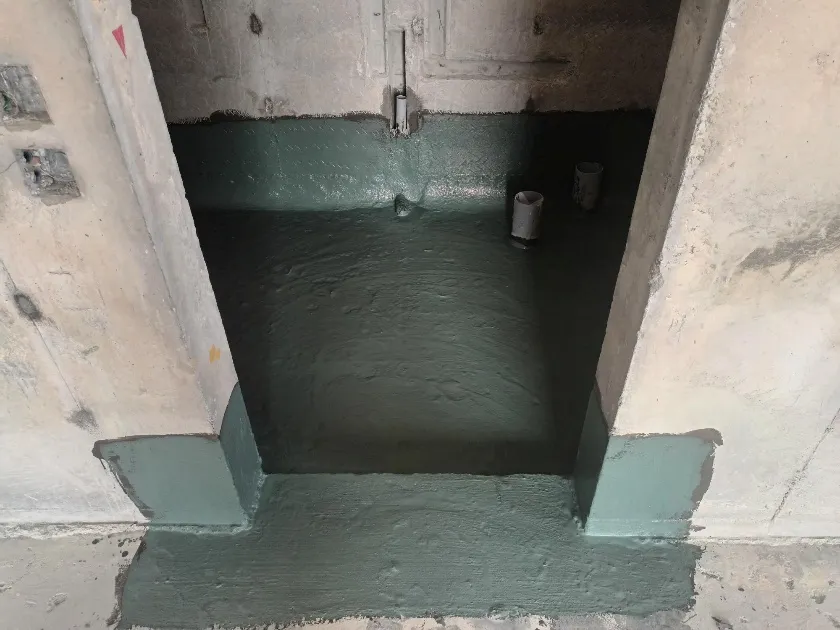

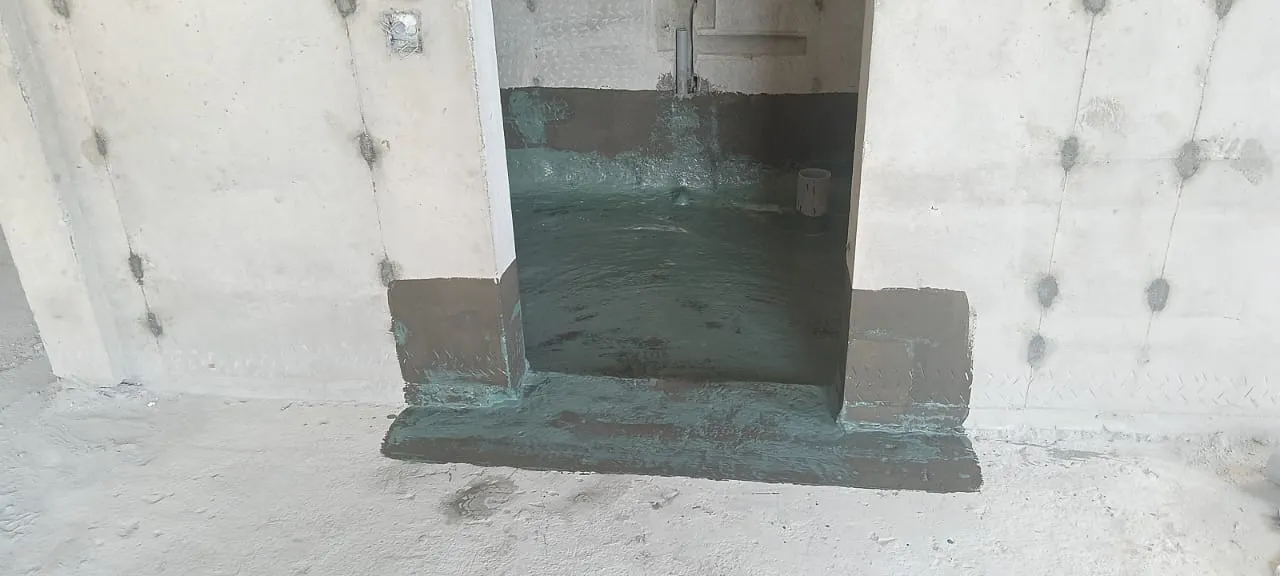

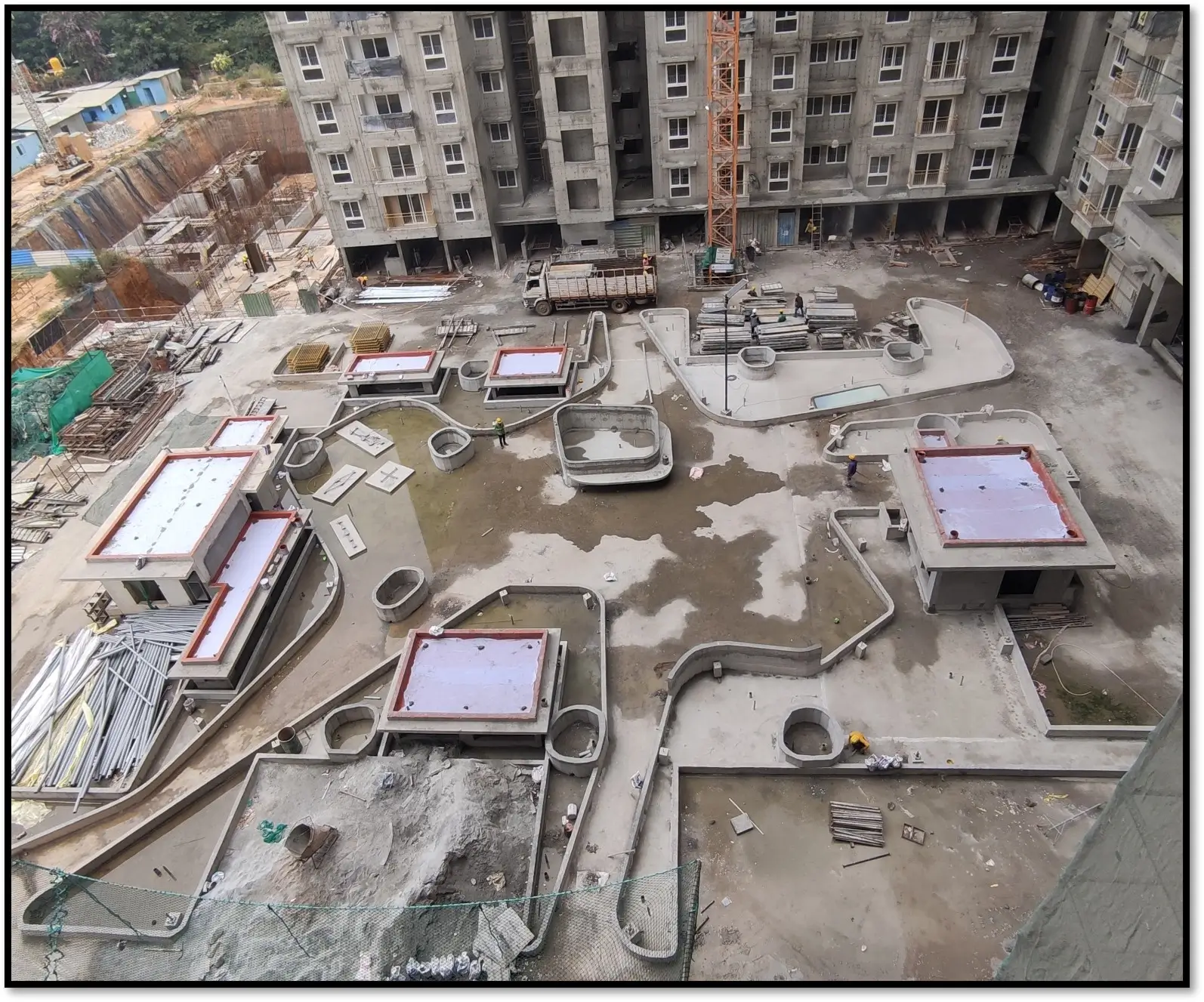

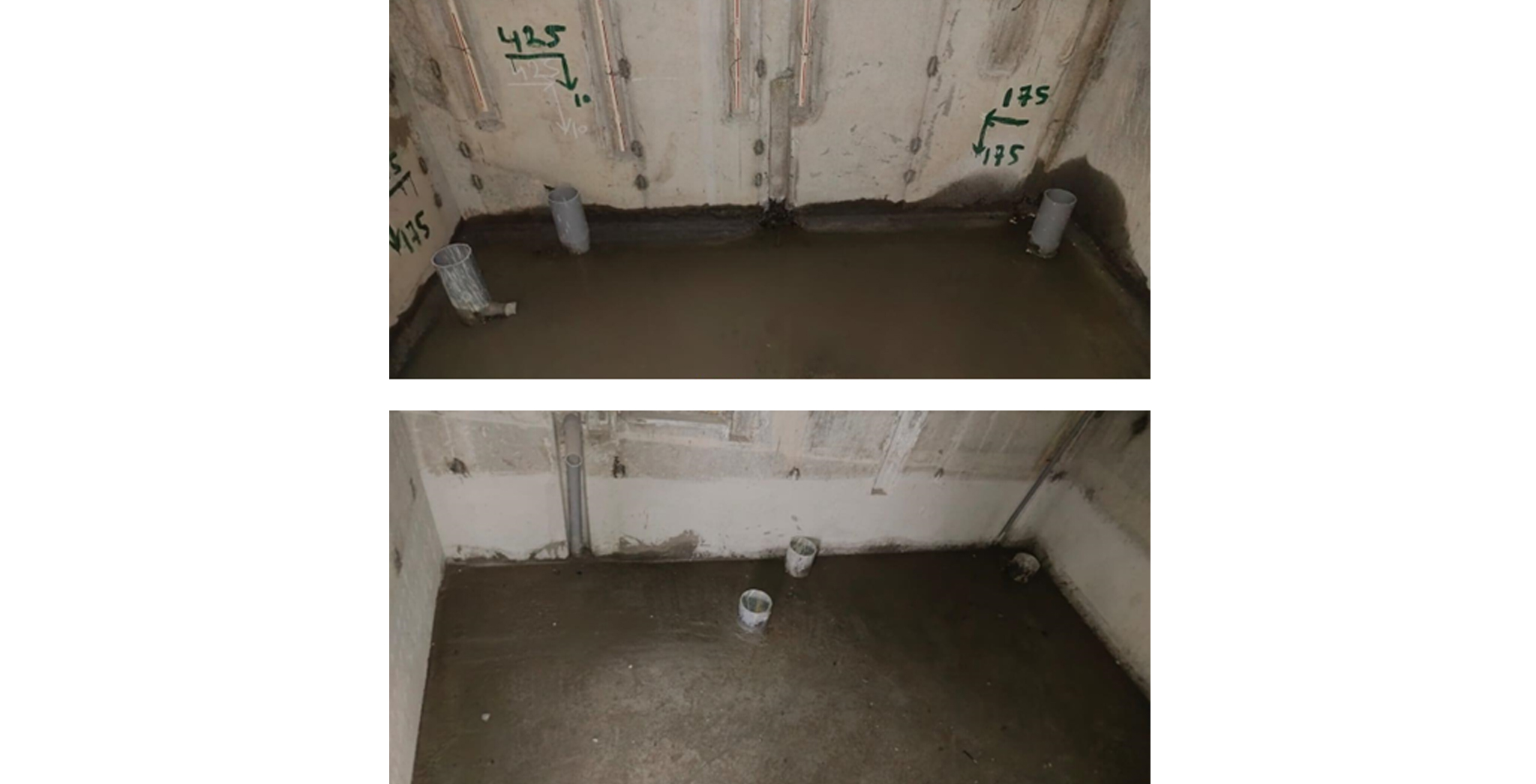

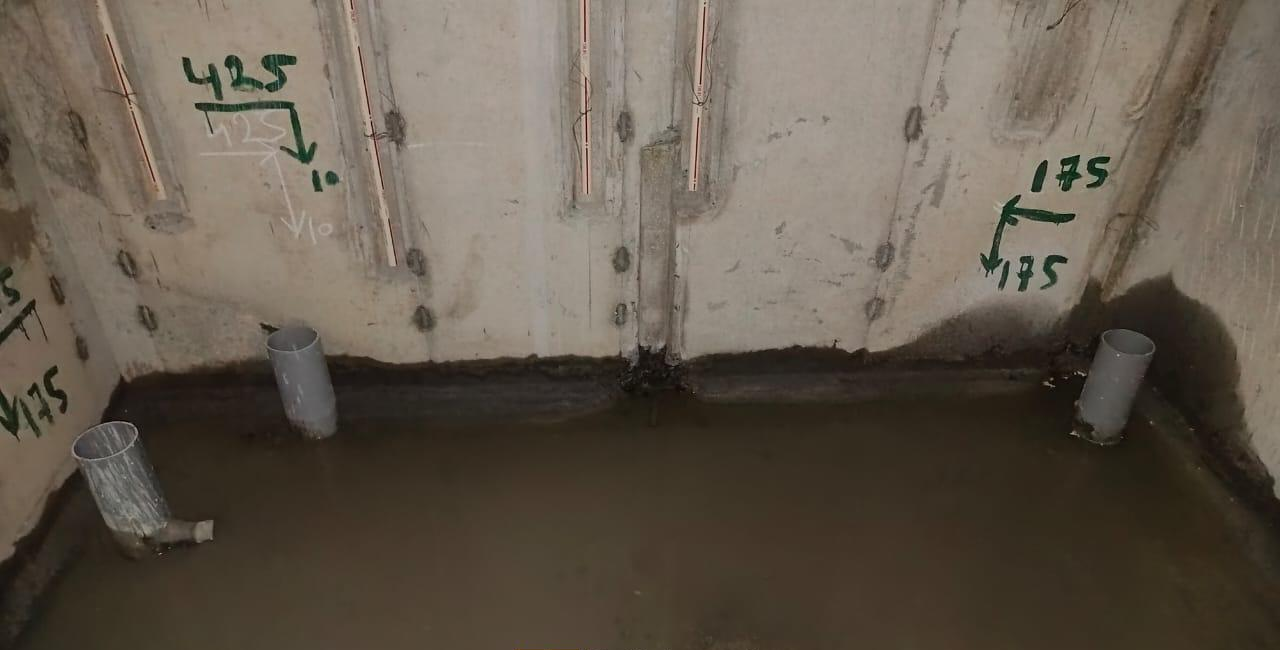

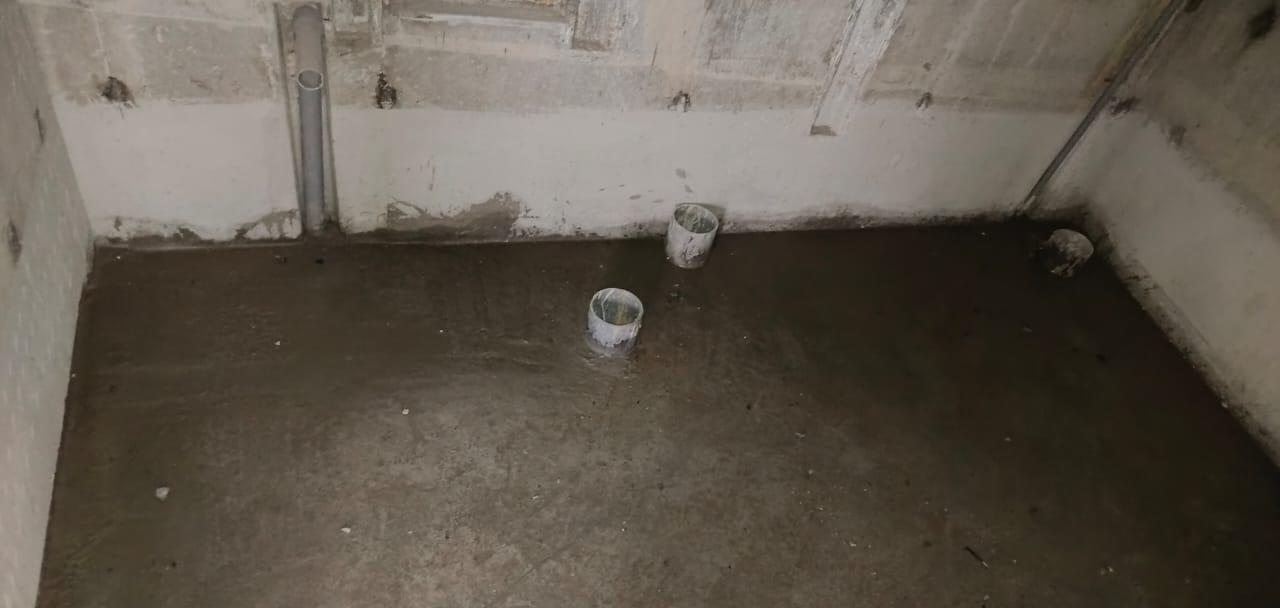

4th & 5th Floor Toilet Waterproofing works in progress - Jun 2025

Internal flats Painting (Up to Primer) - flats started - Jun 2025

Internal flats Painting (Up to Primer) - flats started - Jun 2025

Internal flats Painting (Up to Primer) - flats started - Jun 2025

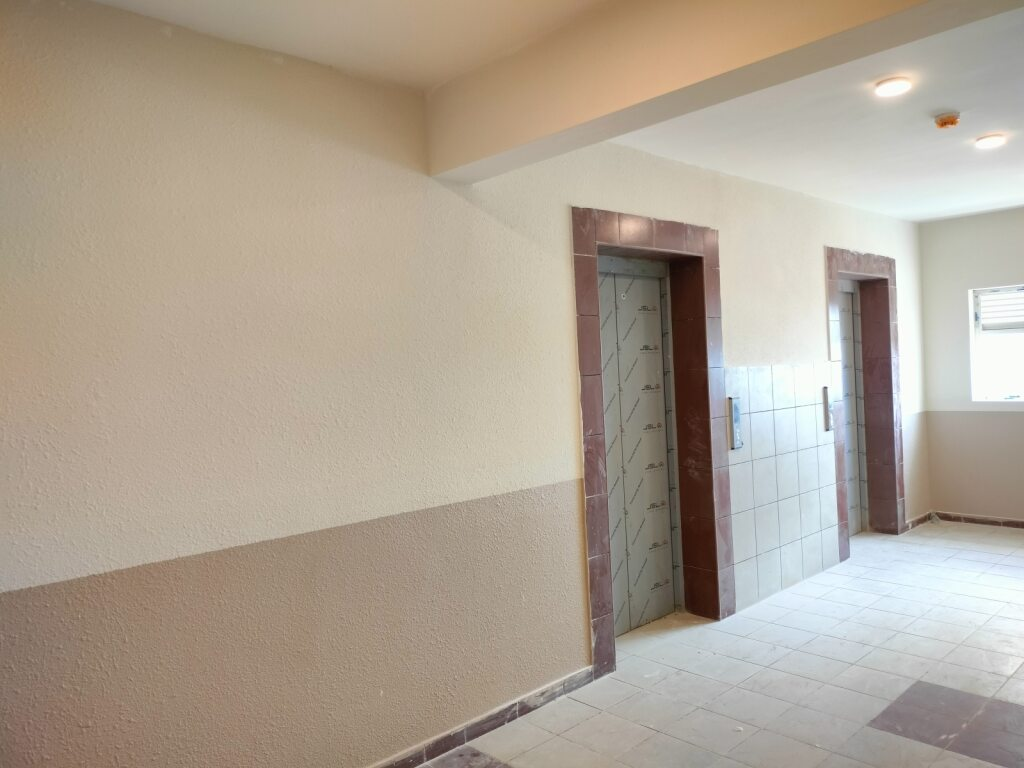

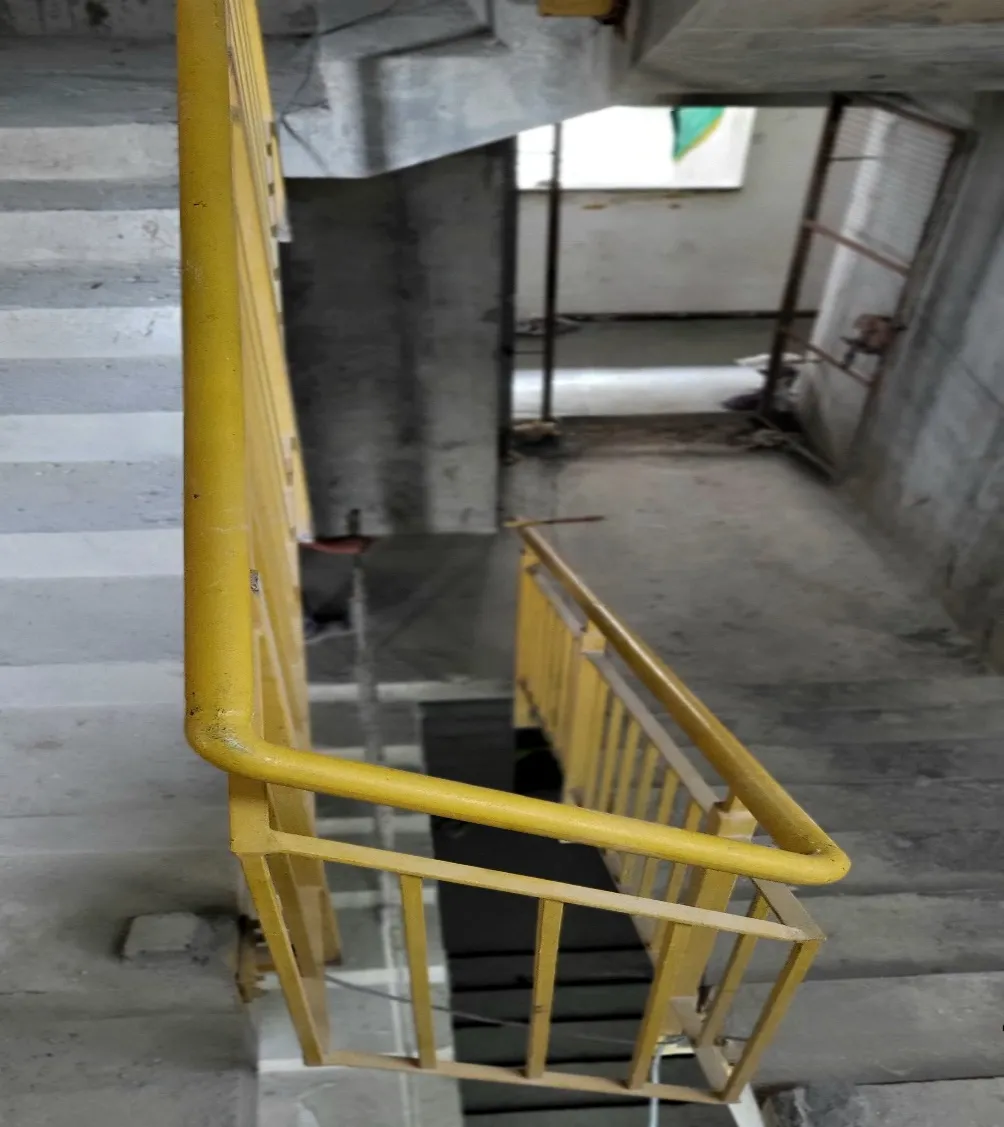

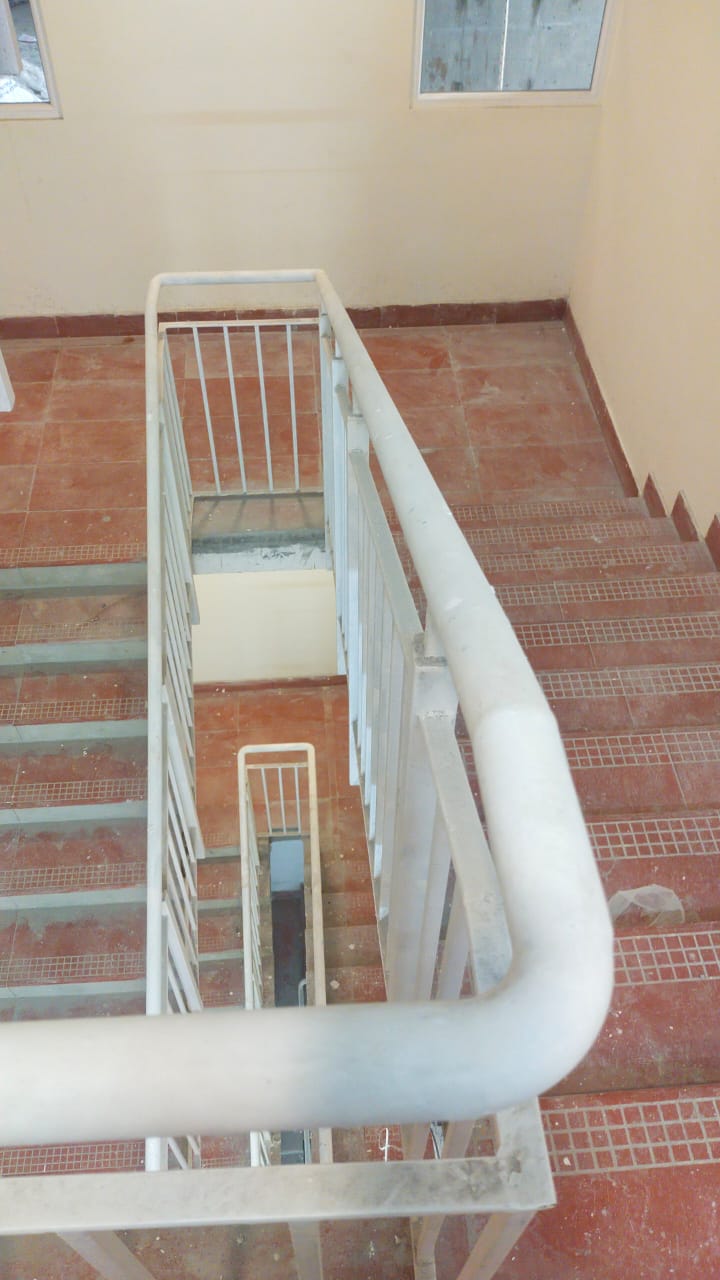

Lift wall Texture WIP - Jun 2025

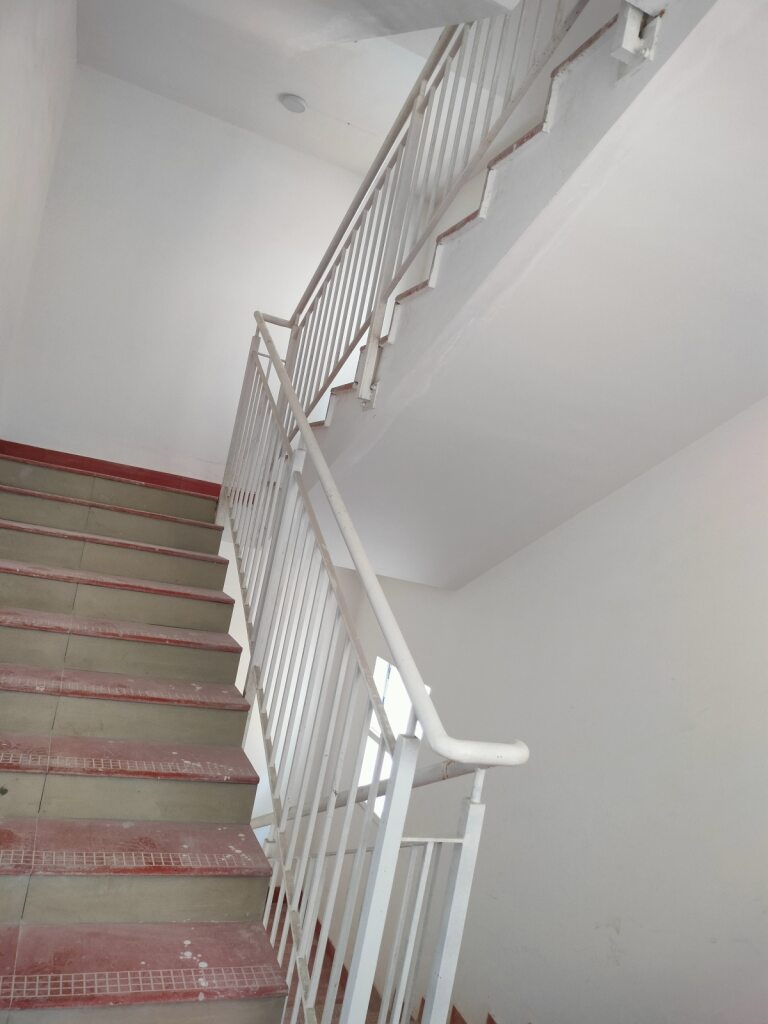

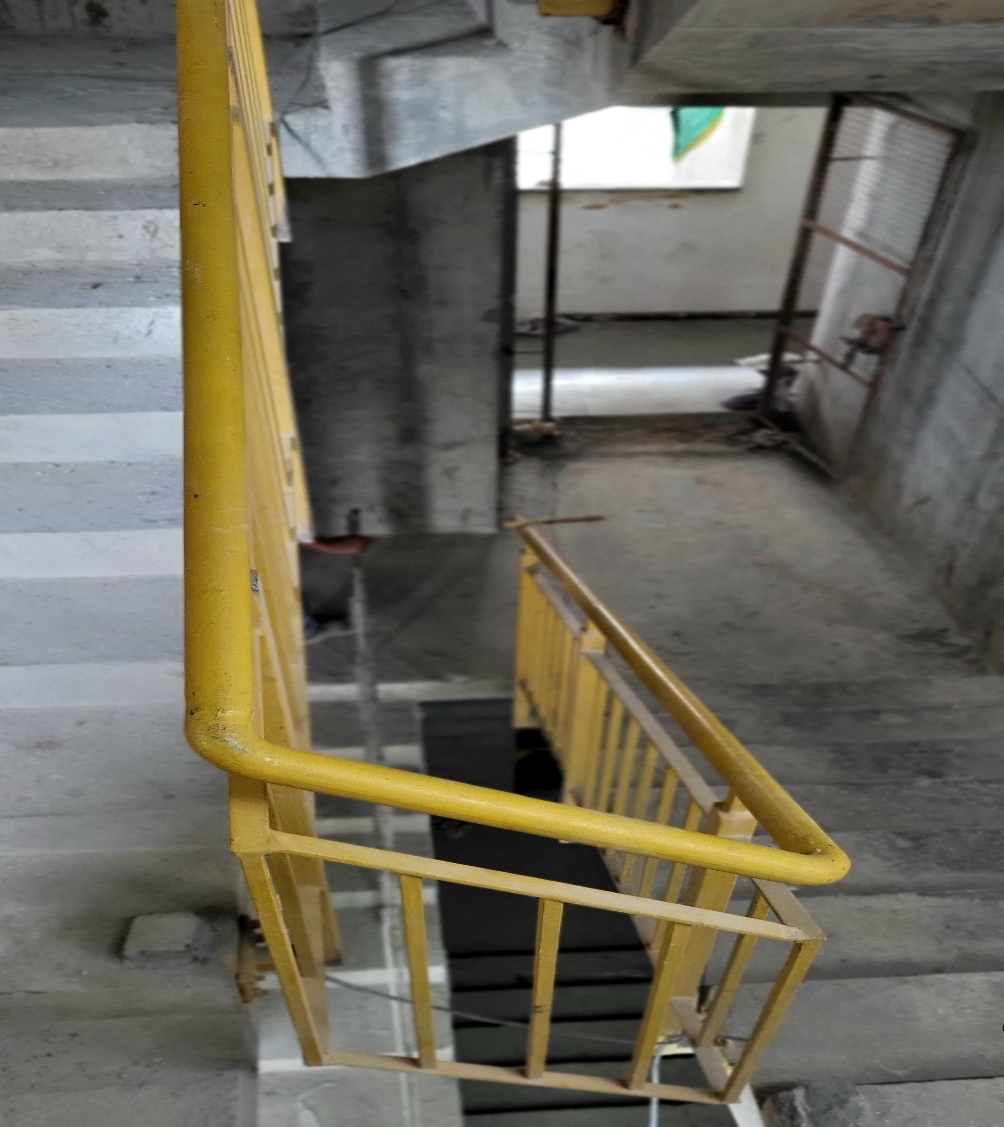

Staircase Painting WIP - Jun 2025

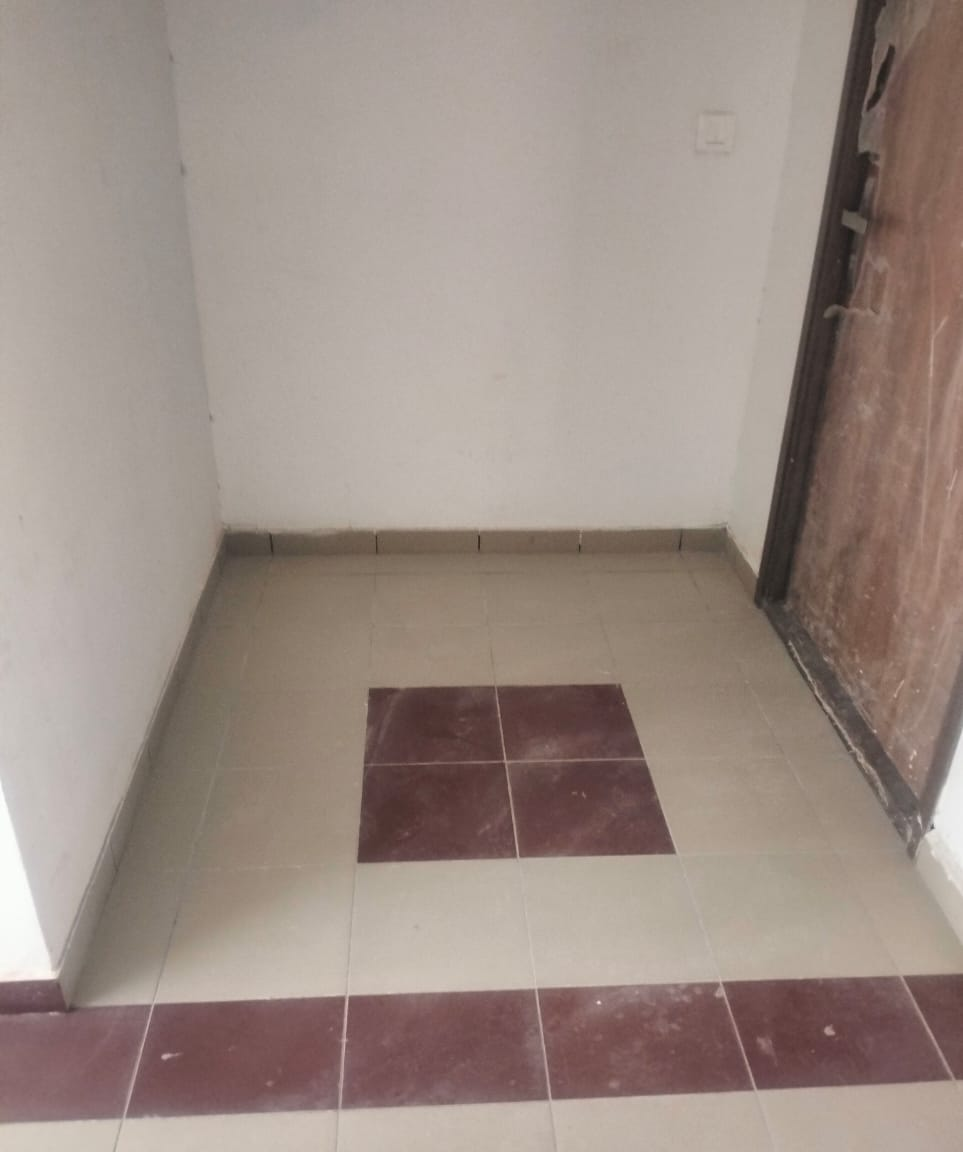

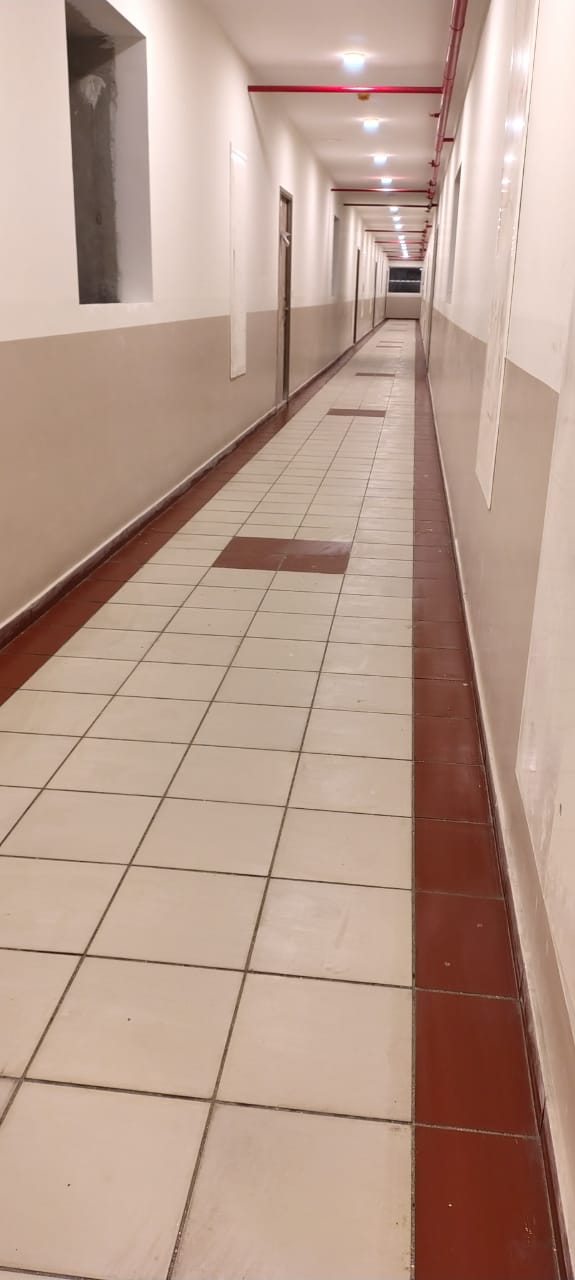

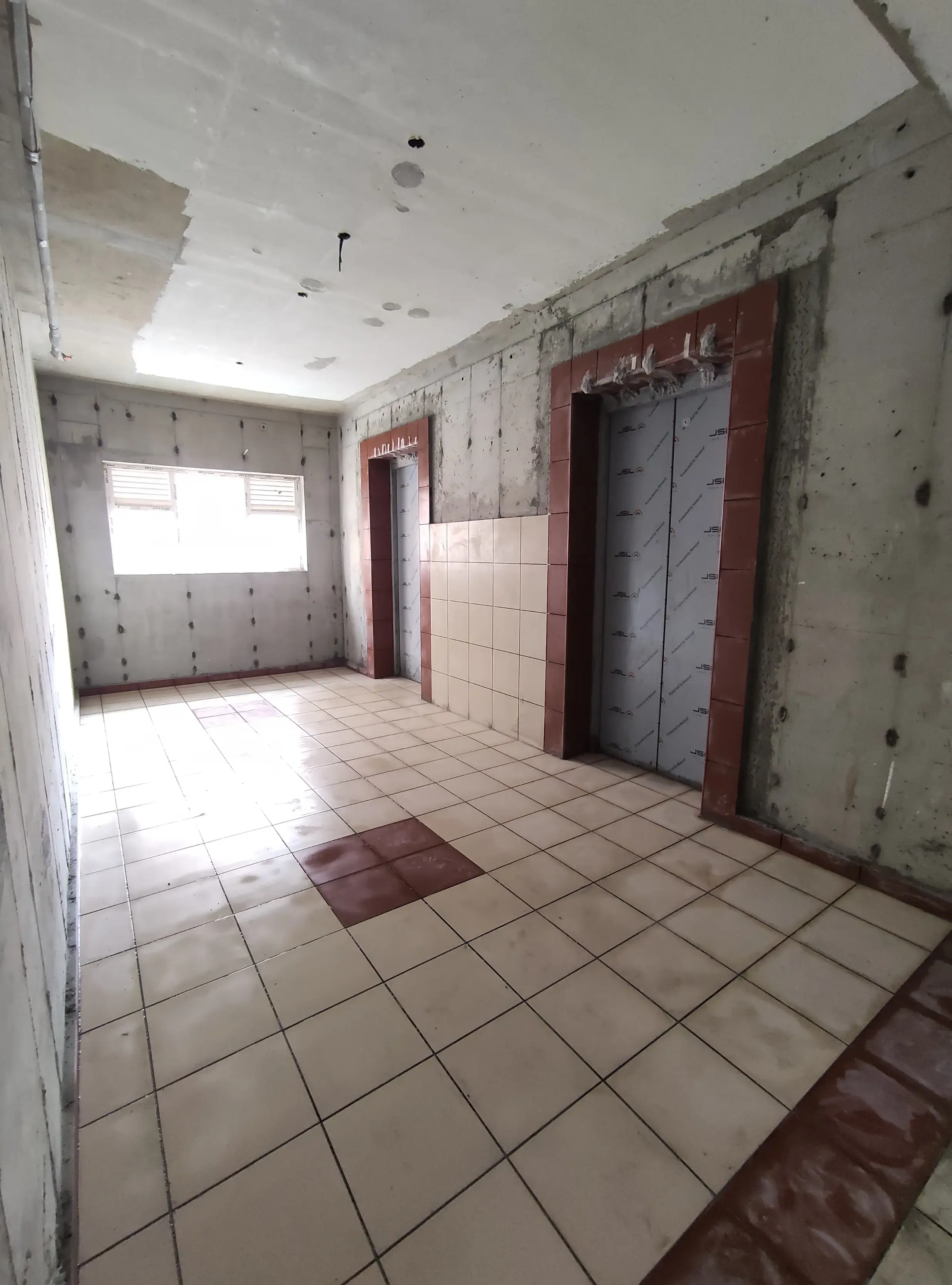

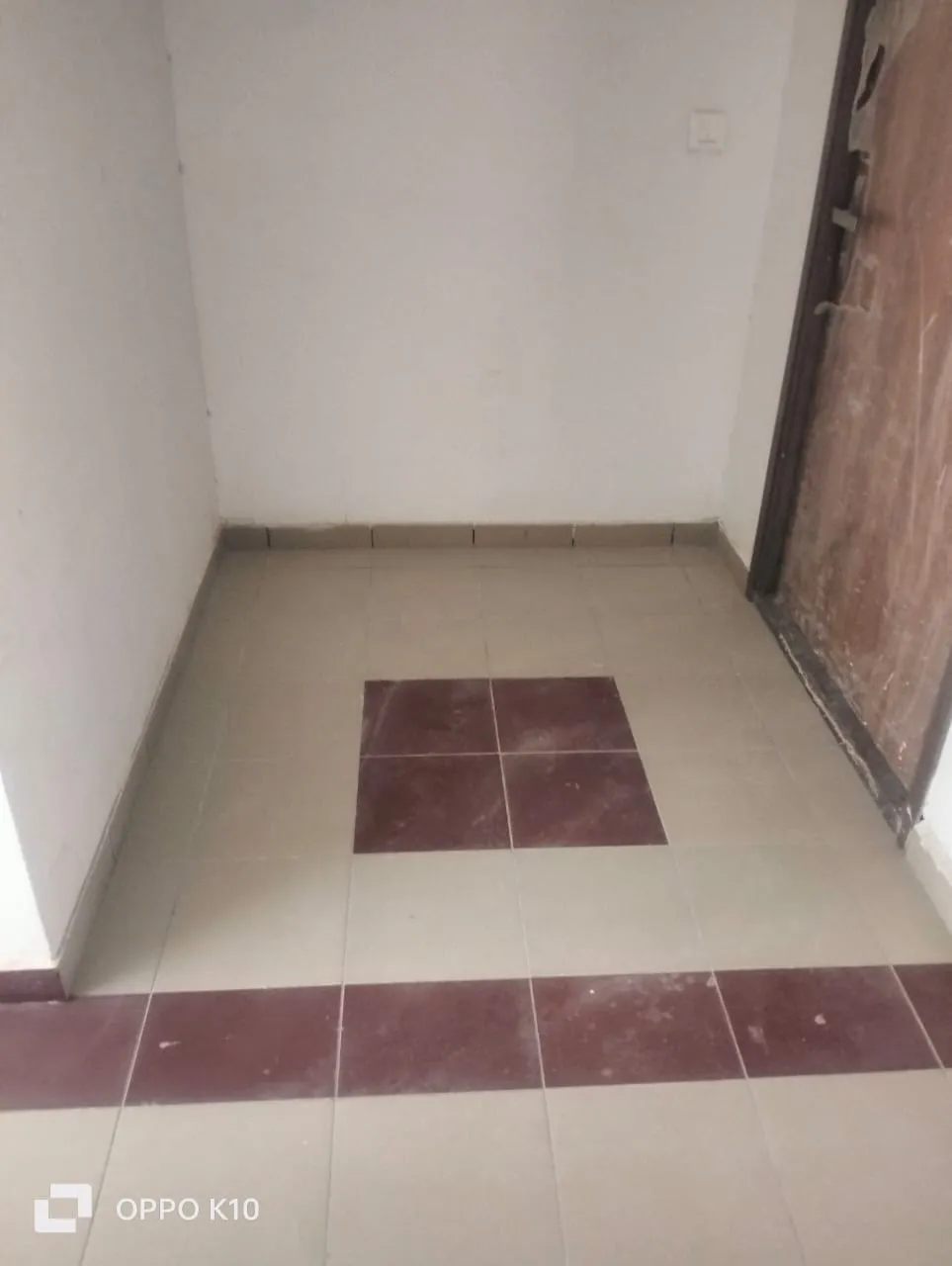

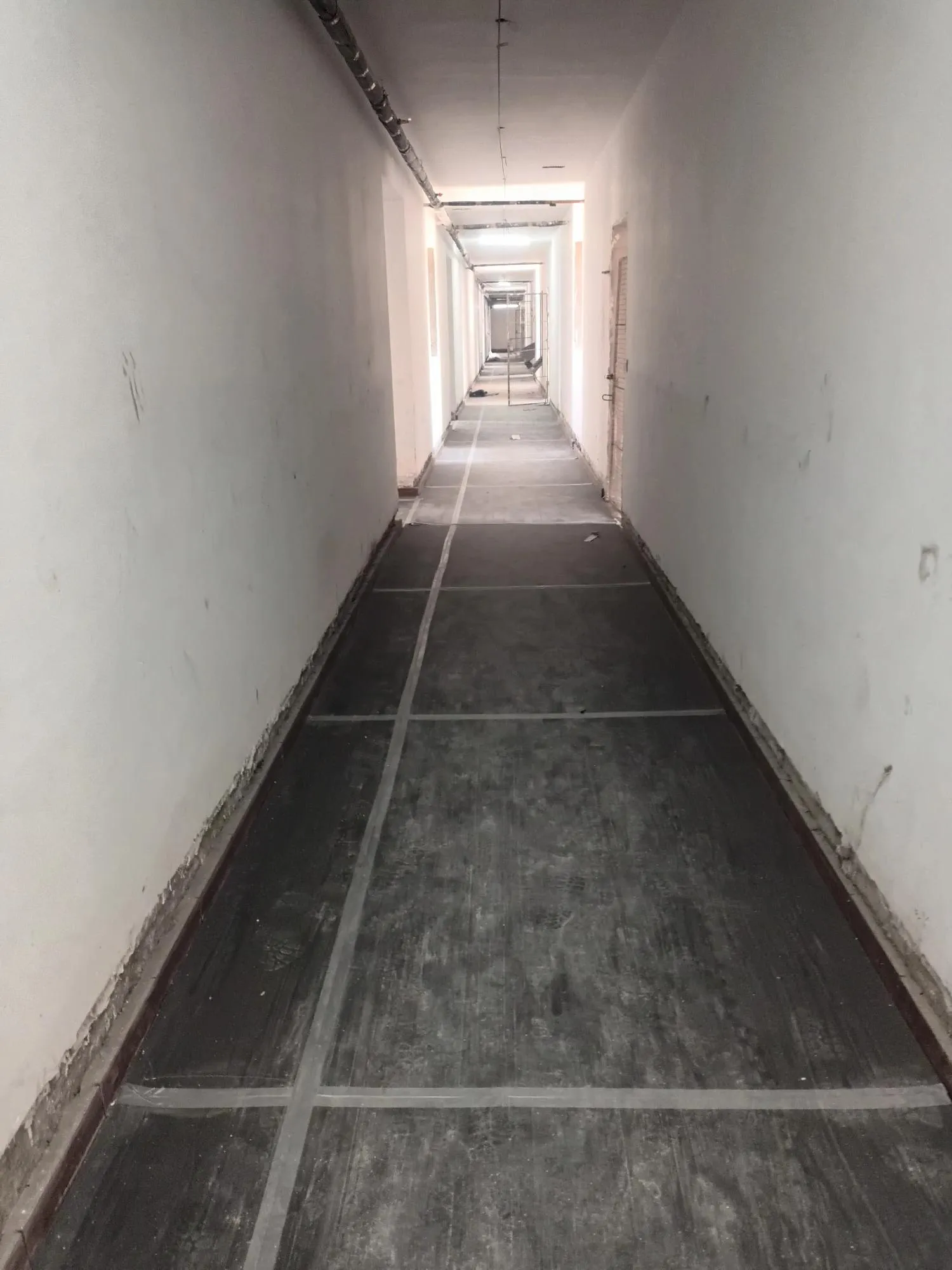

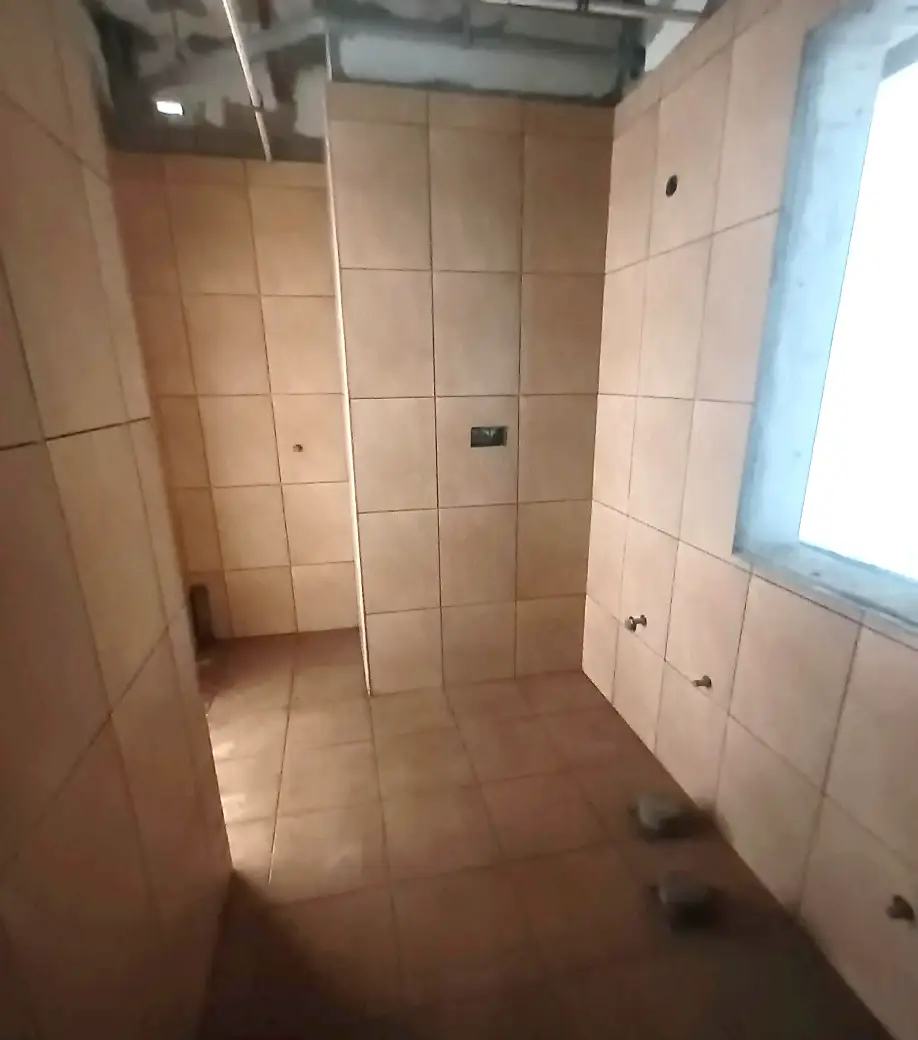

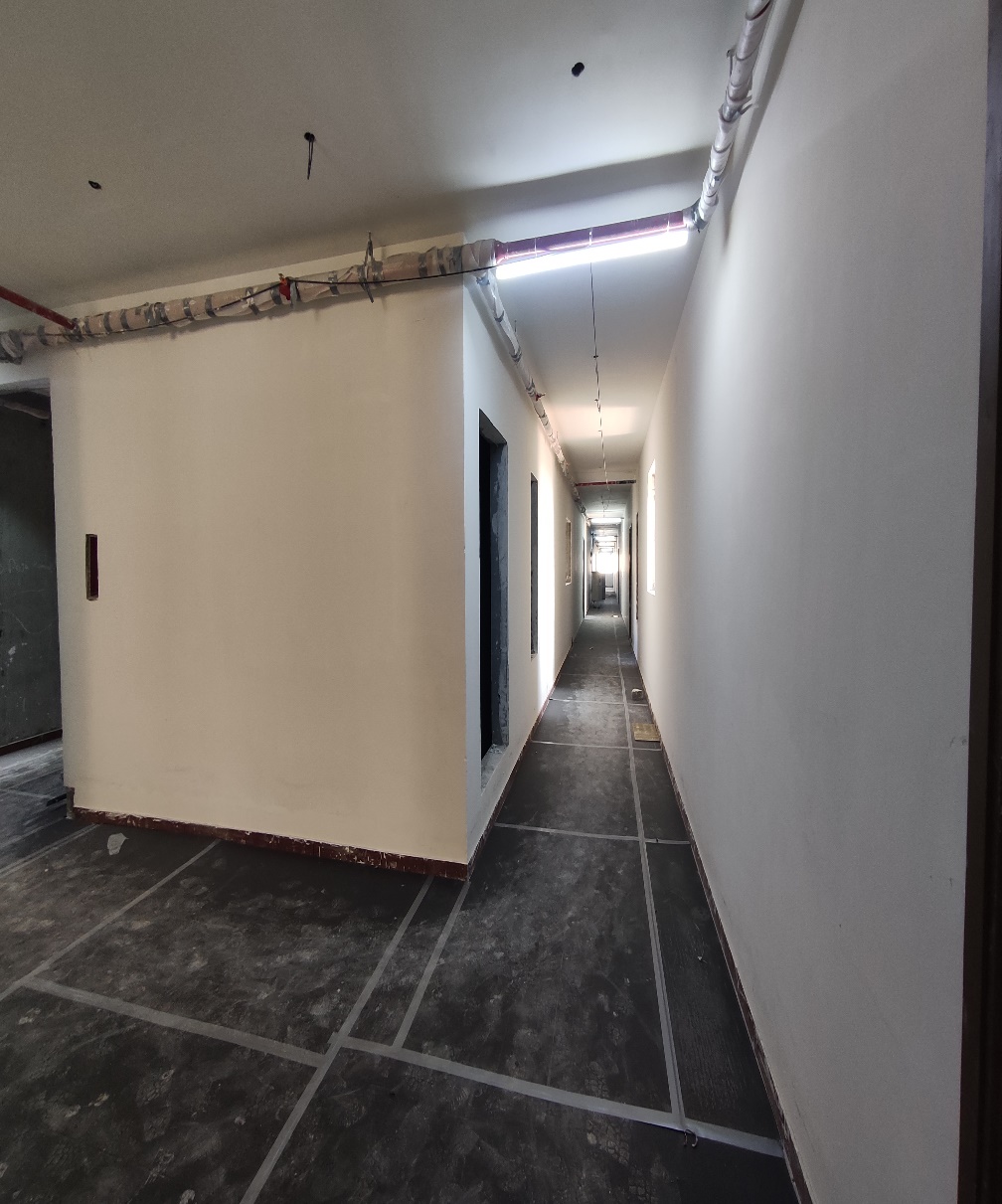

Tiling Work In Progress - Jun 2025

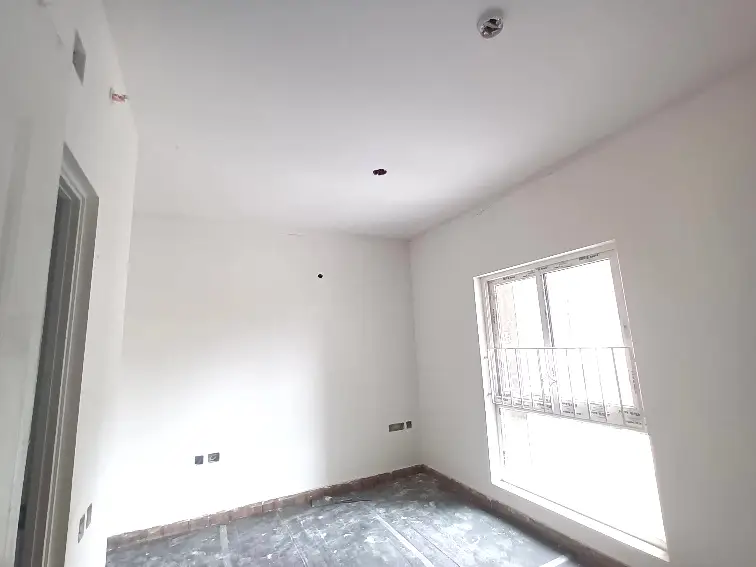

Painting work in progress - Jun 2025

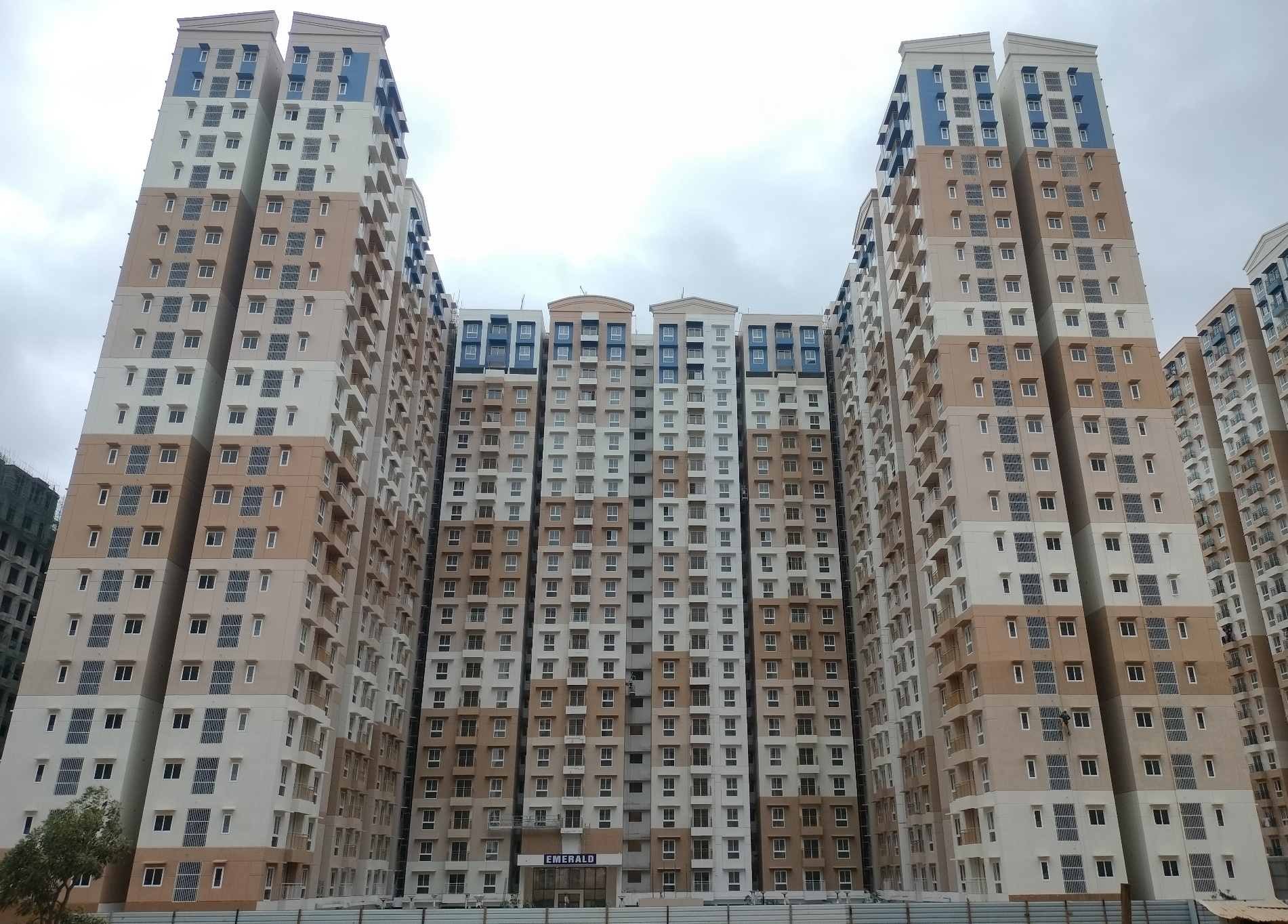

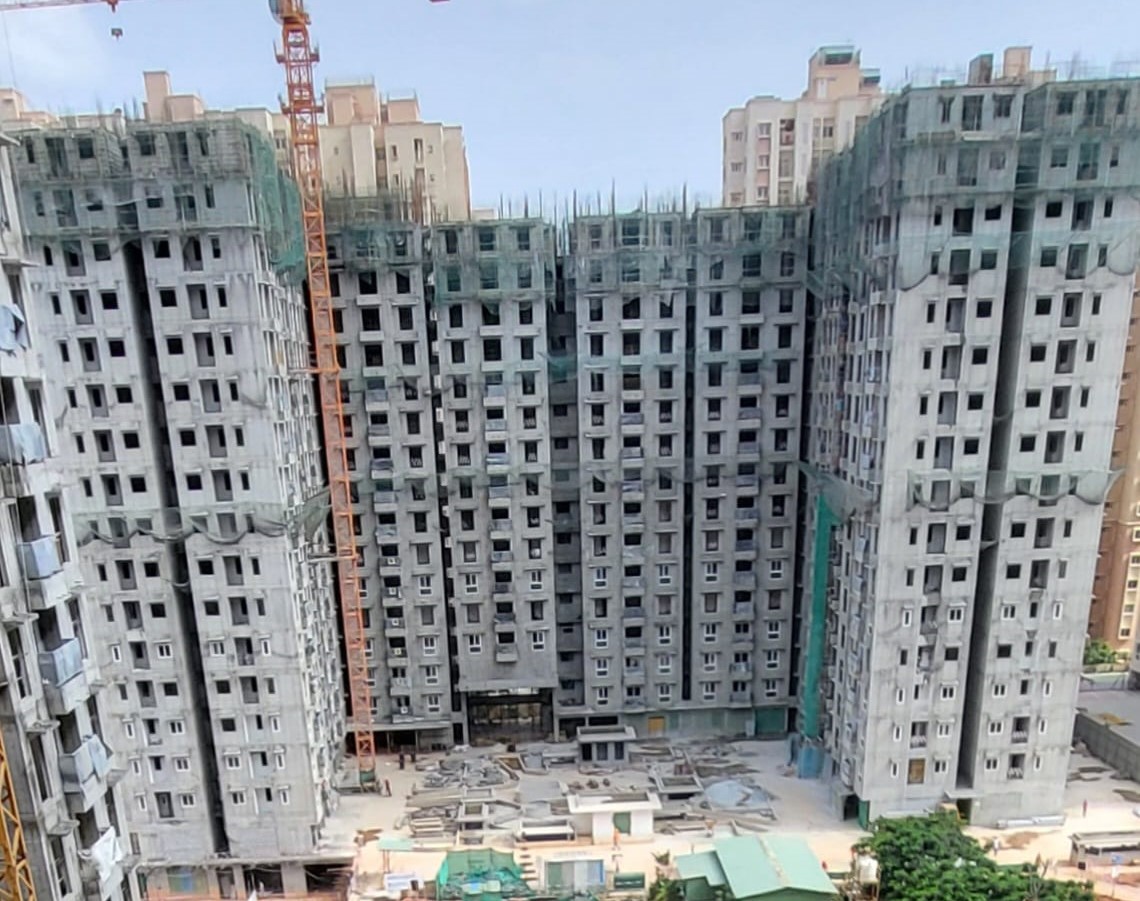

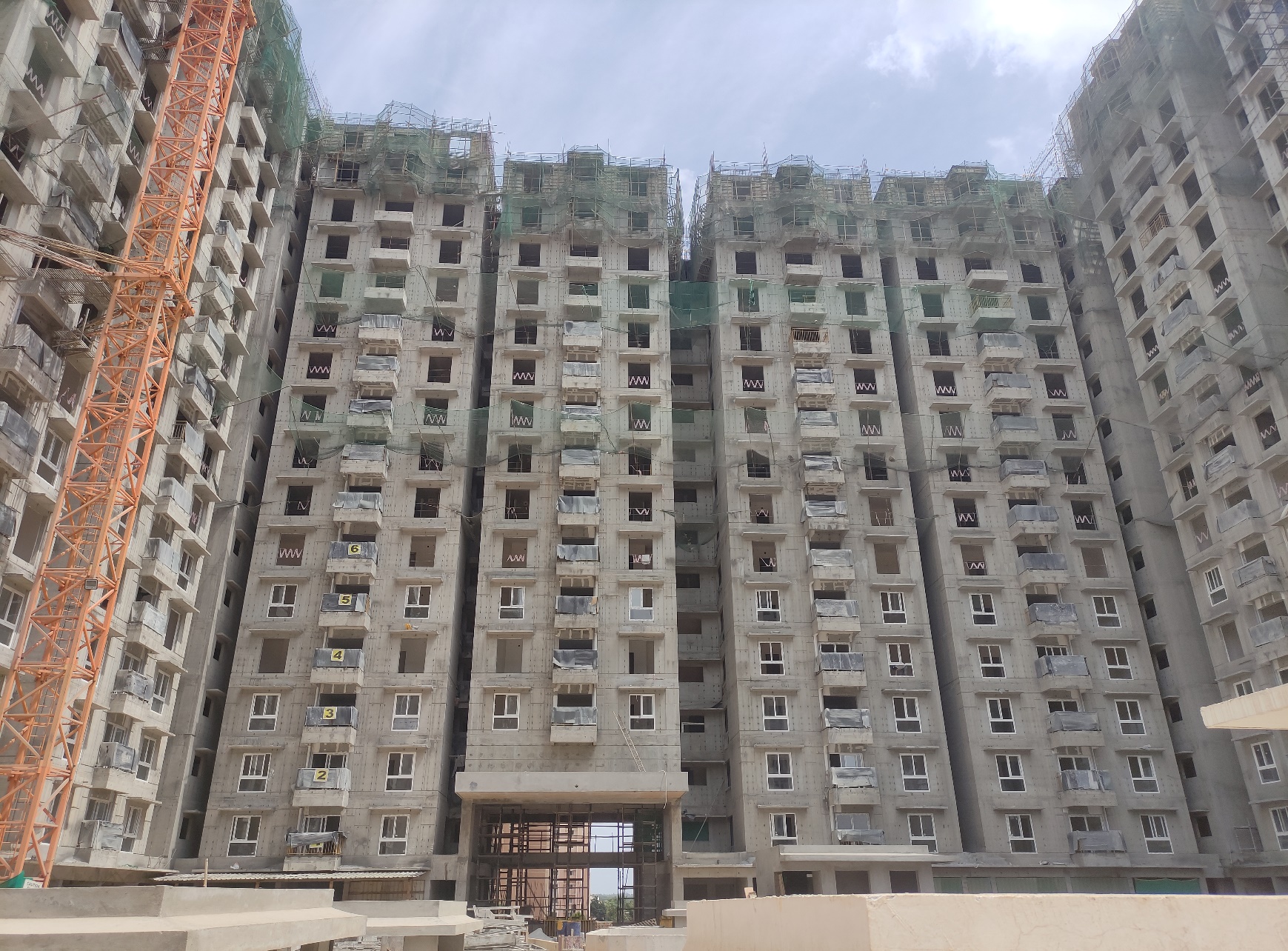

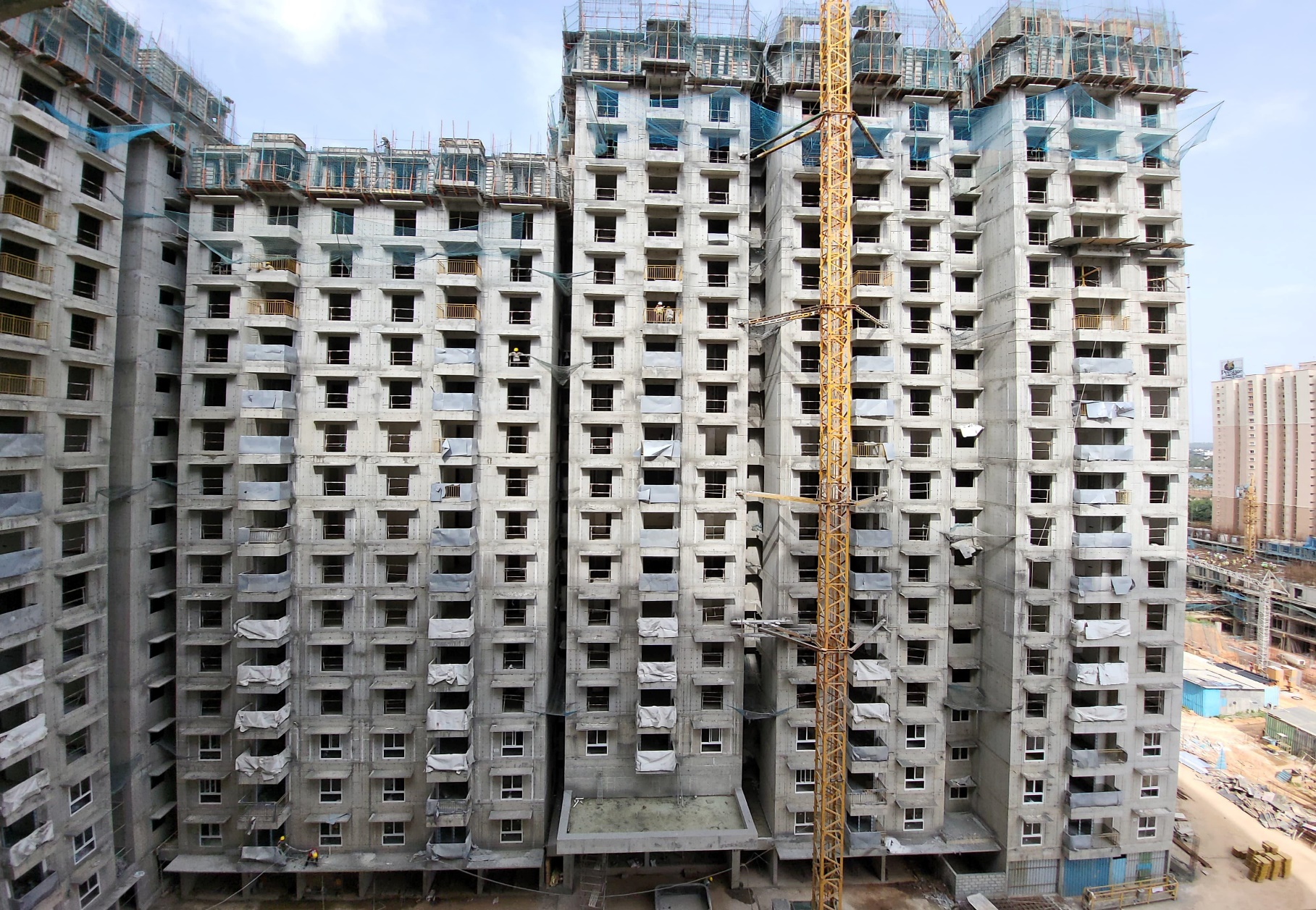

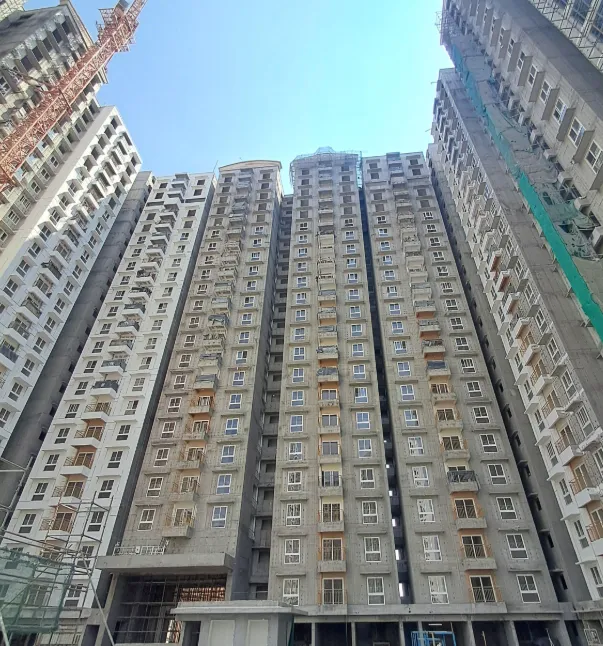

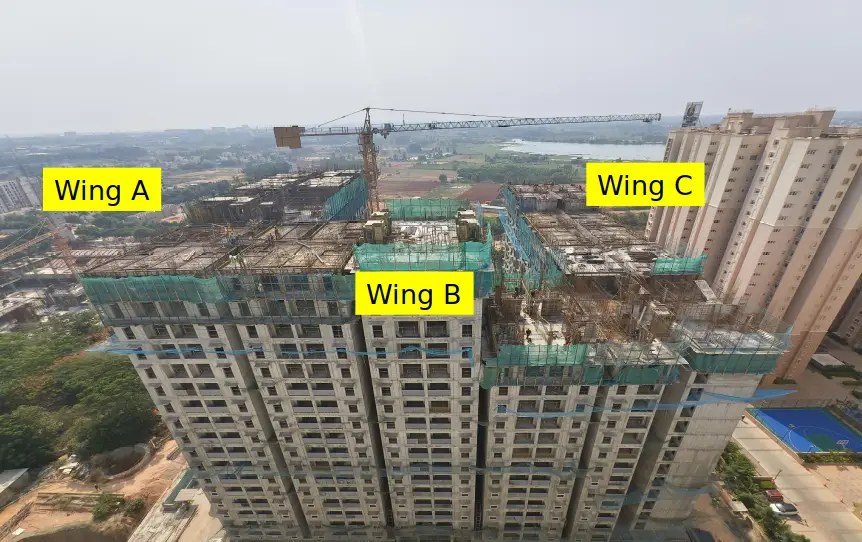

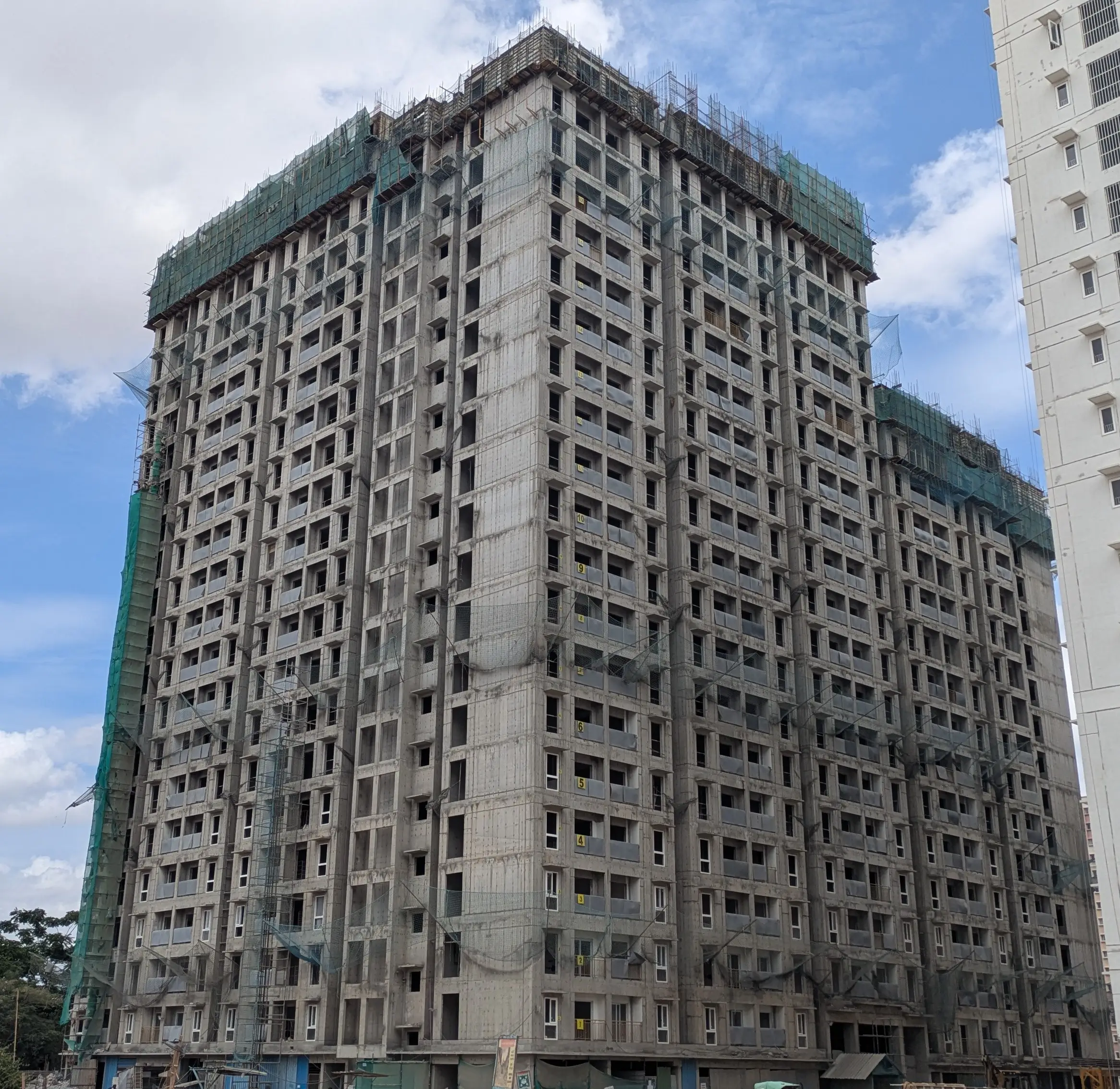

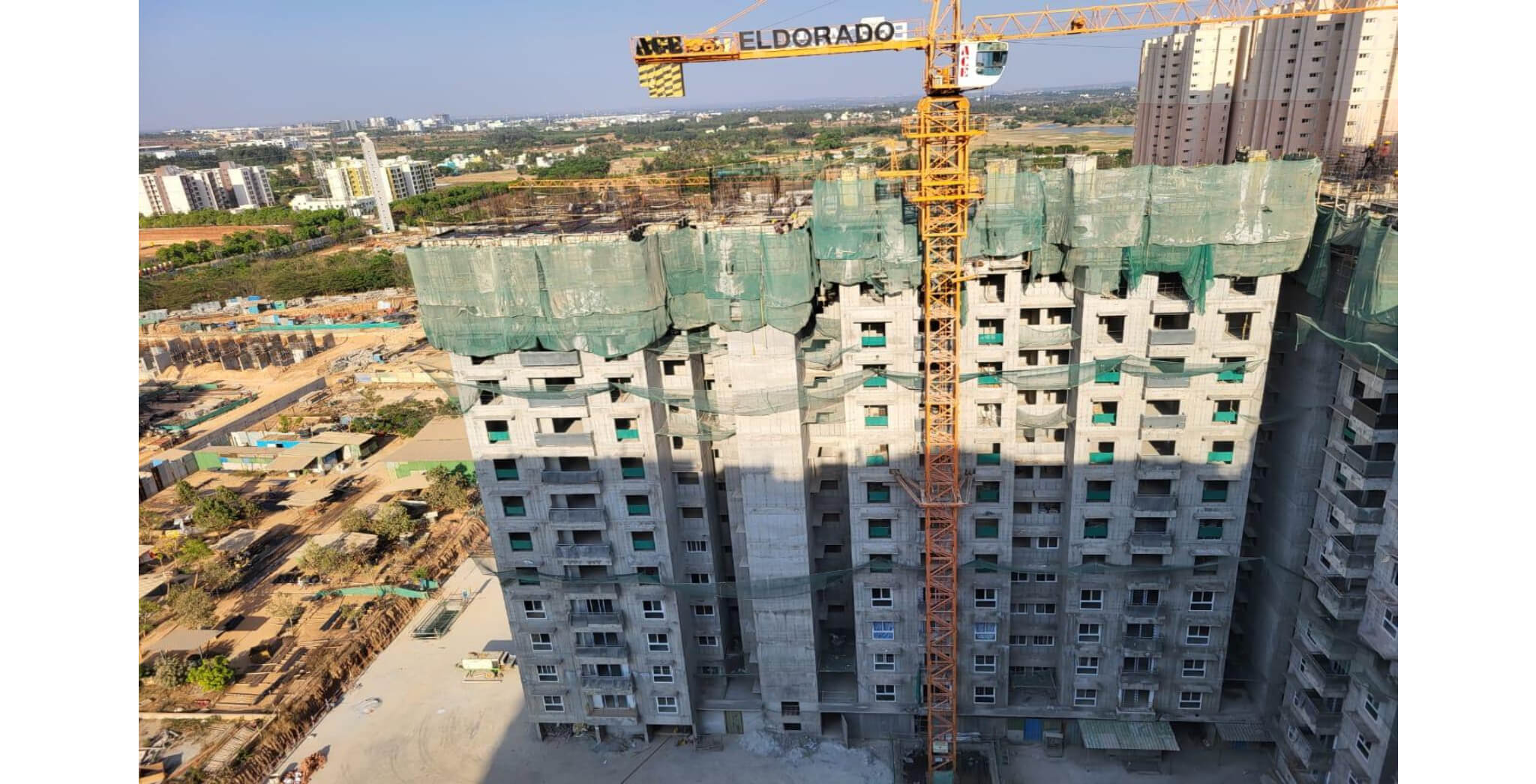

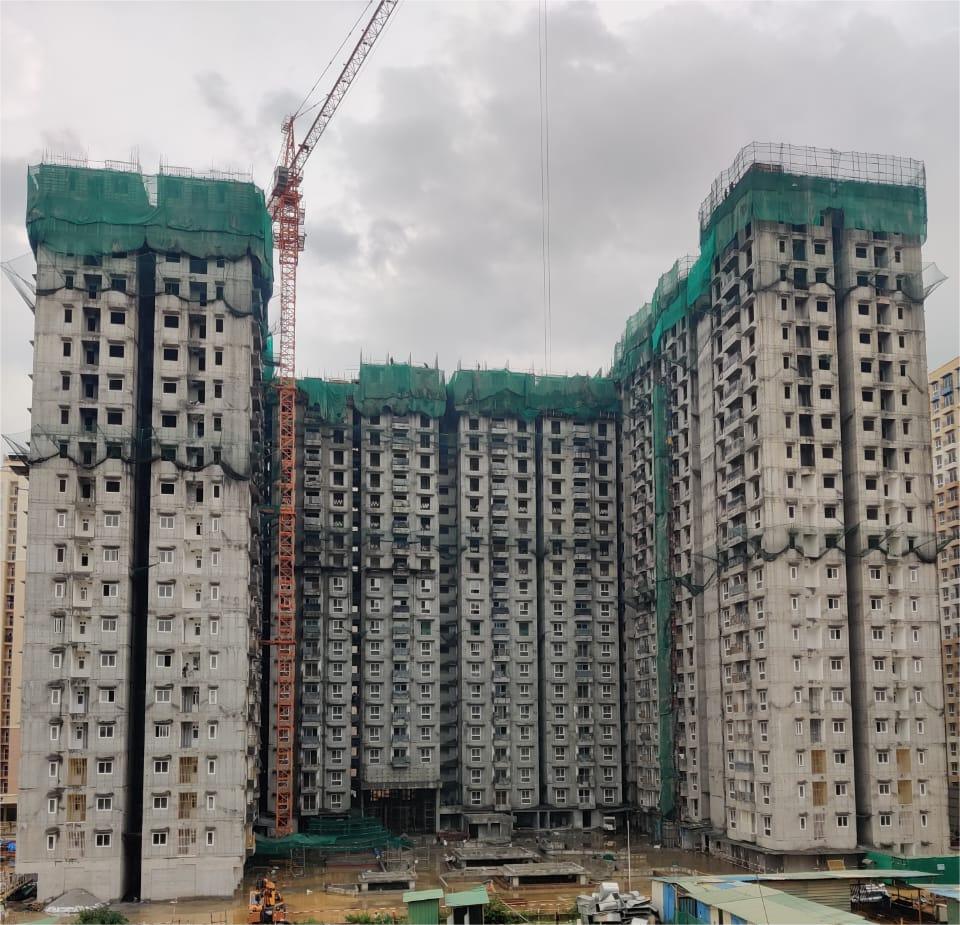

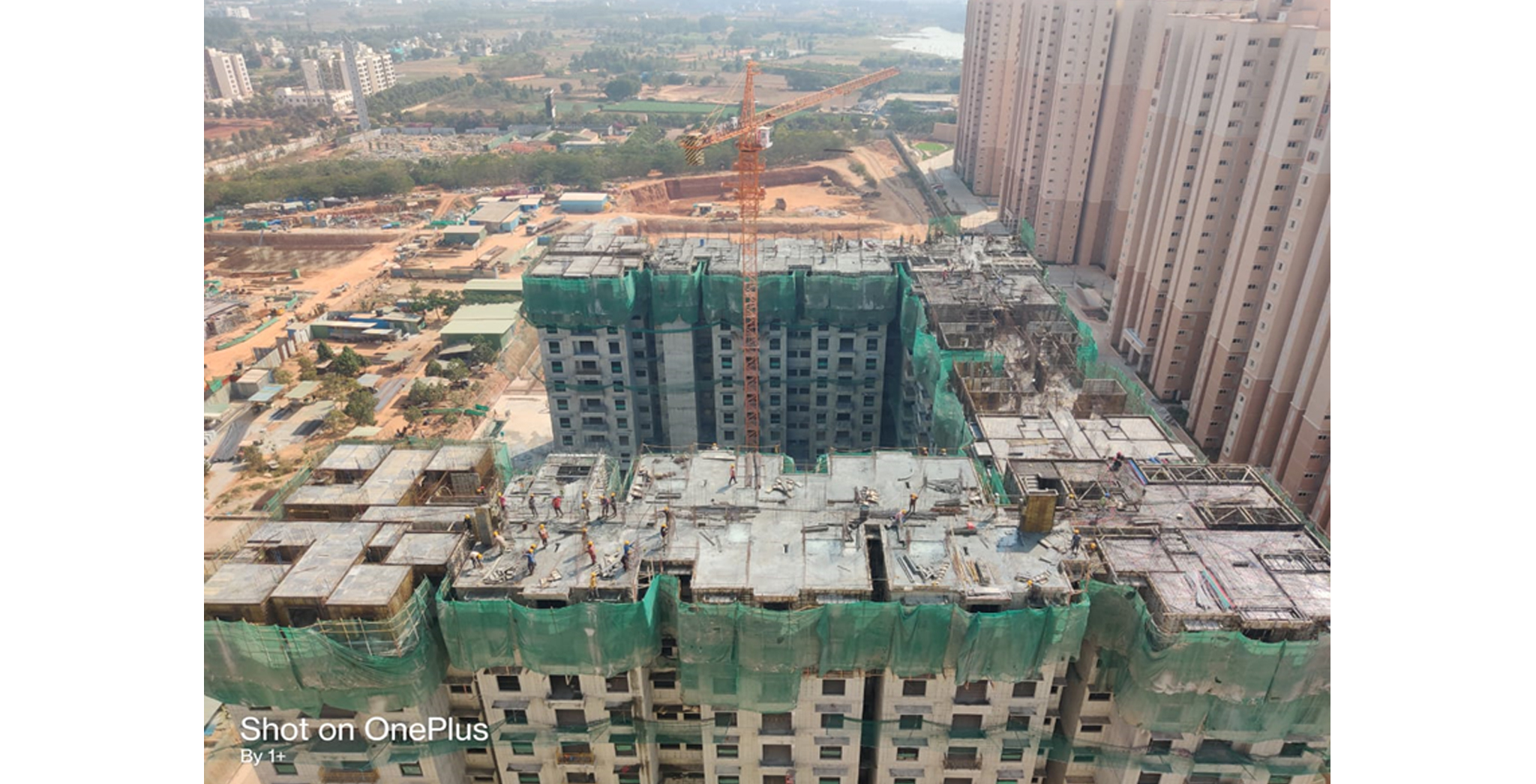

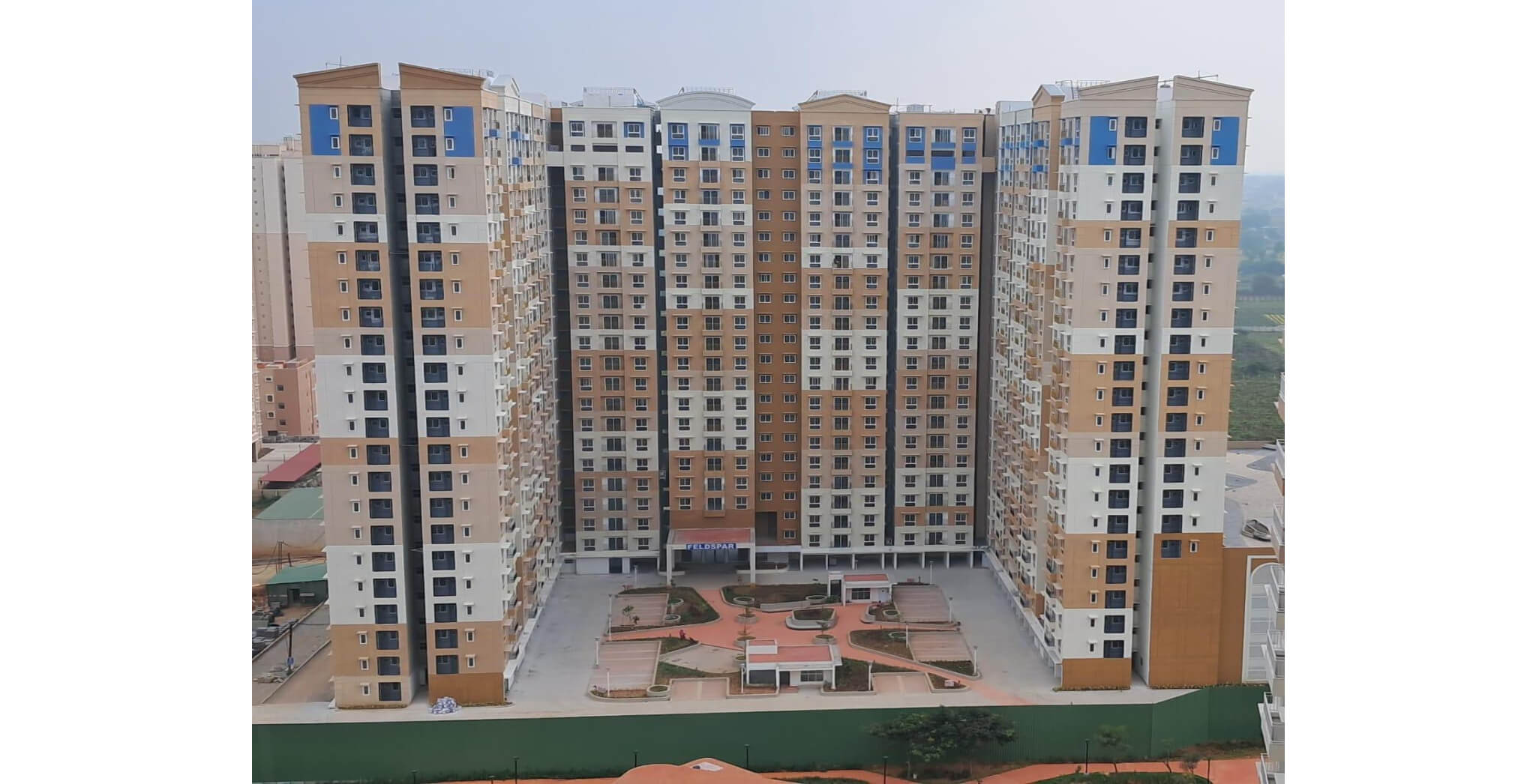

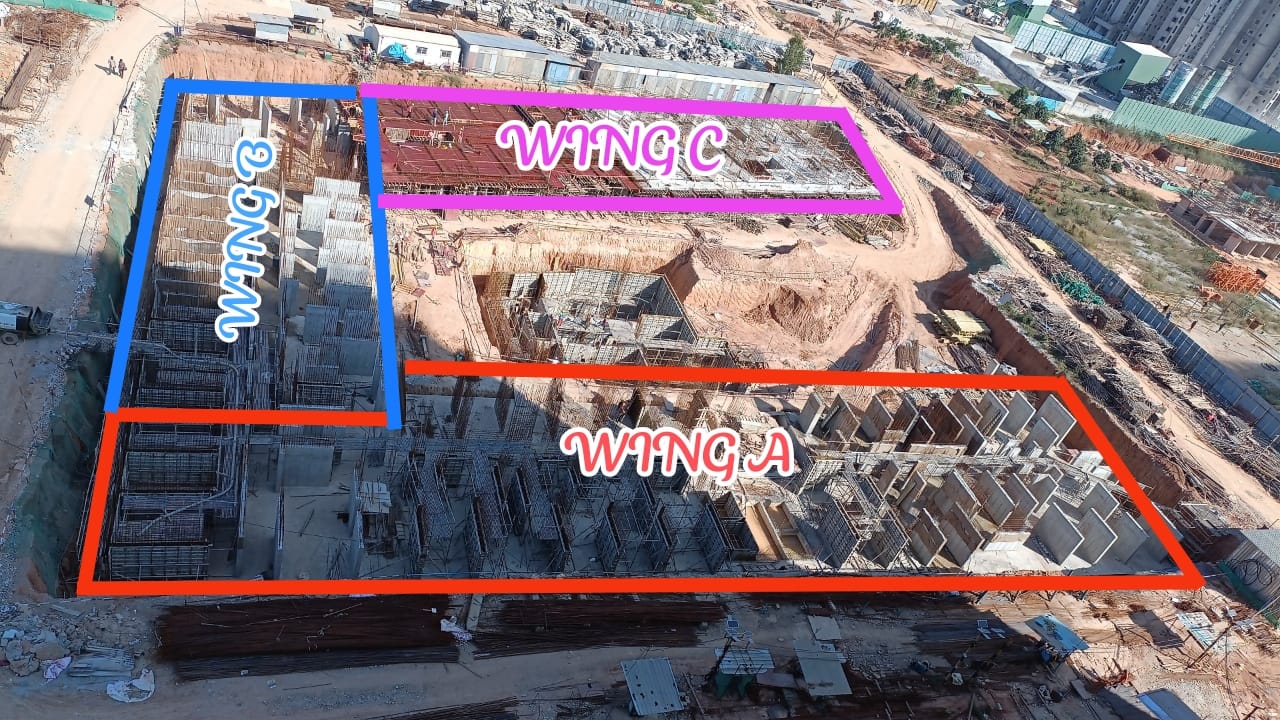

Overall View - Jun 2025

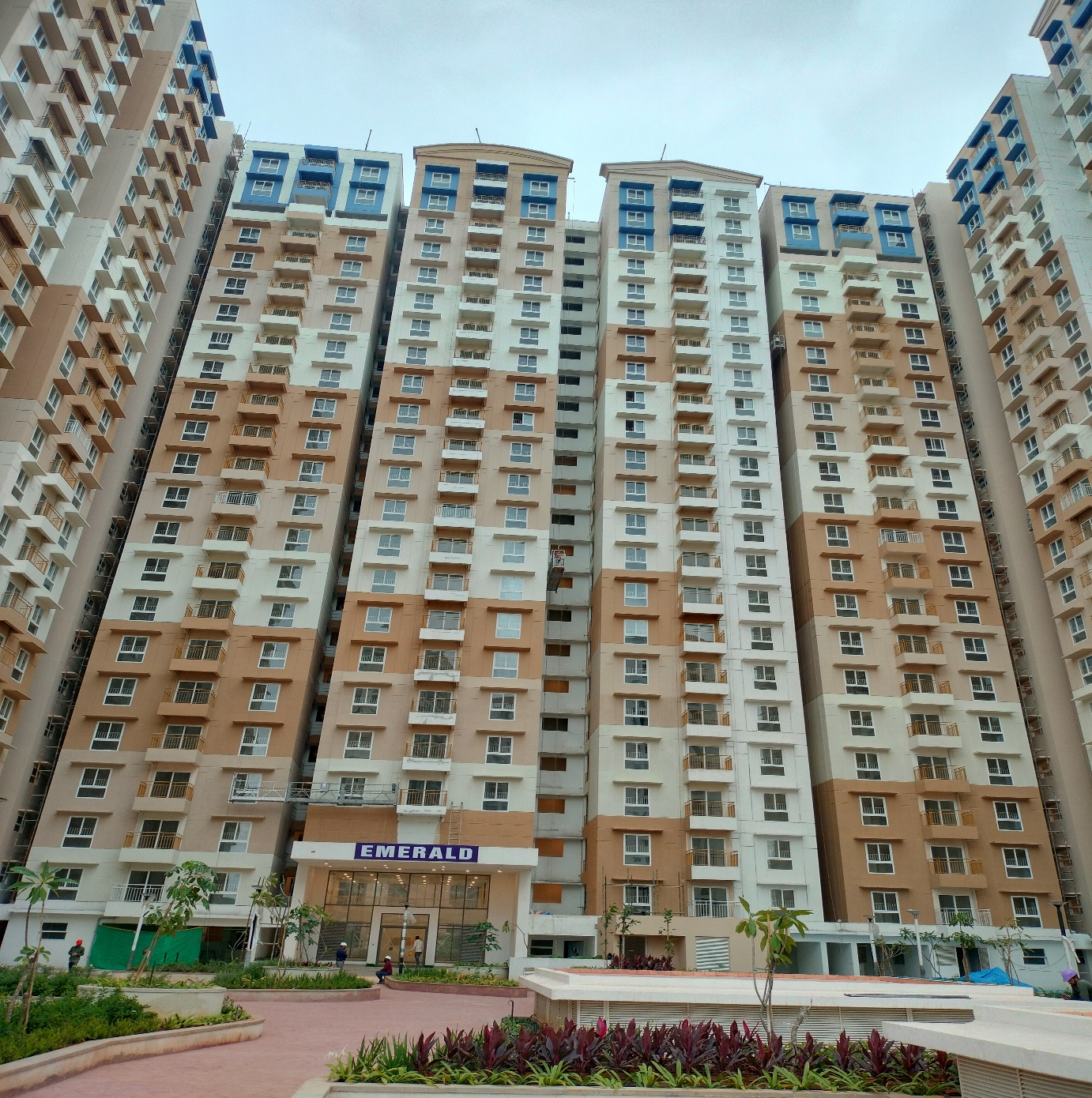

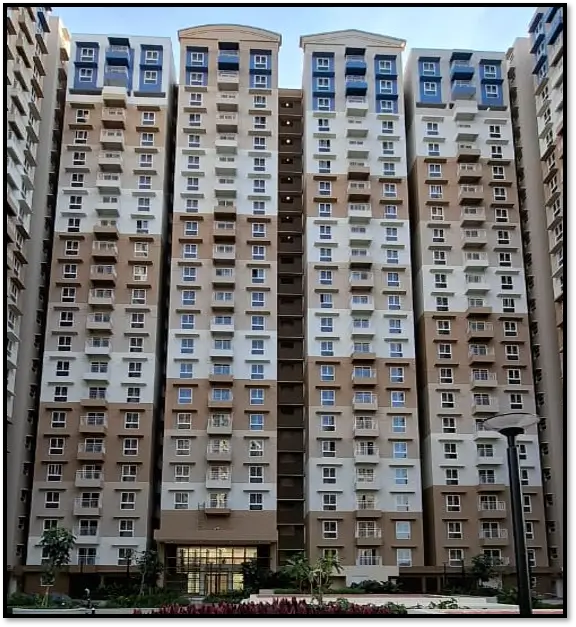

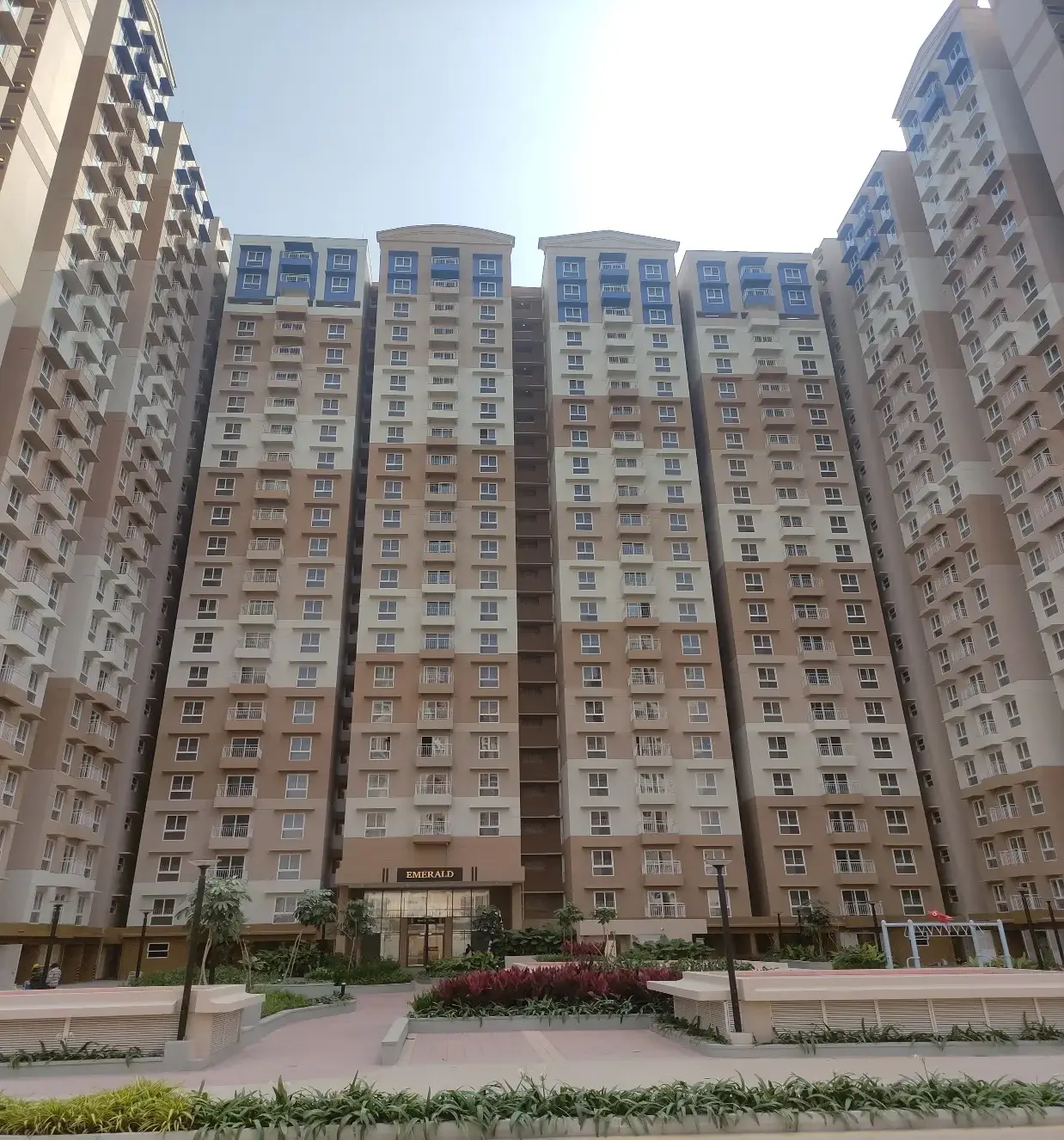

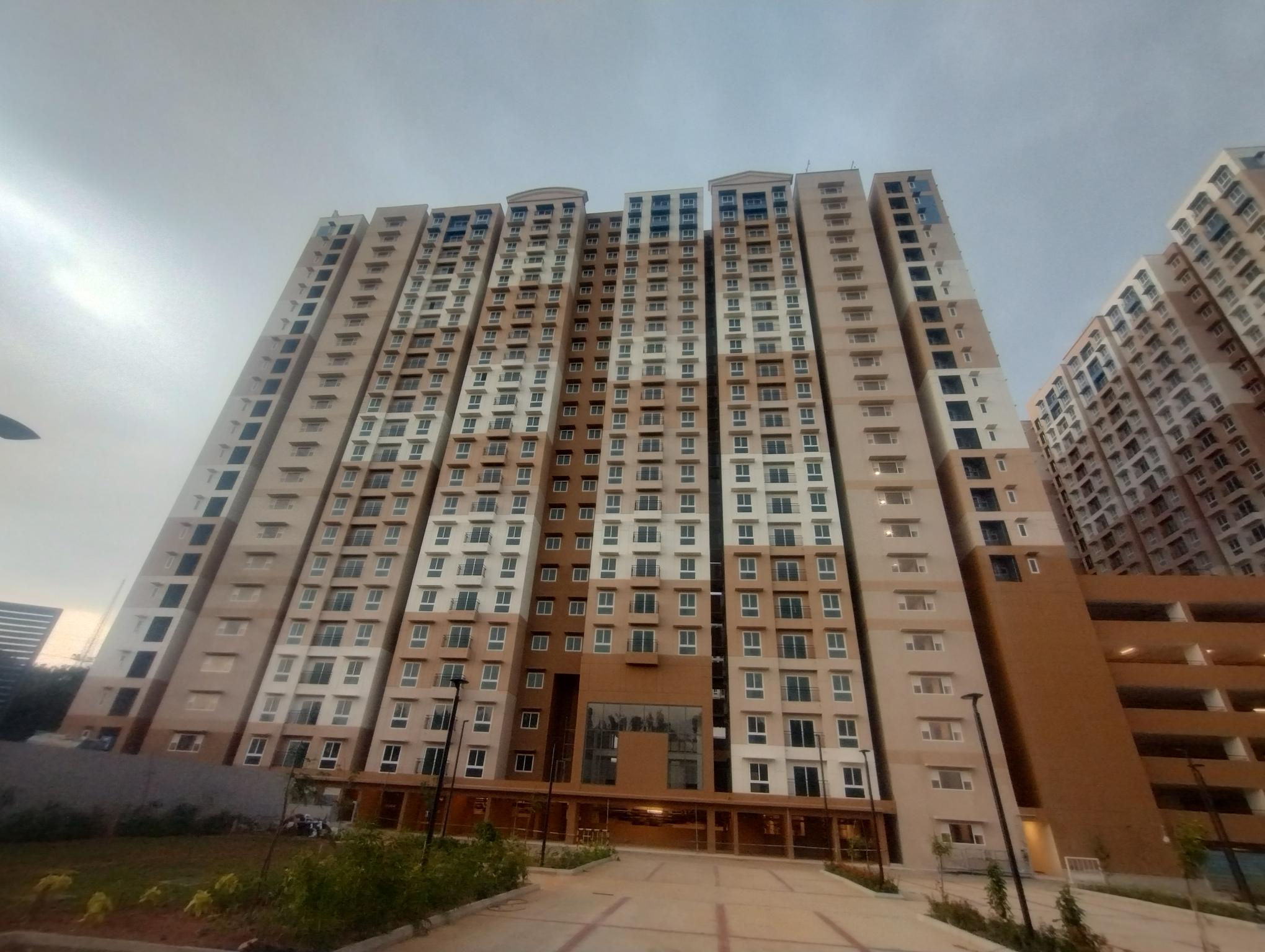

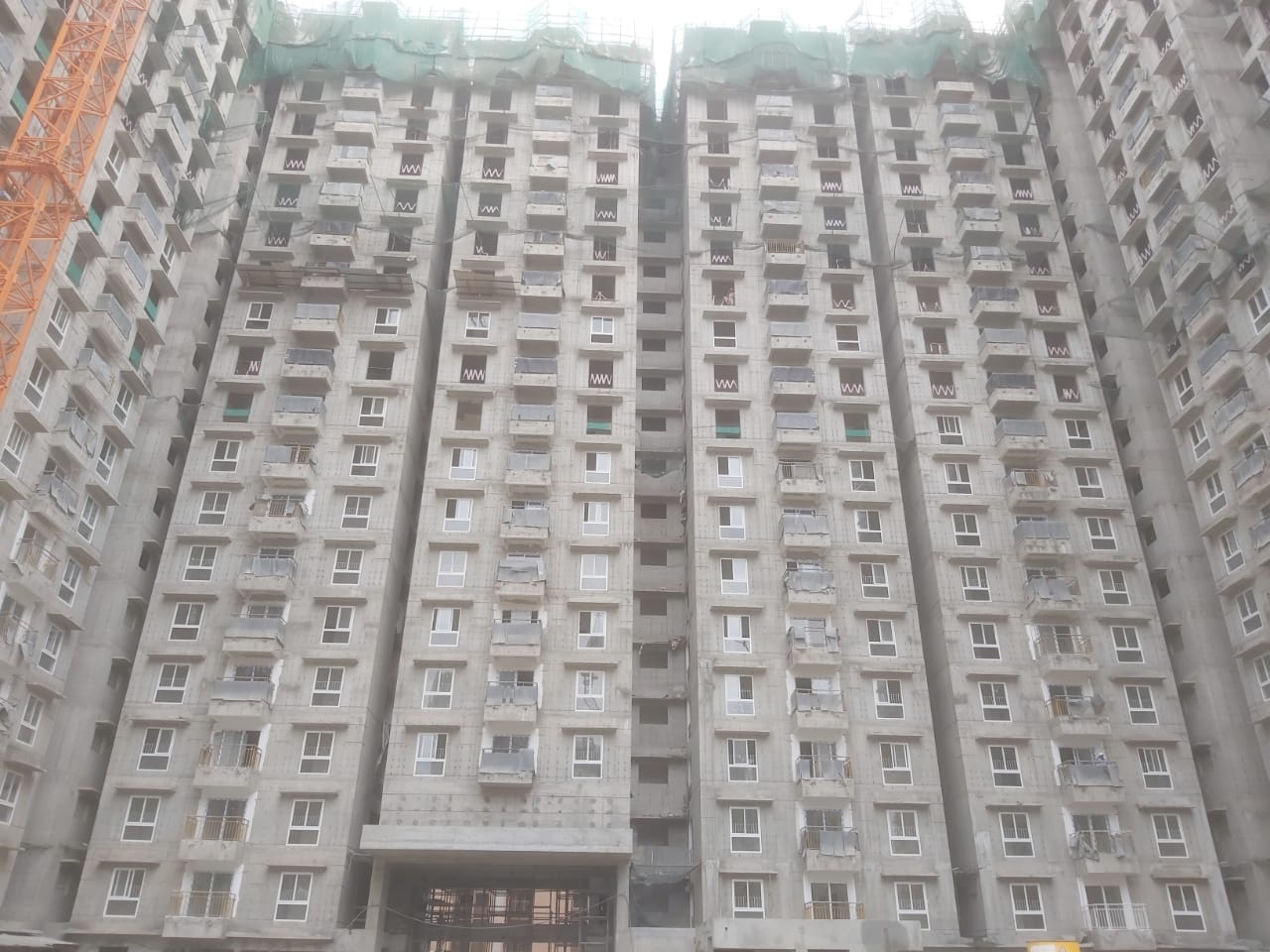

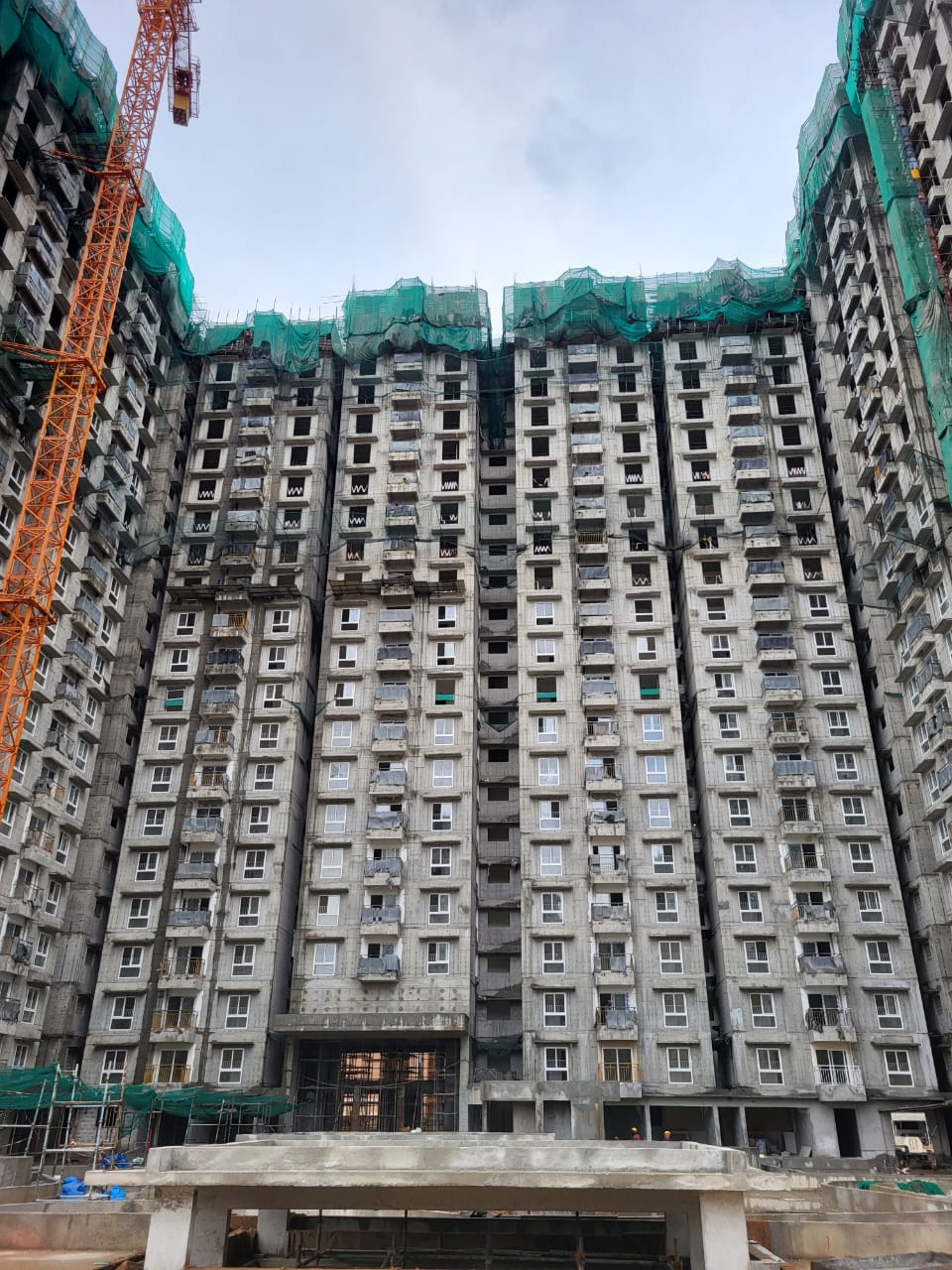

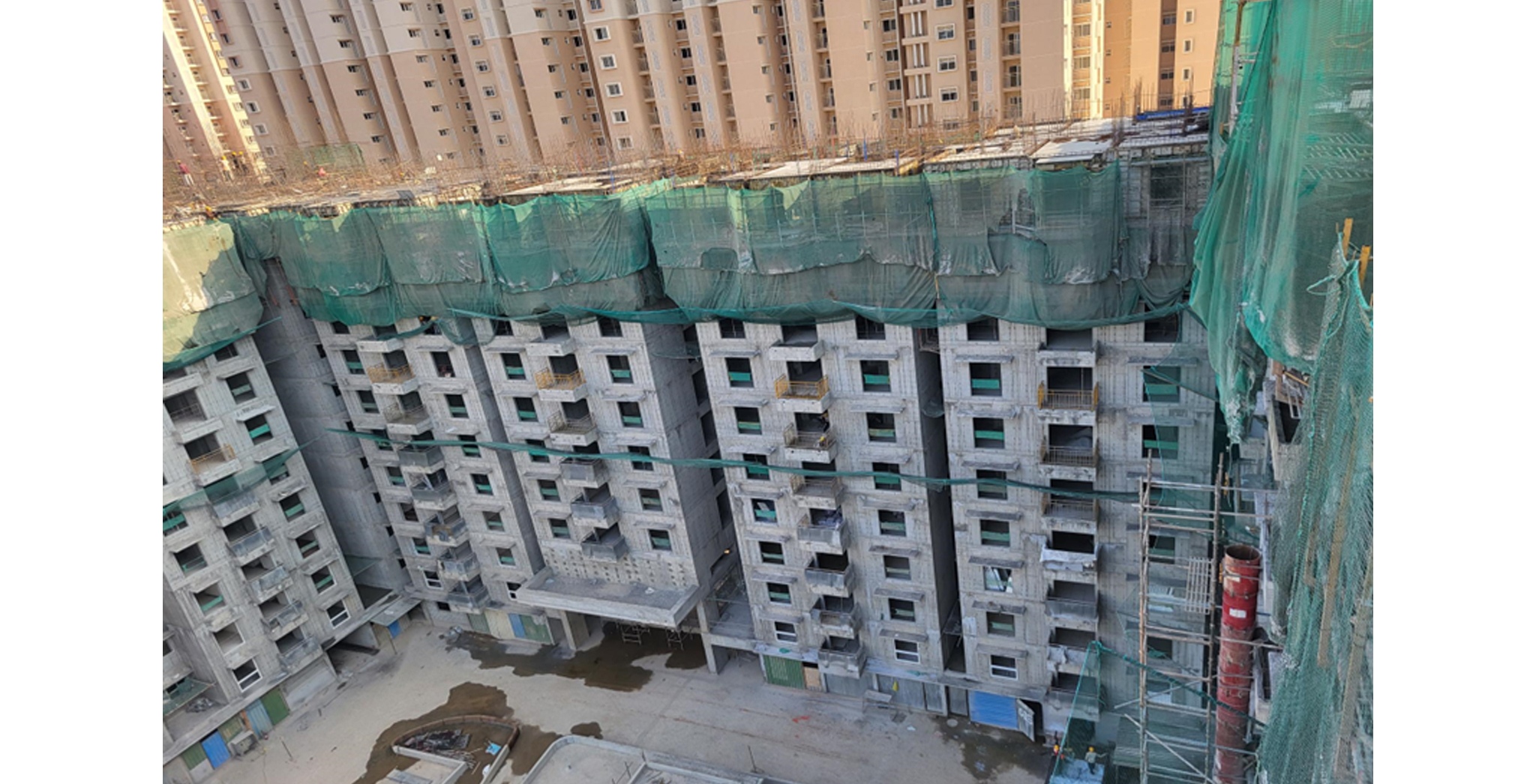

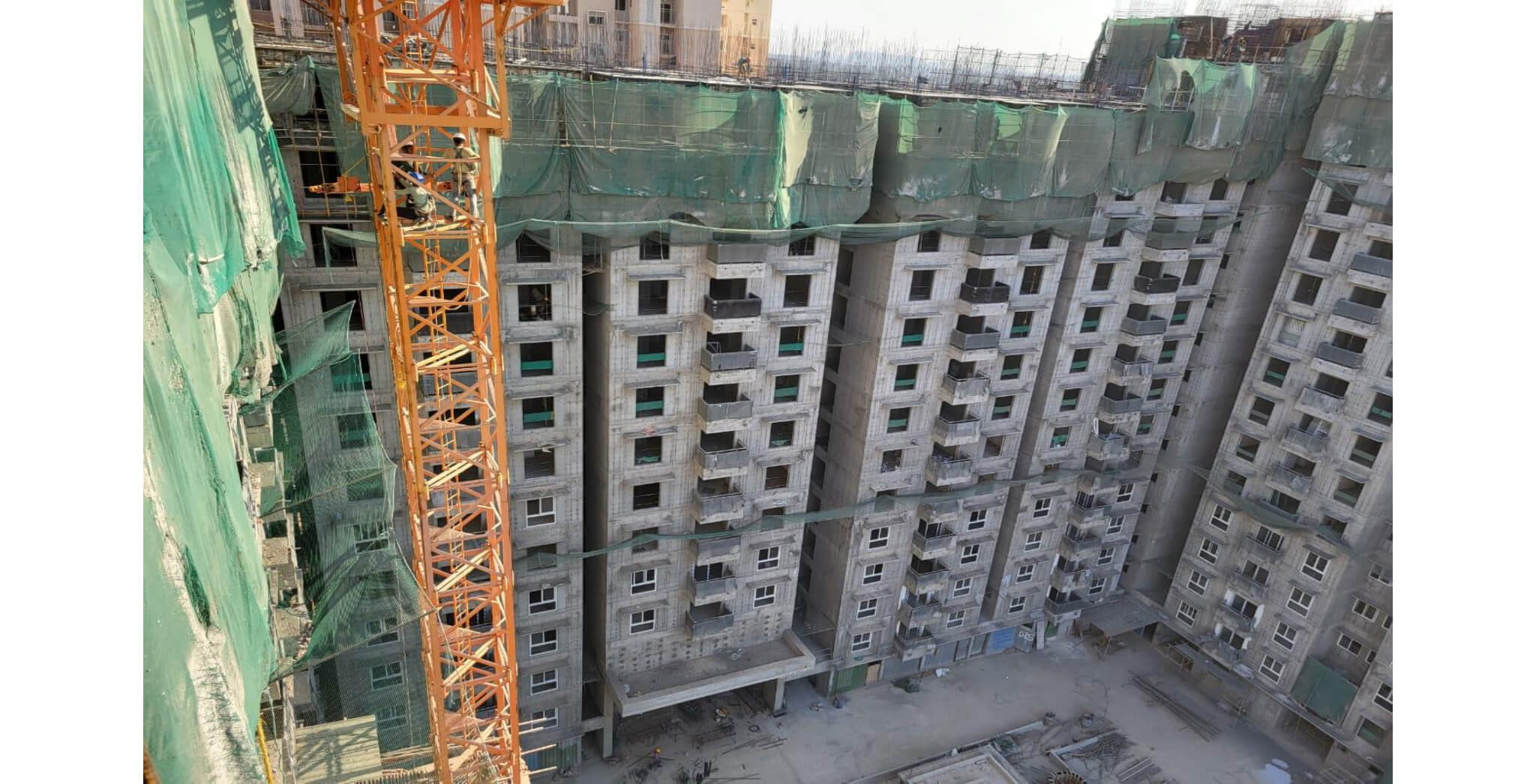

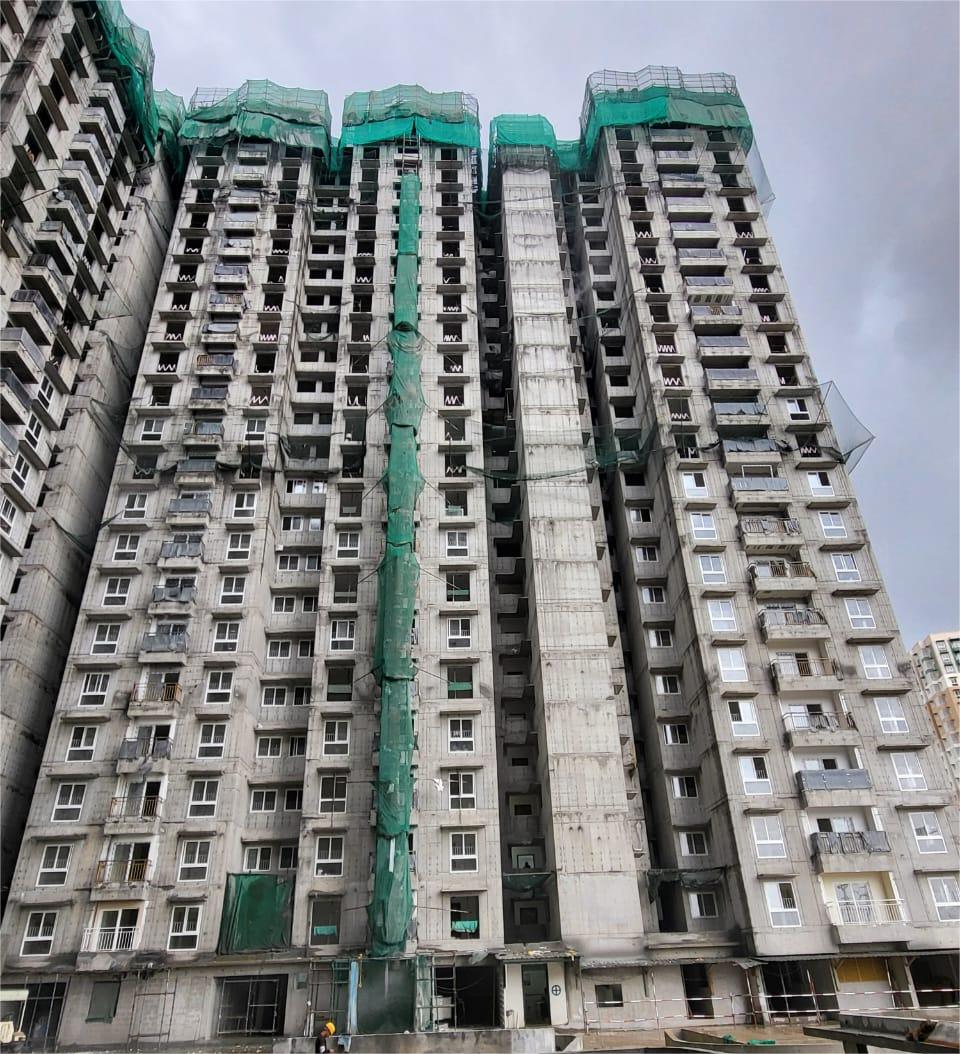

South Wing - Jun 2025

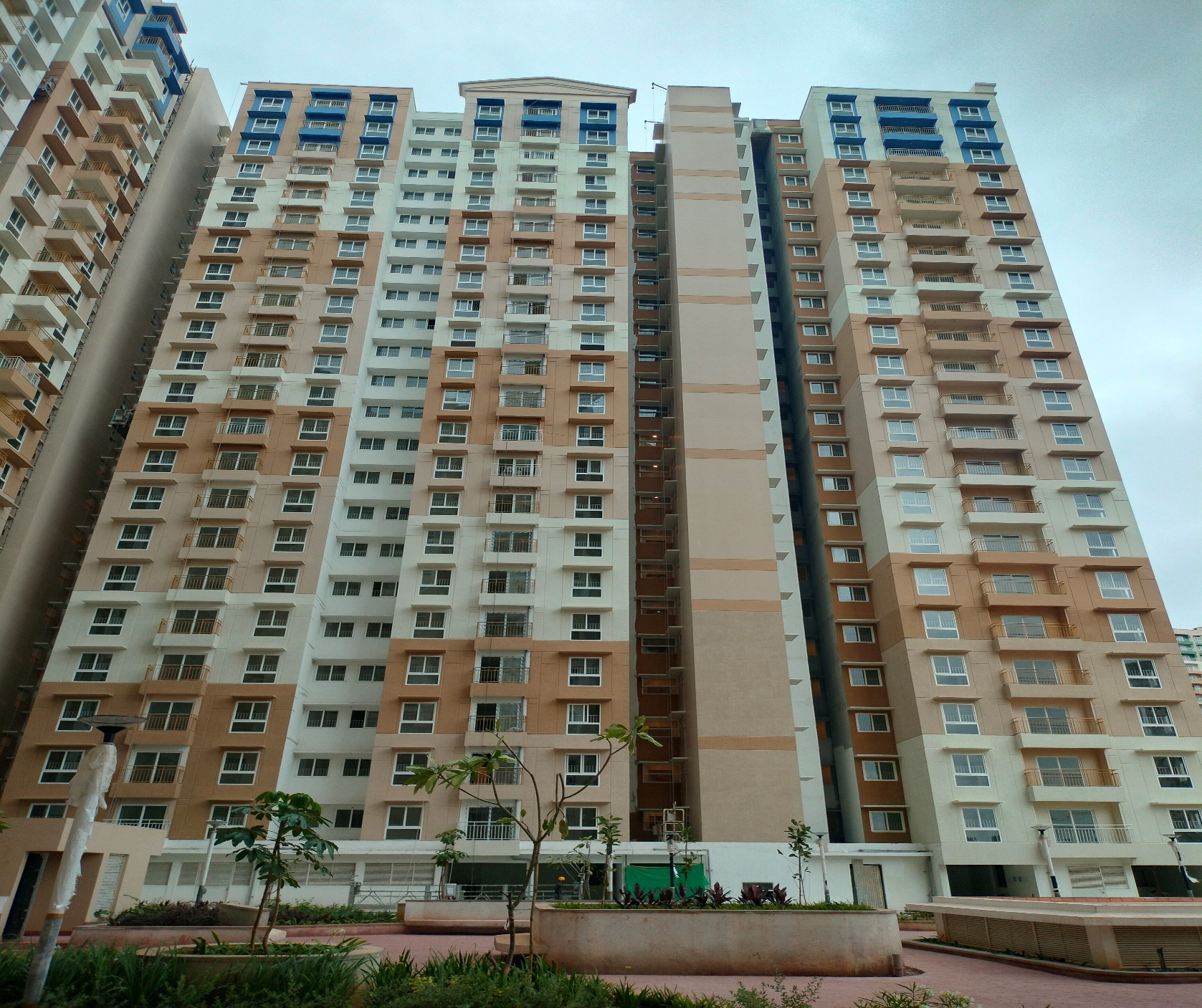

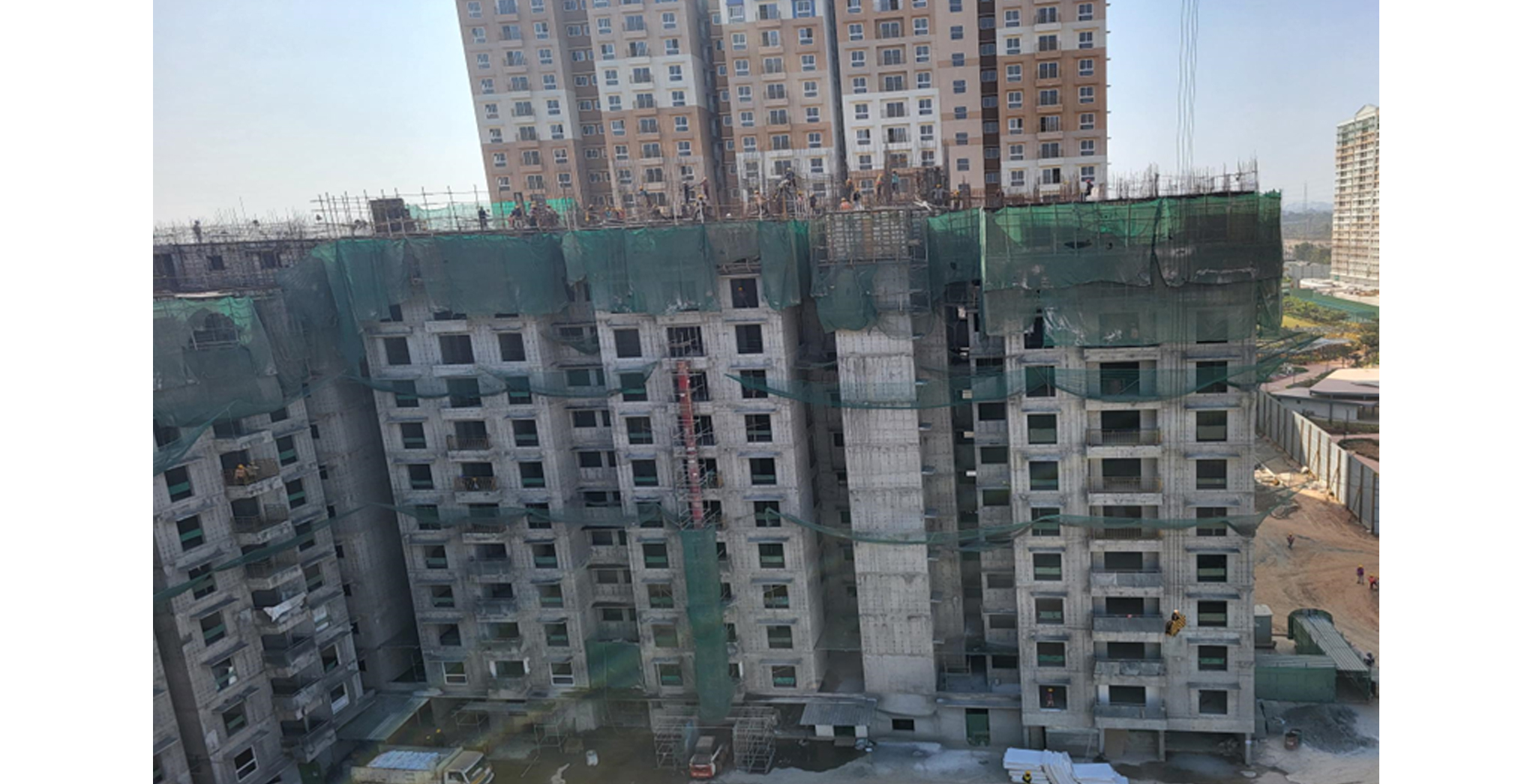

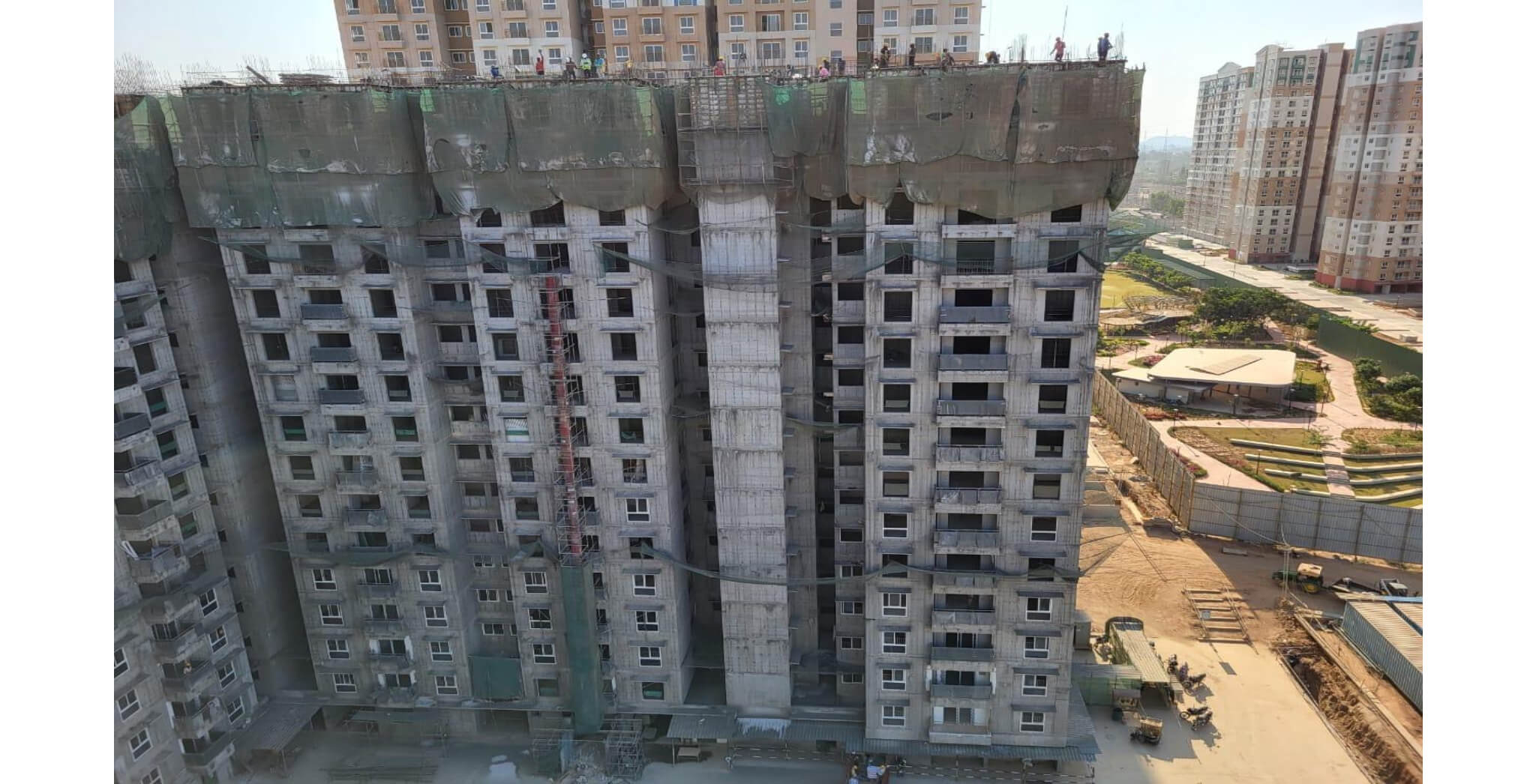

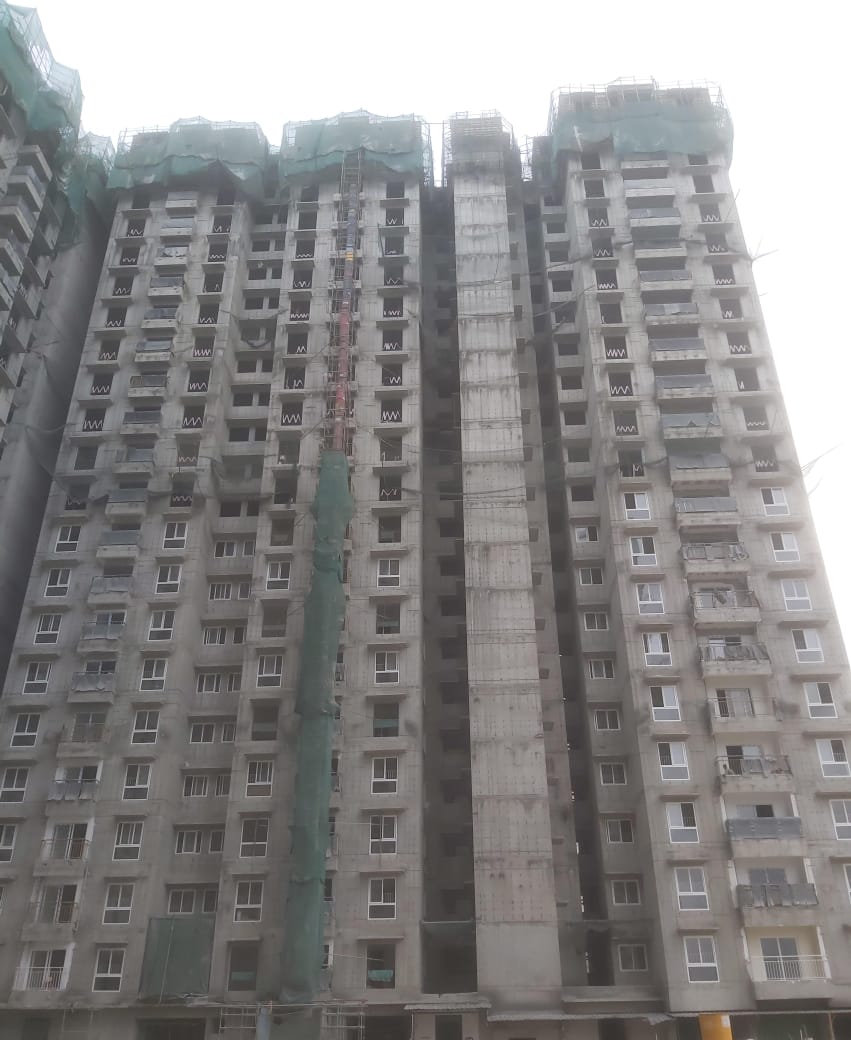

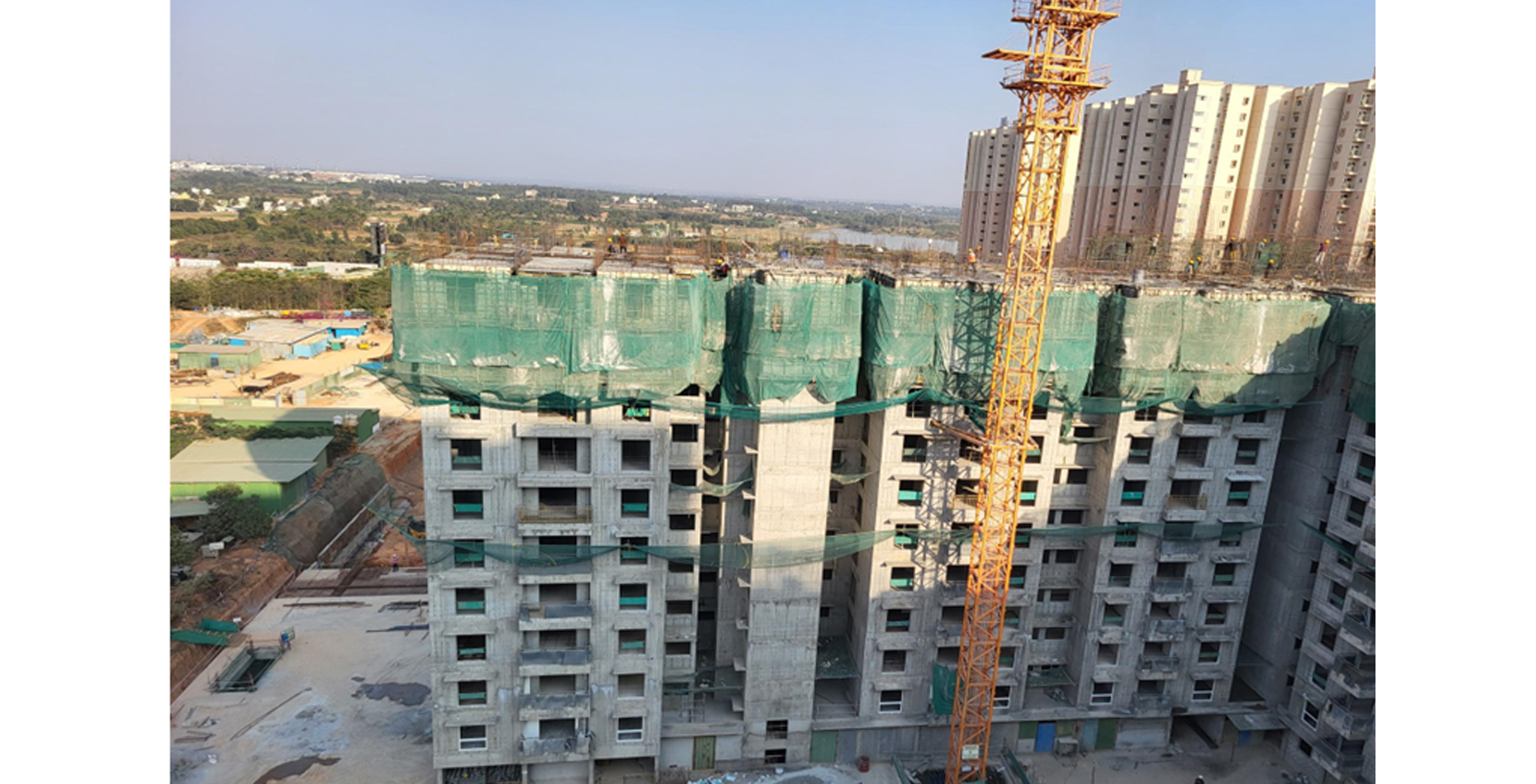

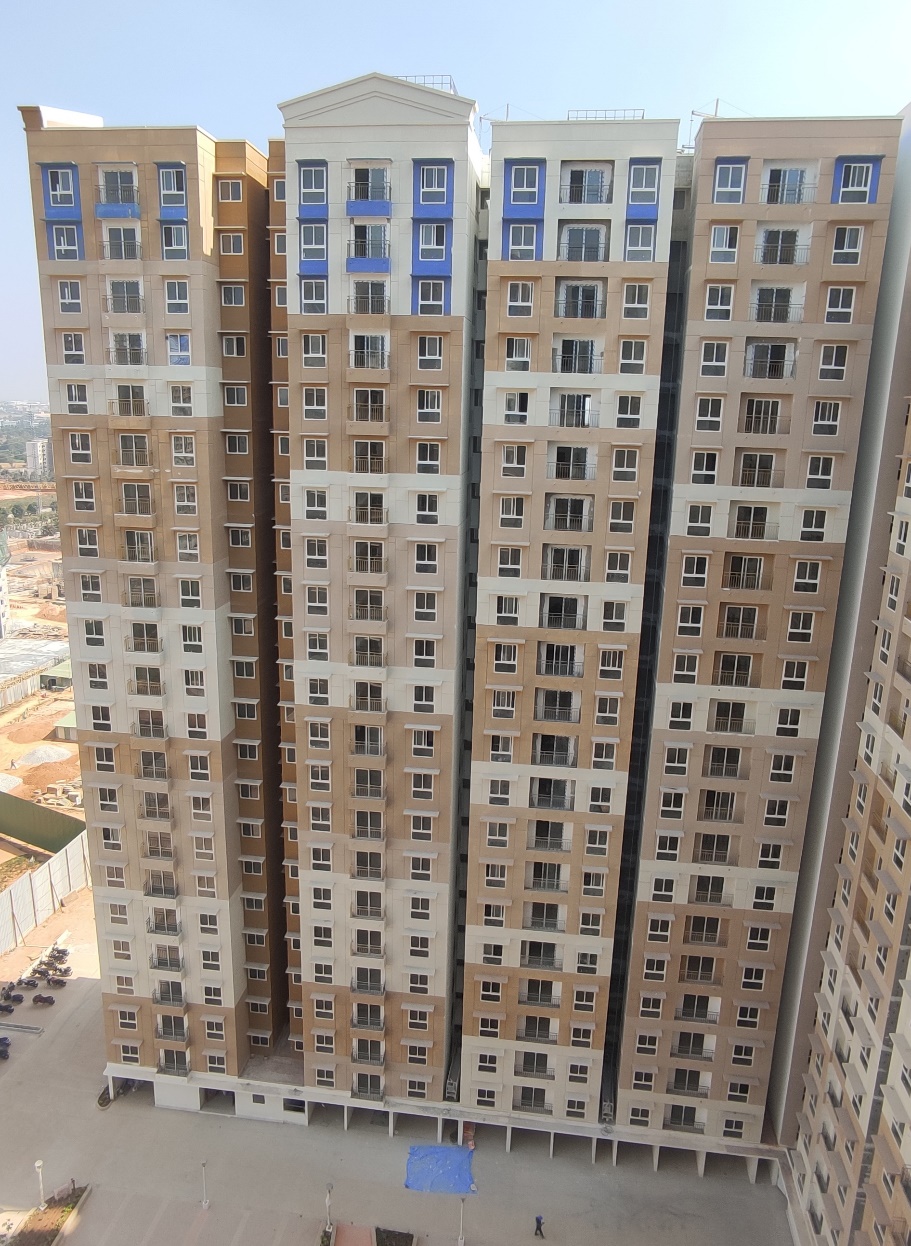

West Wing - Jun 2025

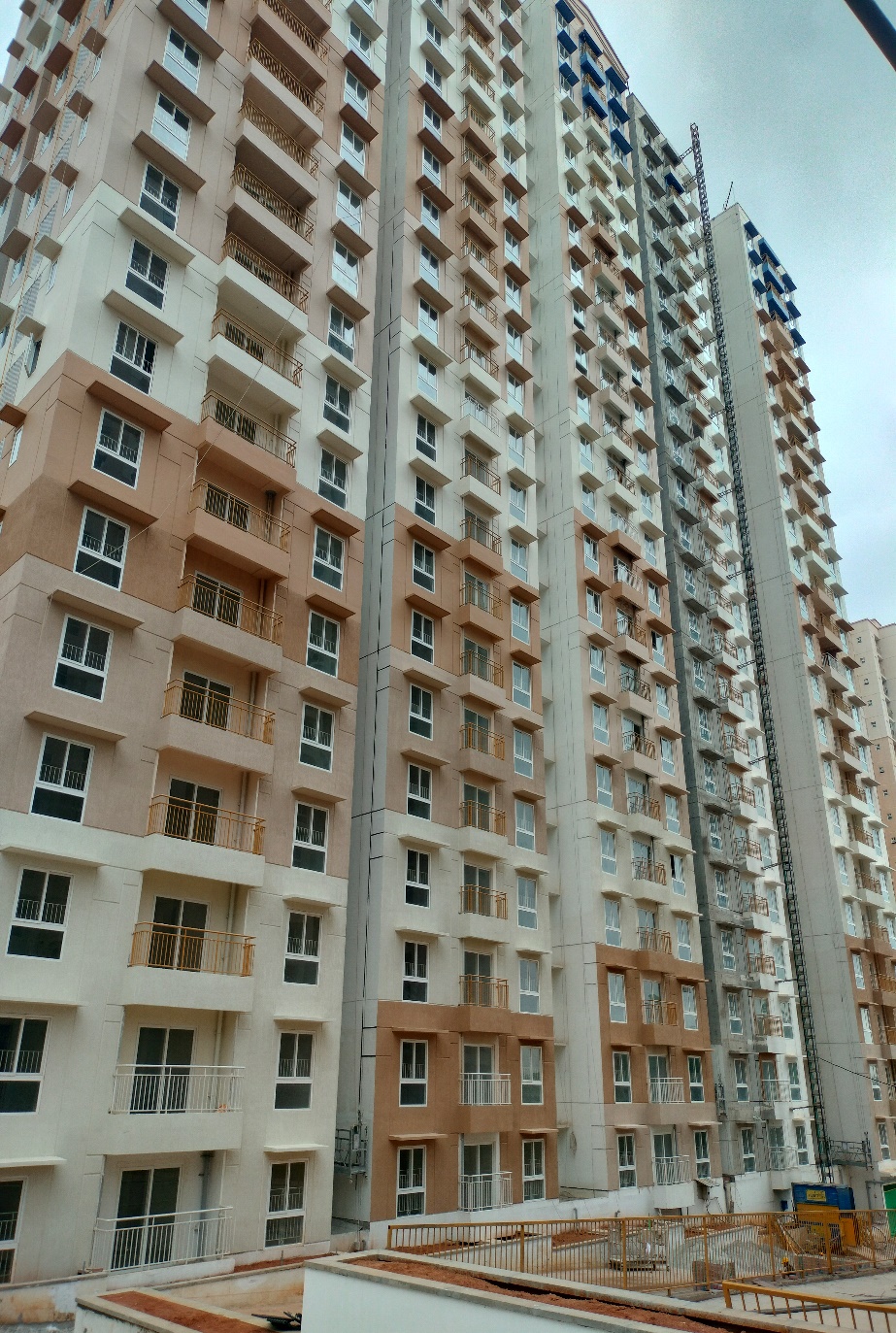

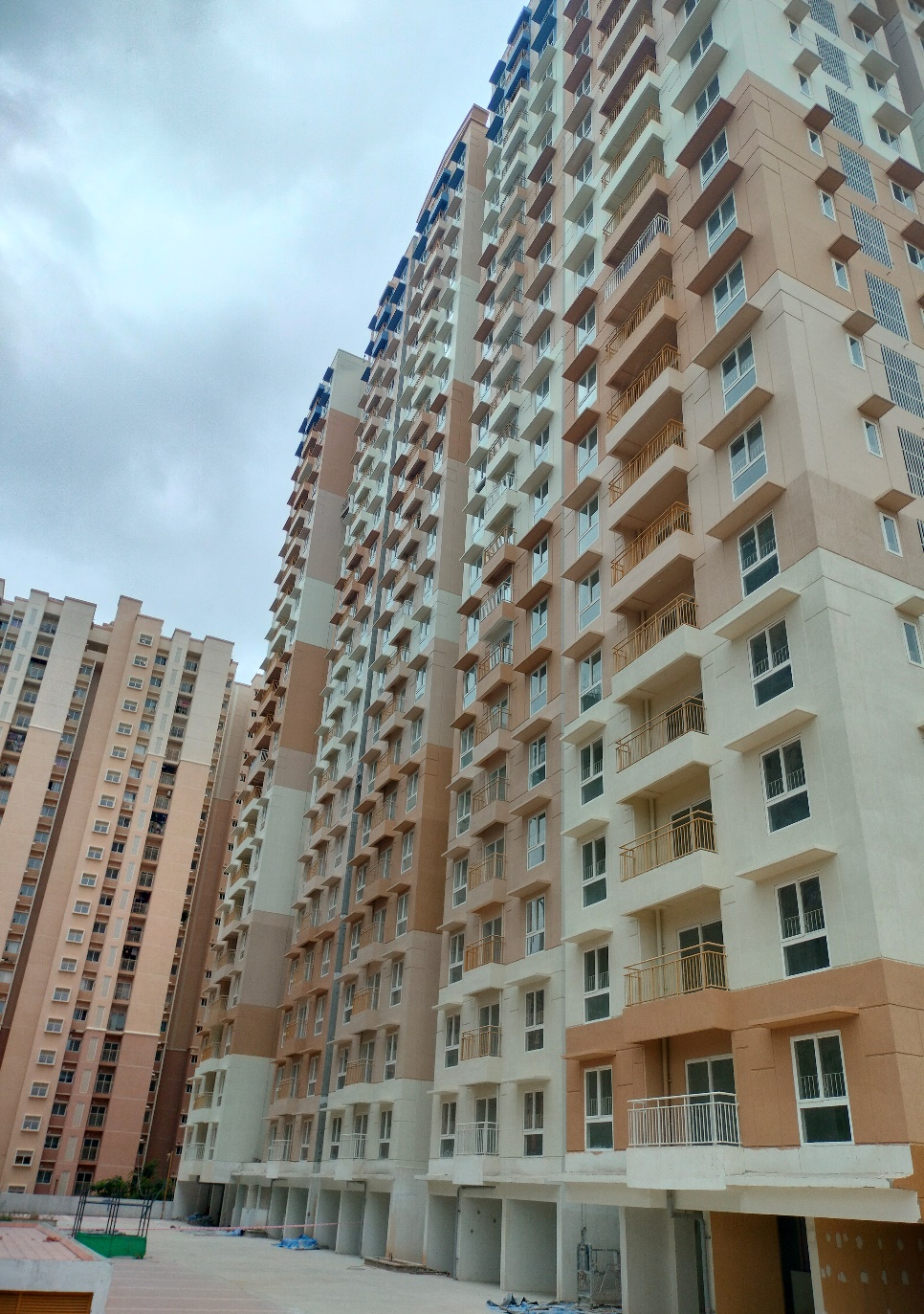

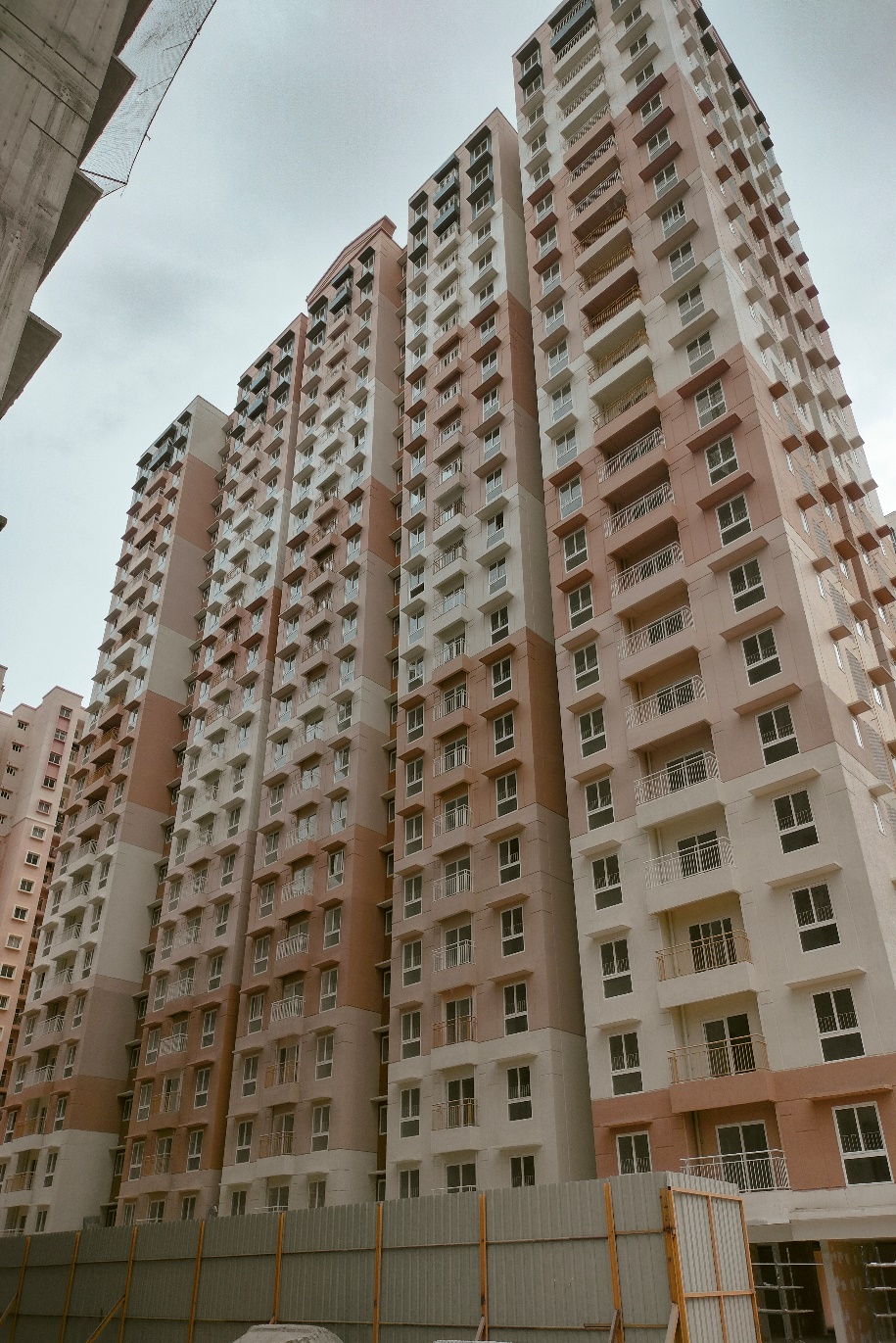

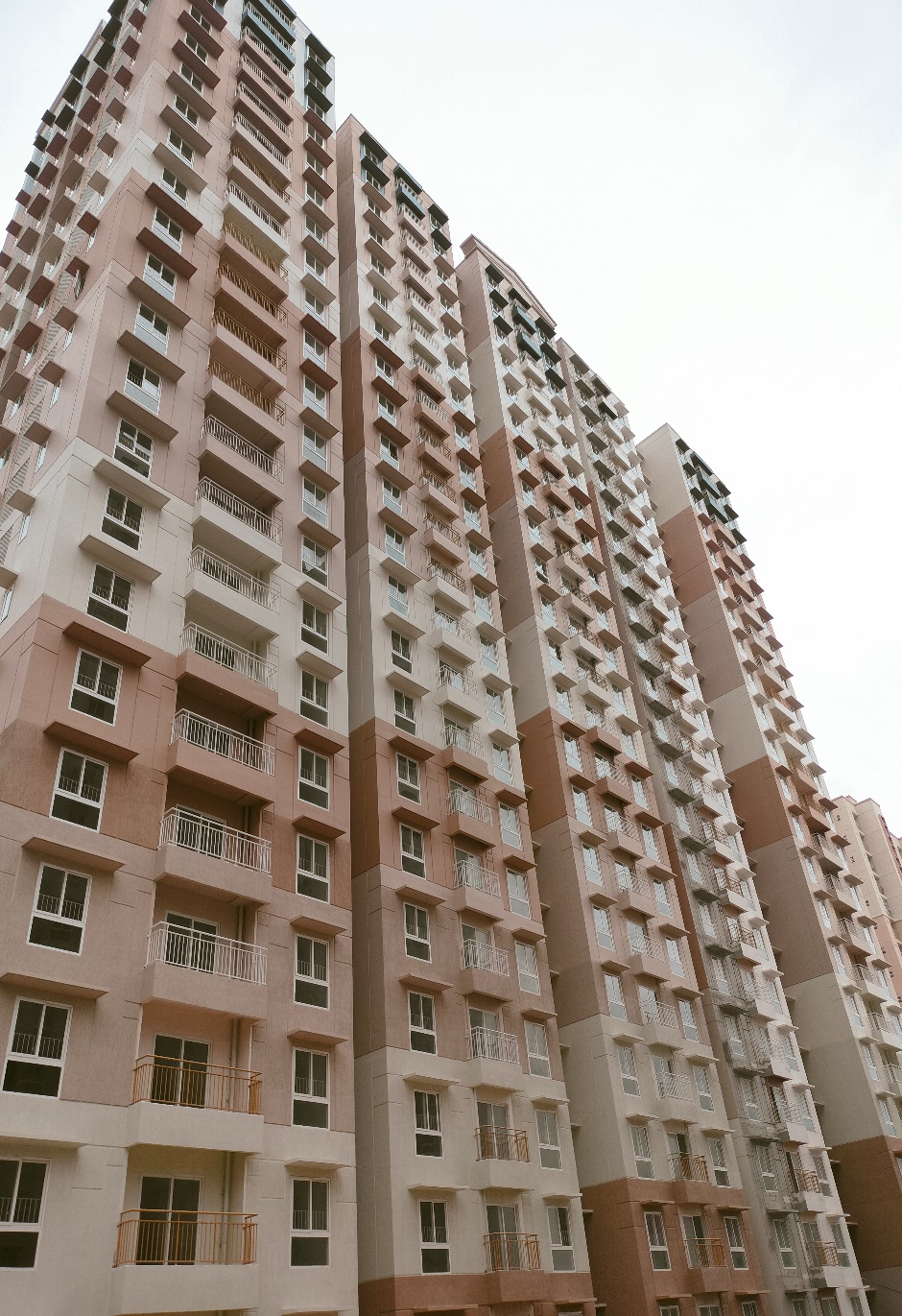

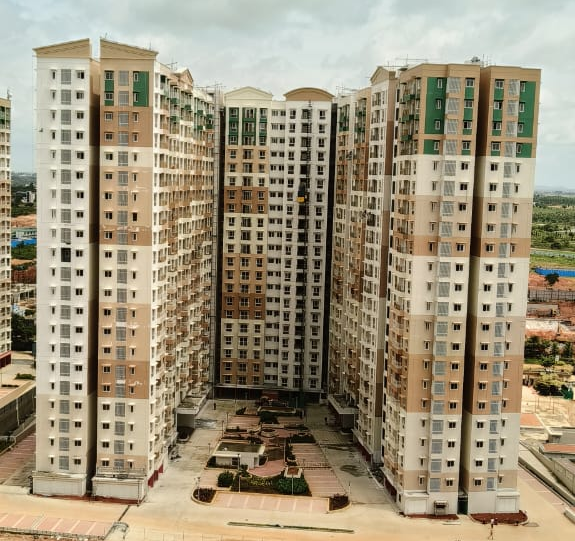

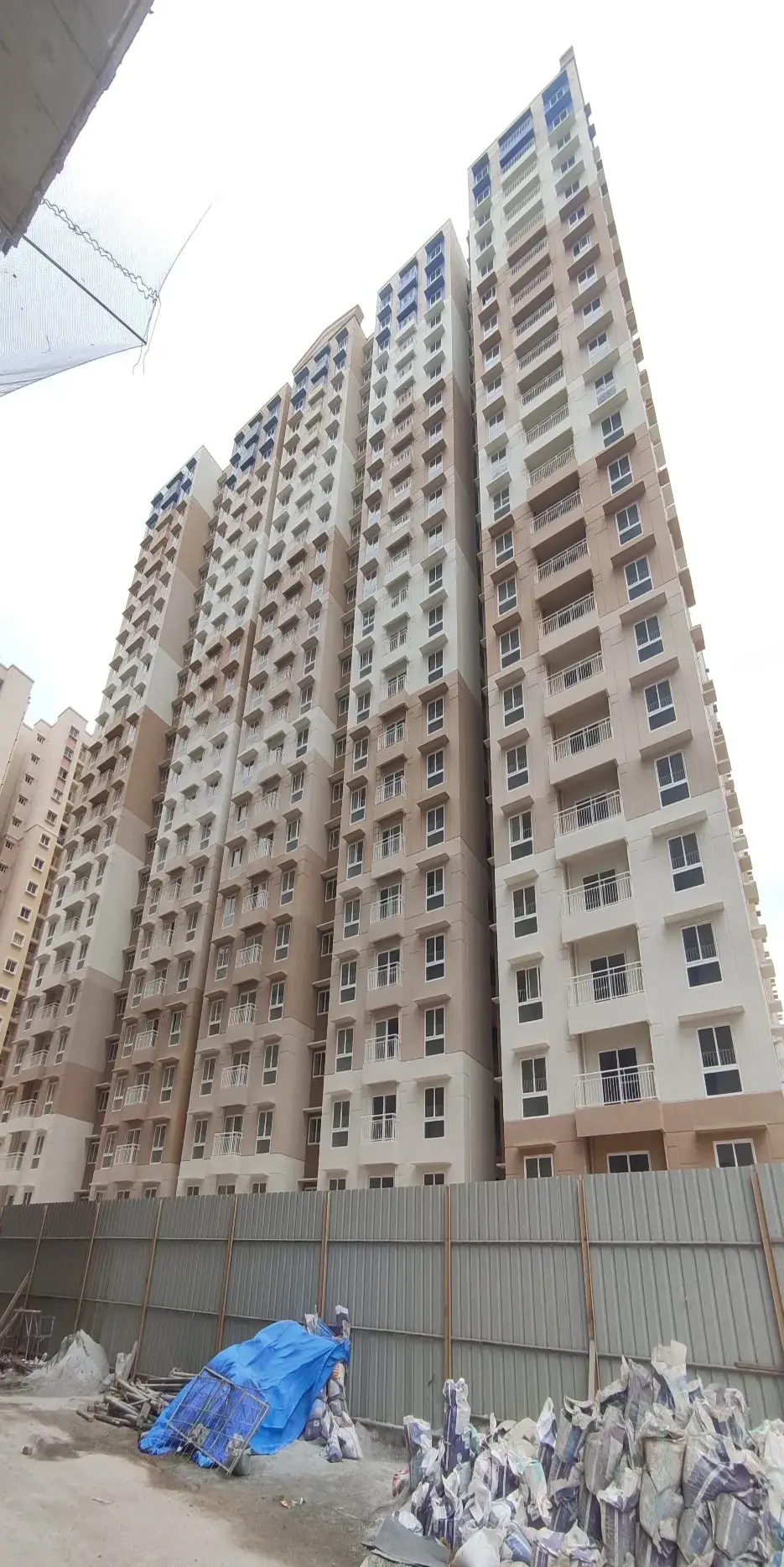

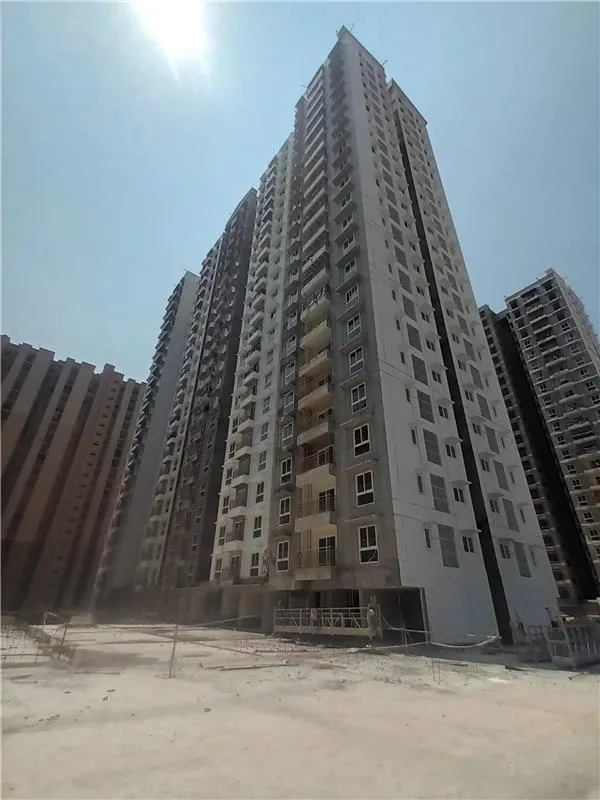

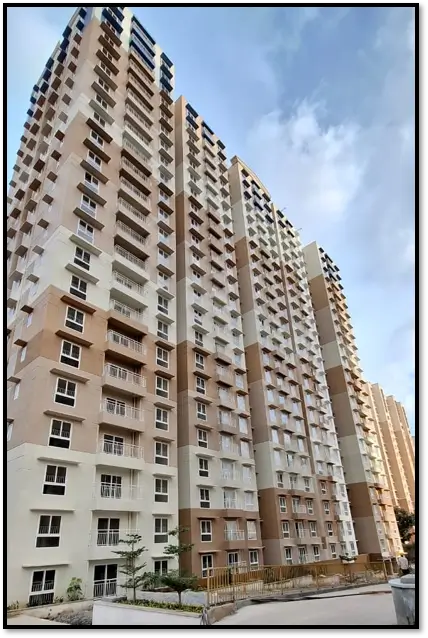

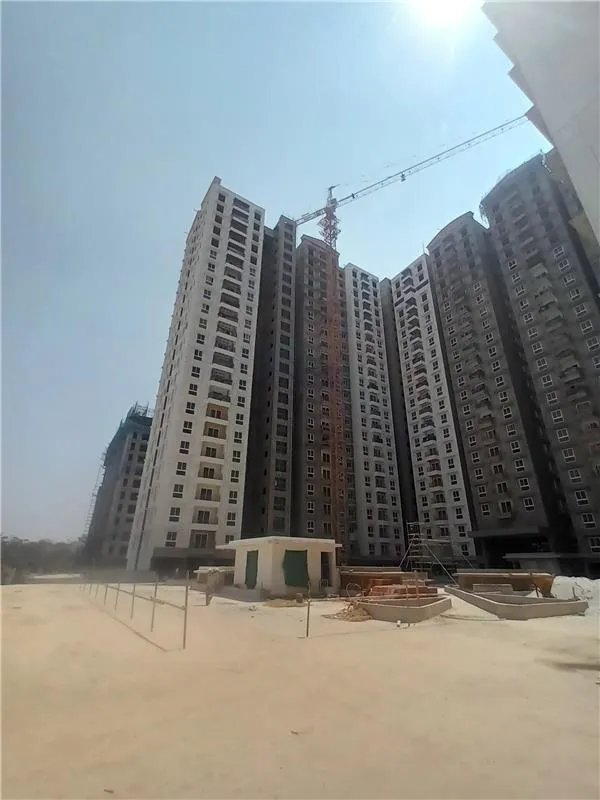

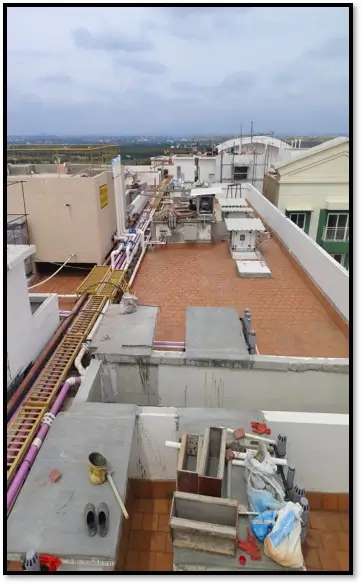

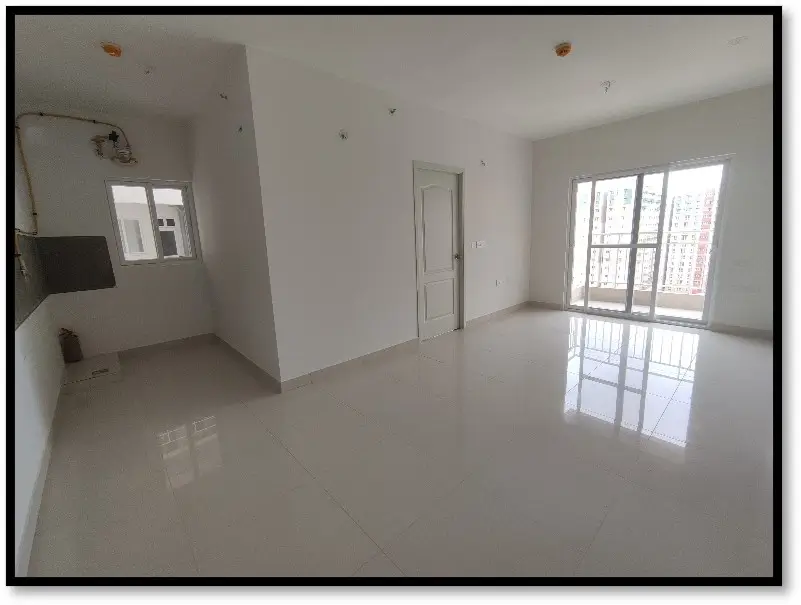

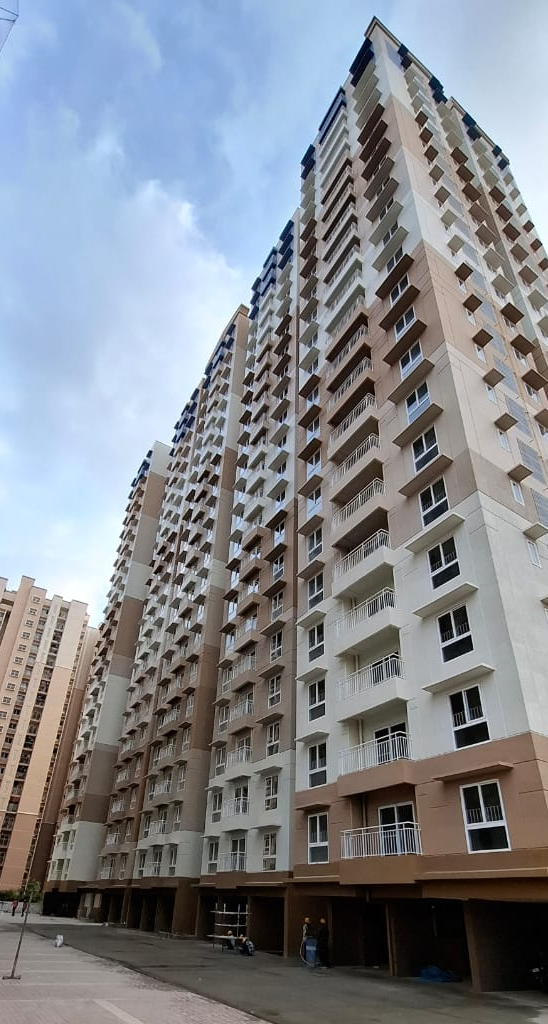

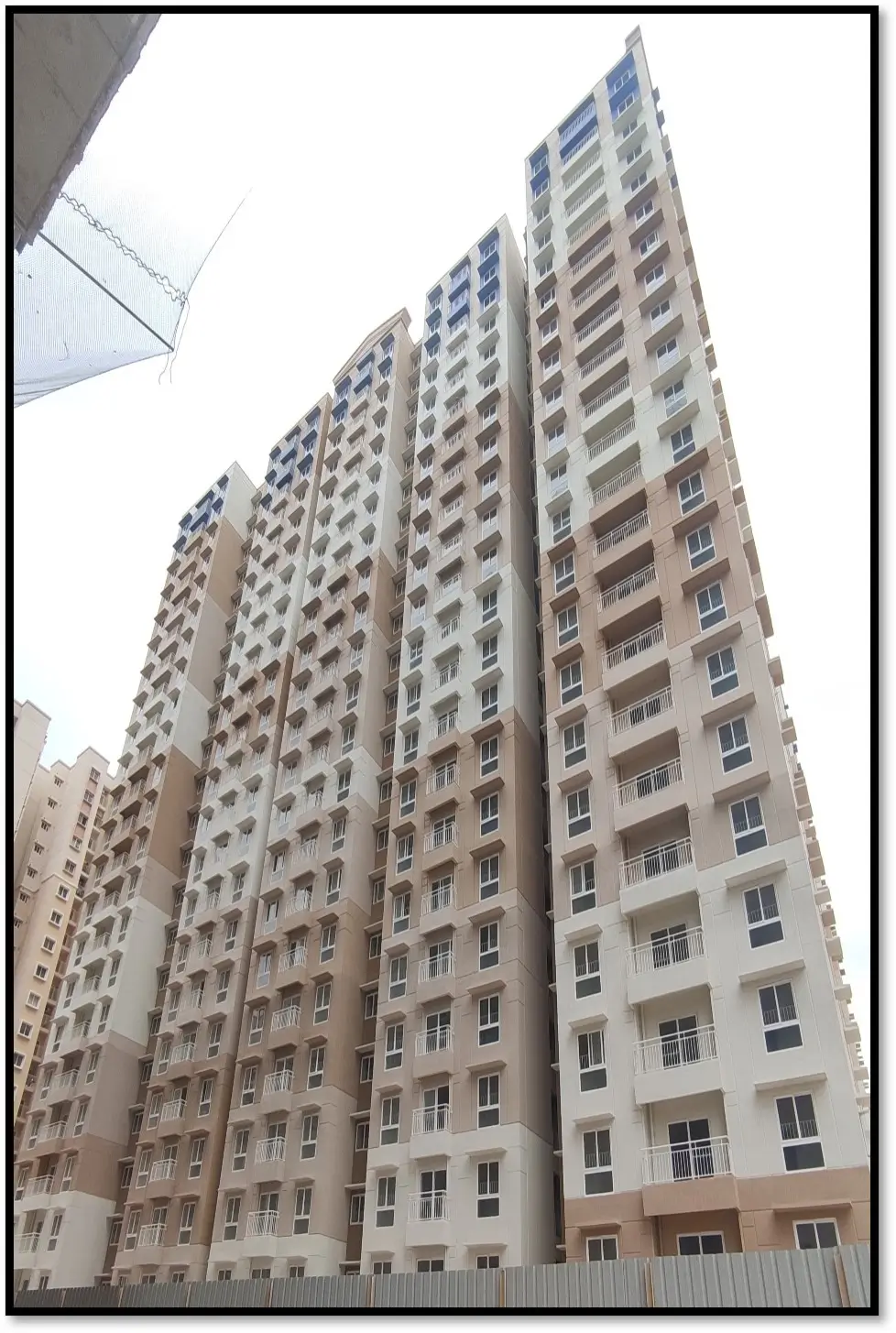

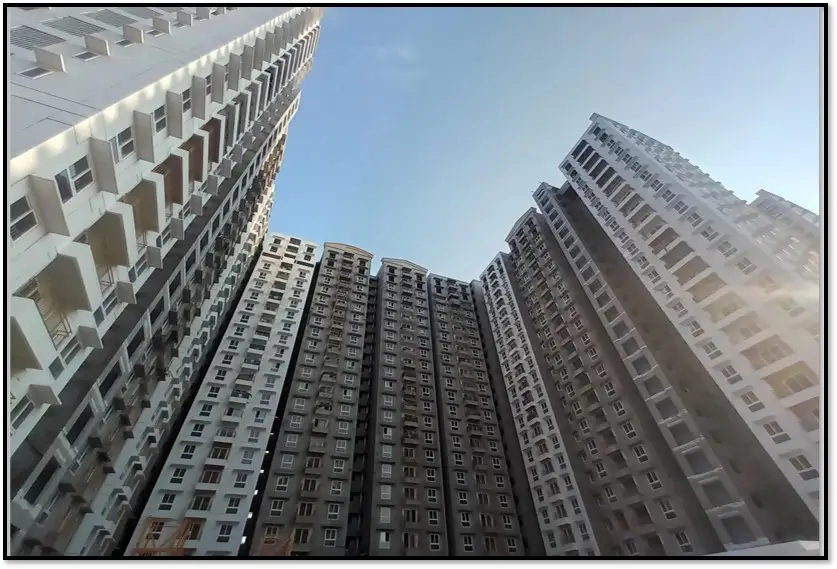

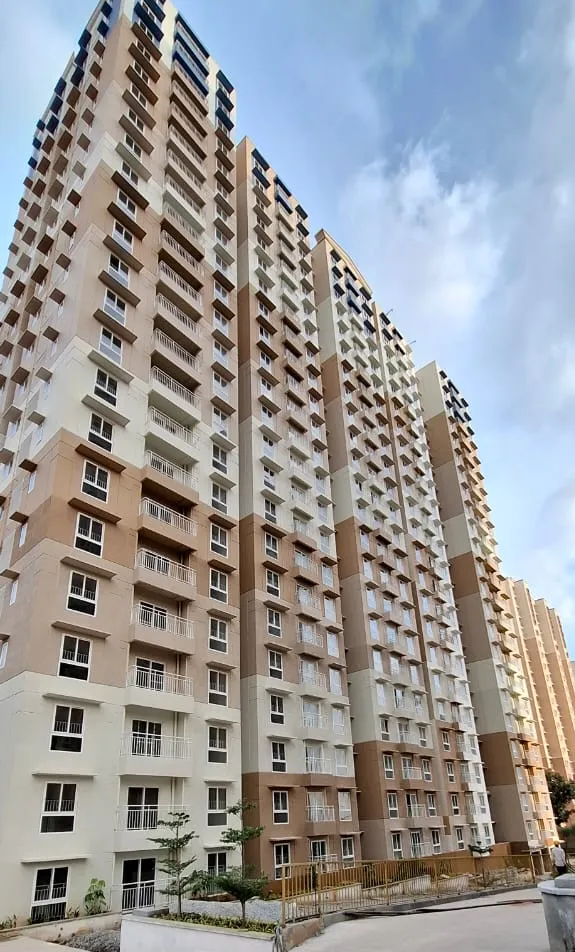

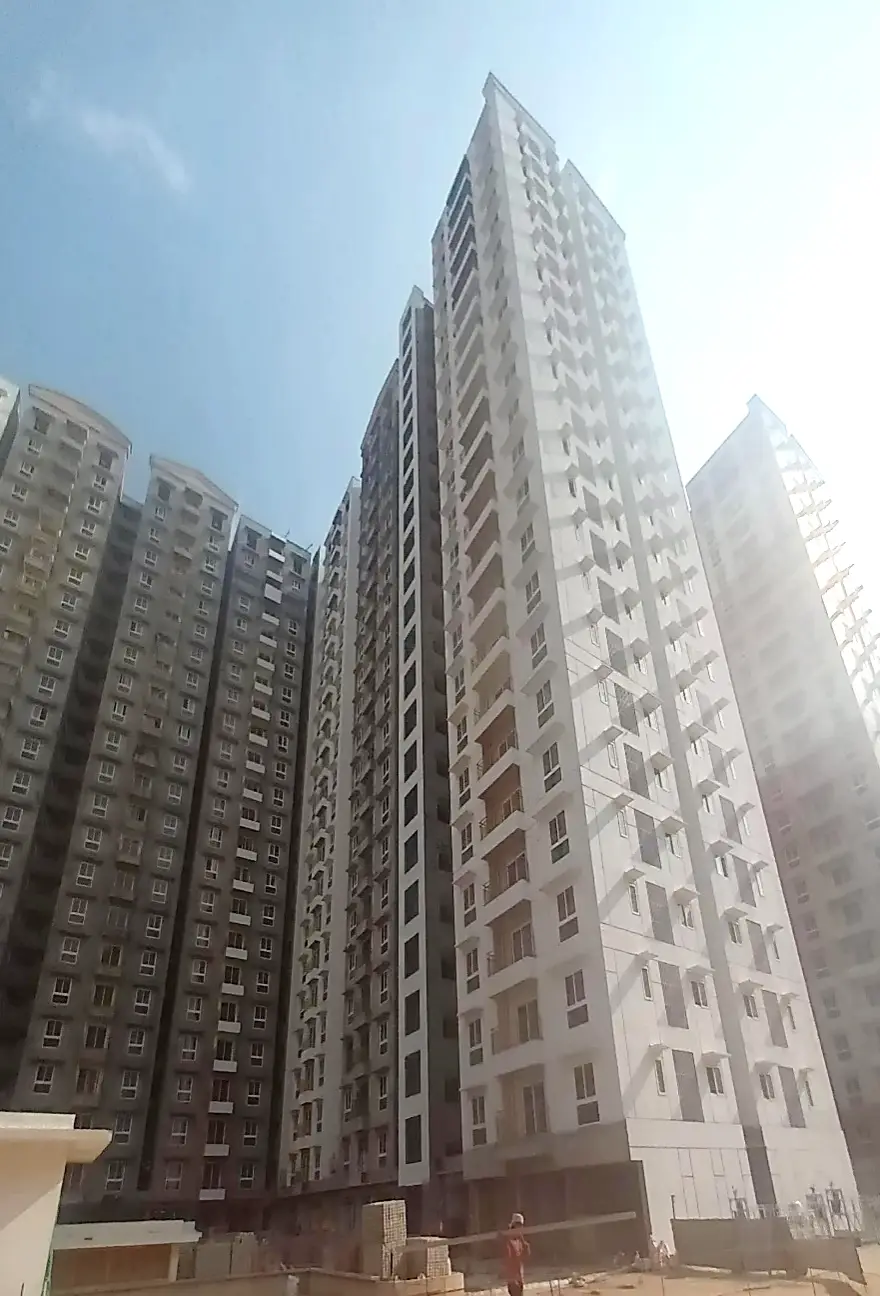

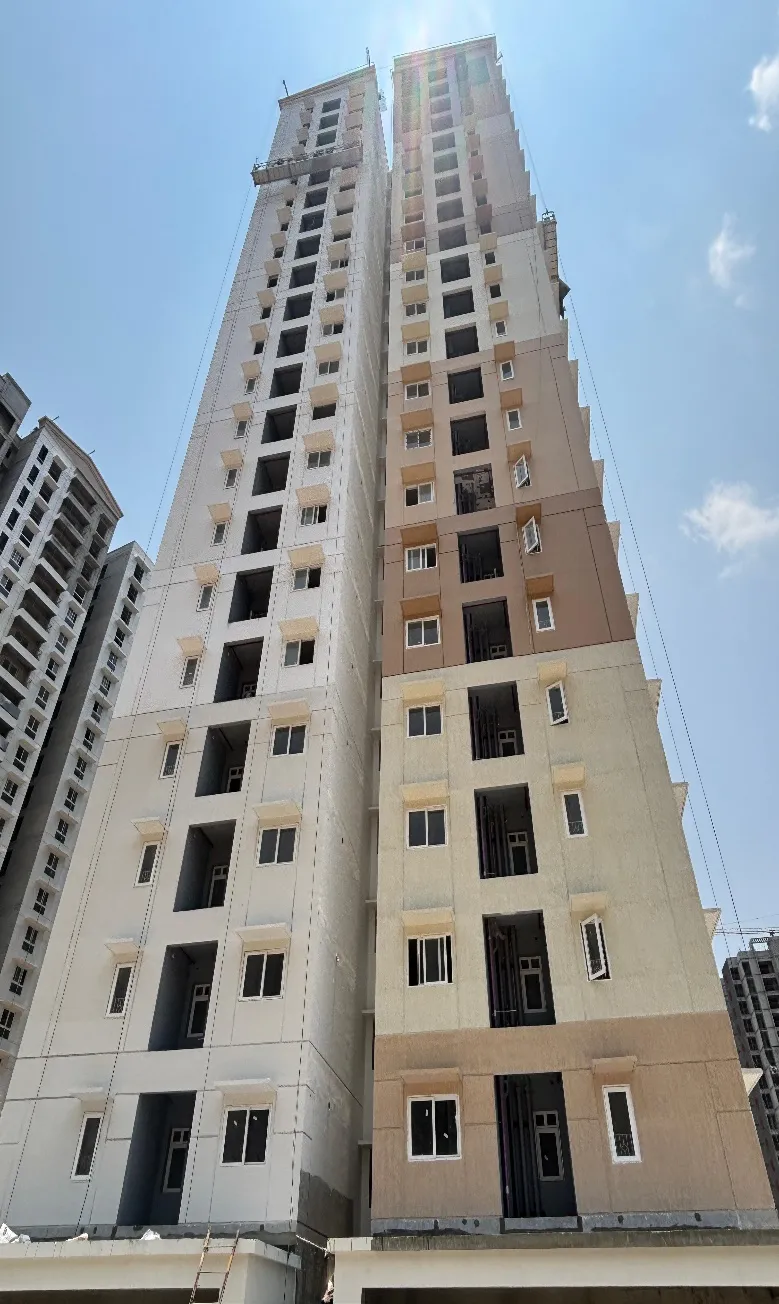

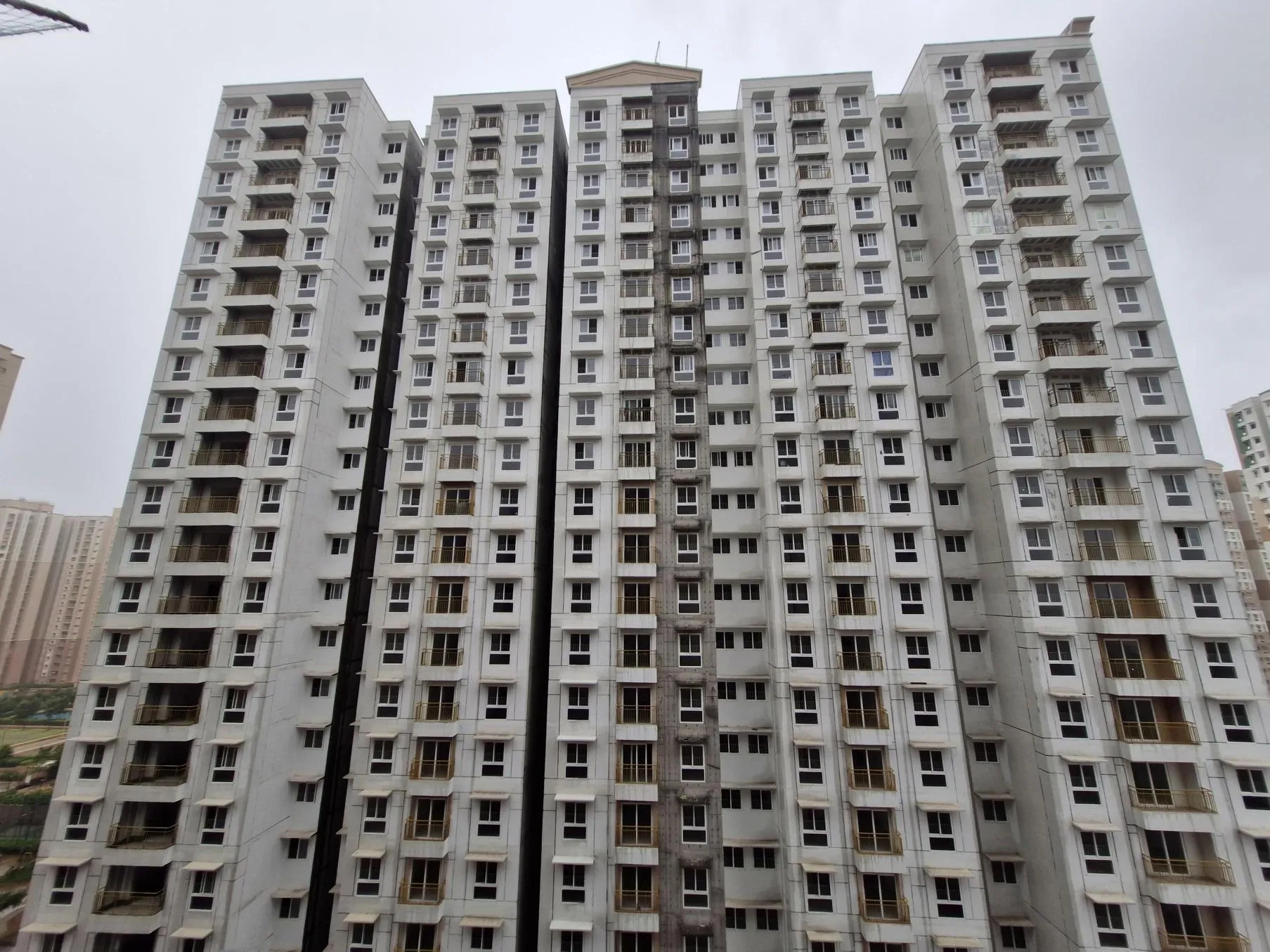

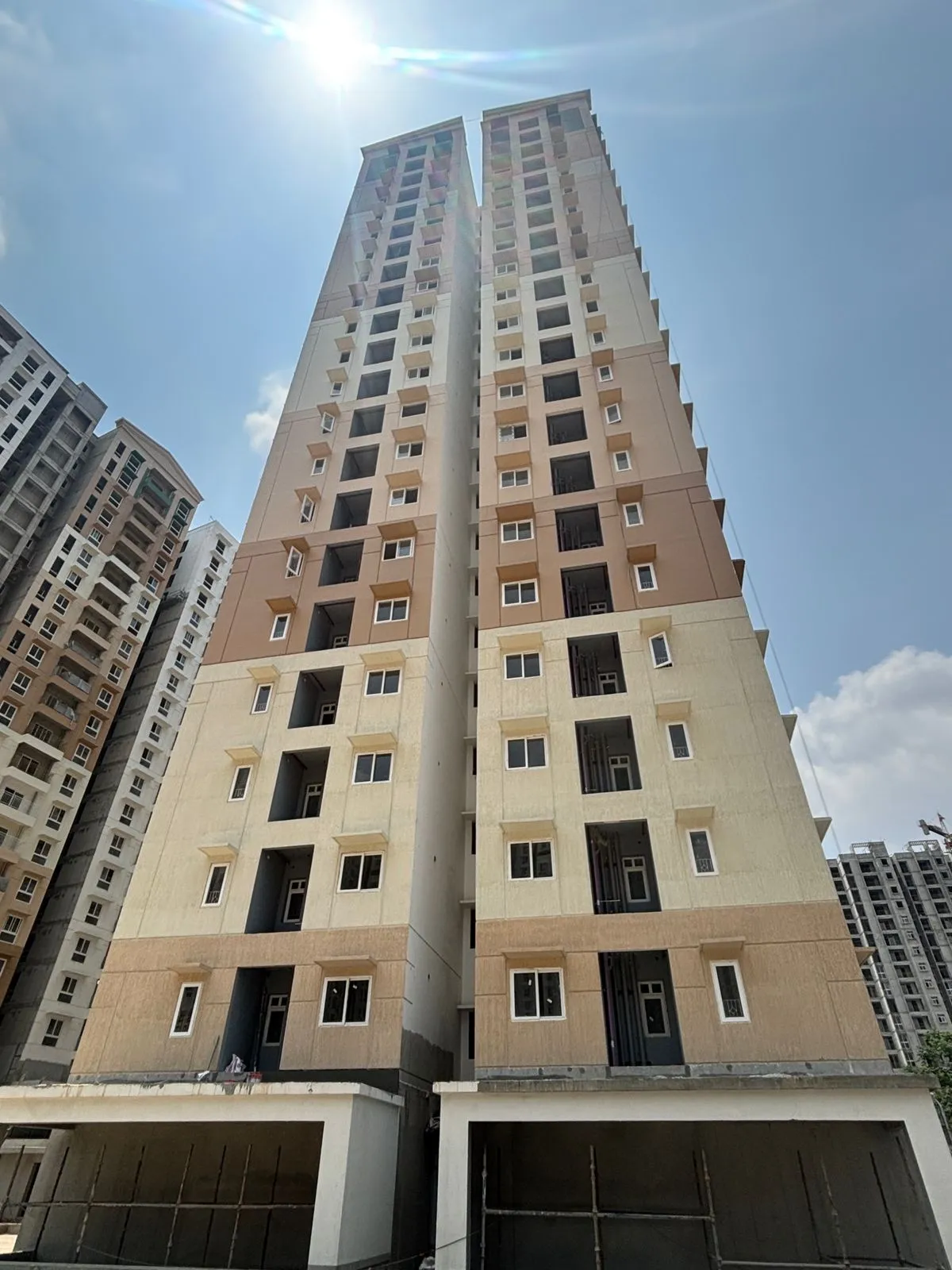

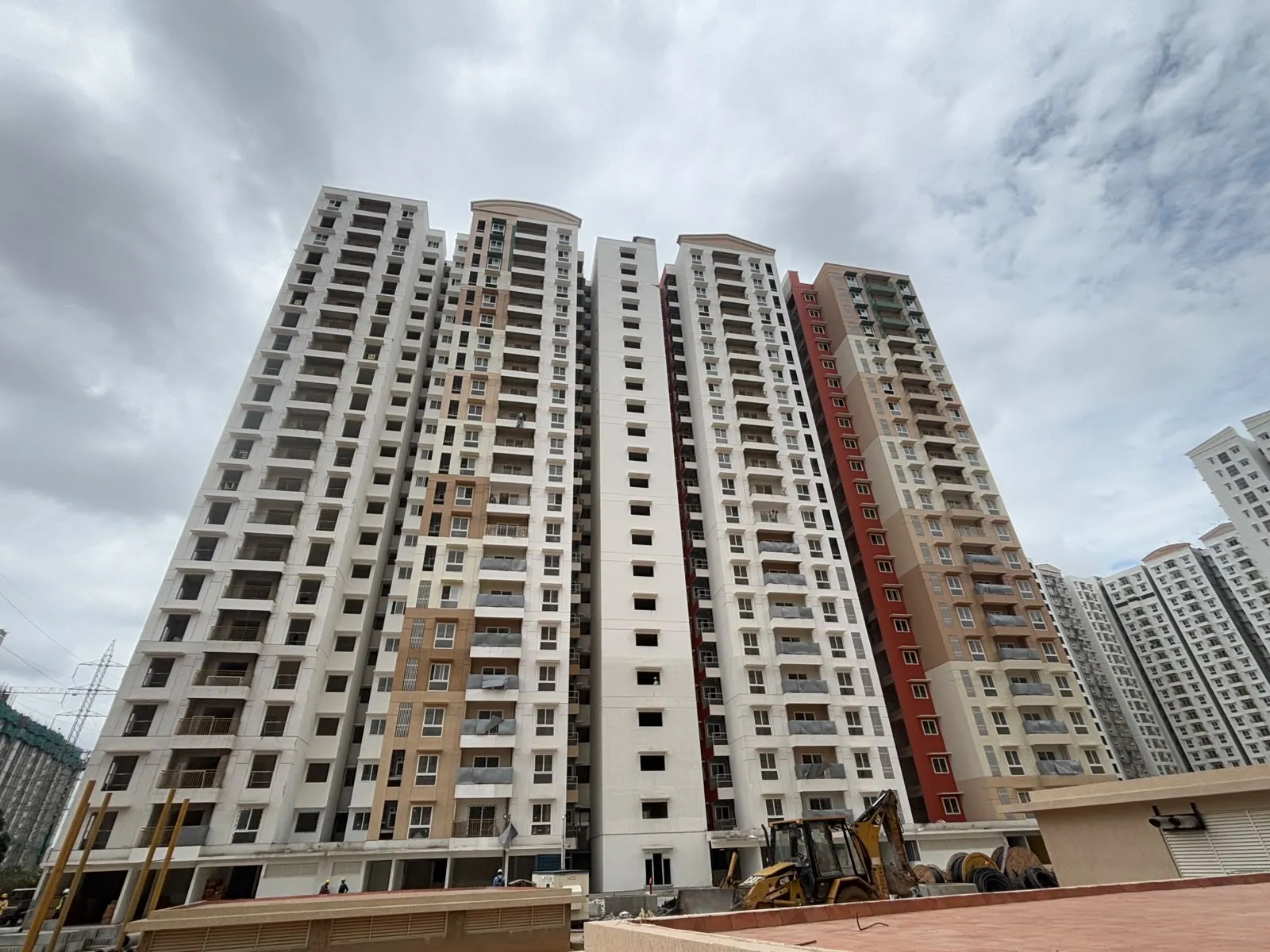

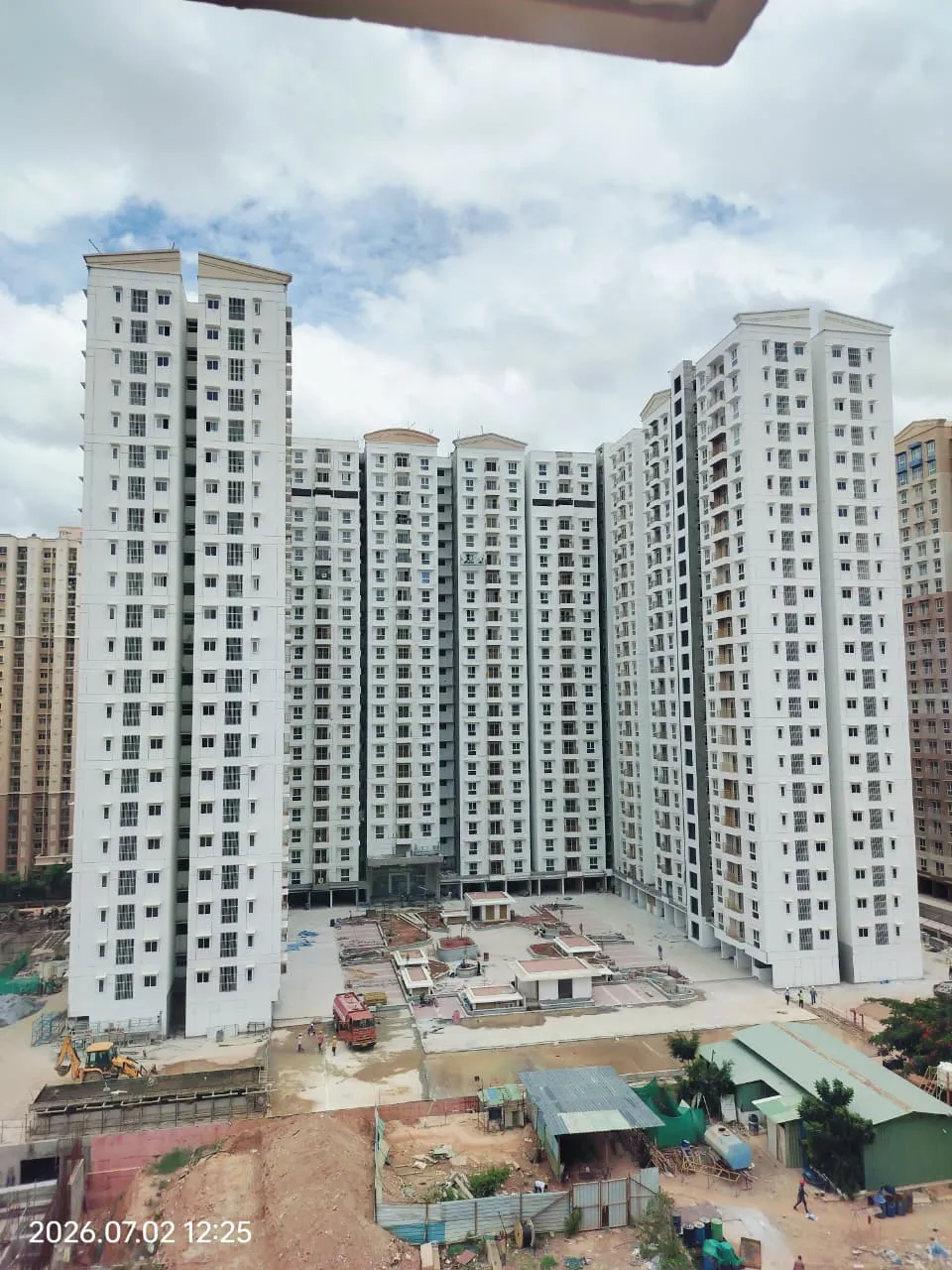

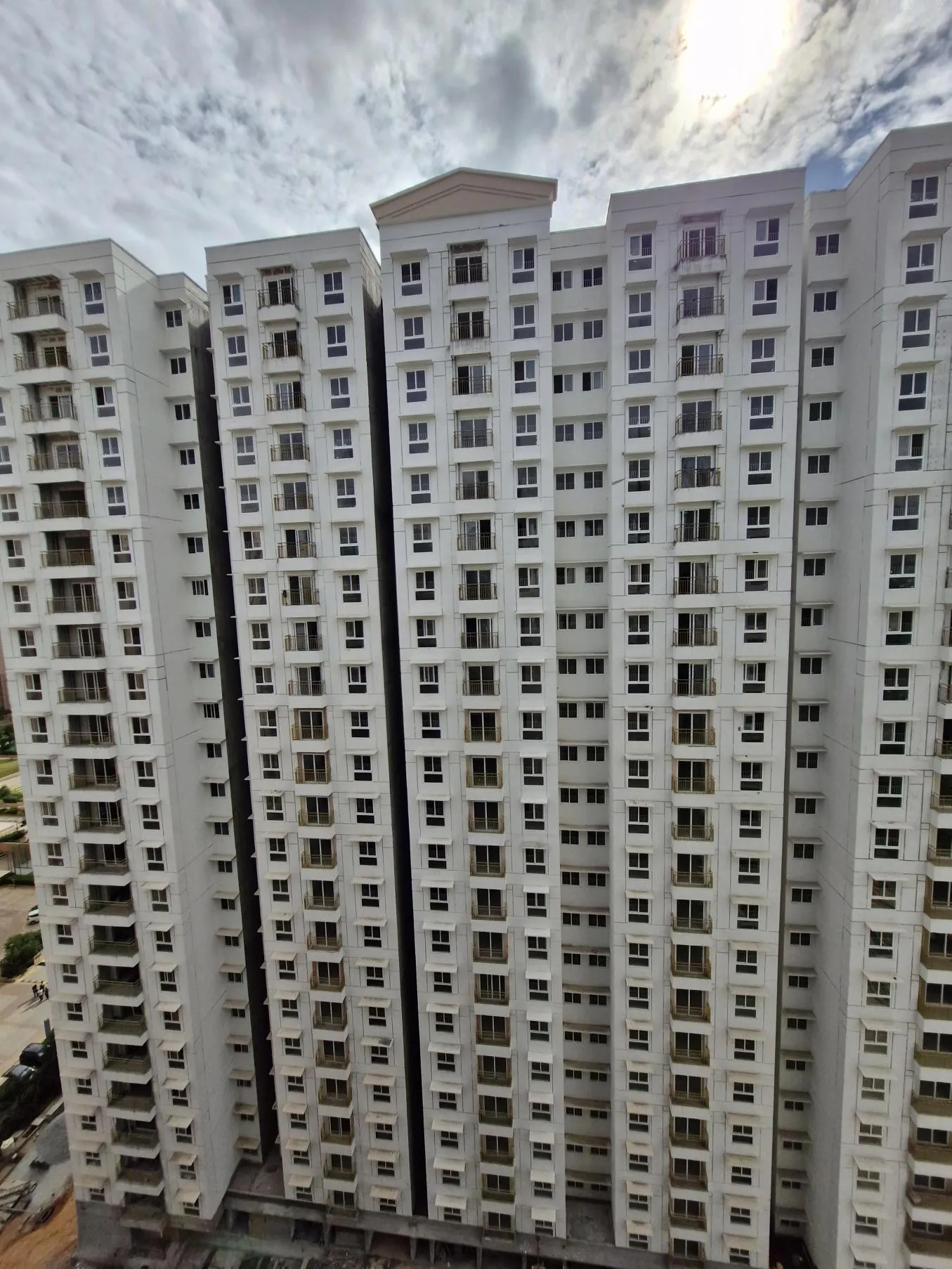

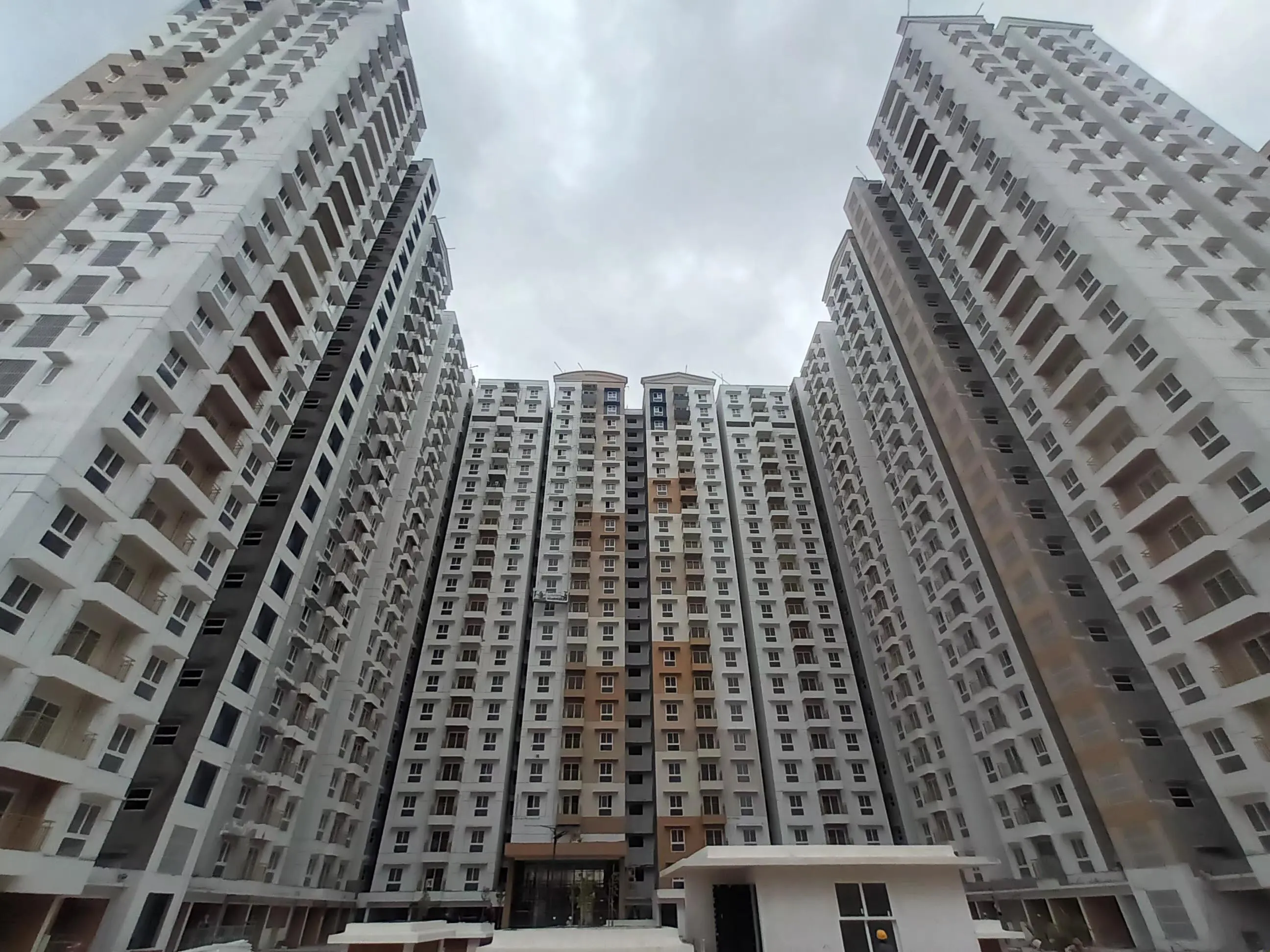

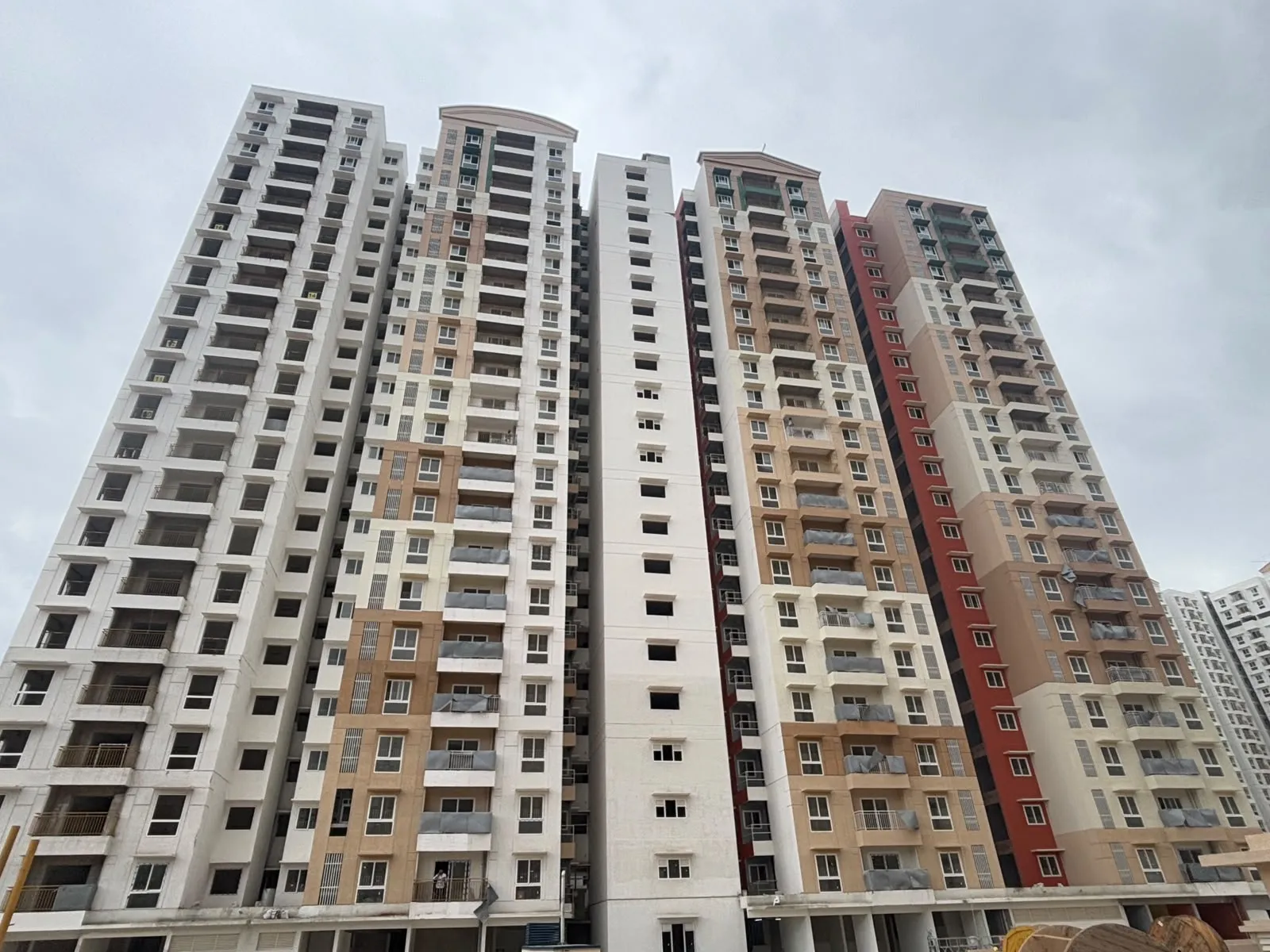

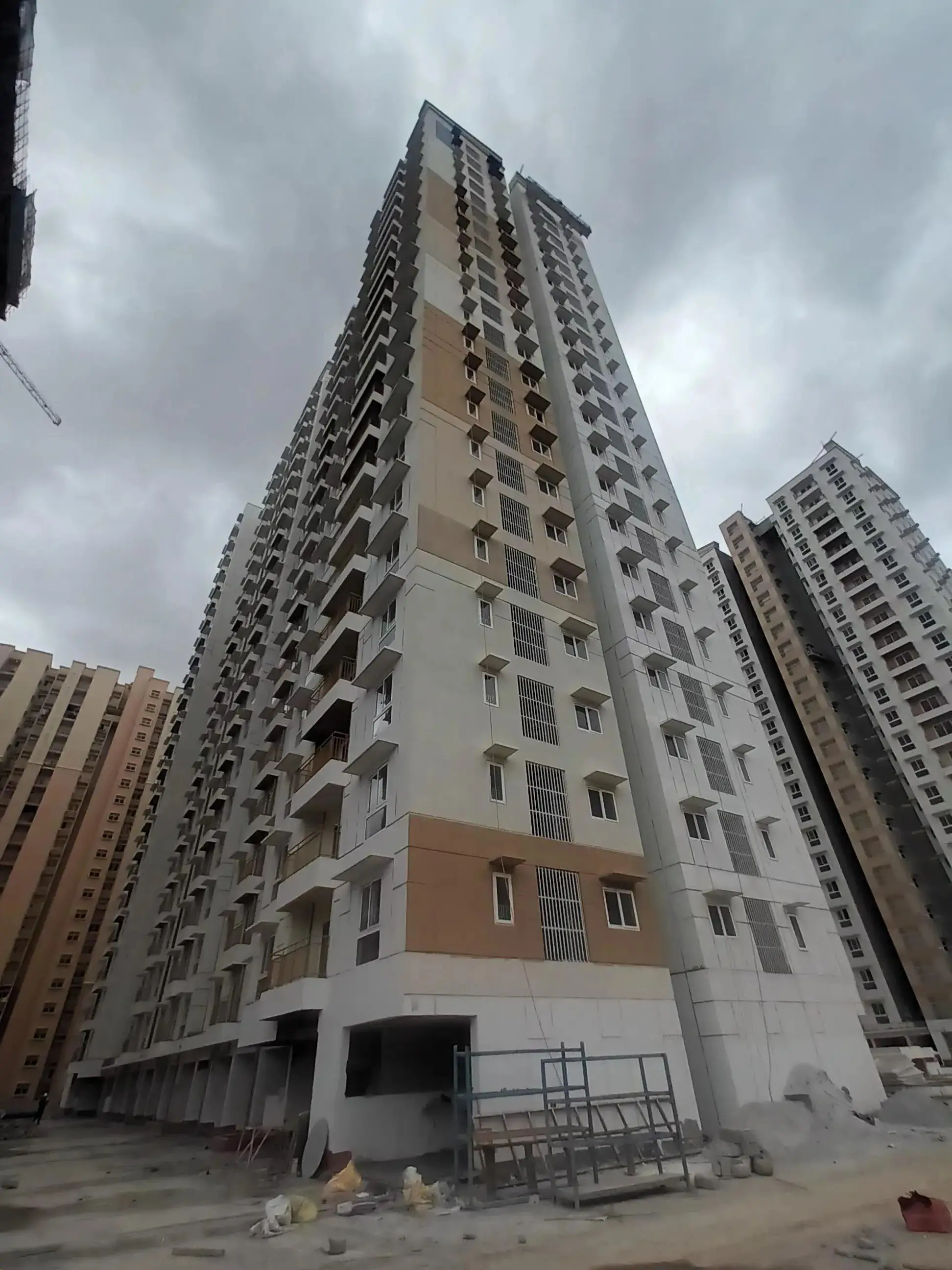

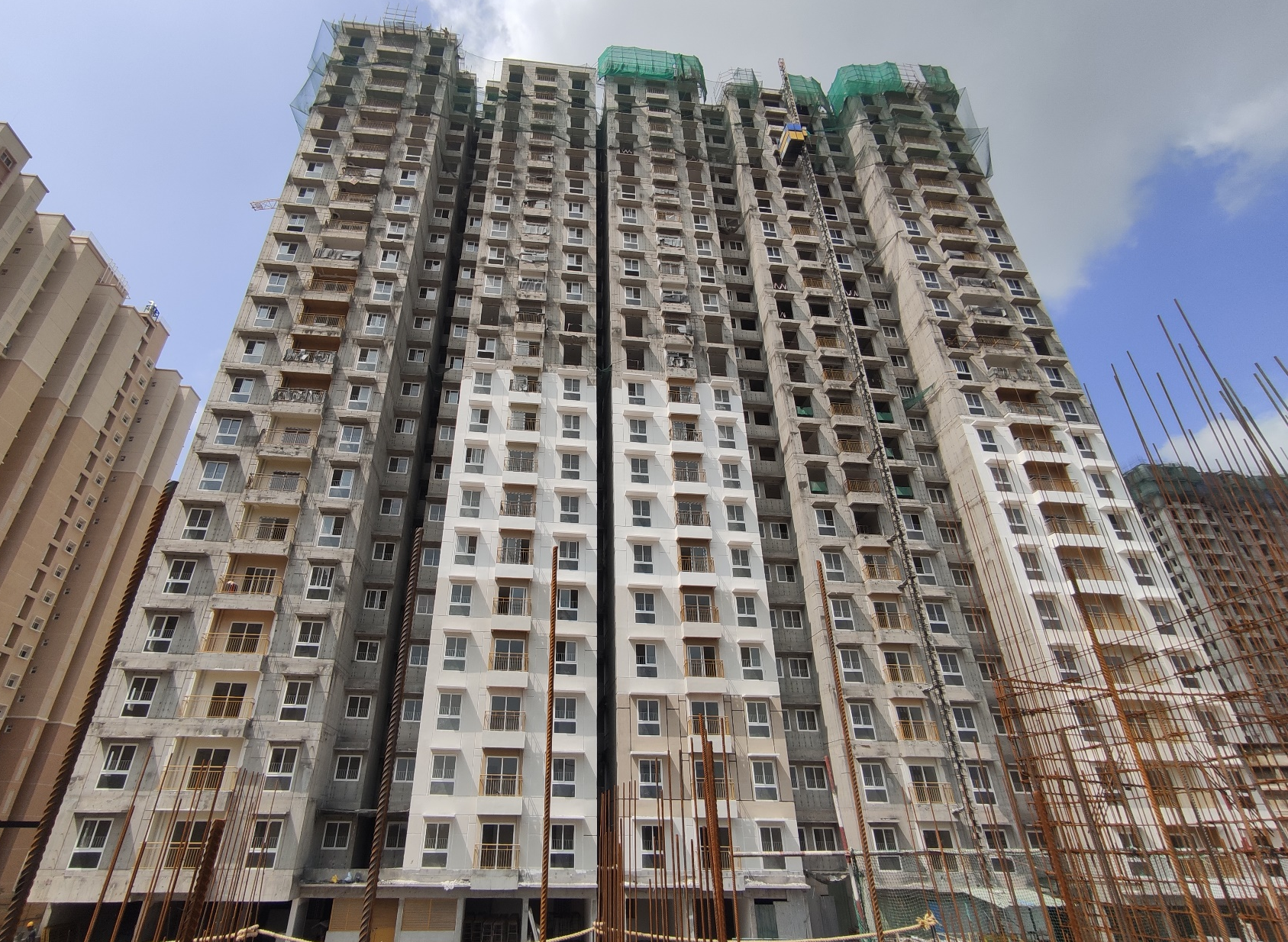

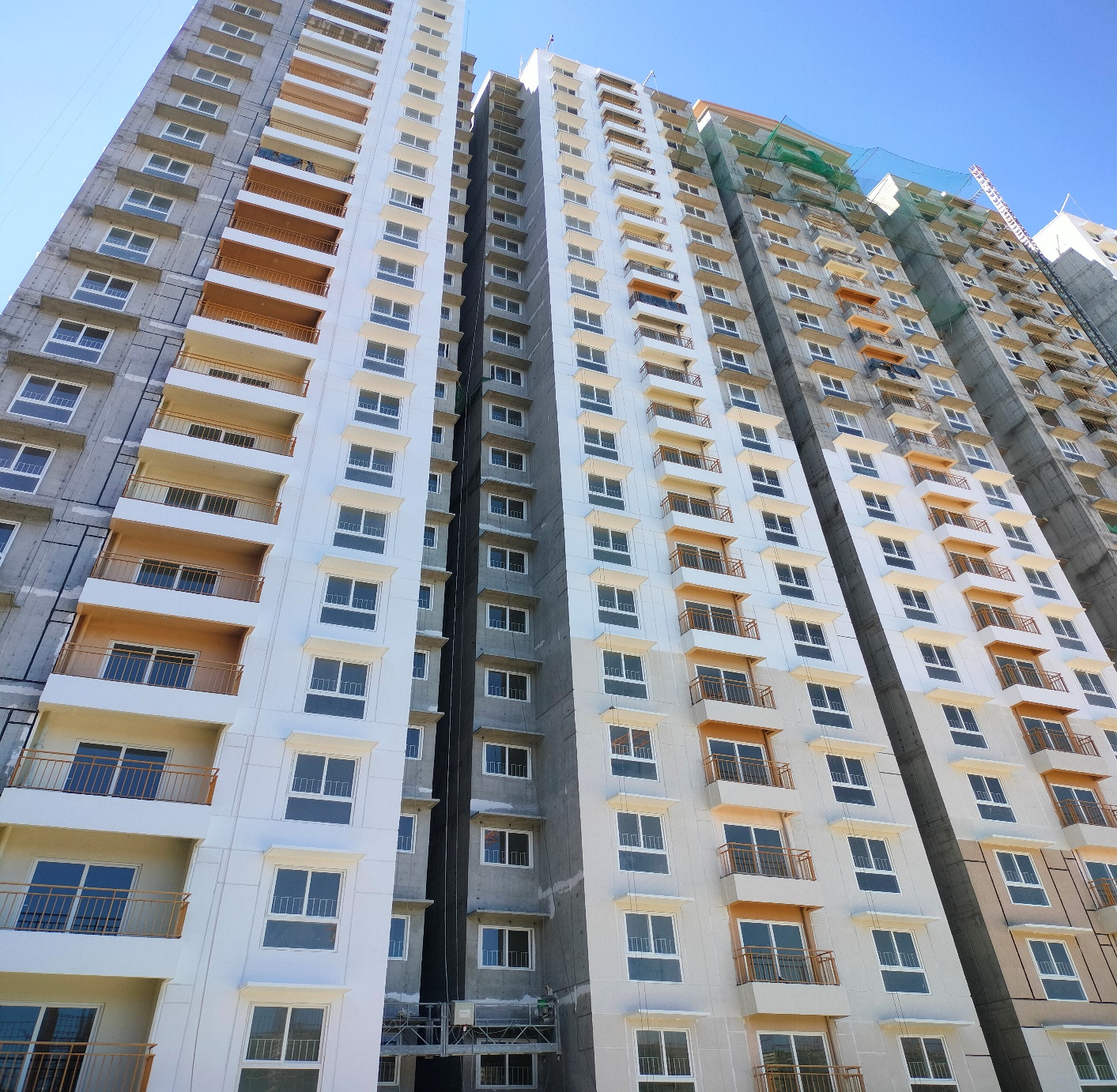

East ,South and West wing External Painting works Started - Jun 2025

East ,South and West wing External Painting works Started - Jun 2025

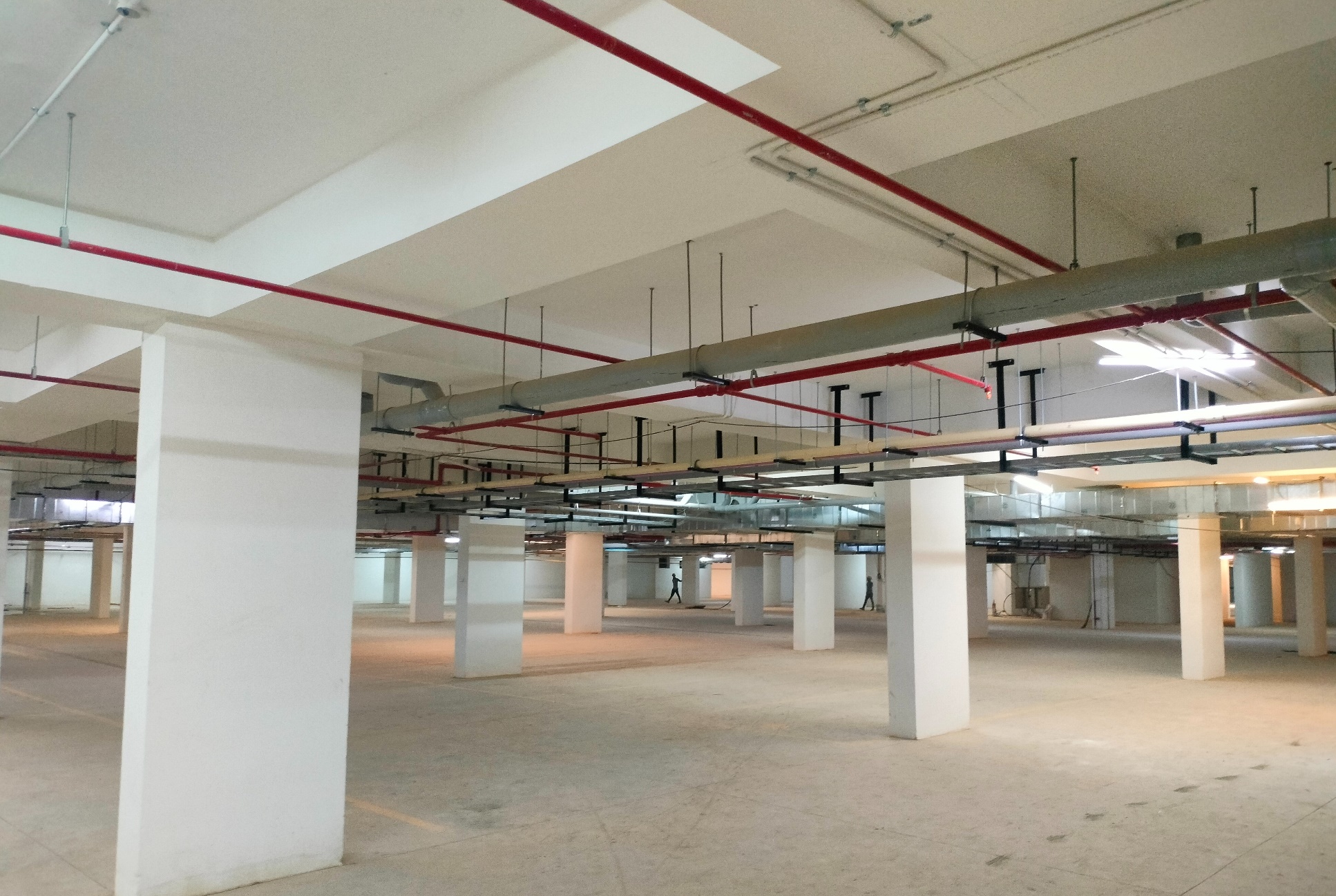

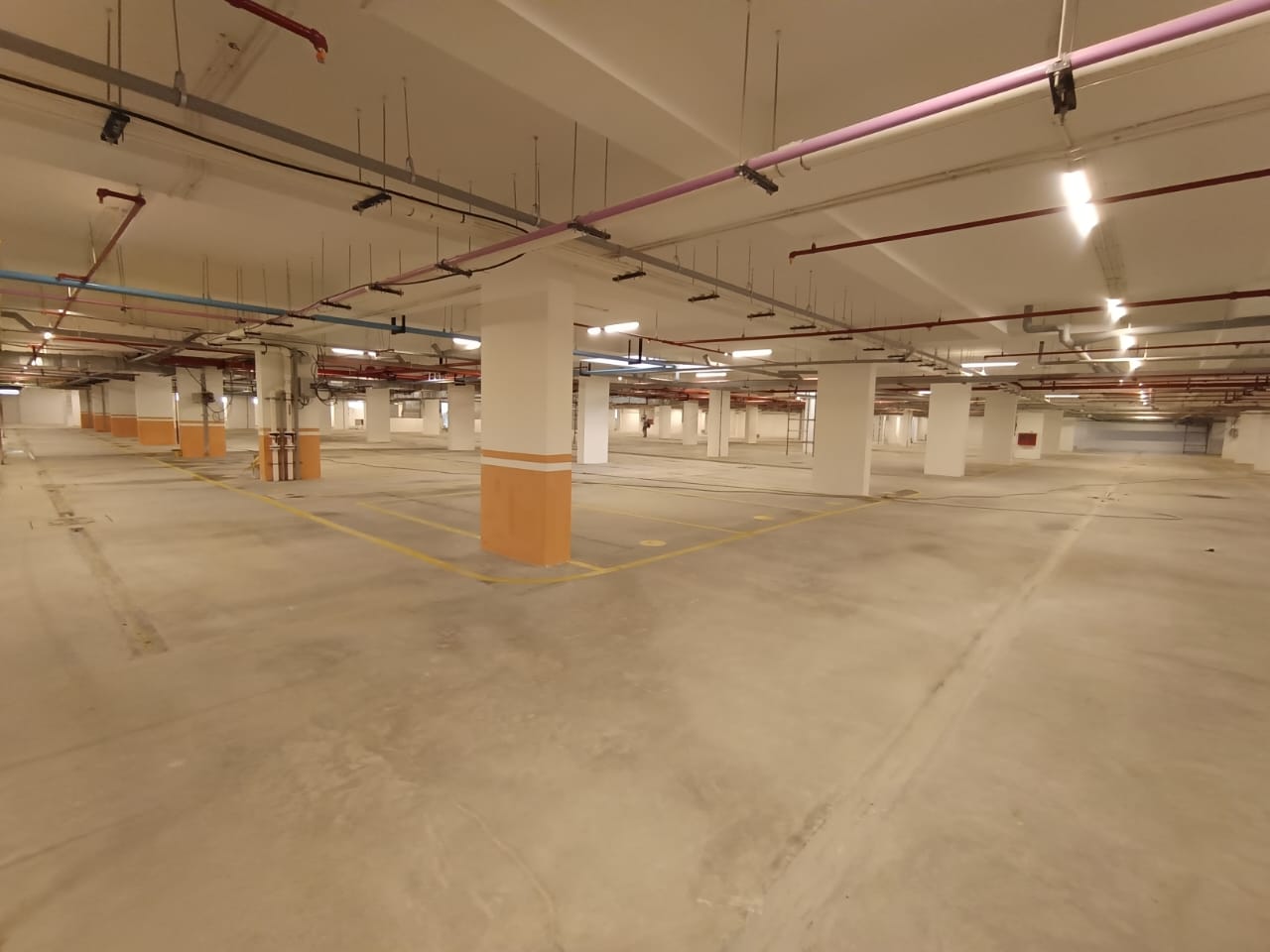

Basement Painting and Services WIP - Jun 2025

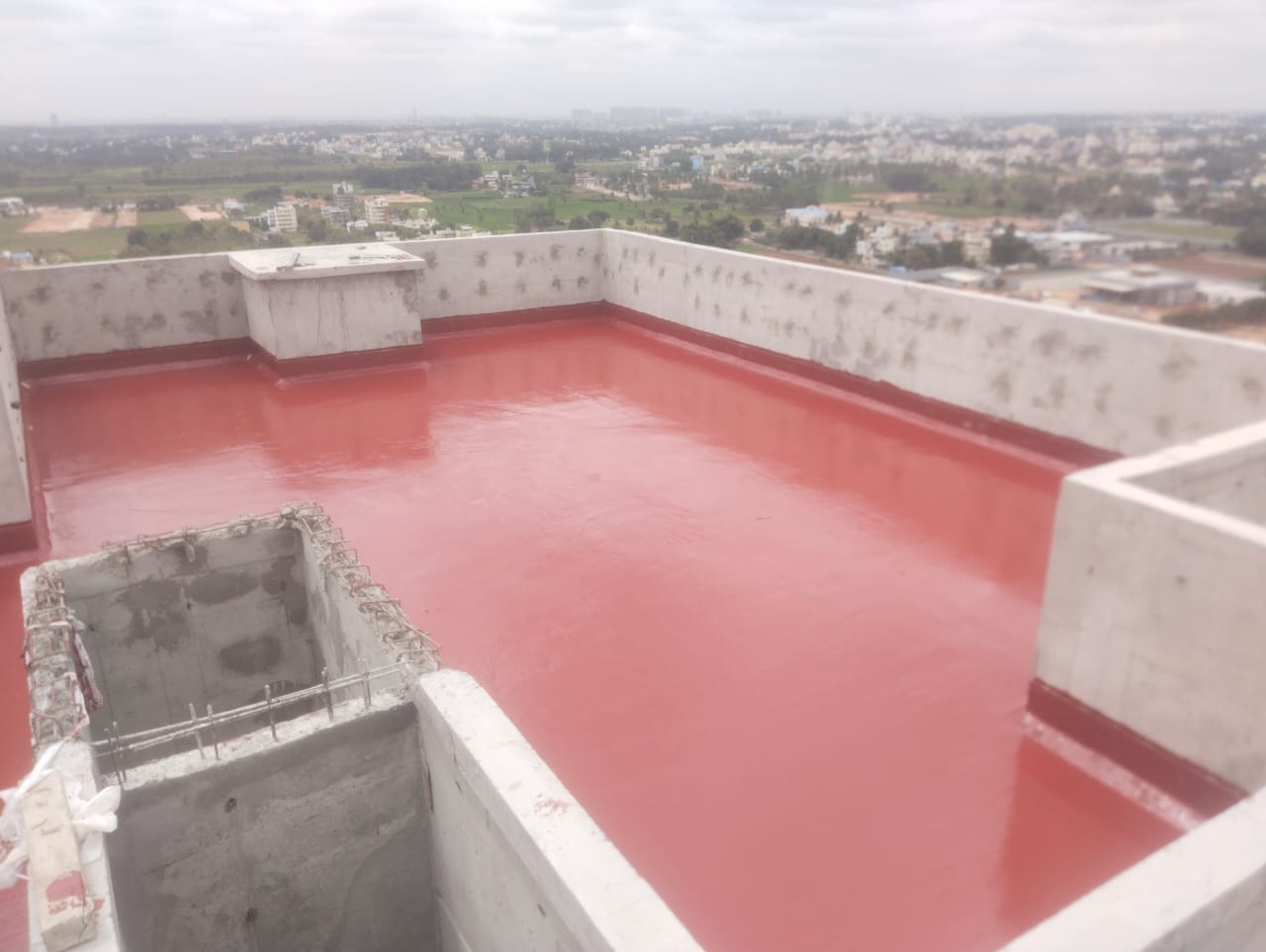

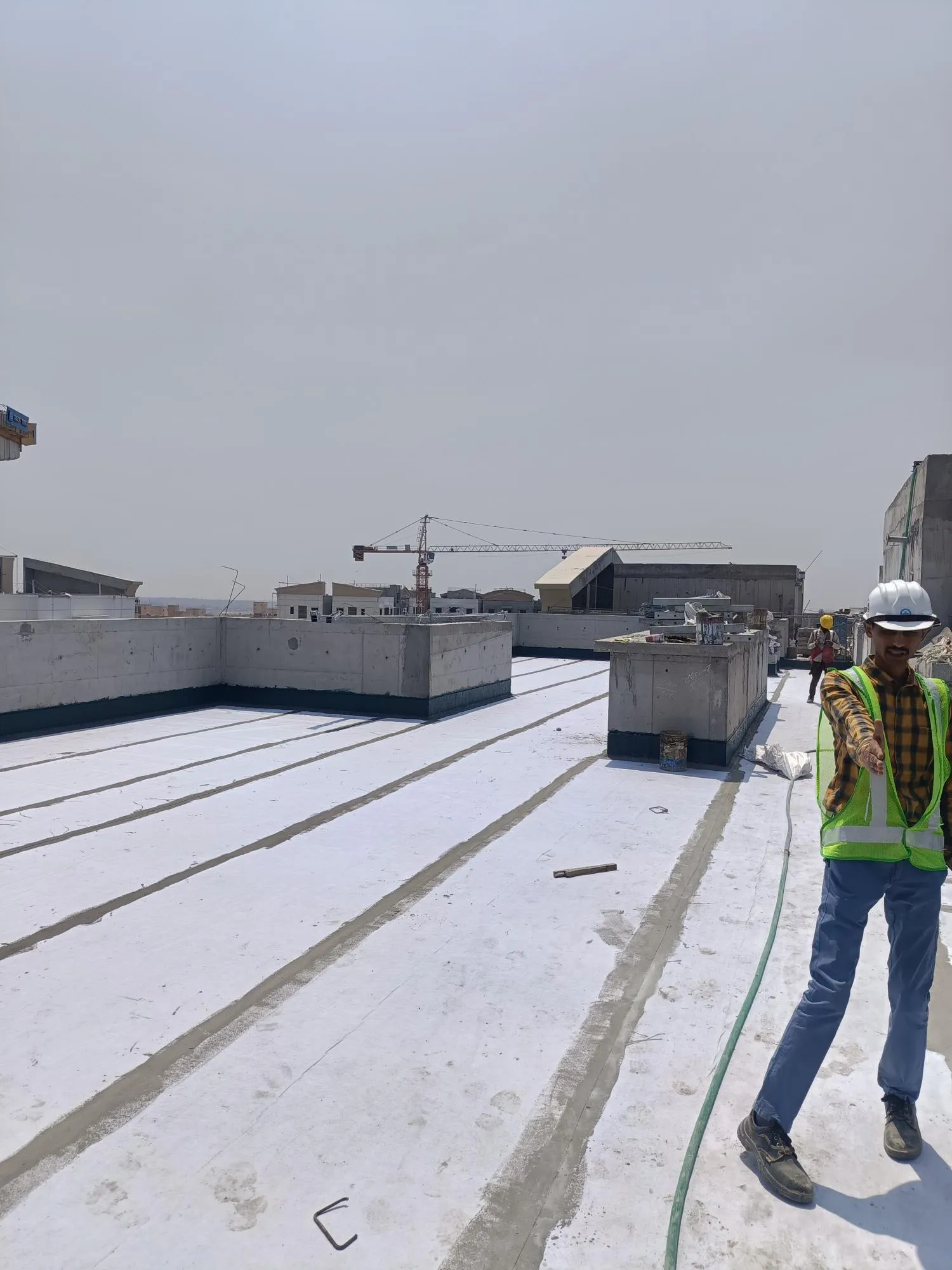

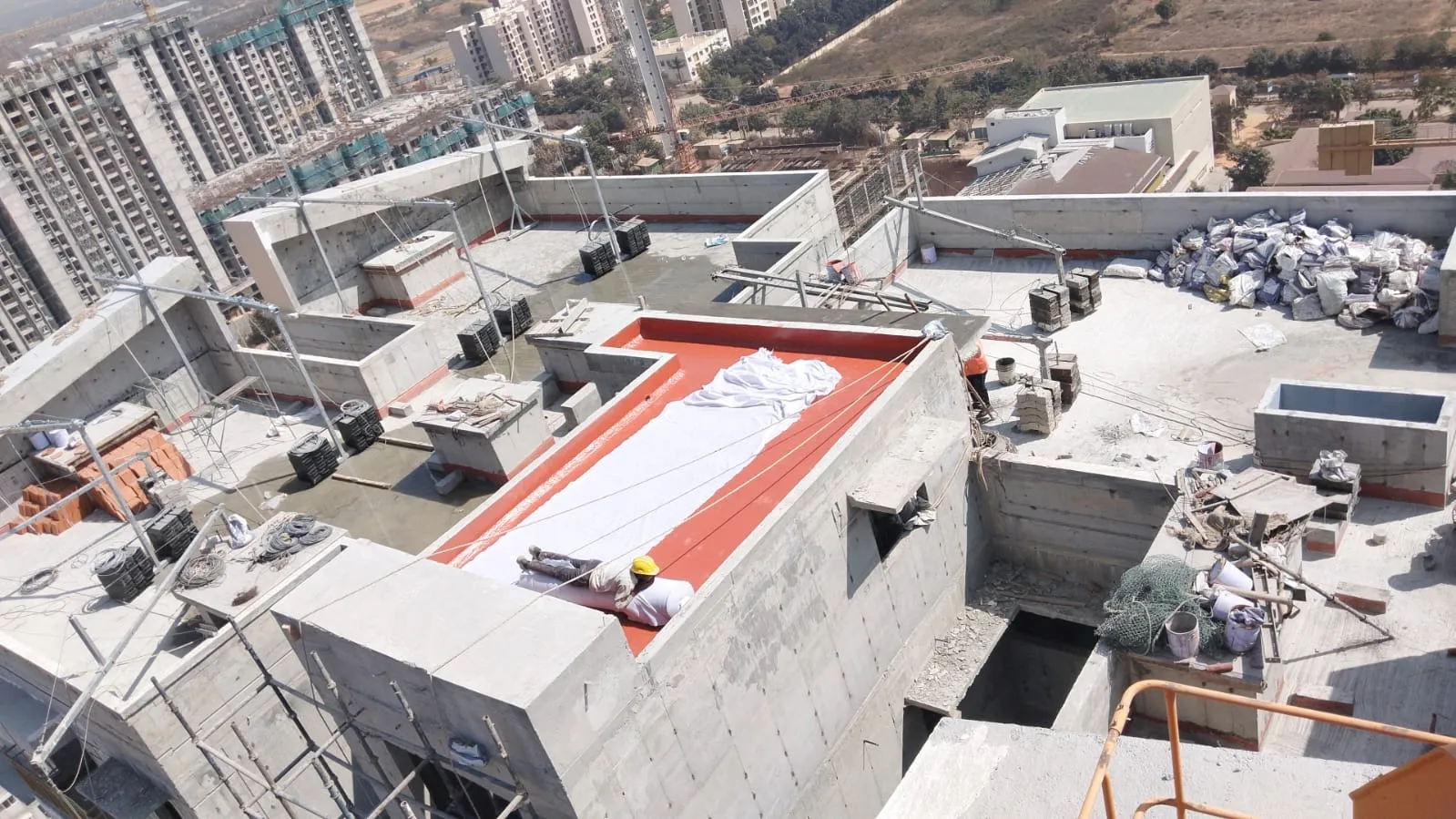

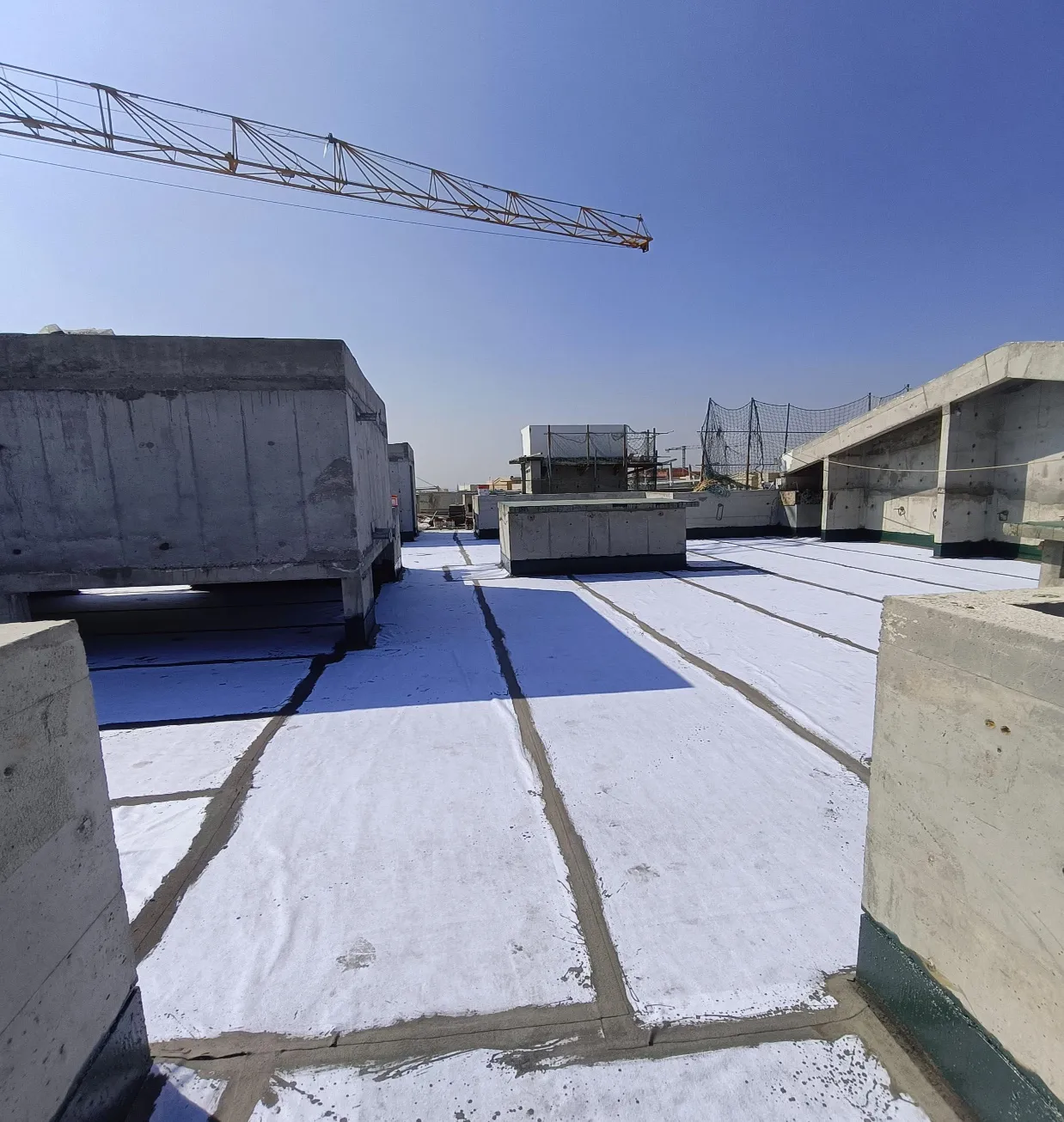

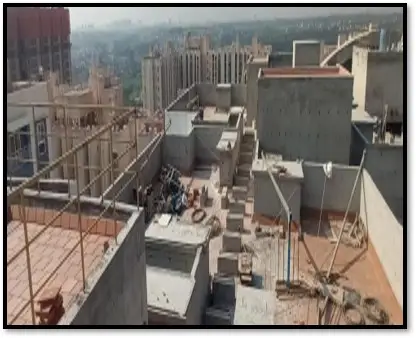

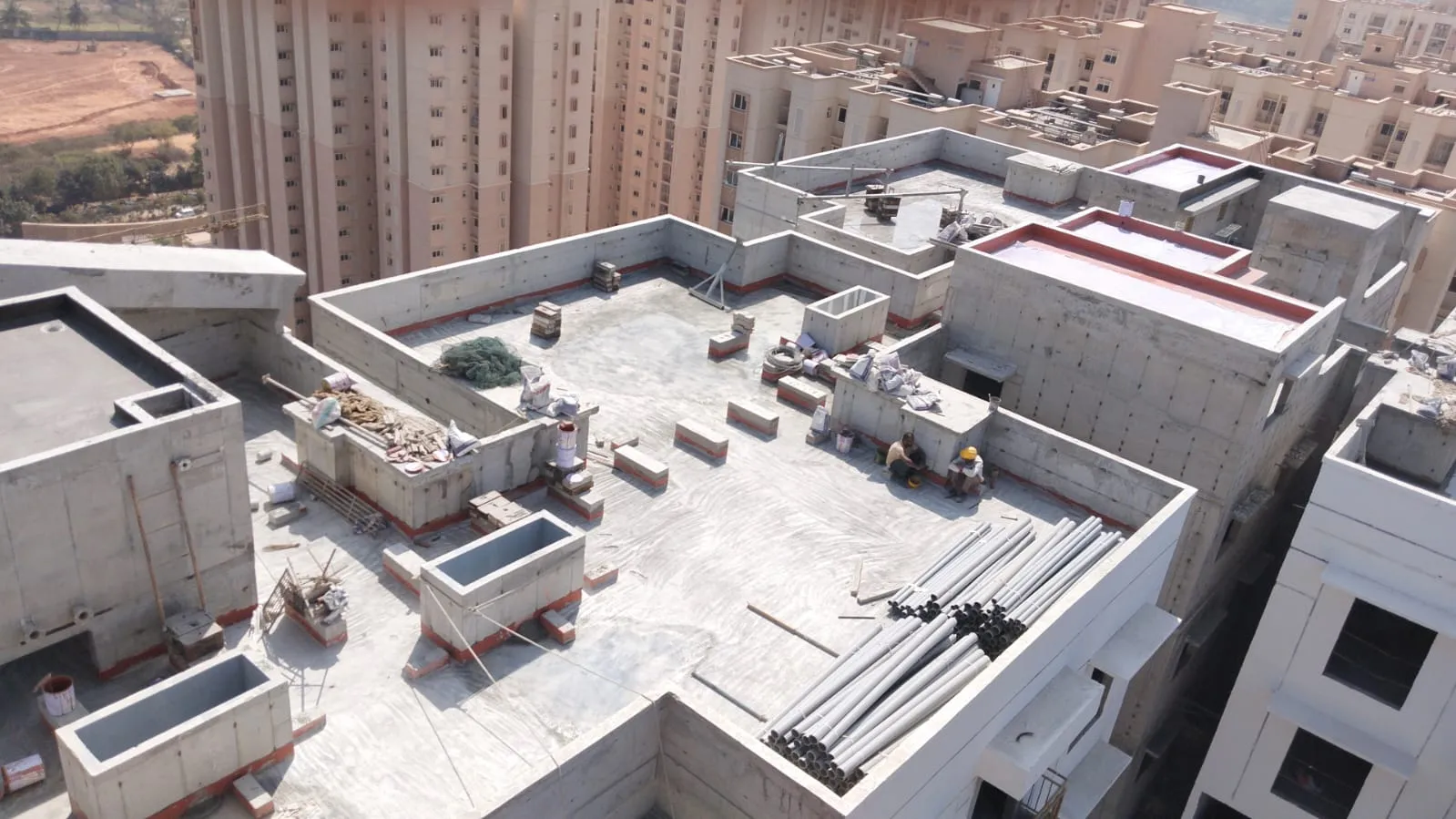

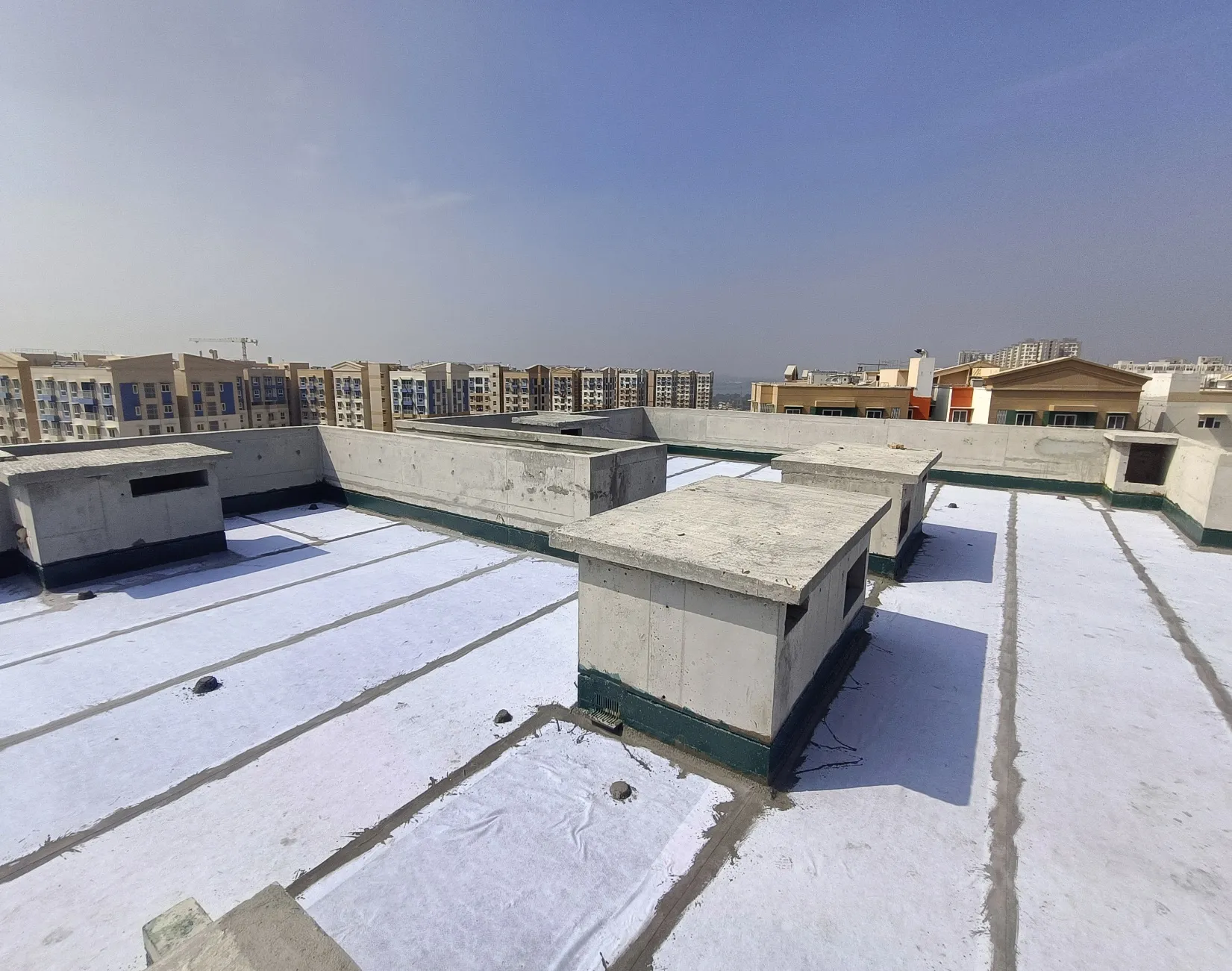

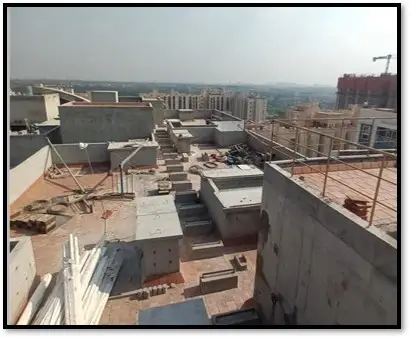

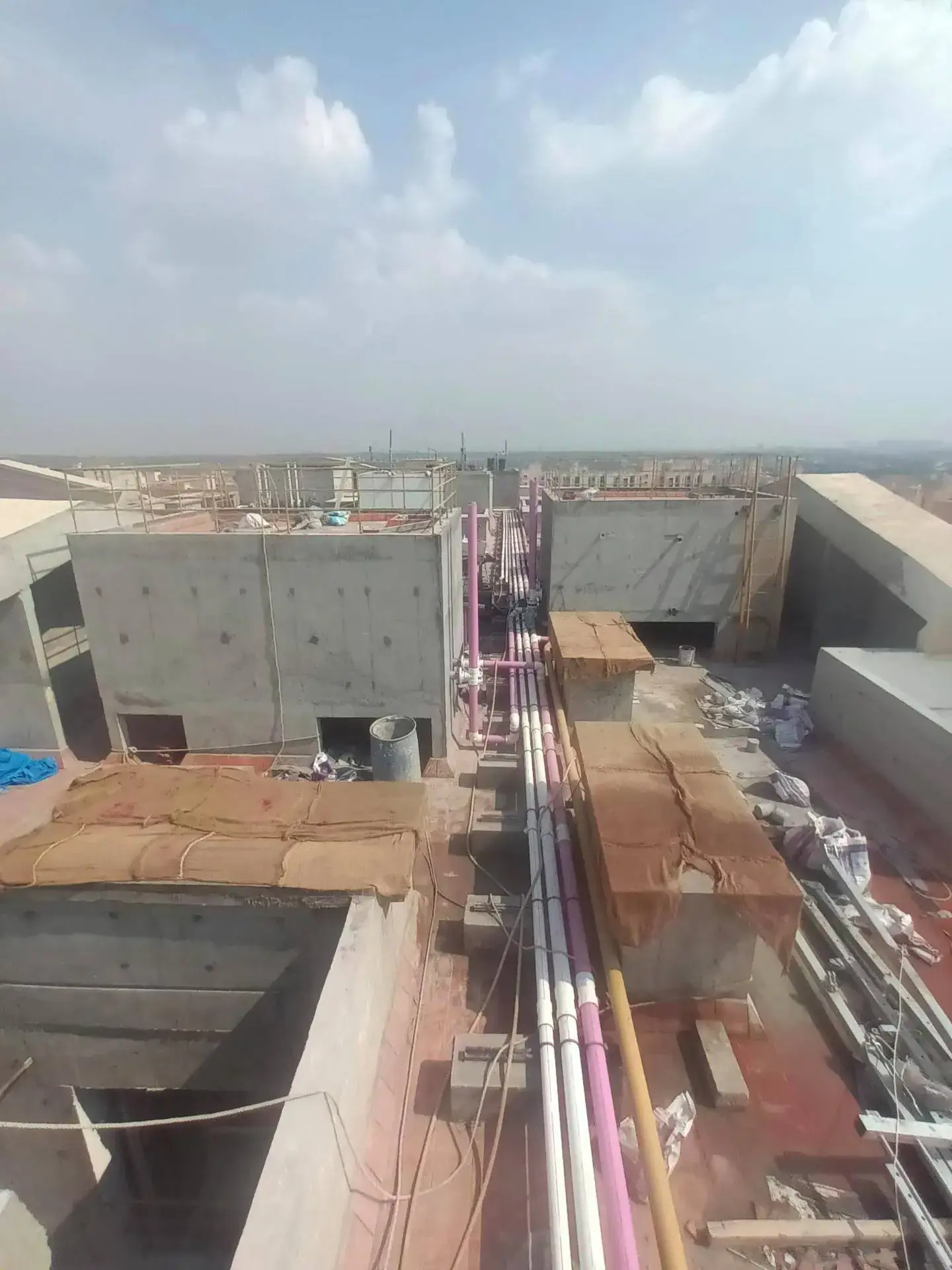

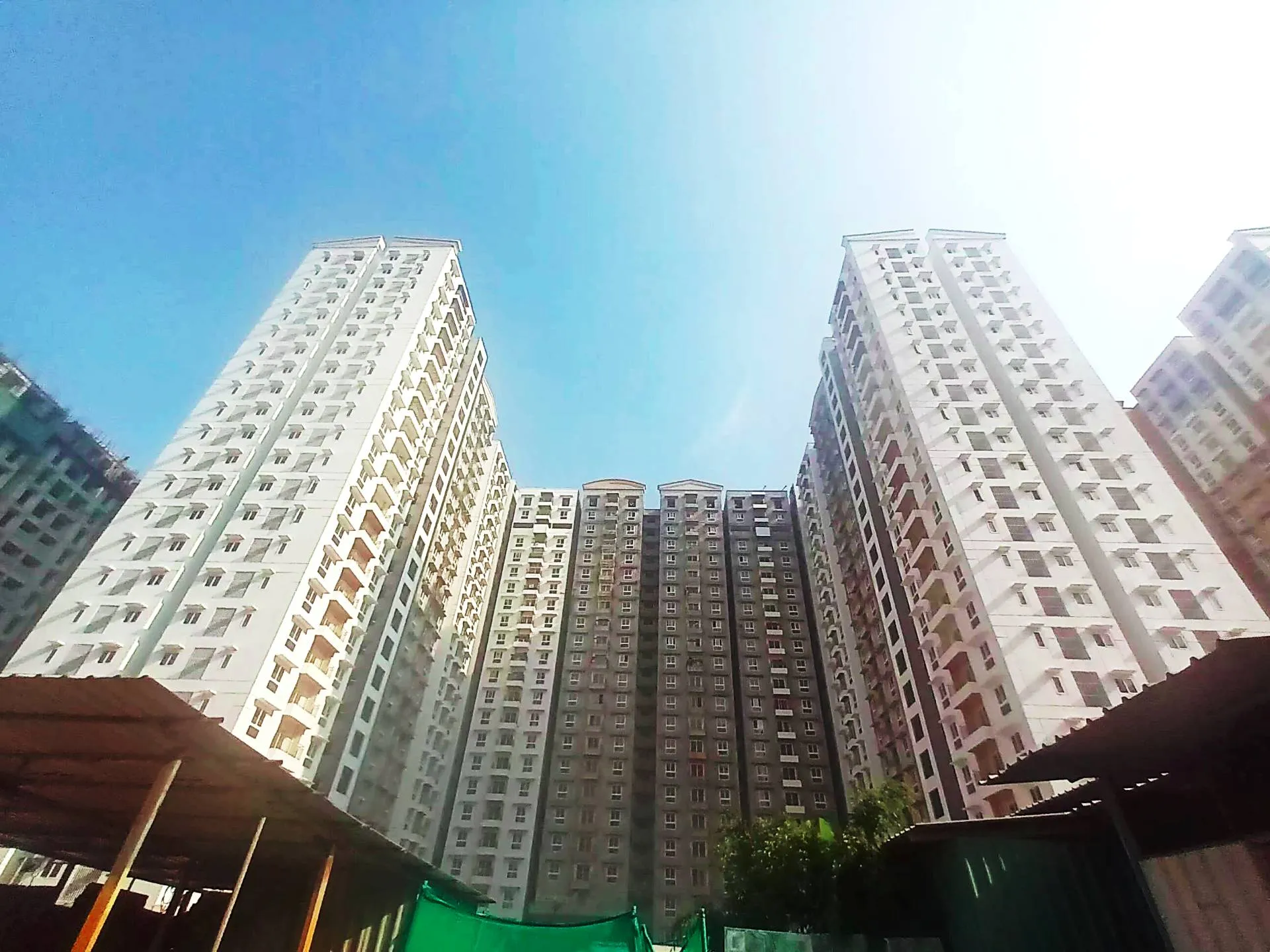

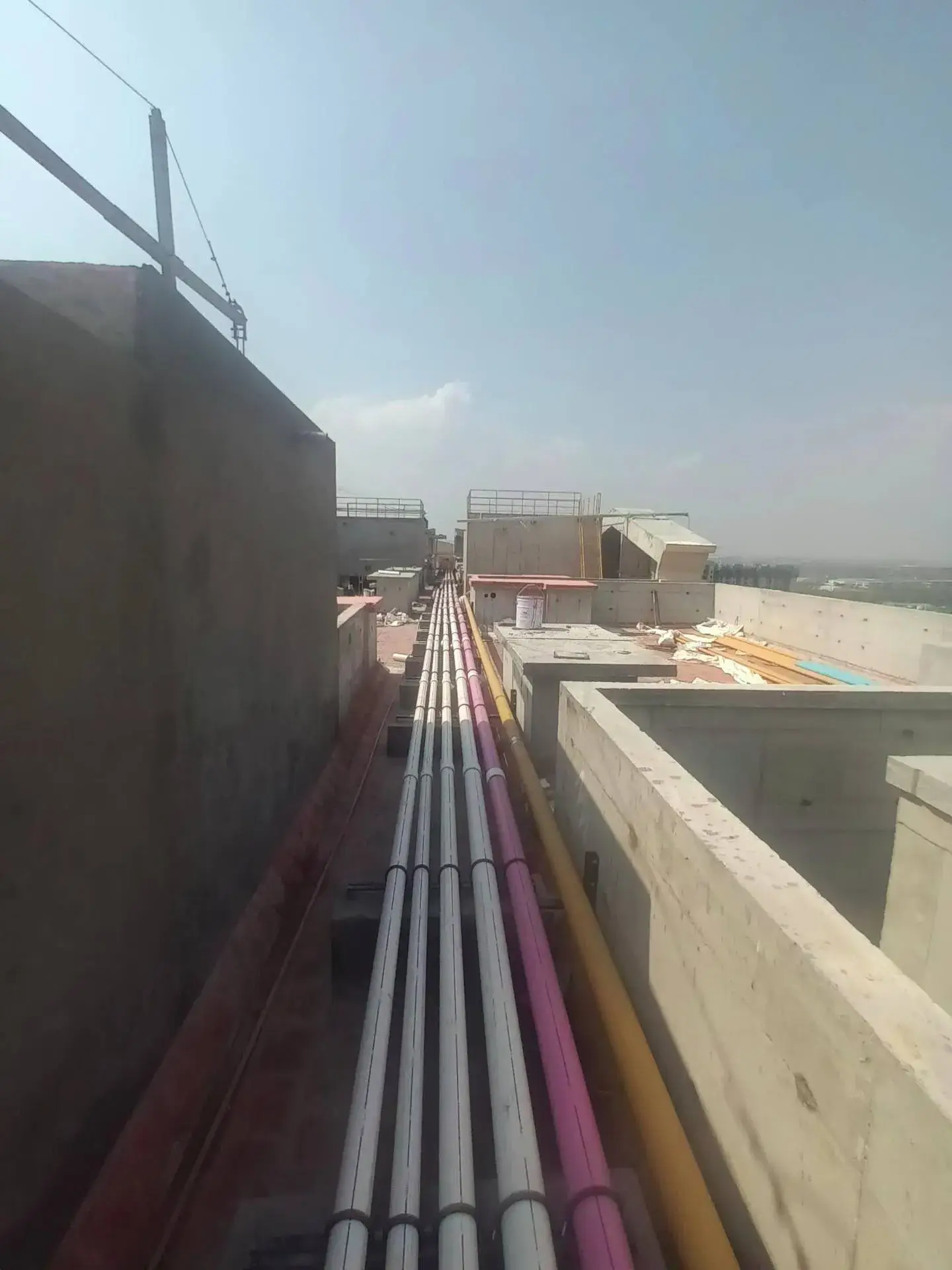

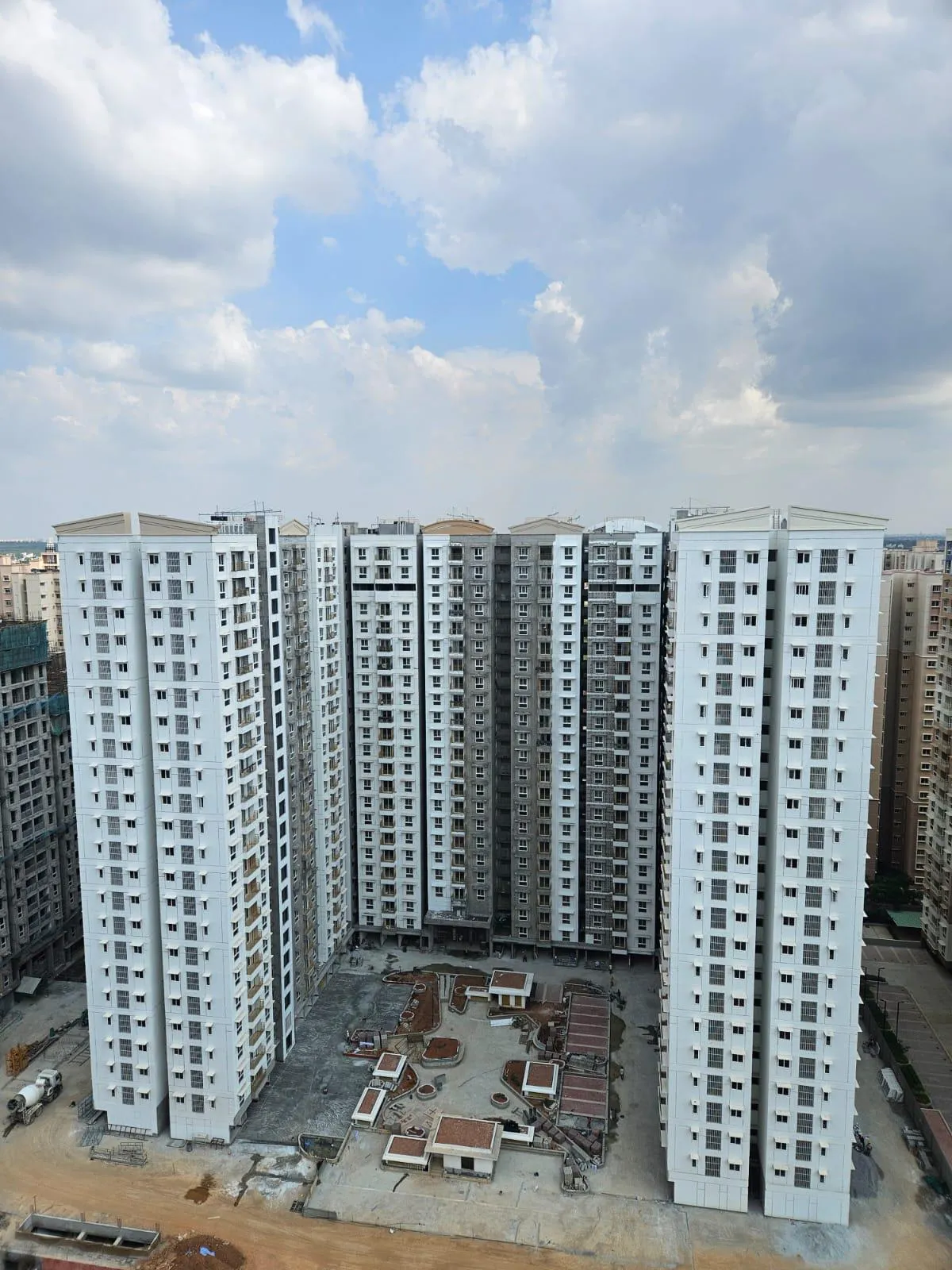

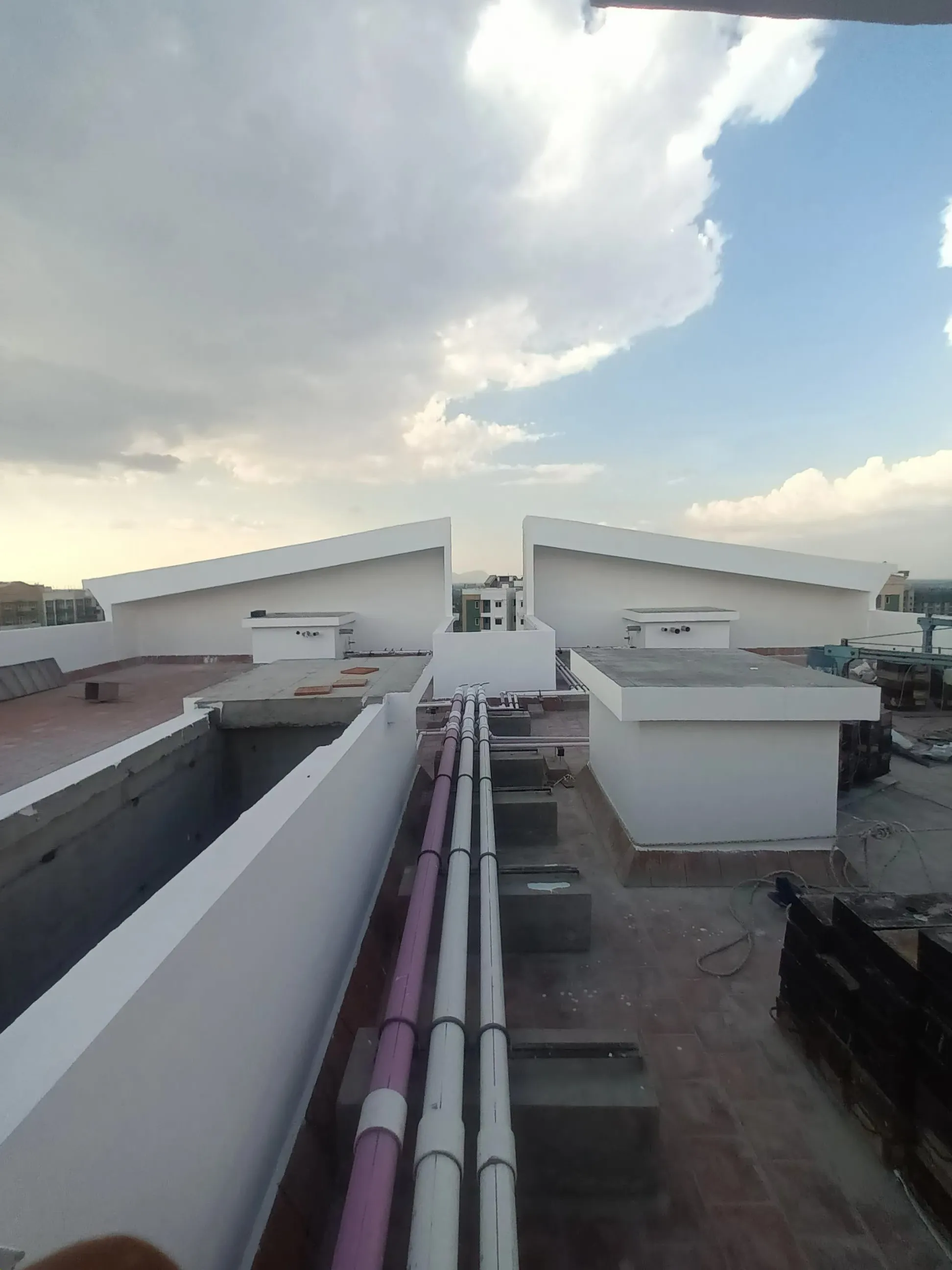

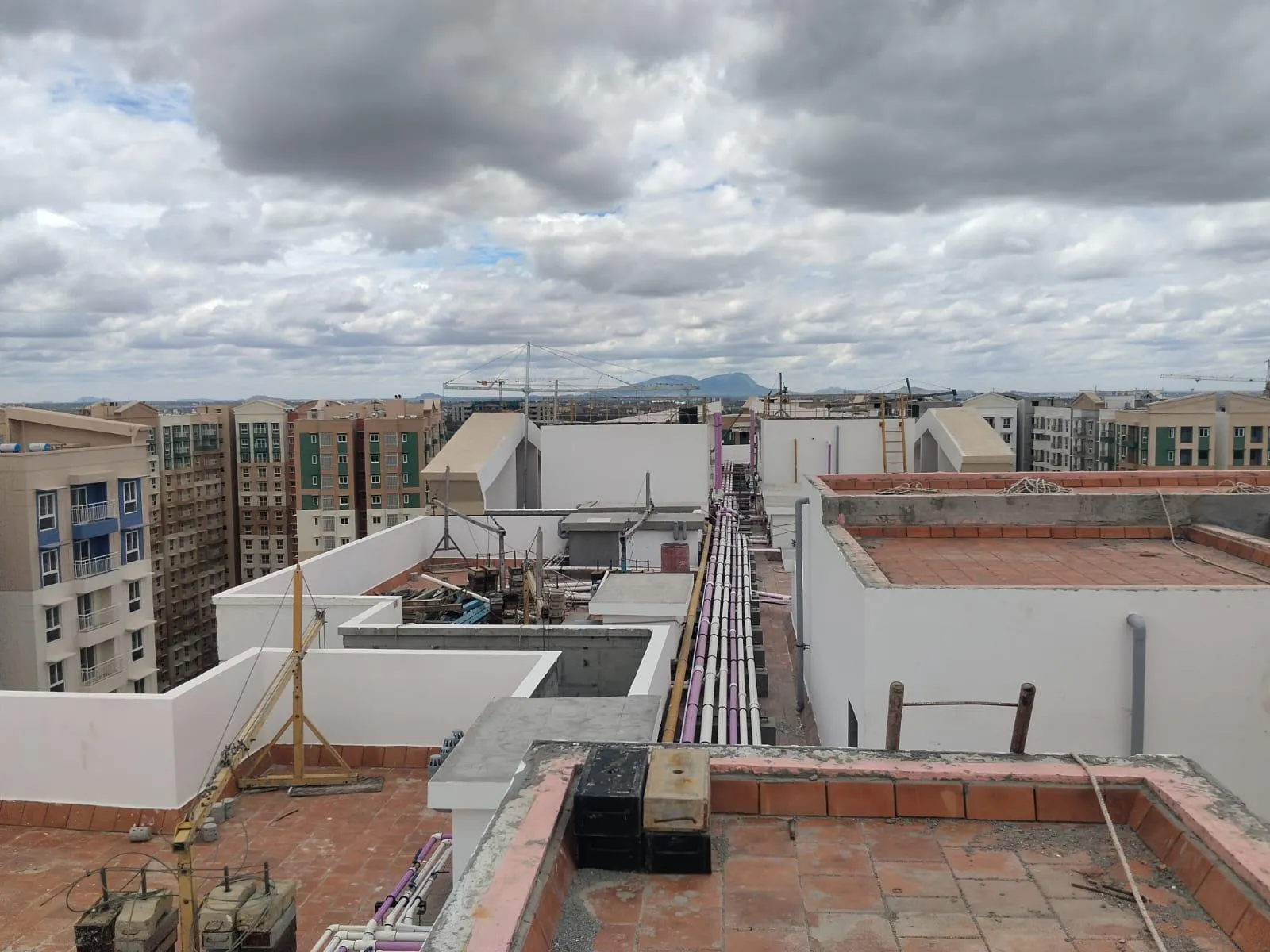

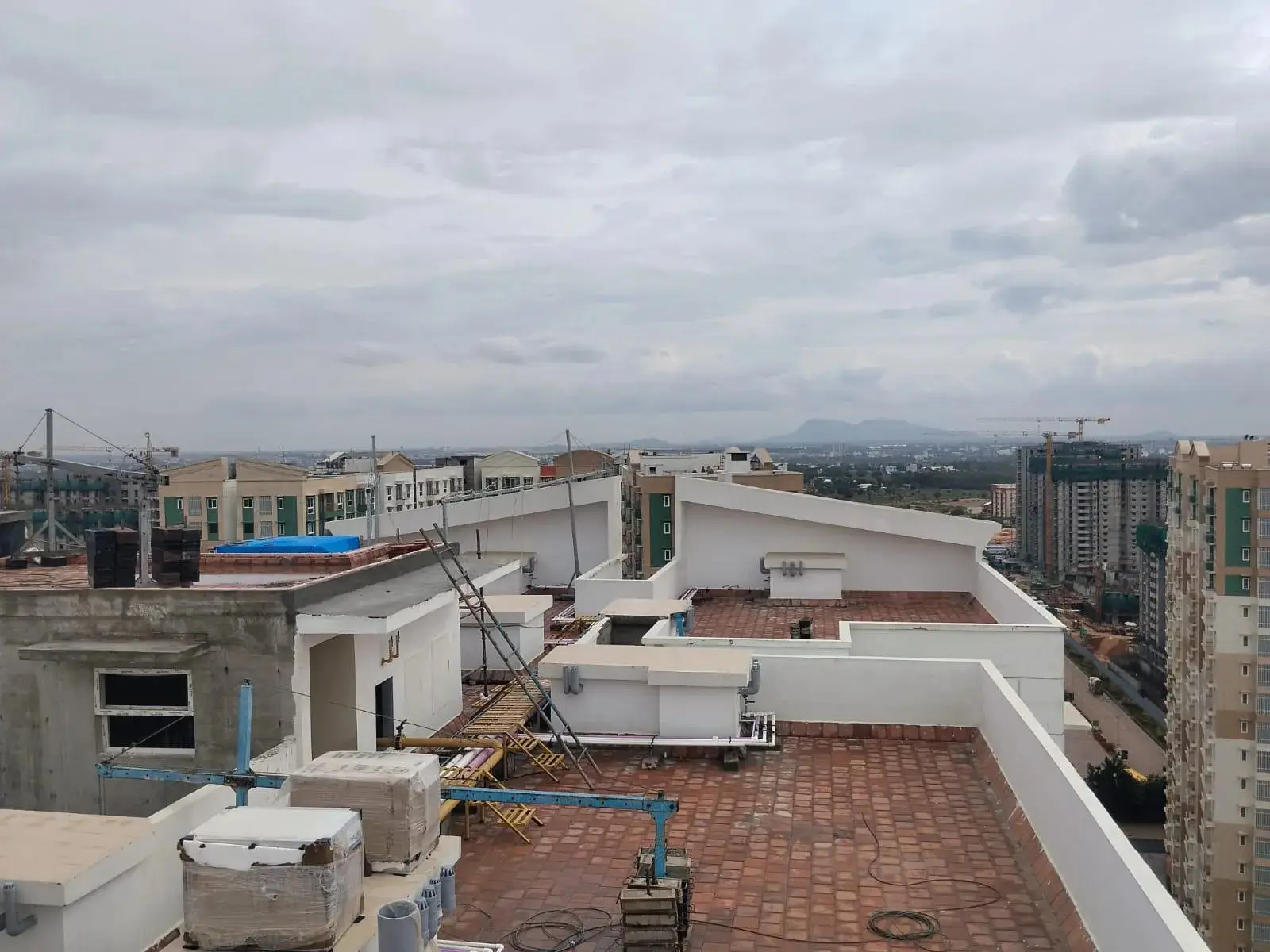

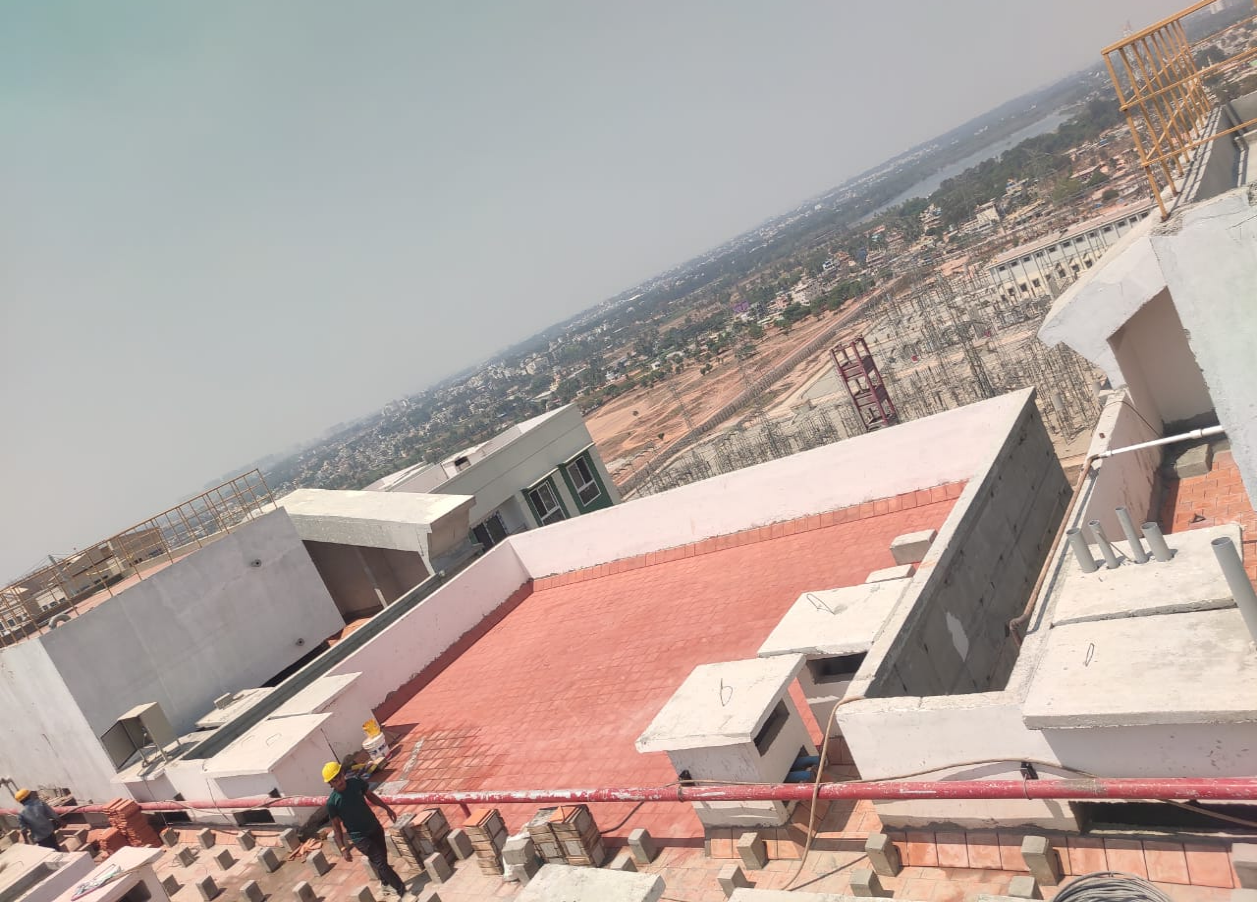

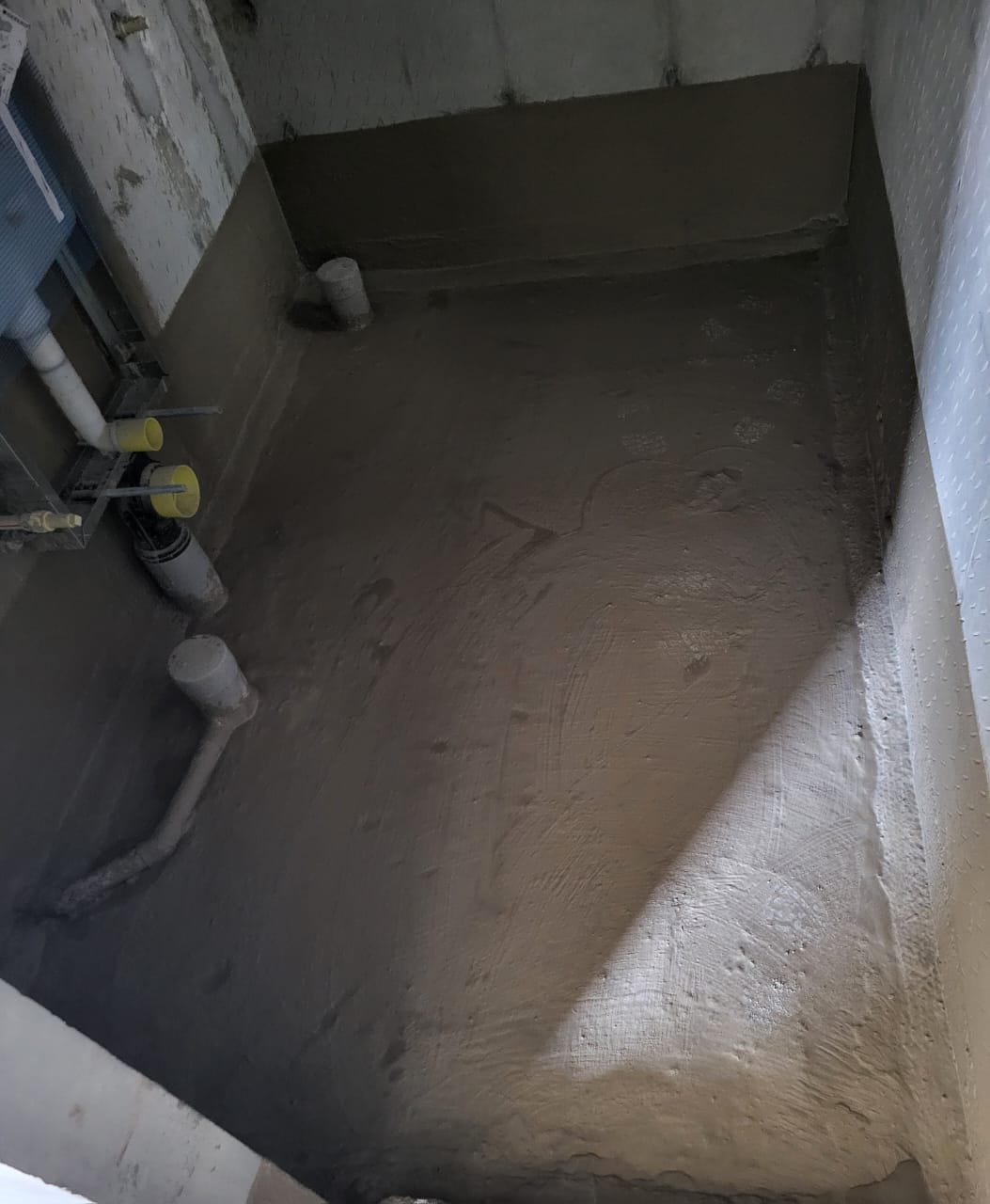

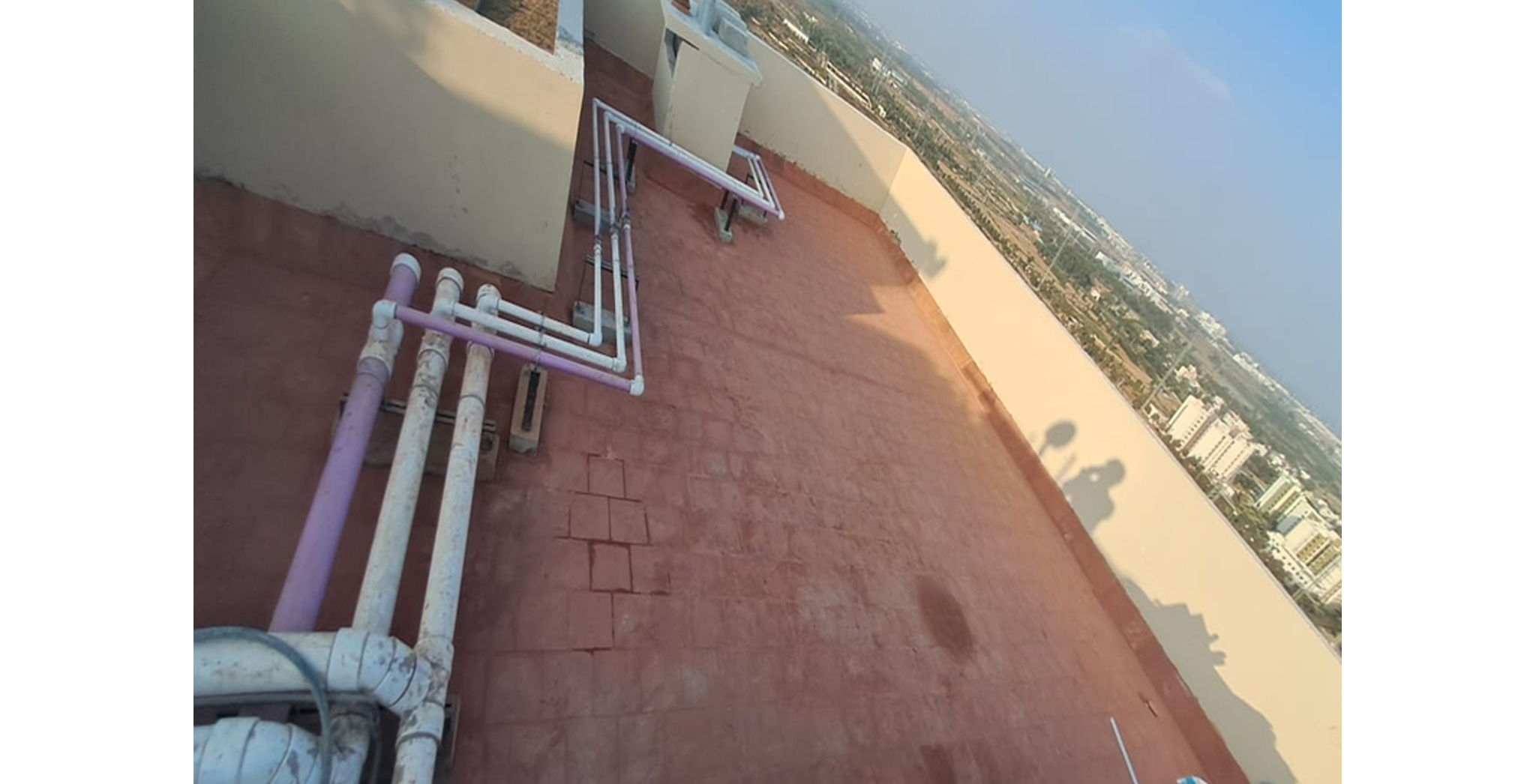

Terrace Waterproofing Works is completed - Jun 2025

Terrace Waterproofing Works is completed - Jun 2025

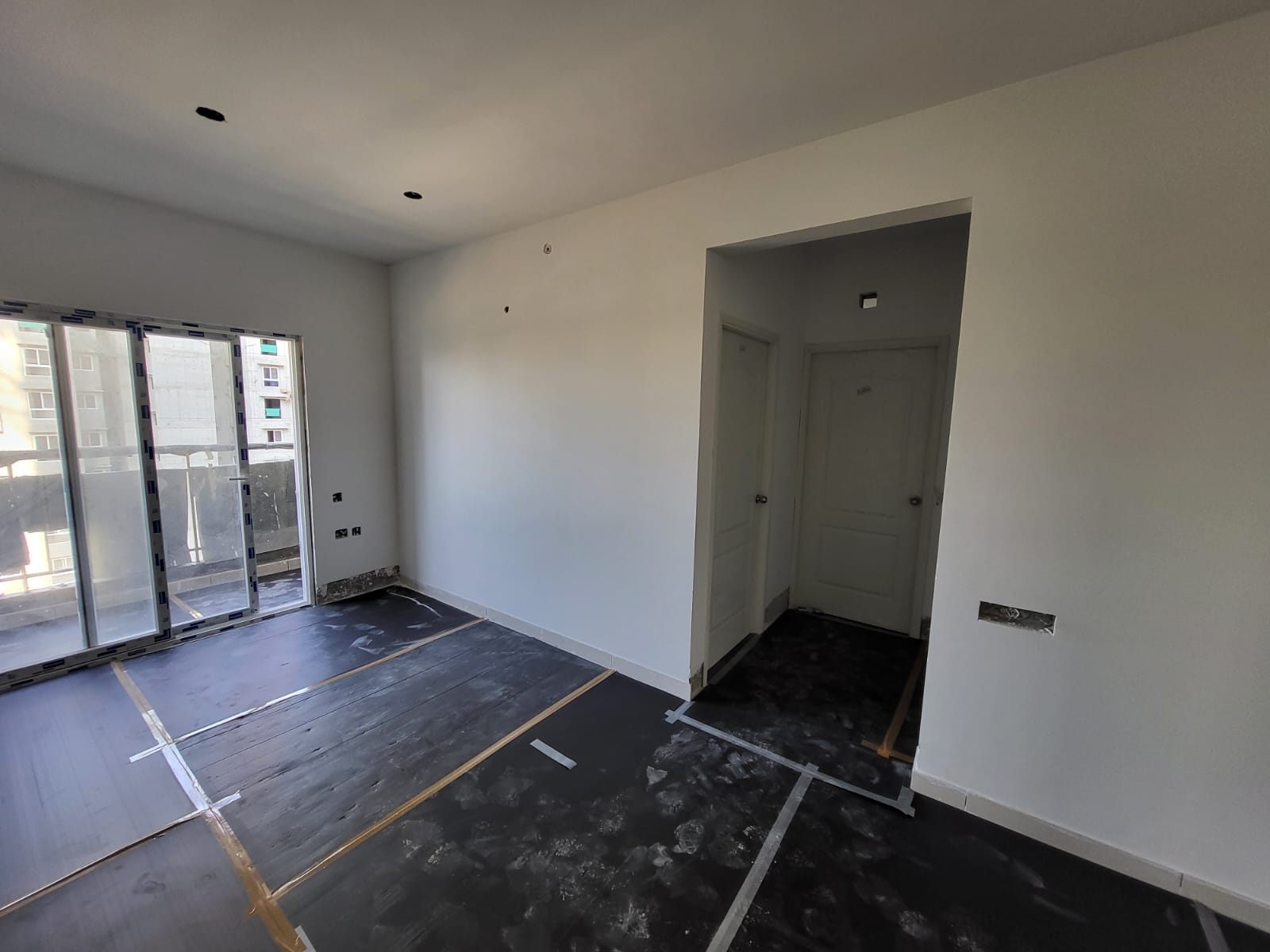

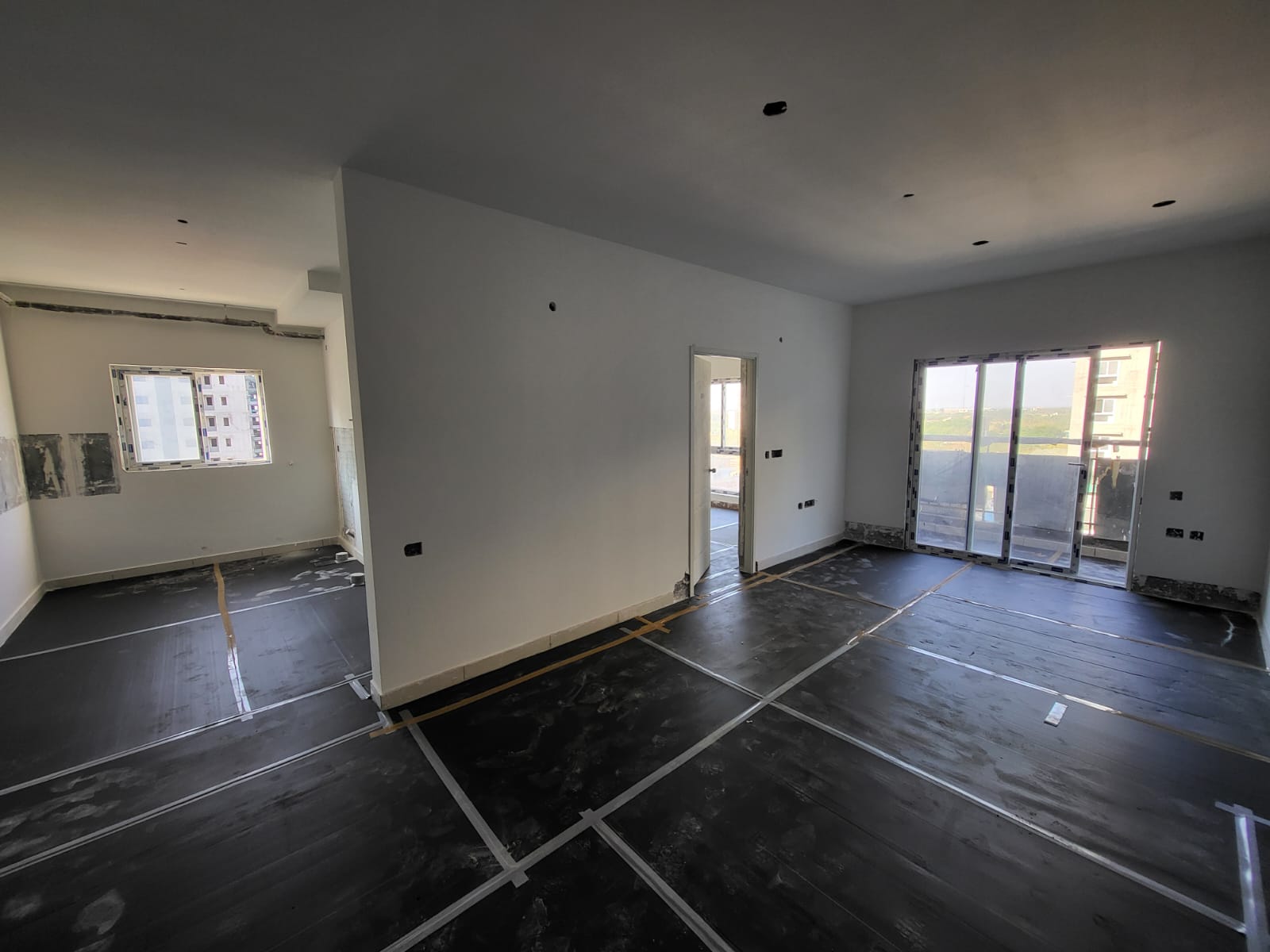

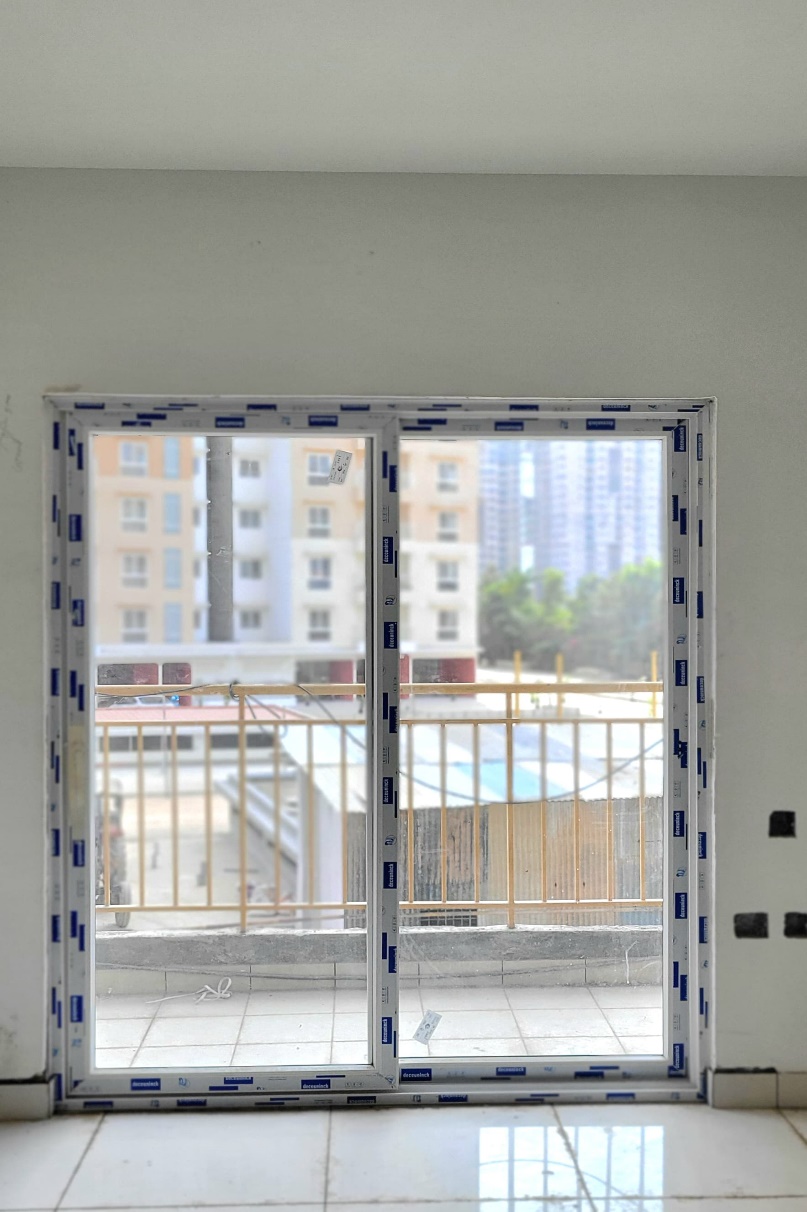

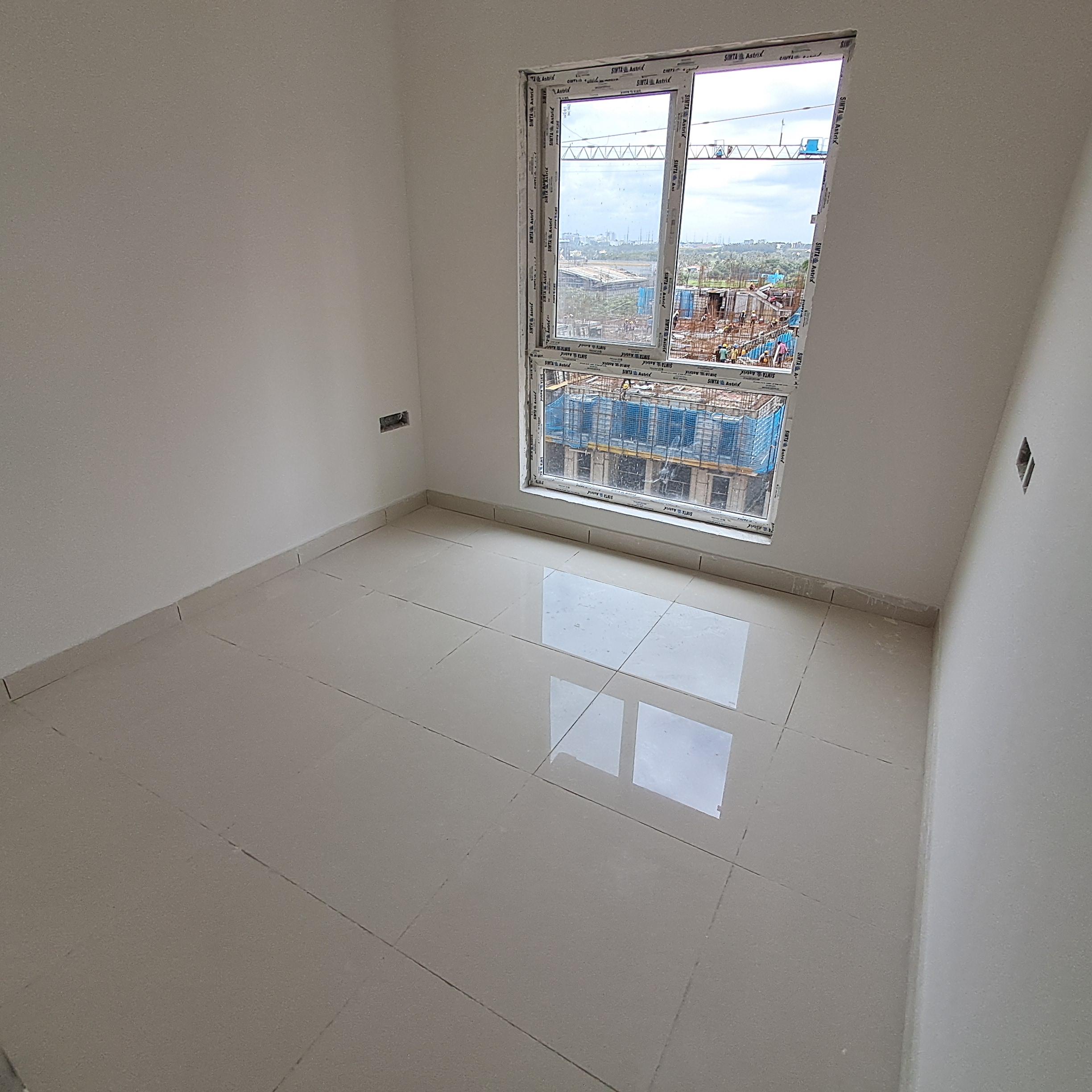

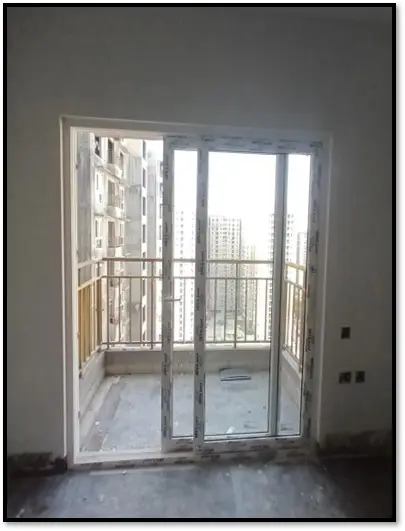

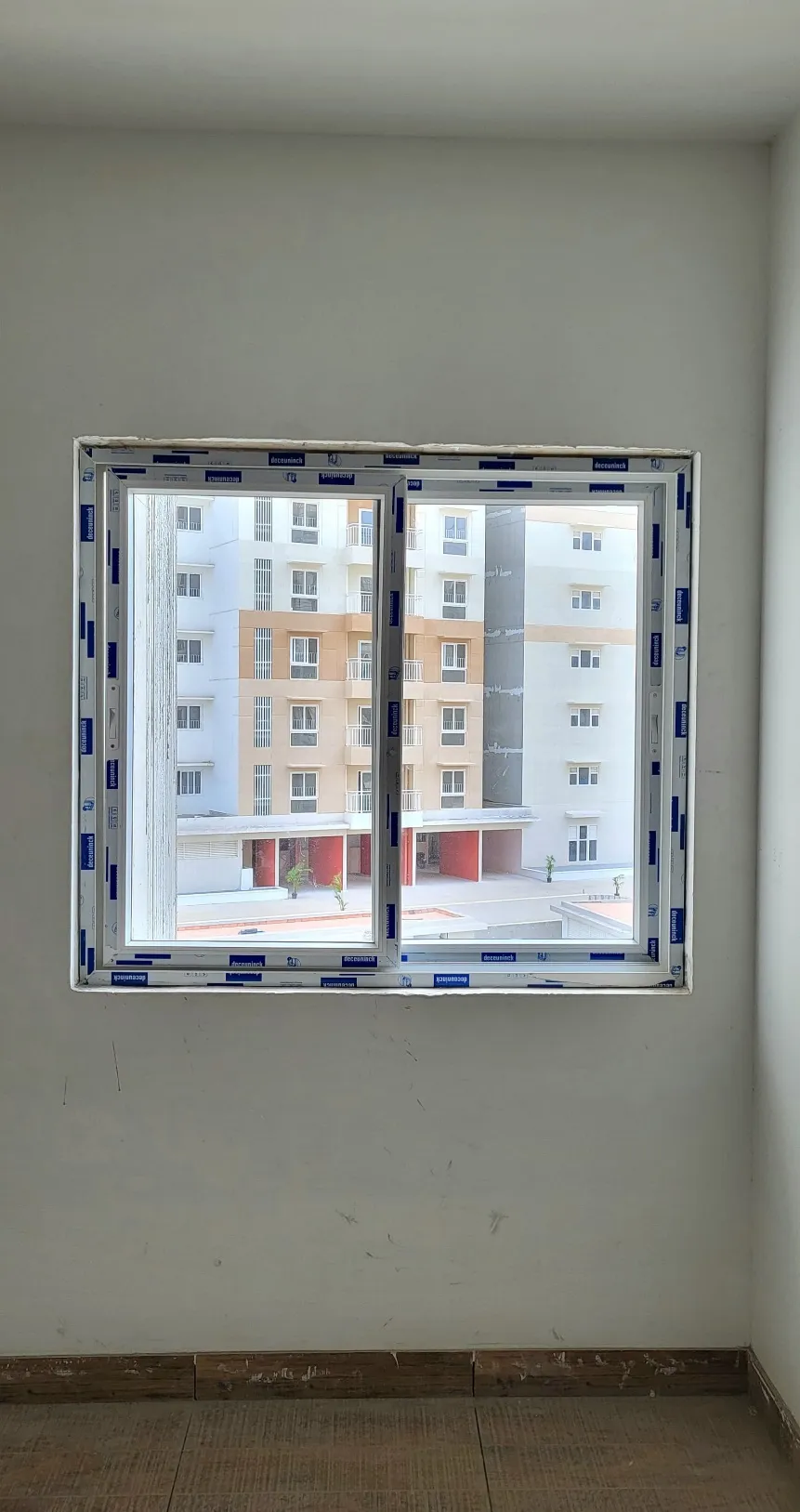

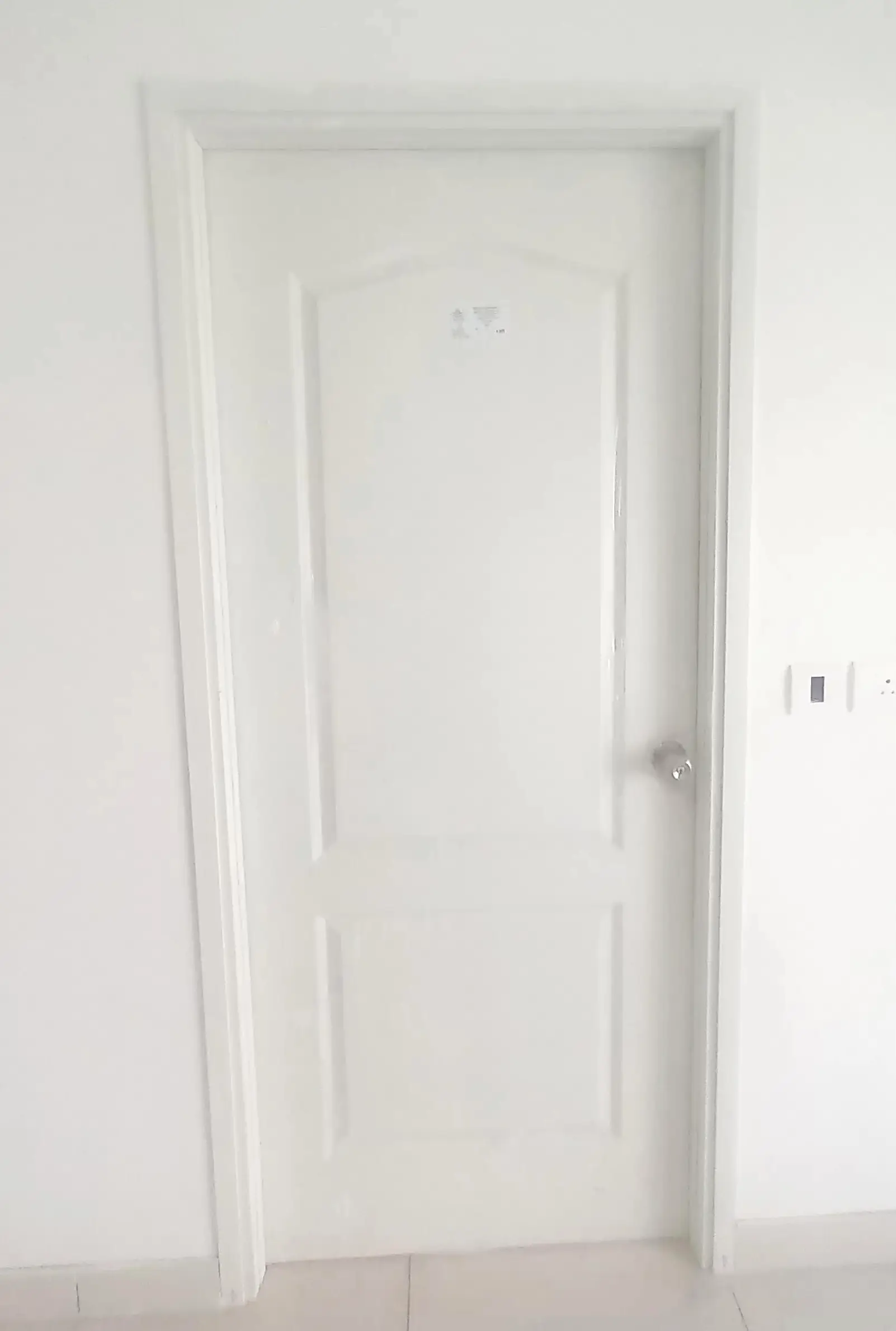

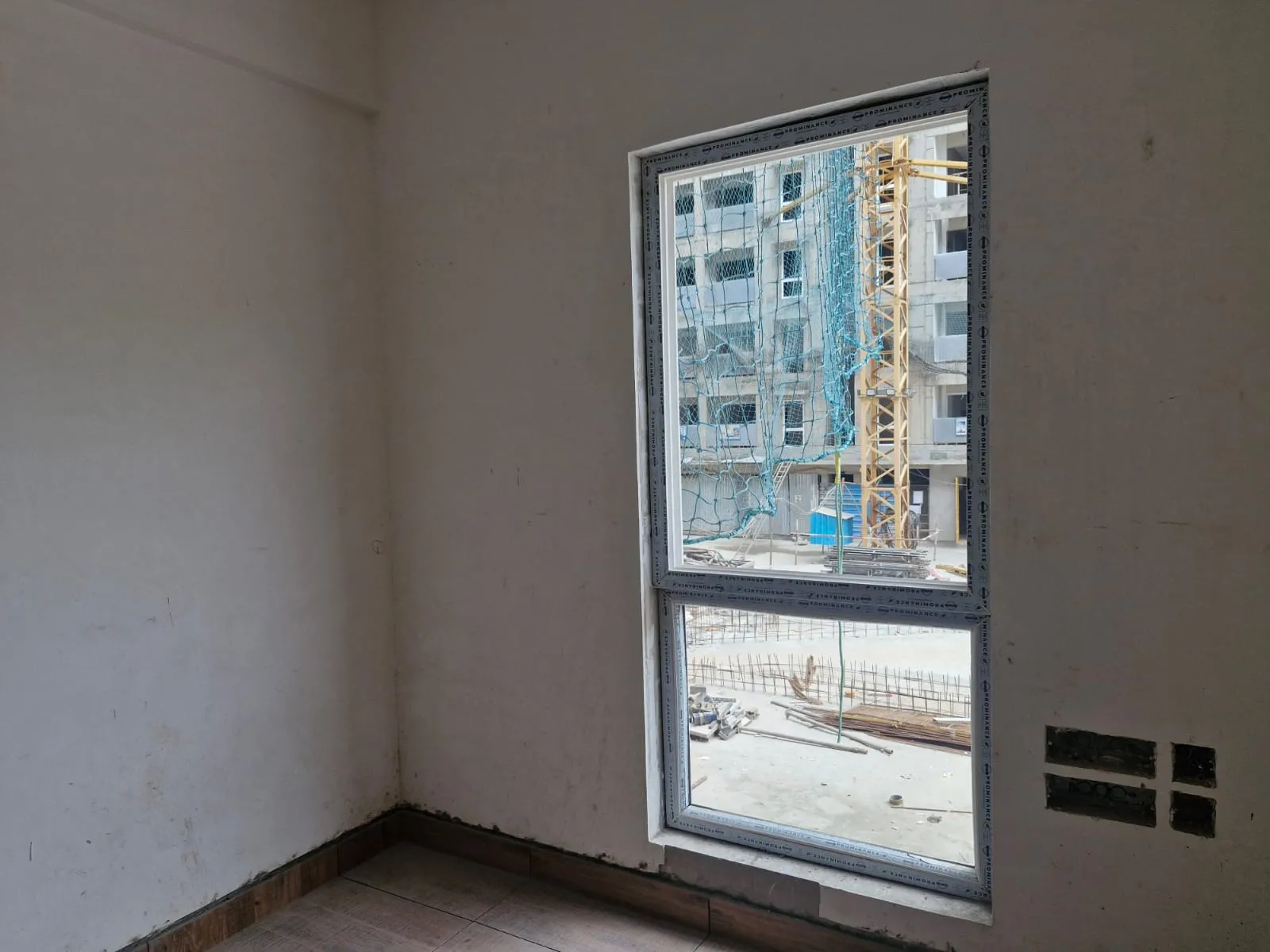

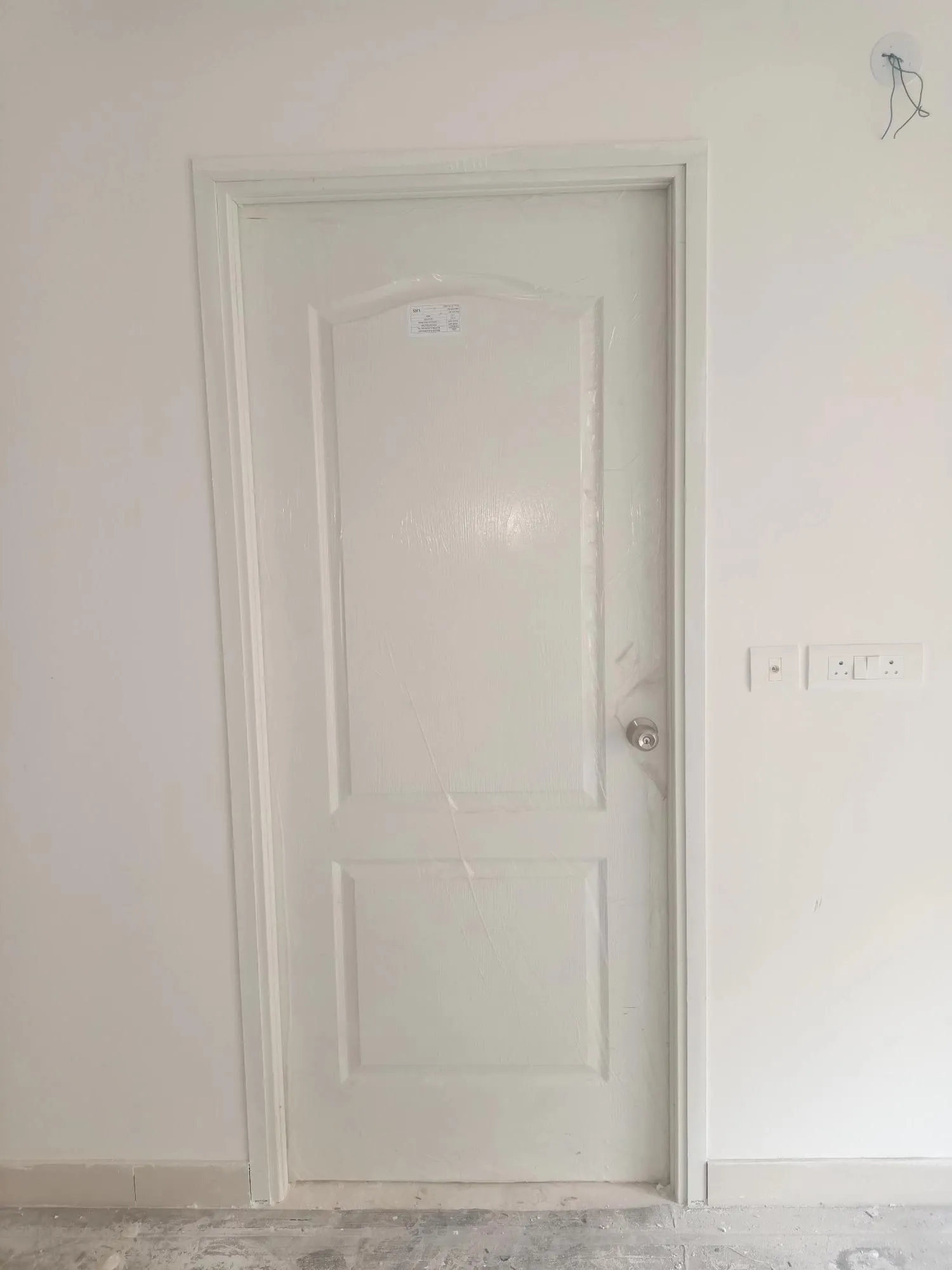

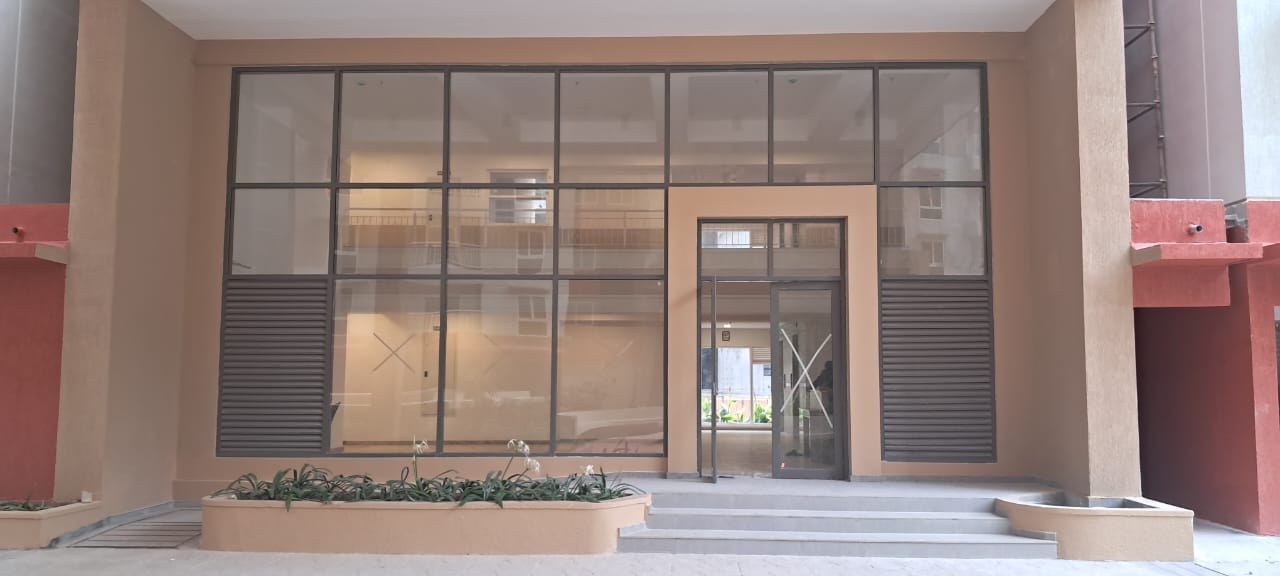

Windows and Doors fixing work is completed - Jun 2025

Windows and Doors fixing work is completed - Jun 2025

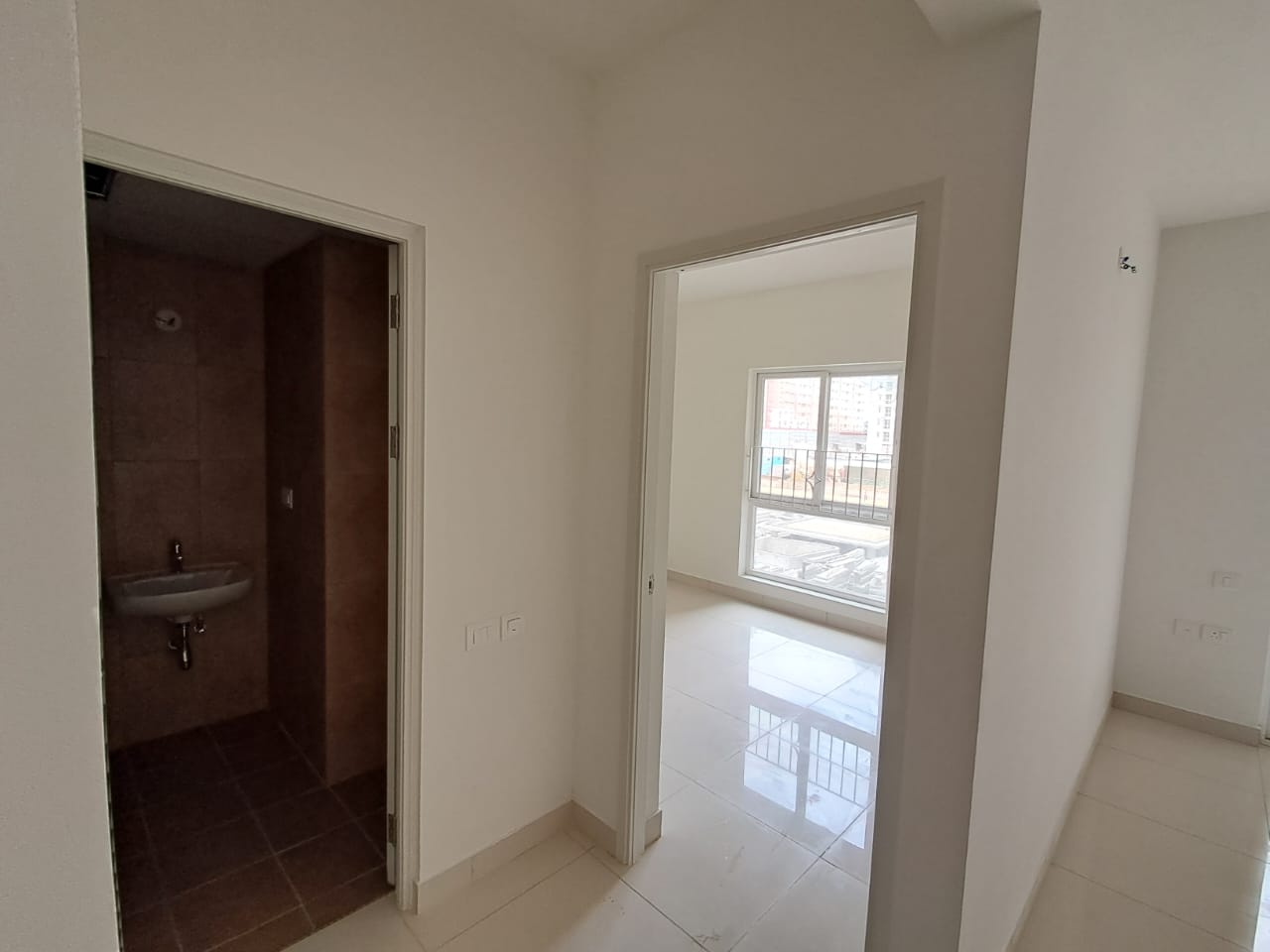

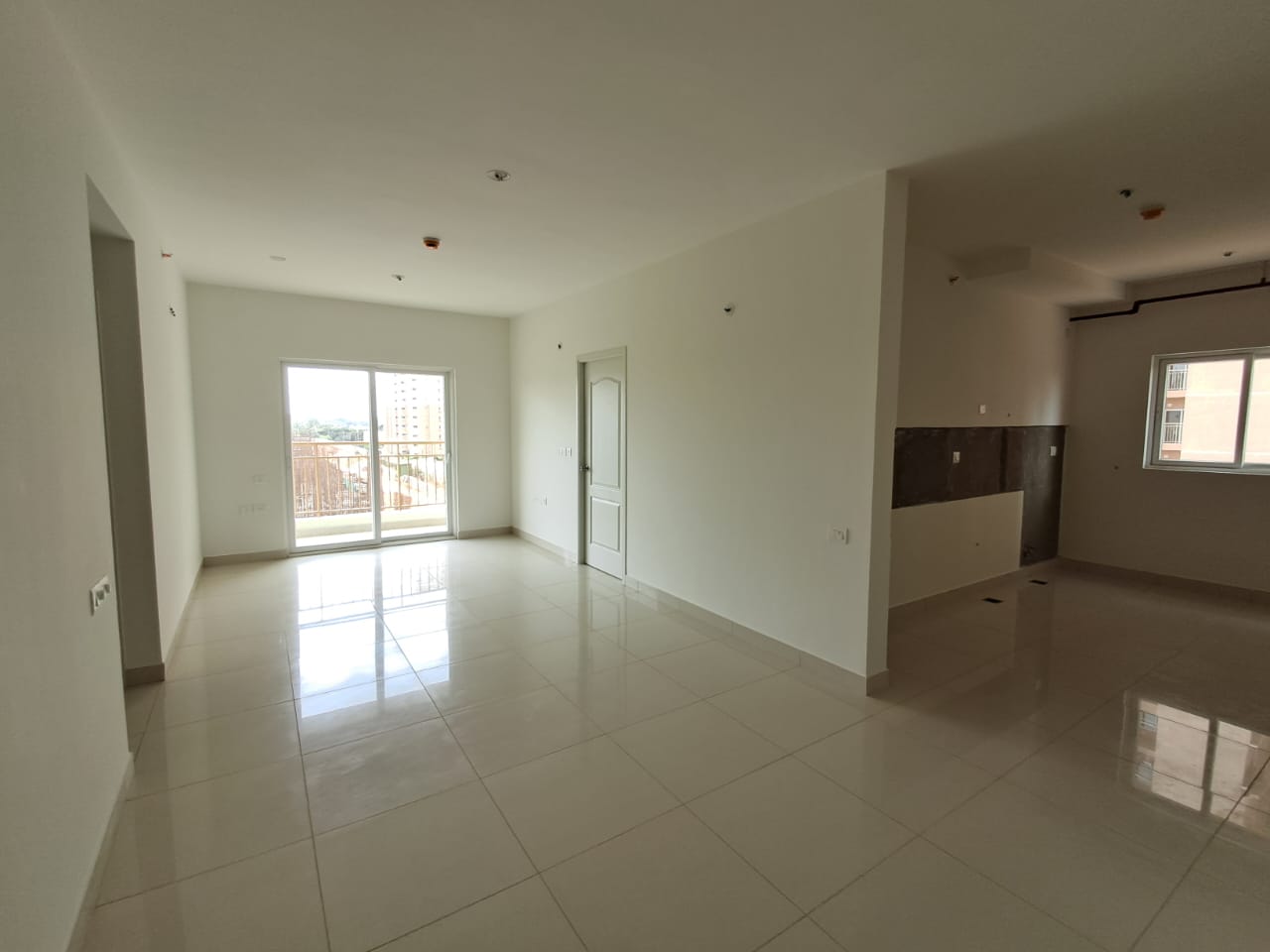

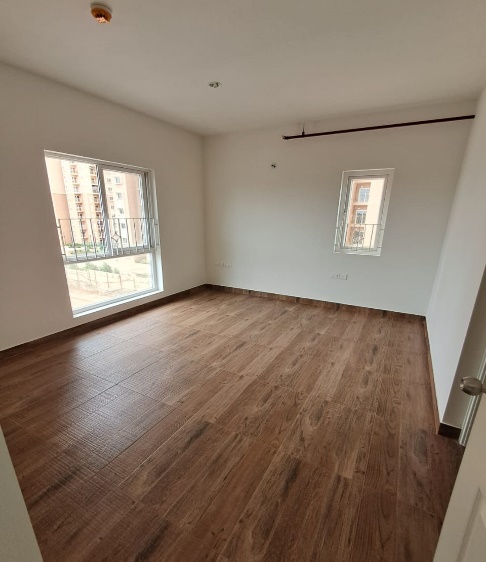

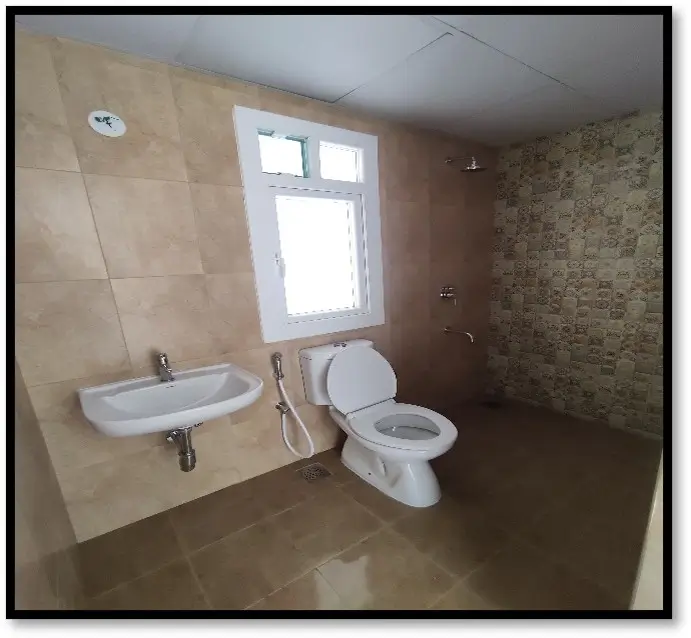

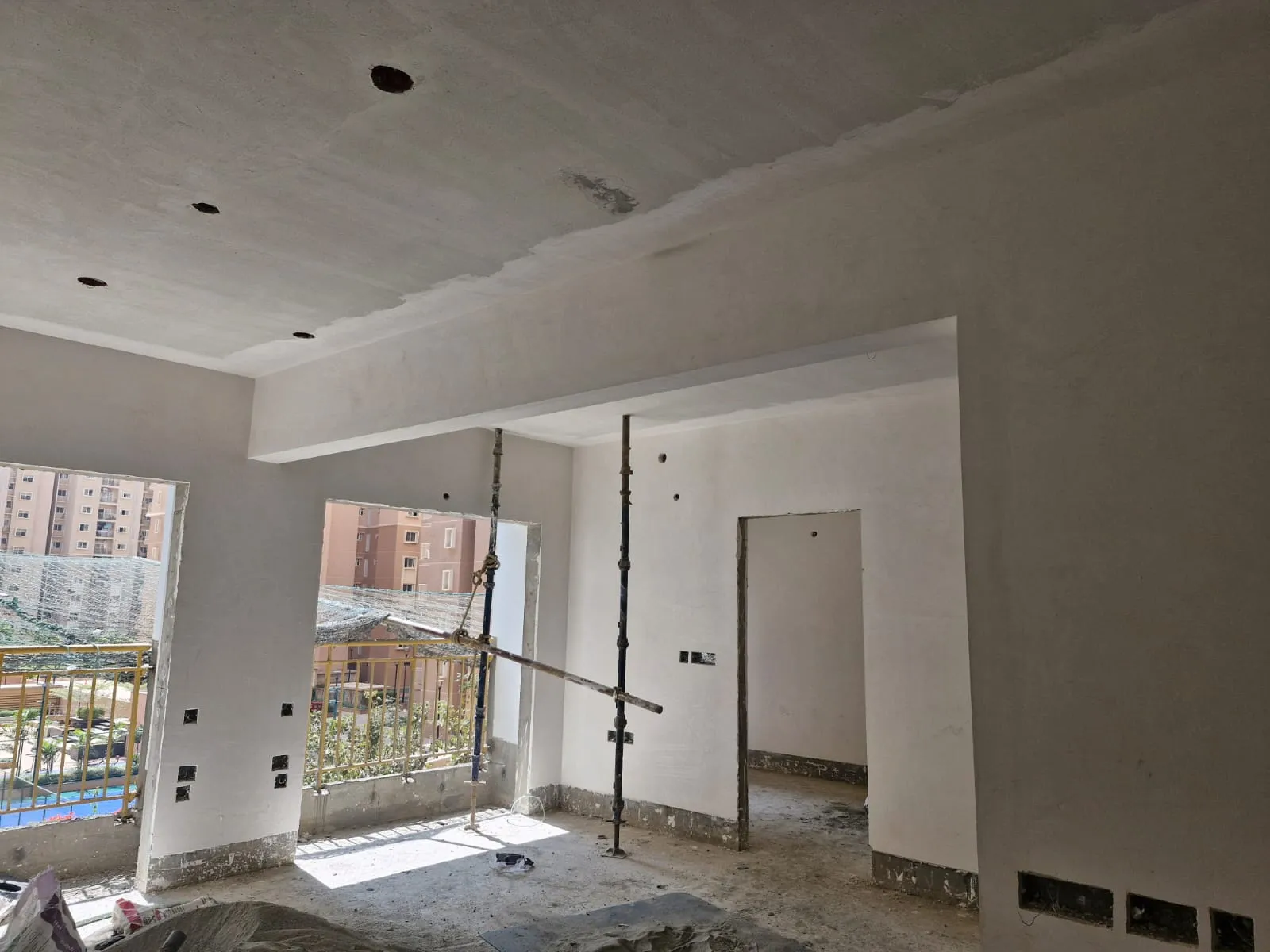

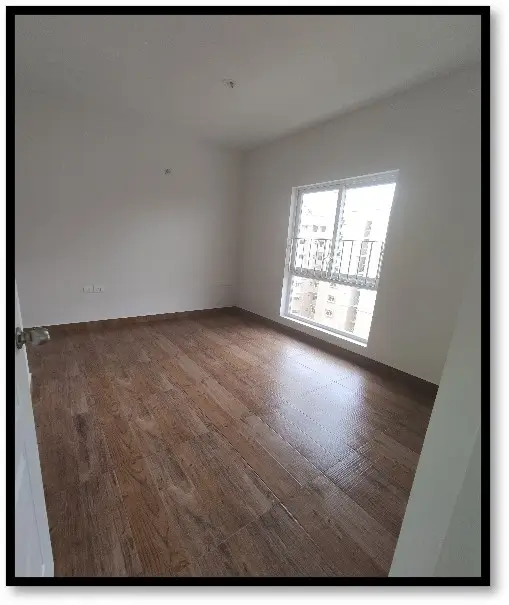

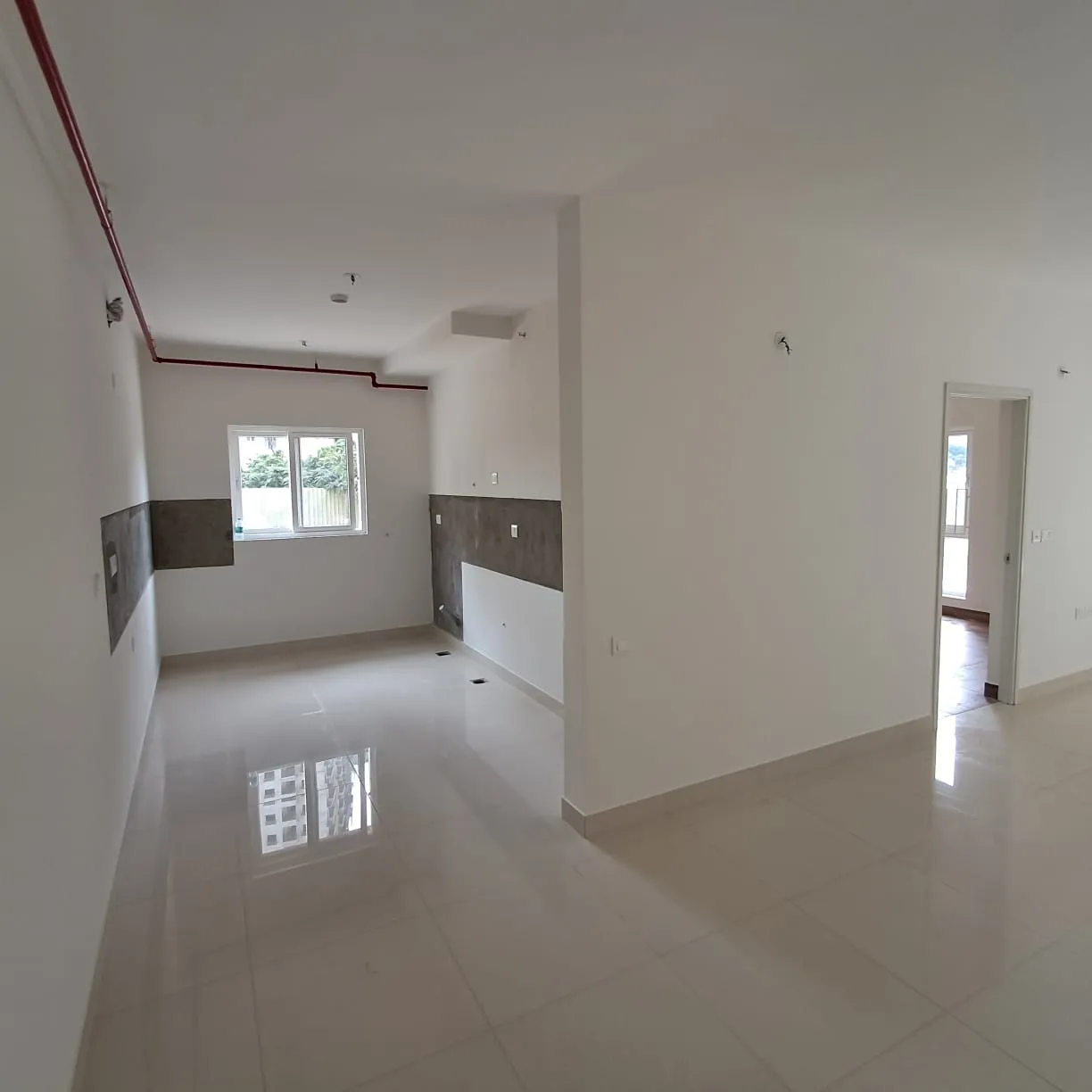

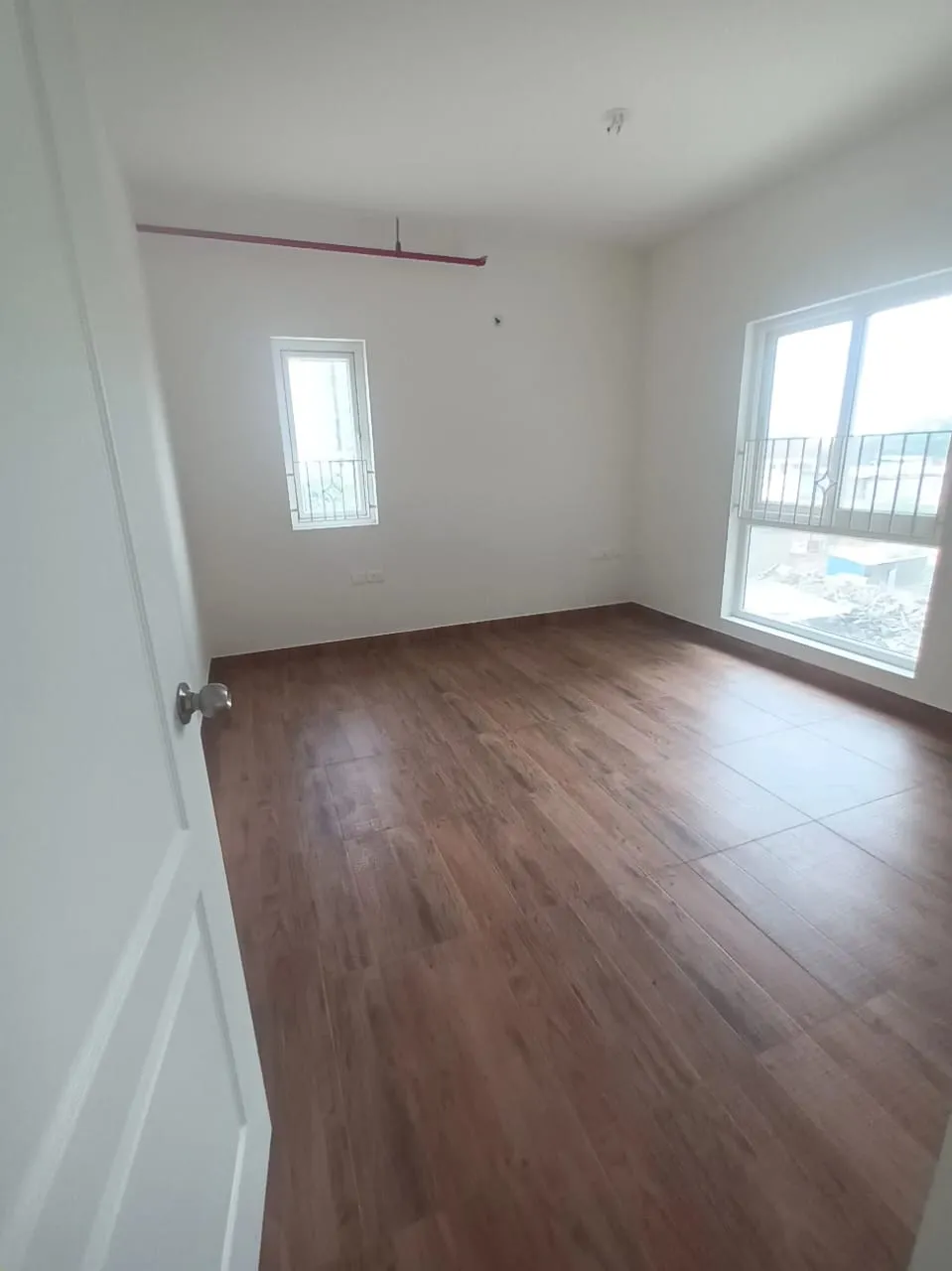

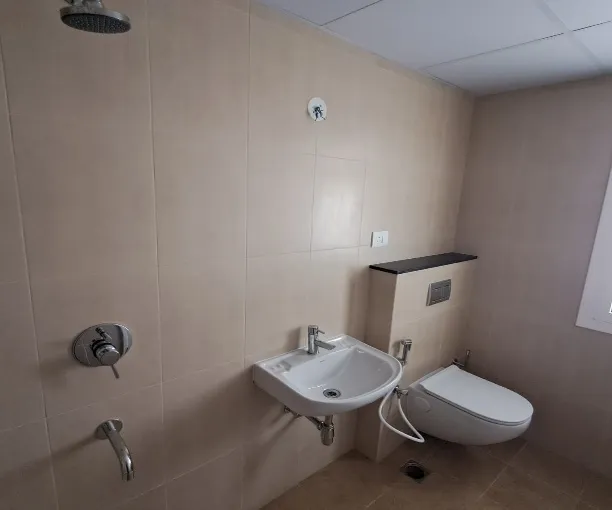

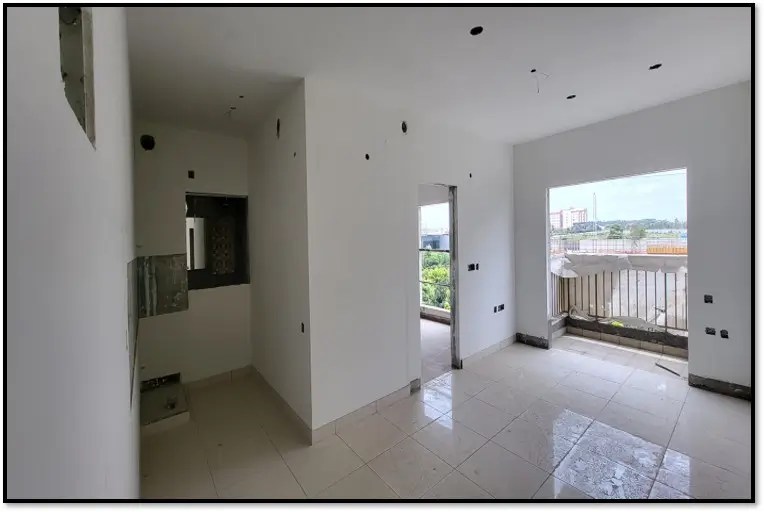

Finishing Work in Progress - Jun 2025

Finishing Work in Progress - Jun 2025

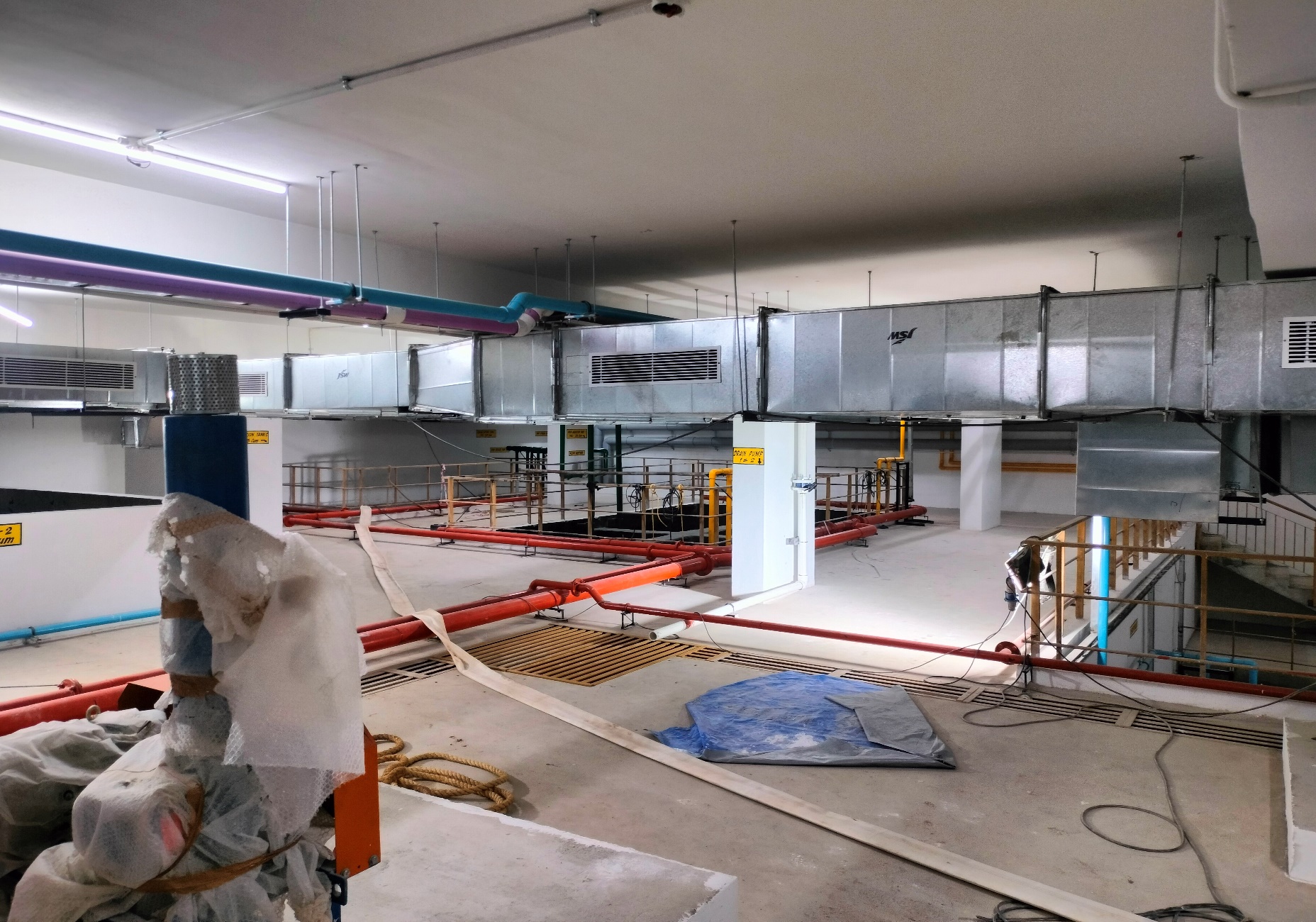

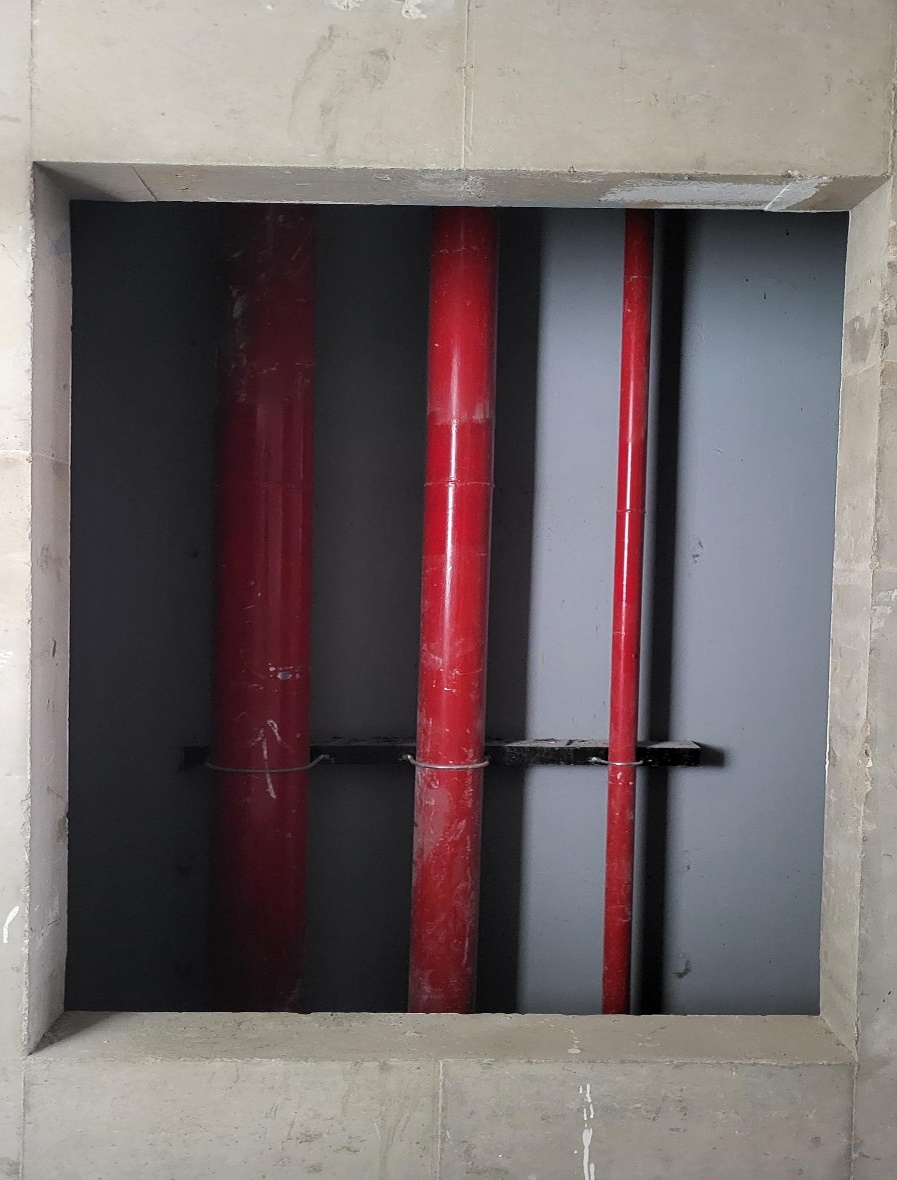

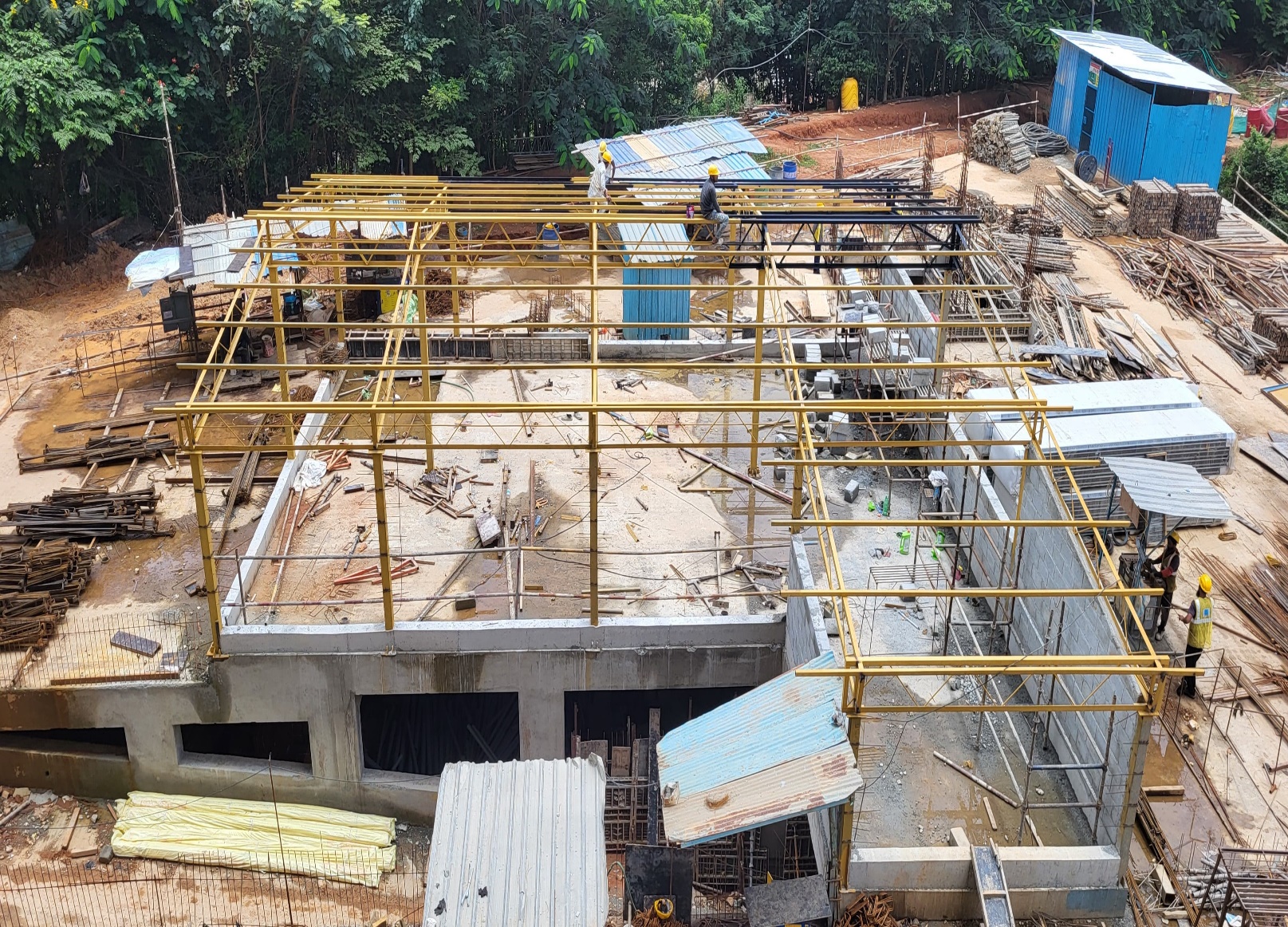

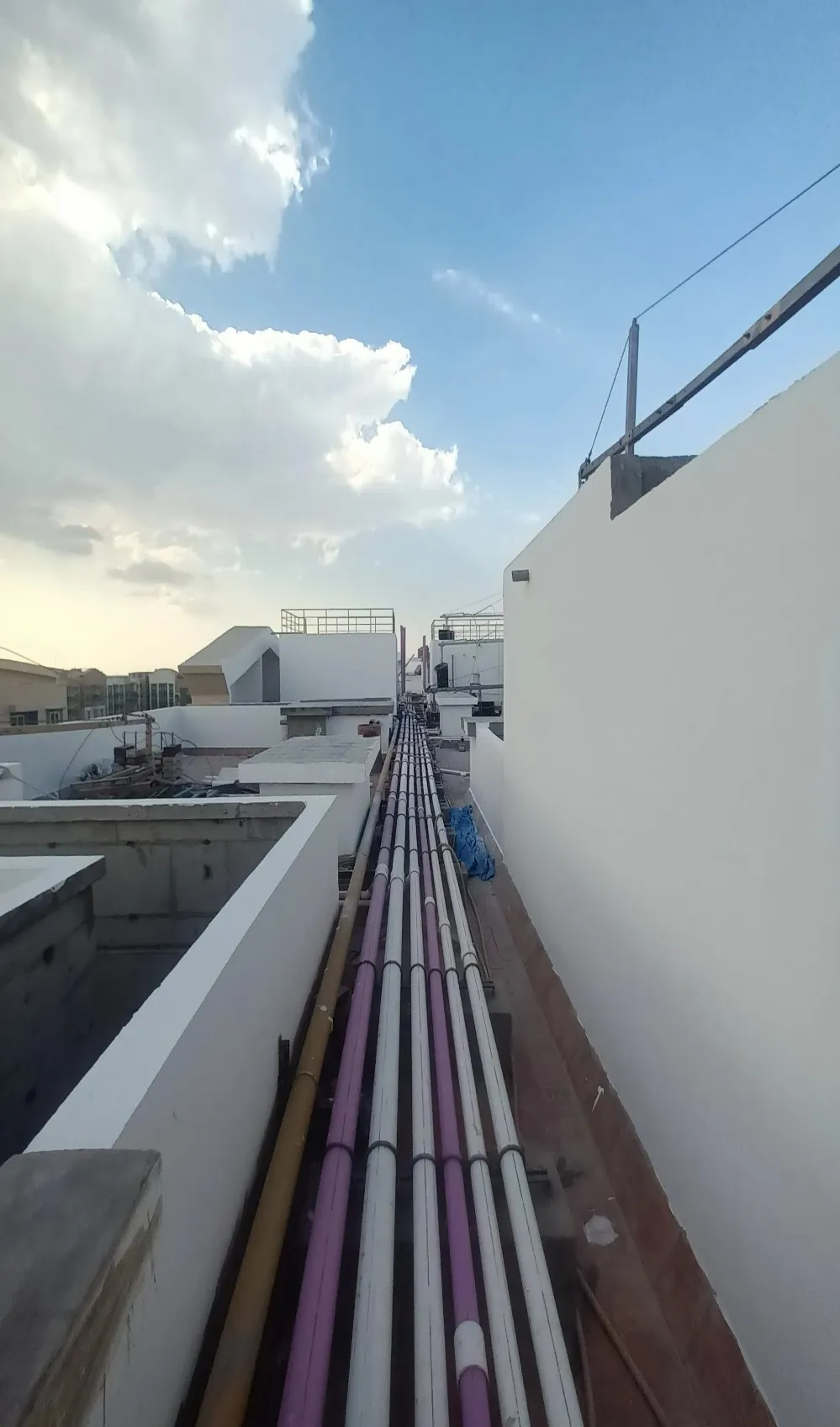

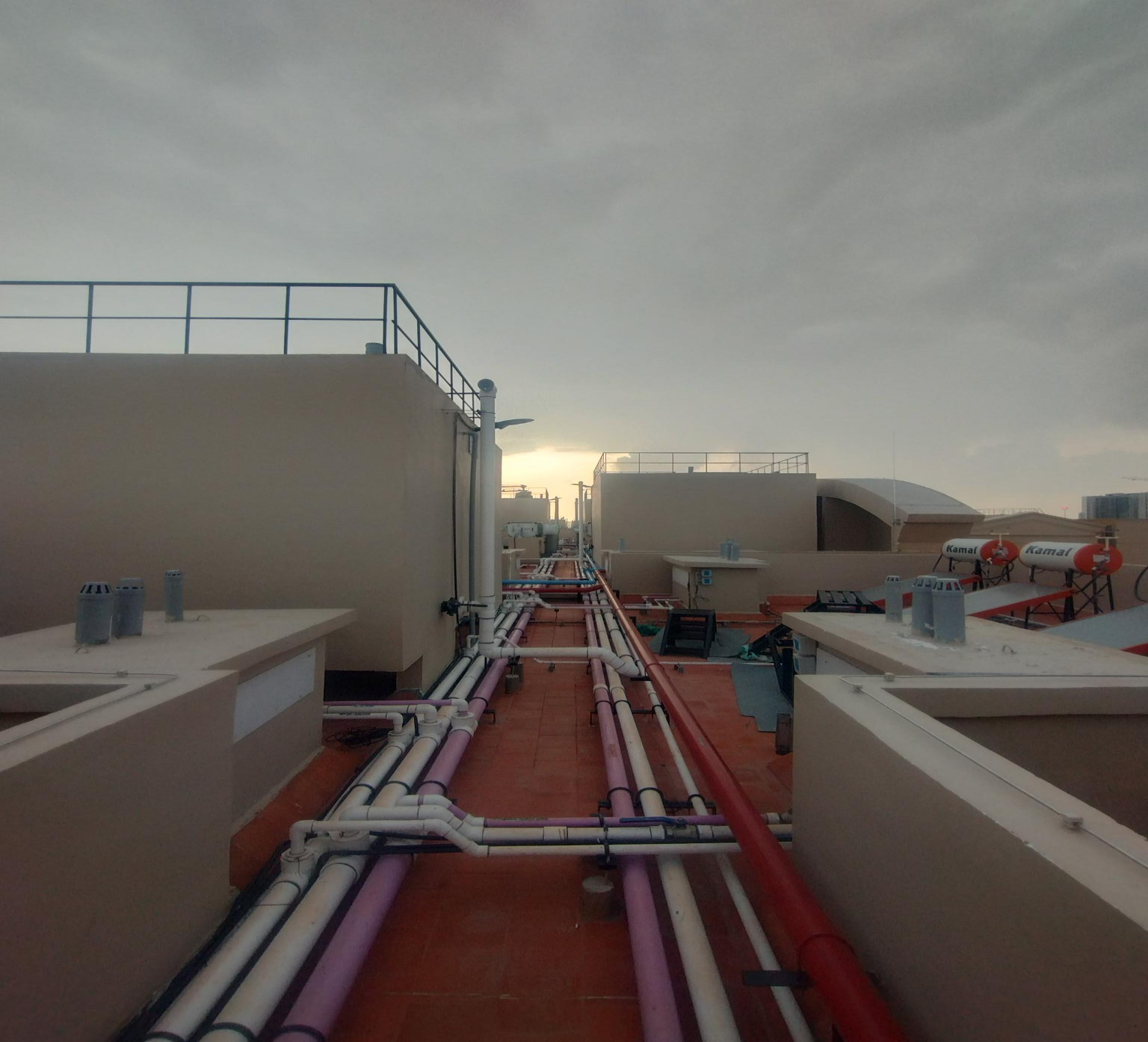

STP HVAC duct and Plumbing Work is in progress - Jun 2025

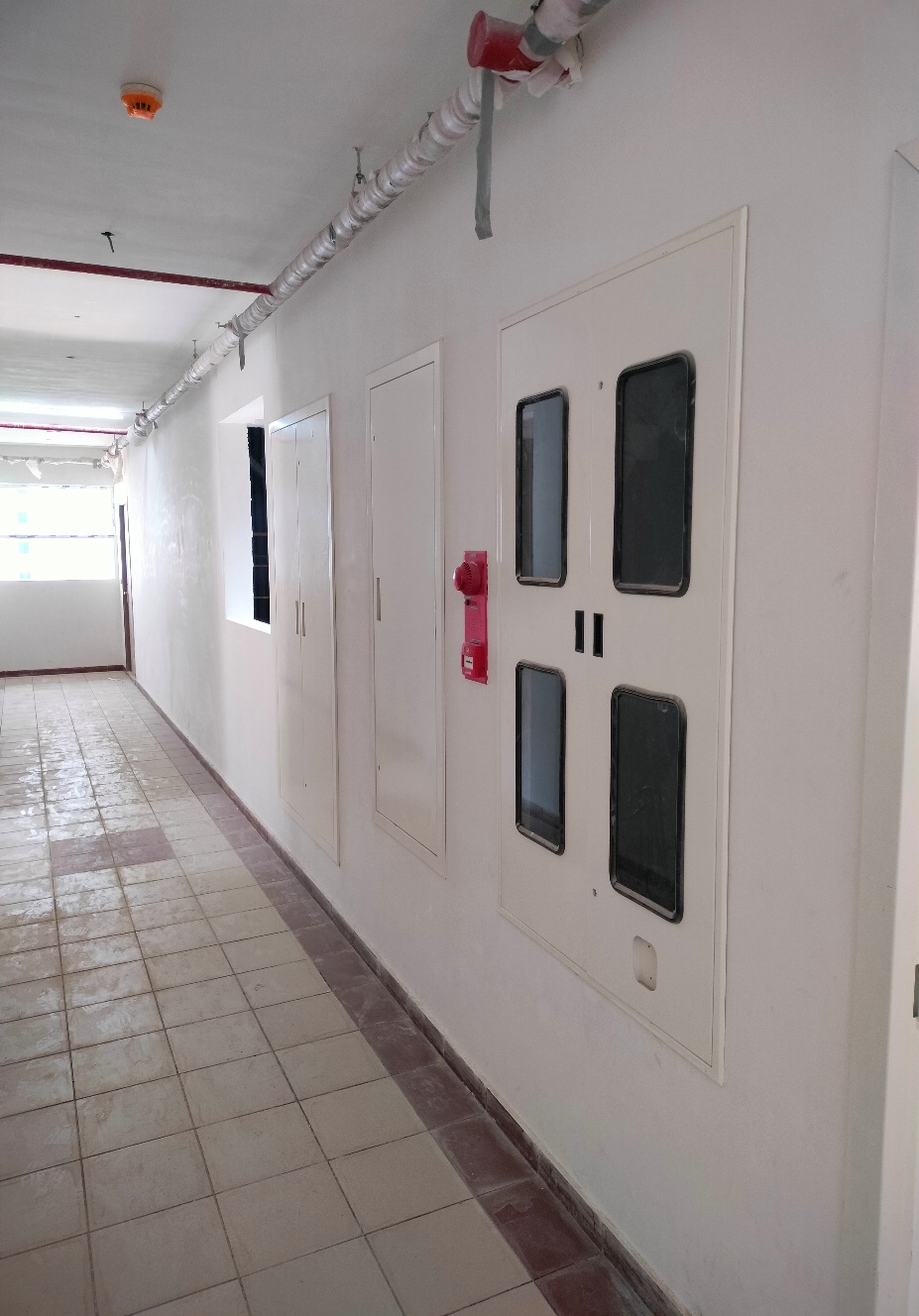

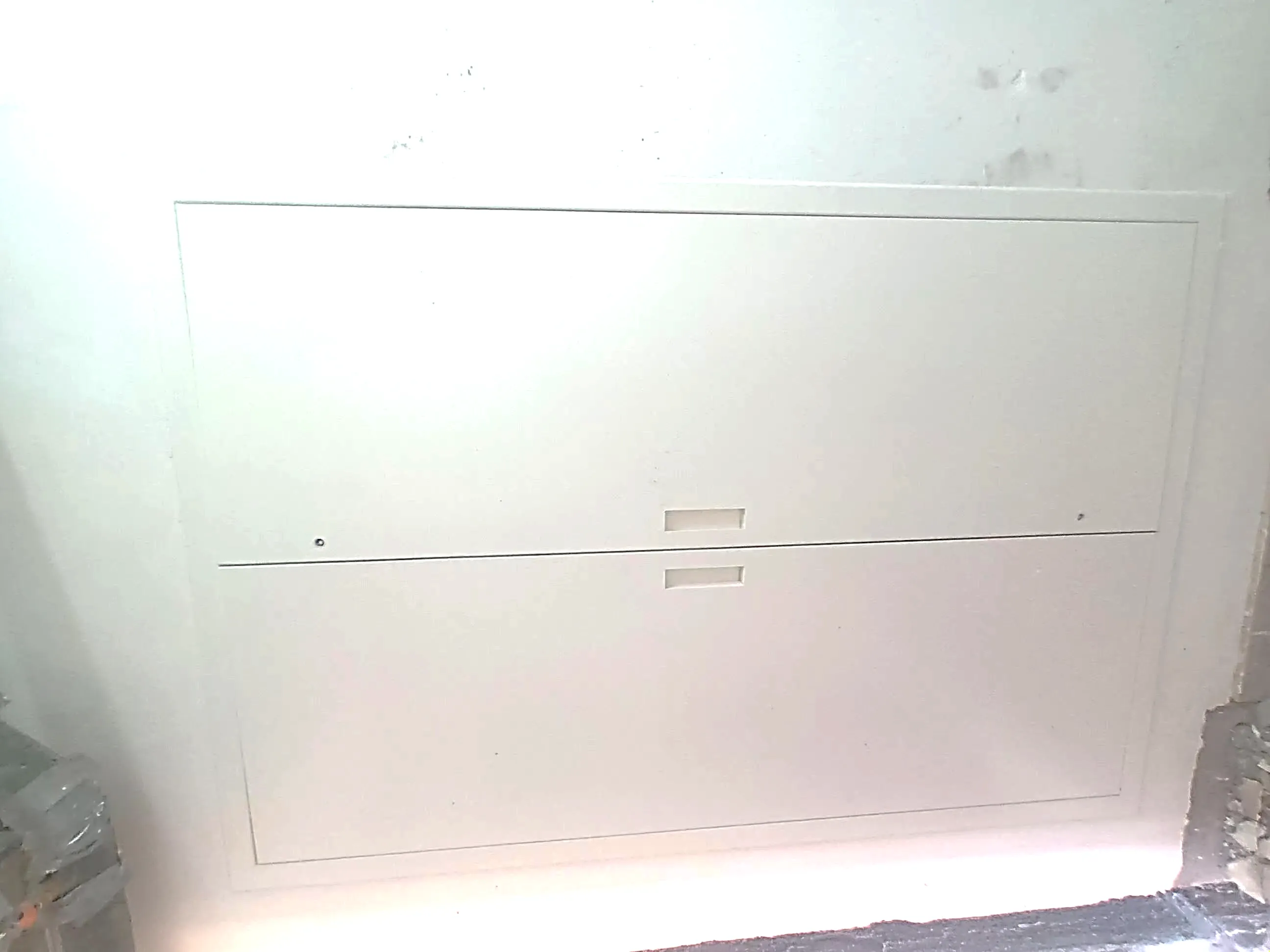

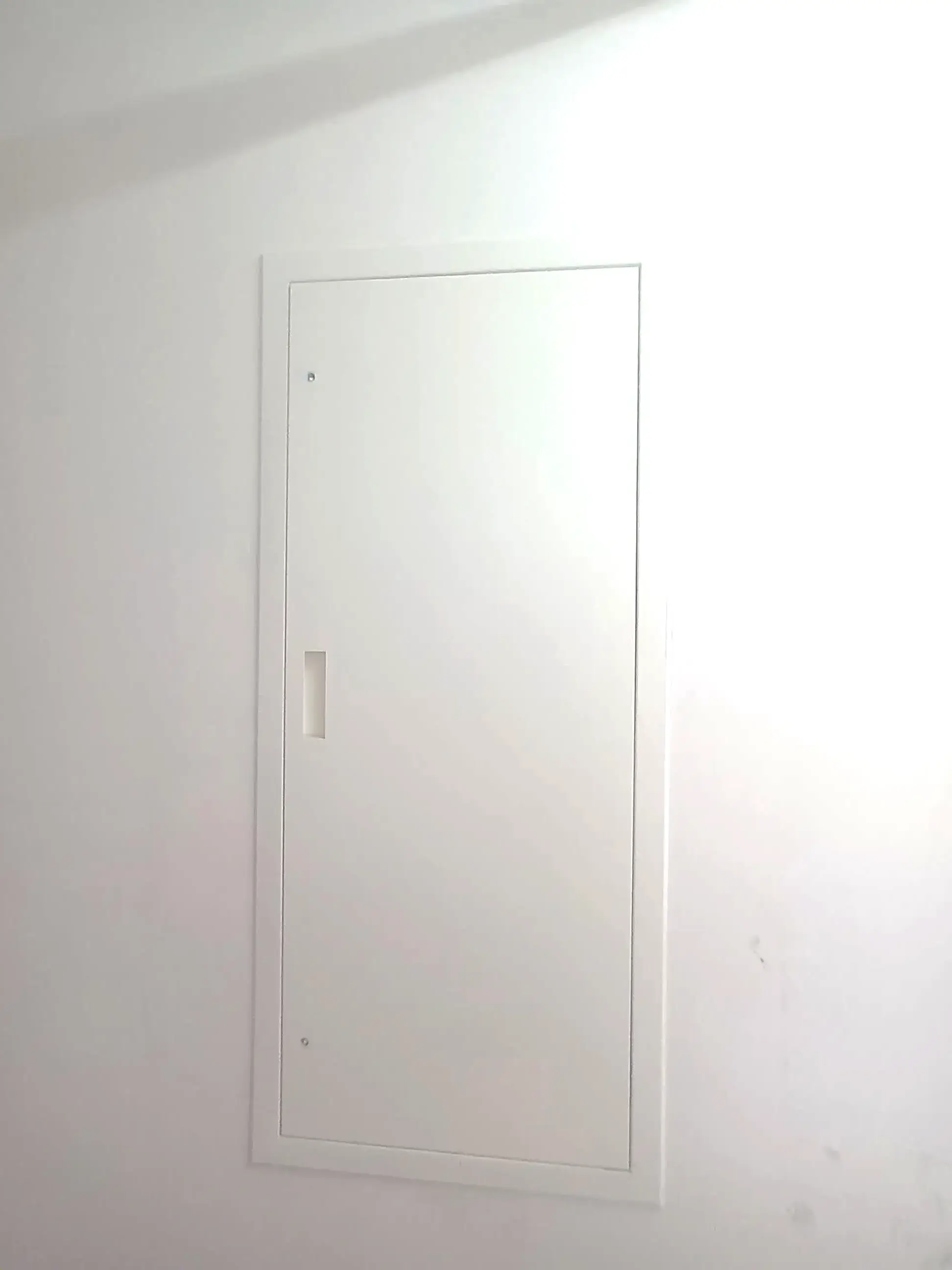

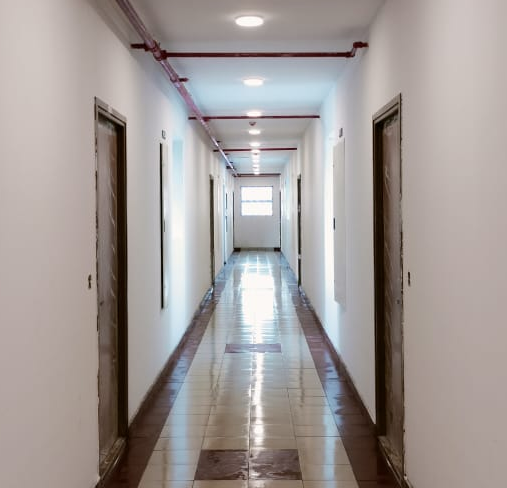

PHE shaft door fixing is completed - Jun 2025

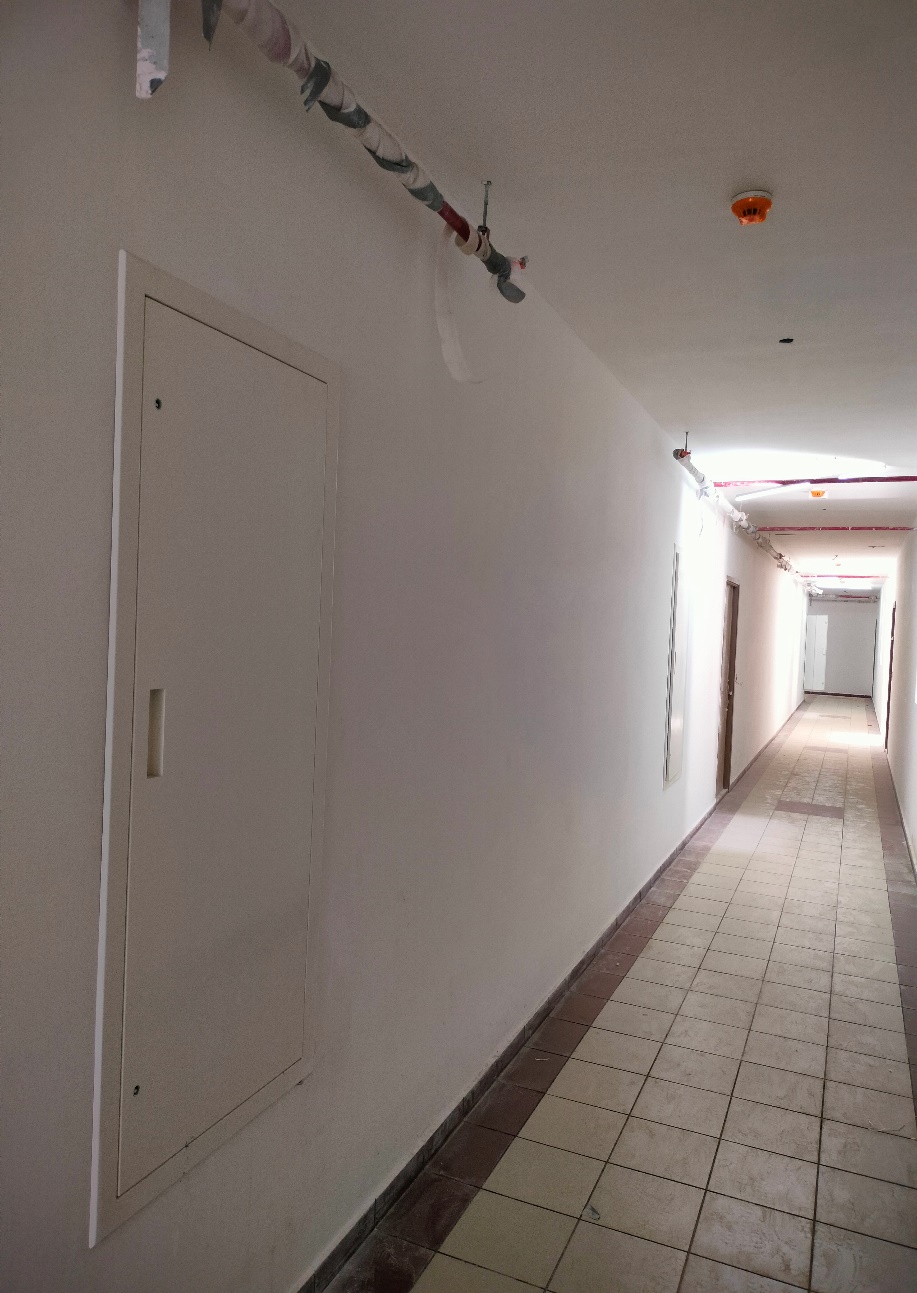

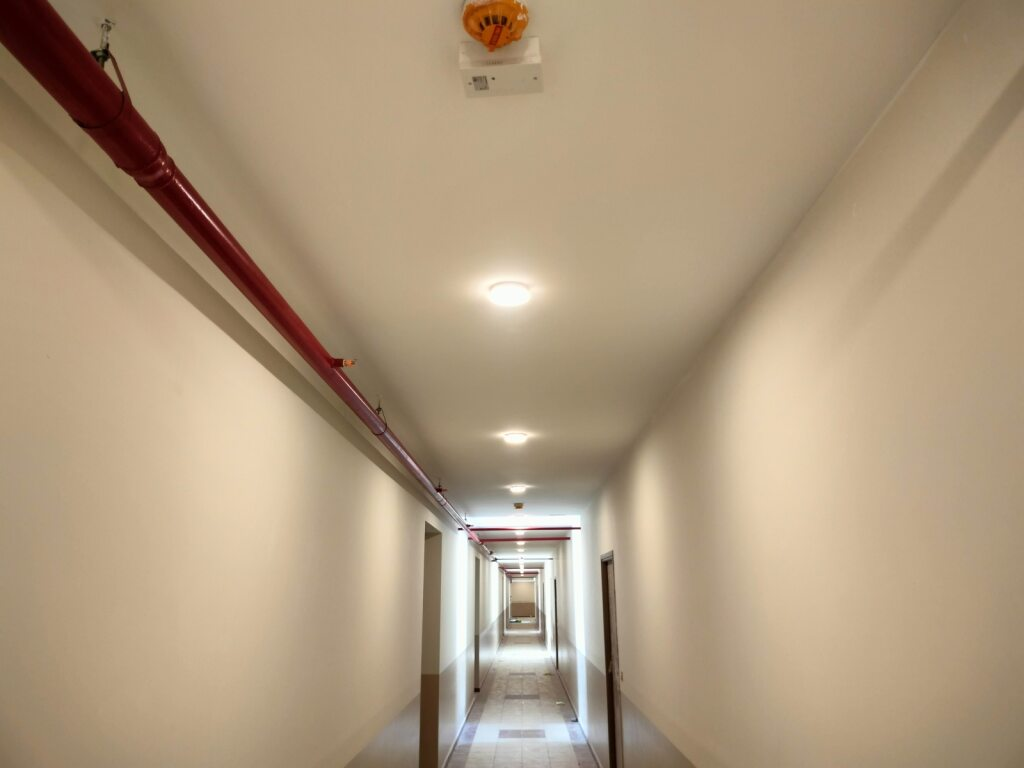

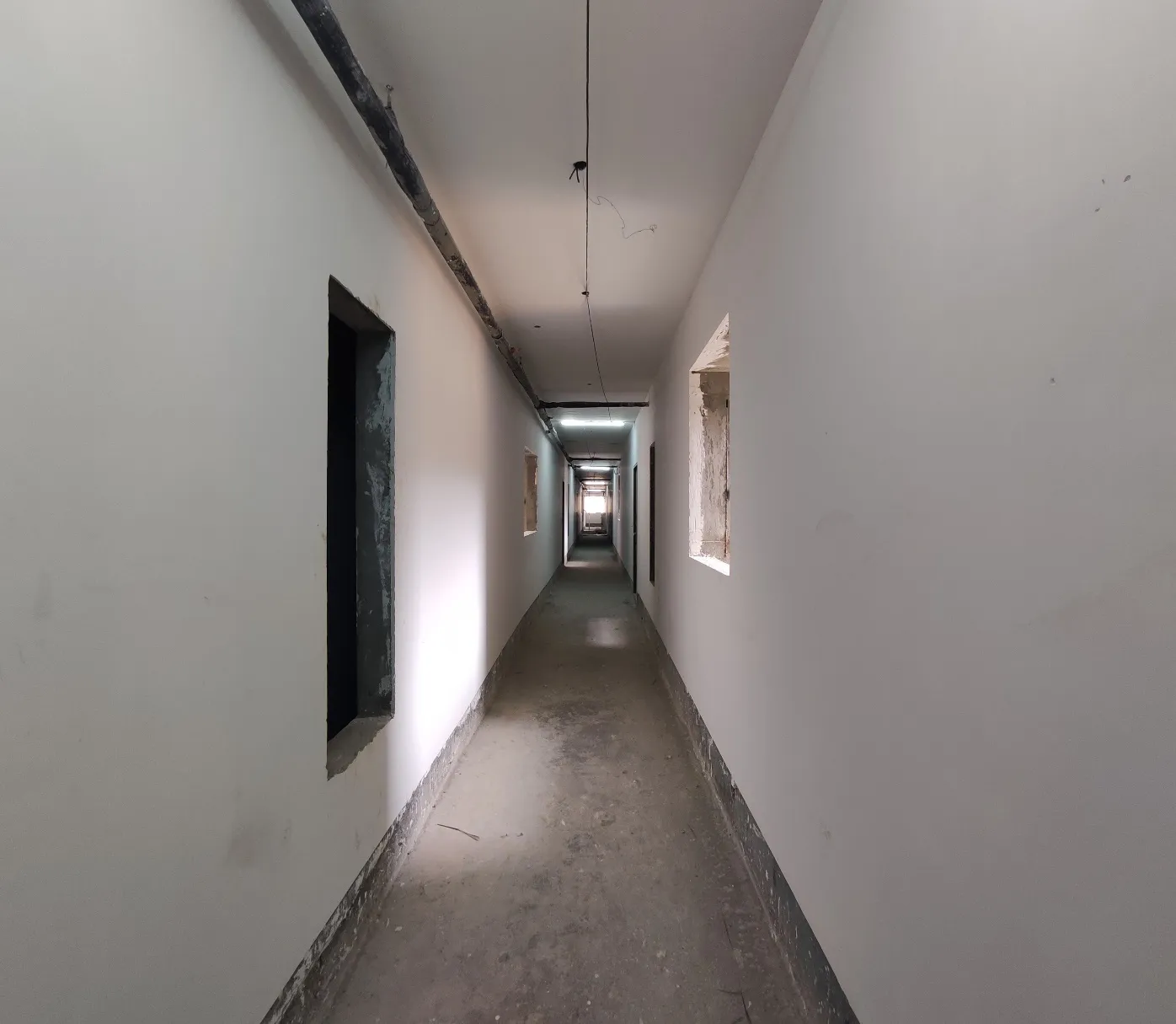

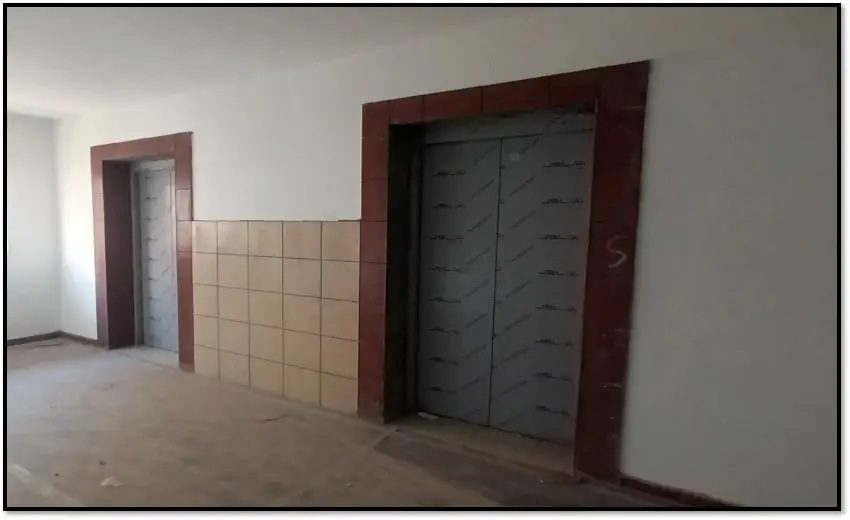

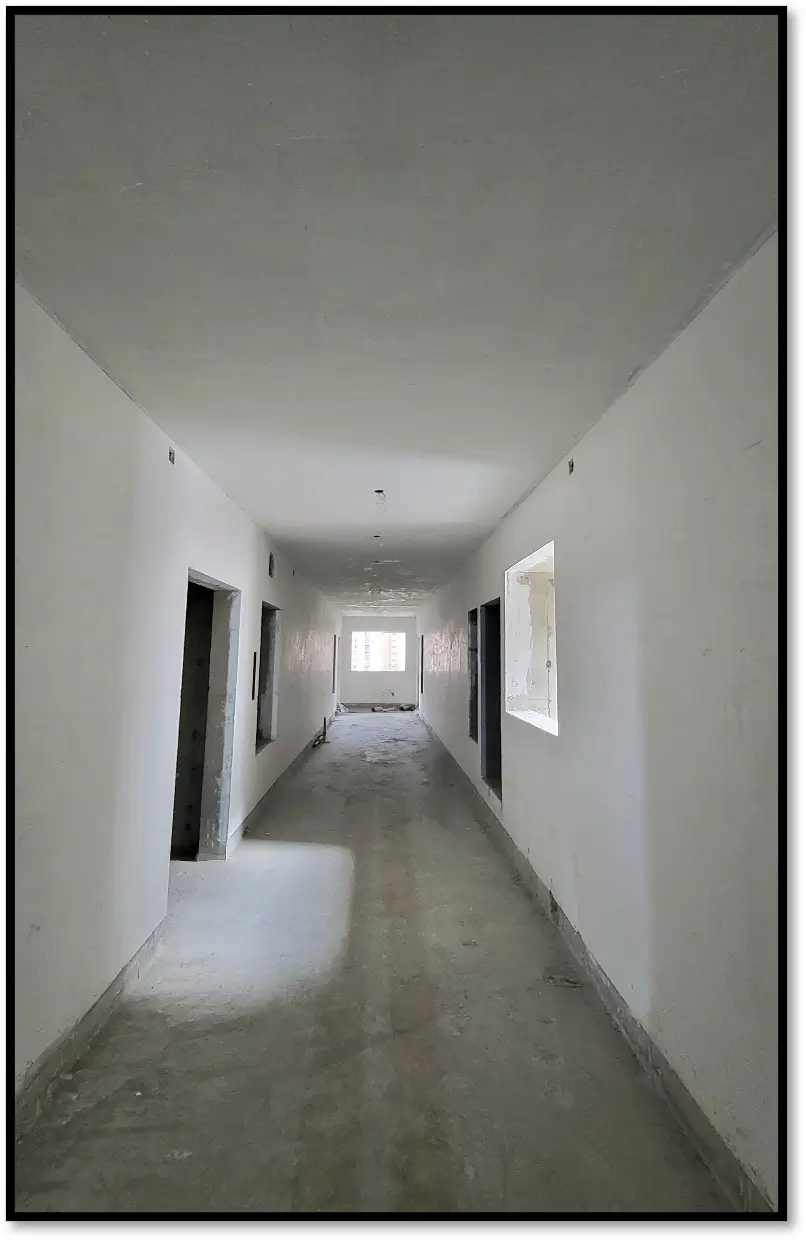

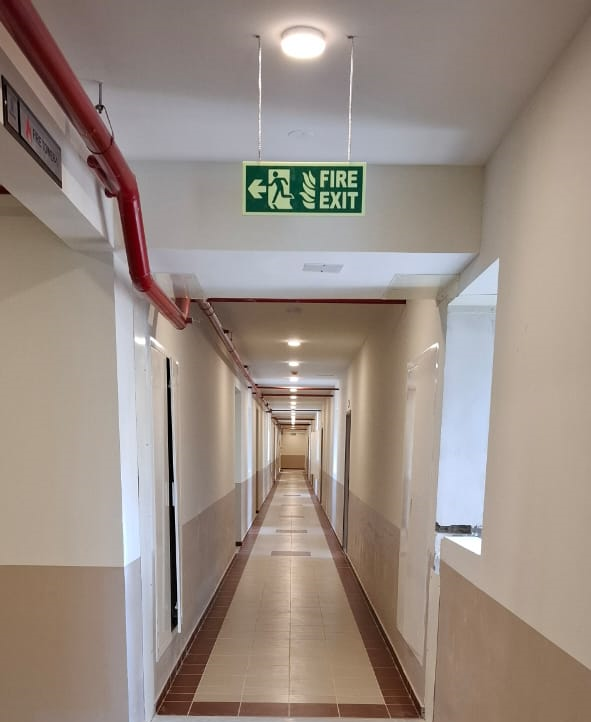

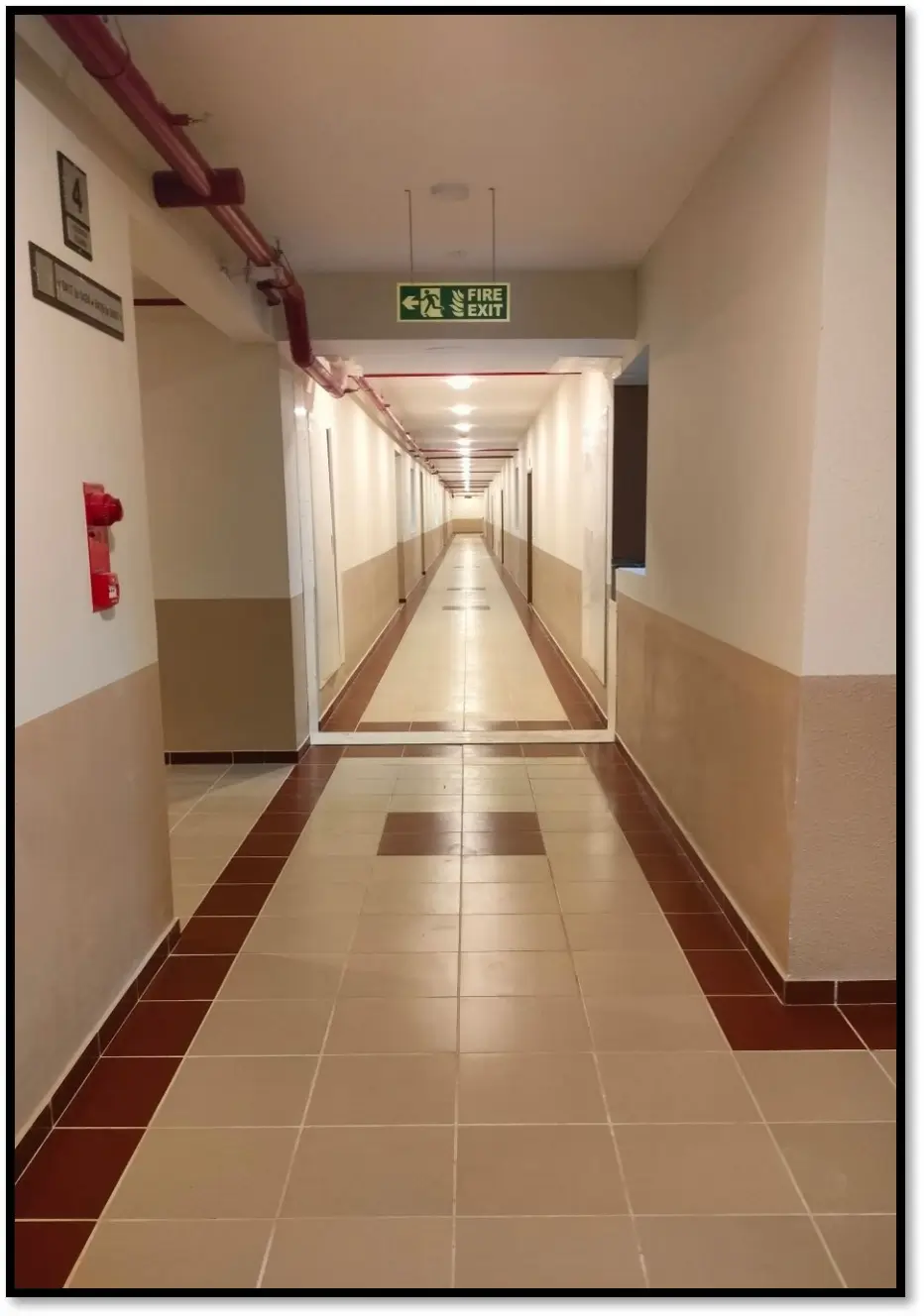

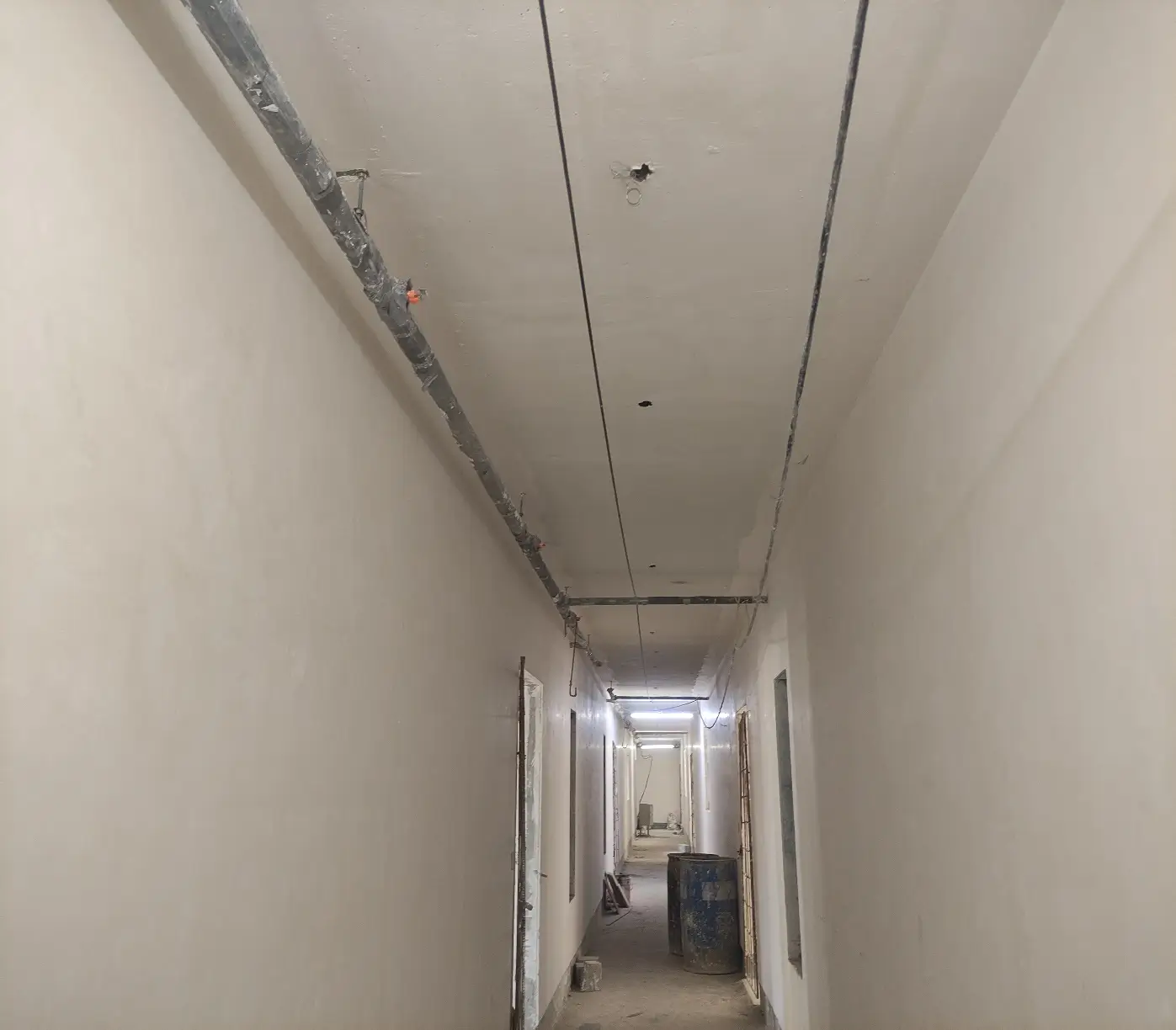

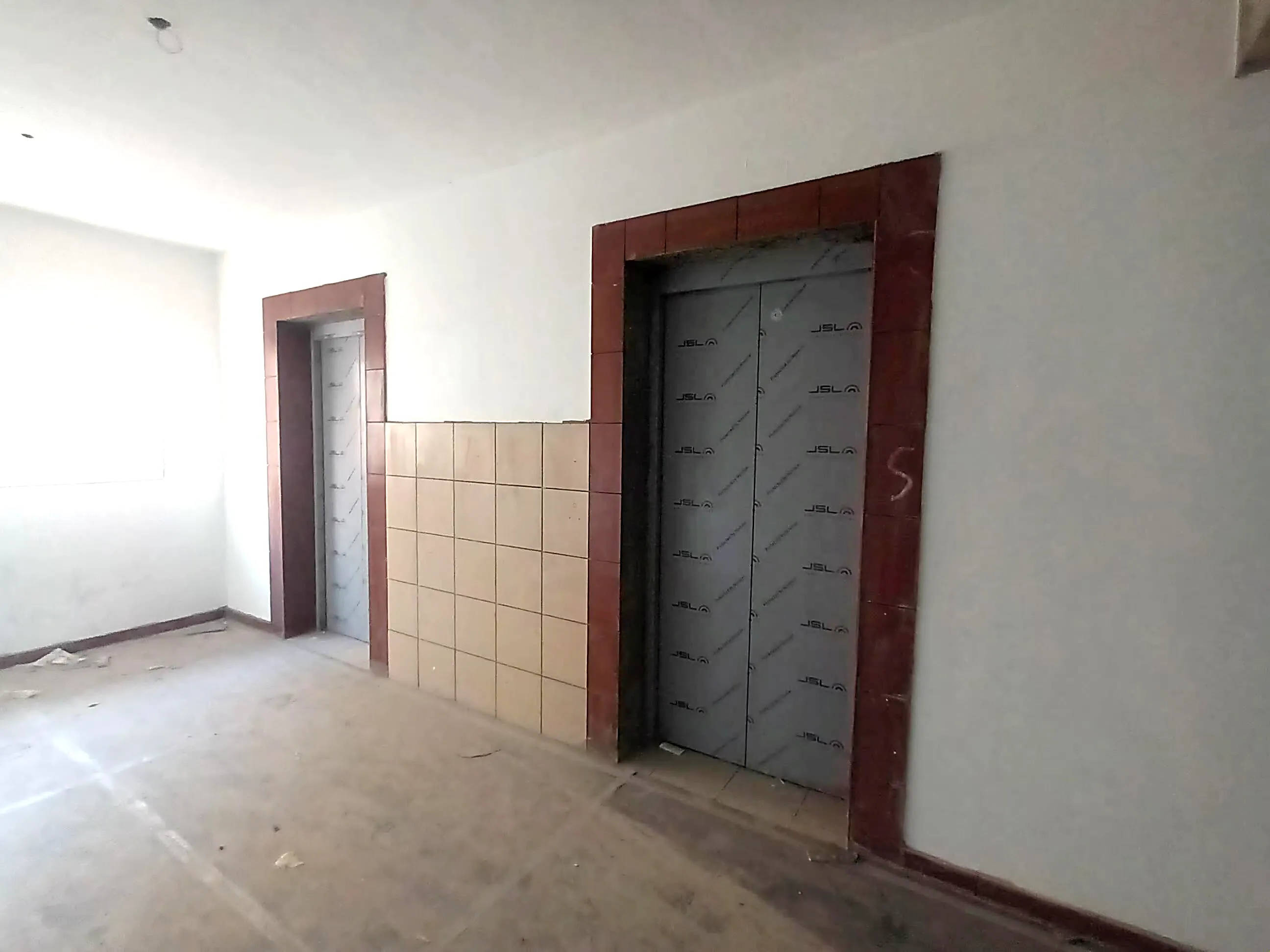

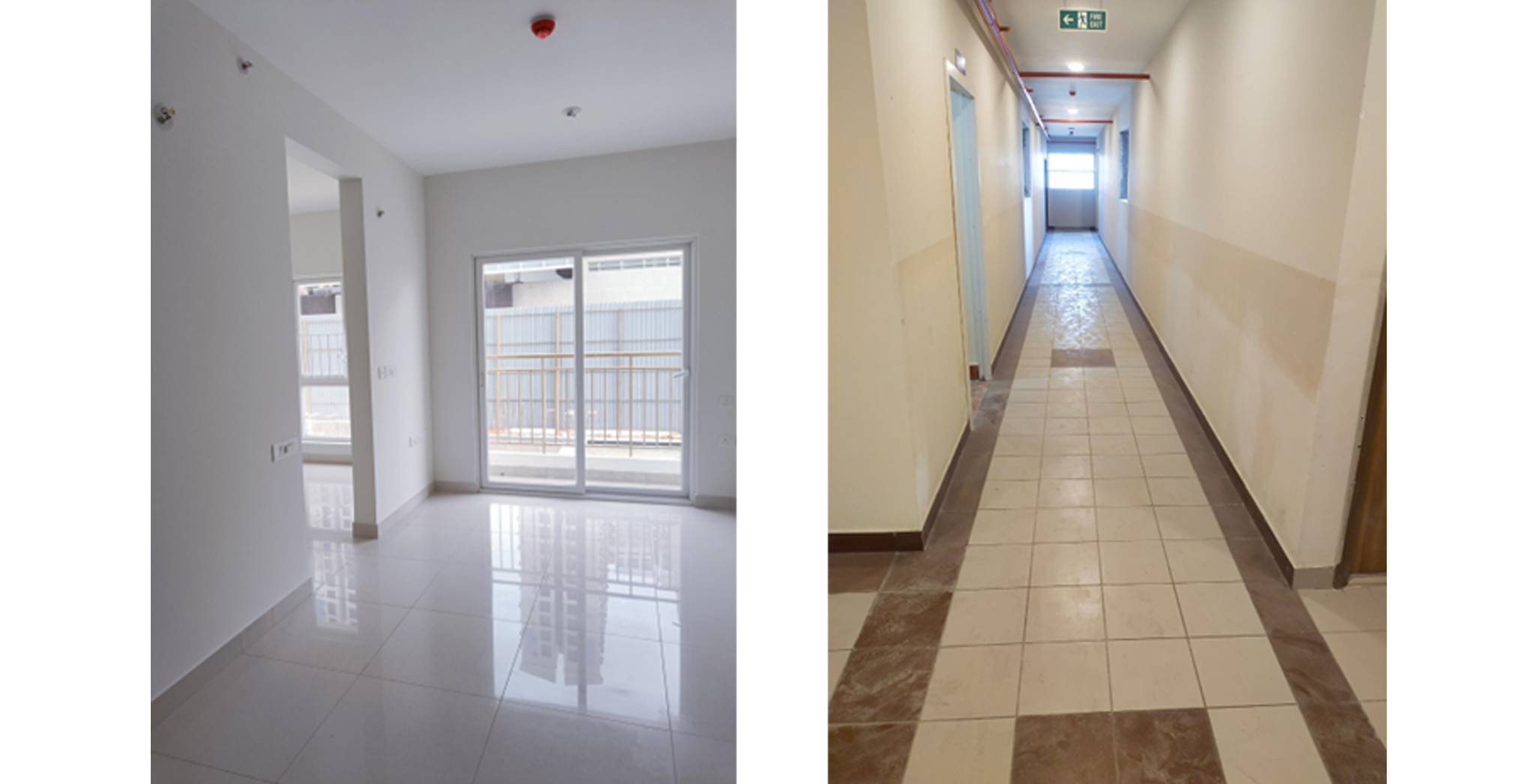

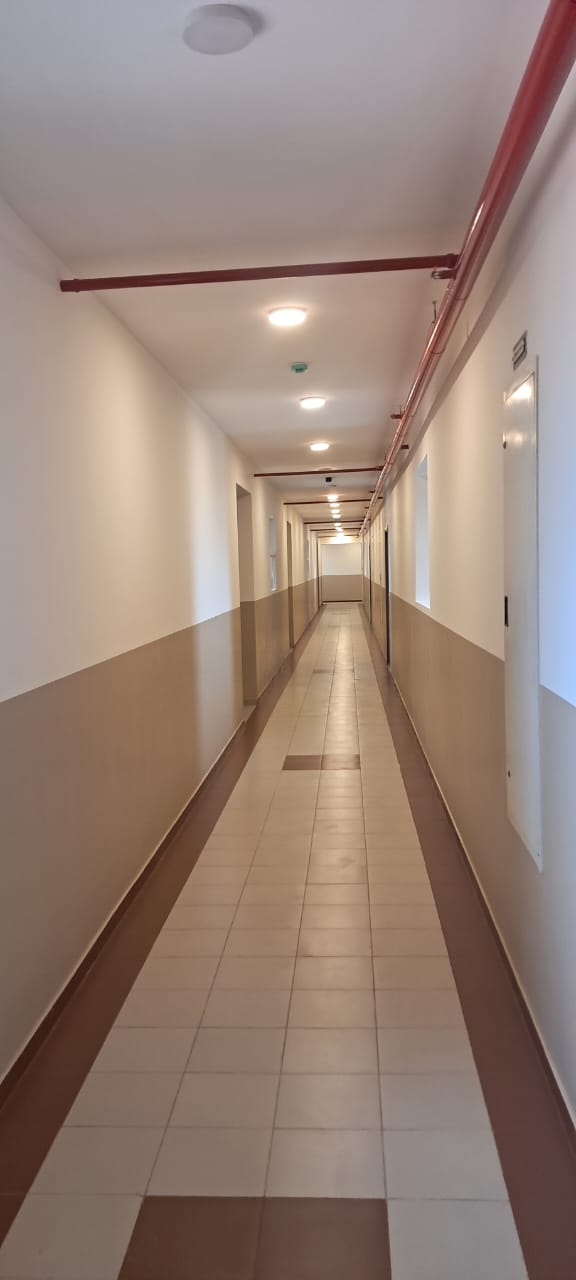

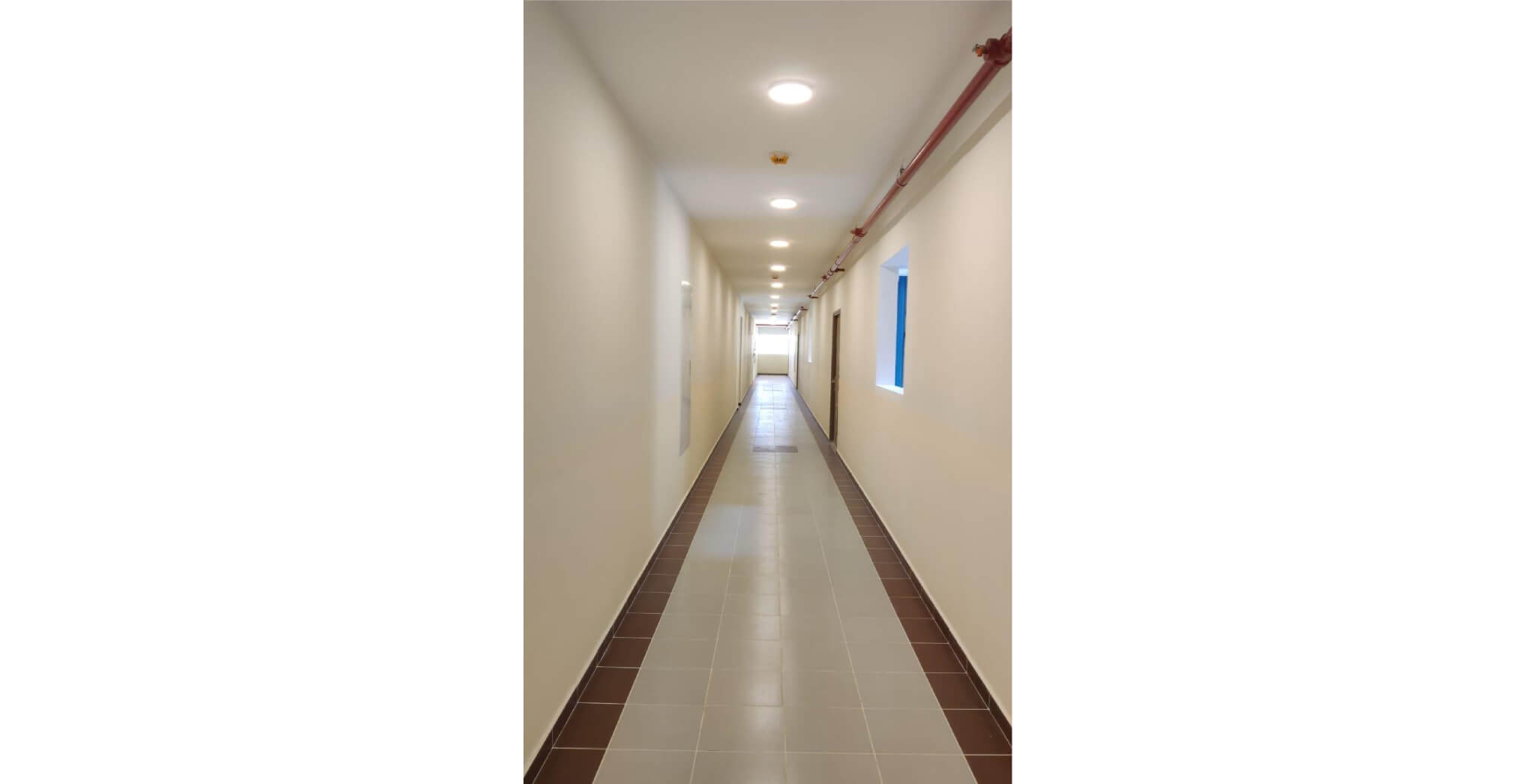

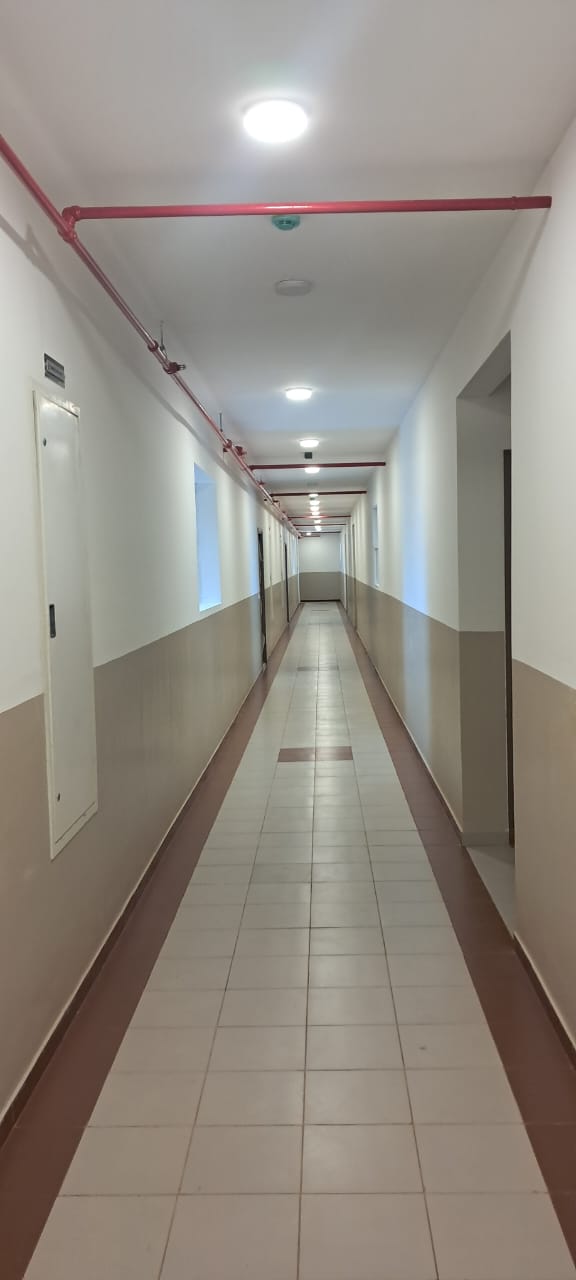

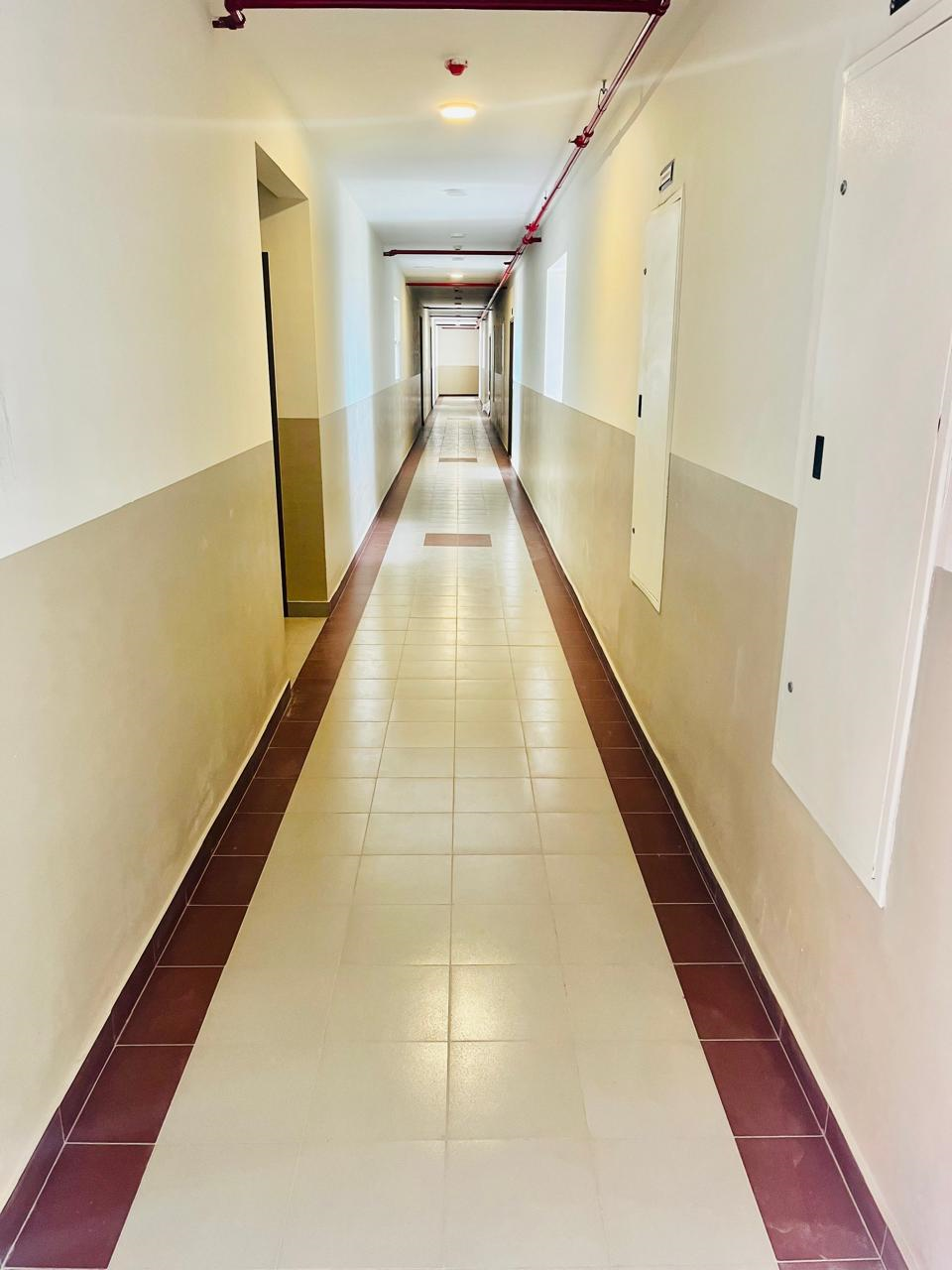

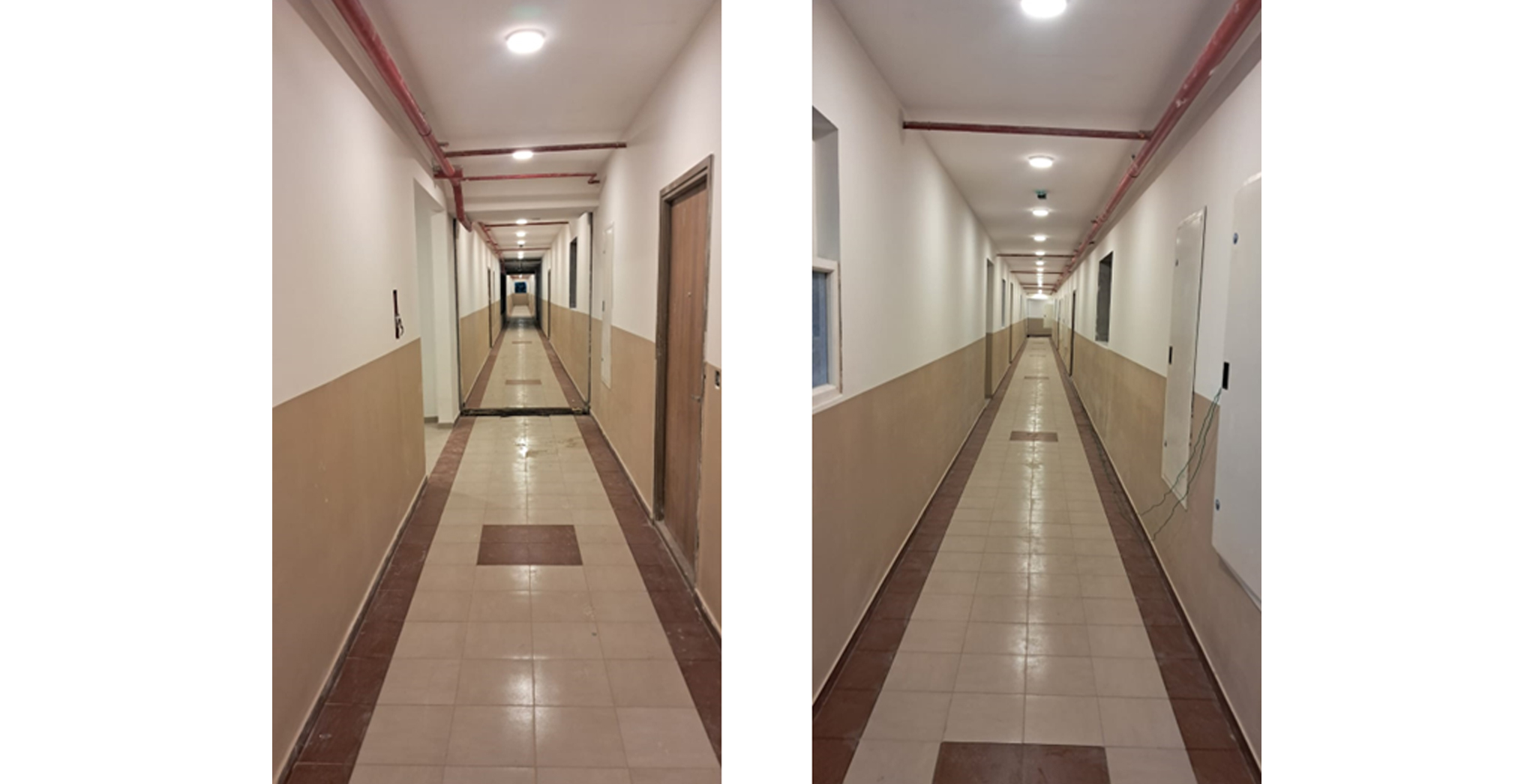

Corridor light fixing and Painting WIP - Jun 2025

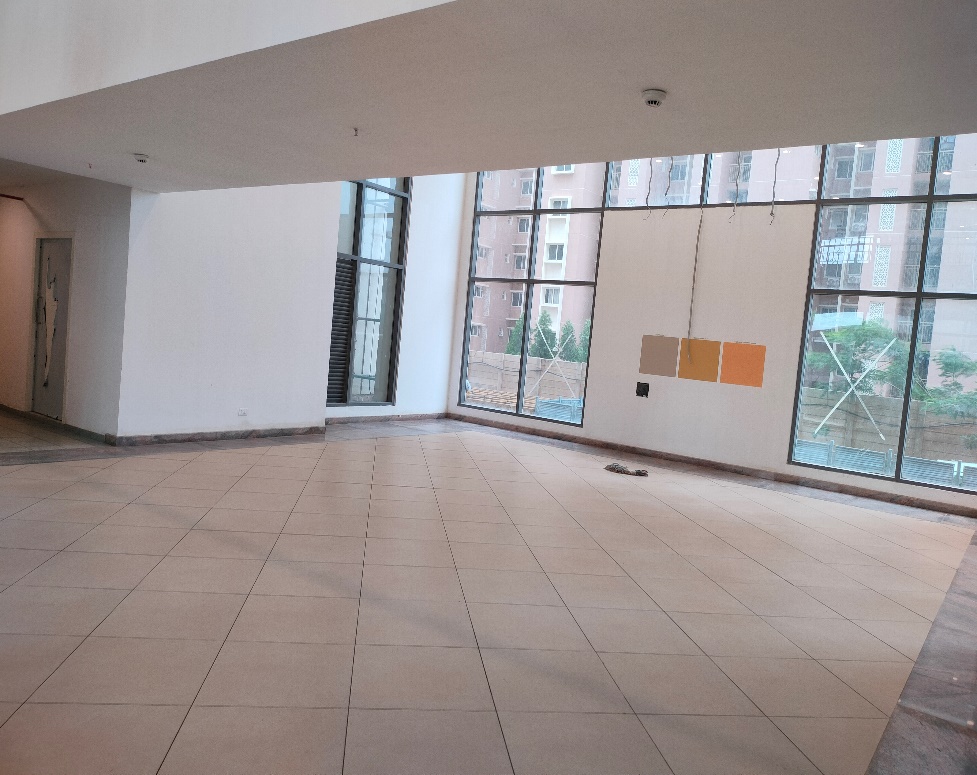

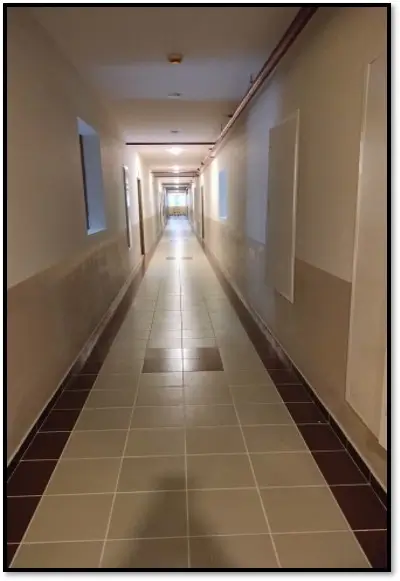

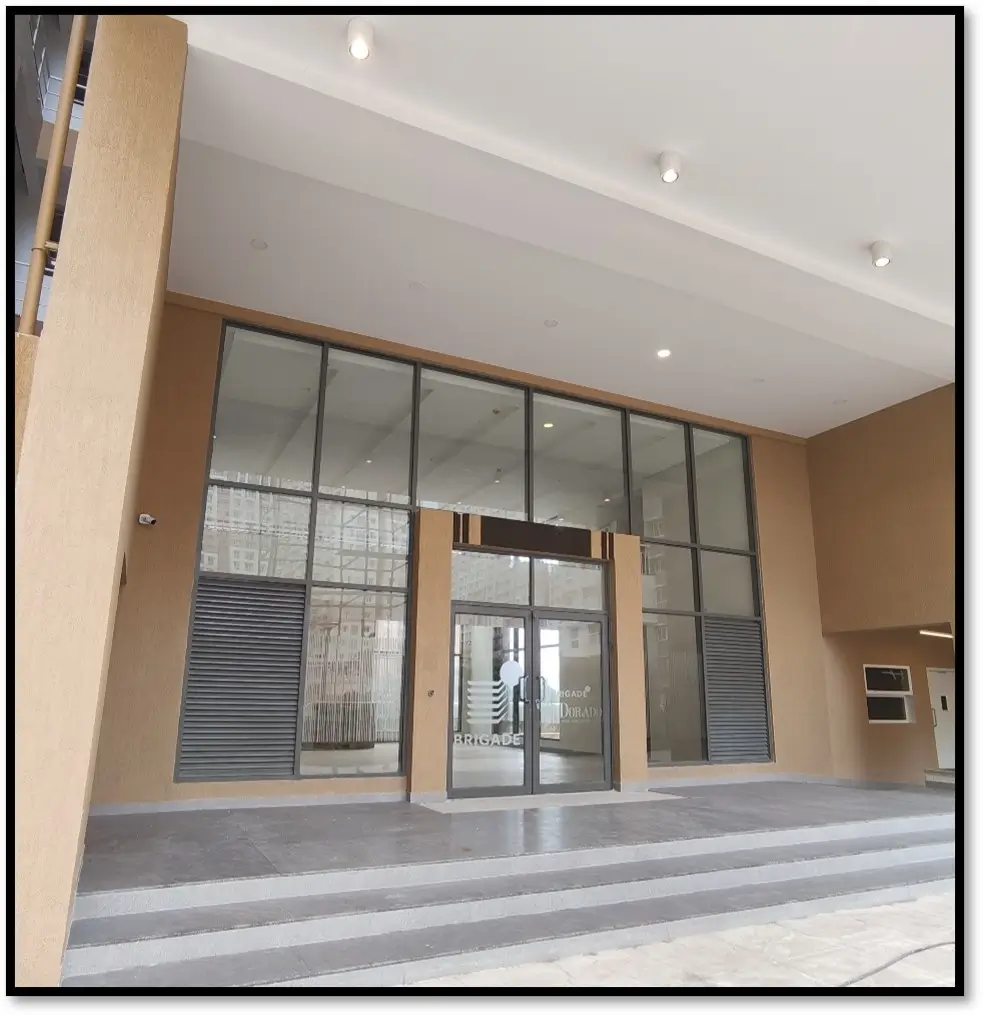

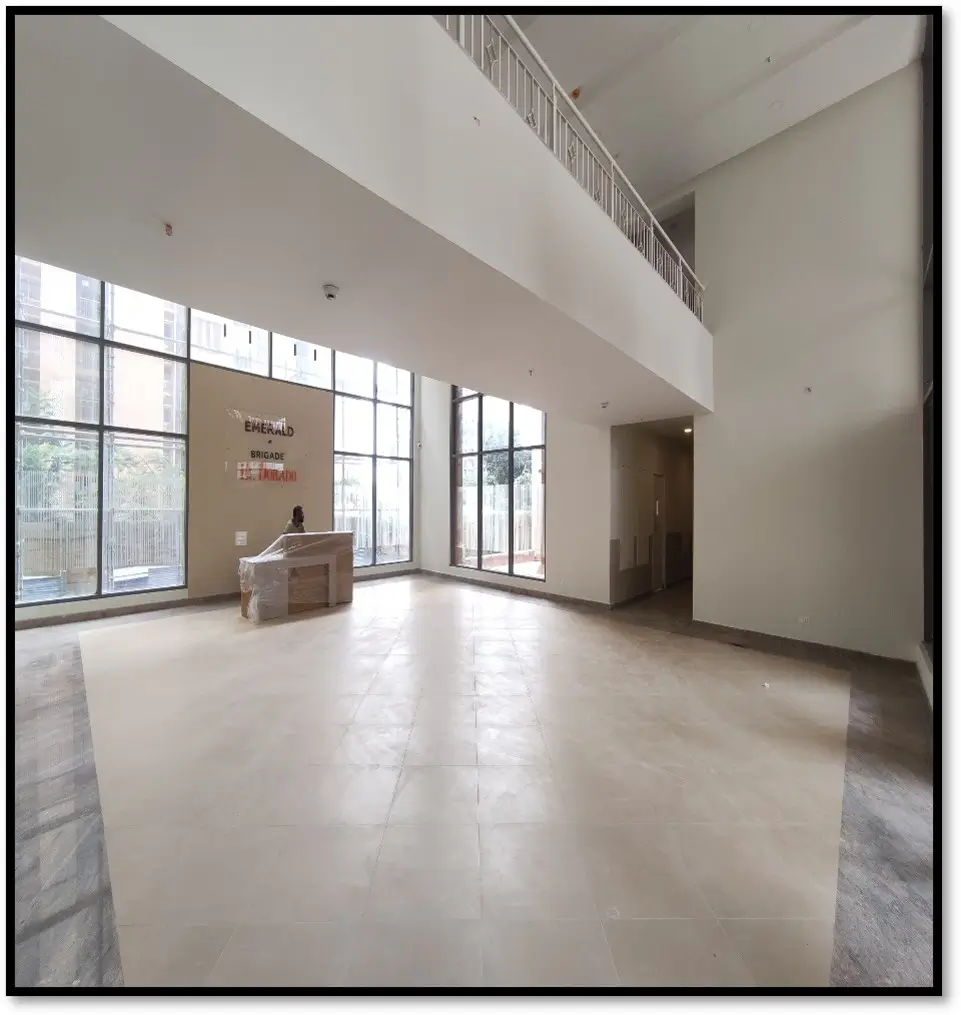

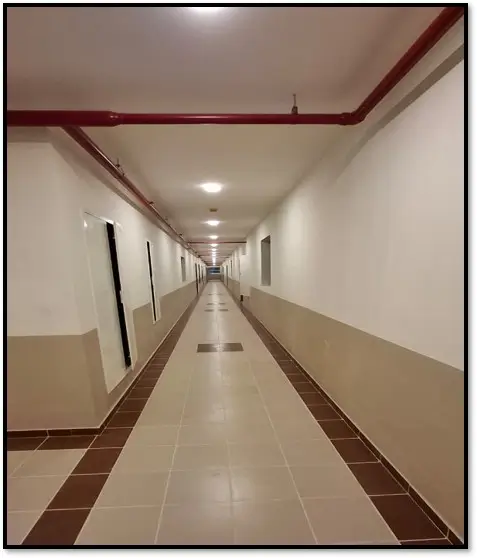

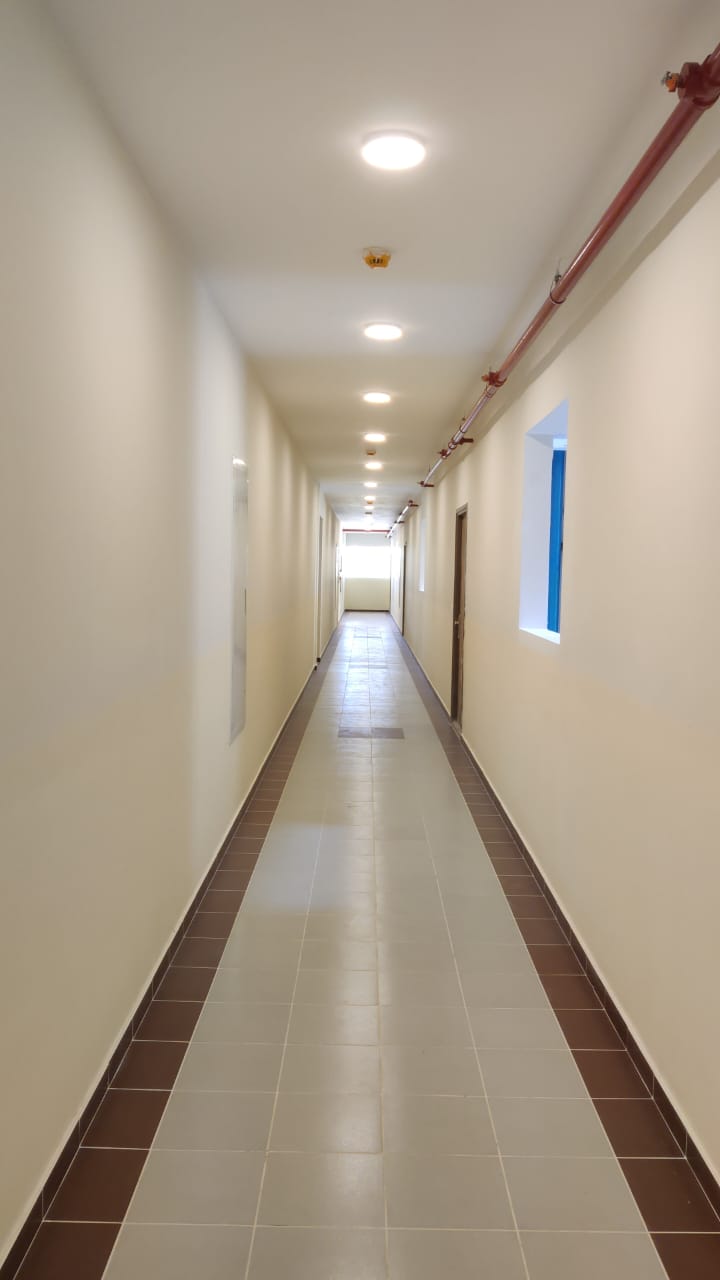

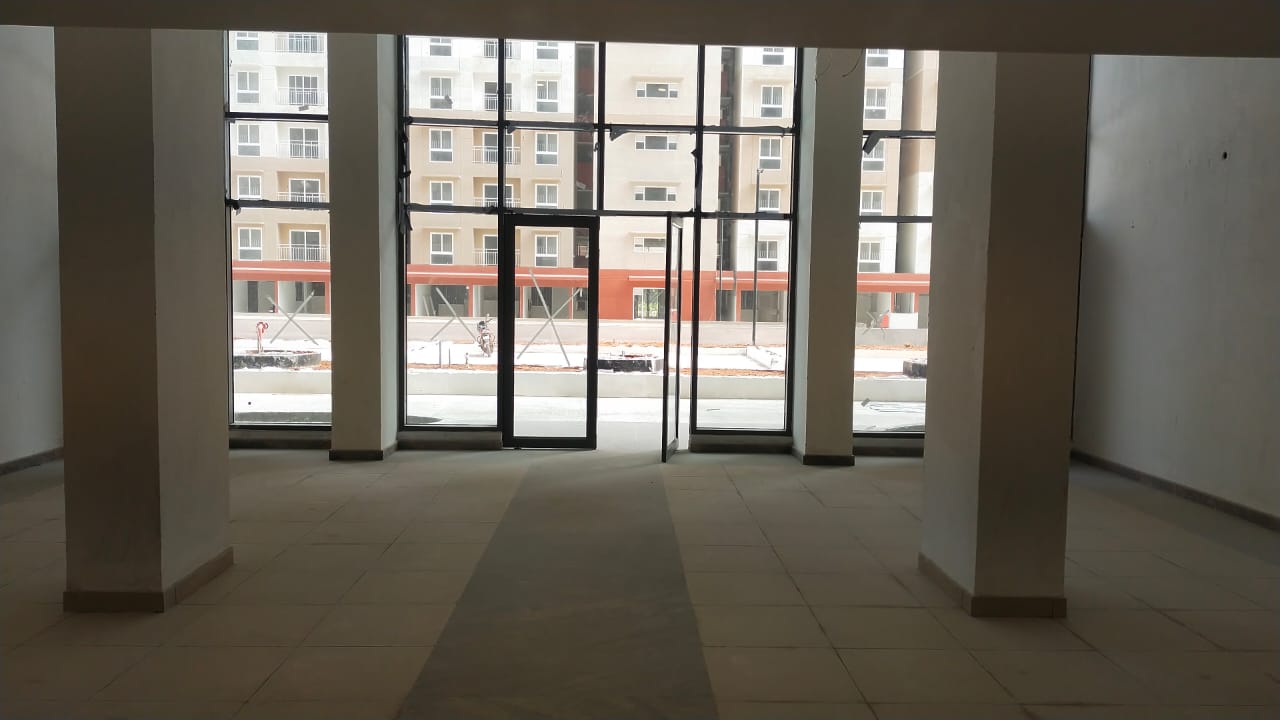

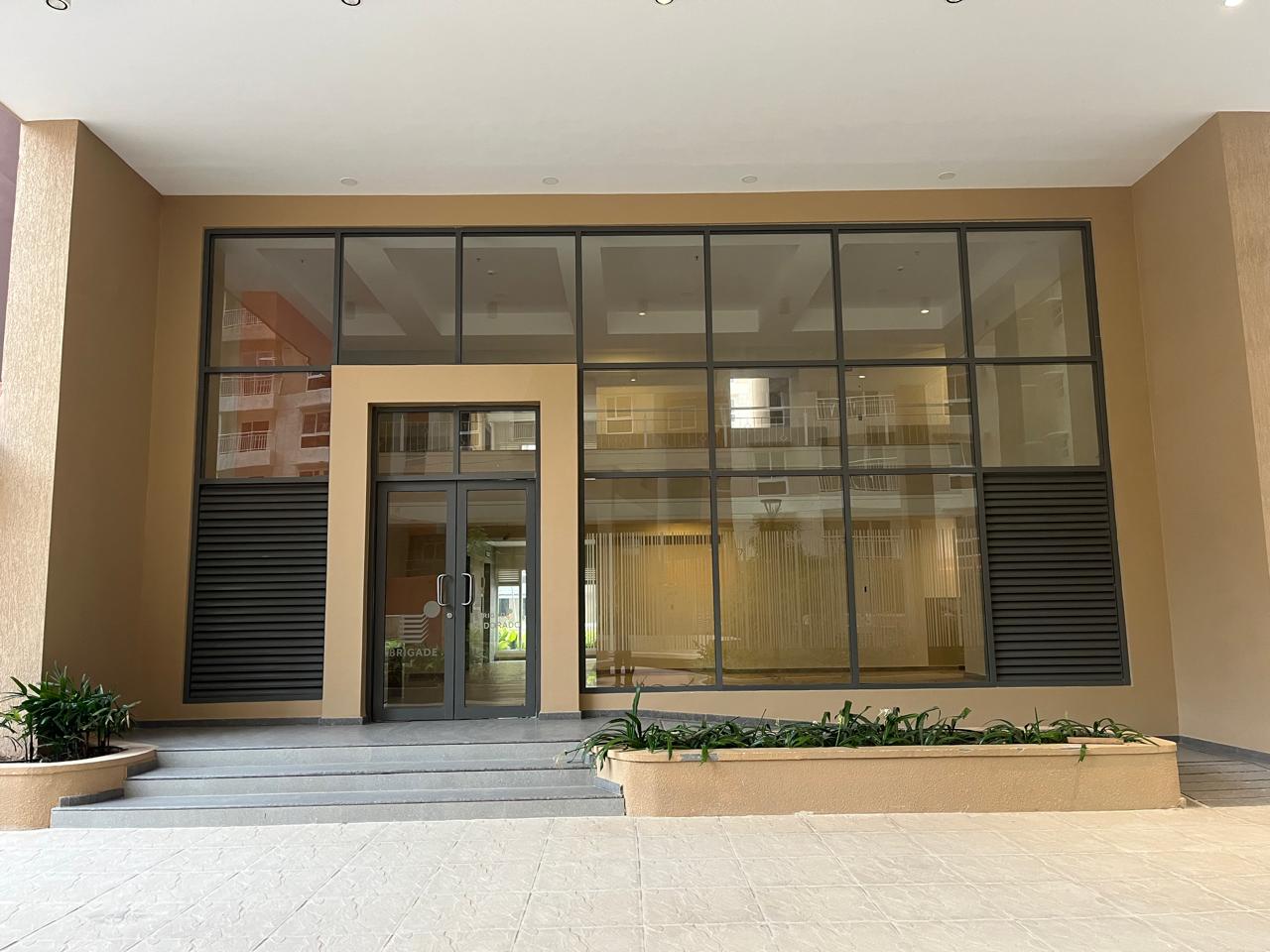

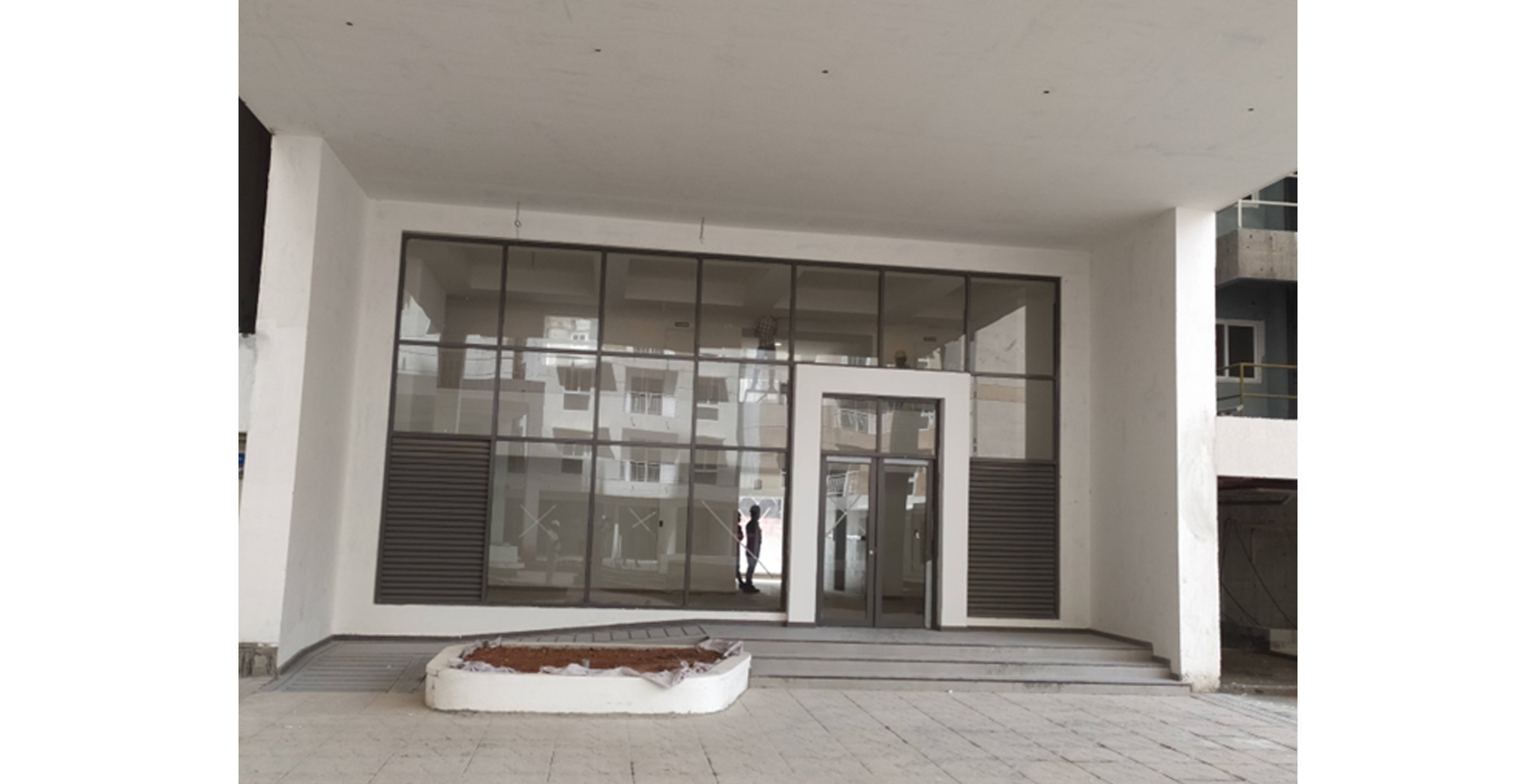

Ground floor triple height lobby finishing WIP - Jun 2025

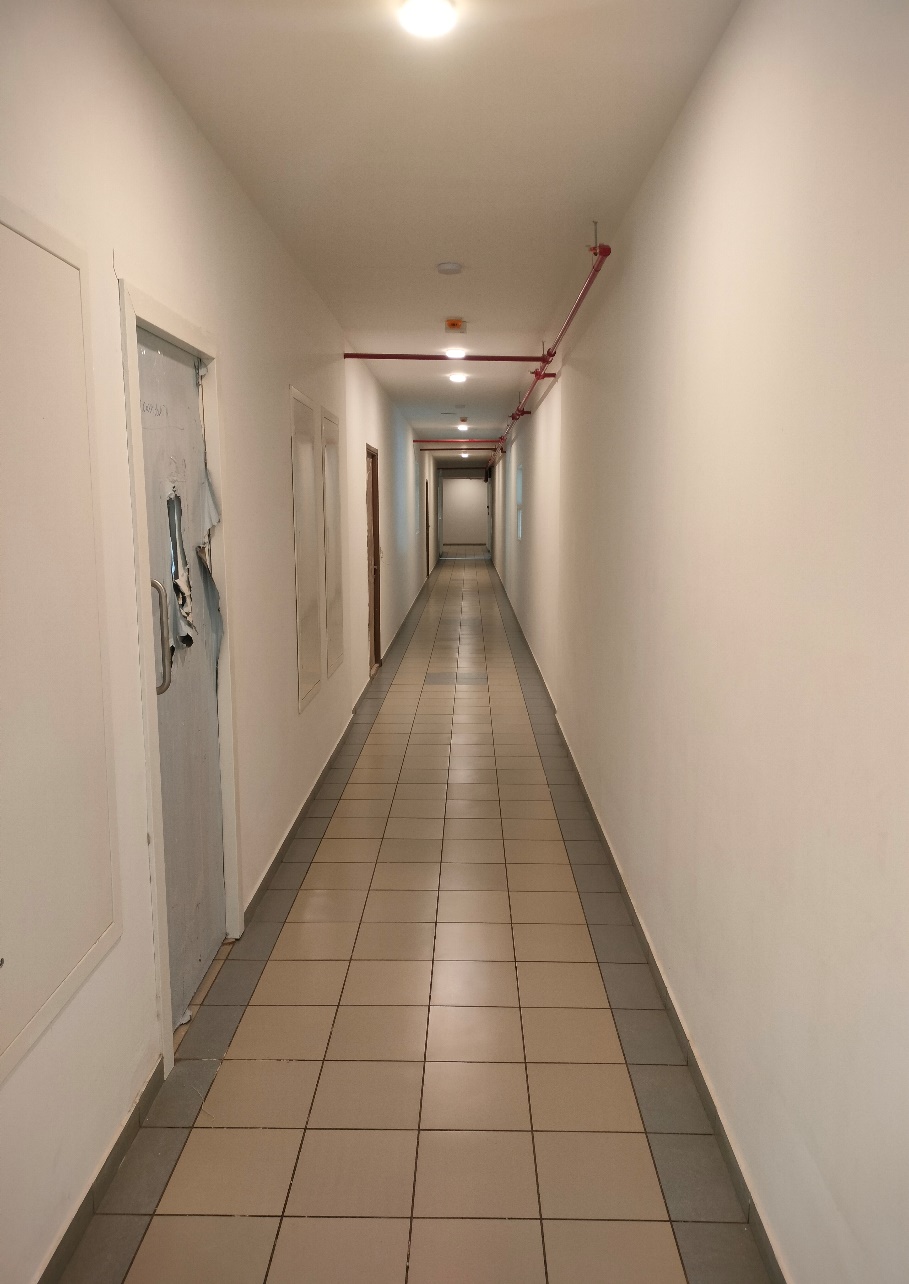

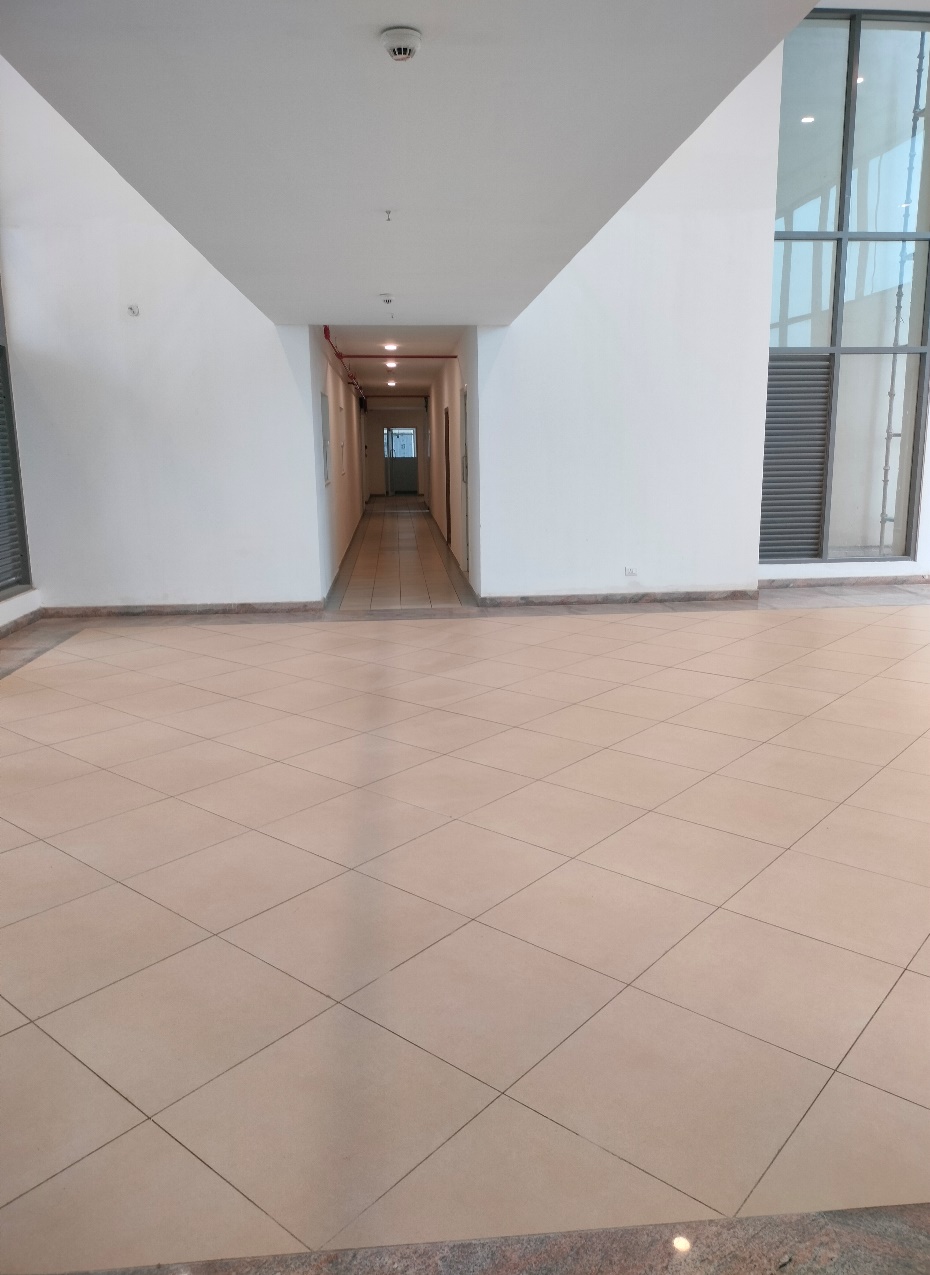

Ground floor corridor Painting WIP - Jun 2025

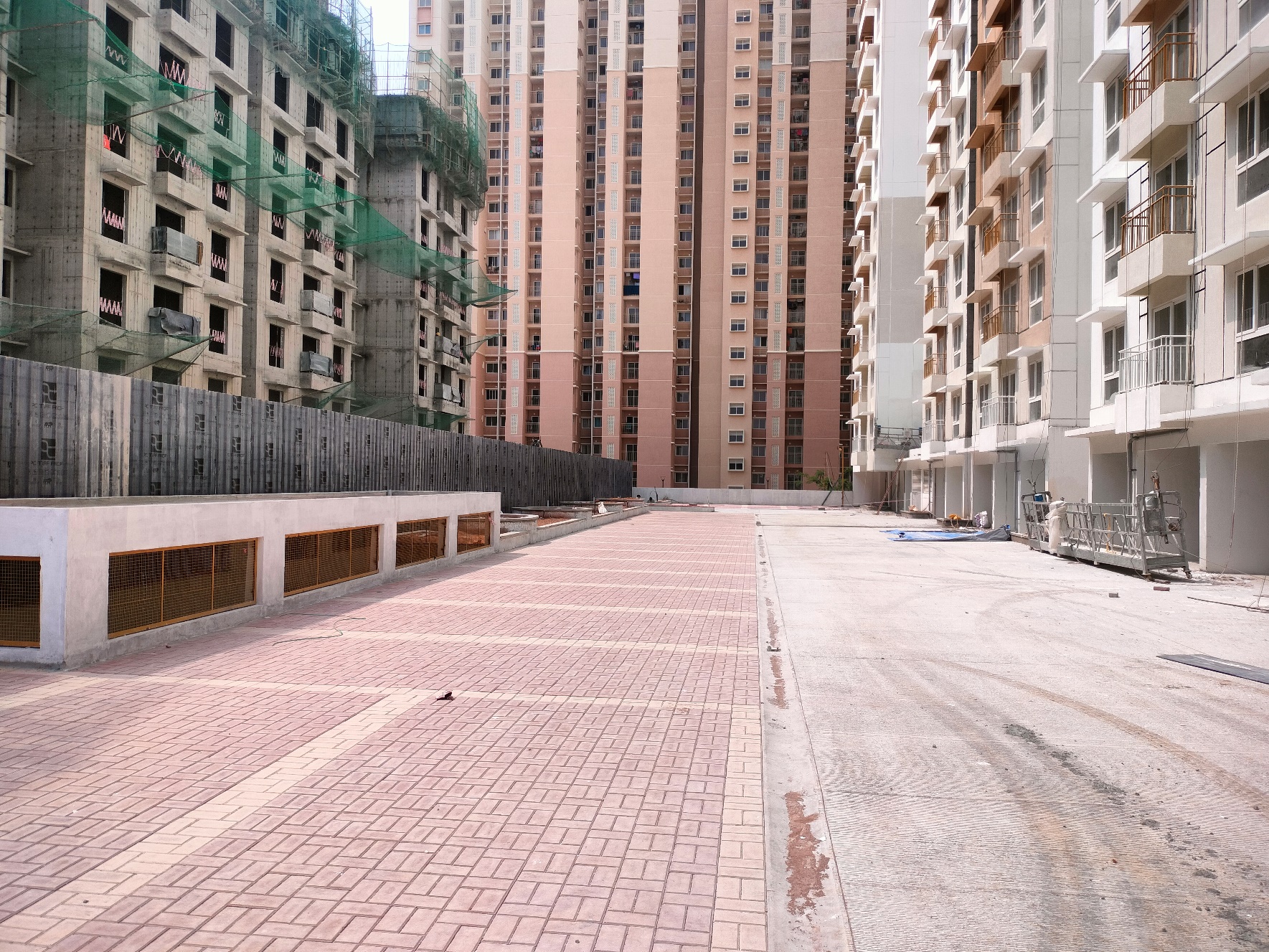

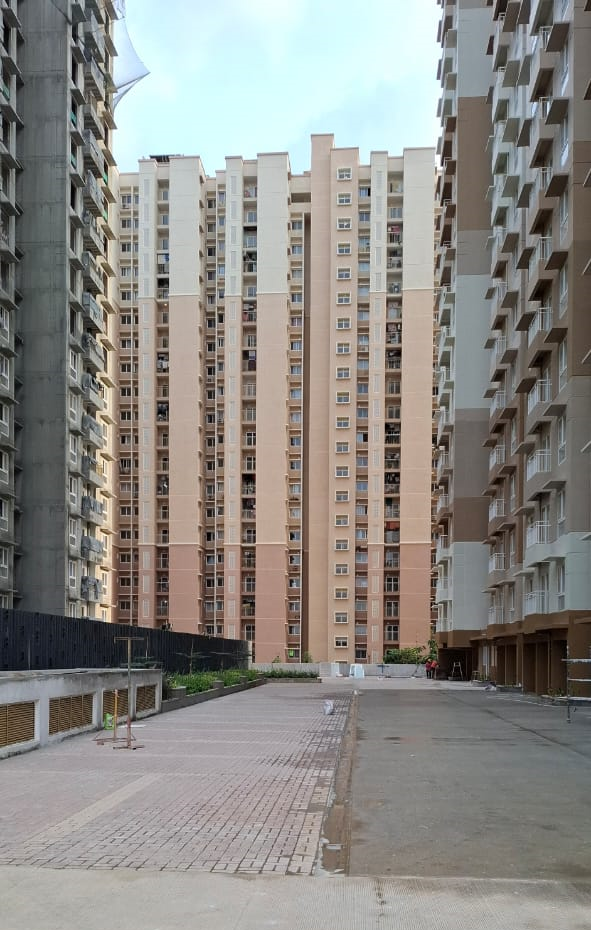

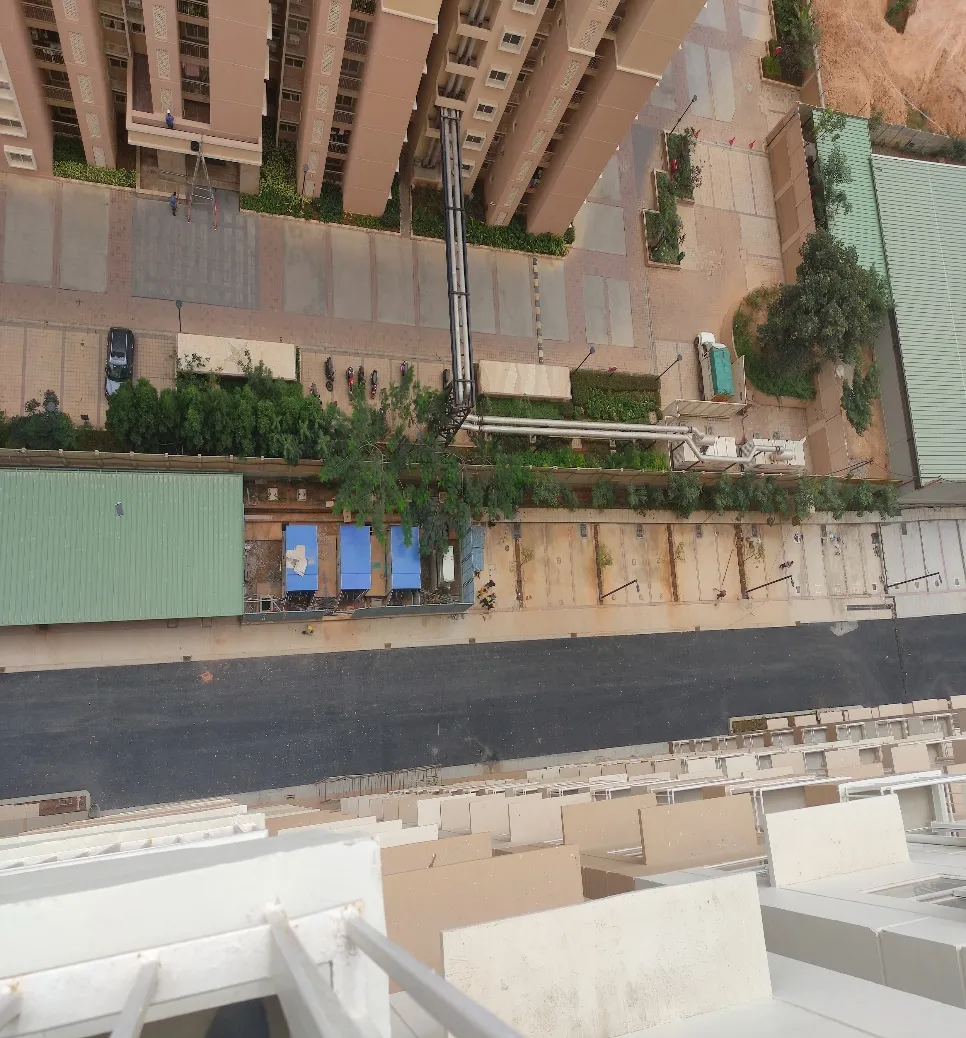

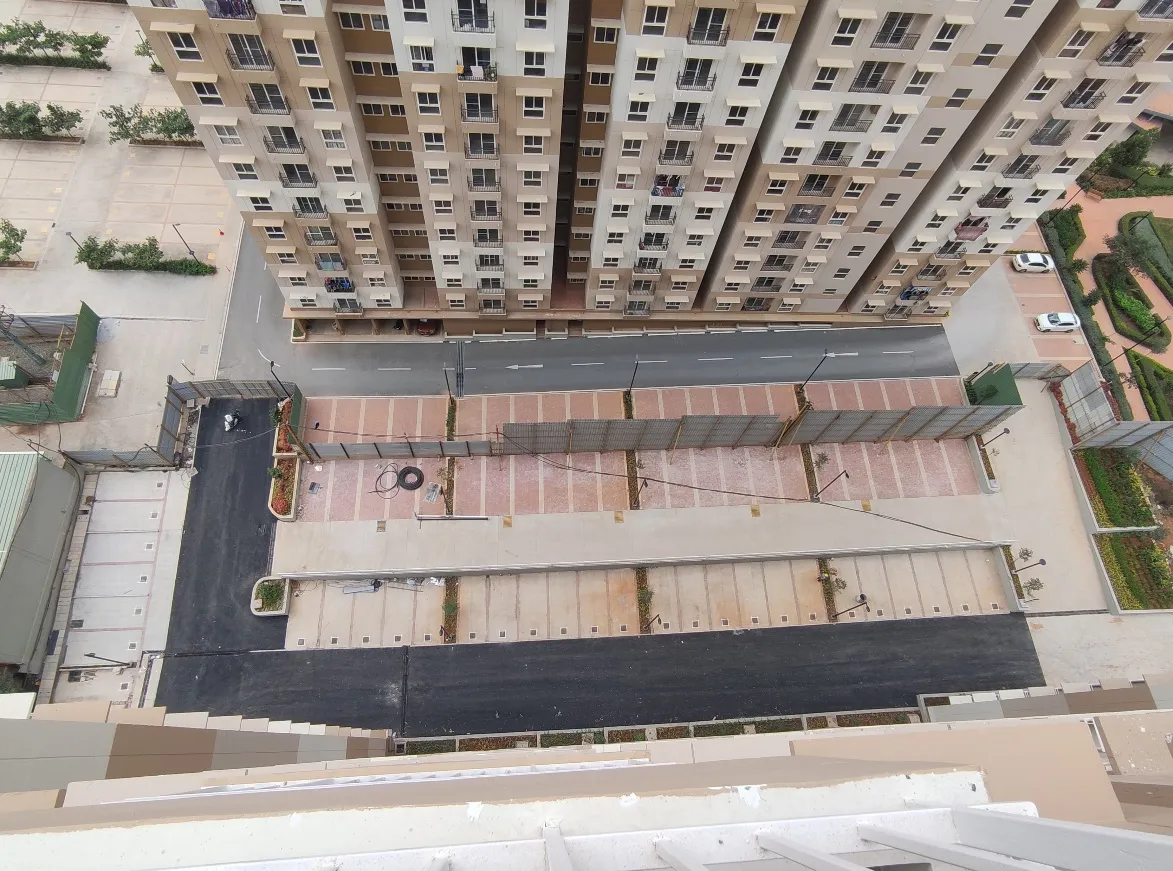

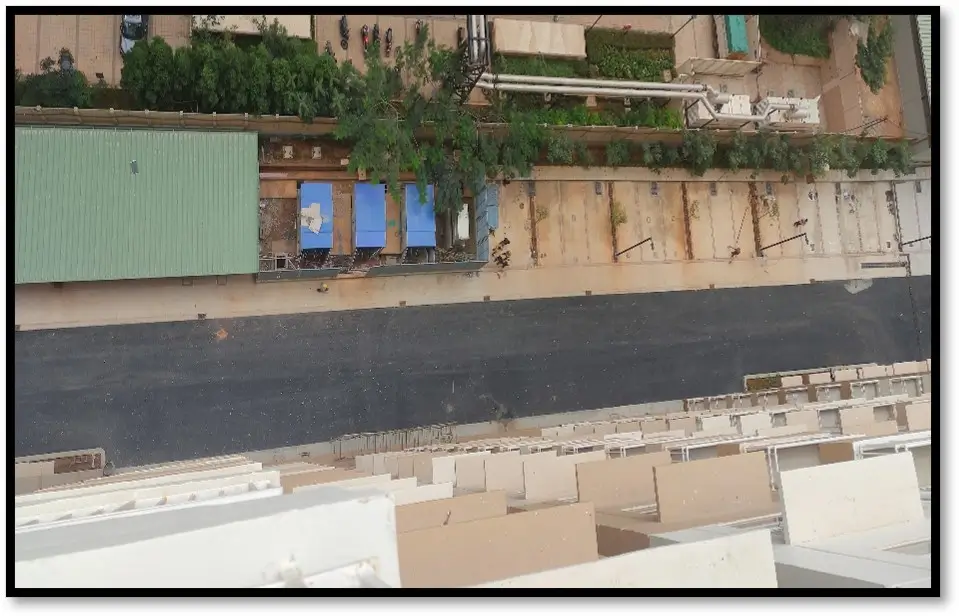

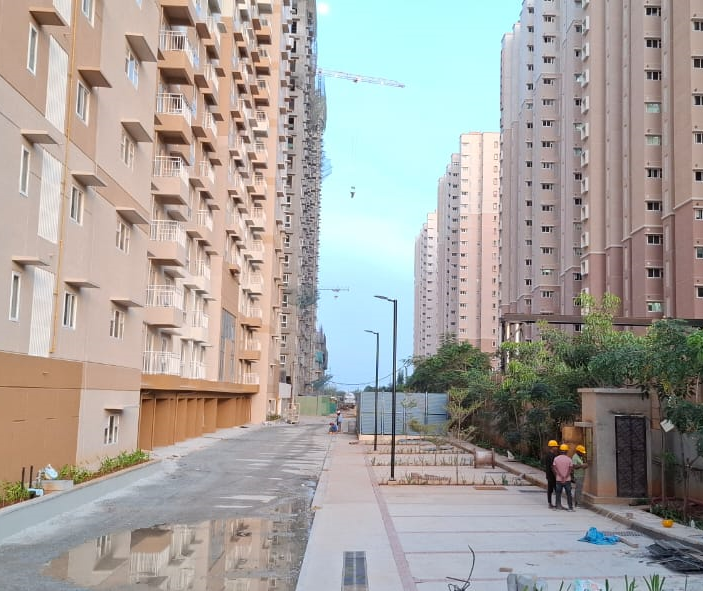

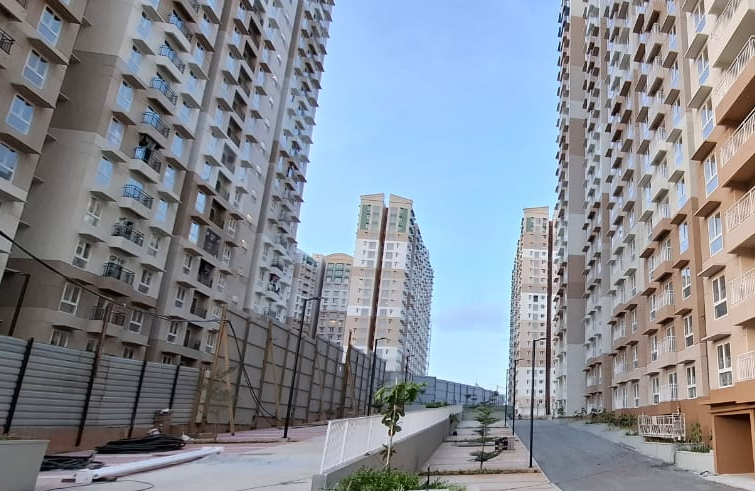

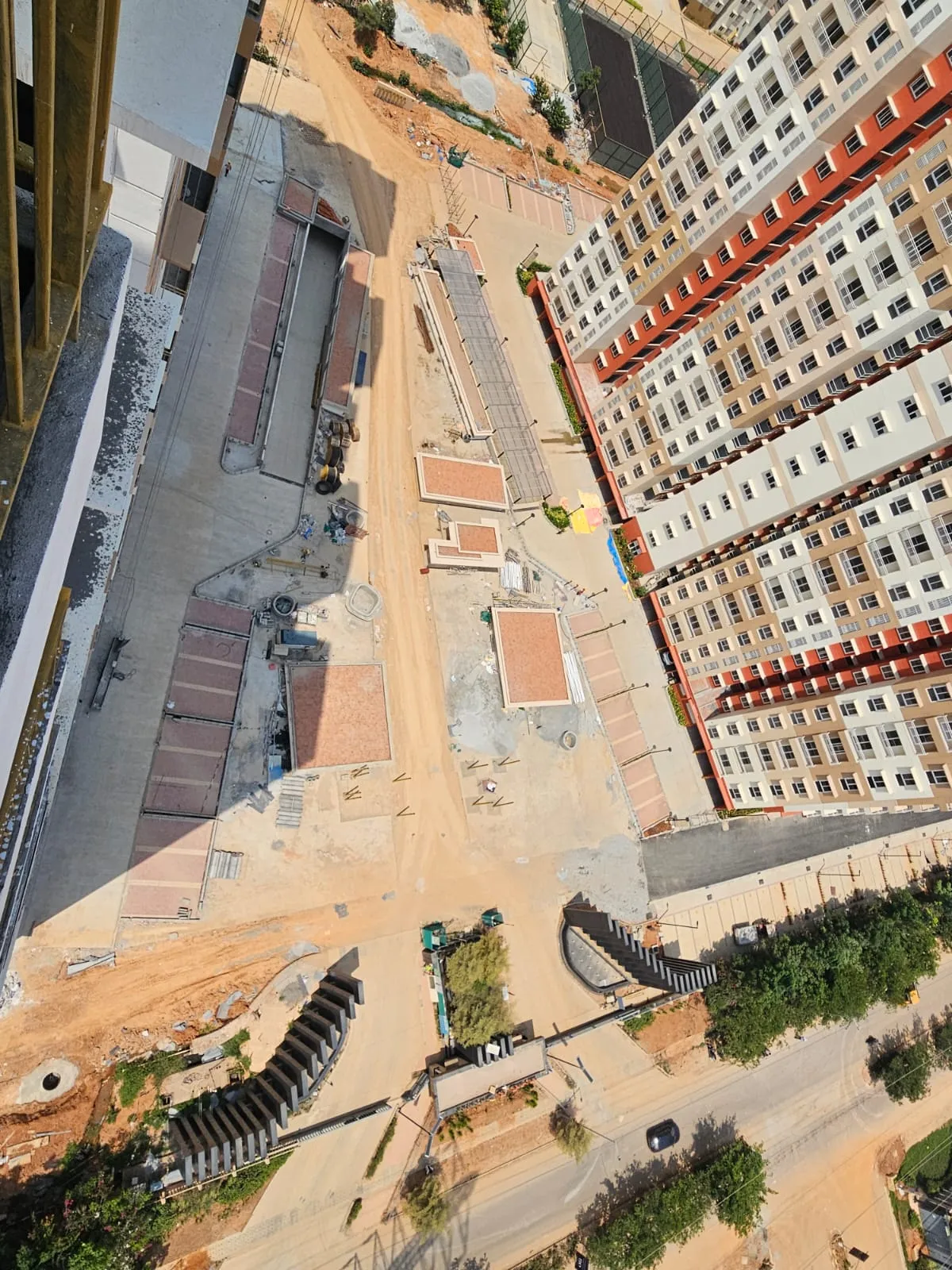

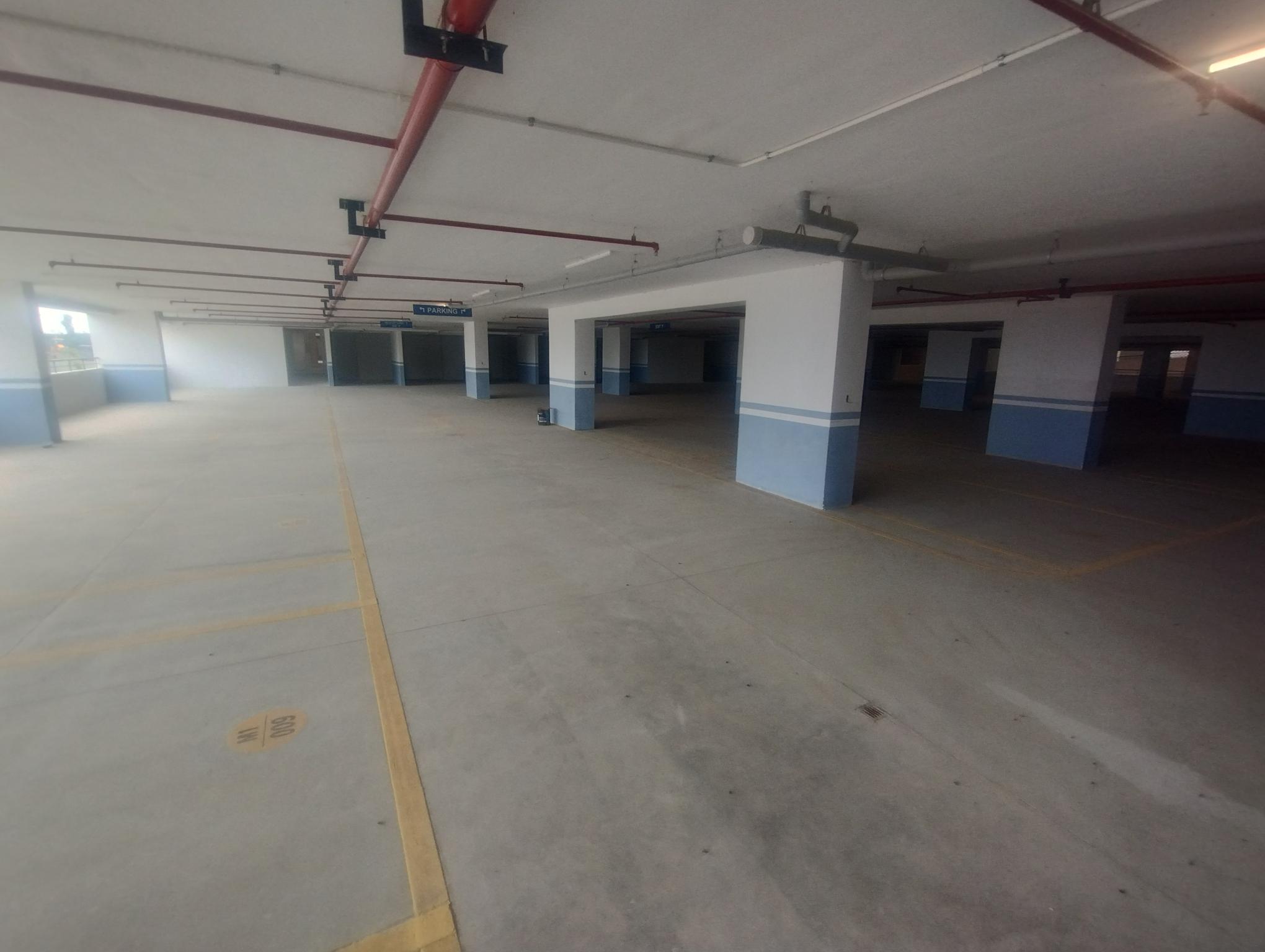

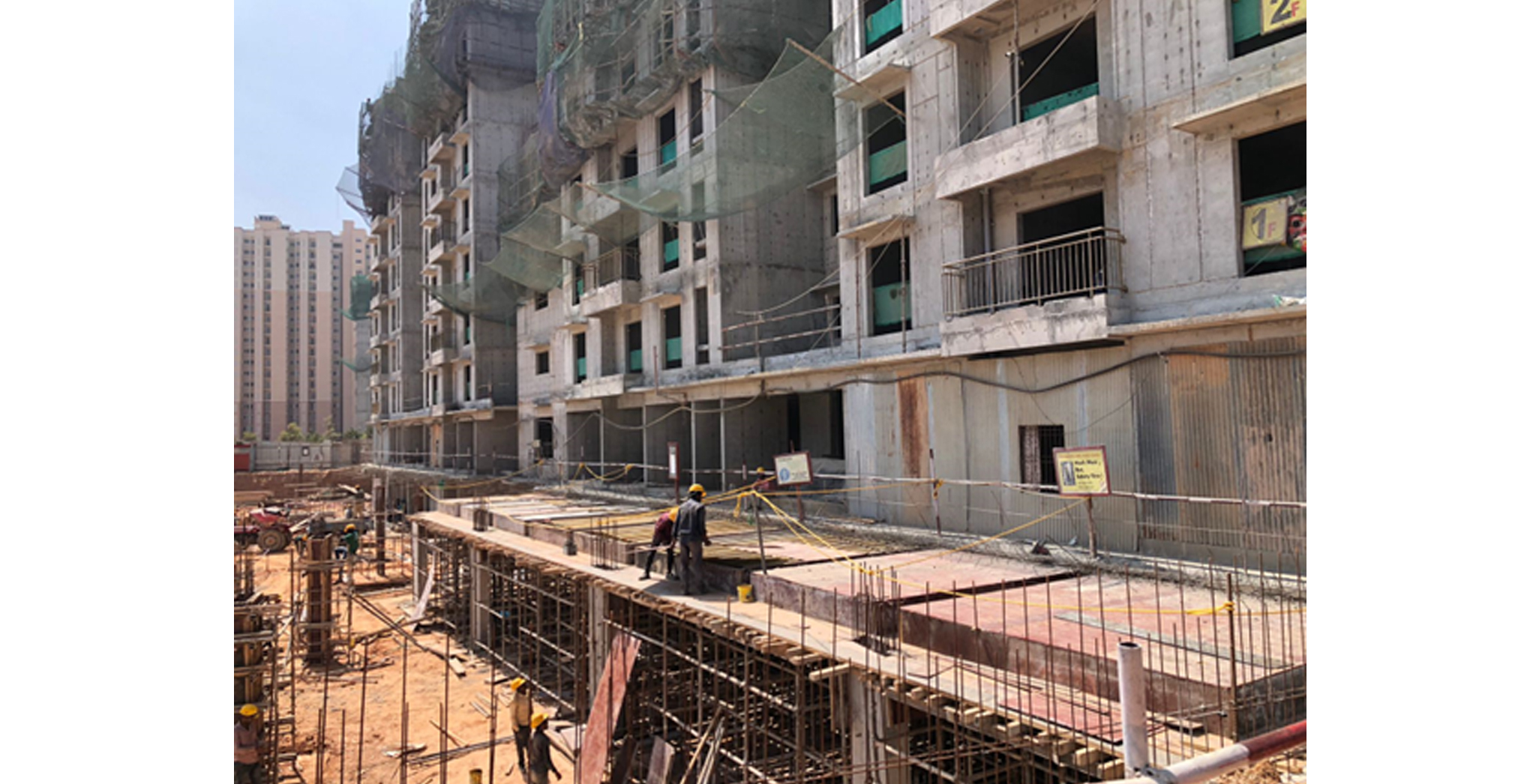

East face( between E and D tower) driveway and car parking work is completed - Jun 2025

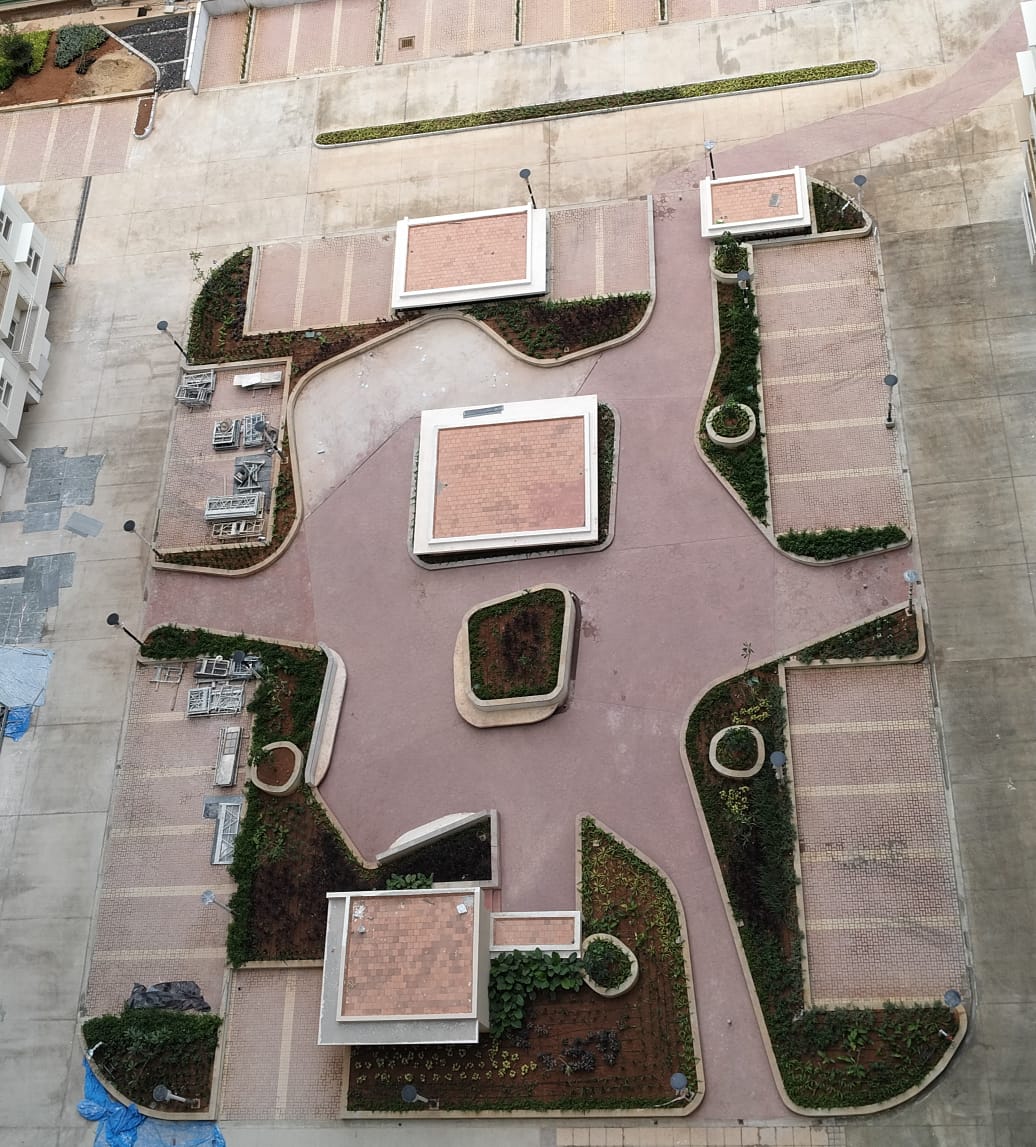

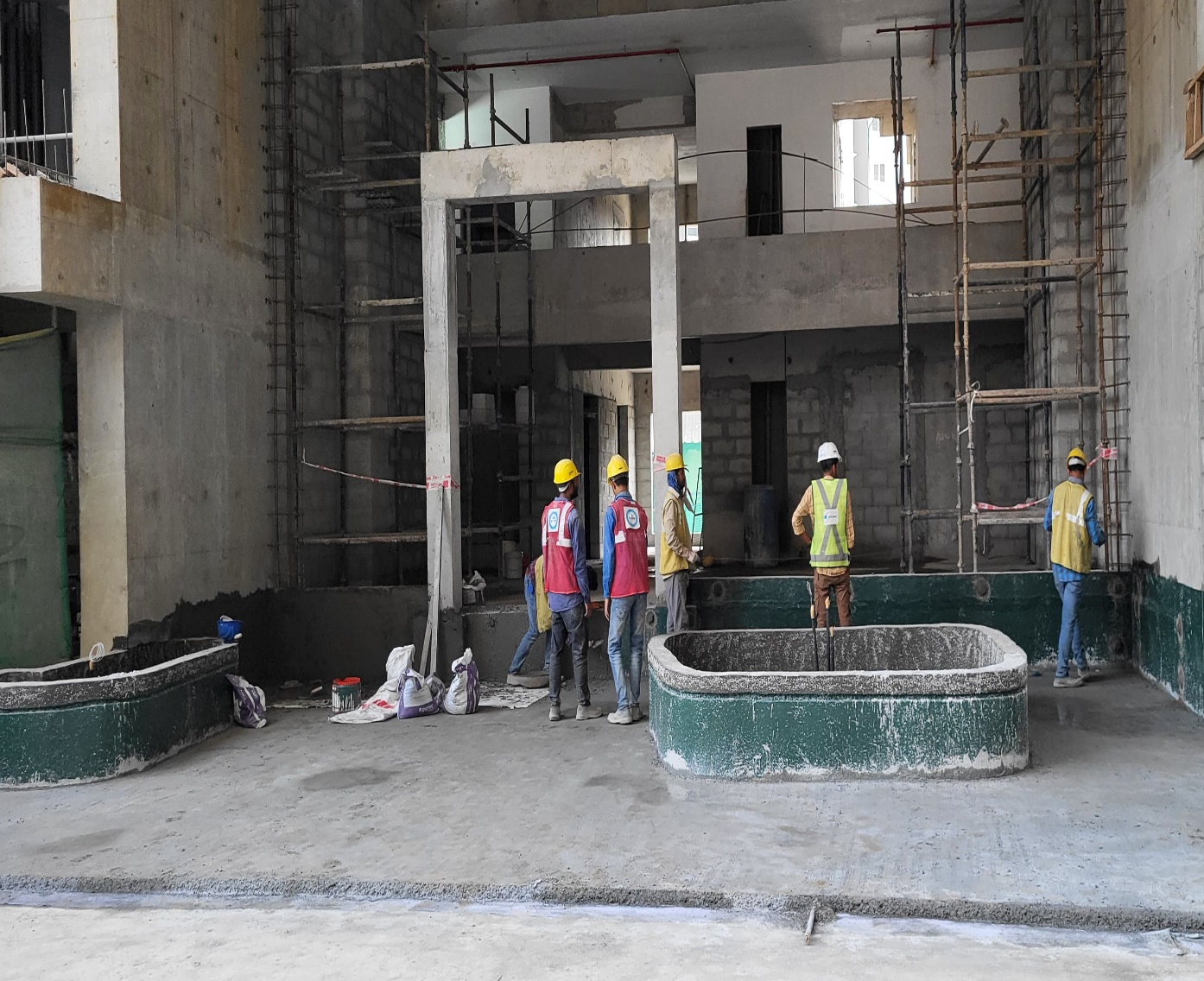

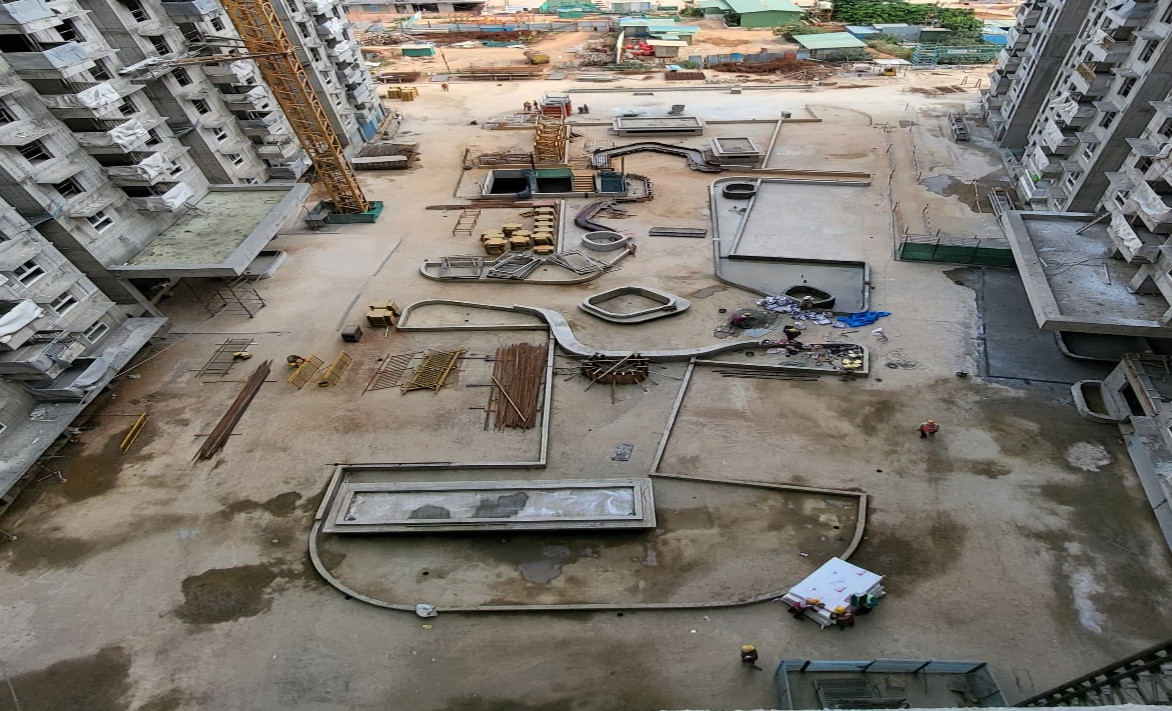

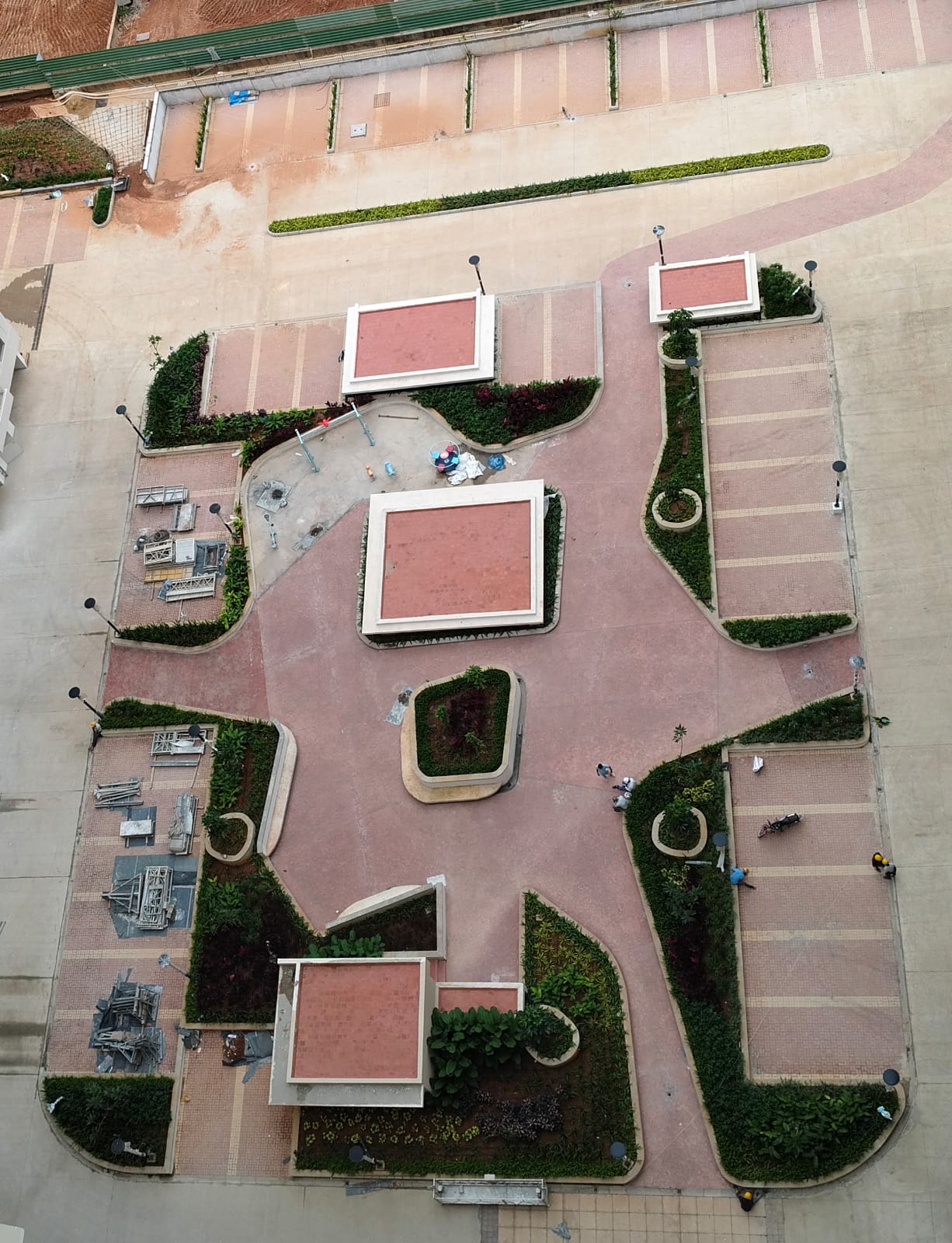

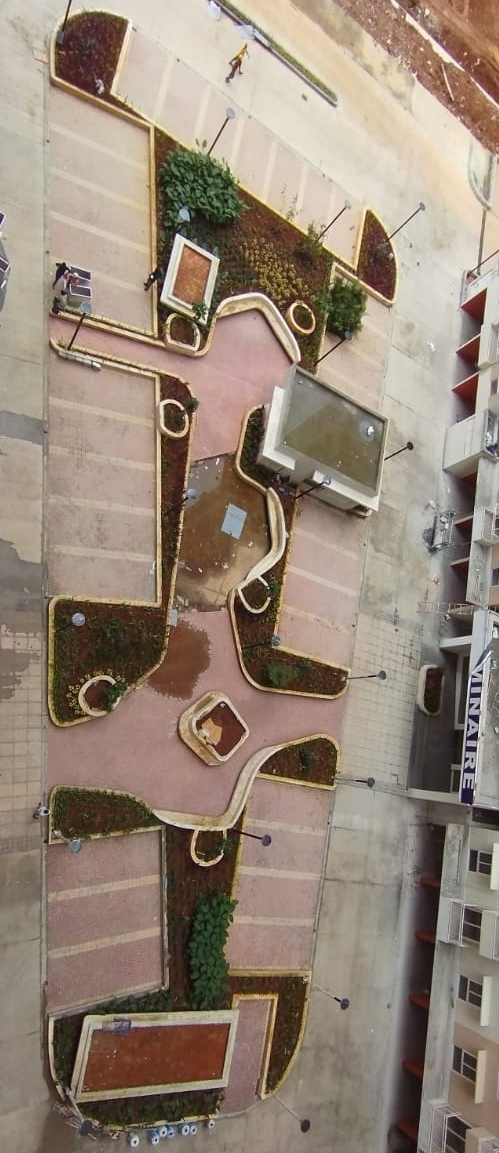

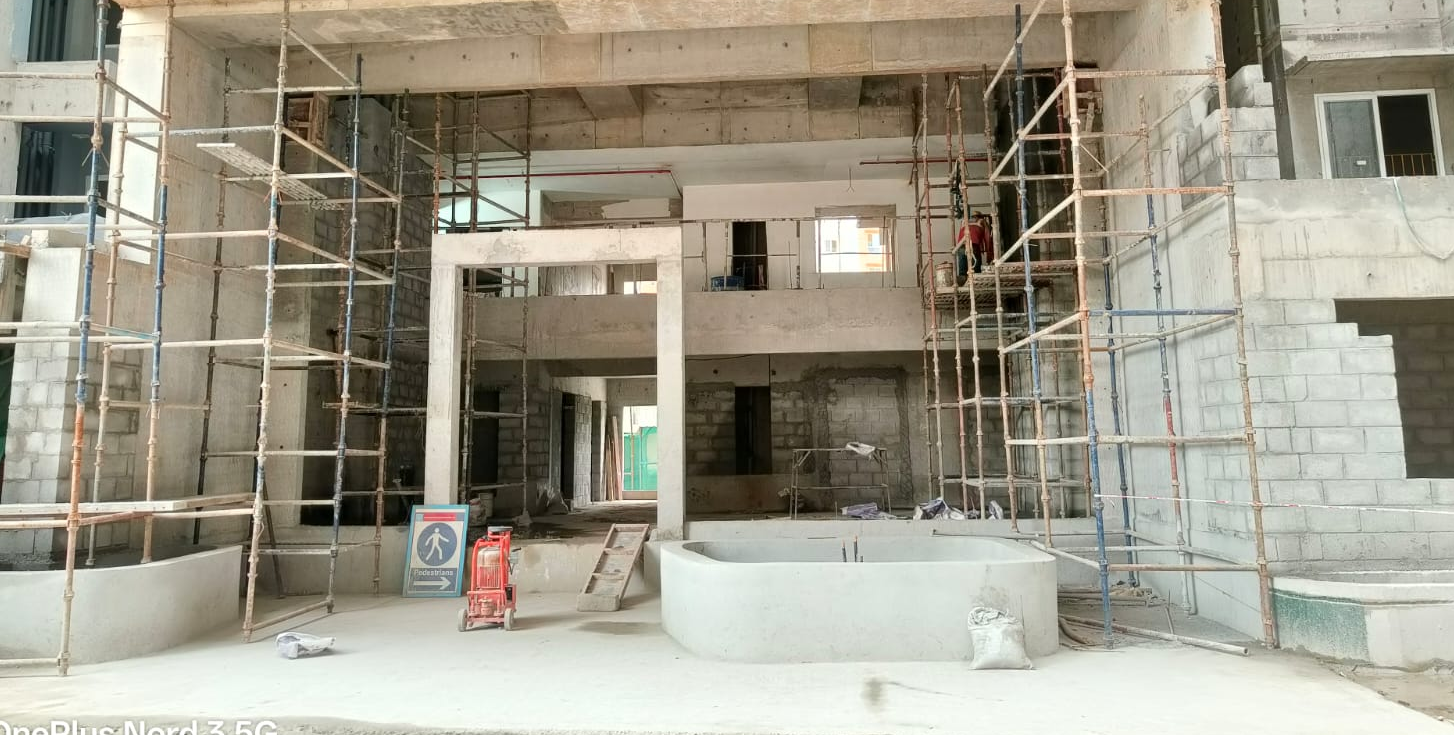

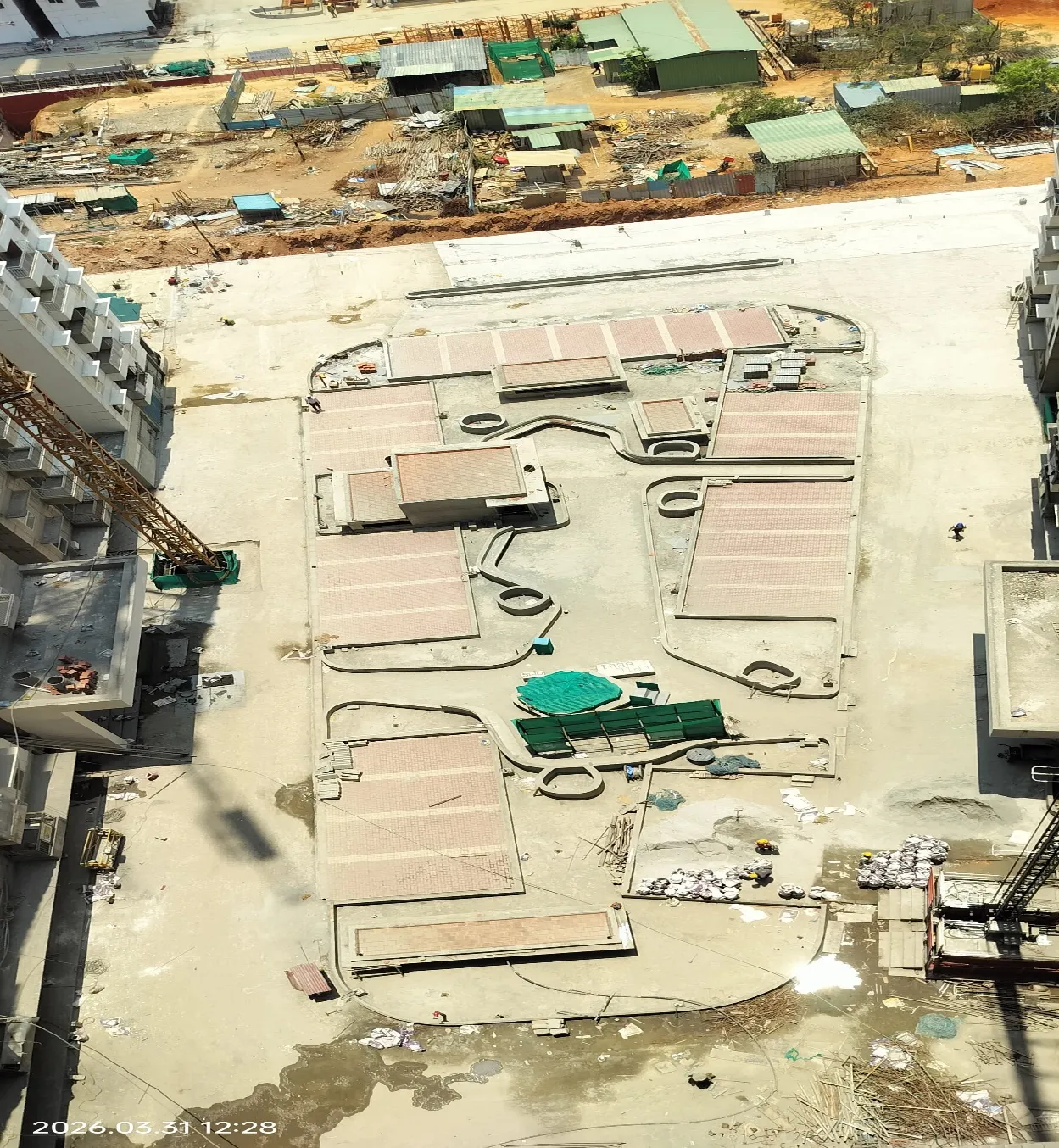

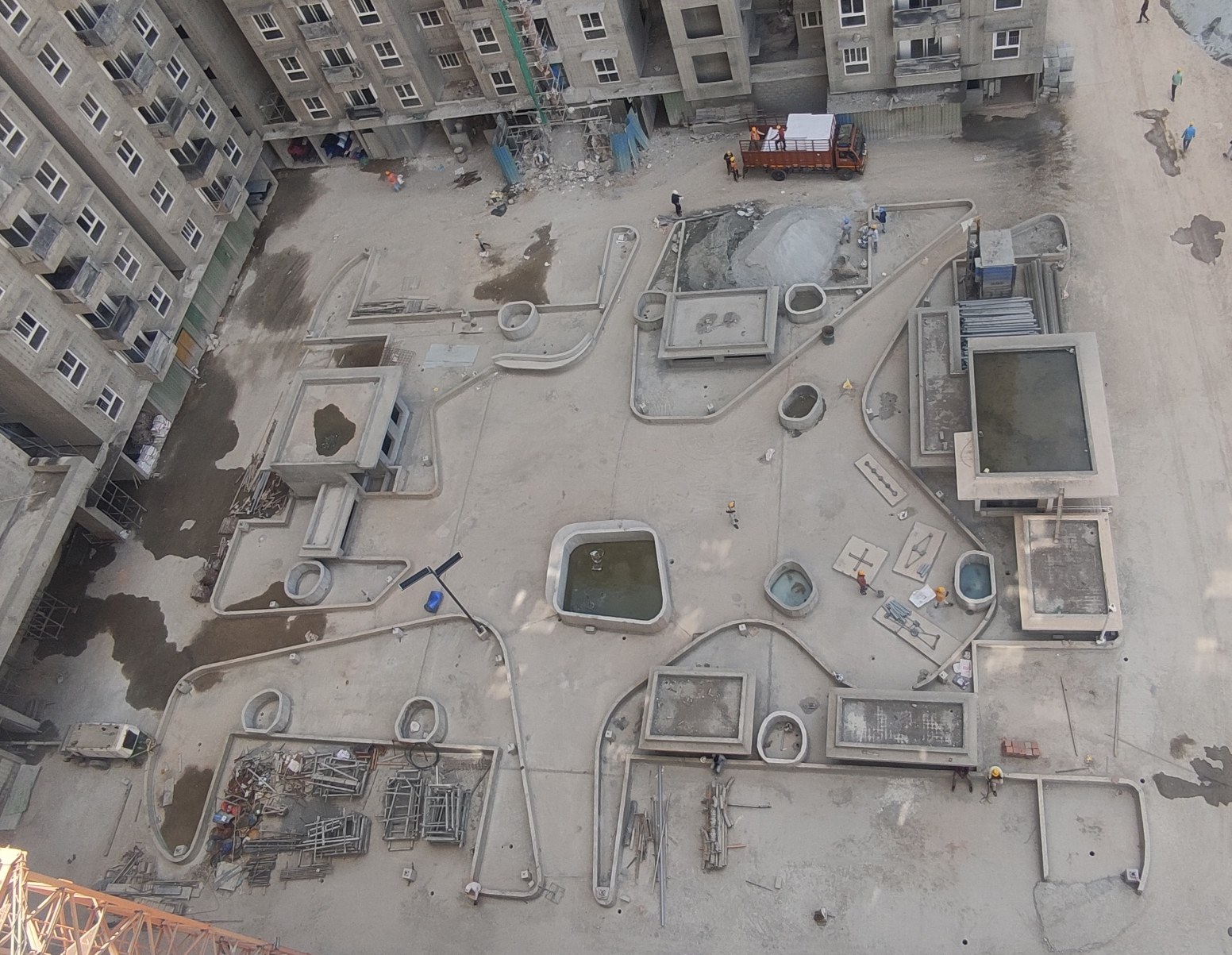

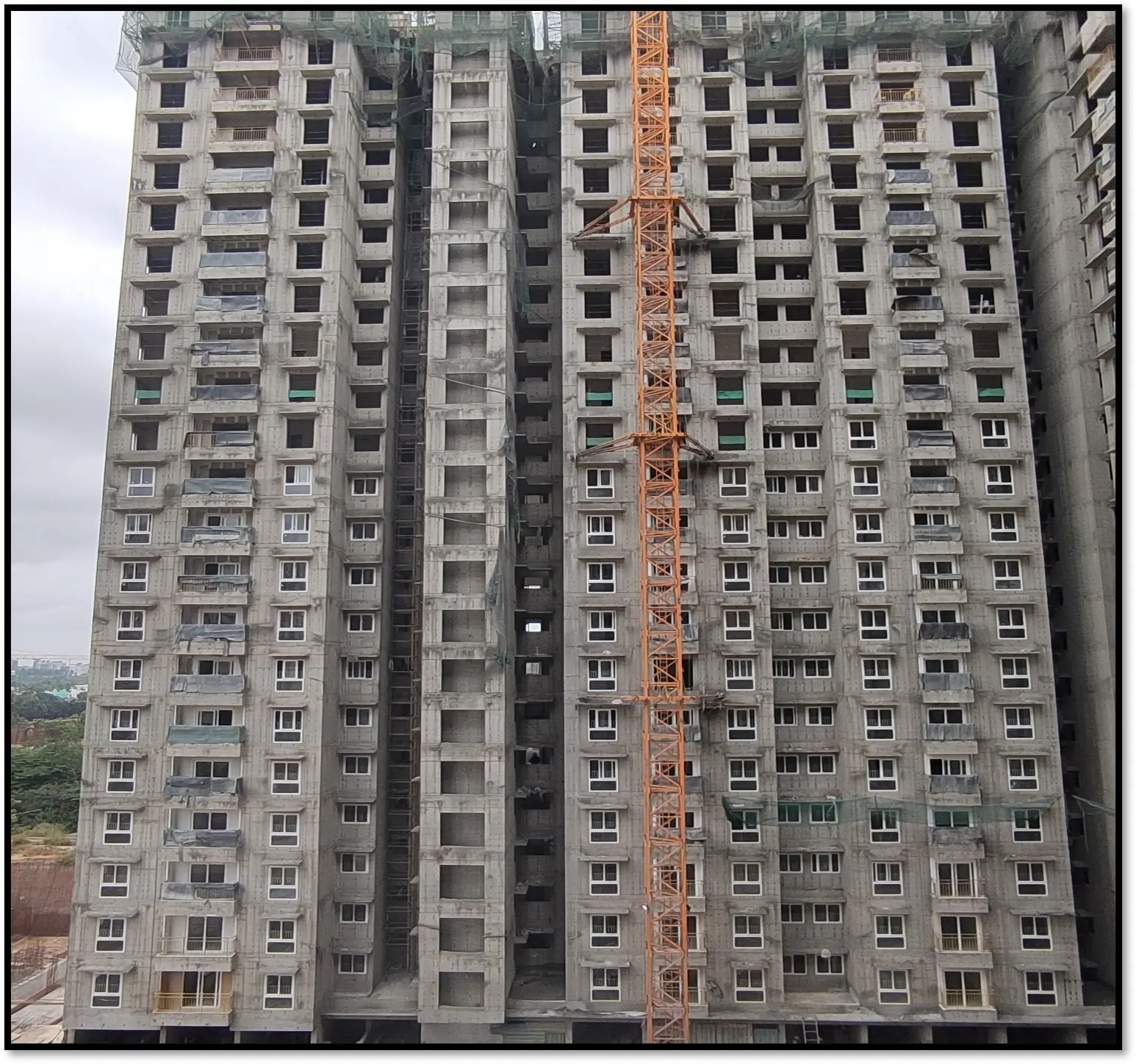

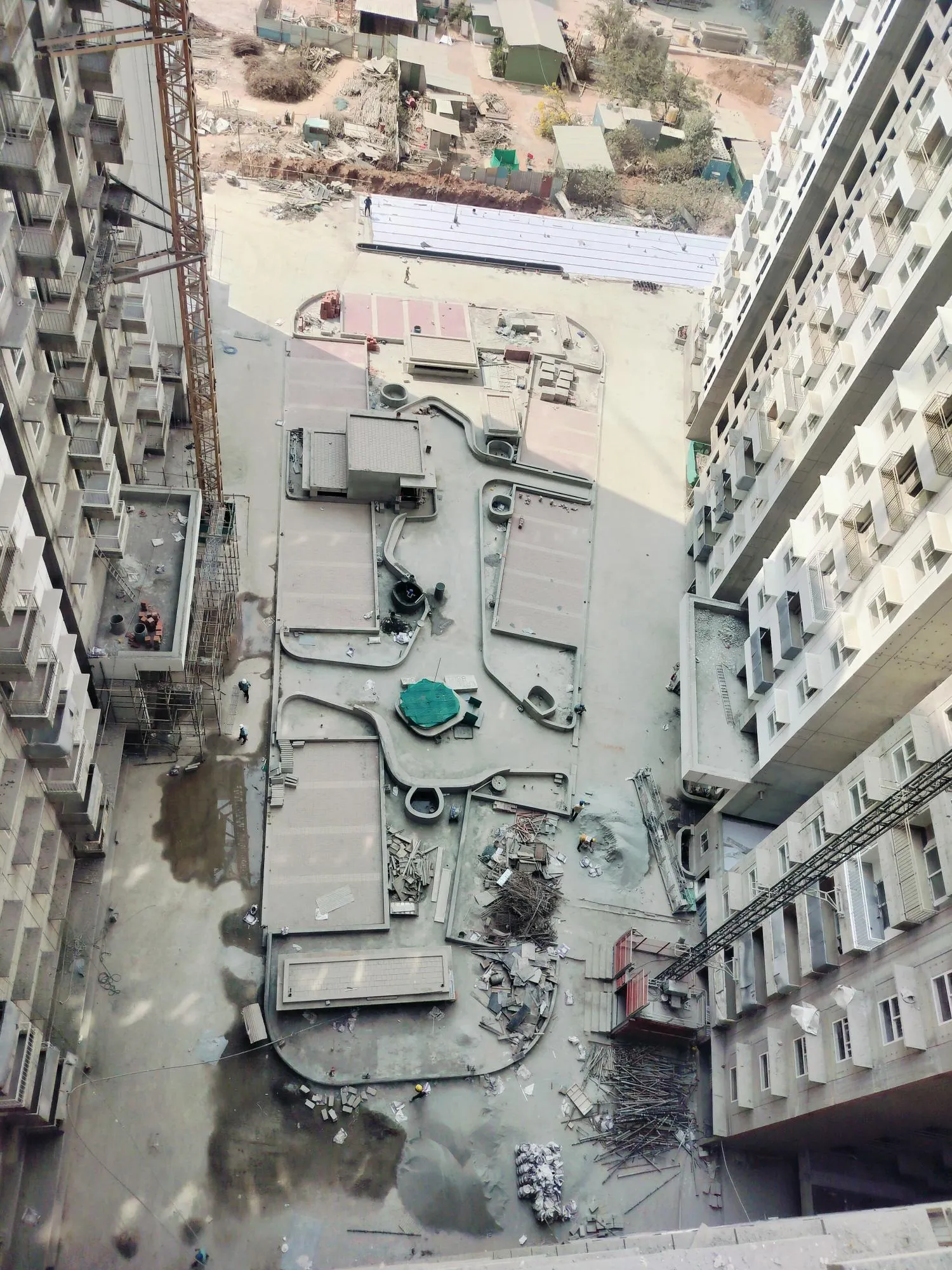

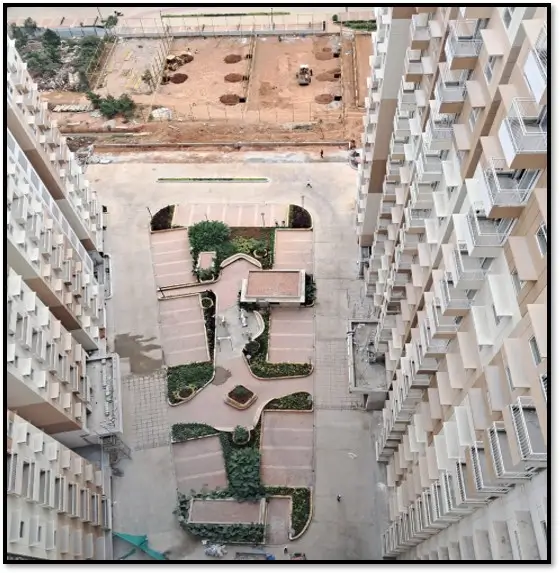

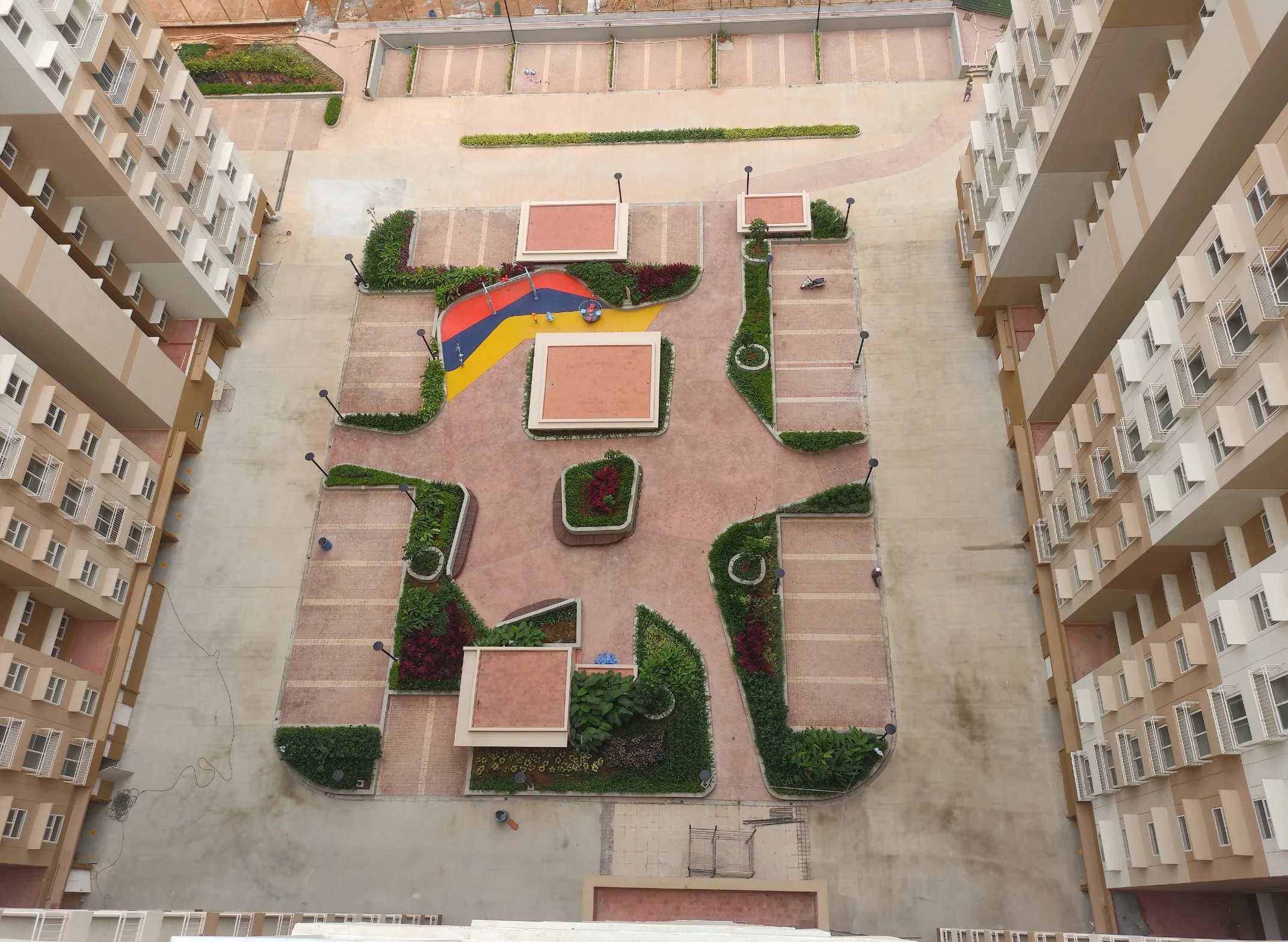

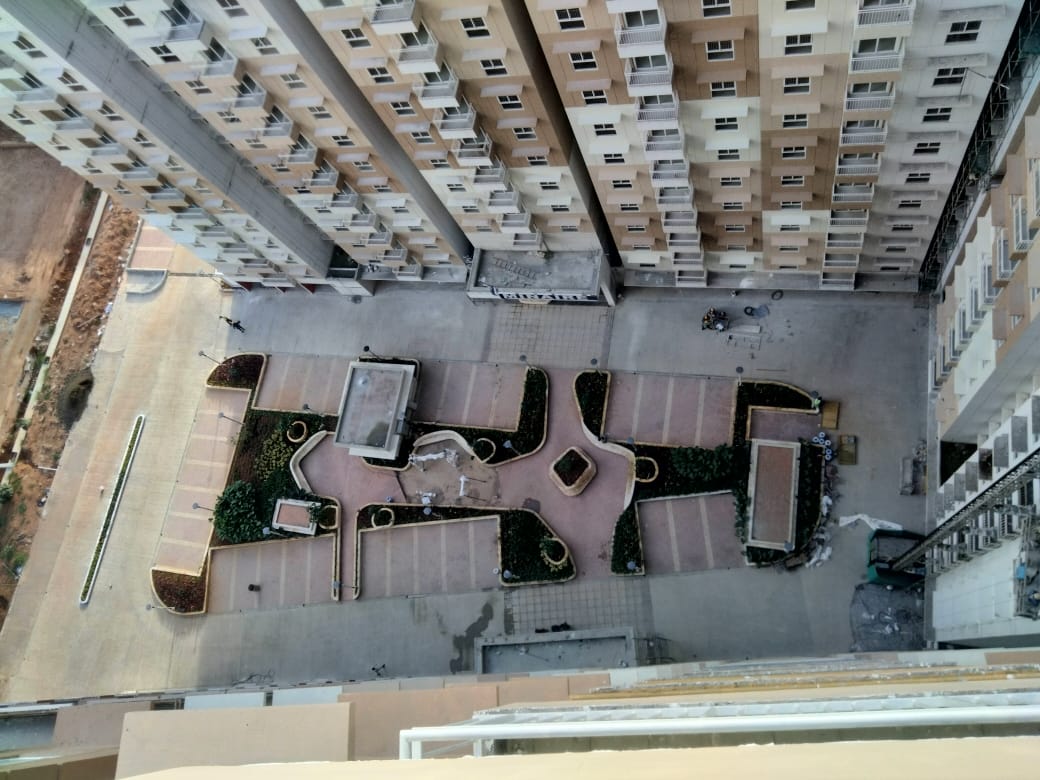

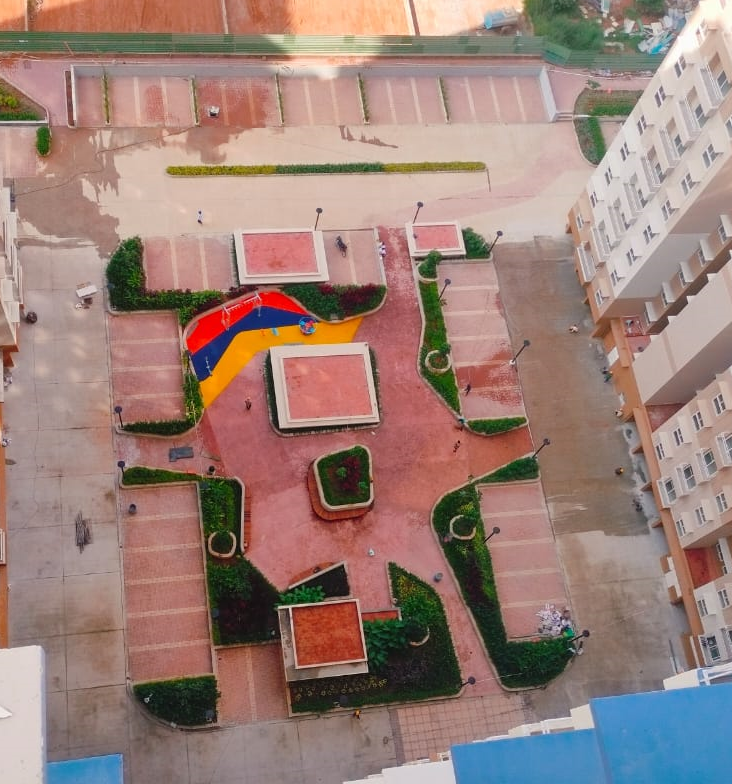

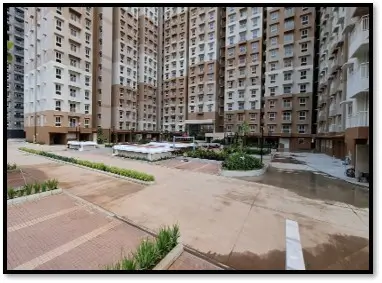

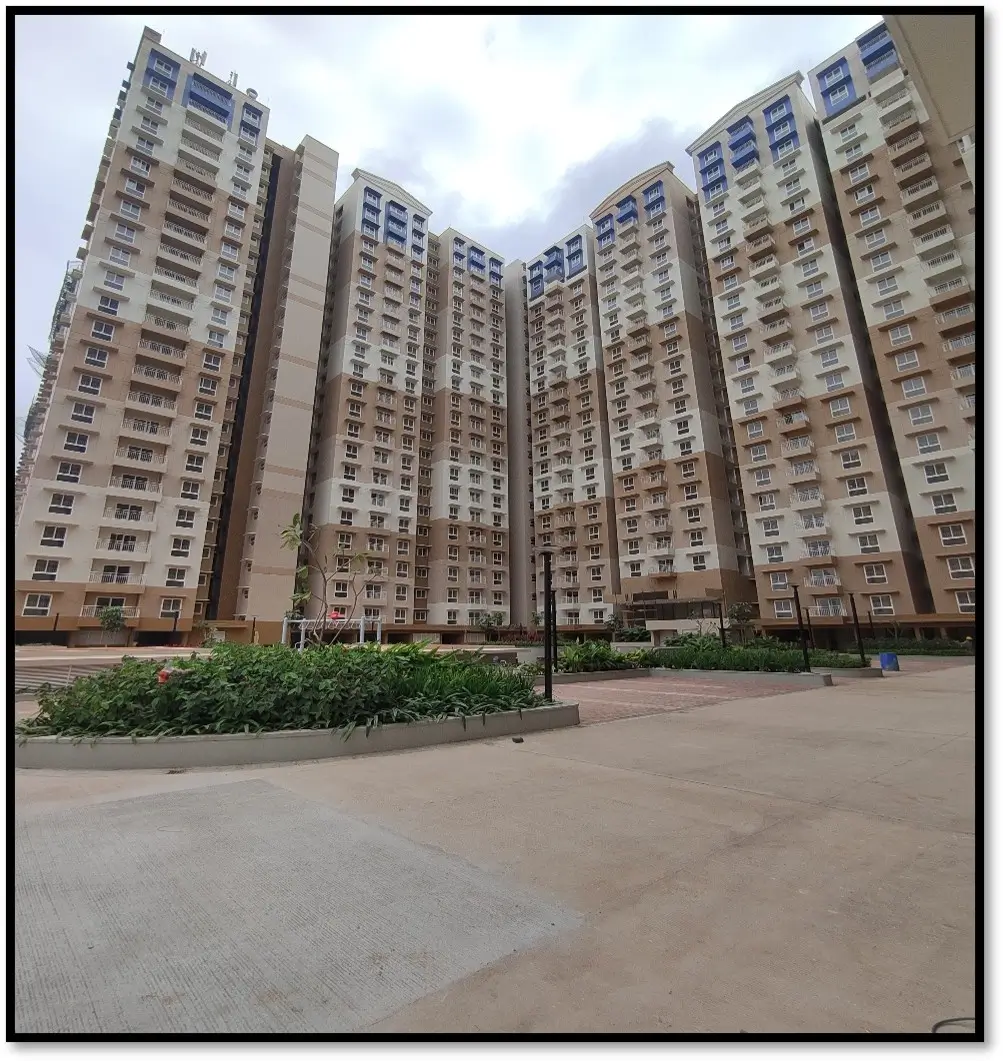

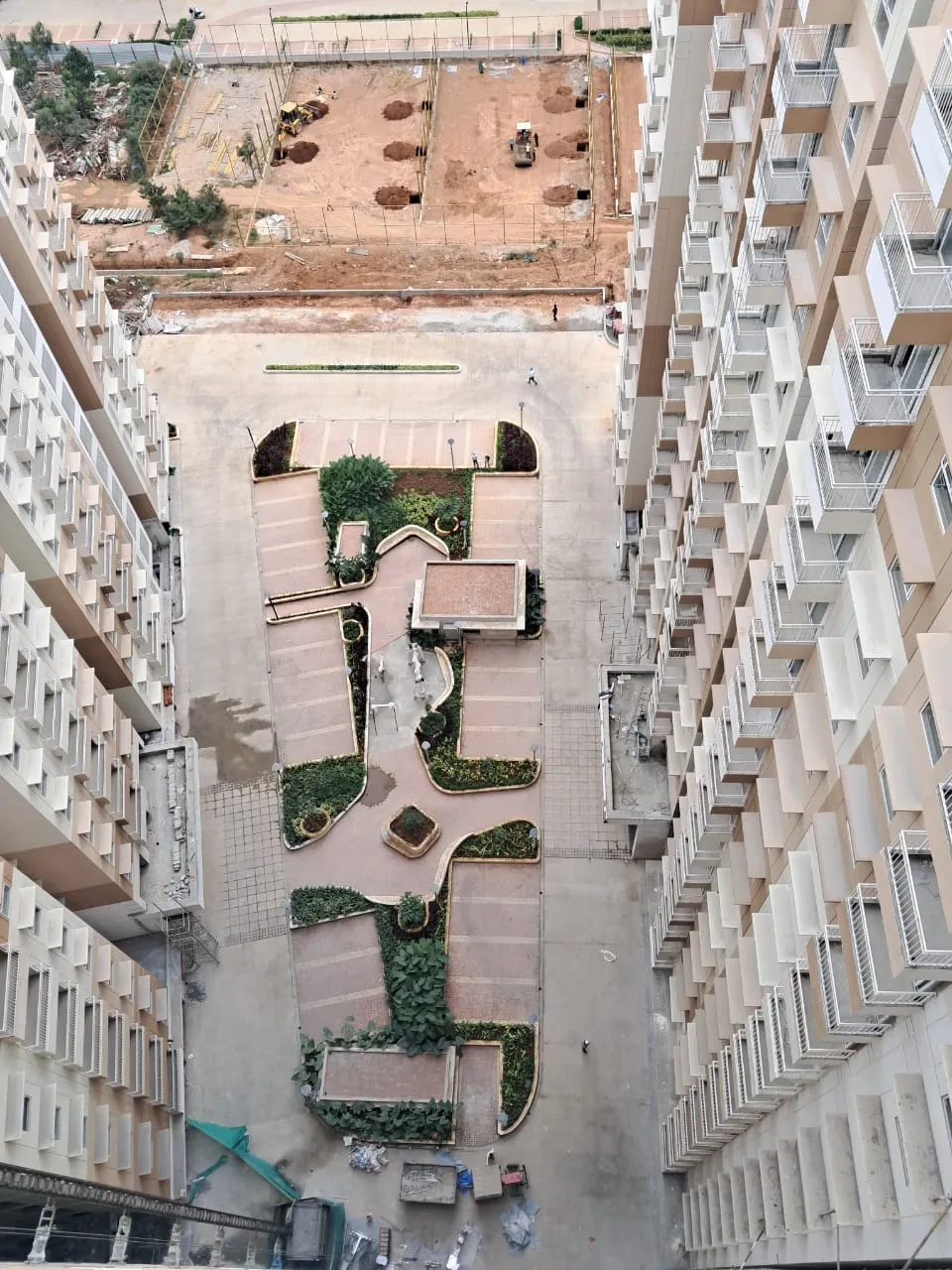

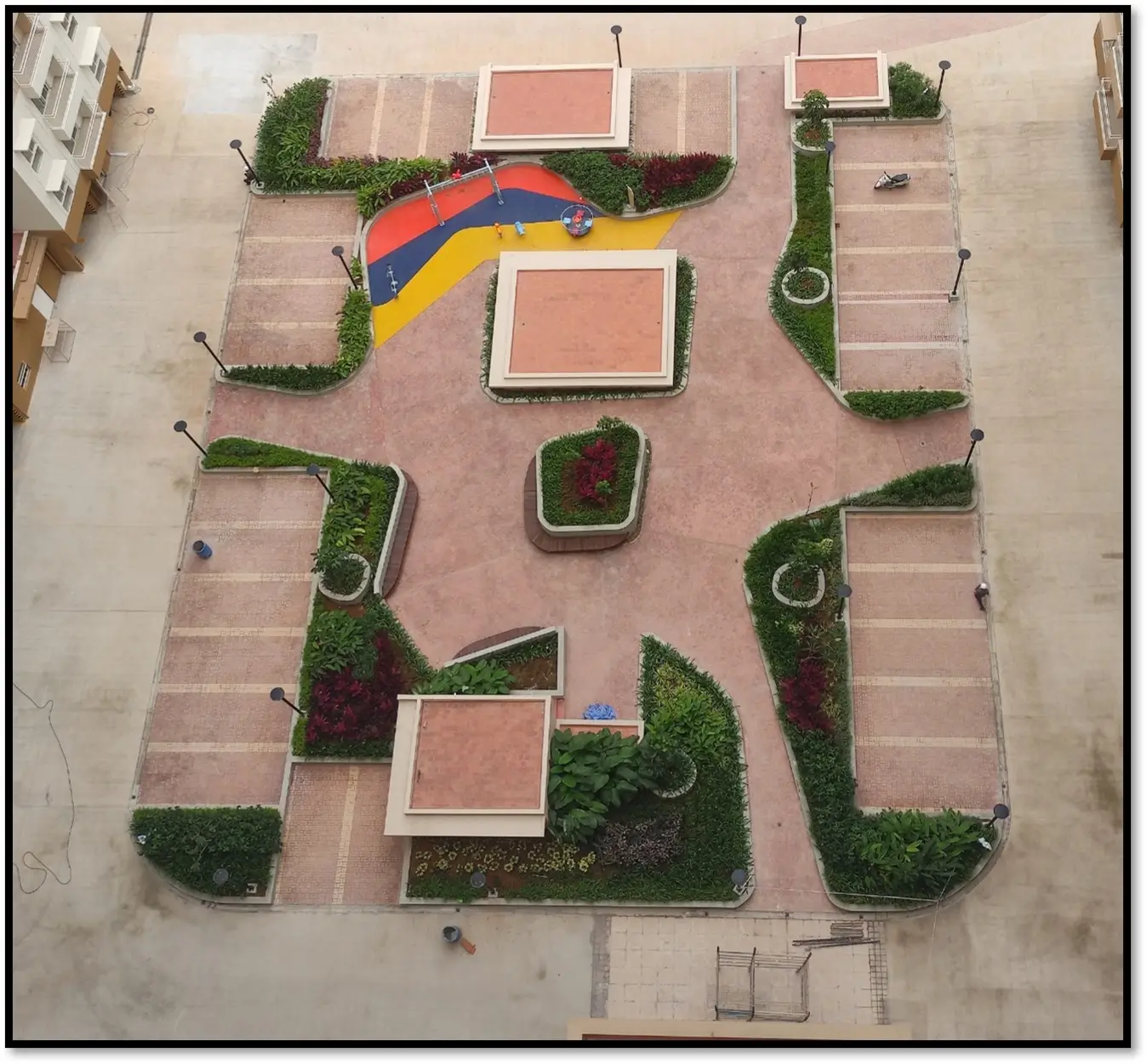

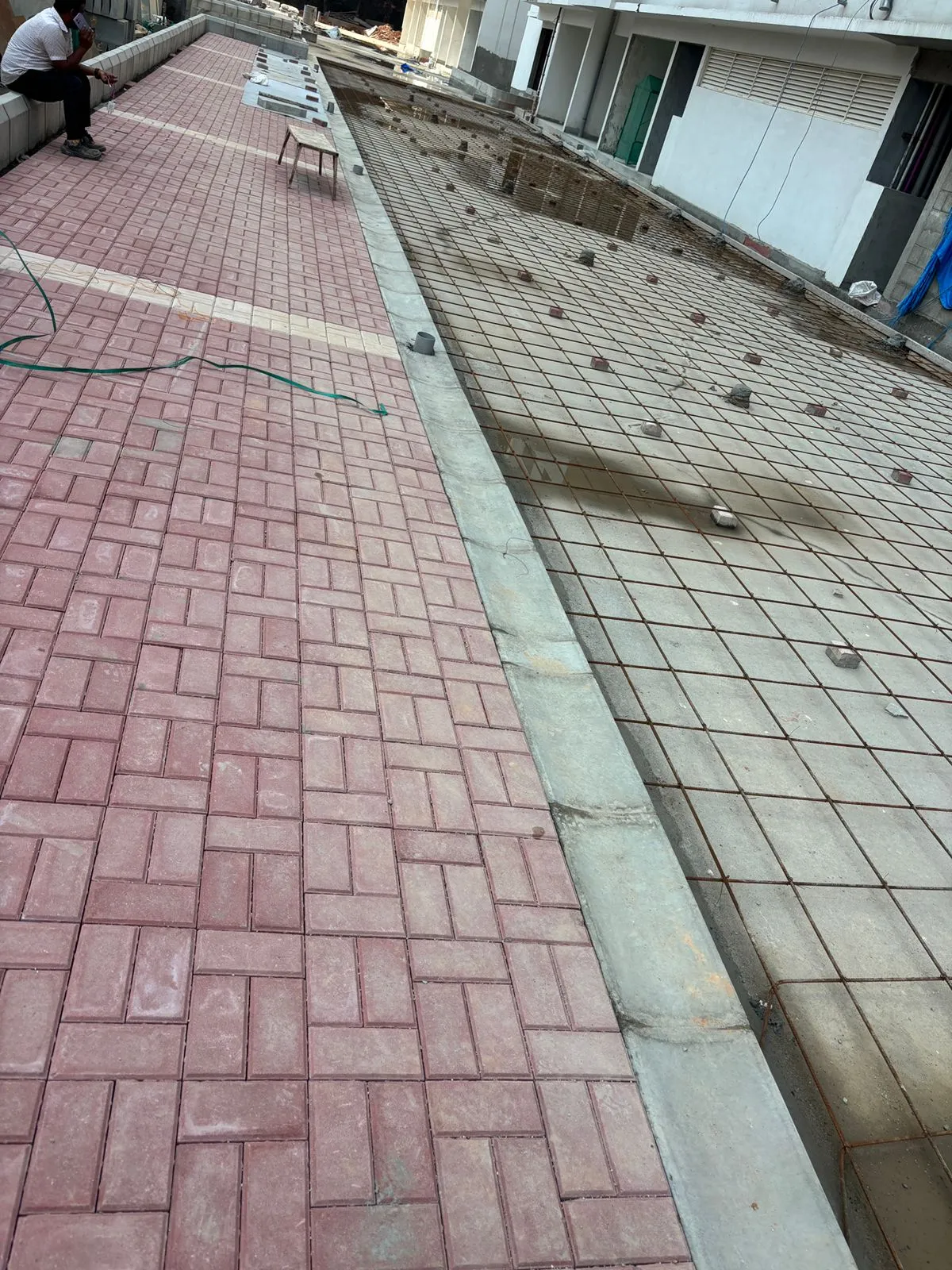

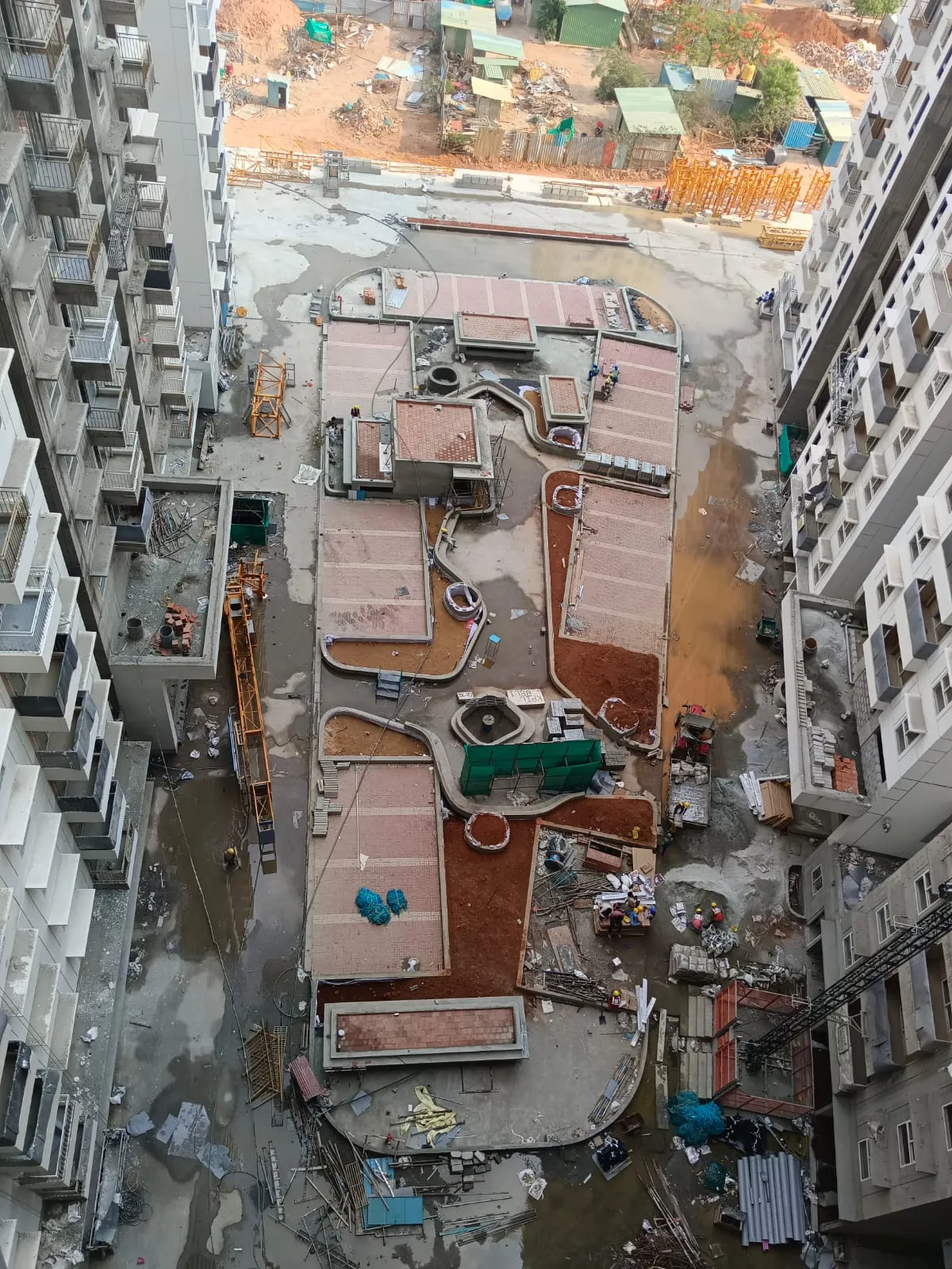

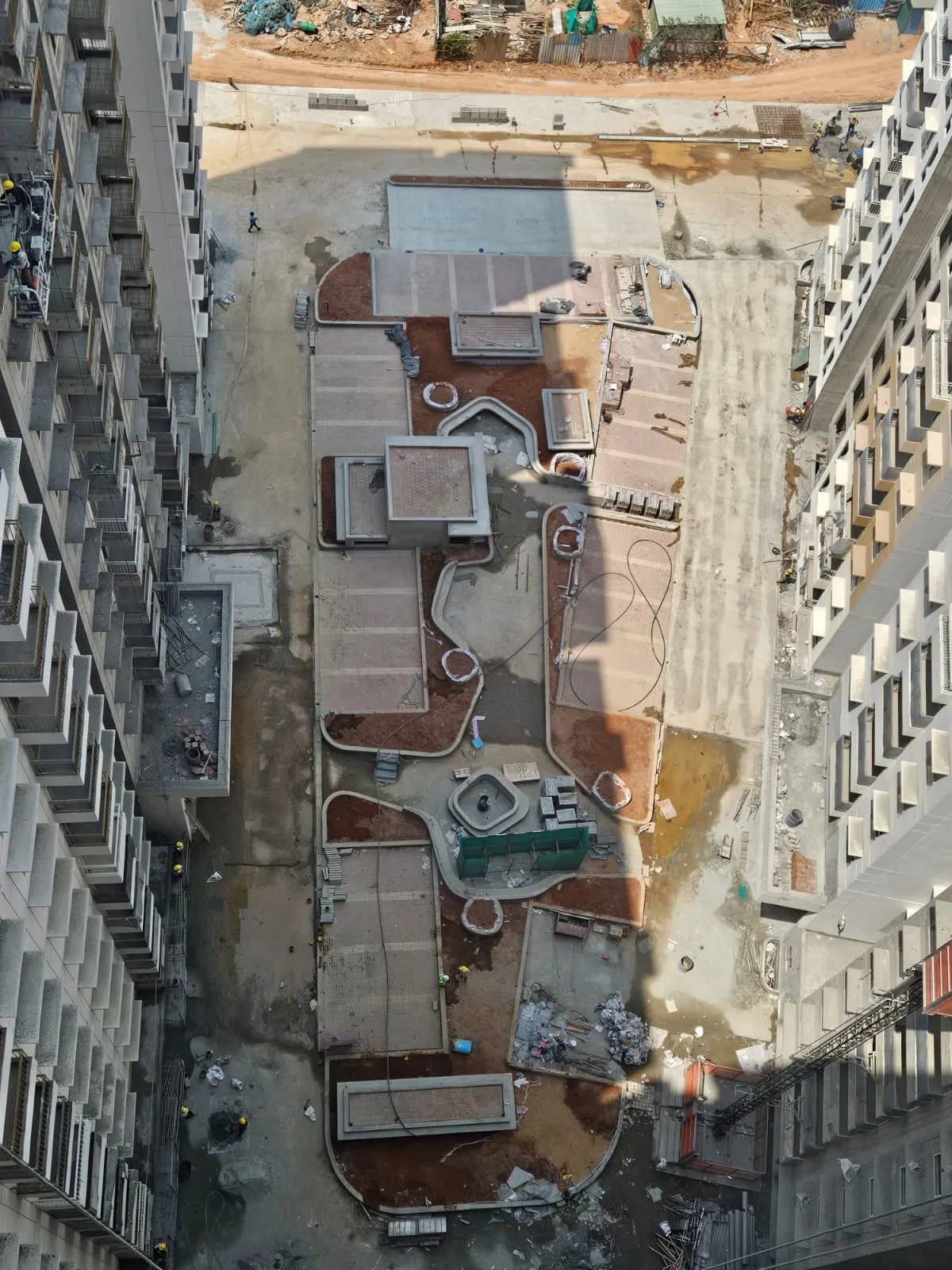

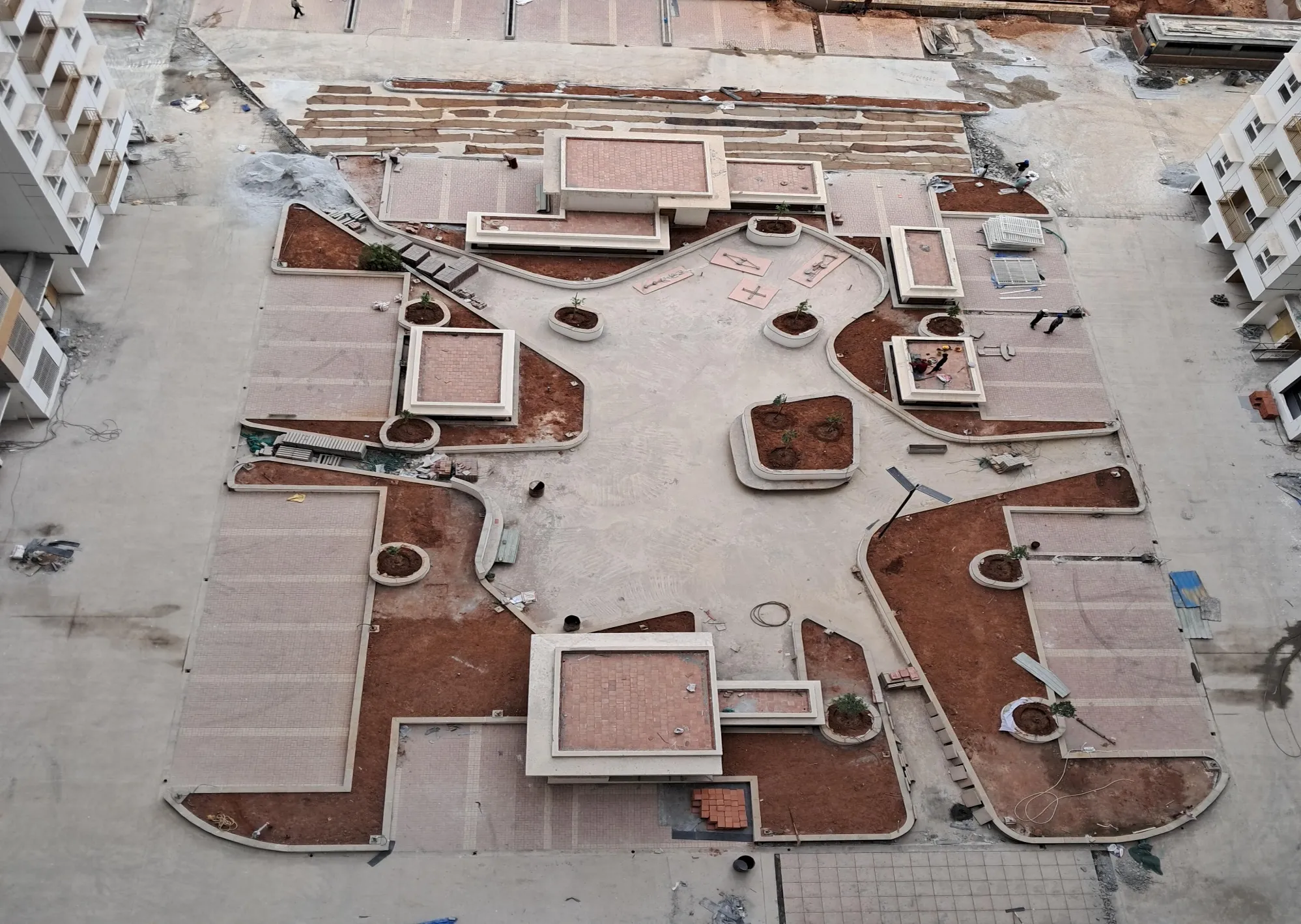

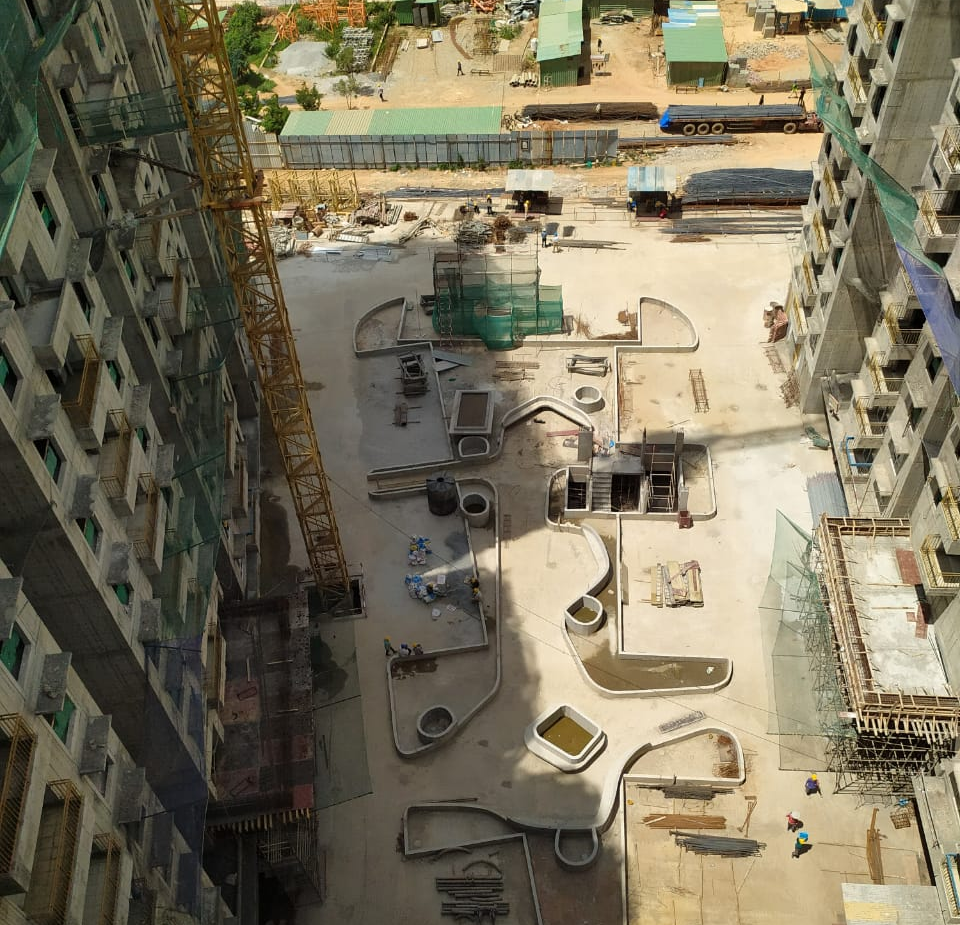

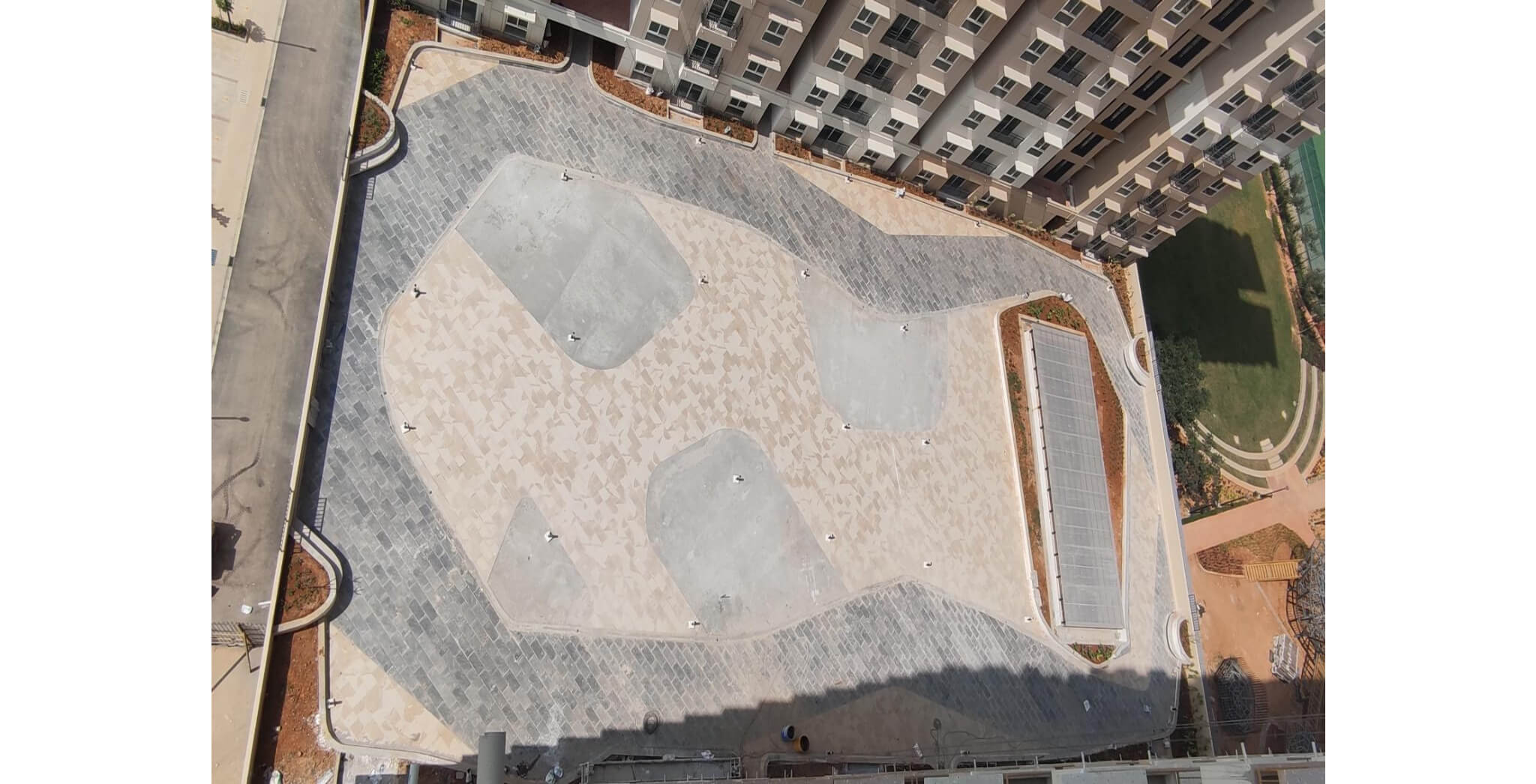

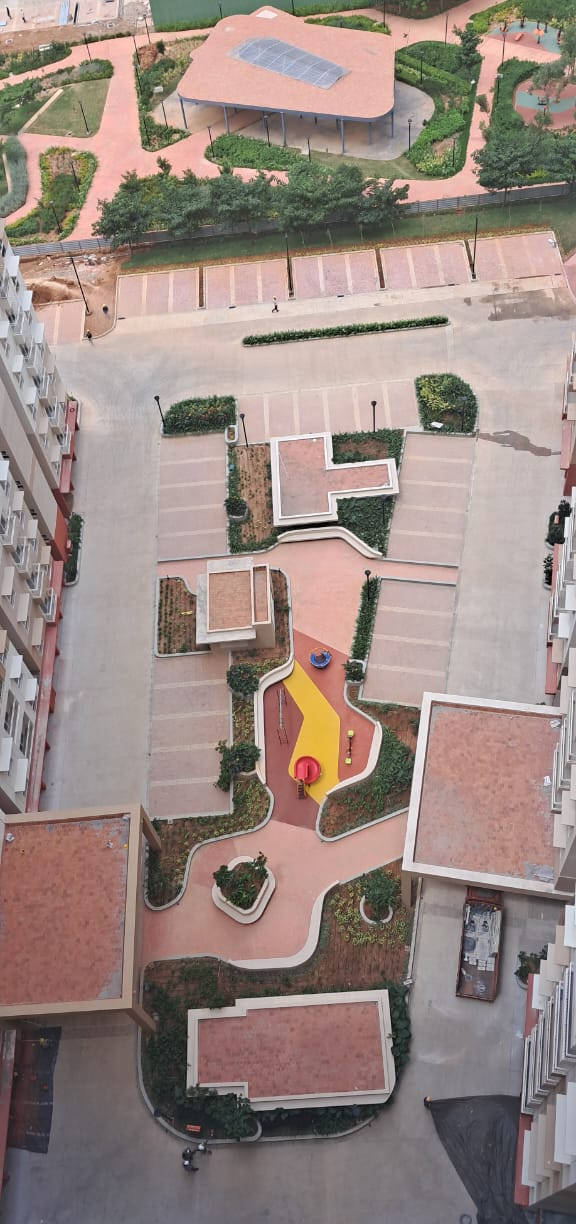

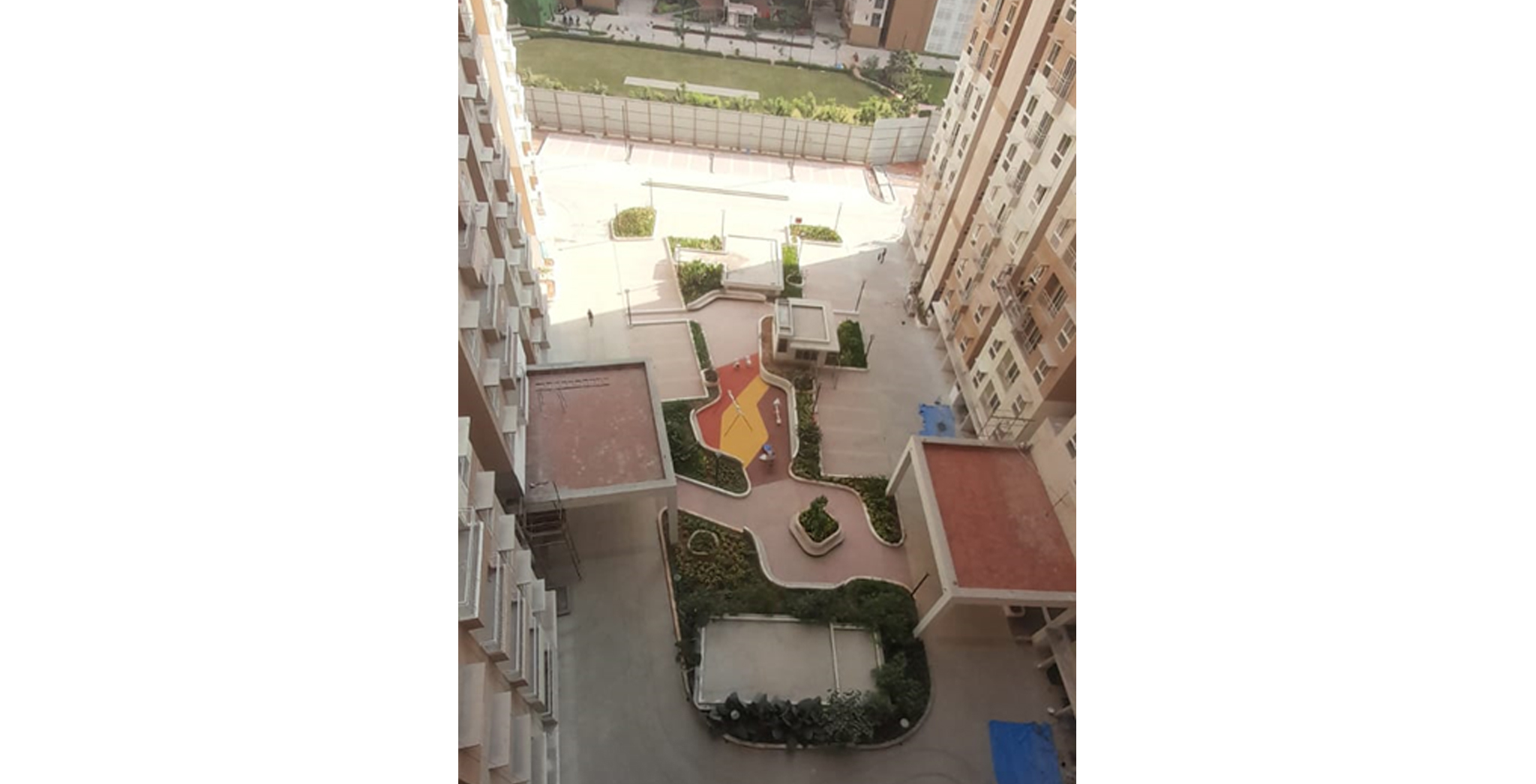

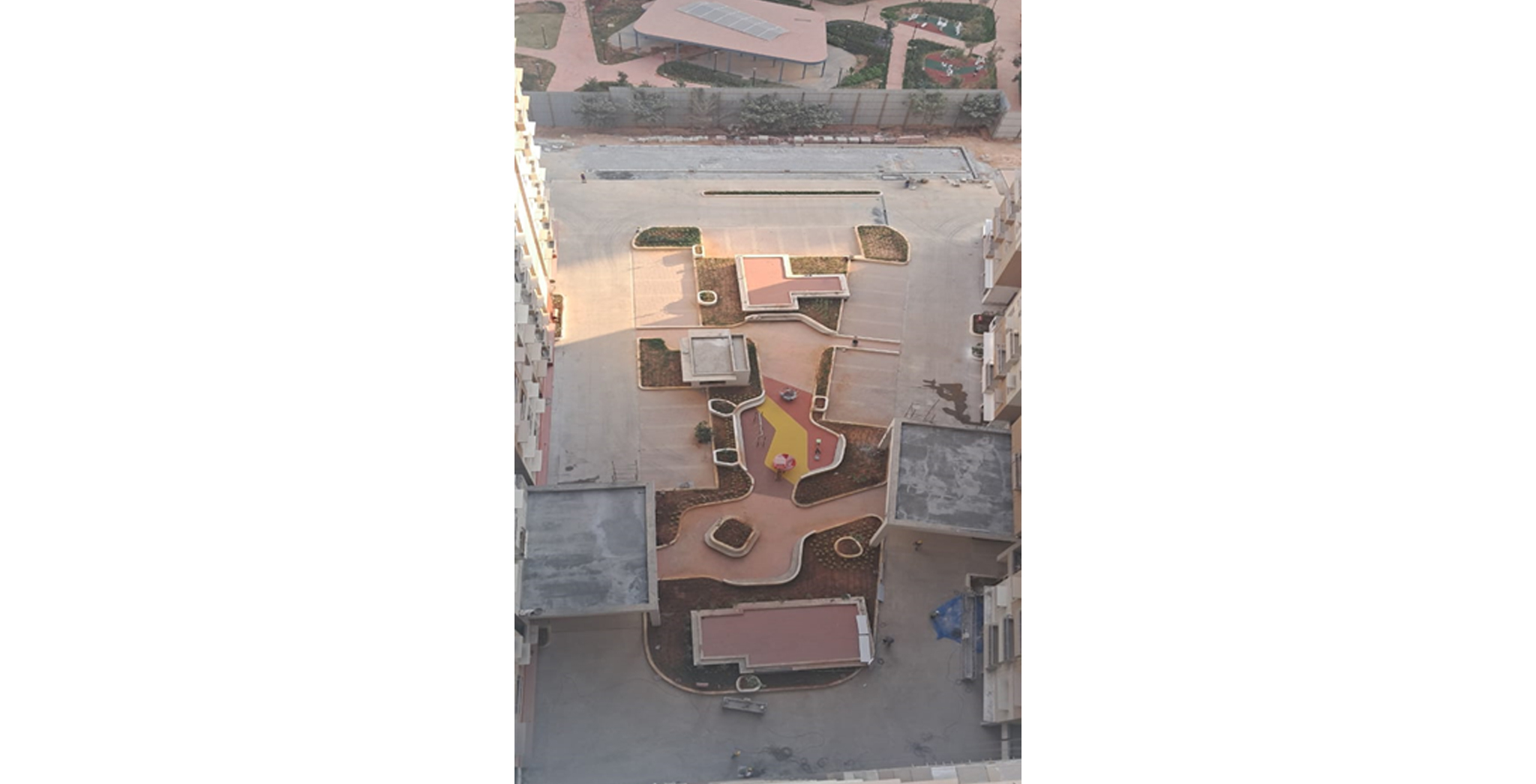

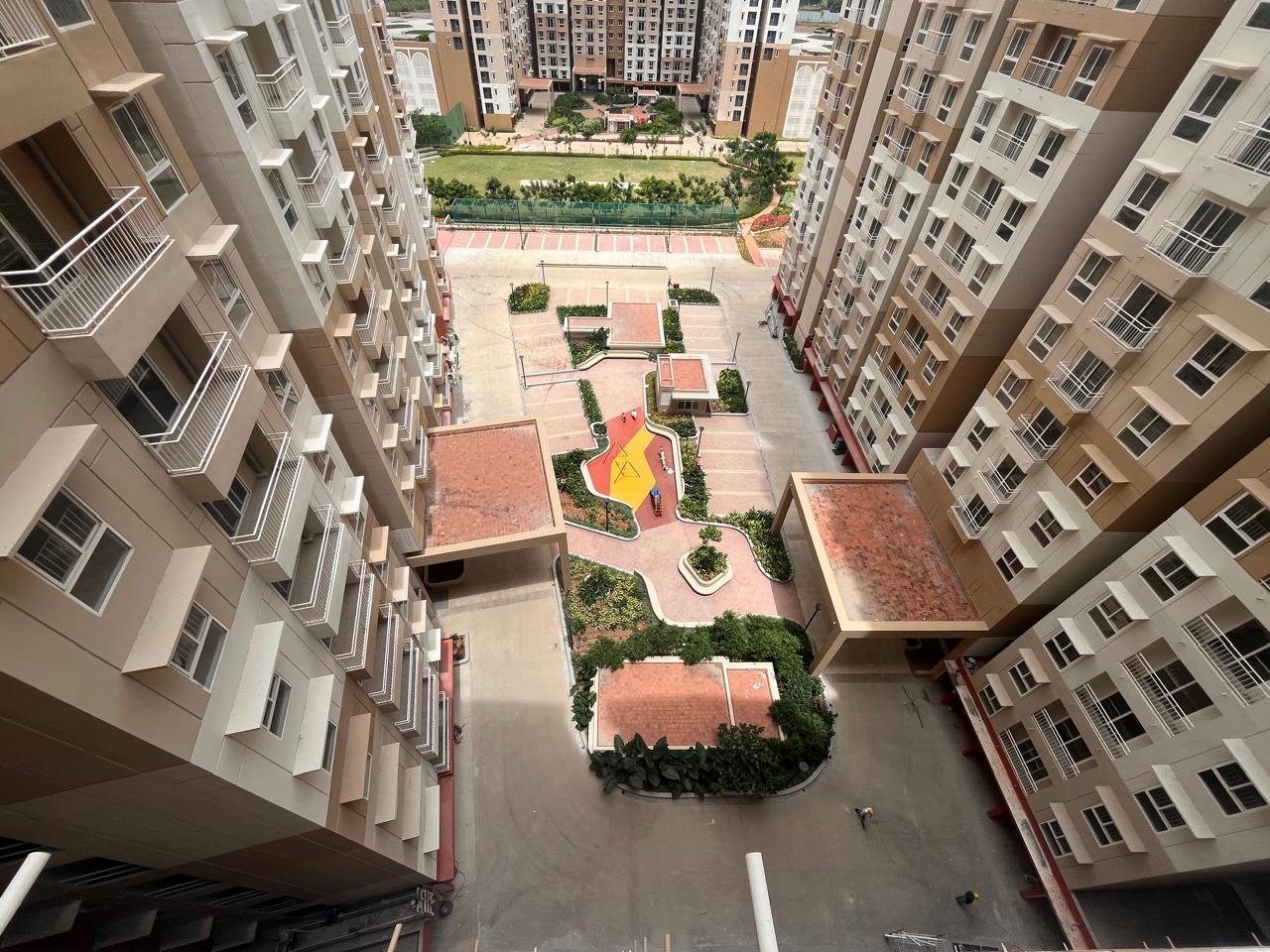

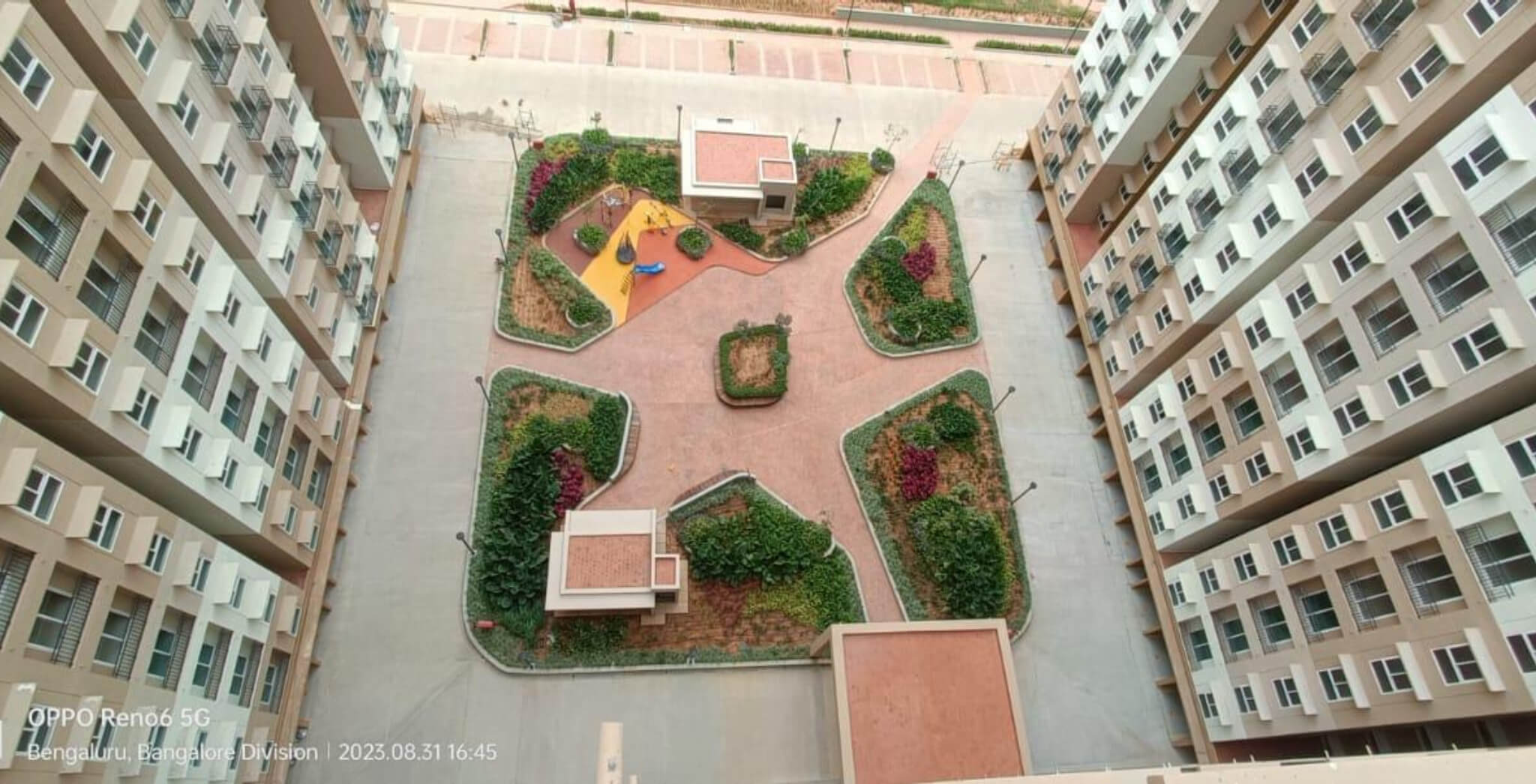

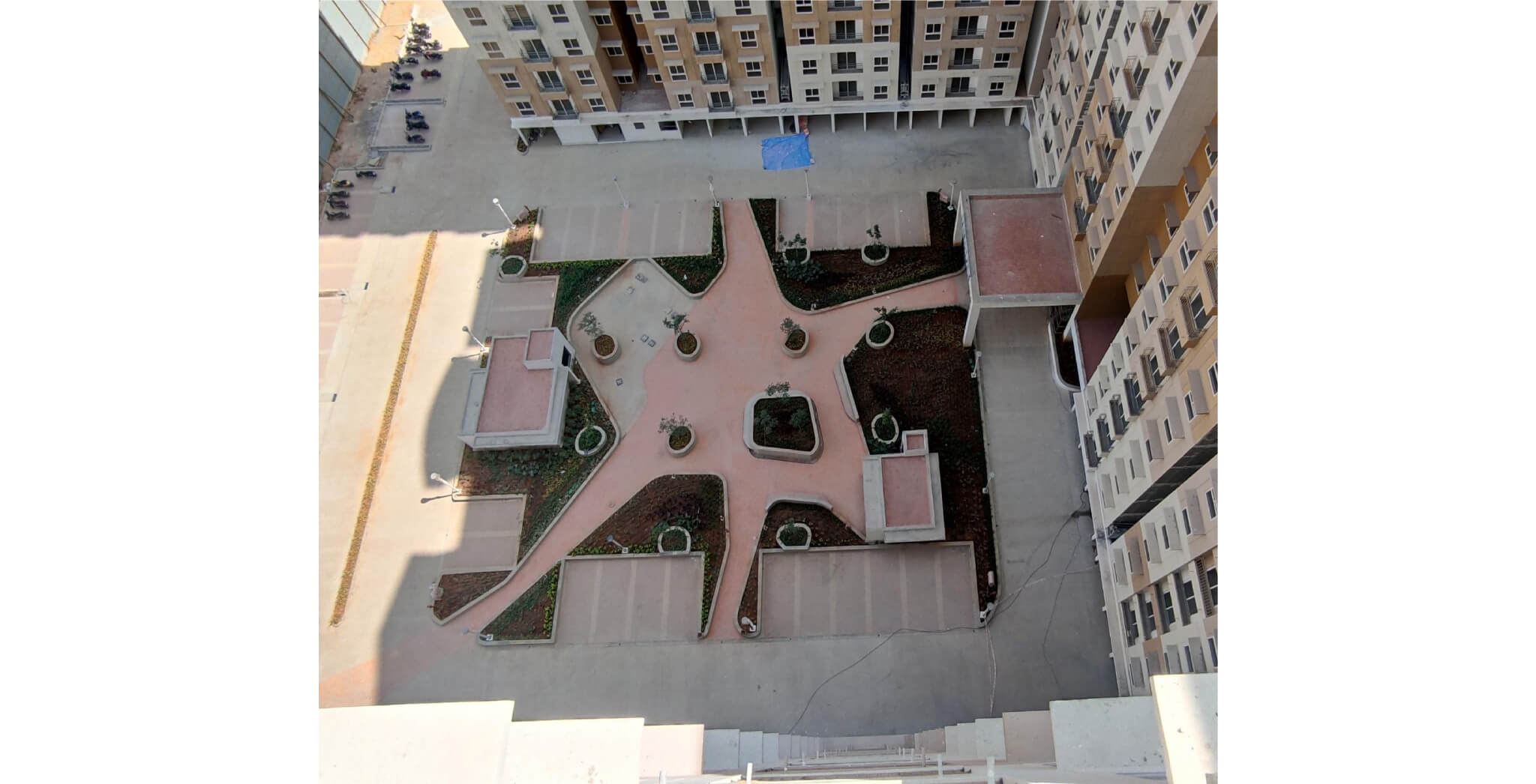

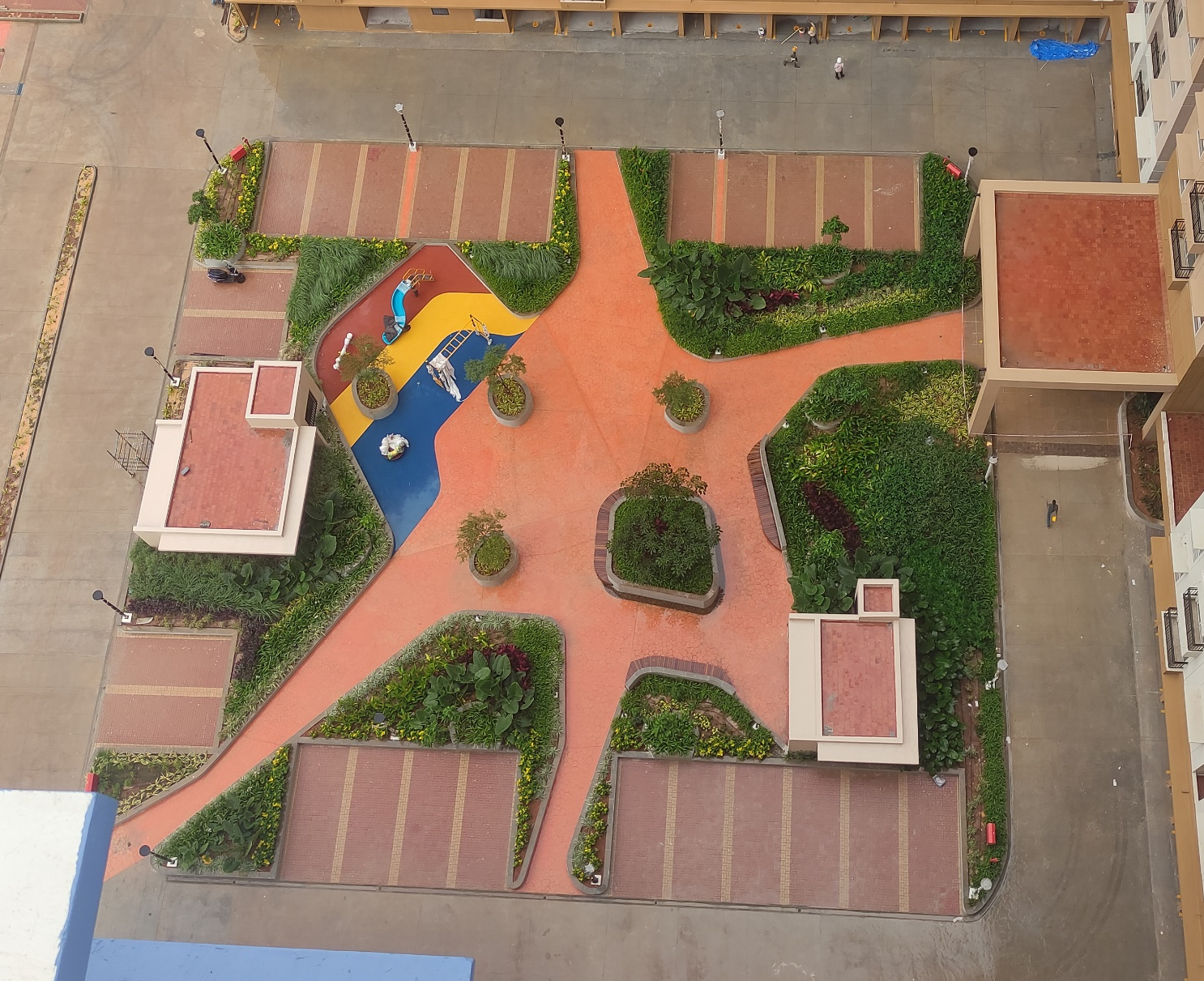

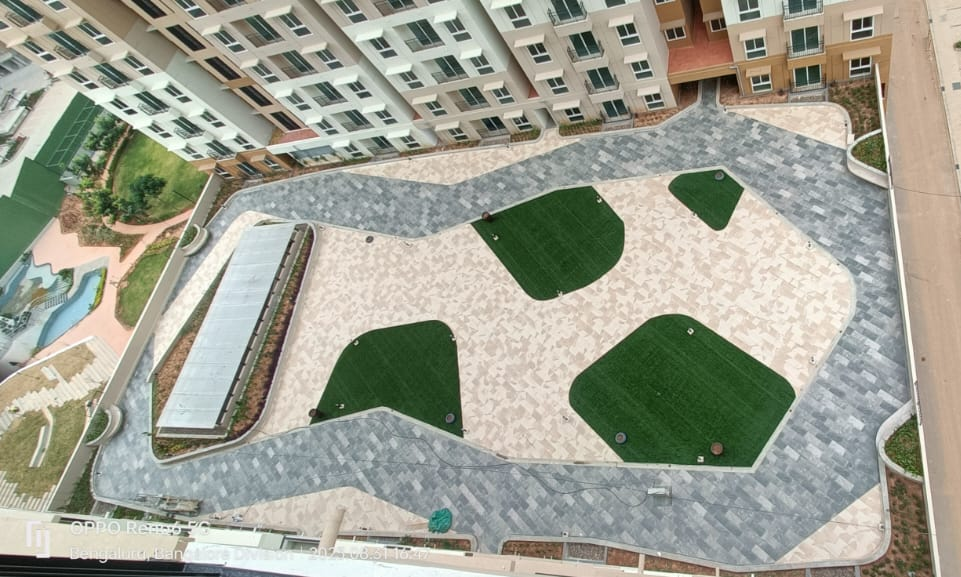

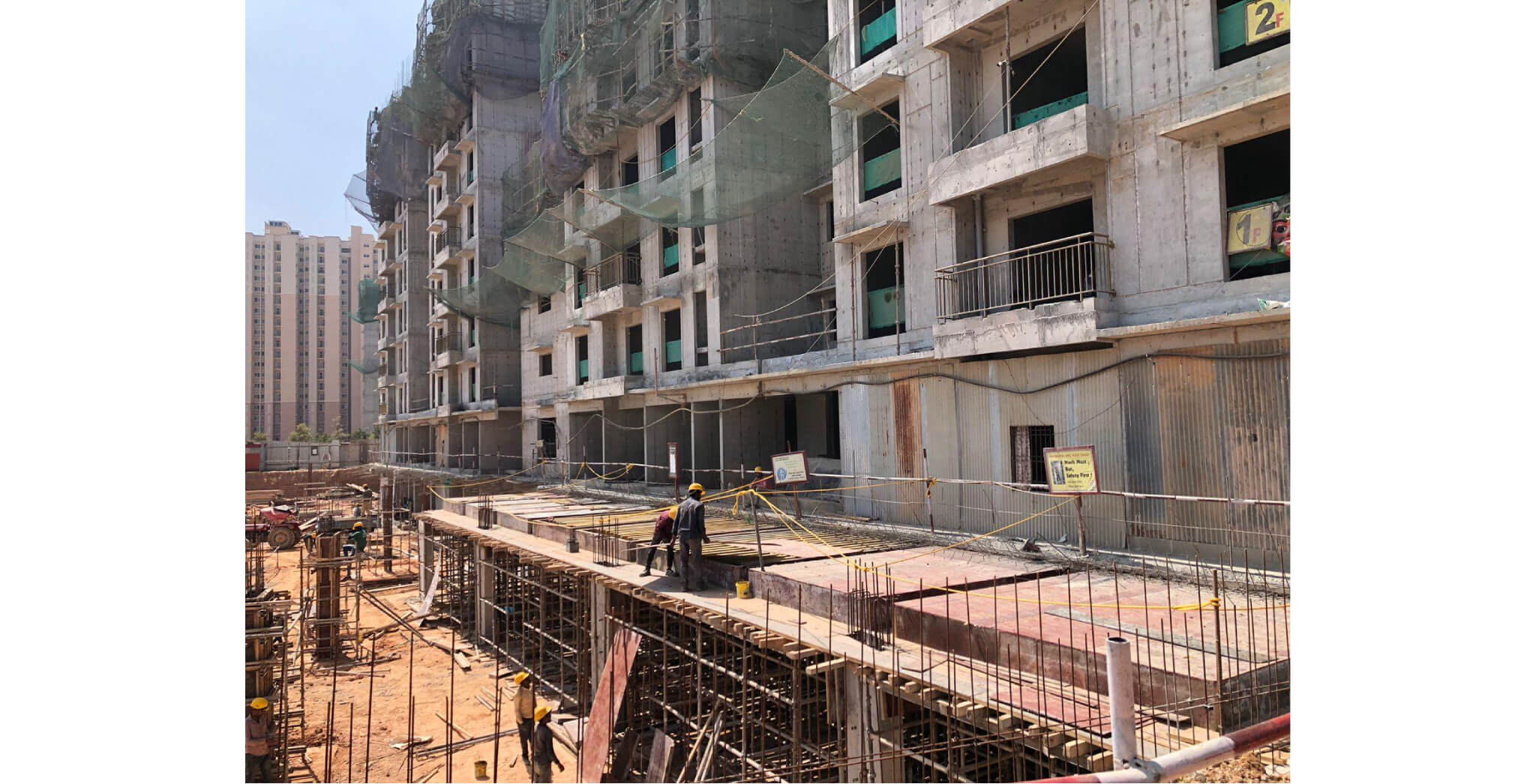

Podium Central Courtyard Area Hardscape and Softscape WIP - Jun 2025

Ground floor triple height lobby finishing WIP - Jun 2025

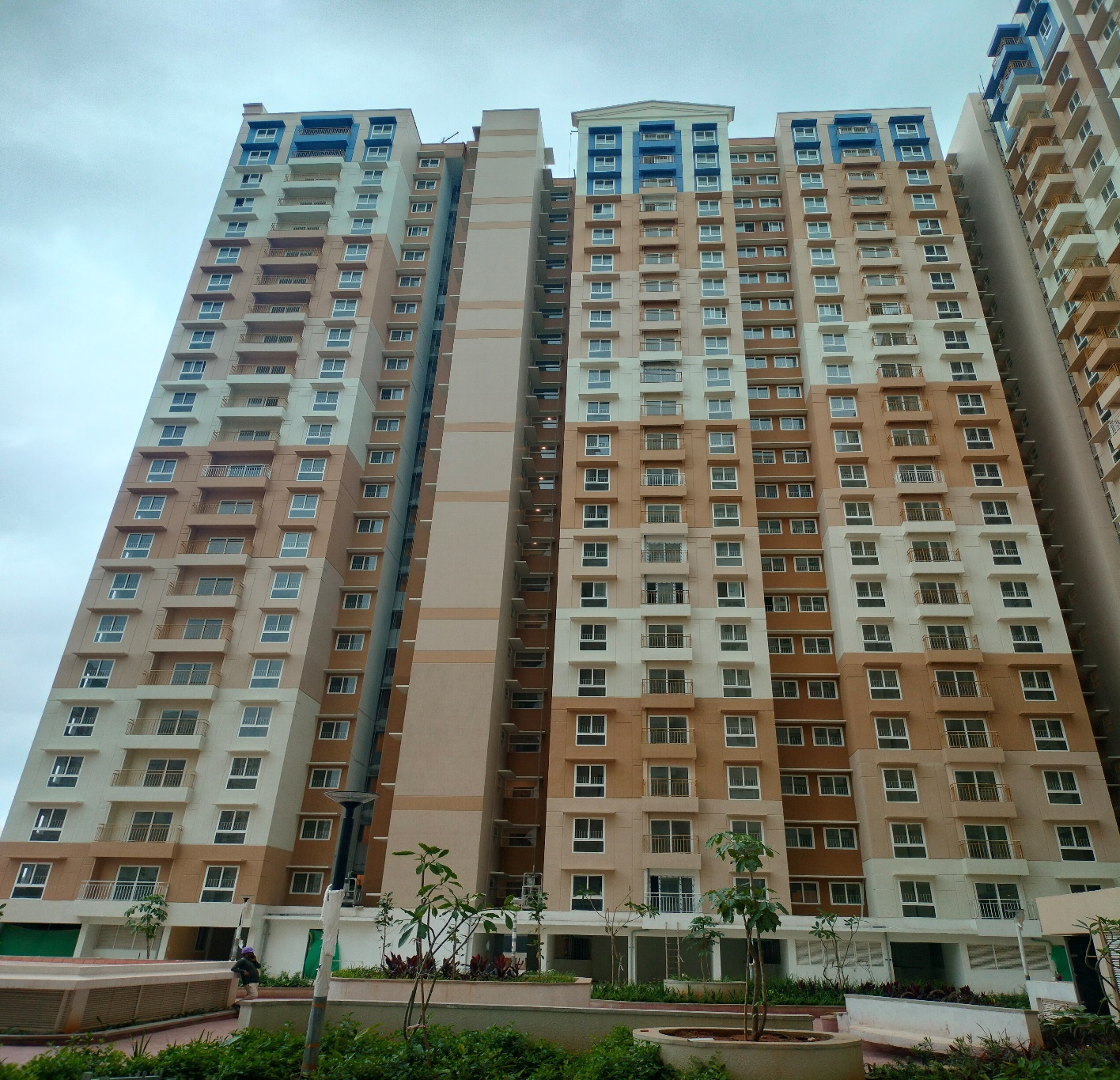

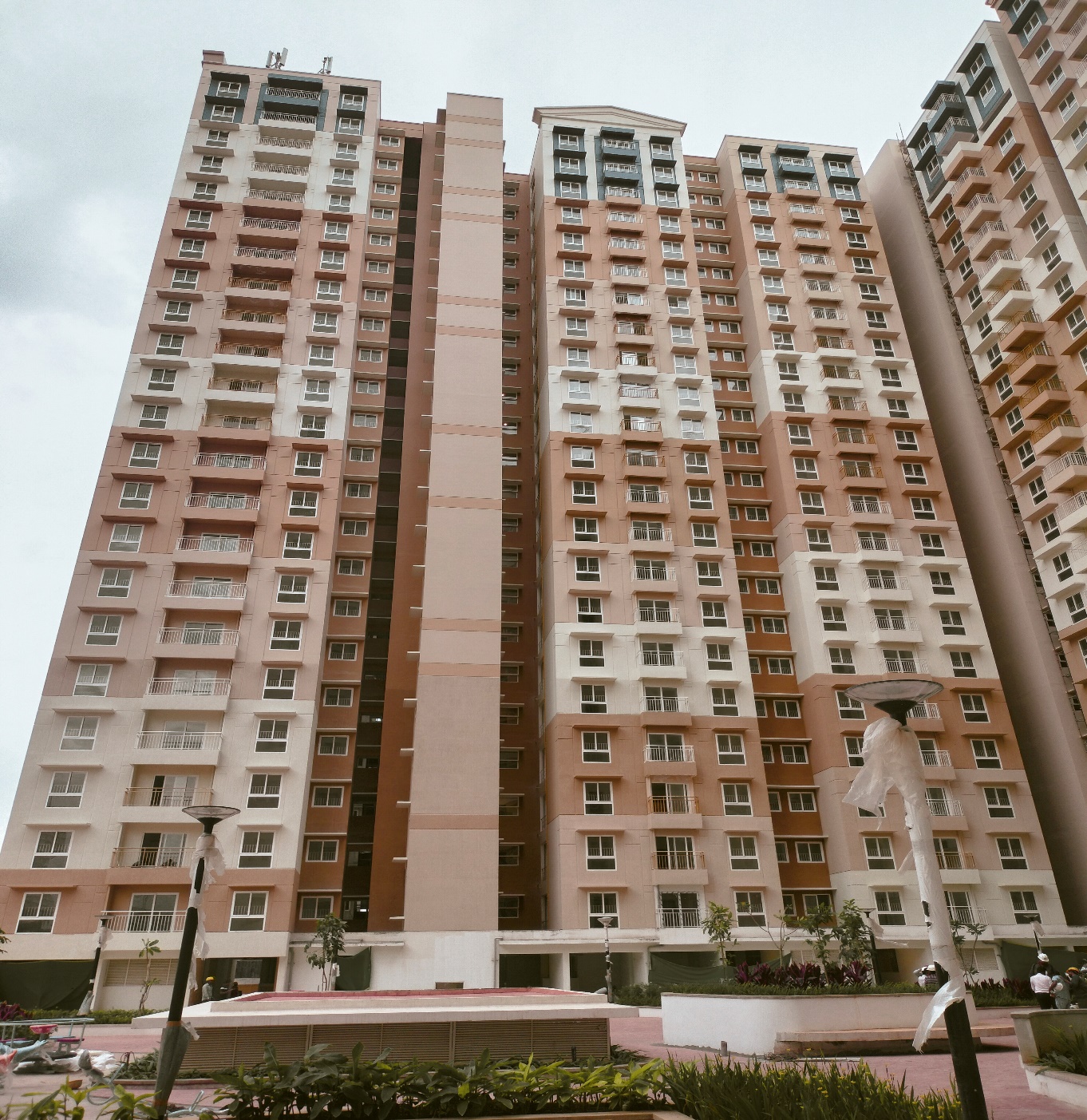

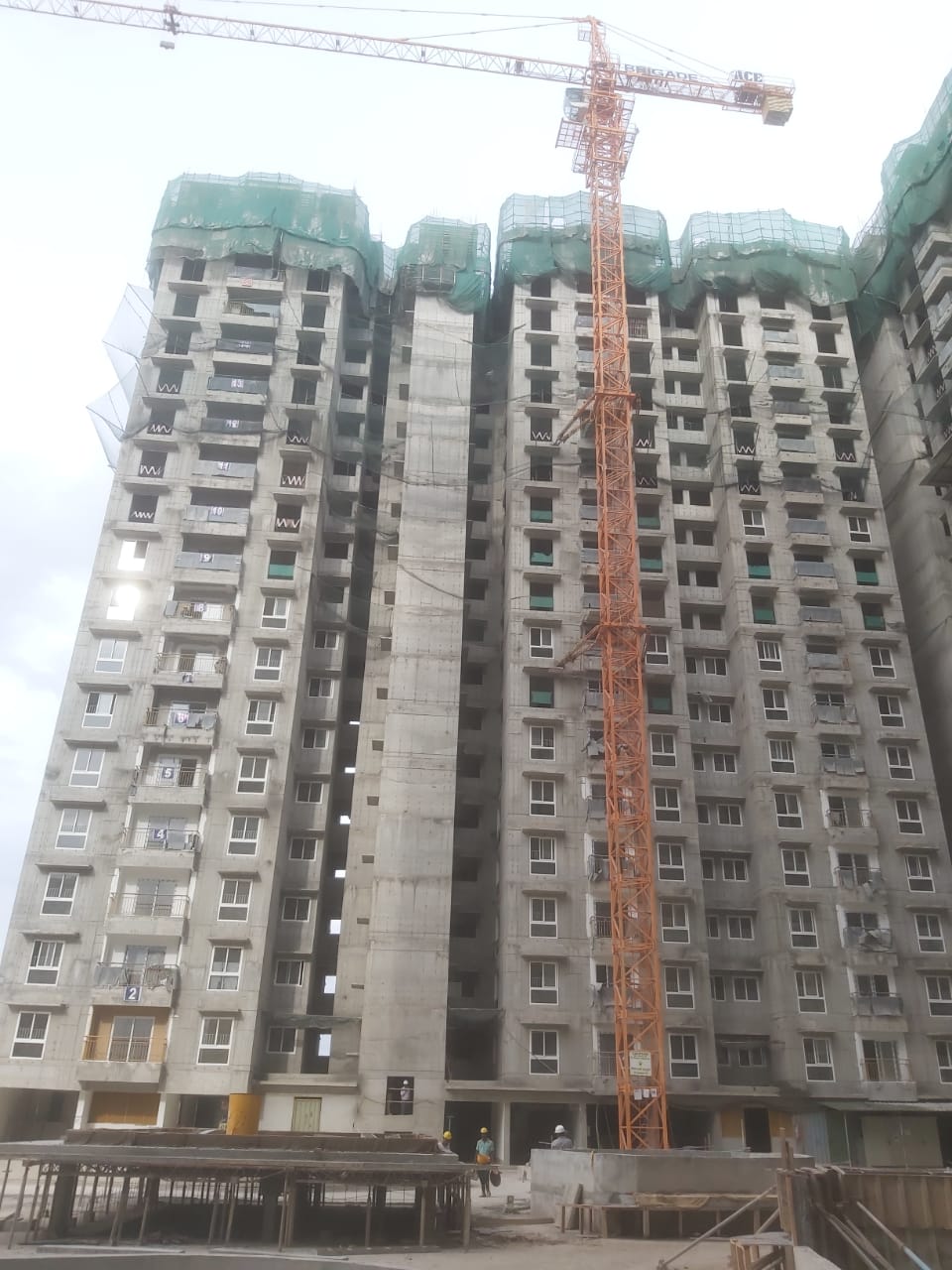

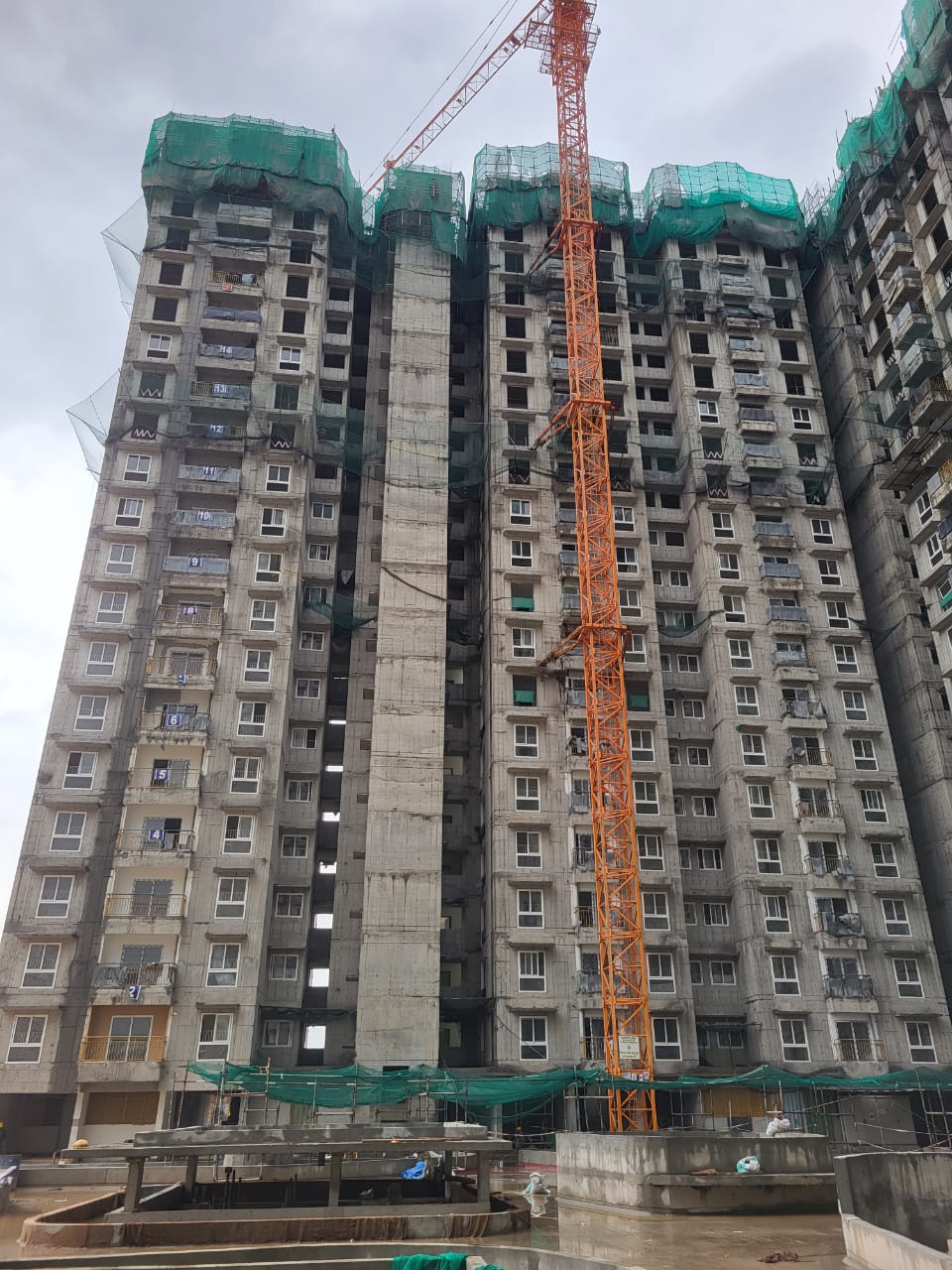

East Wing - Jun 2025

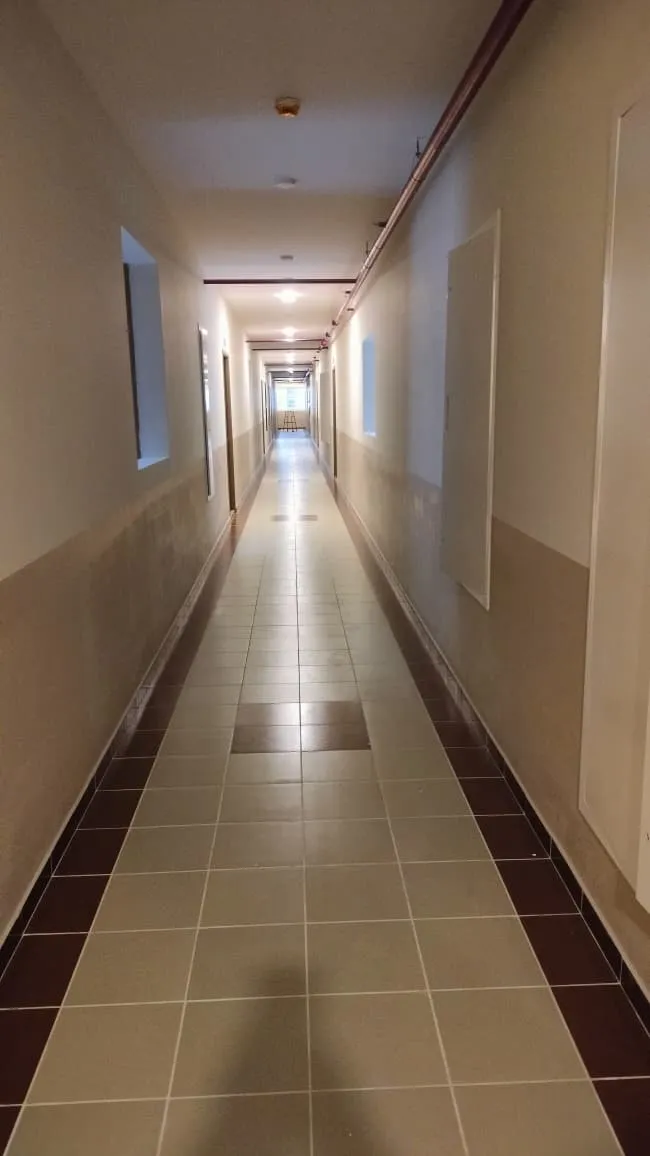

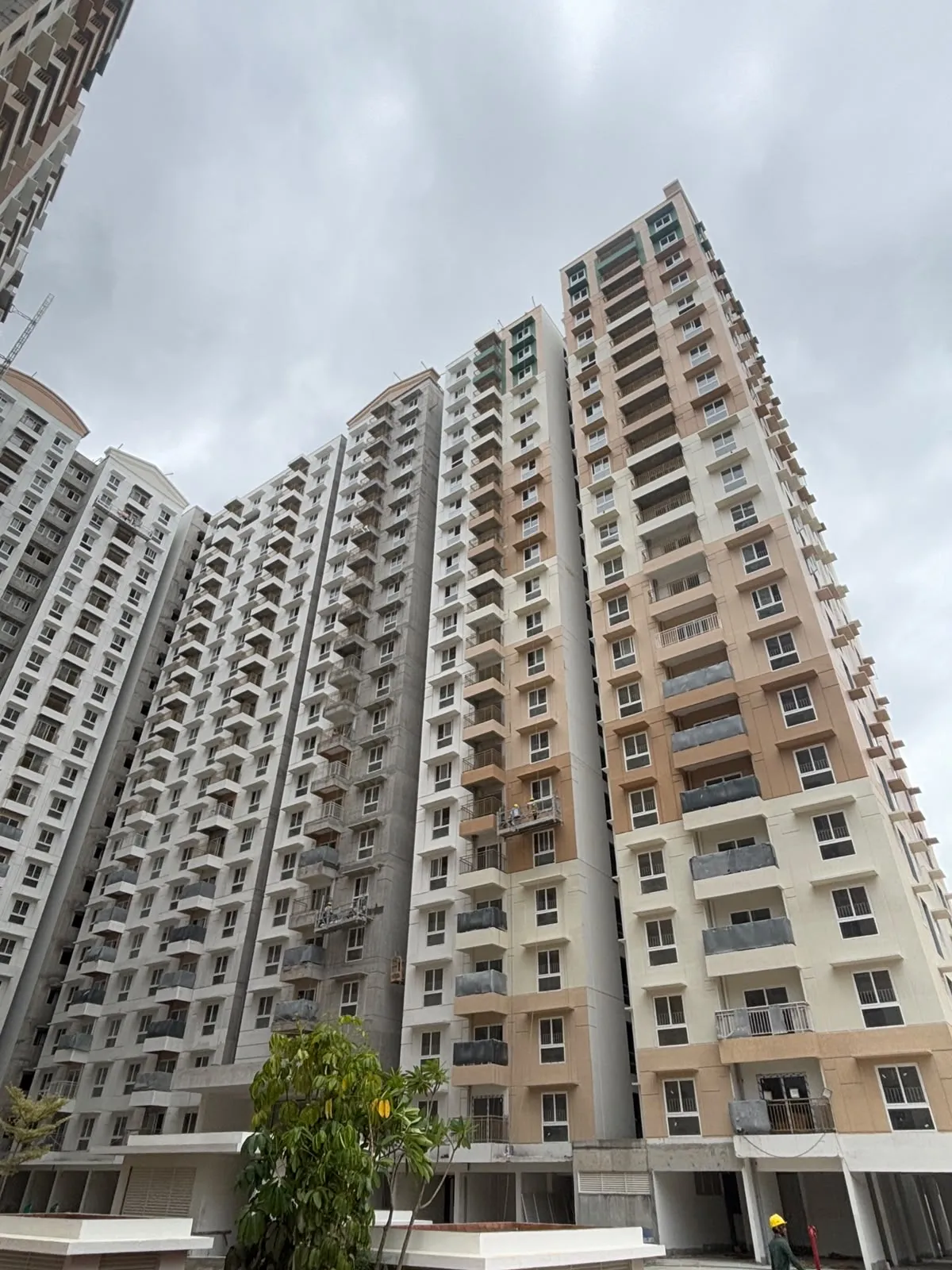

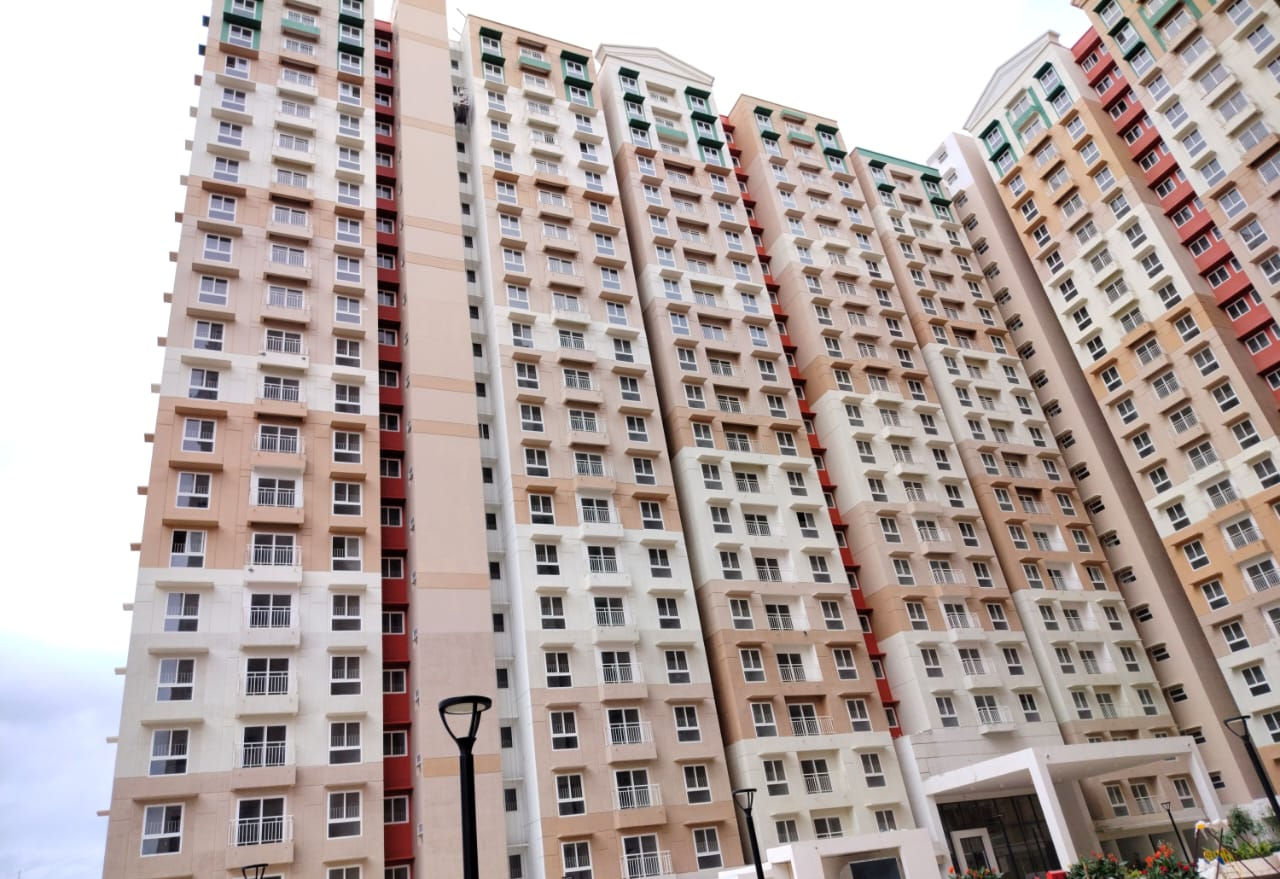

Finishing Work in Progress - Jun 2025

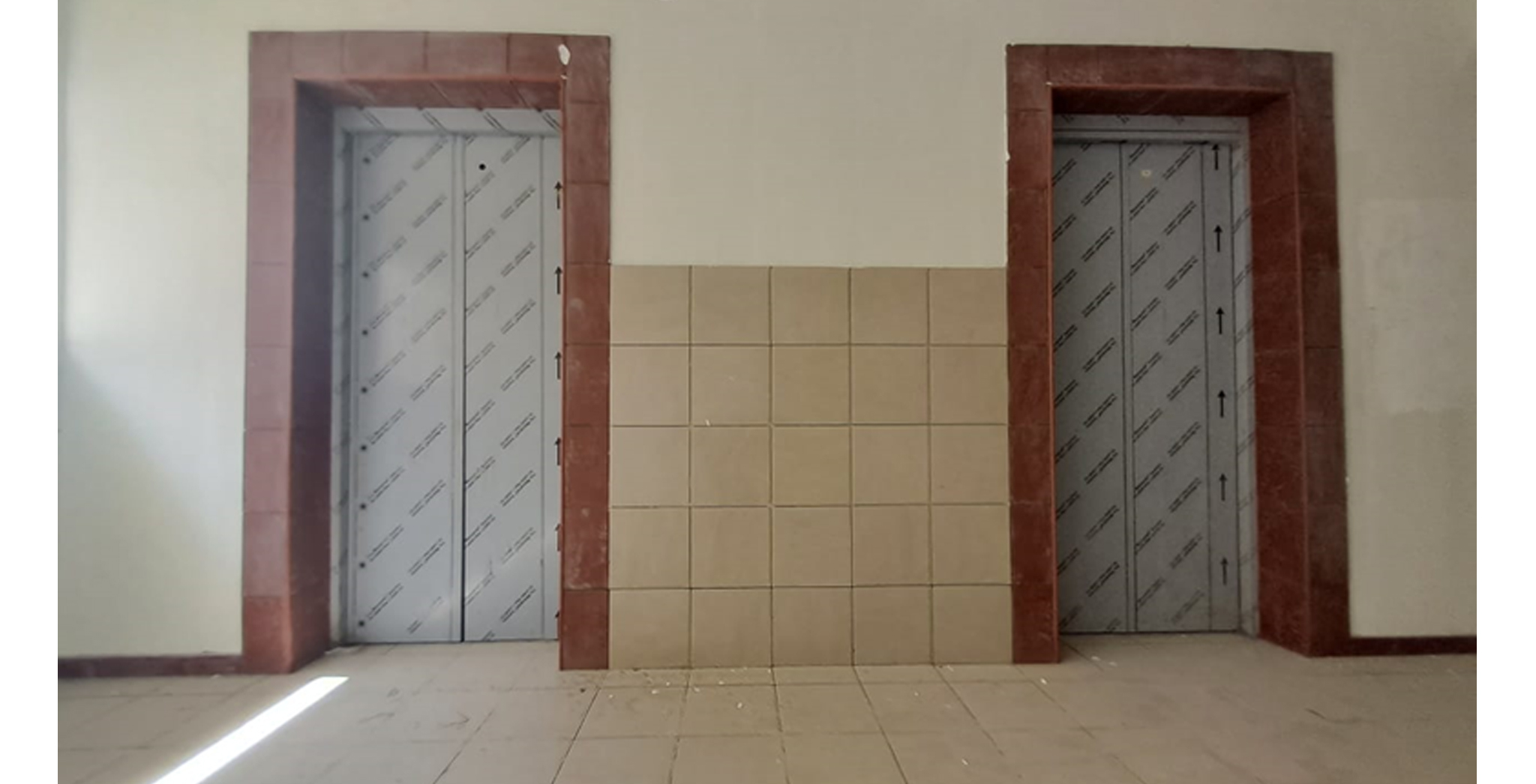

PHE shaft door fixing is completed - Jun 2025

Finishing Work in Progress - Jun 2025

Ground floor corridor Painting WIP - Jun 2025

Podium Central Courtyard Area Hardscape and Softs cape WIP - Jun 2025

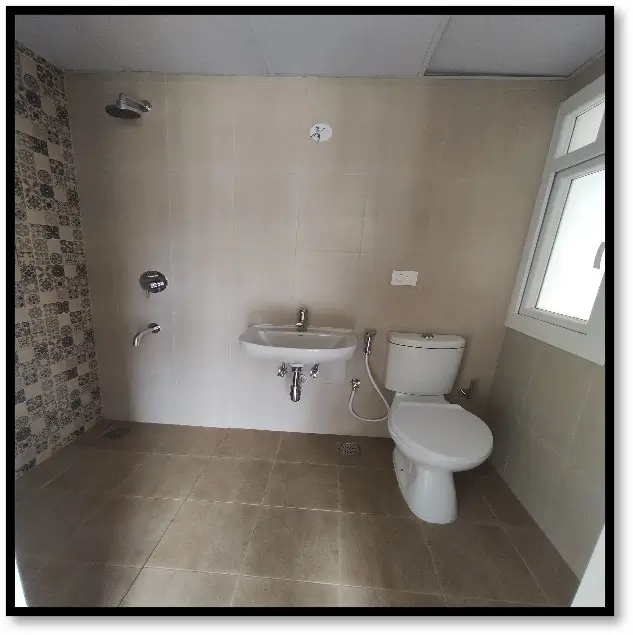

Finishing Work in Progress - Jun 2025

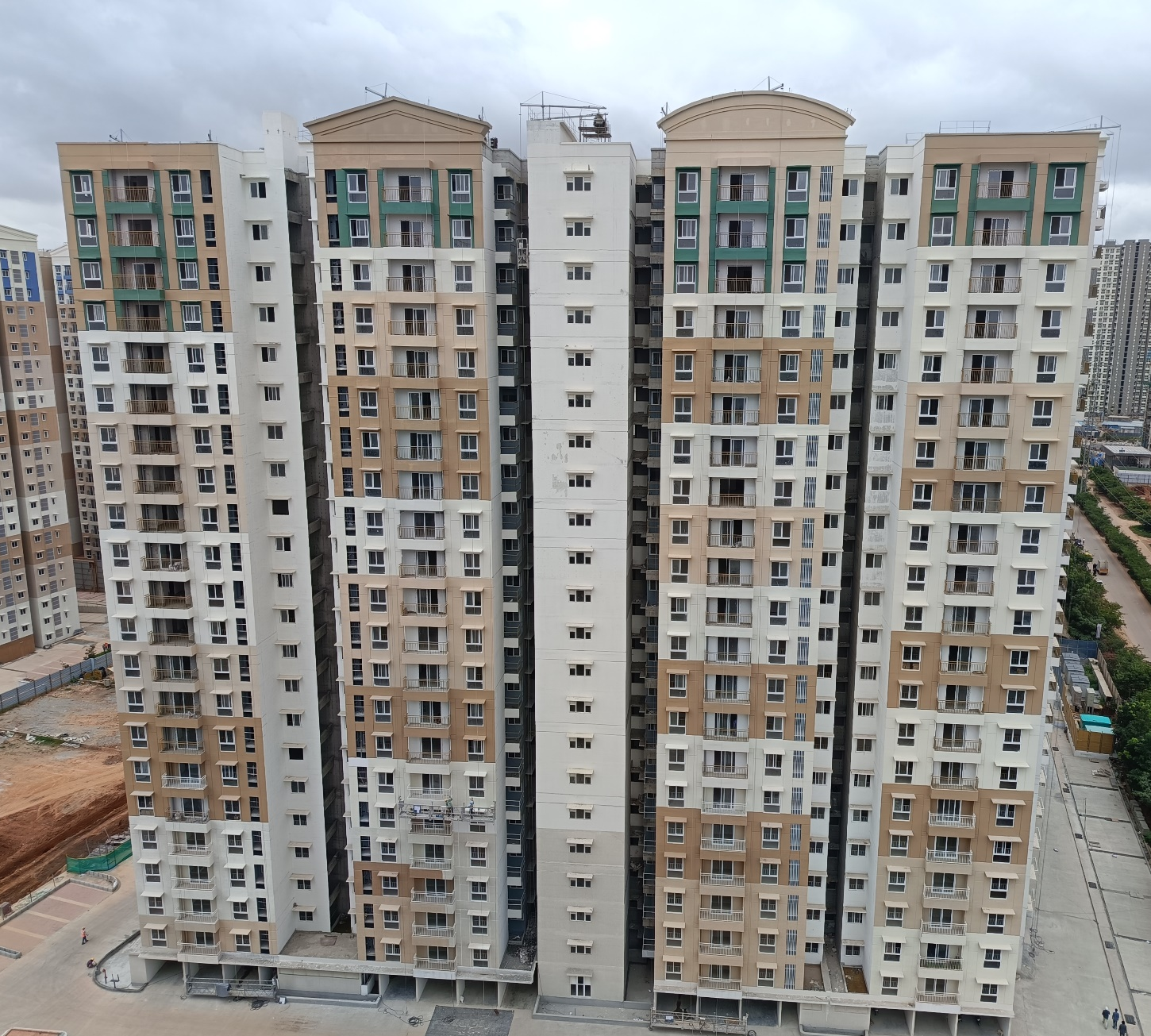

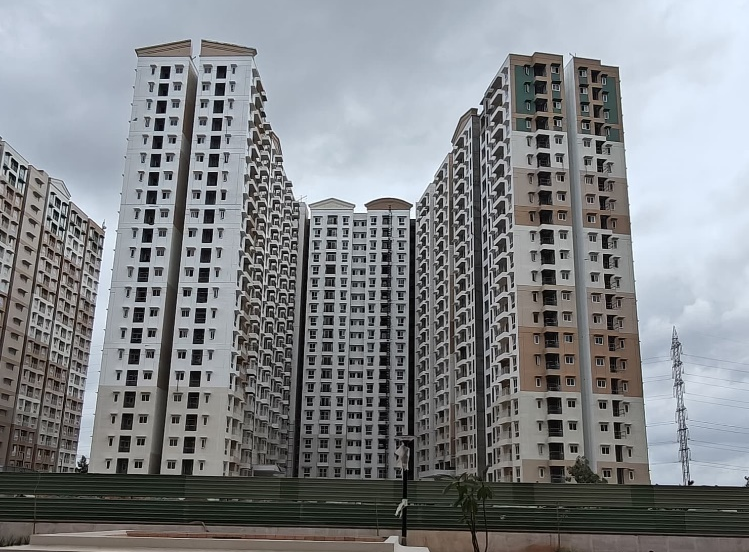

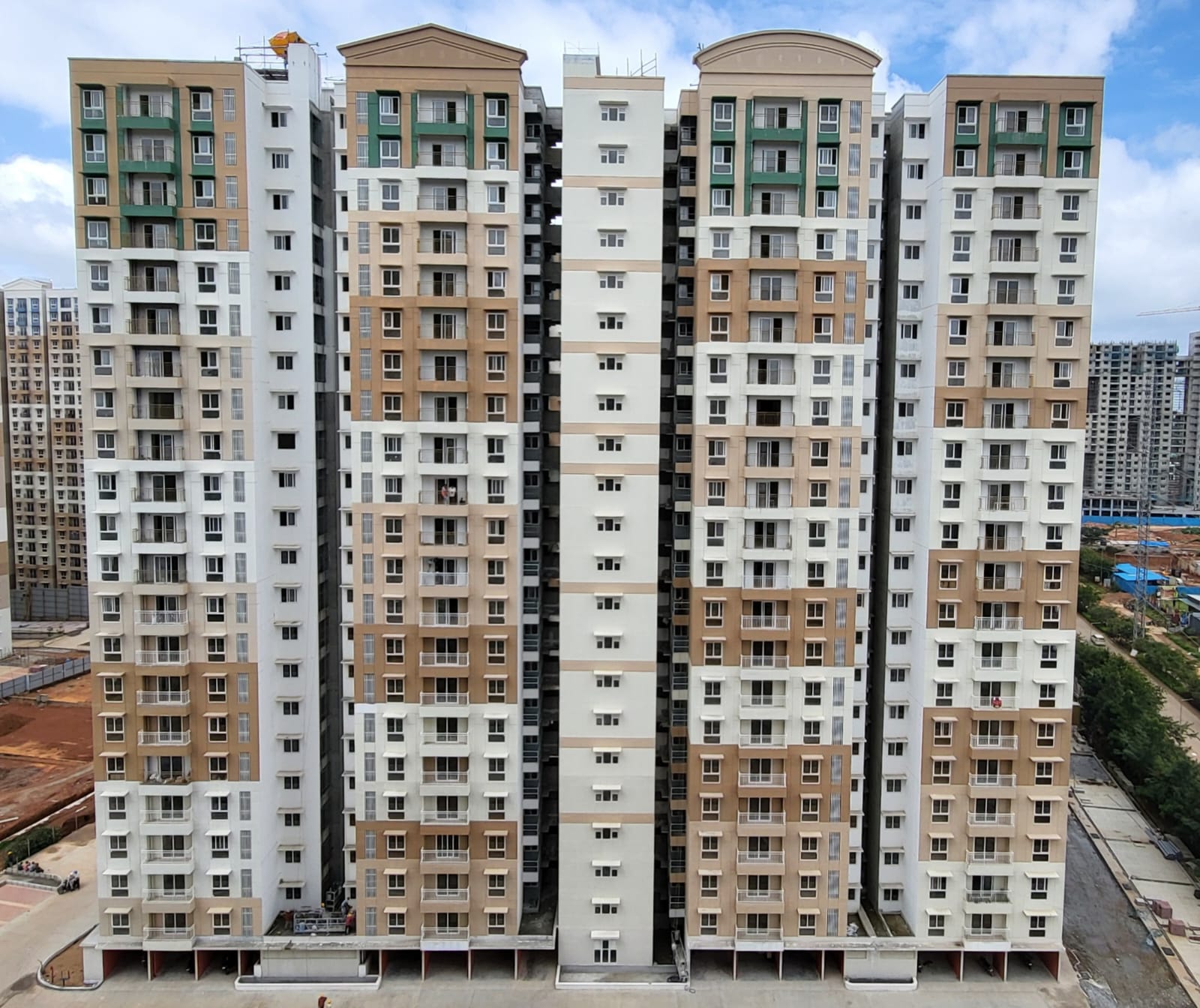

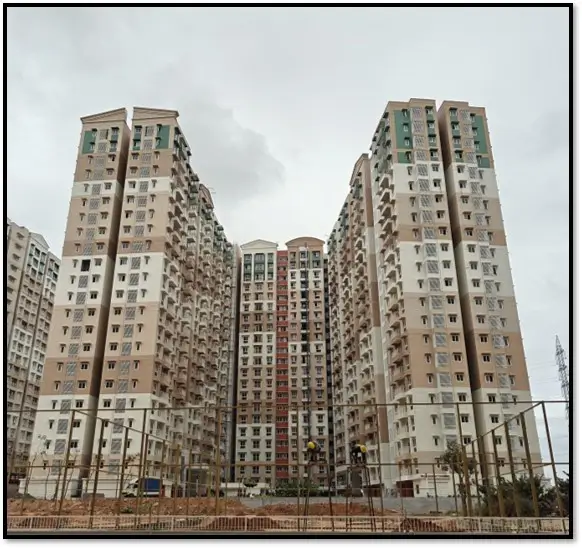

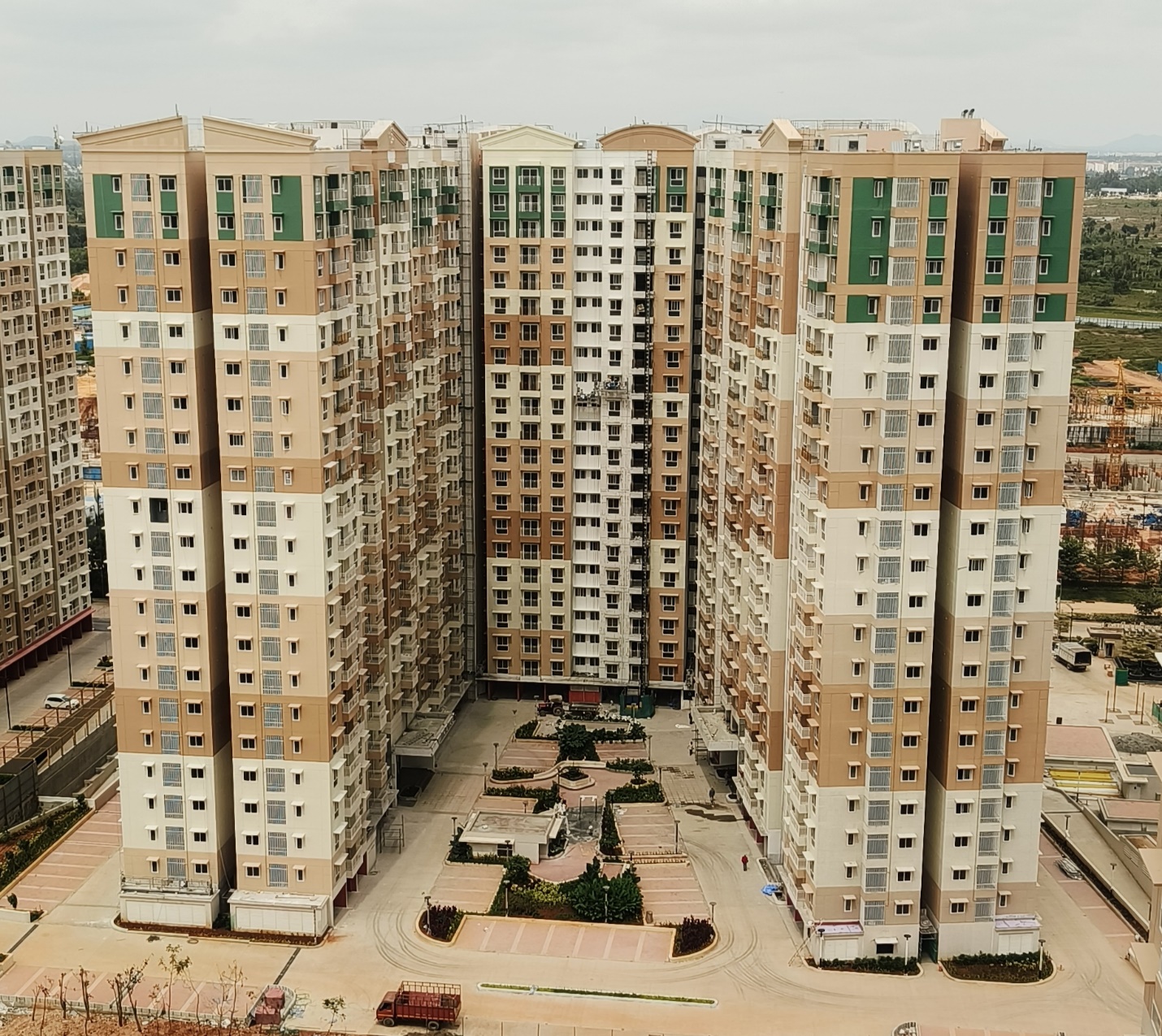

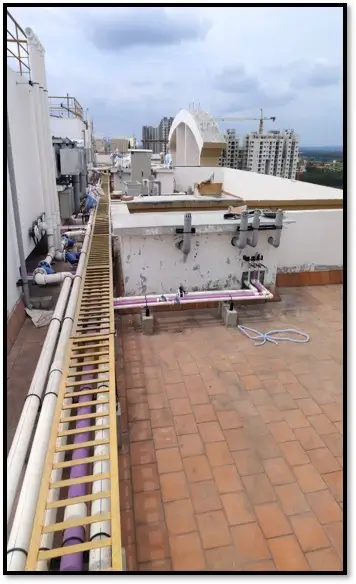

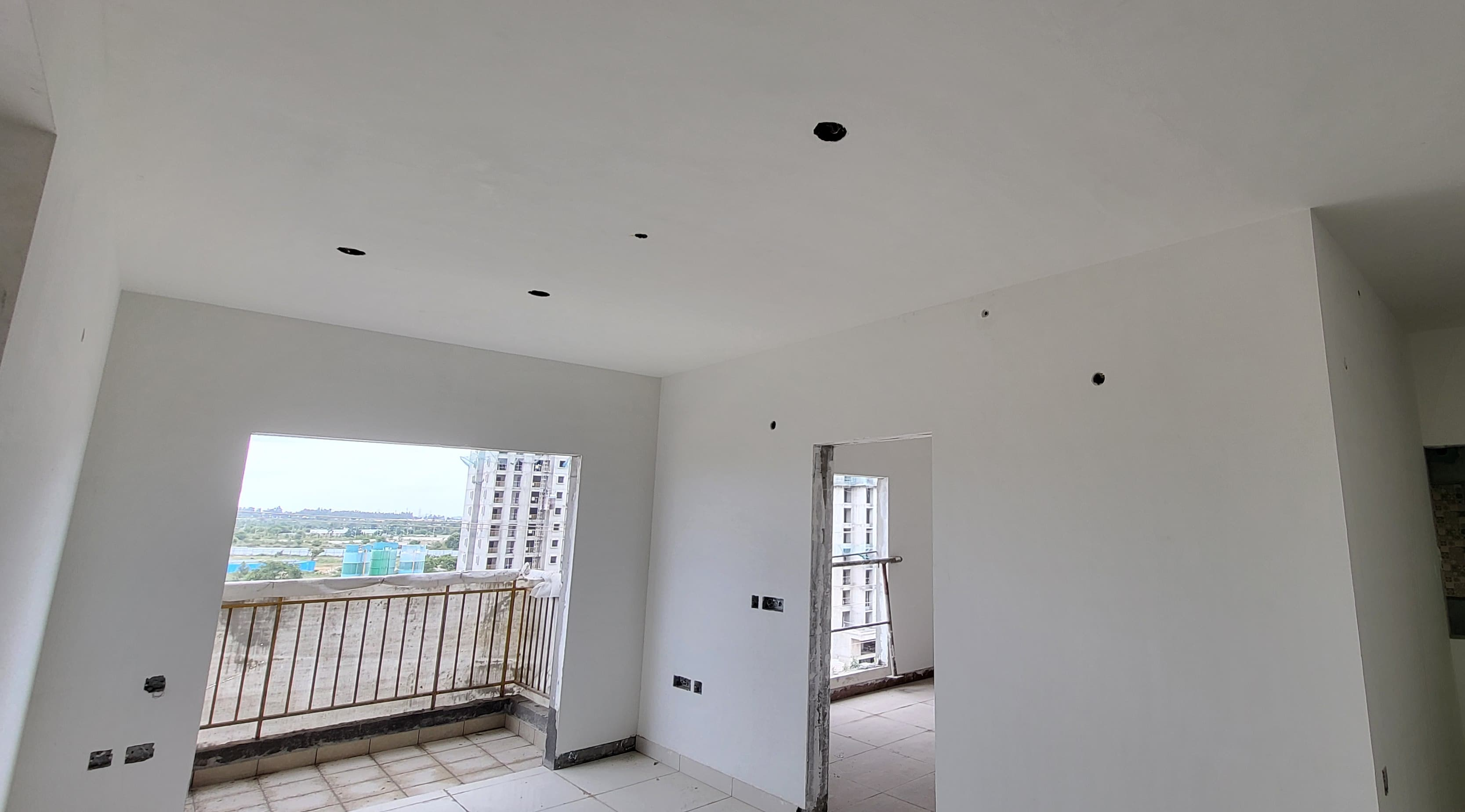

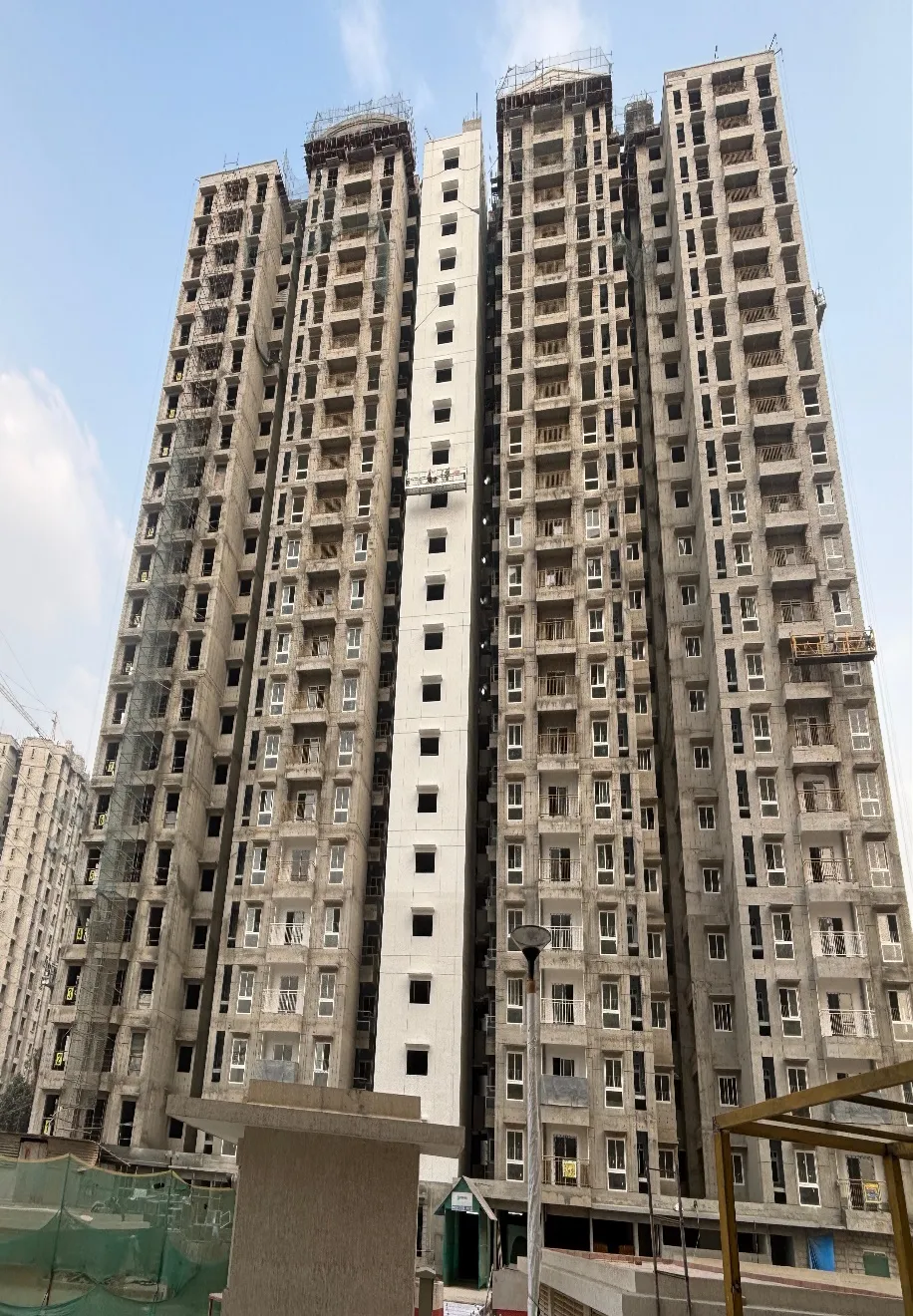

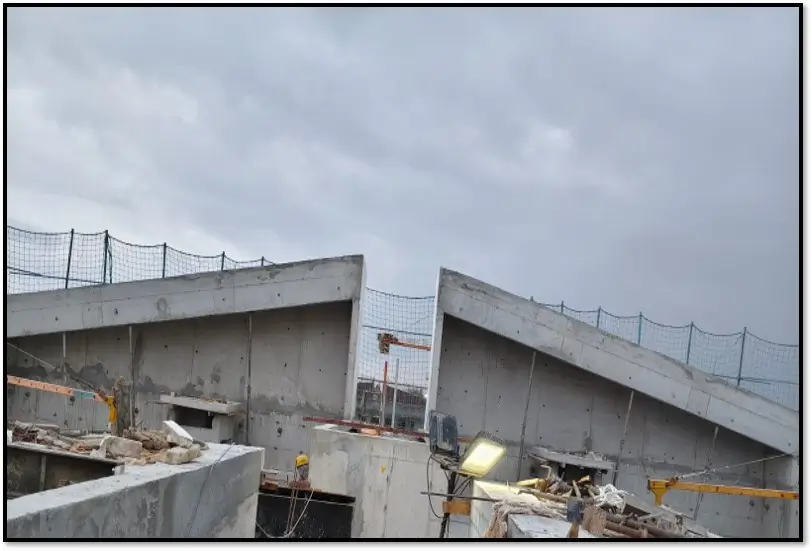

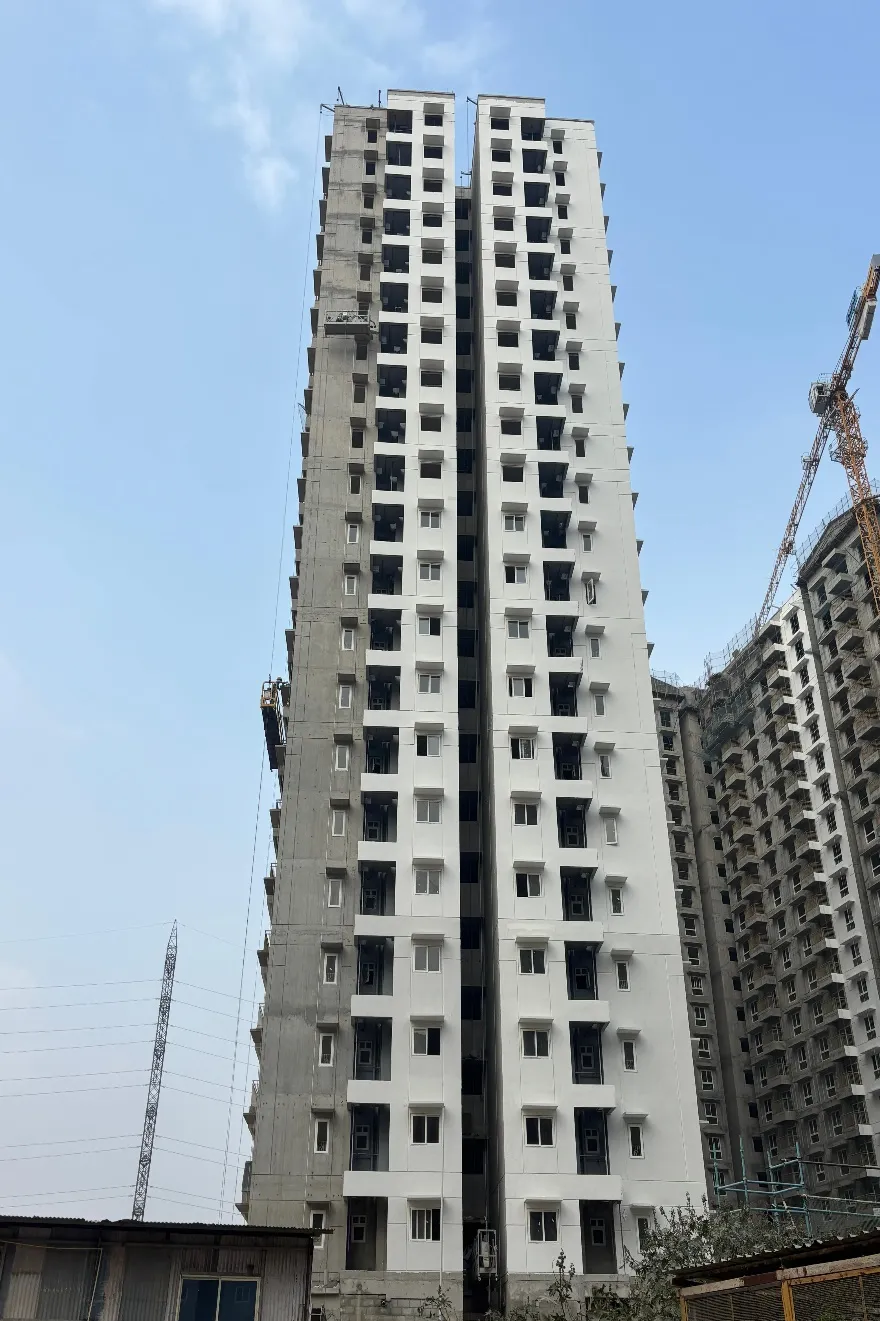

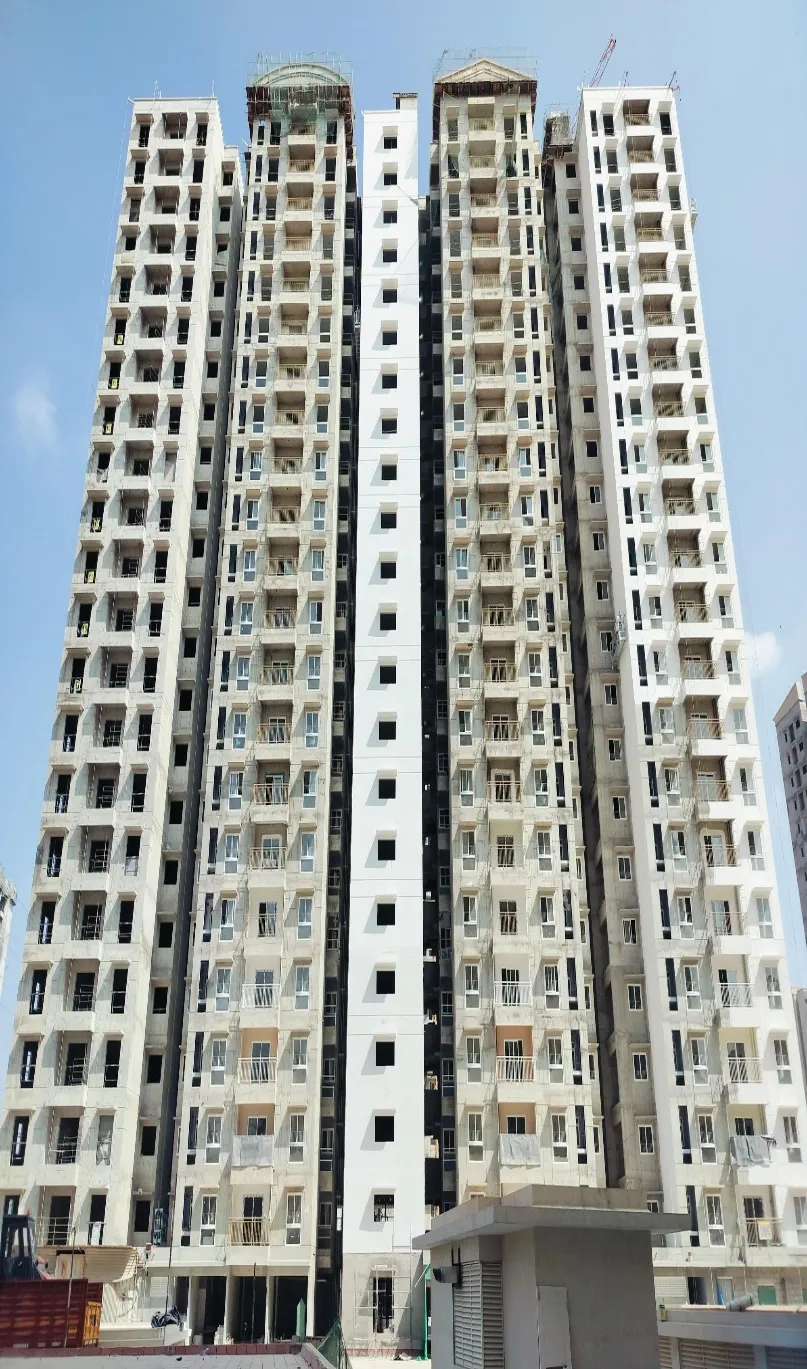

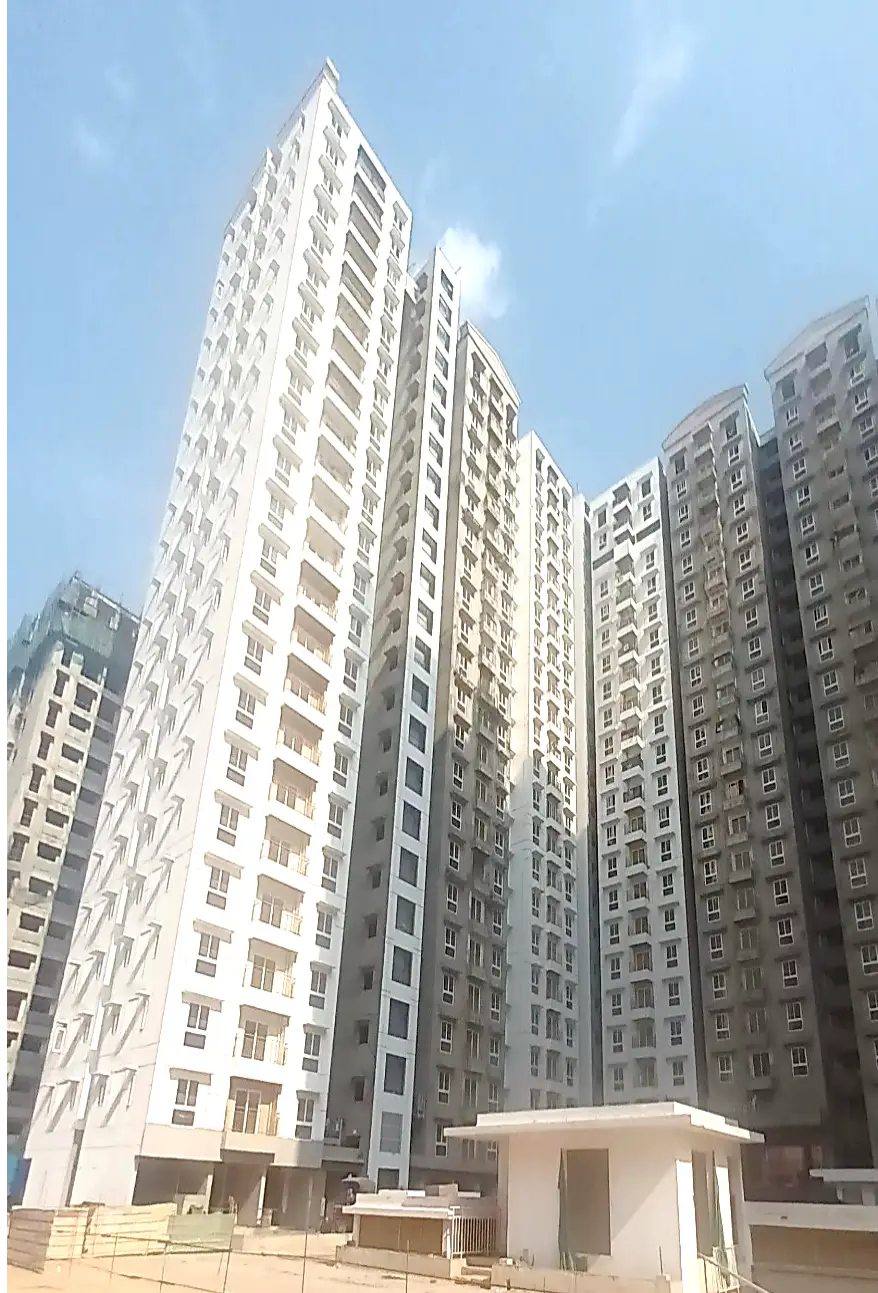

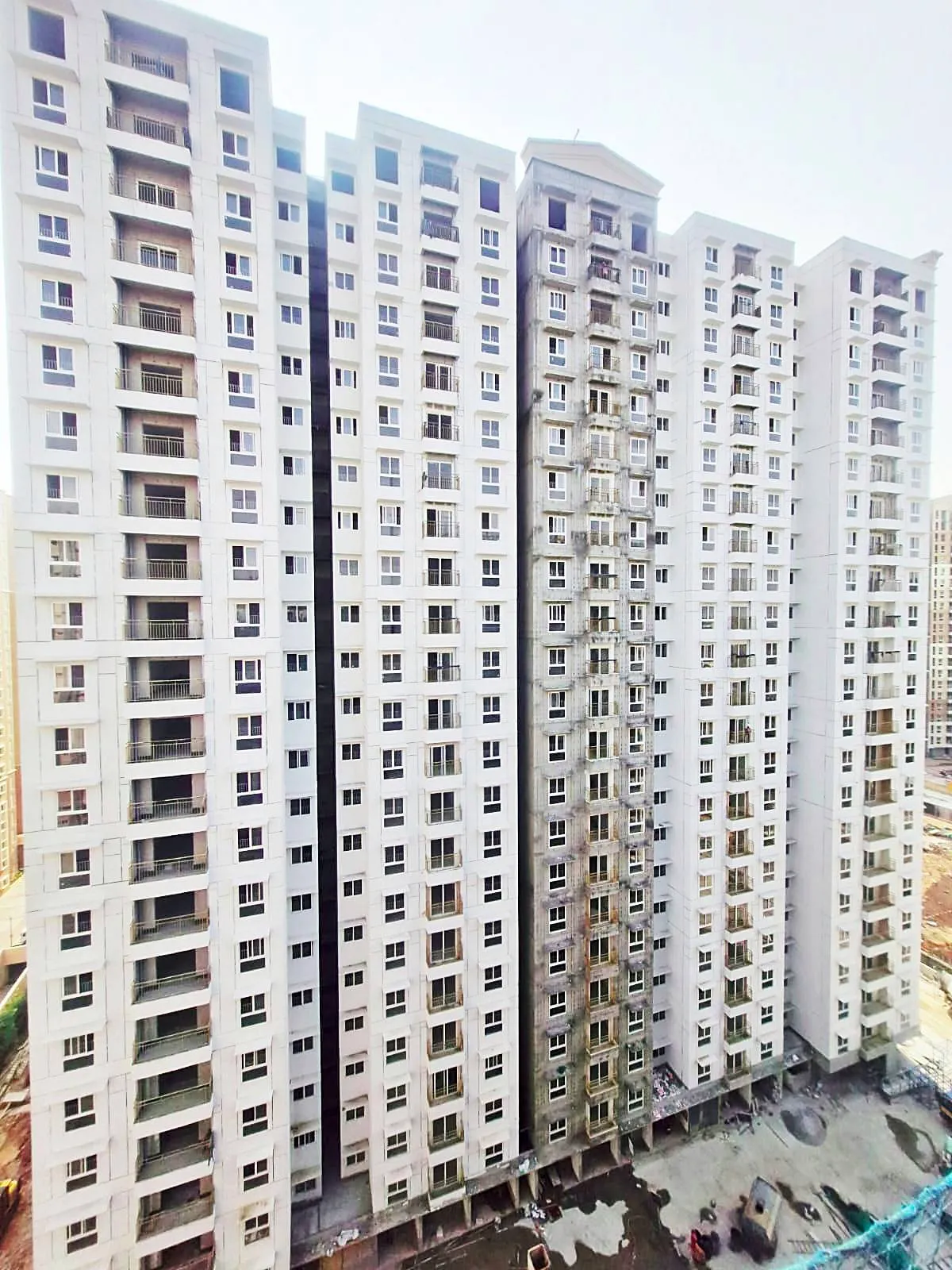

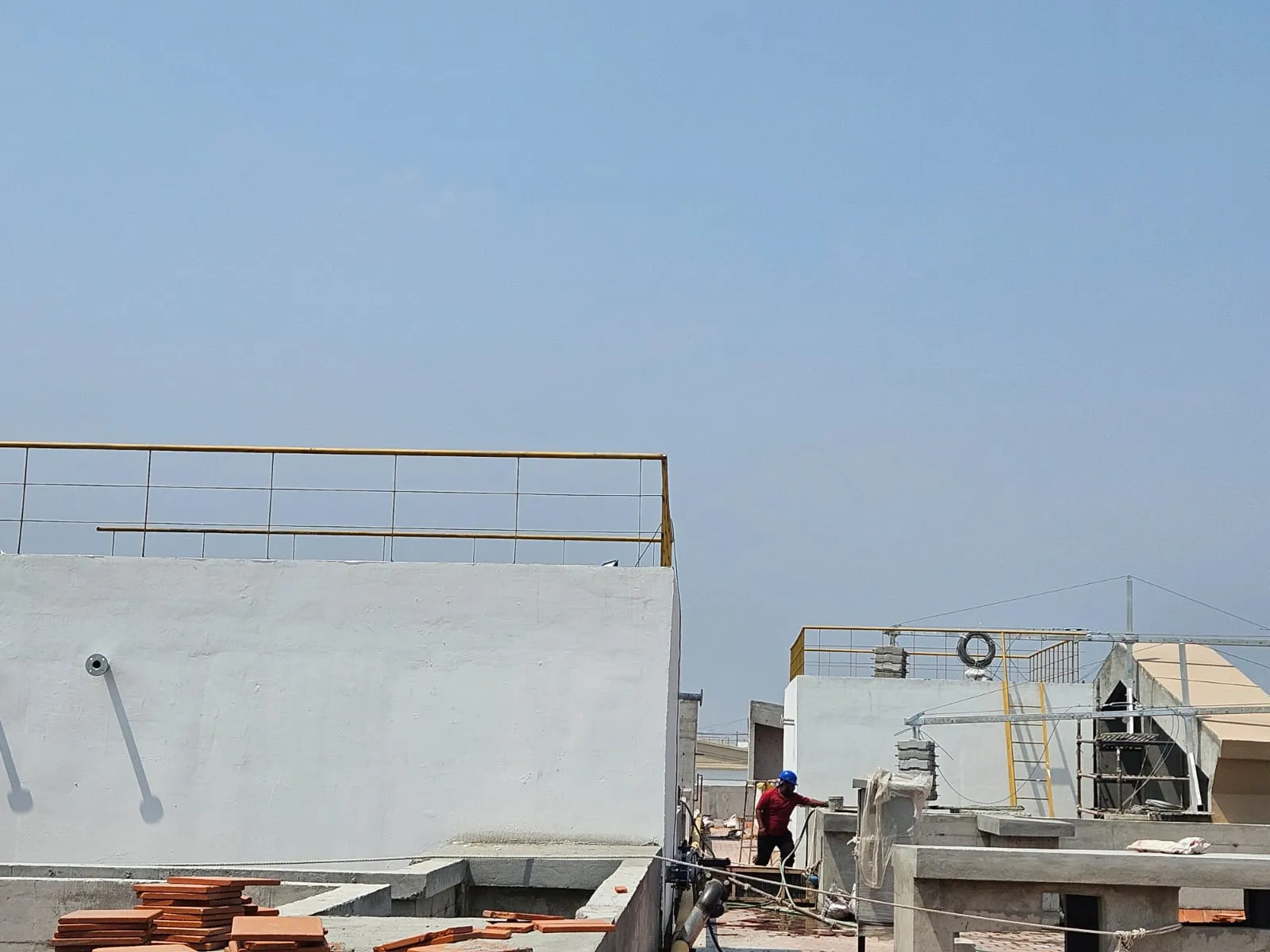

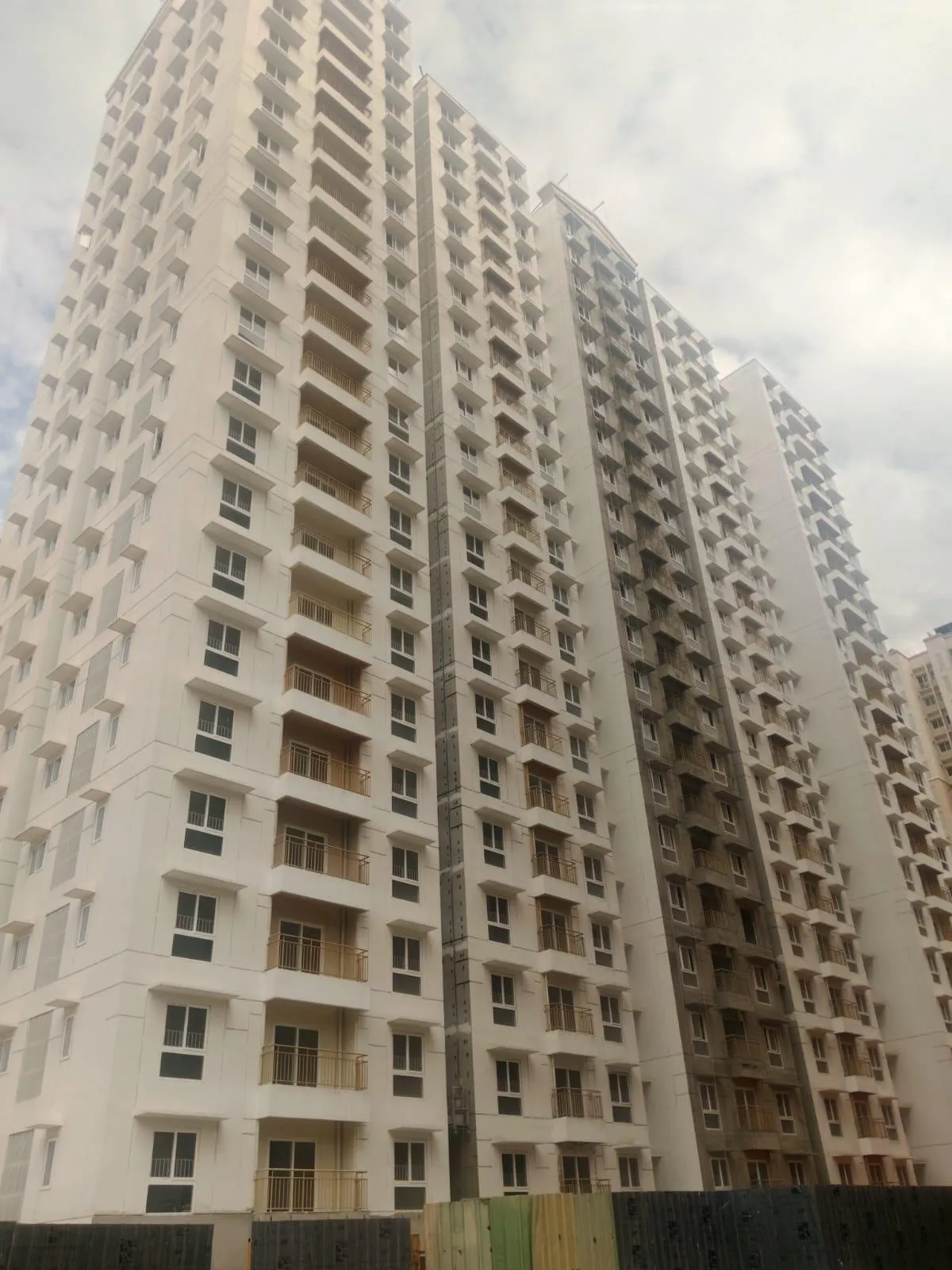

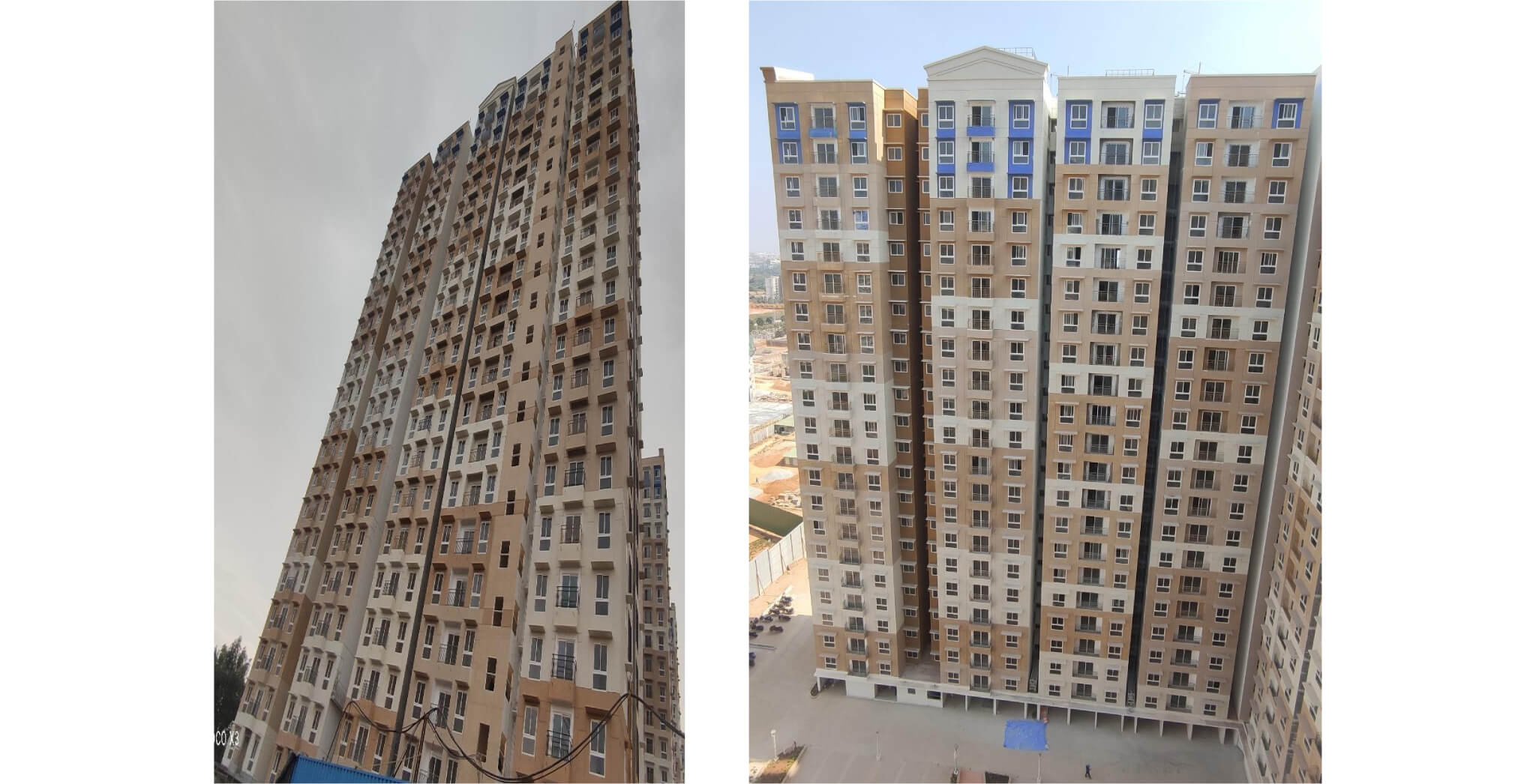

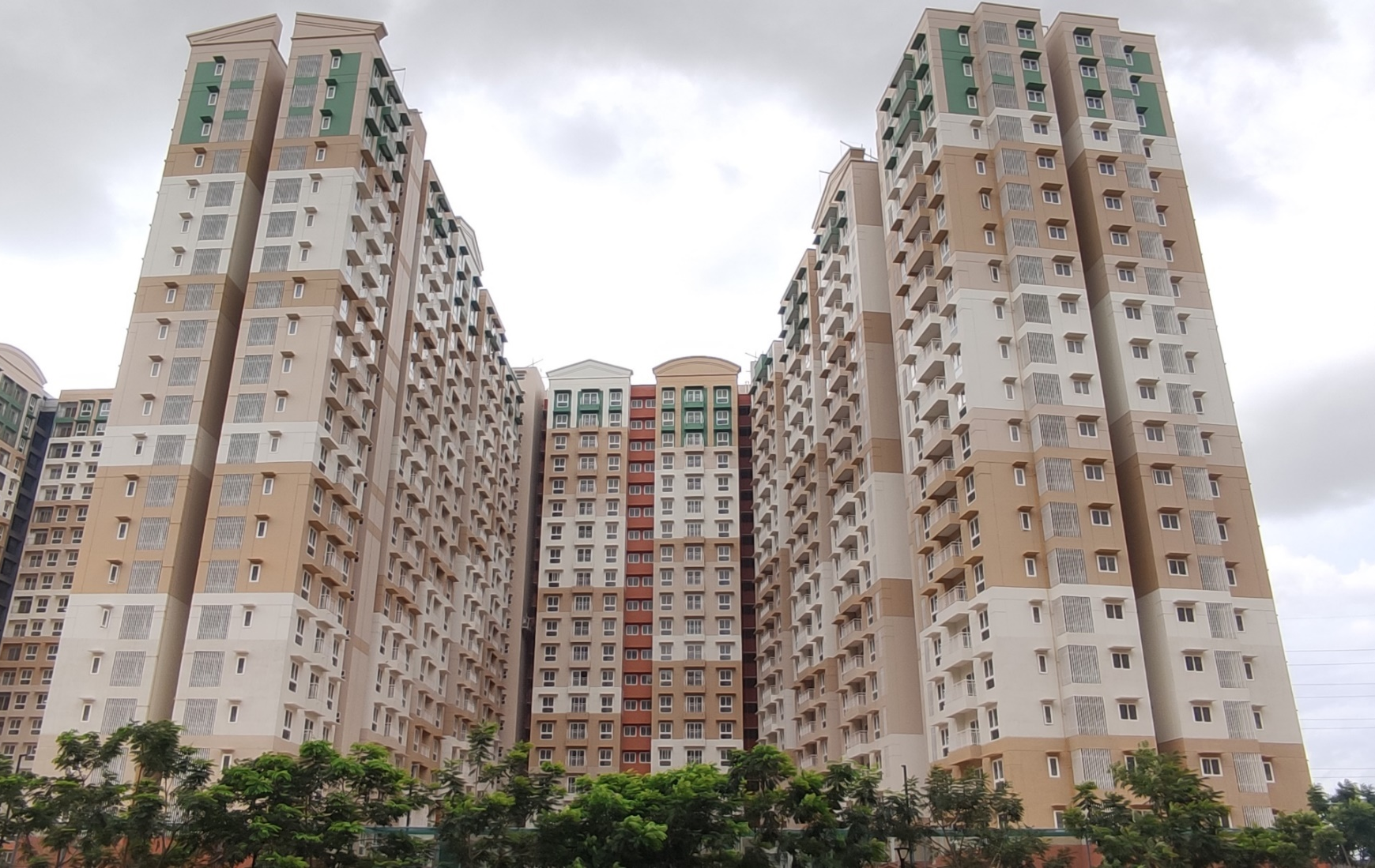

External painting Works in progress - Jun 2025

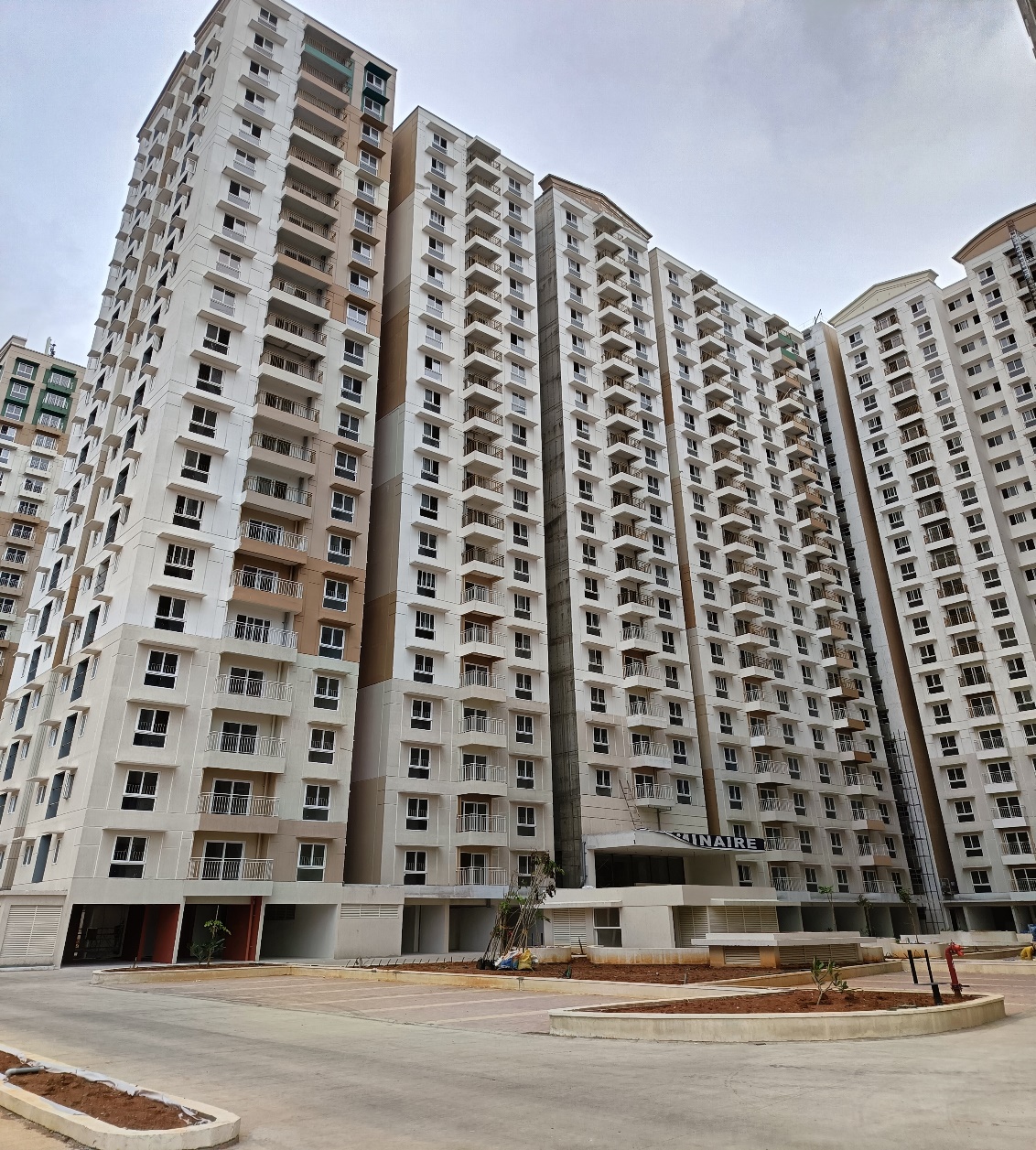

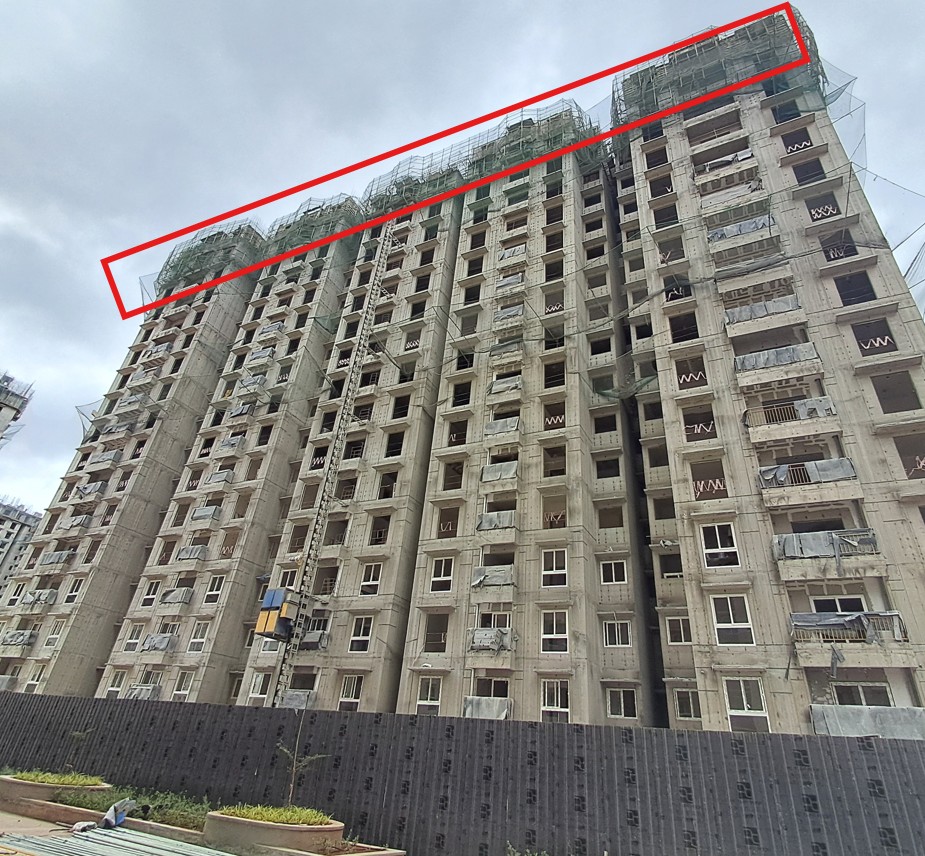

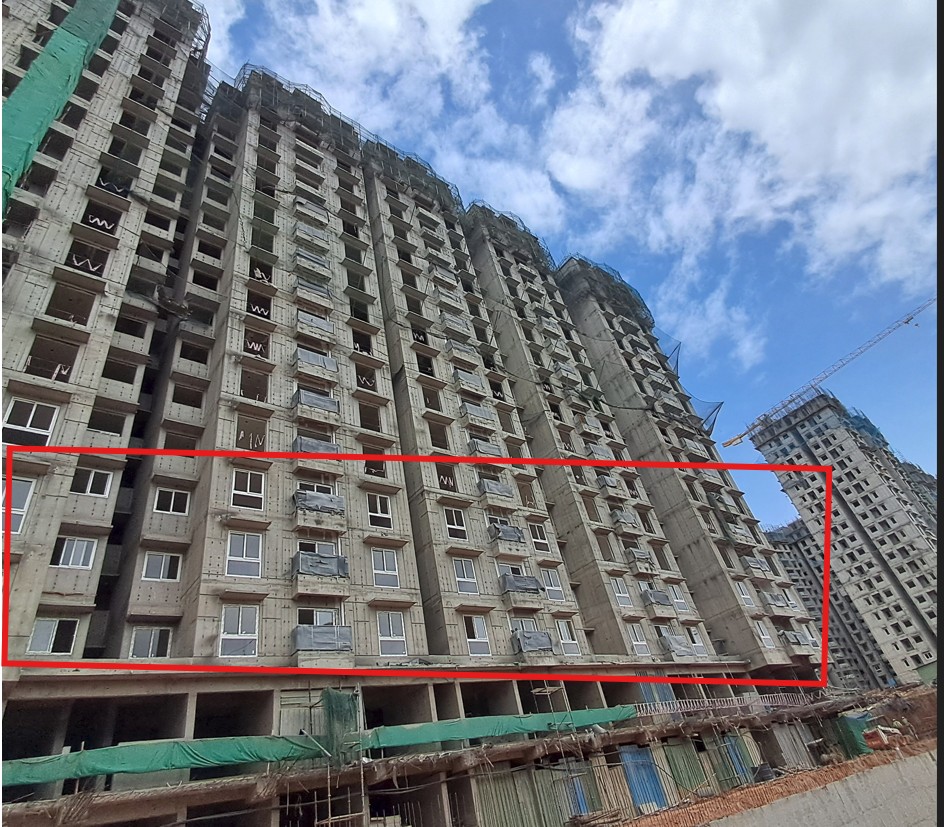

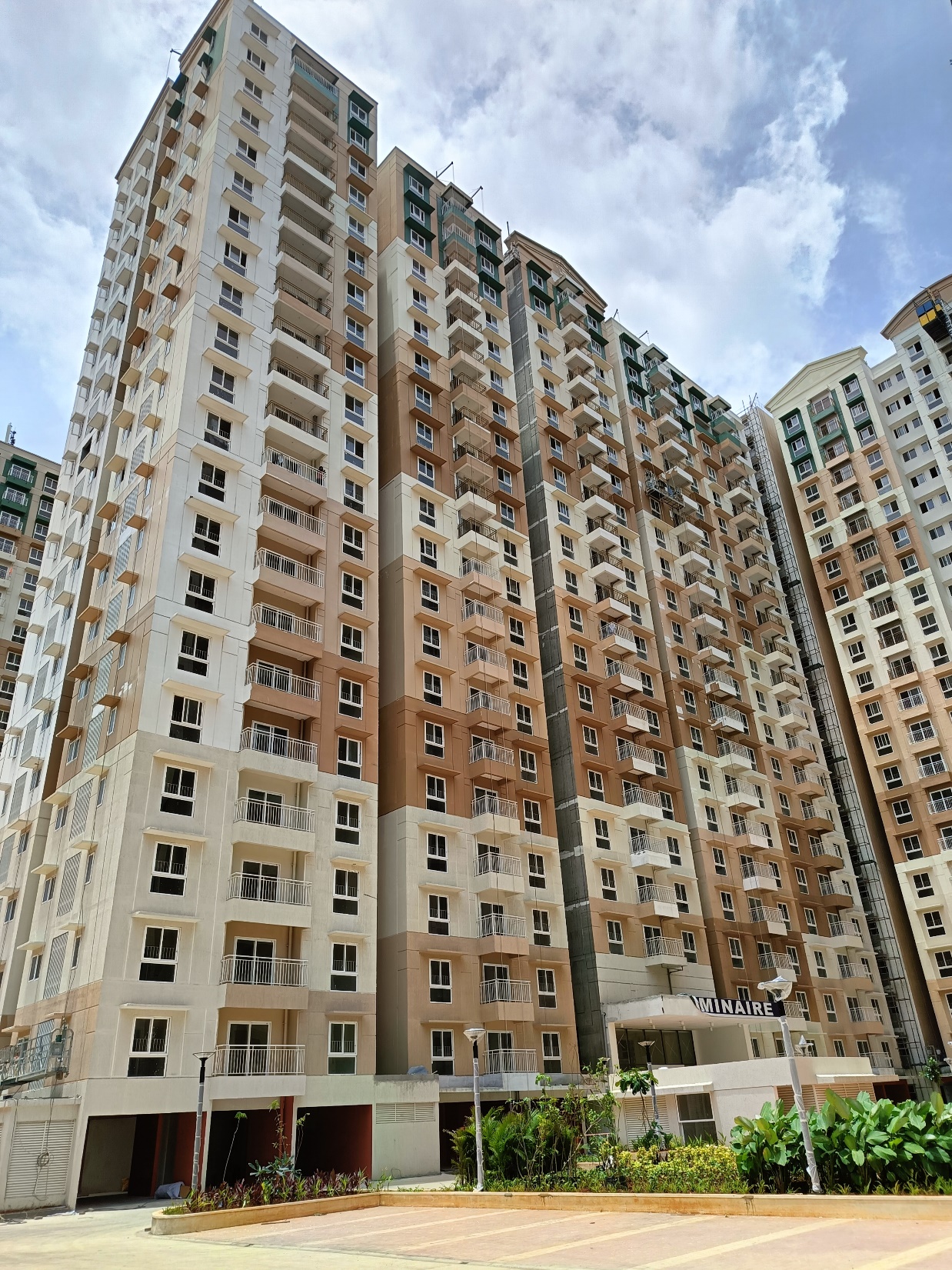

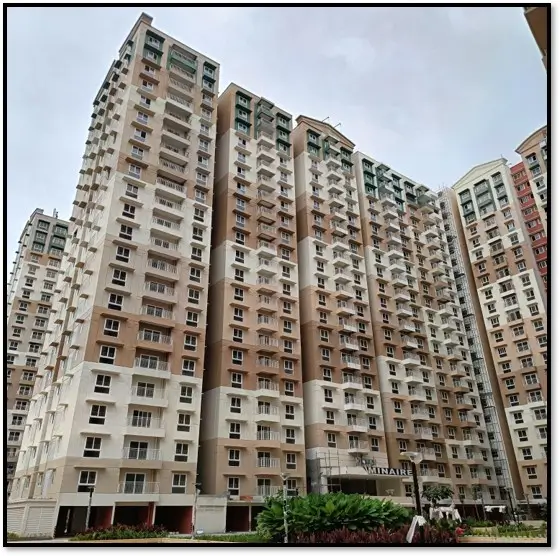

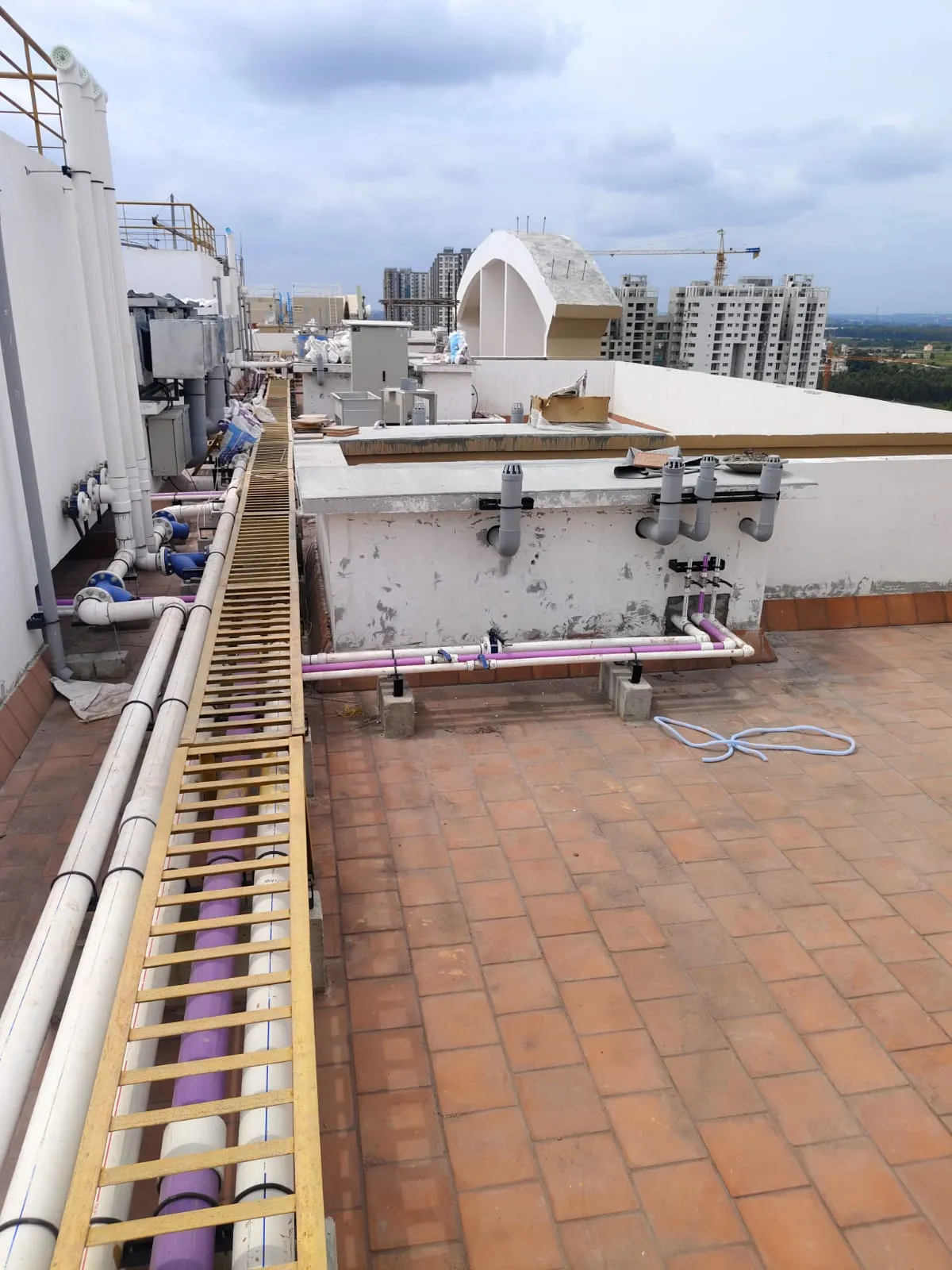

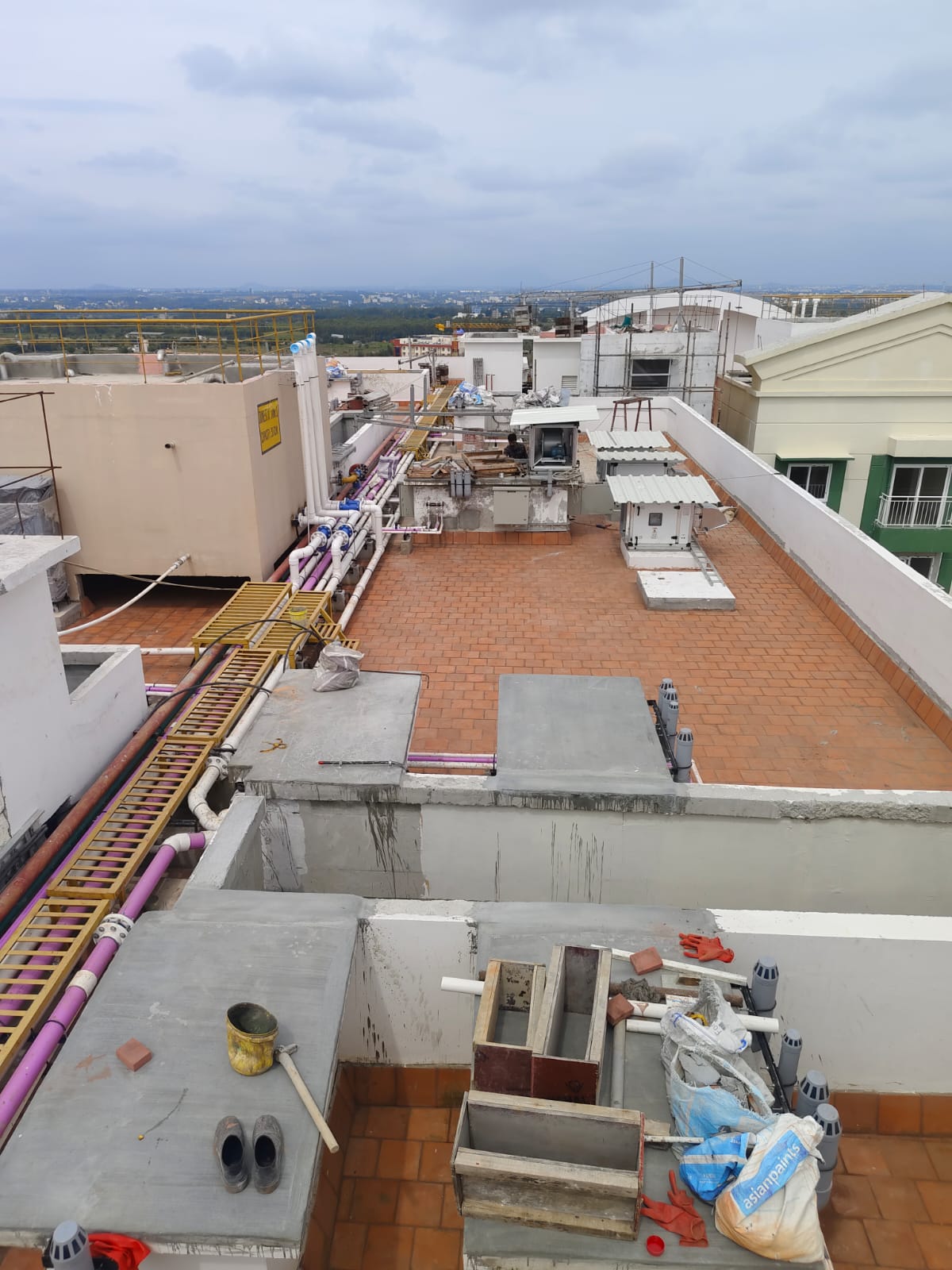

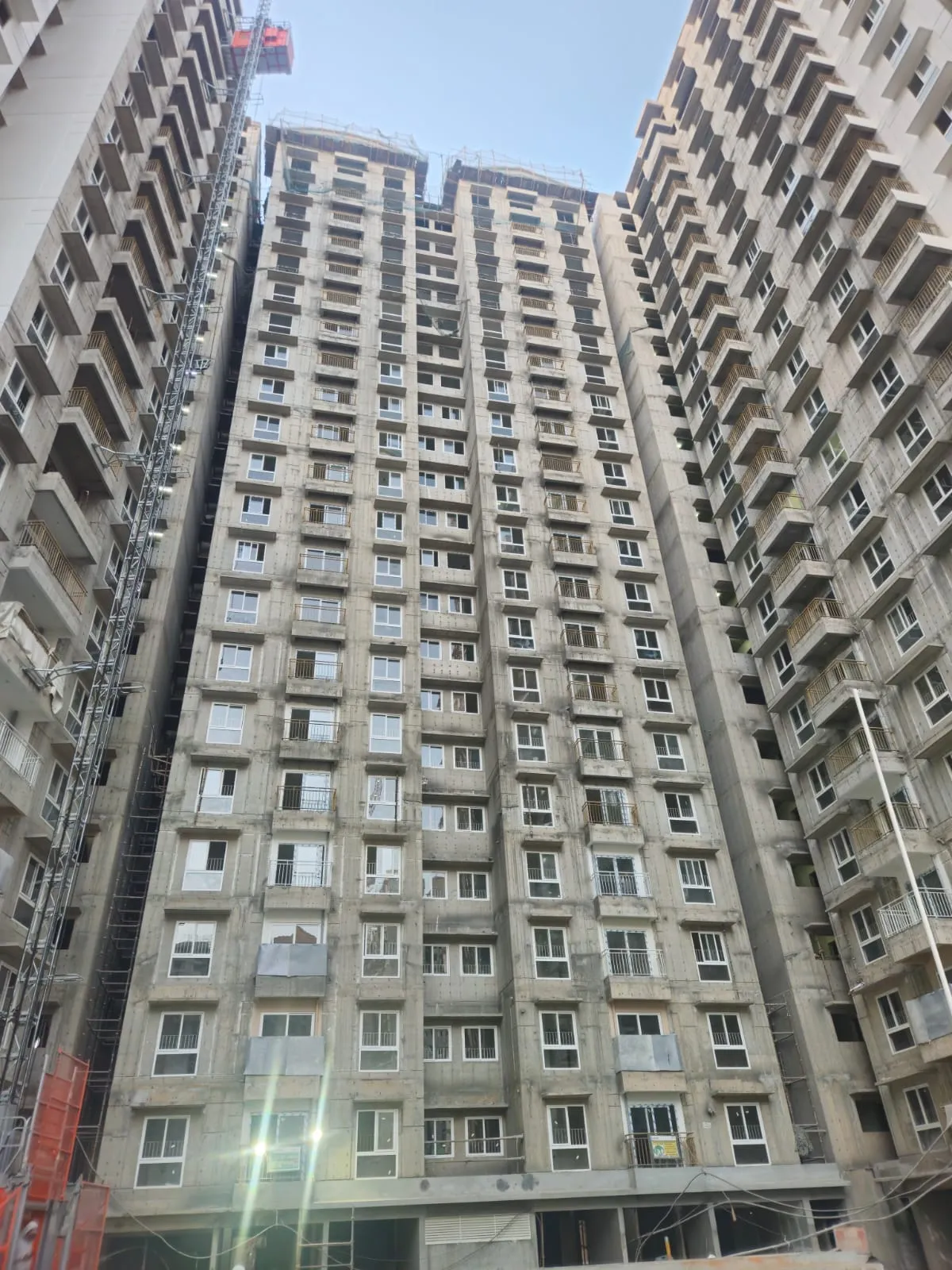

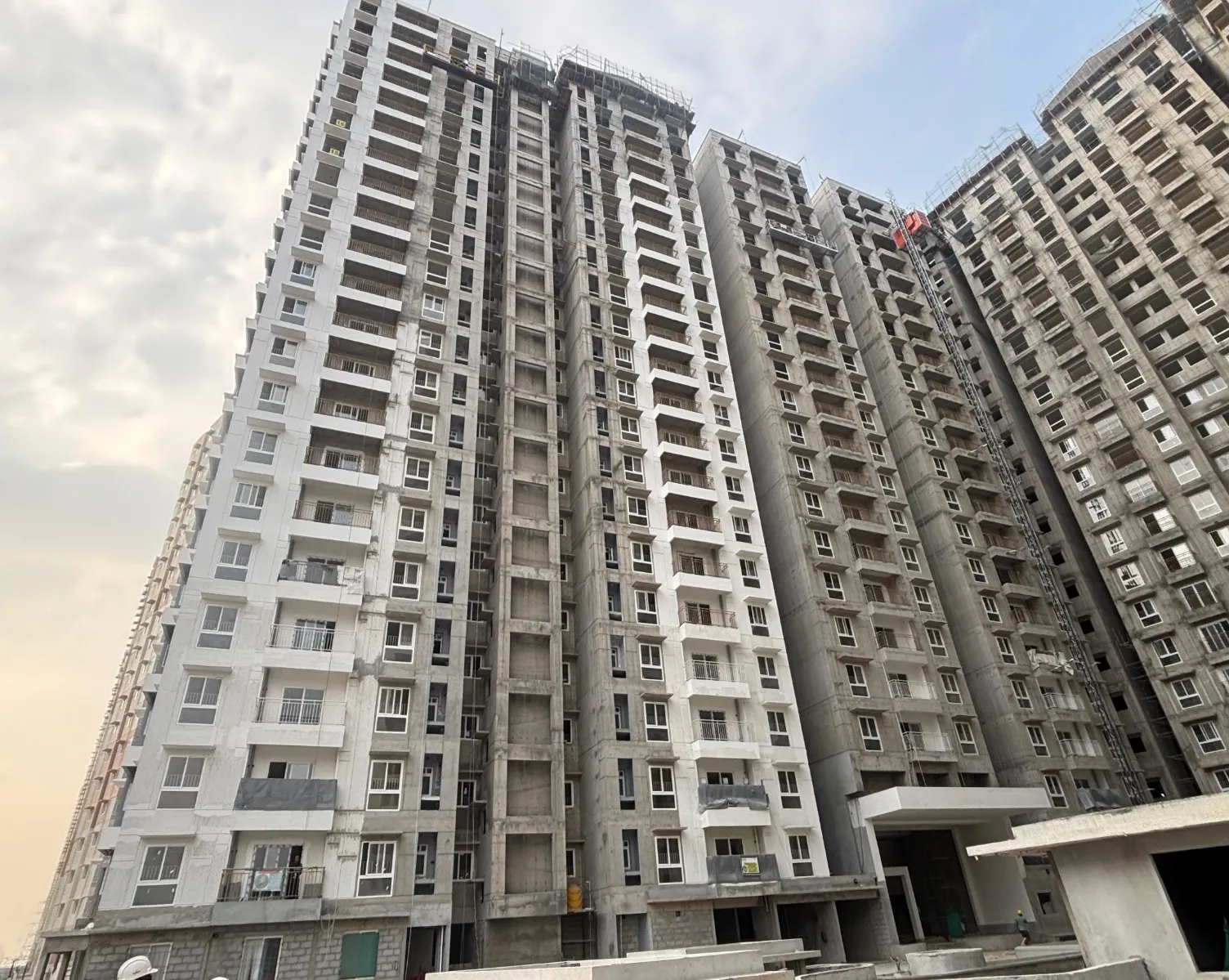

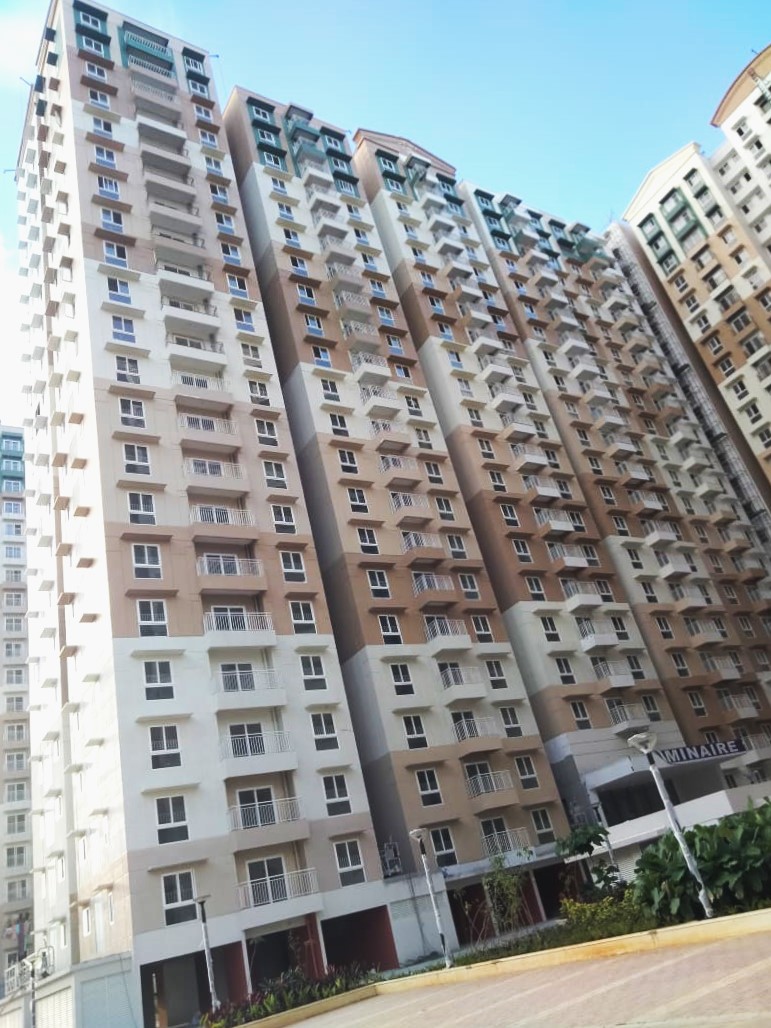

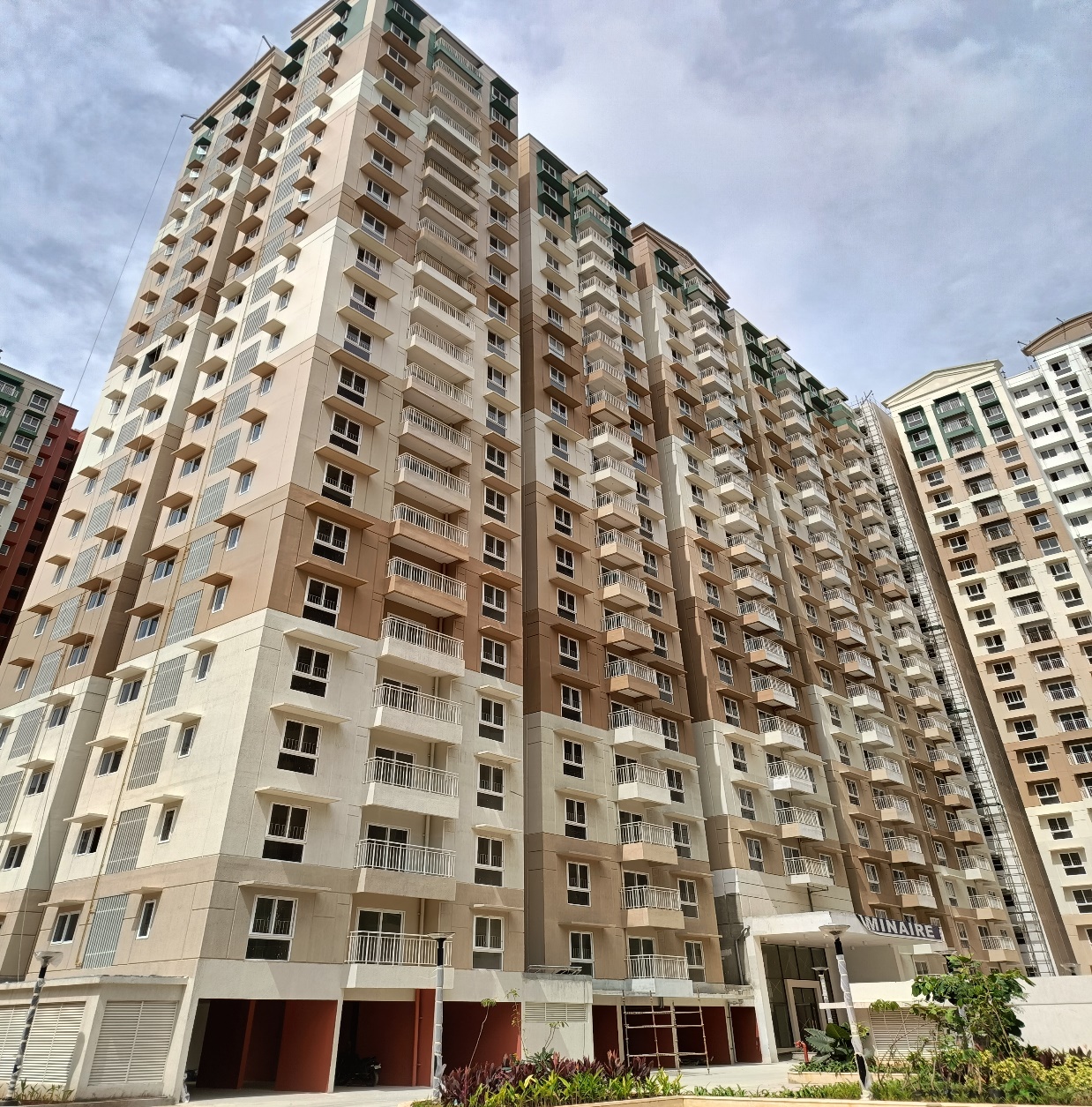

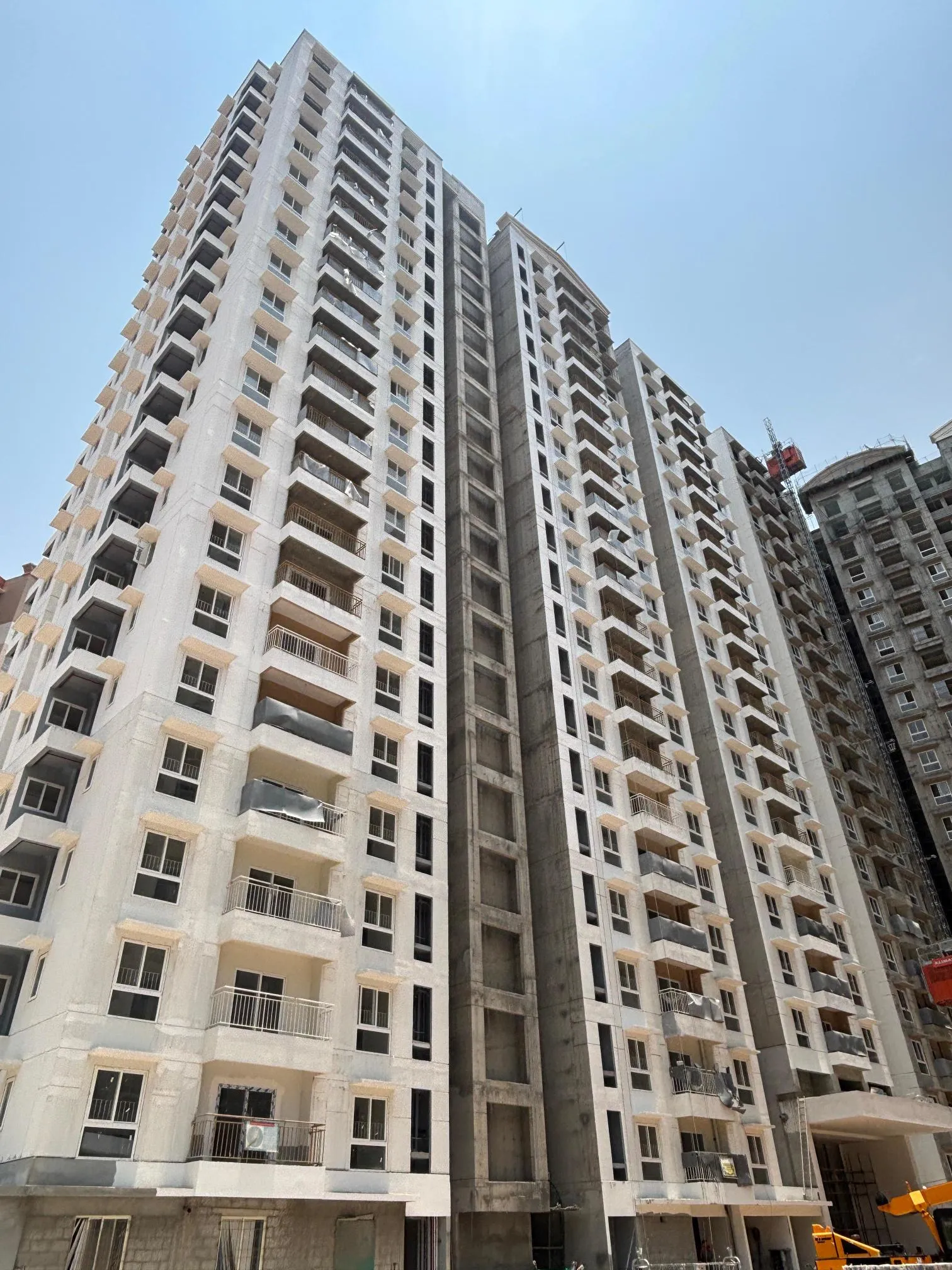

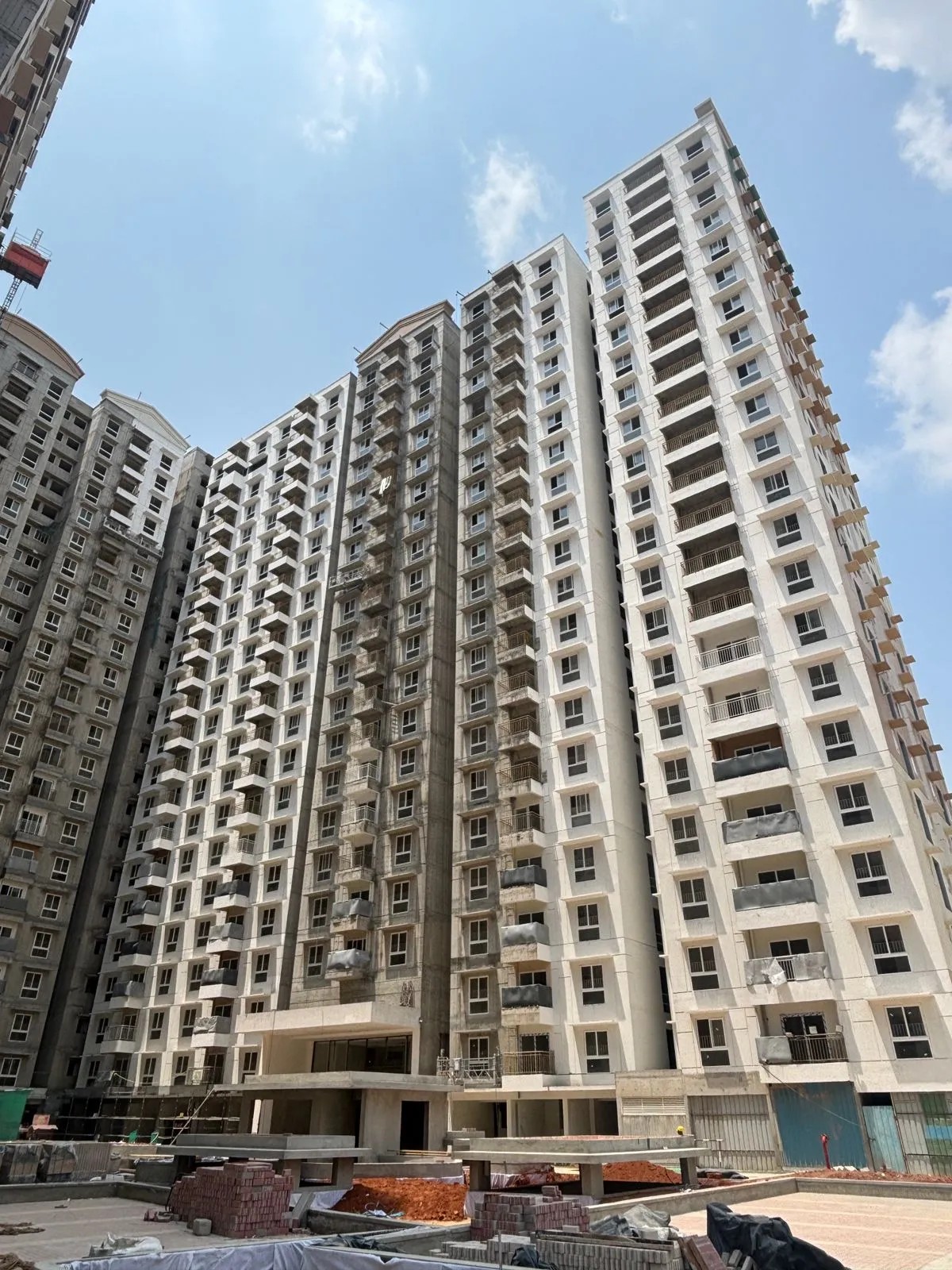

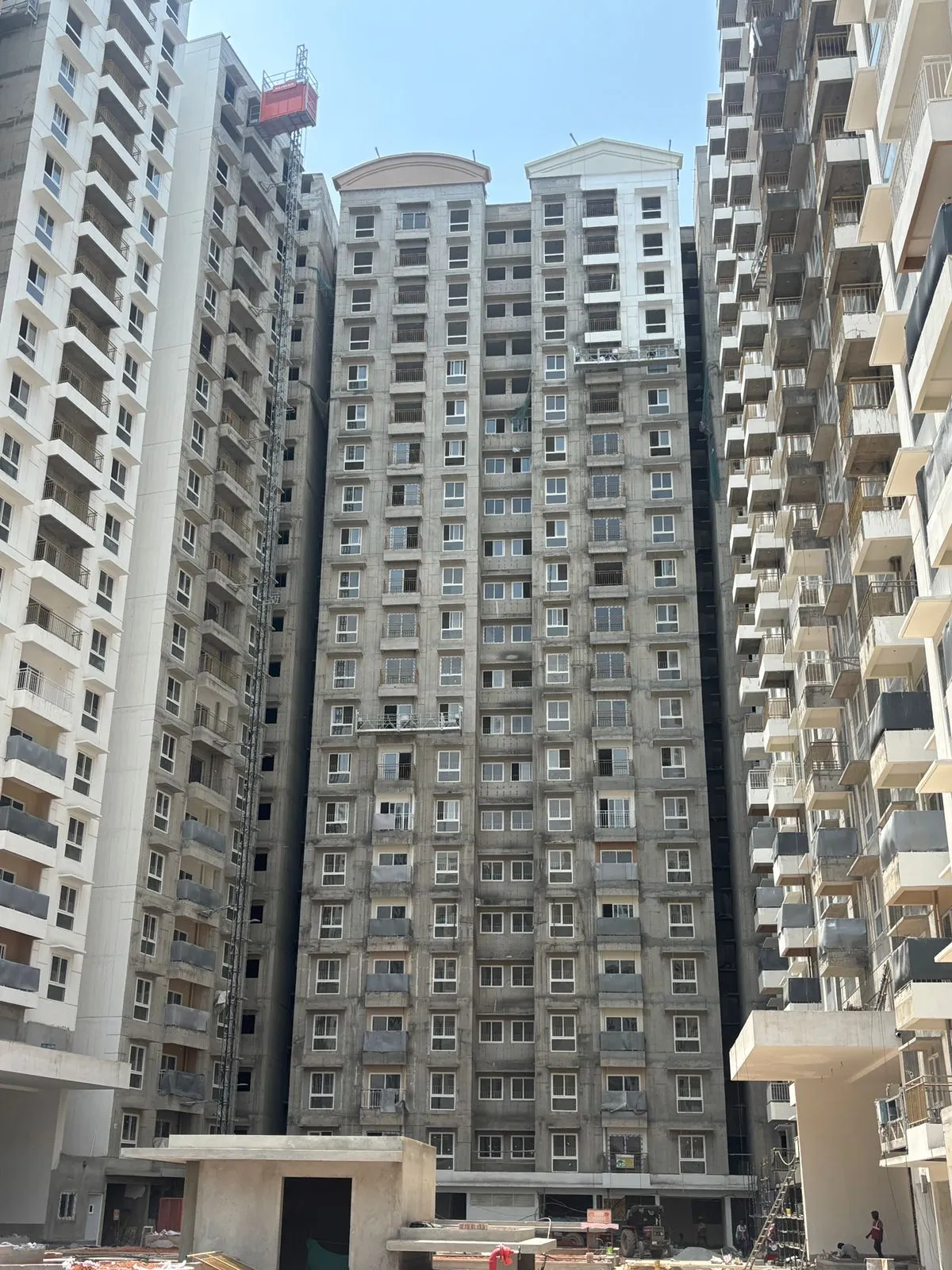

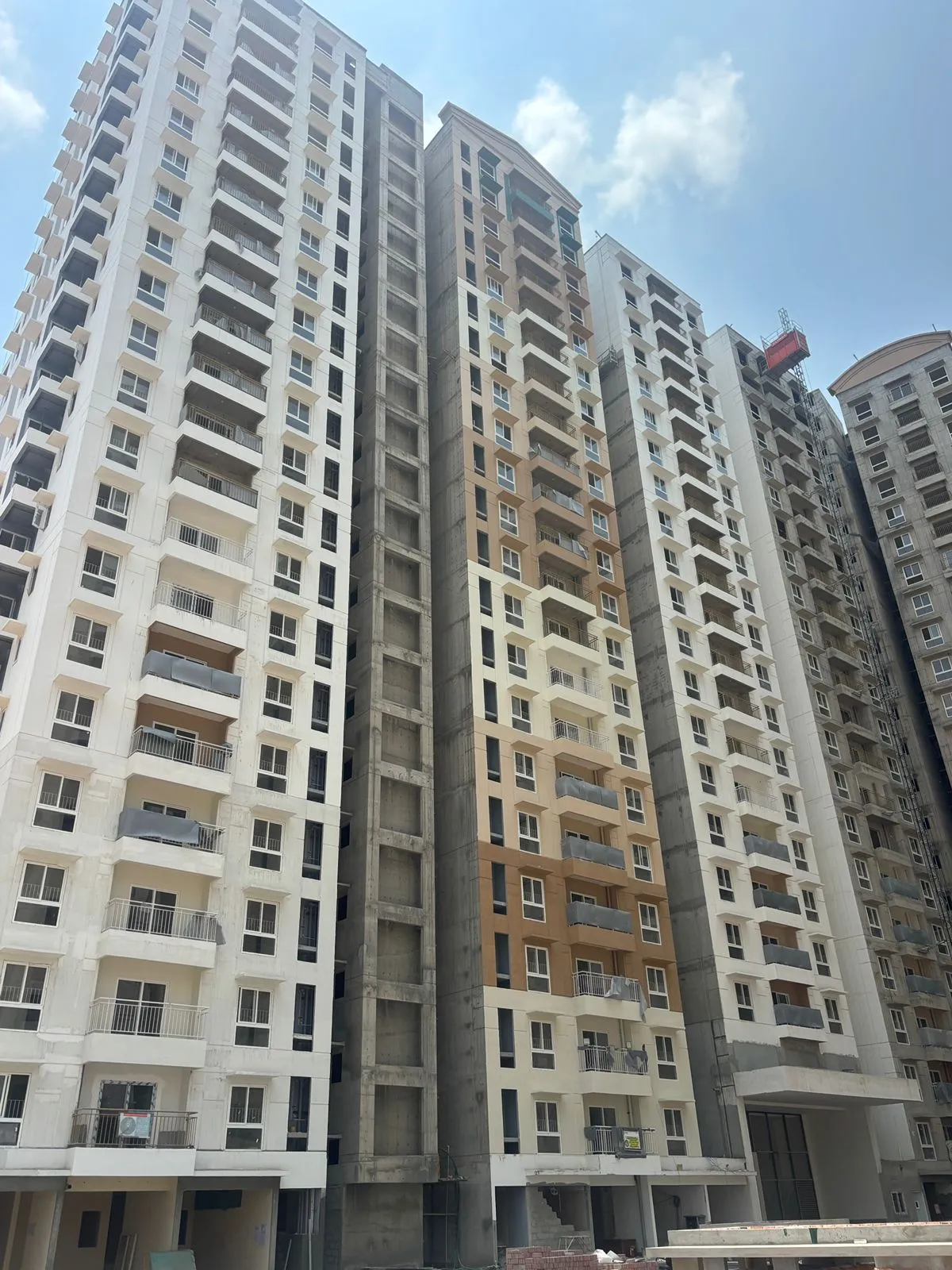

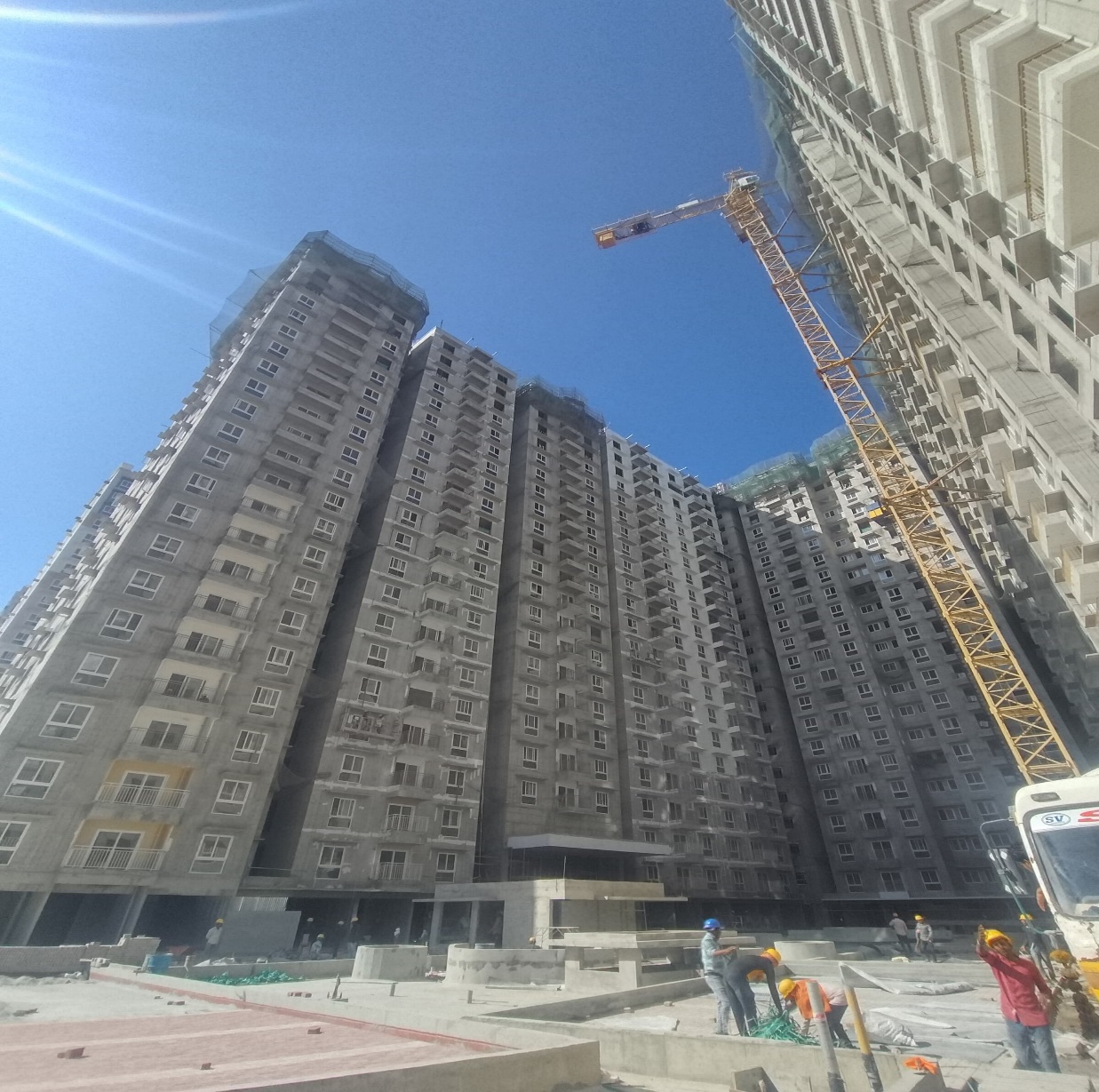

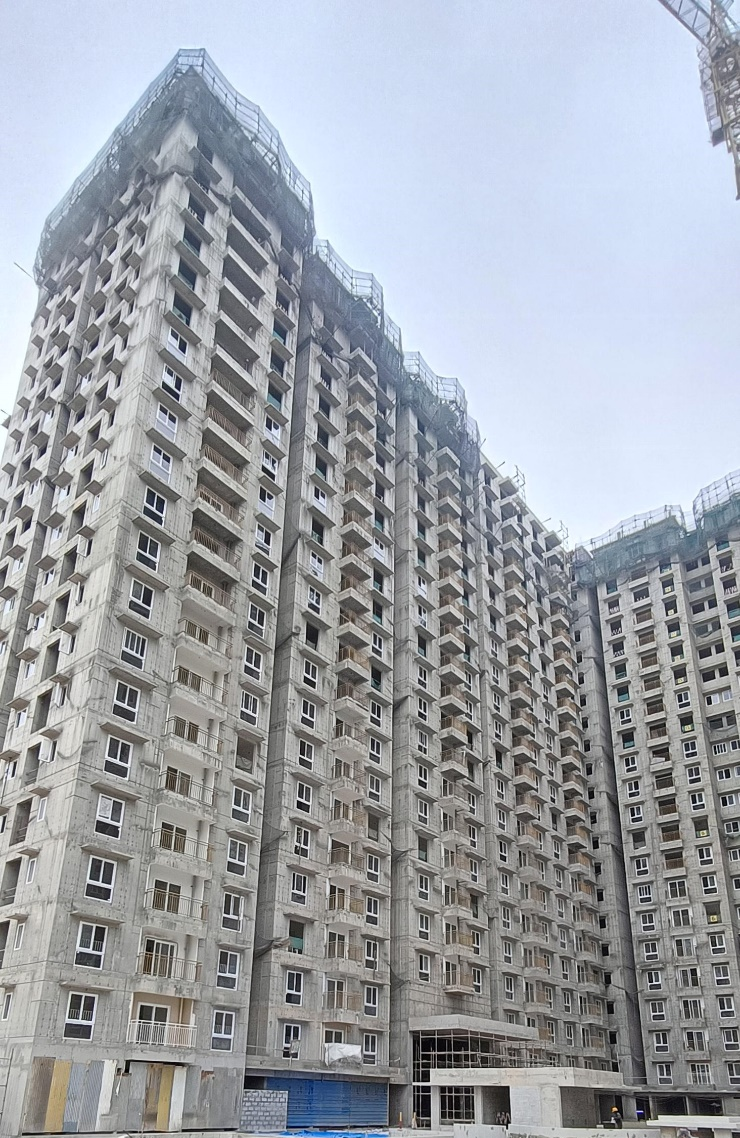

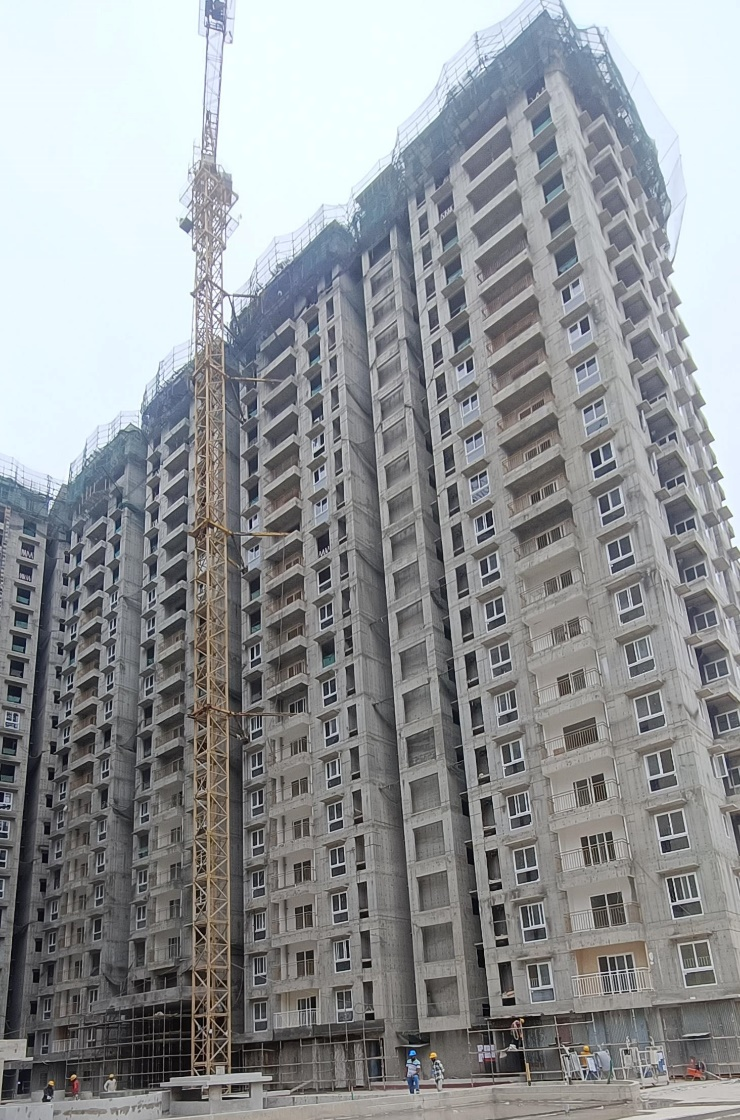

Wing A: Above terrace level painting work in progress - Jun 2025

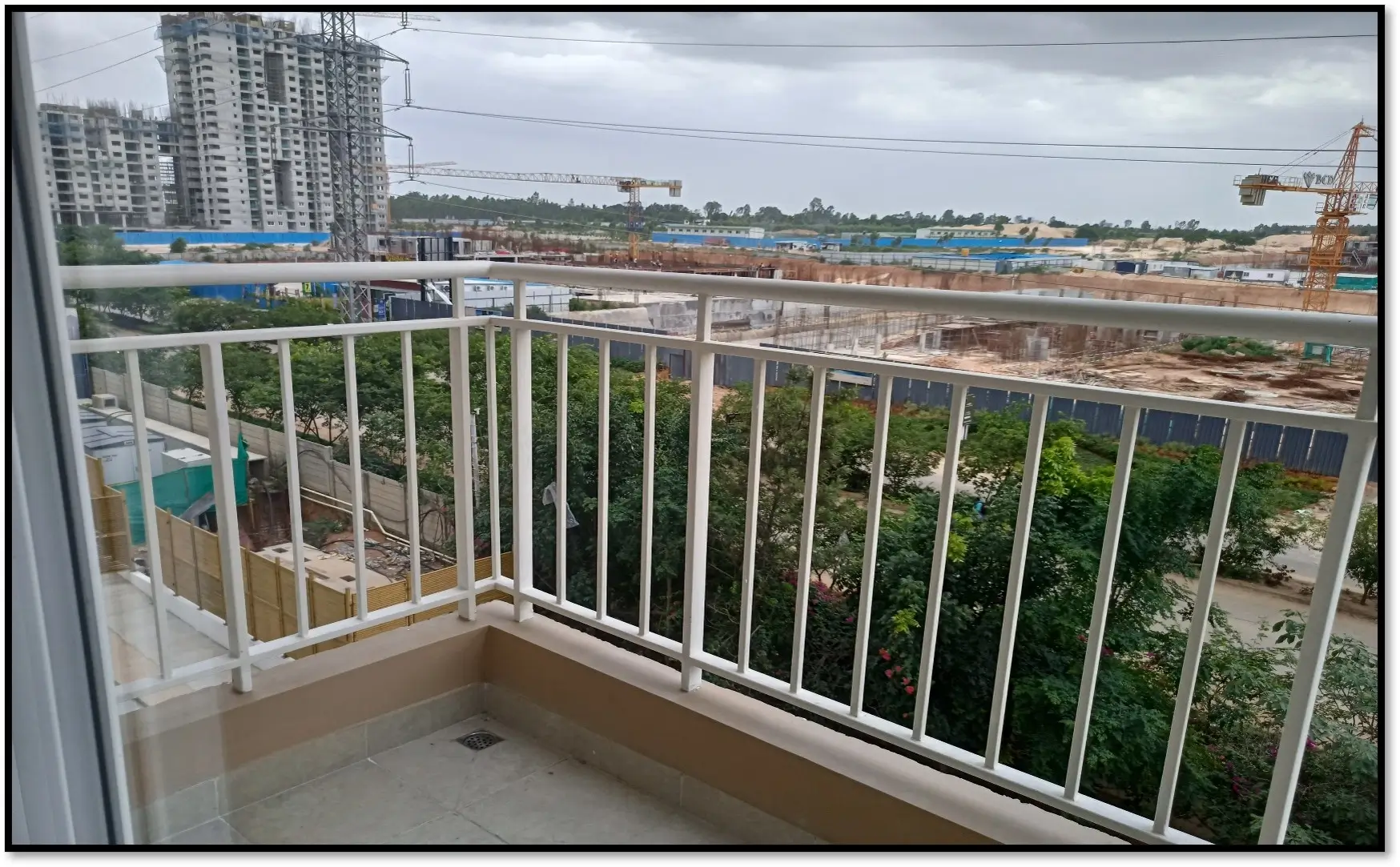

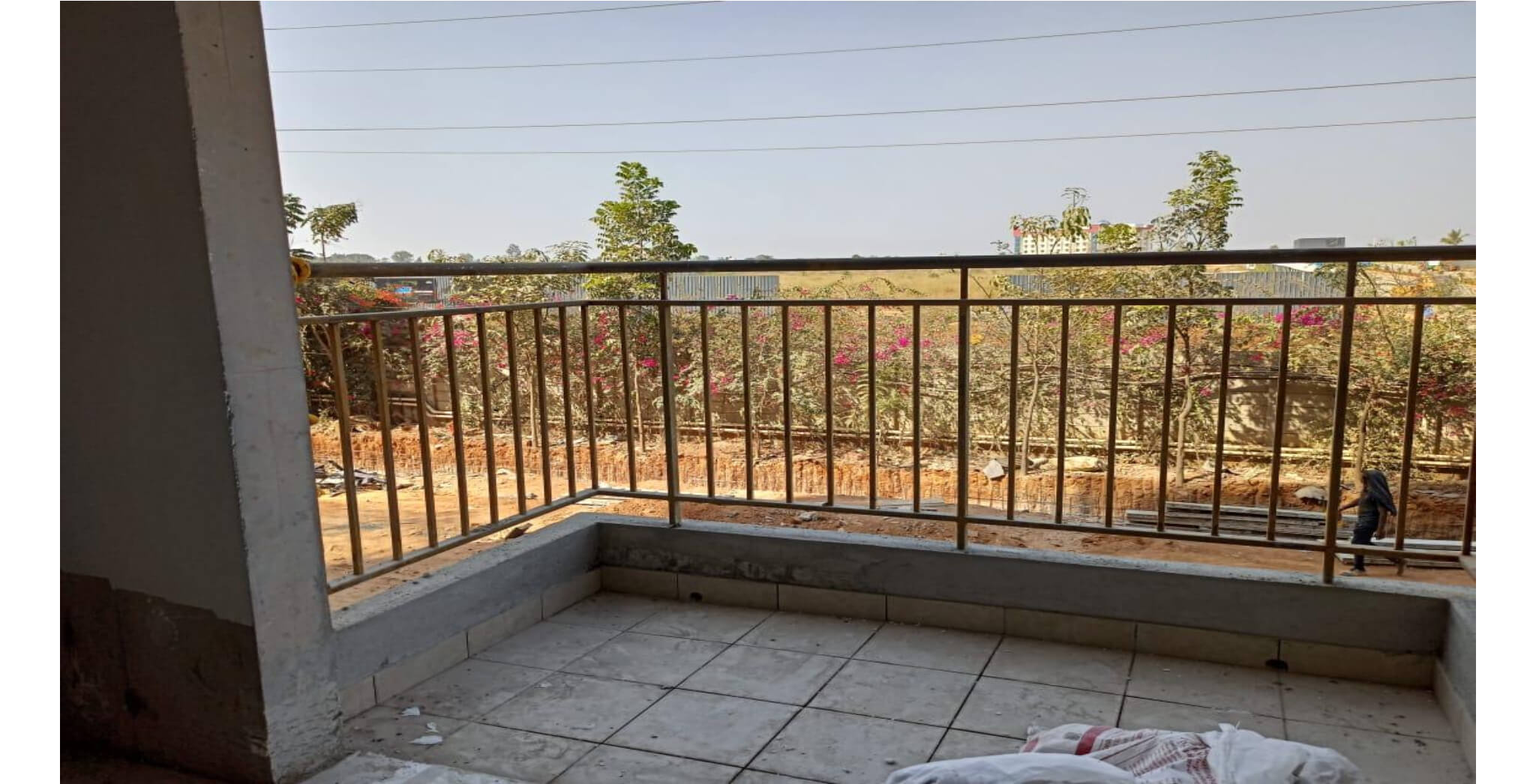

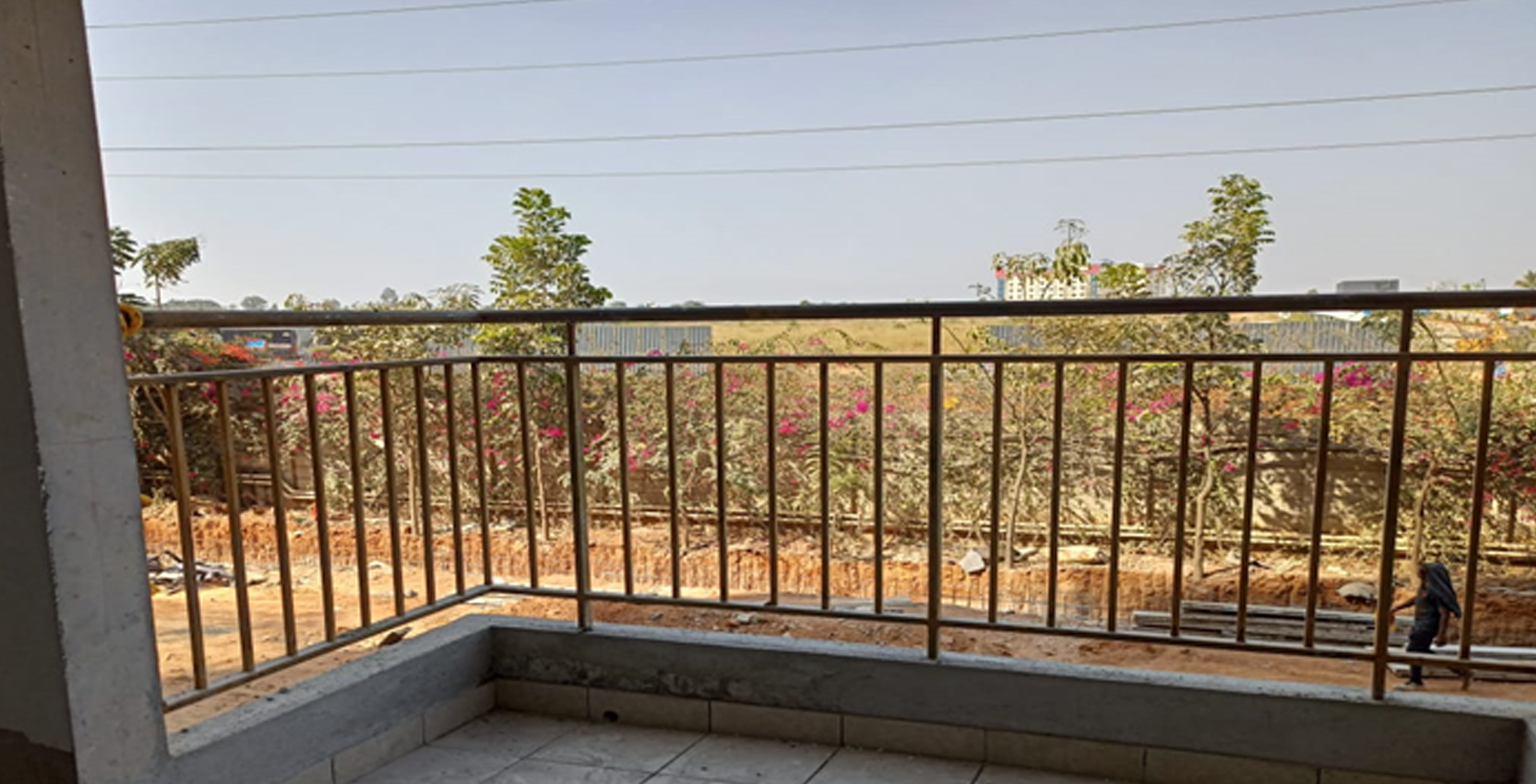

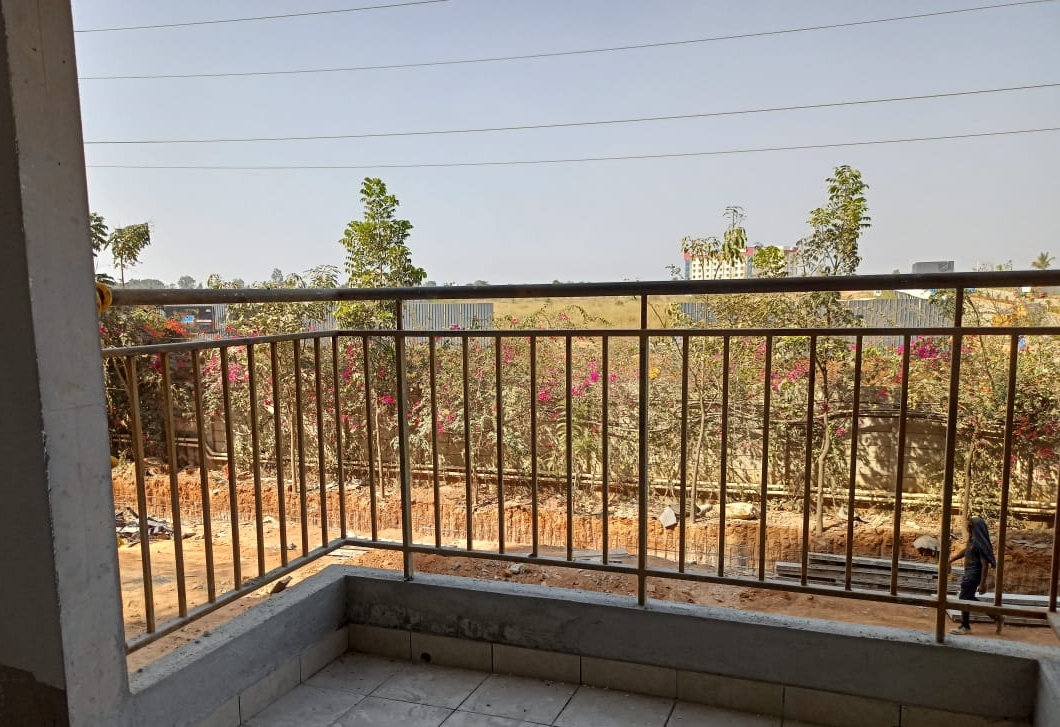

Balcony railing –work in progress - Jun 2025

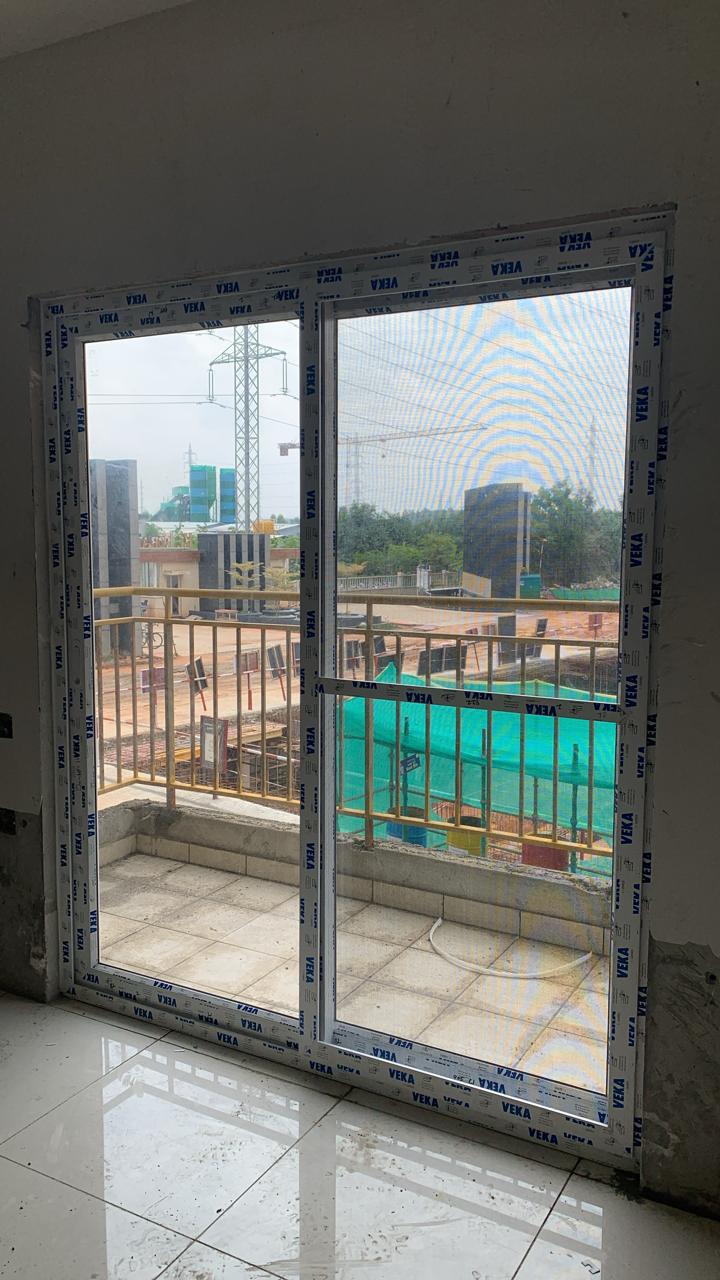

UPVC doors and windows –work in progress - Jun 2025

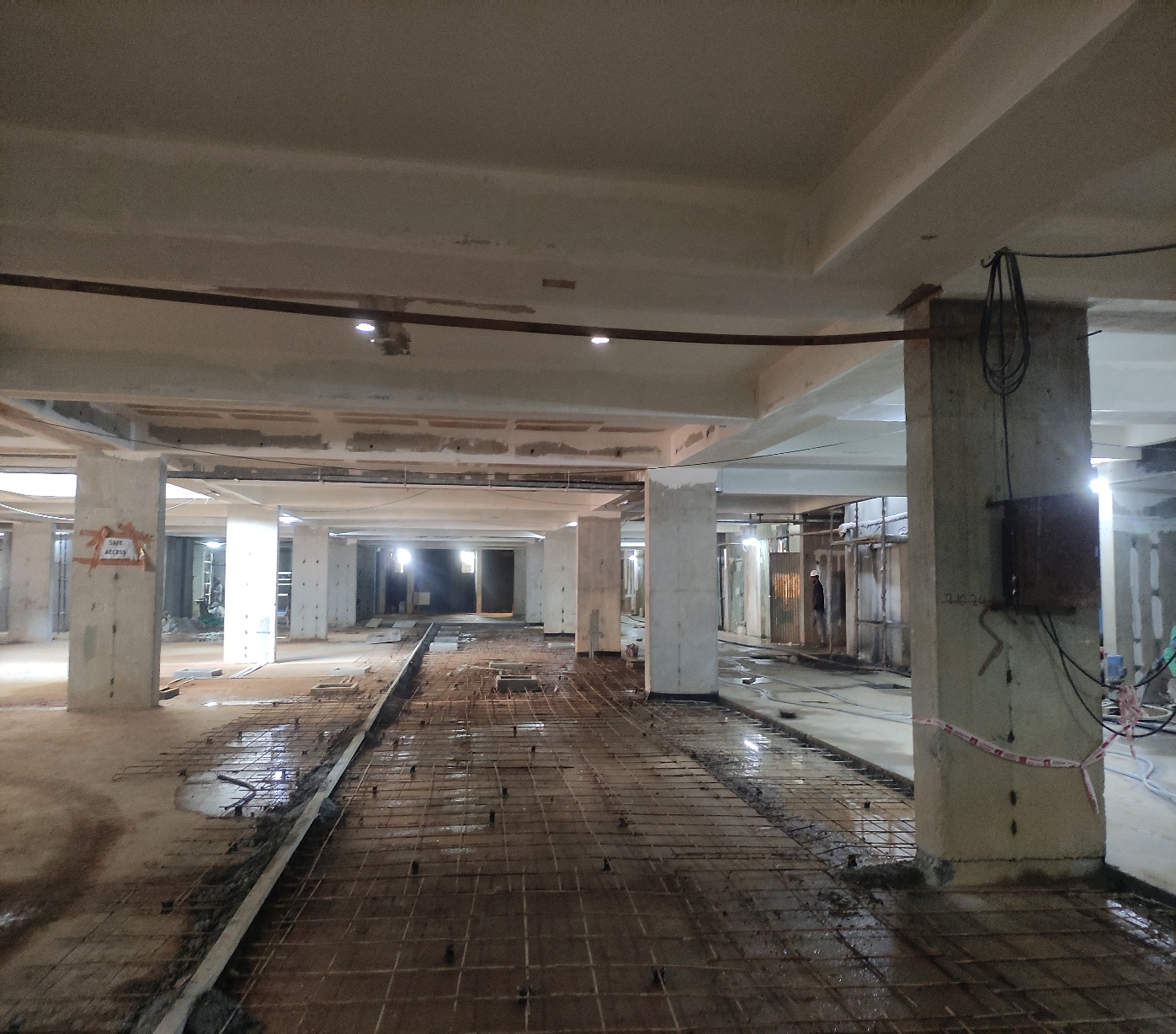

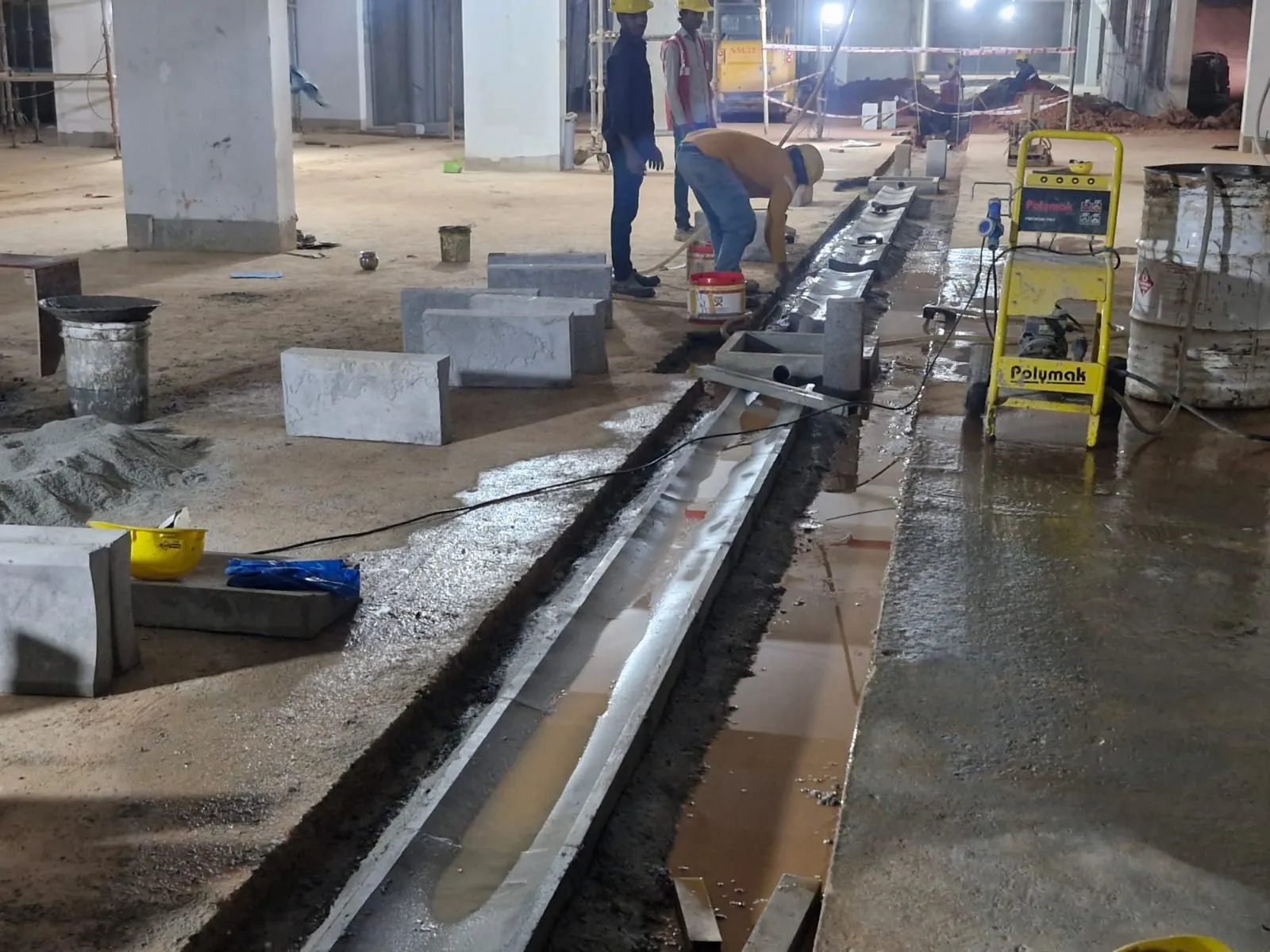

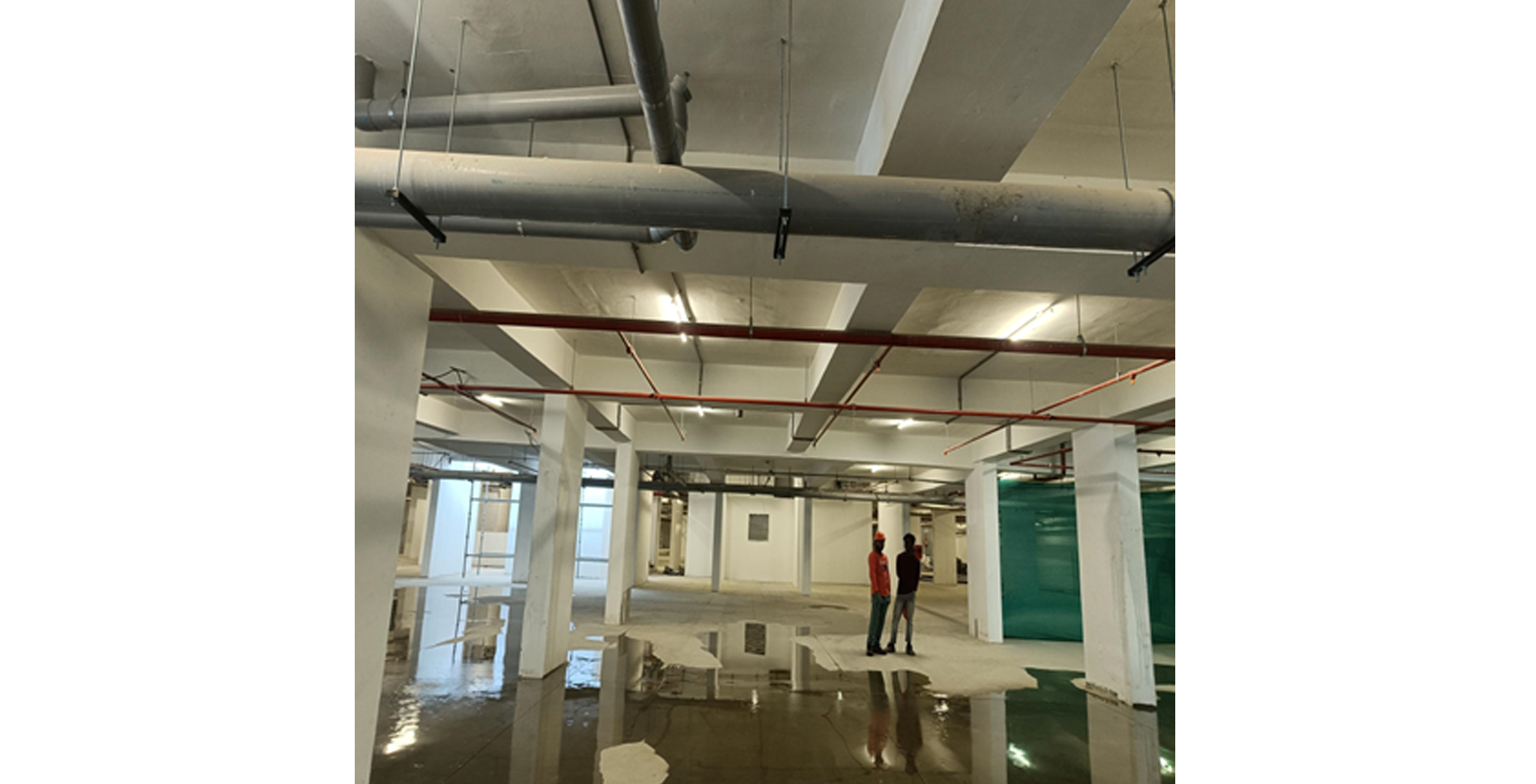

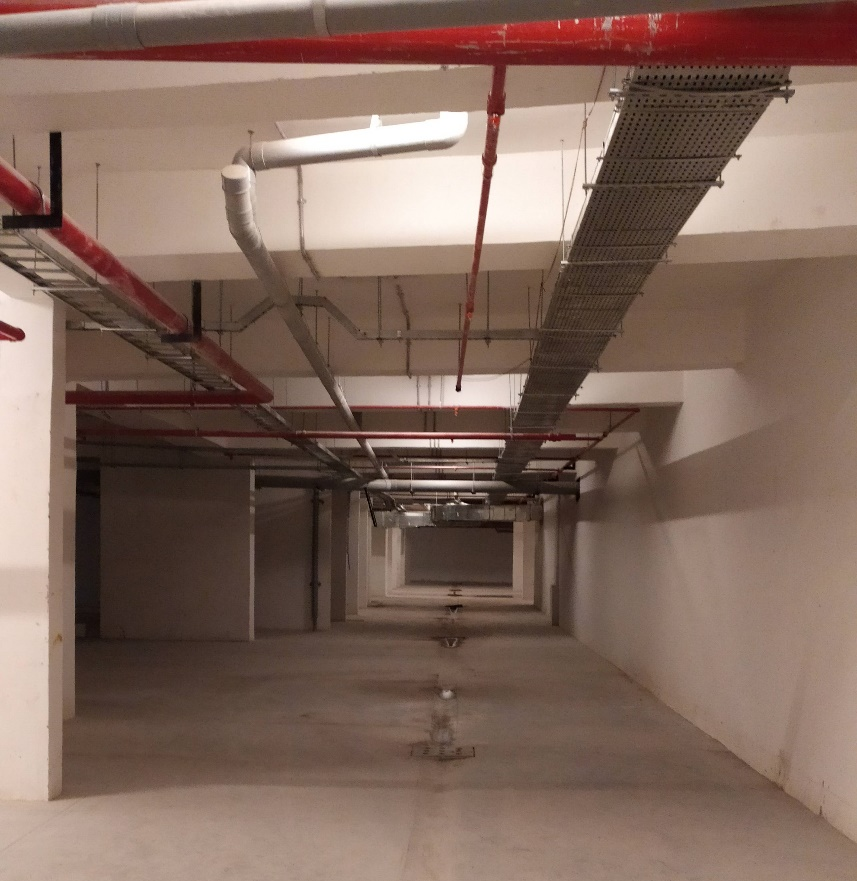

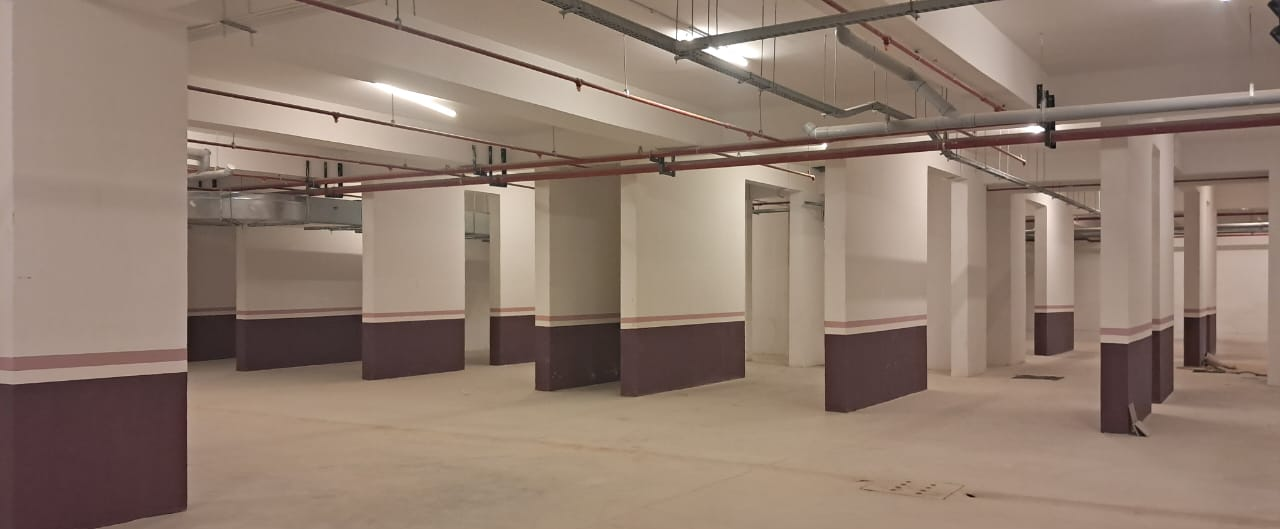

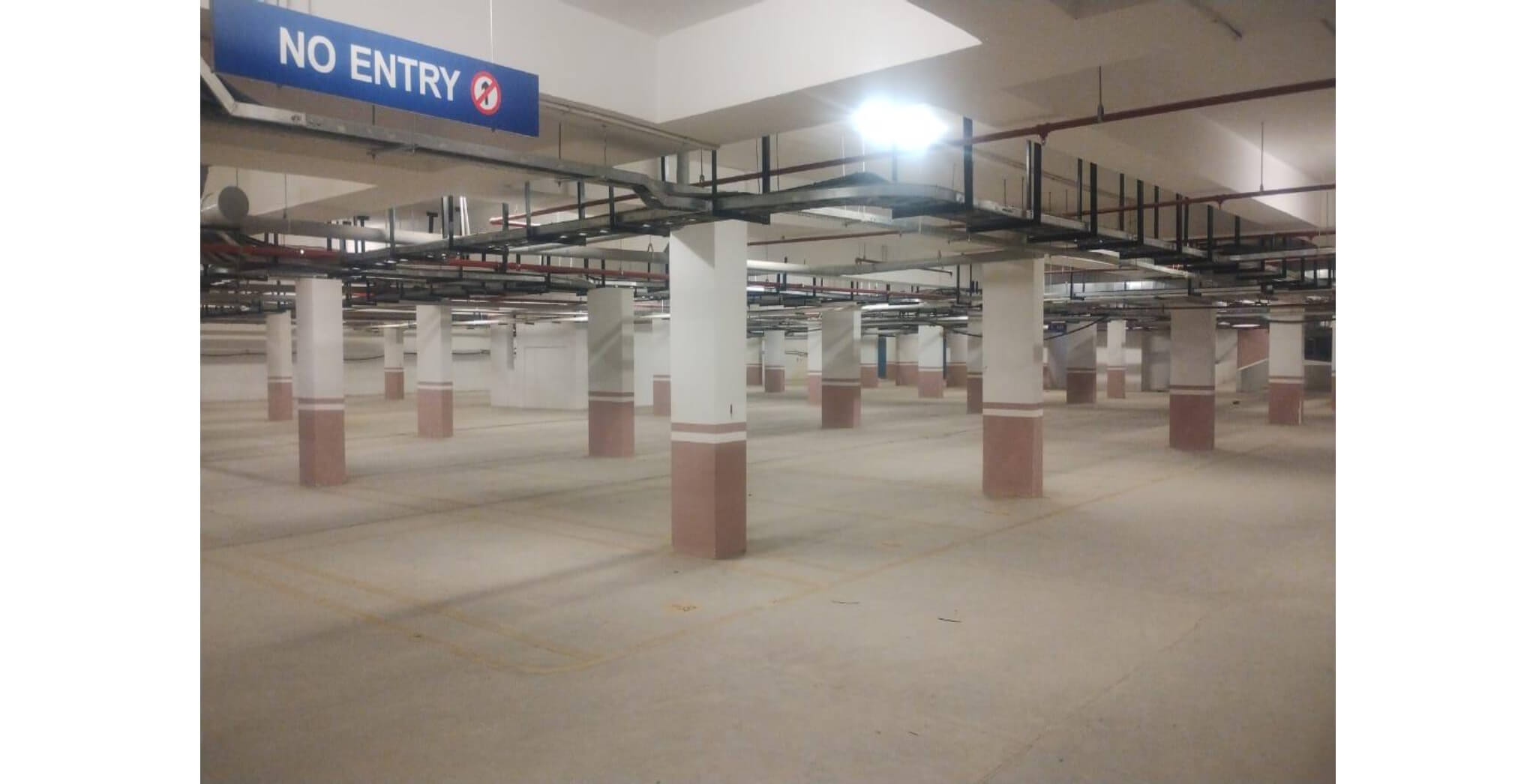

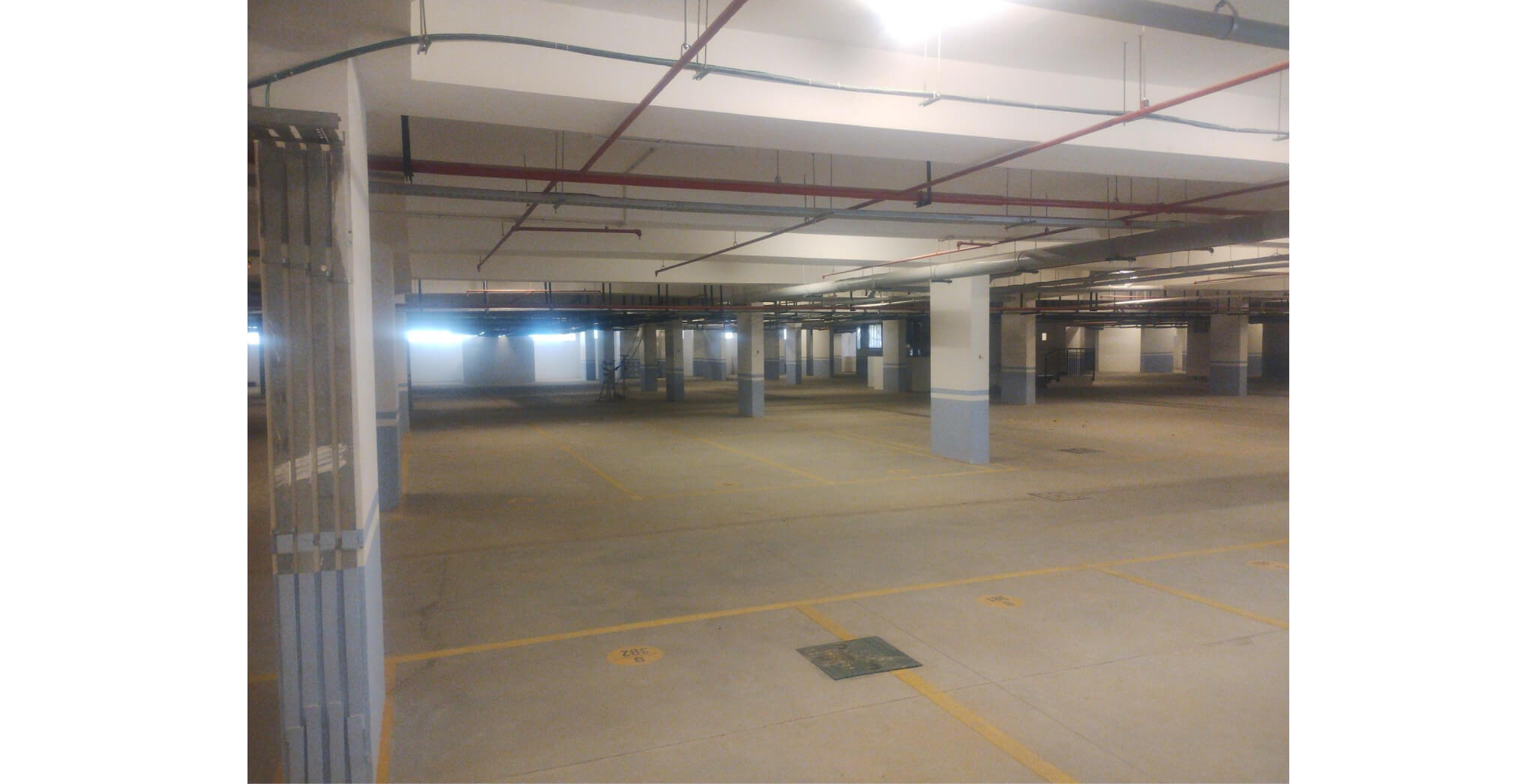

Basement work in progress - Jun 2025

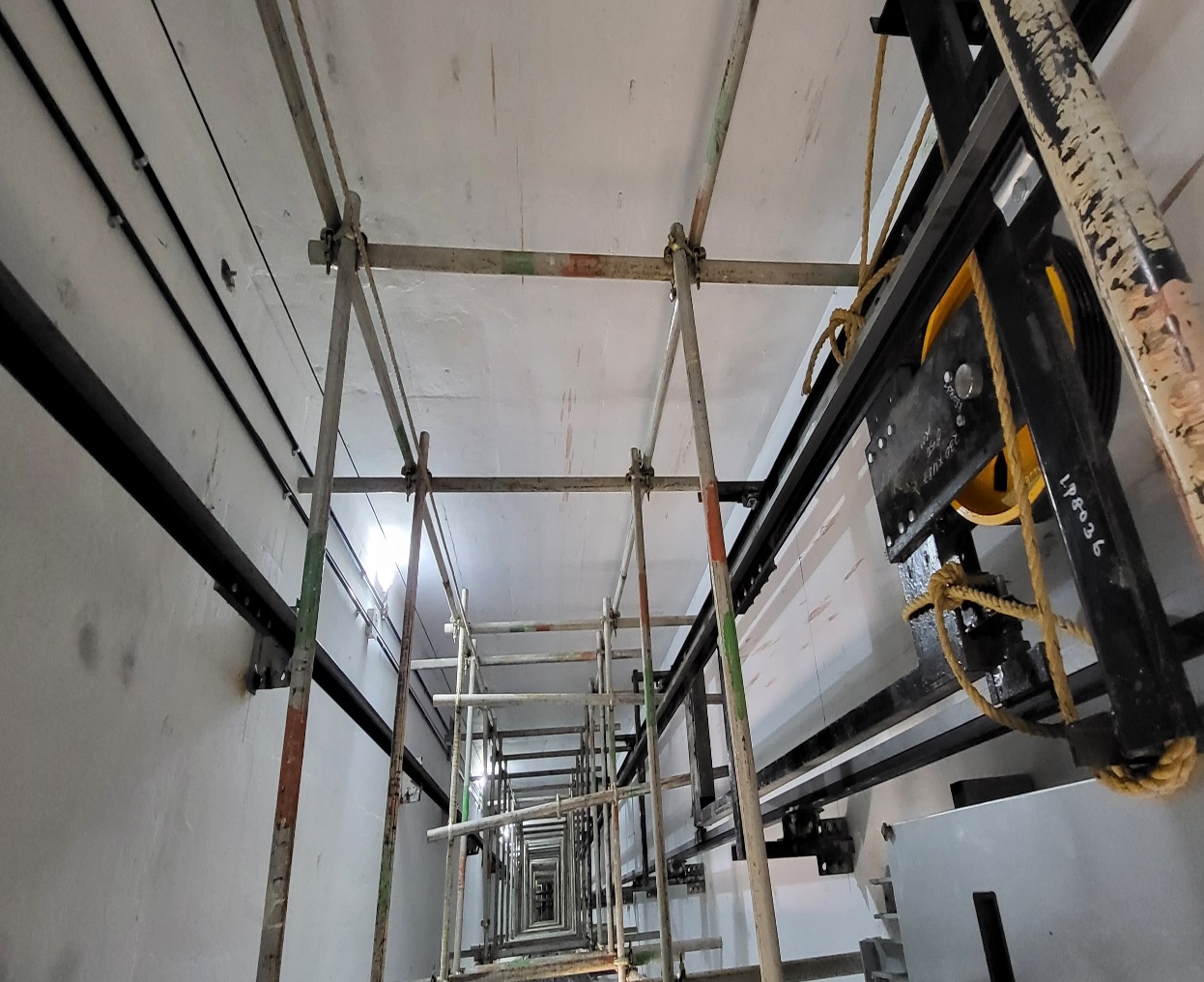

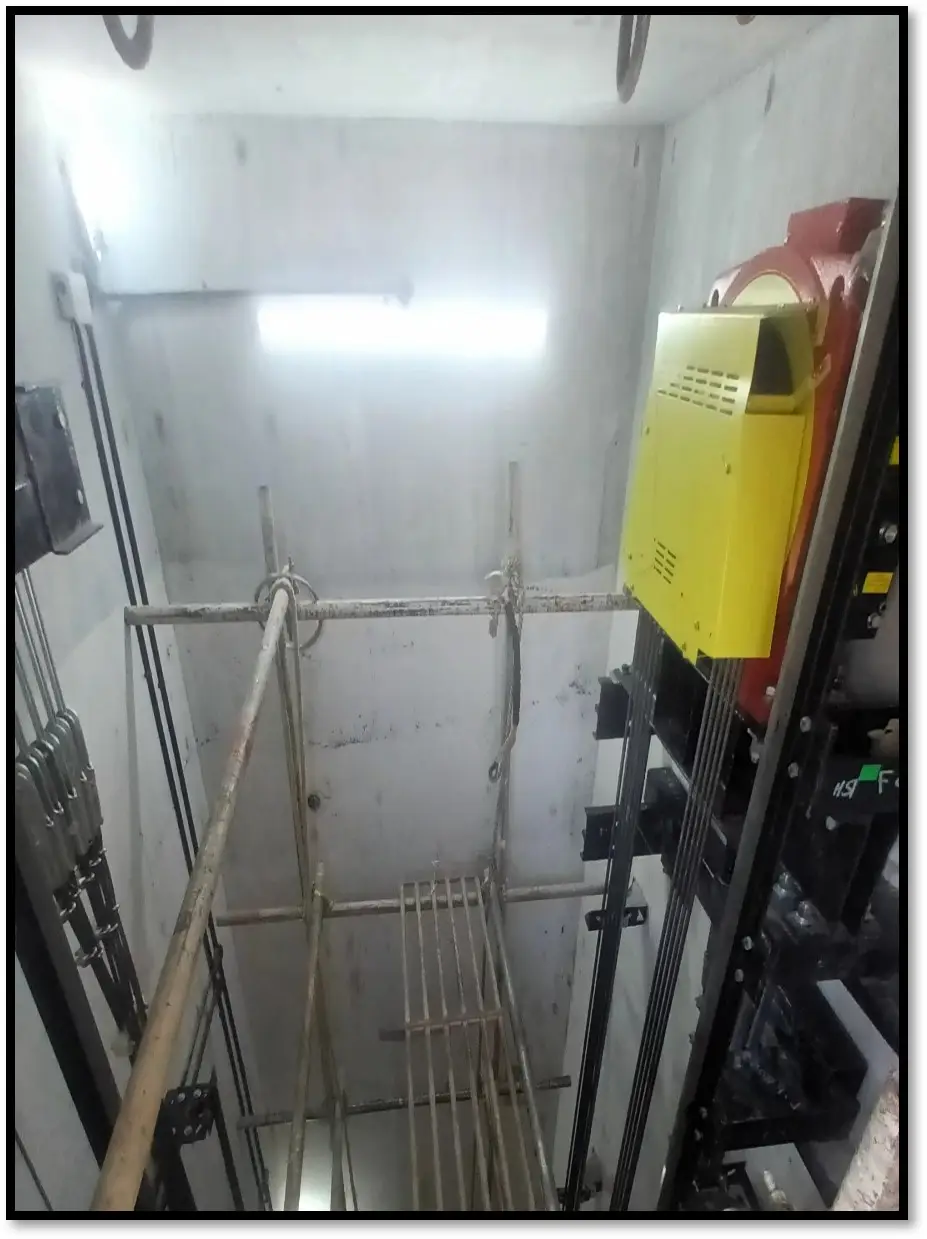

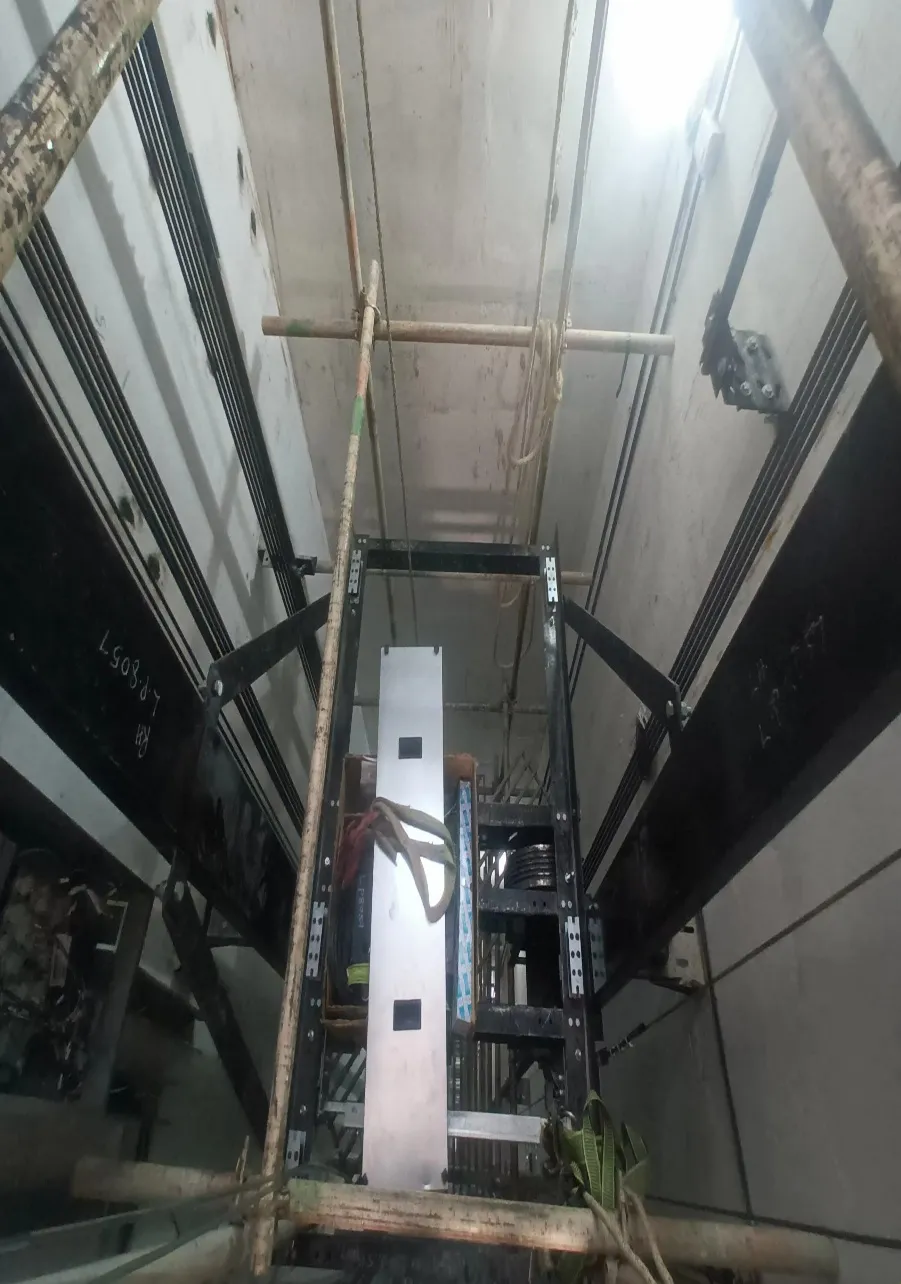

Lift installation work in progress - Jun 2025

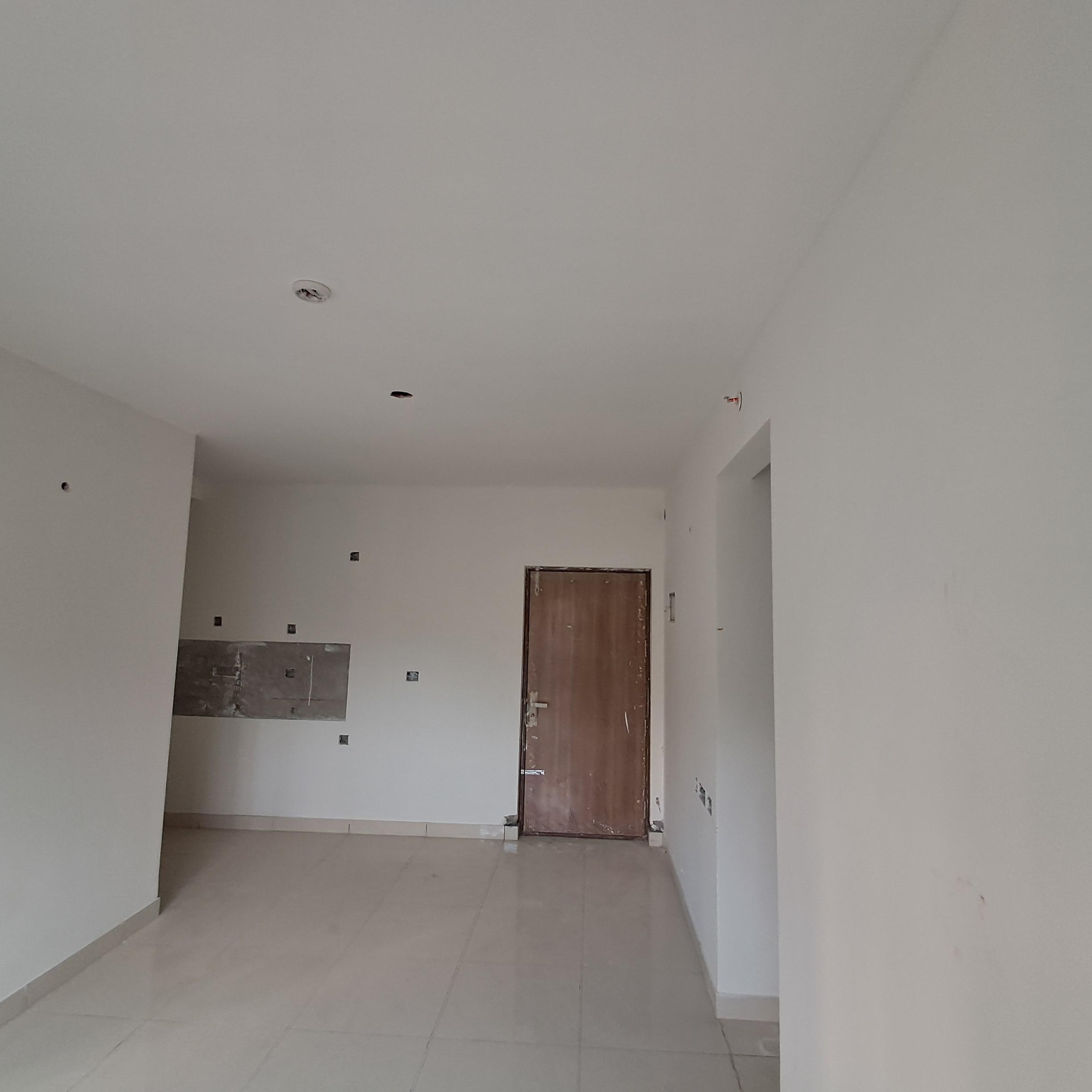

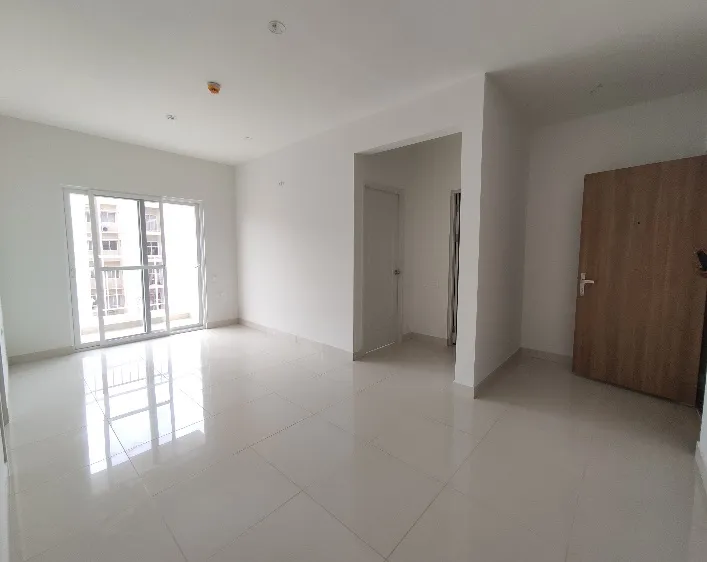

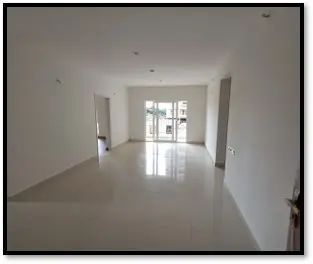

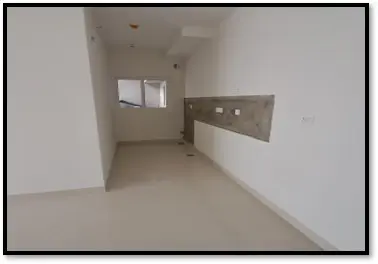

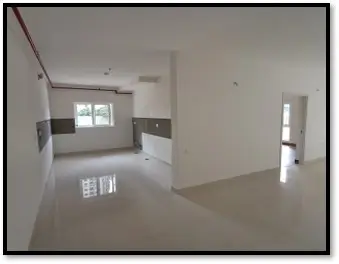

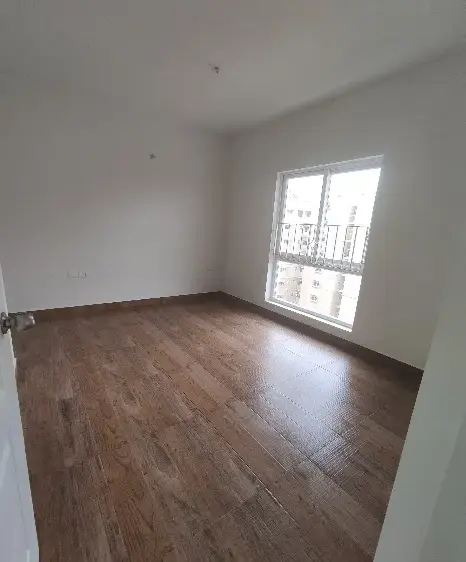

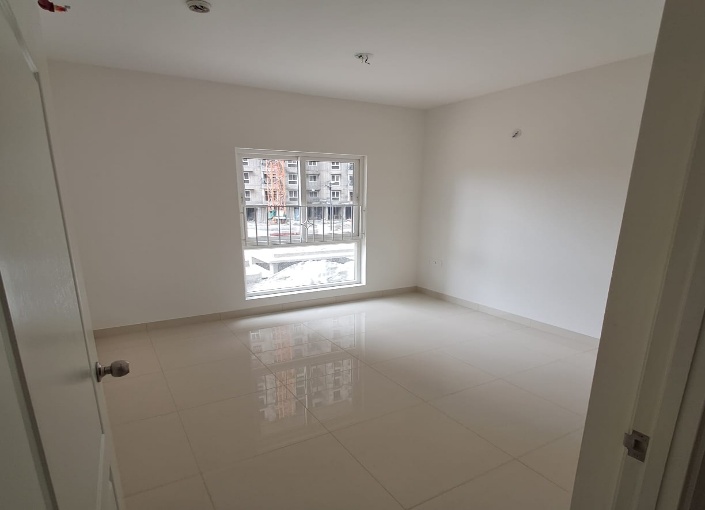

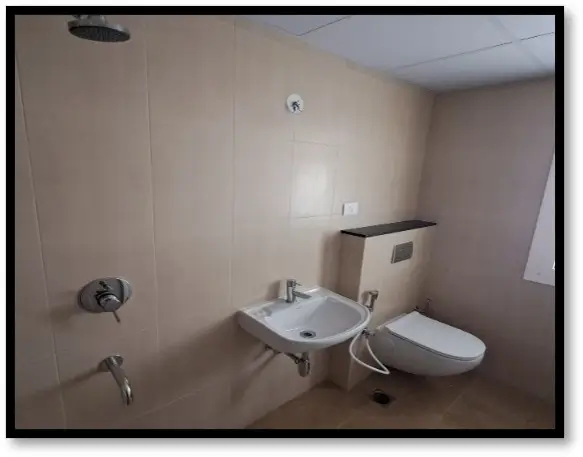

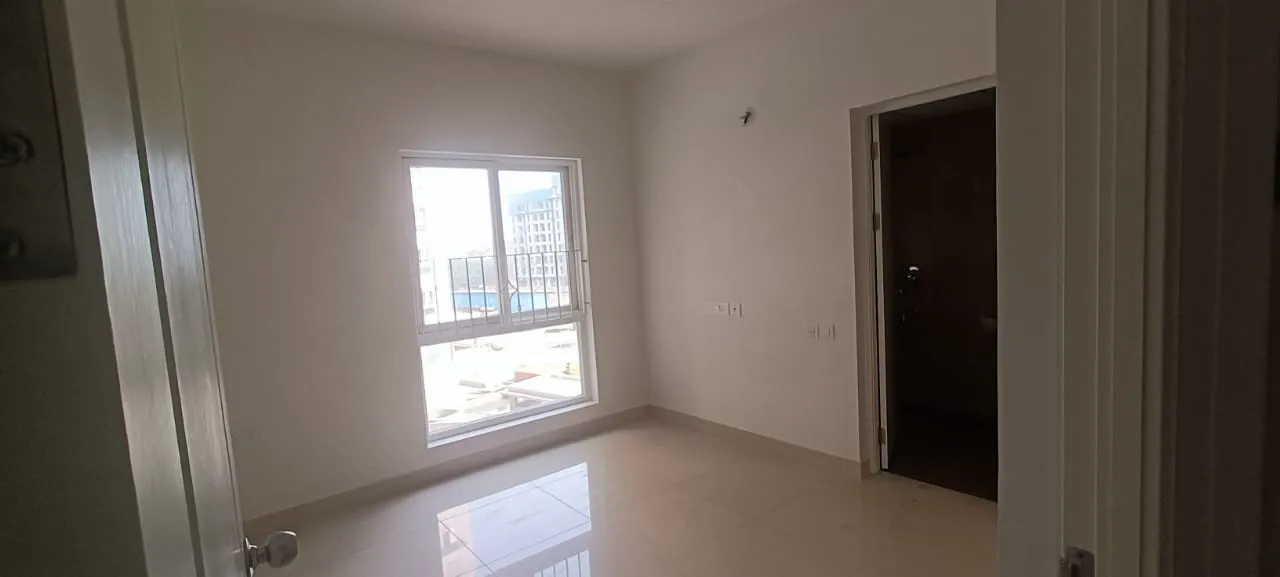

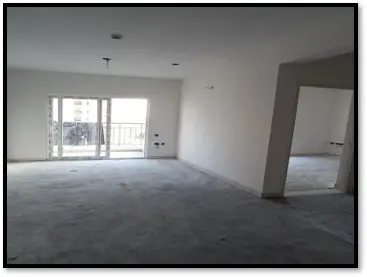

Internal flats finishing work in progress - Jun 2025

Lift installation work in progress - Jun 2025

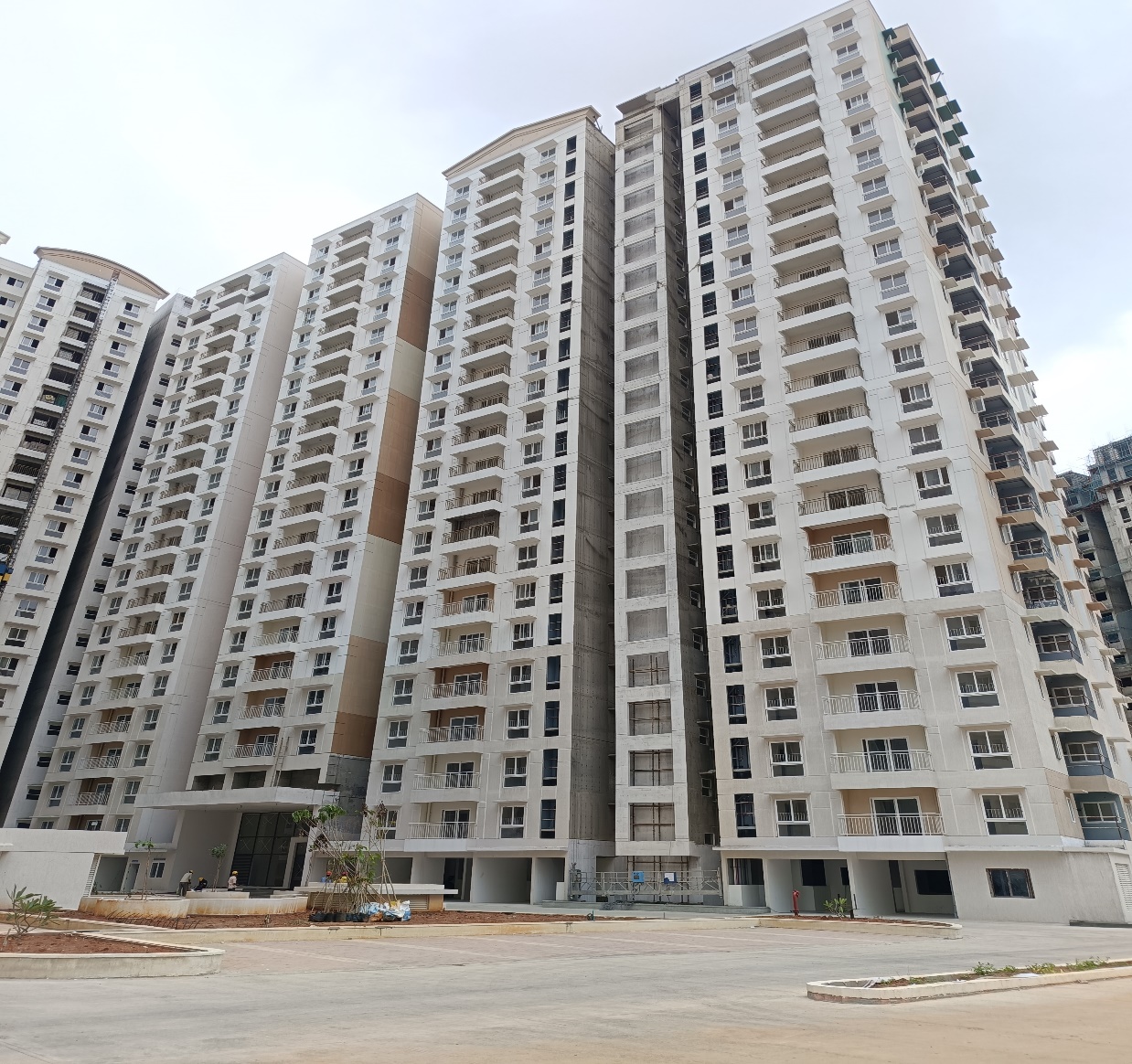

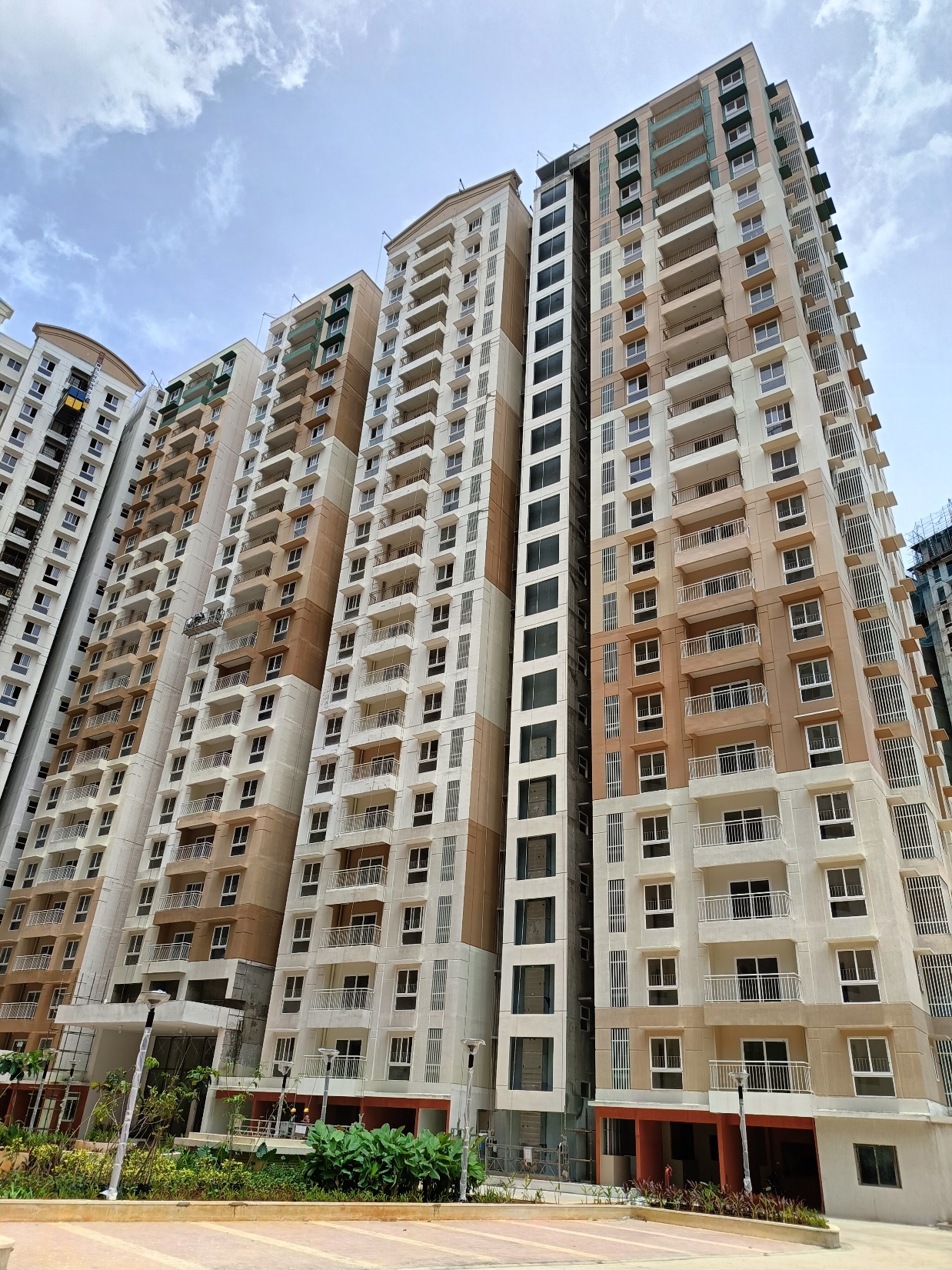

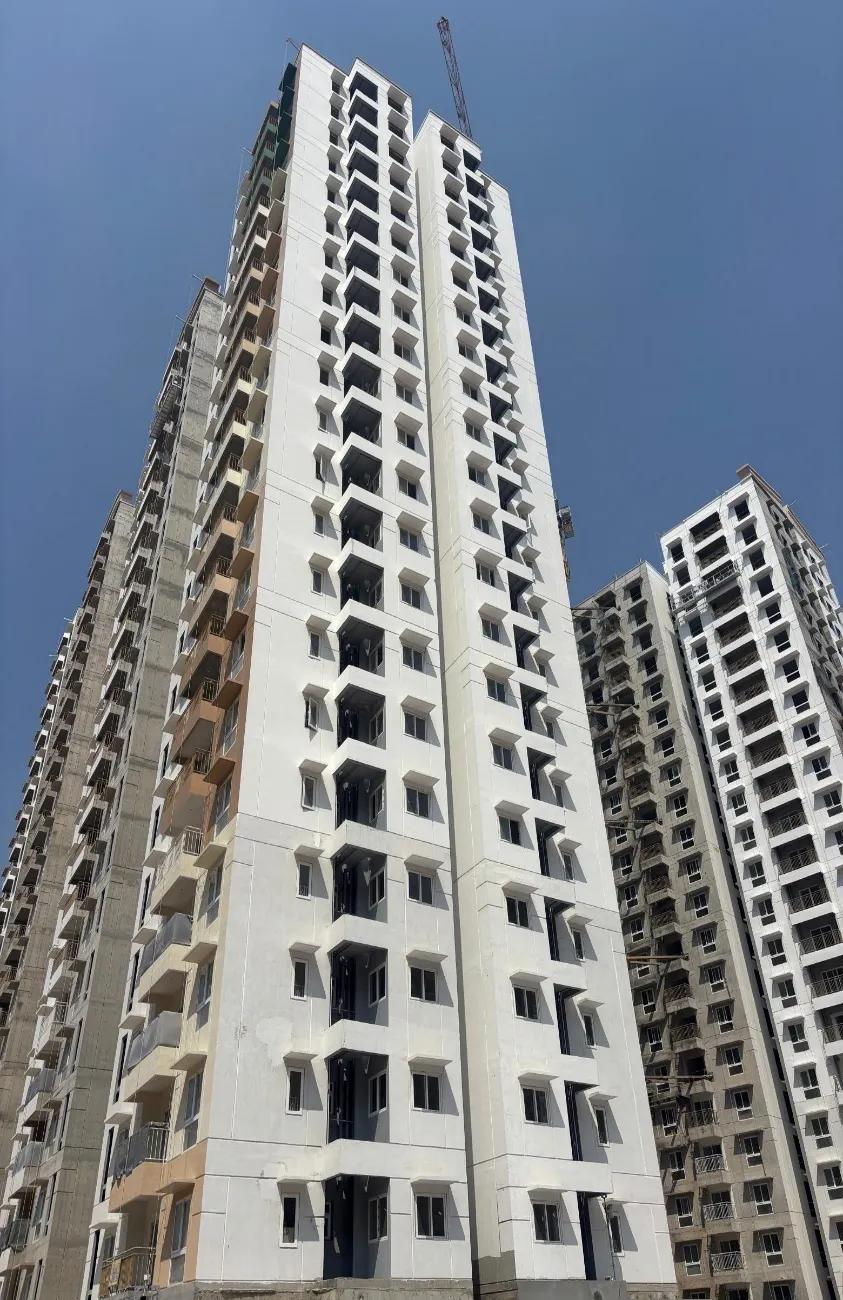

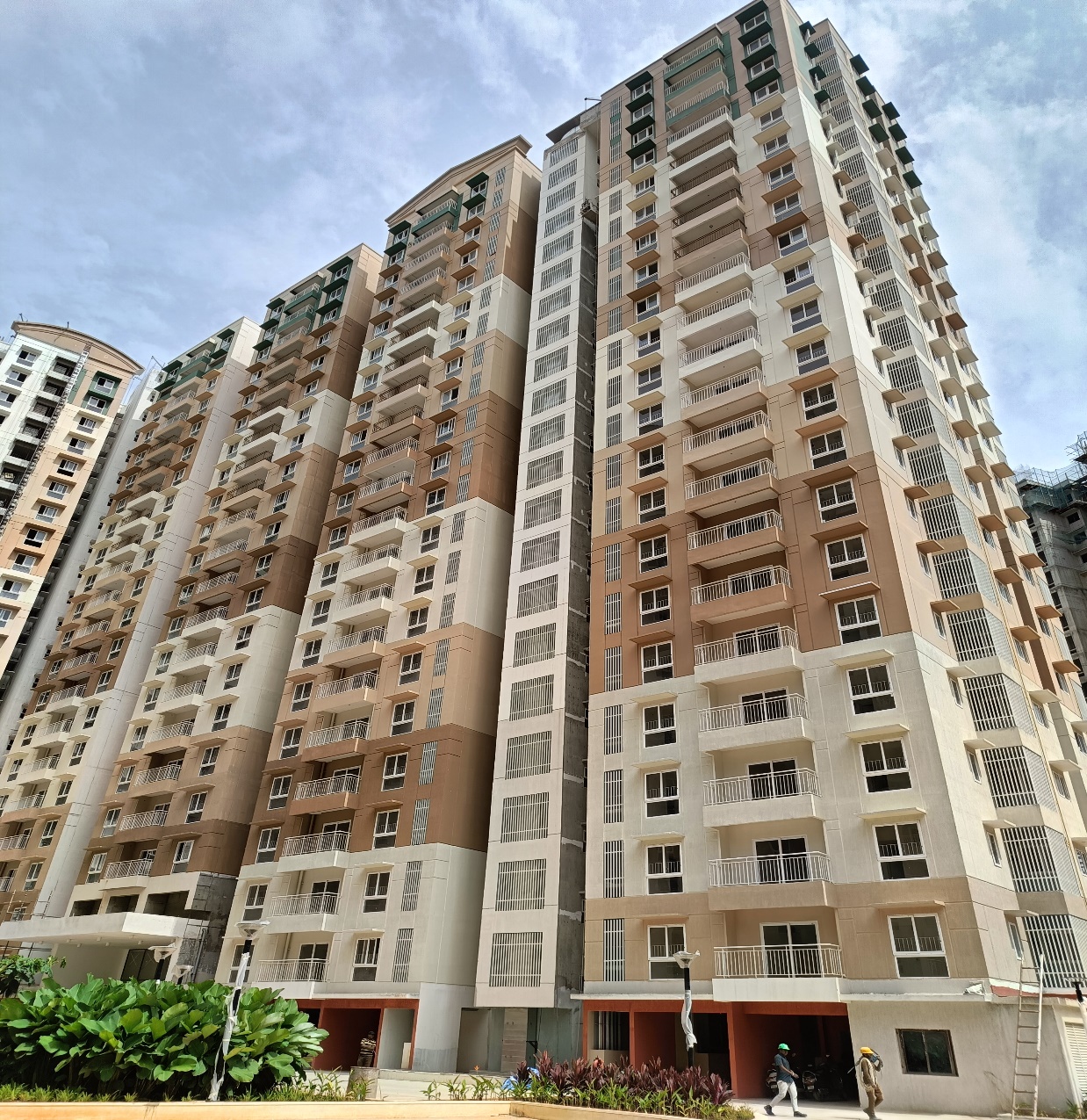

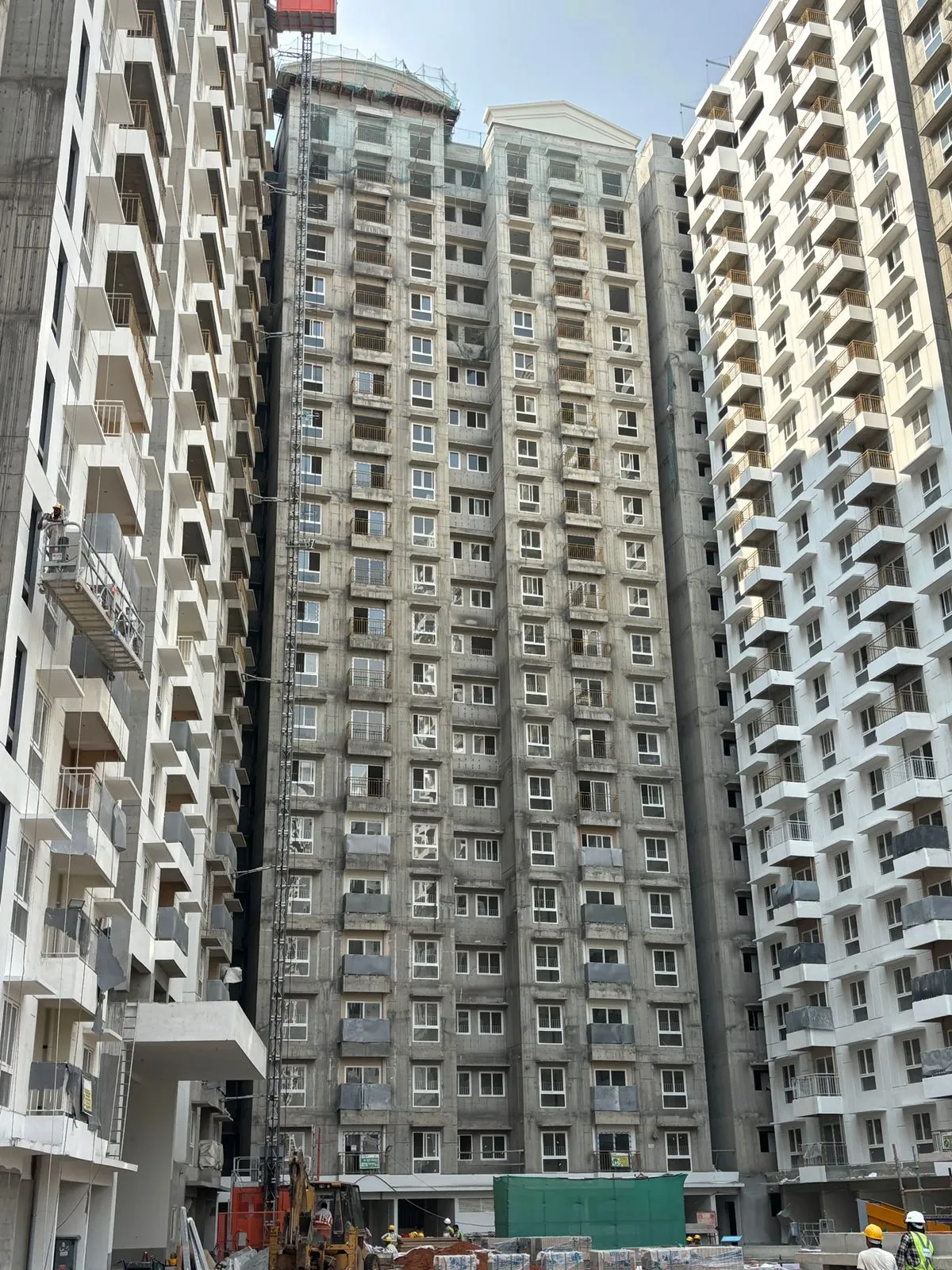

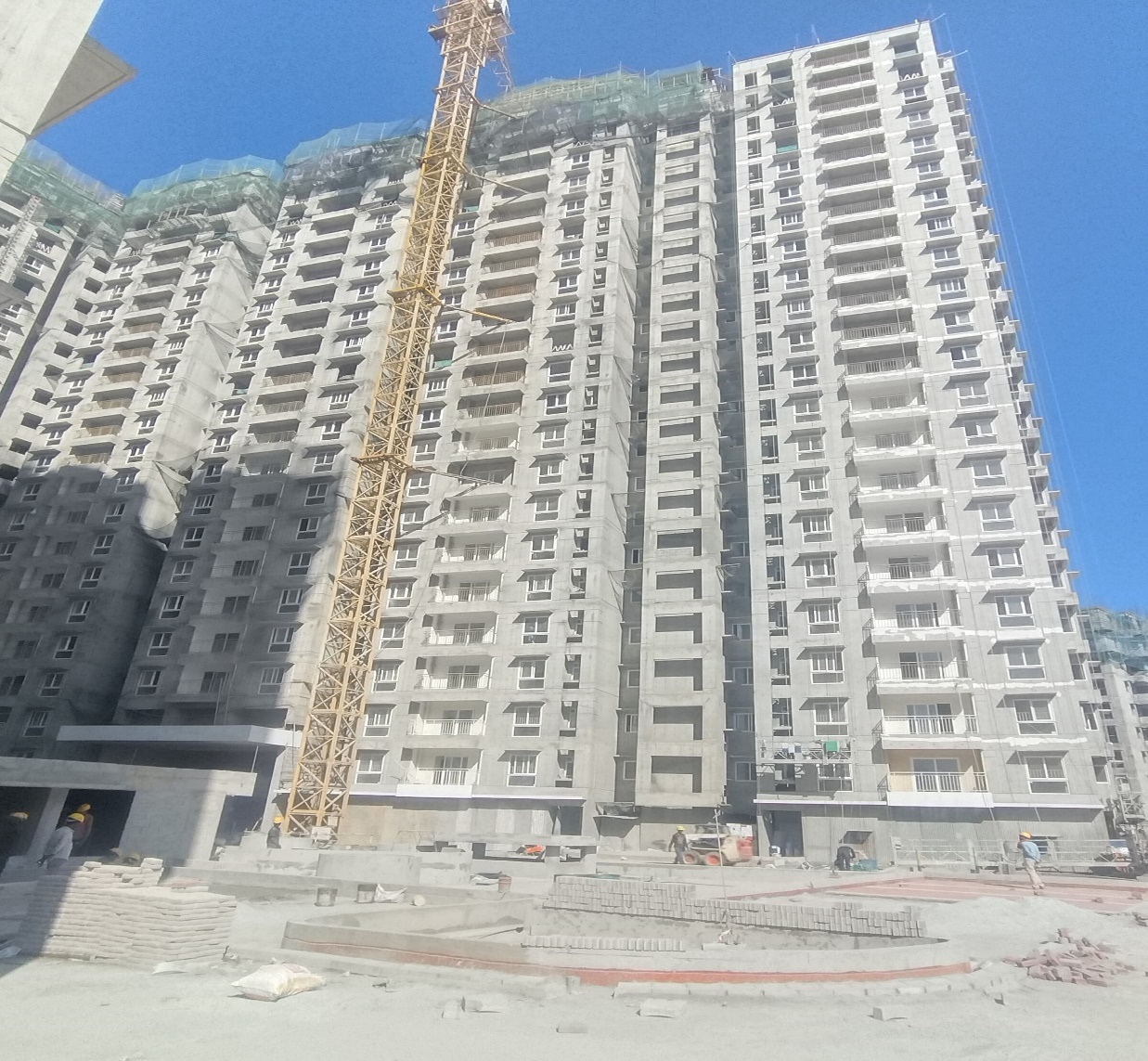

Wing C: Above Terrace floor level painting work in progress - Jun 2025

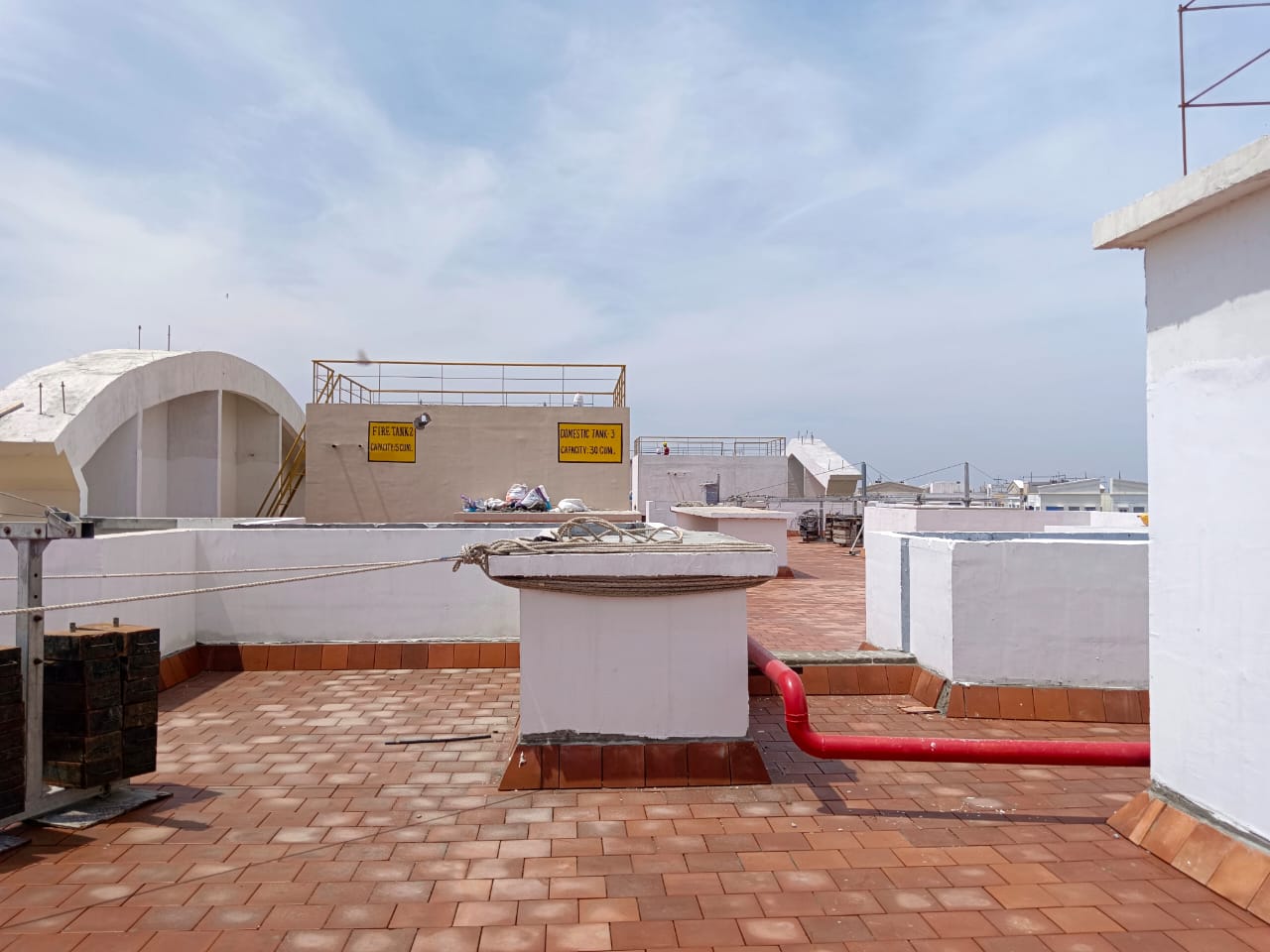

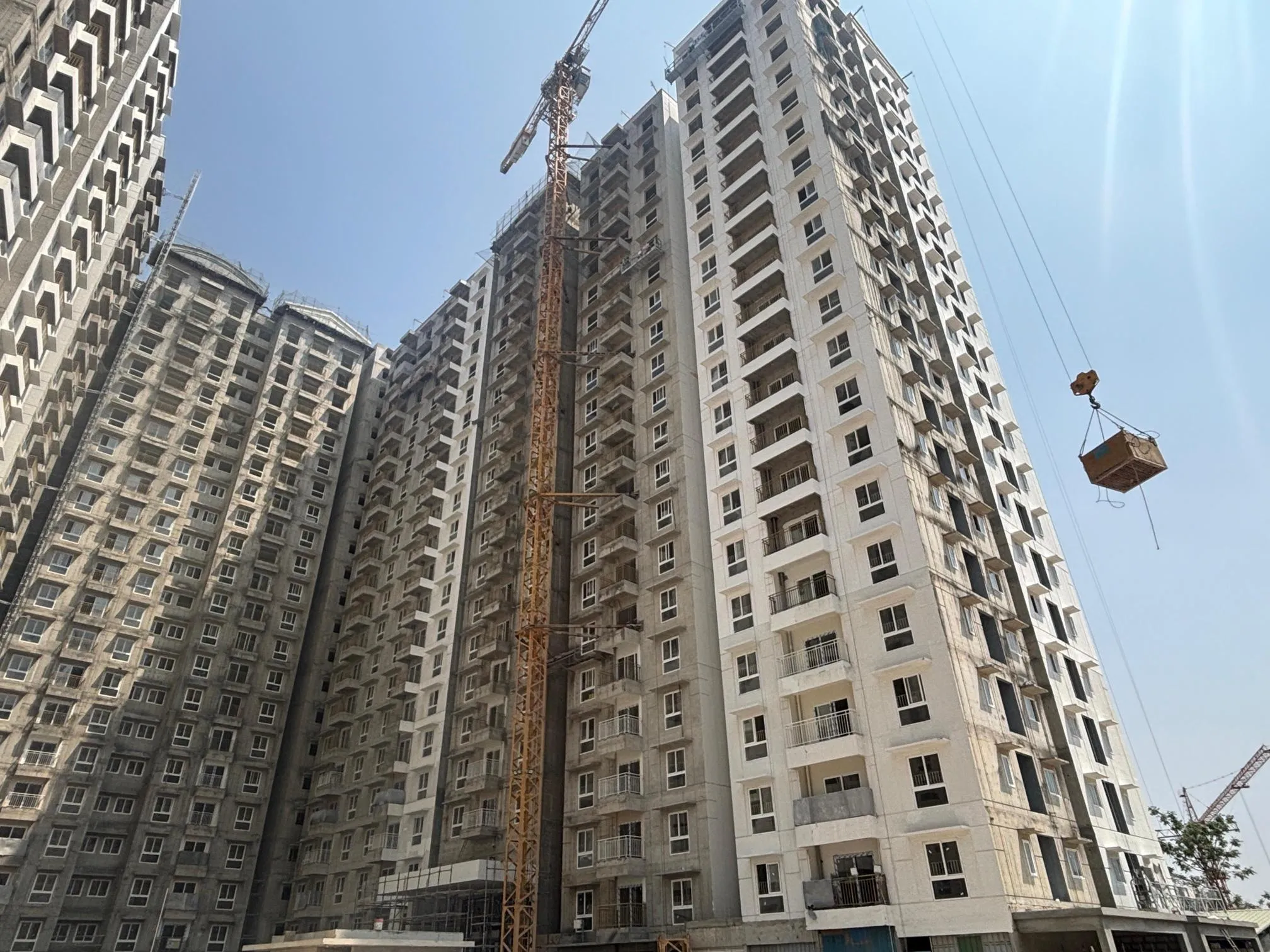

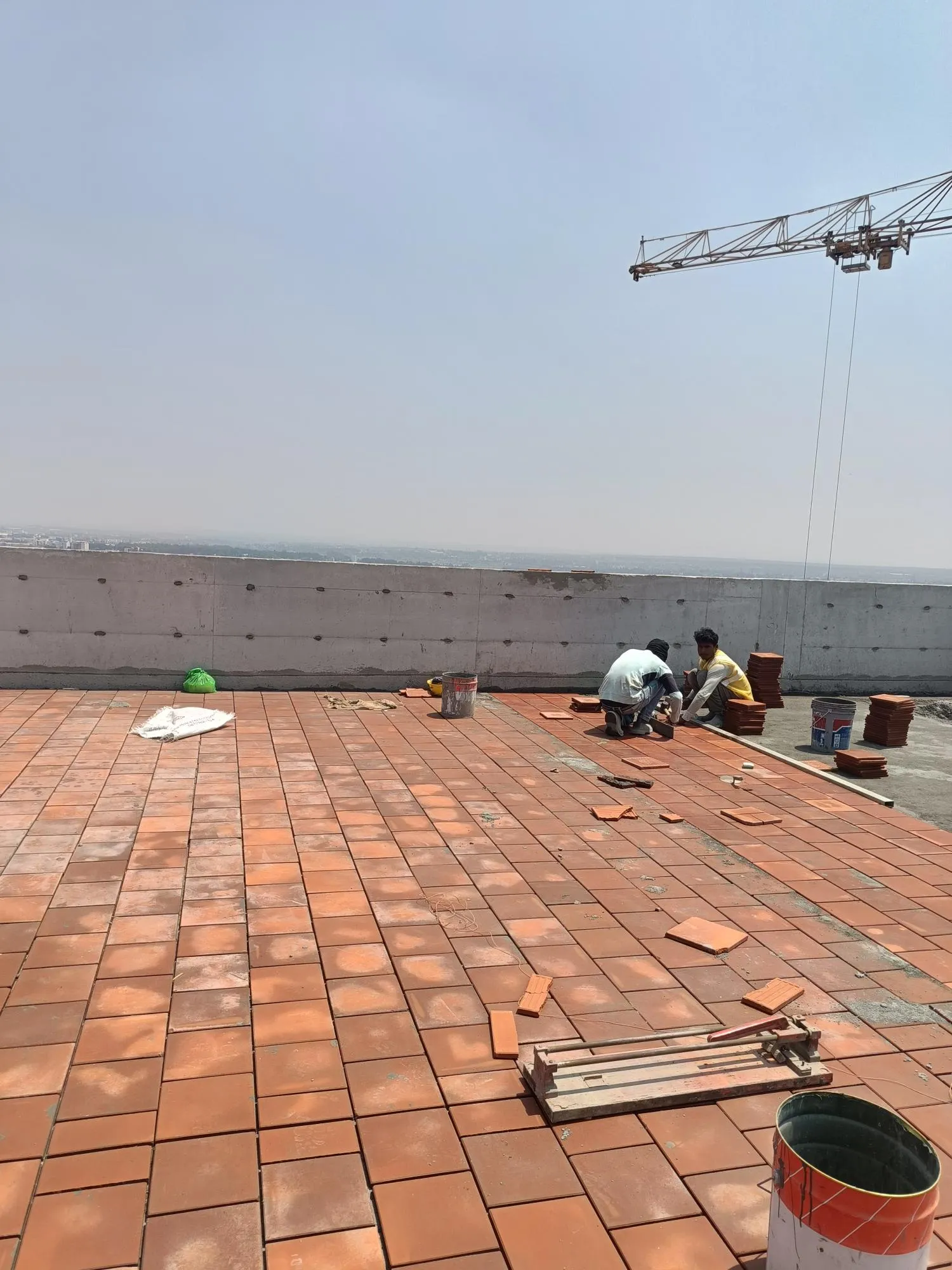

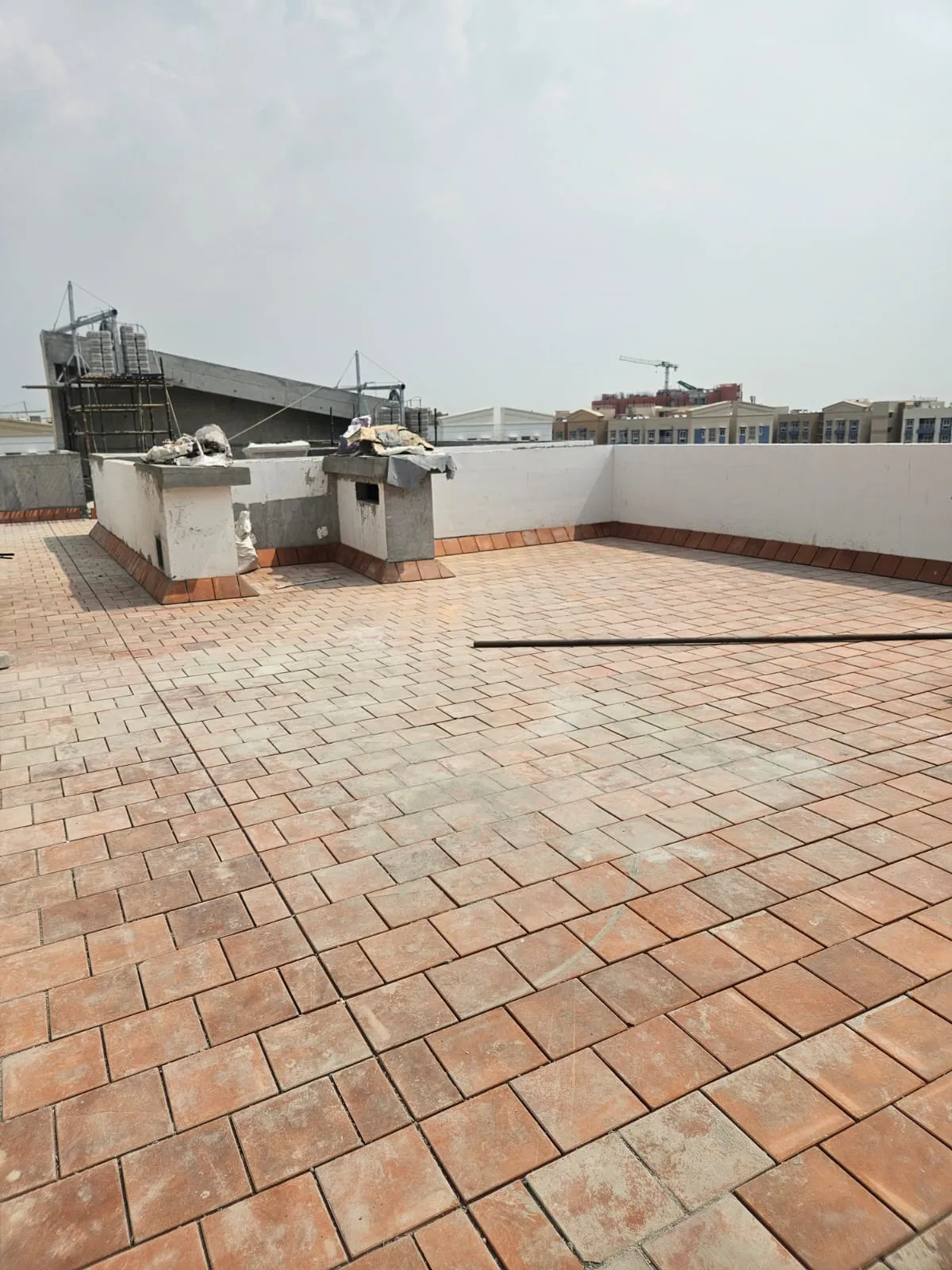

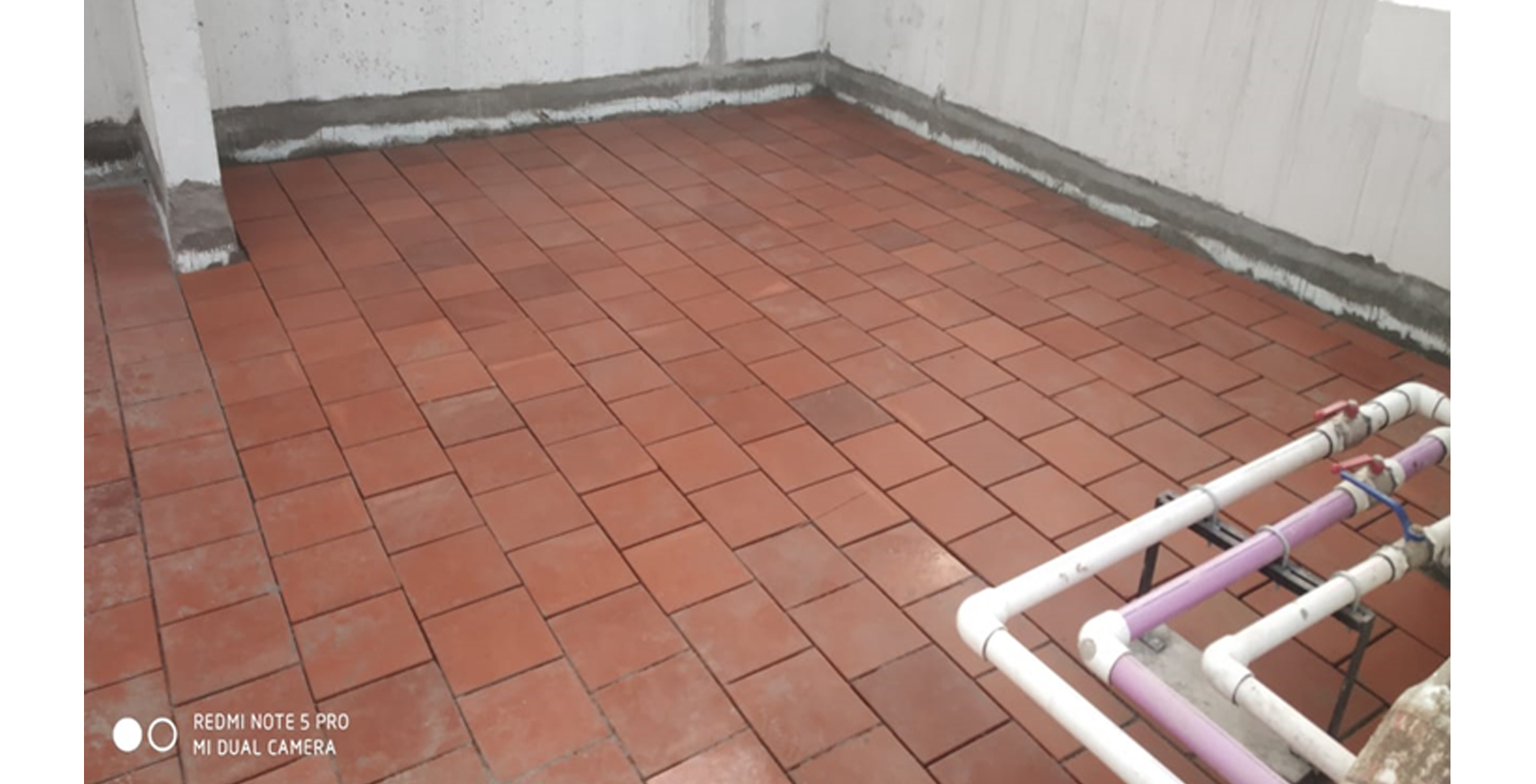

Terrace clay tile and painting work in progress - Jun 2025

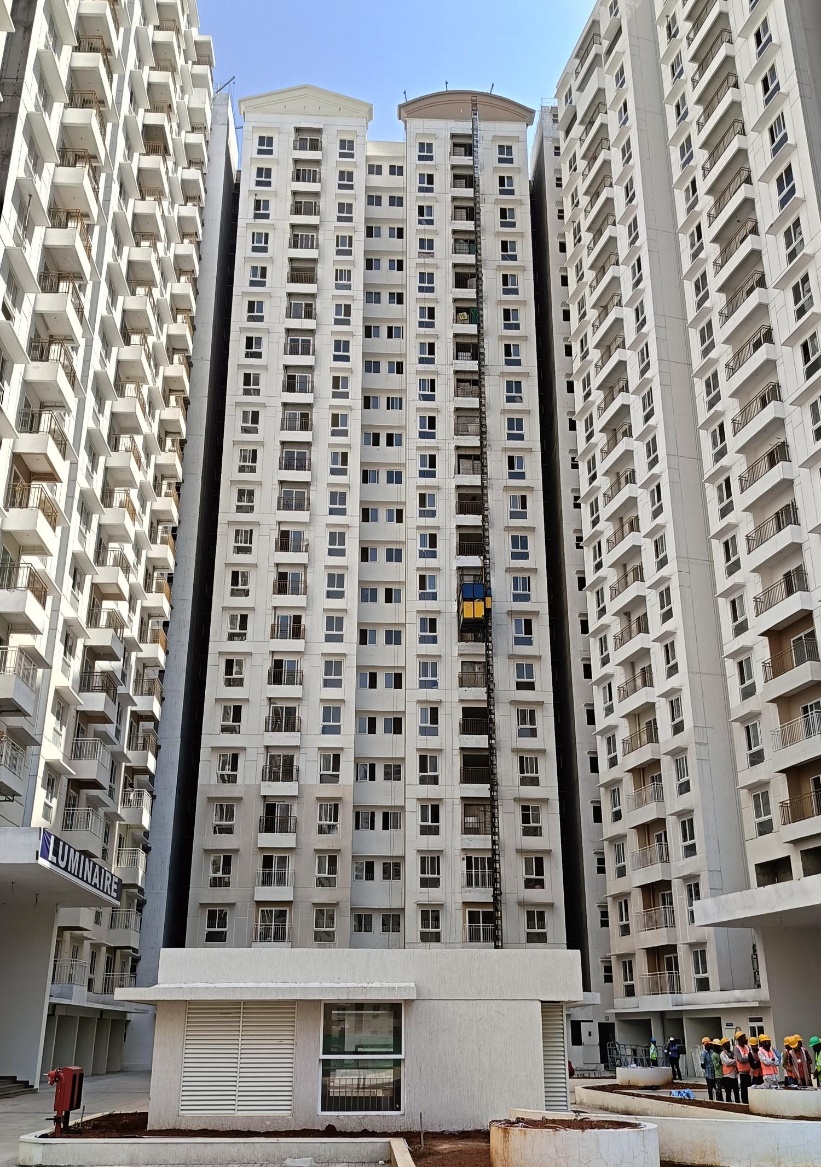

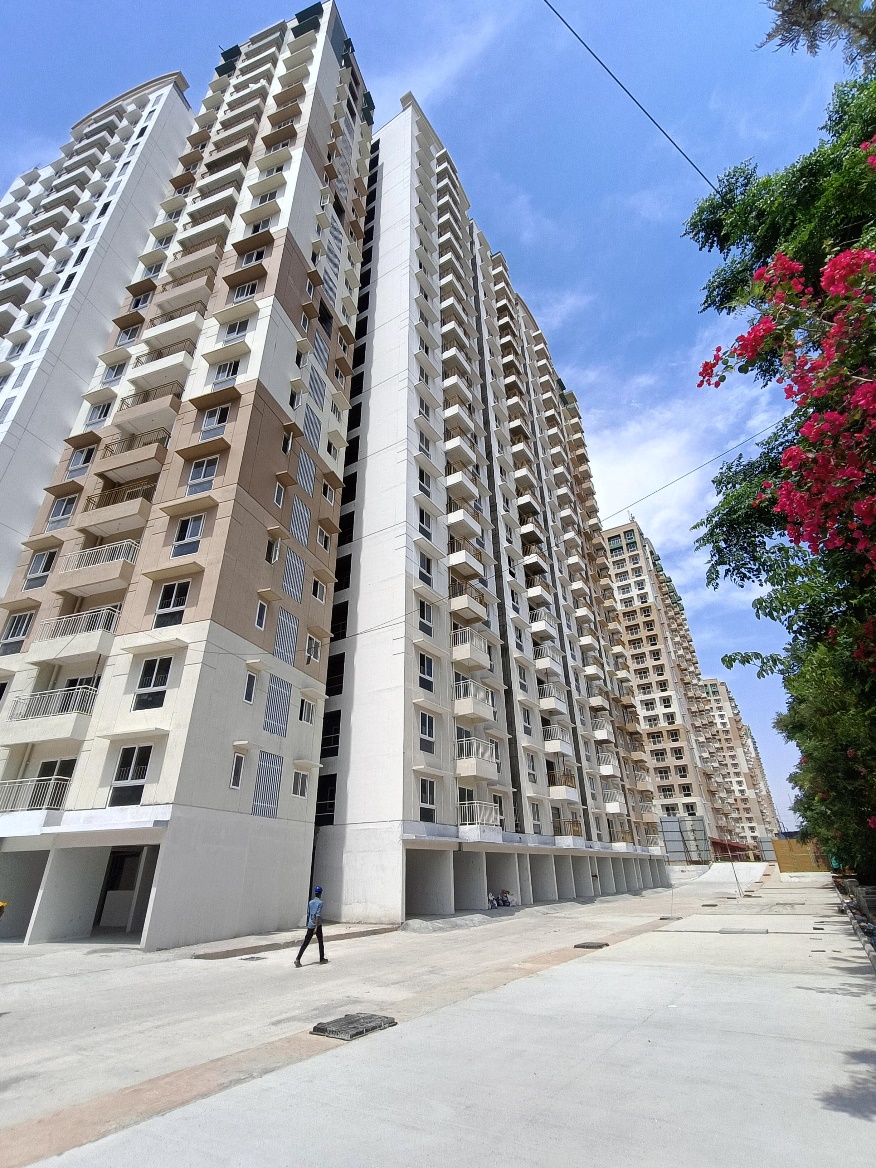

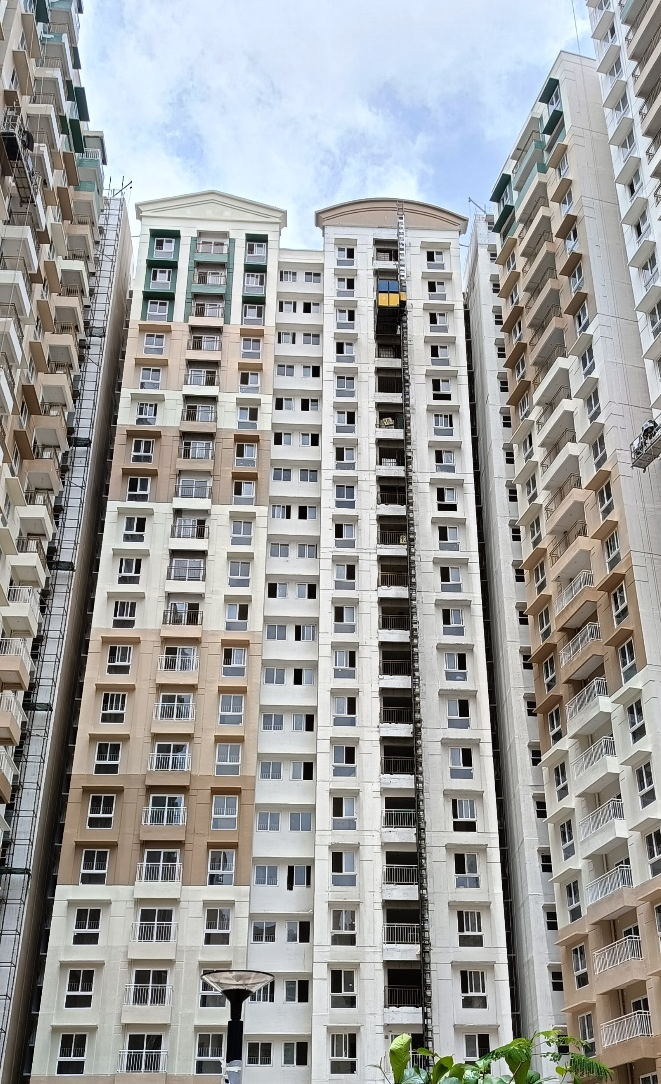

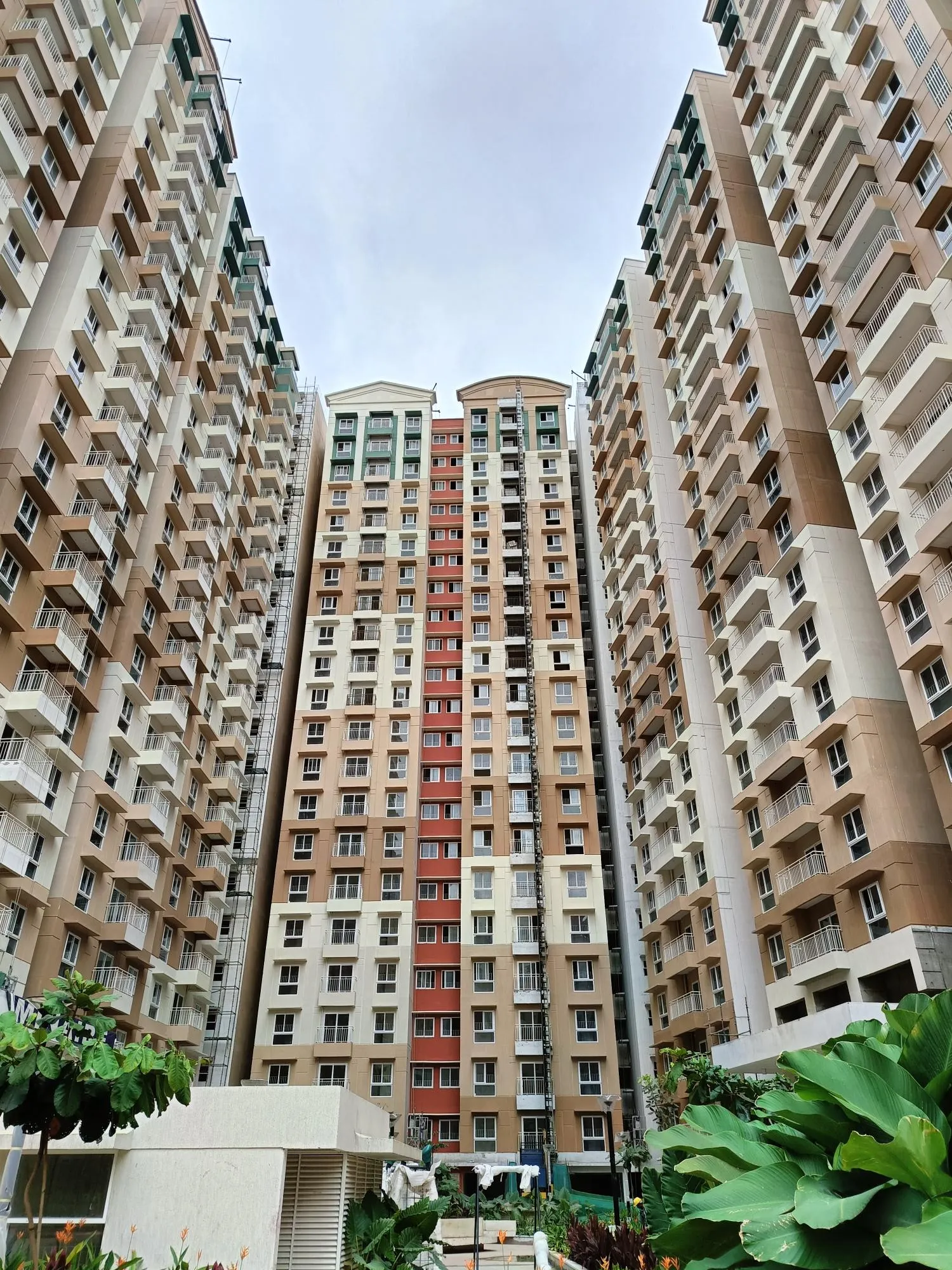

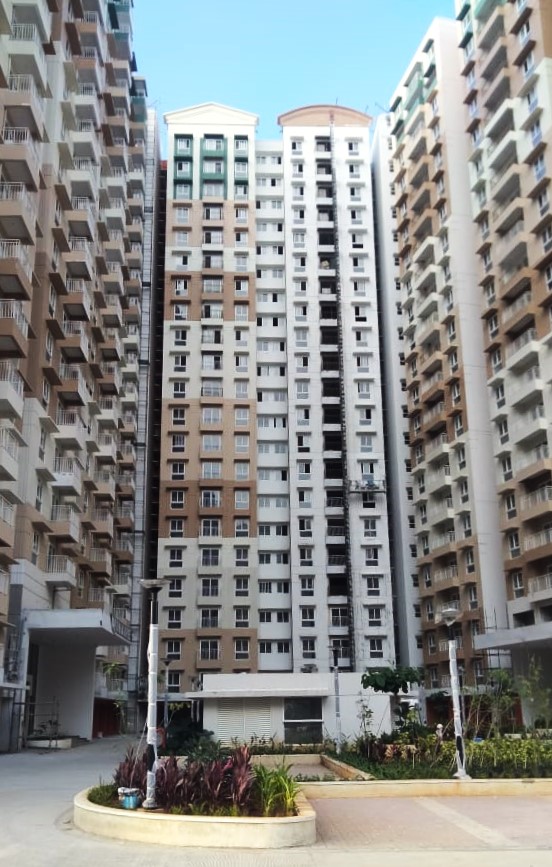

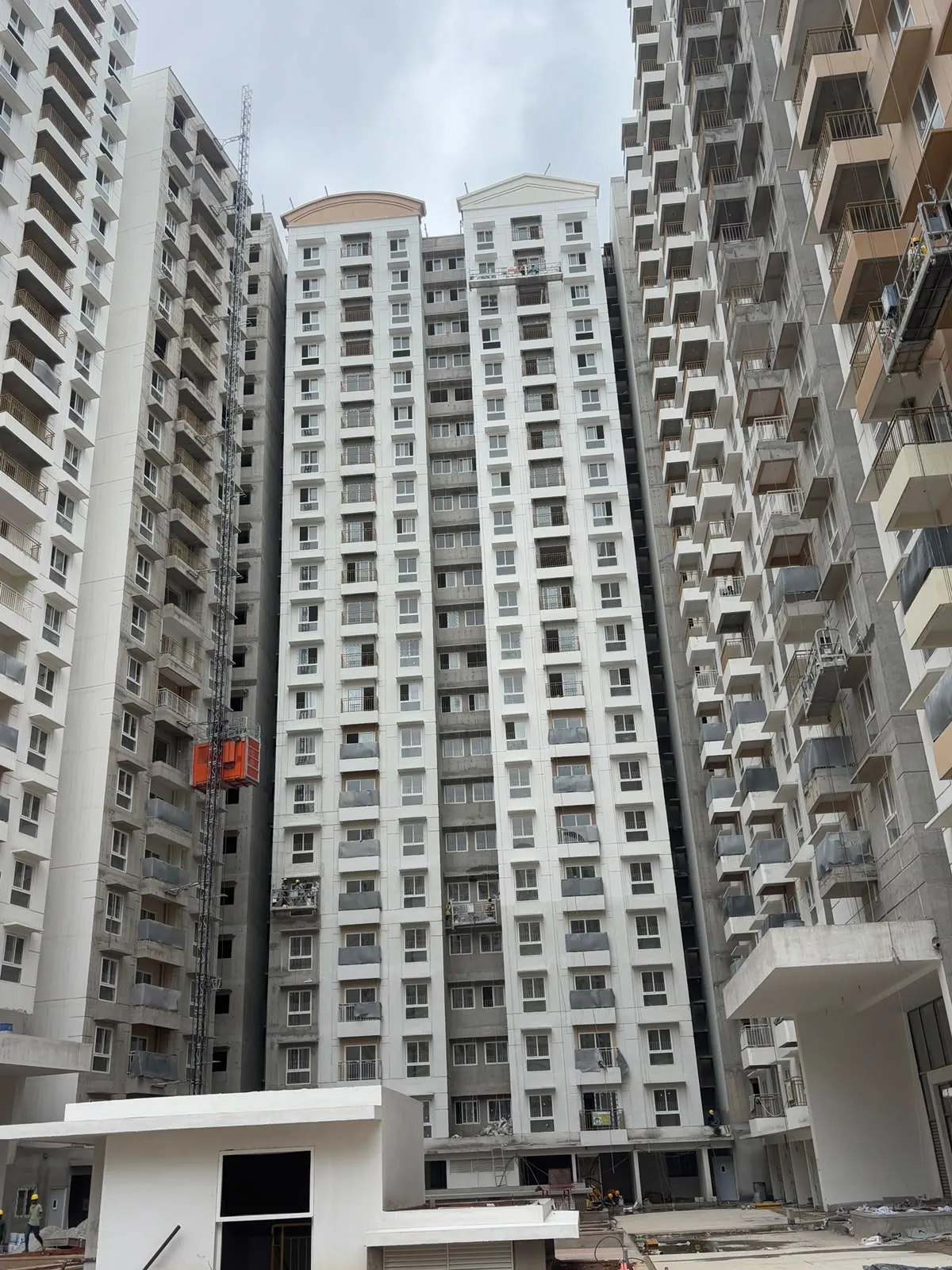

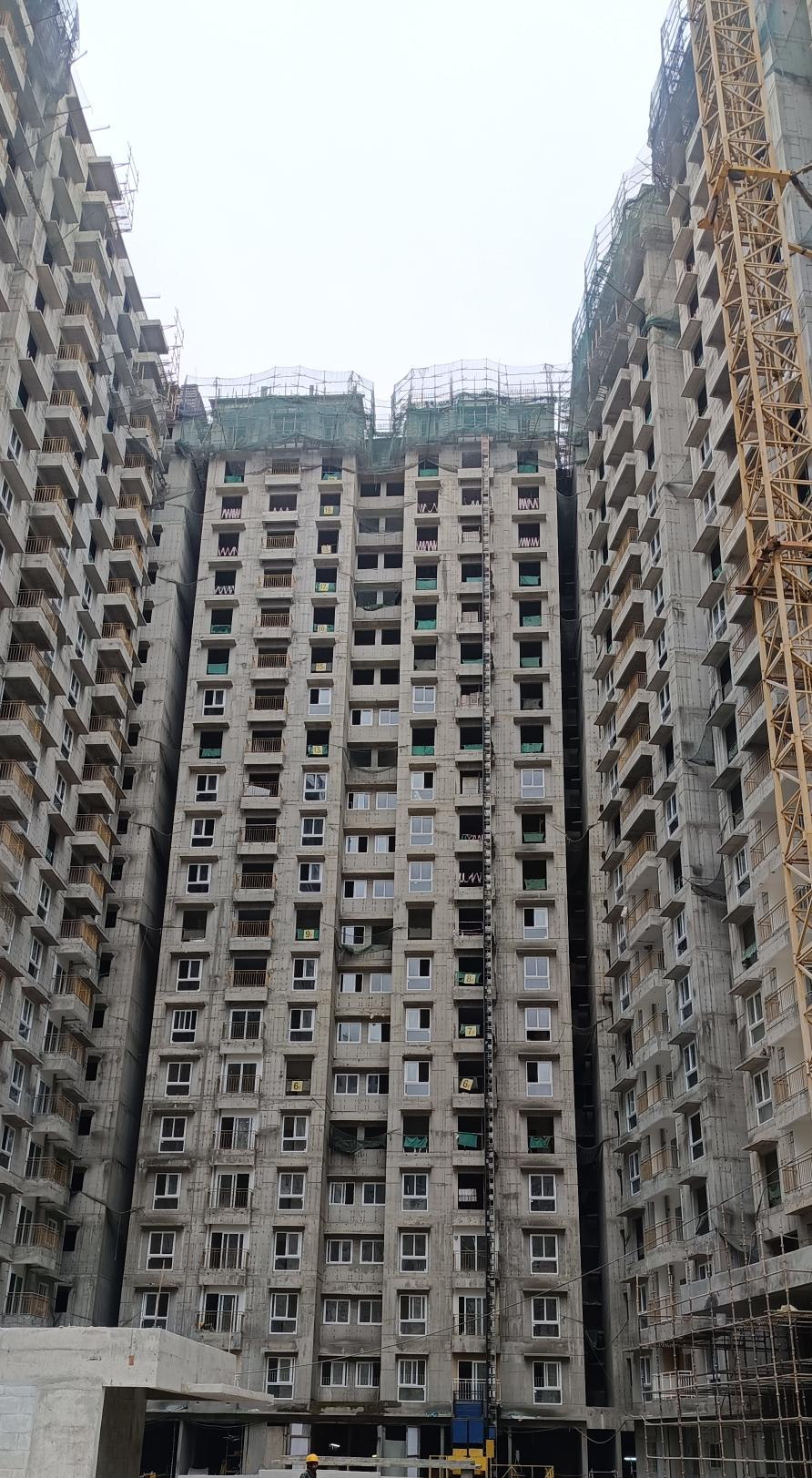

Wing B: Above Terrace level painting work in progress - Jun 2025

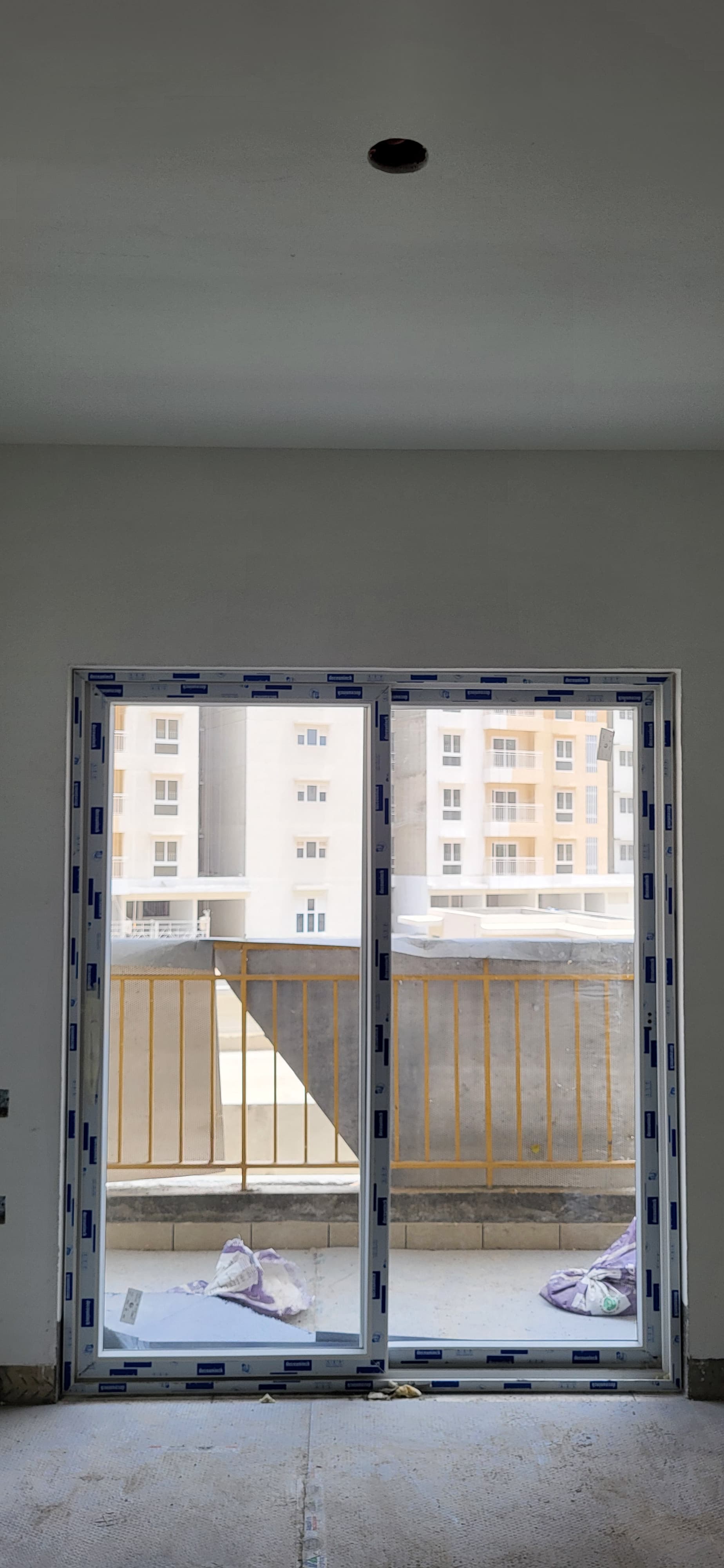

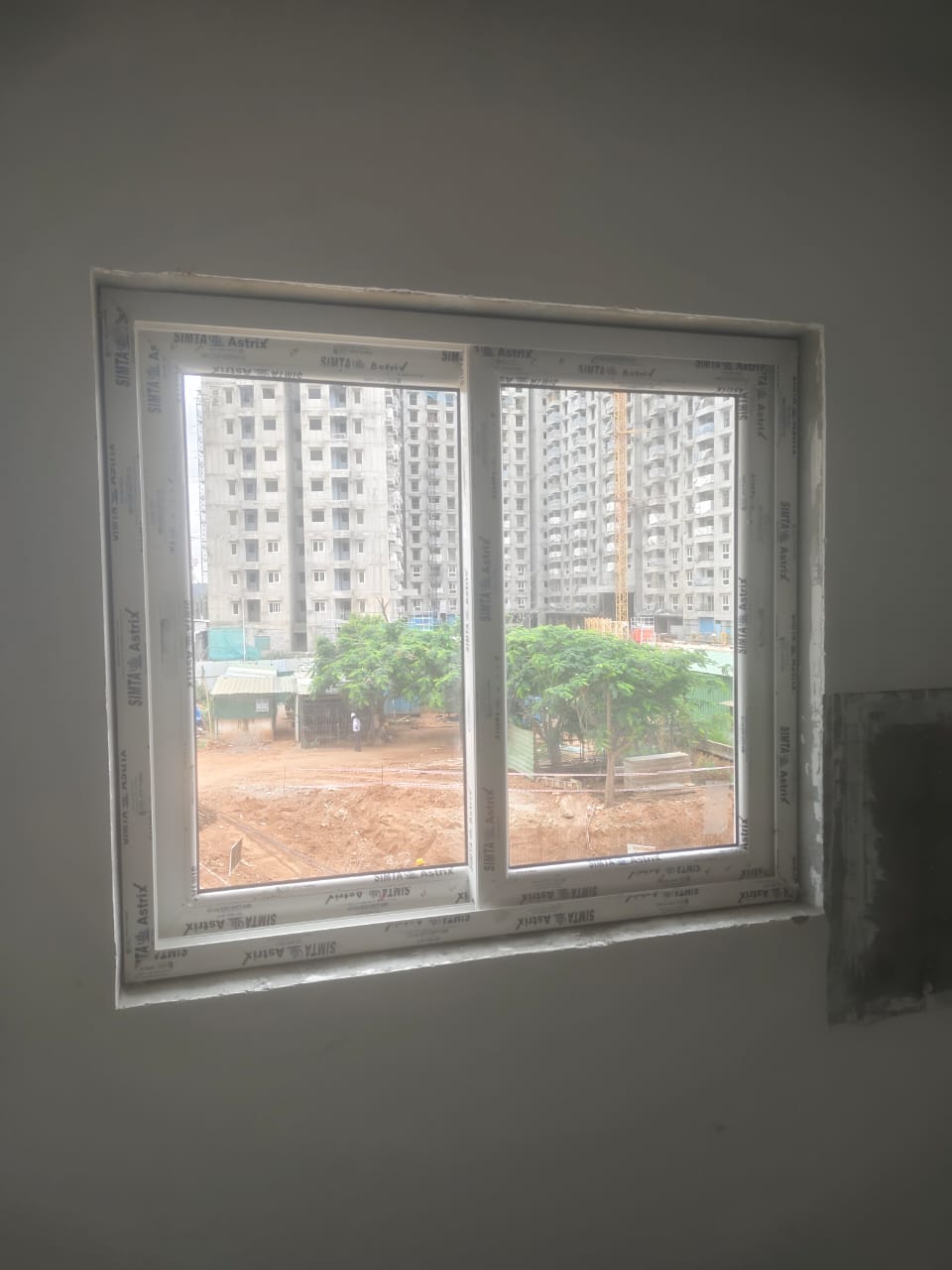

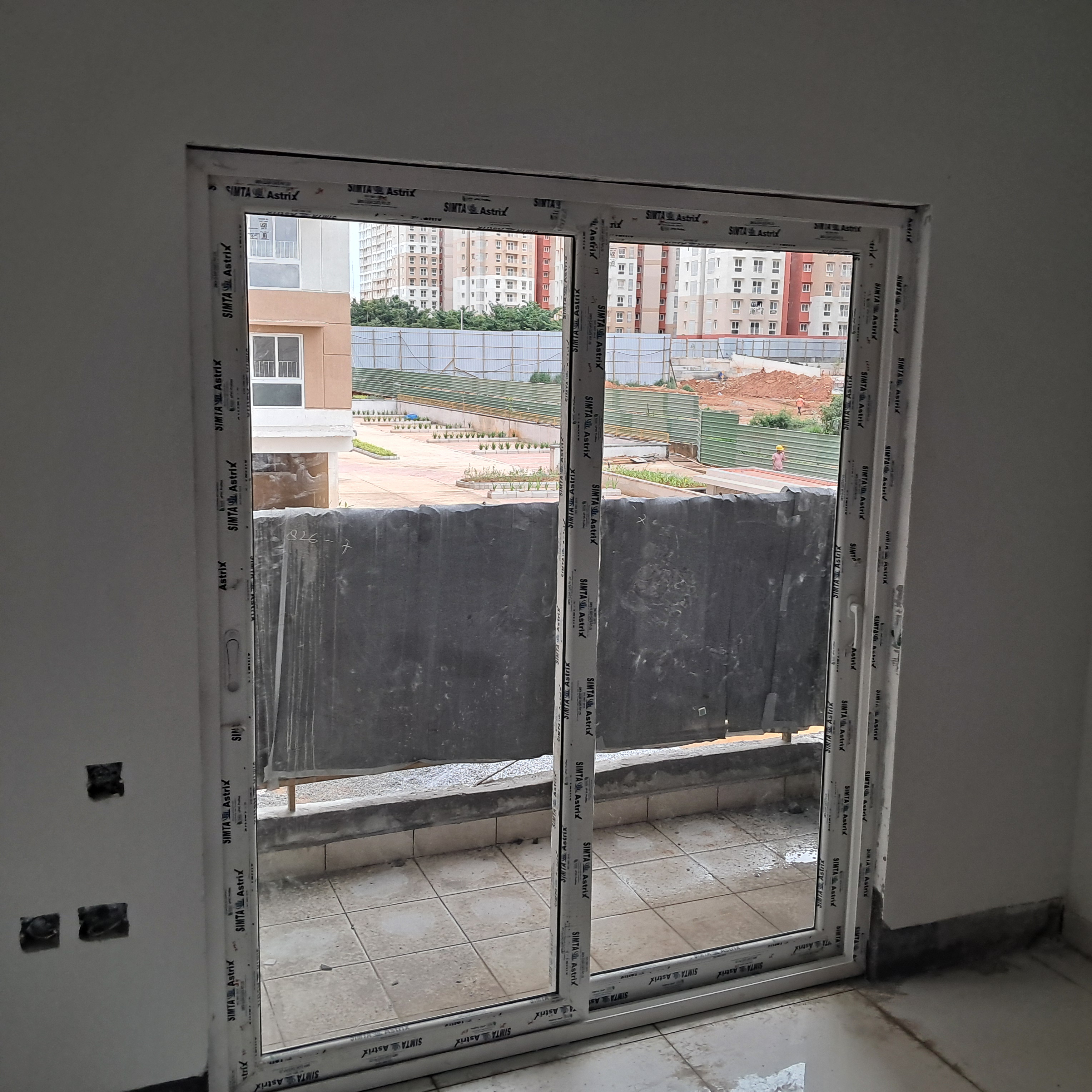

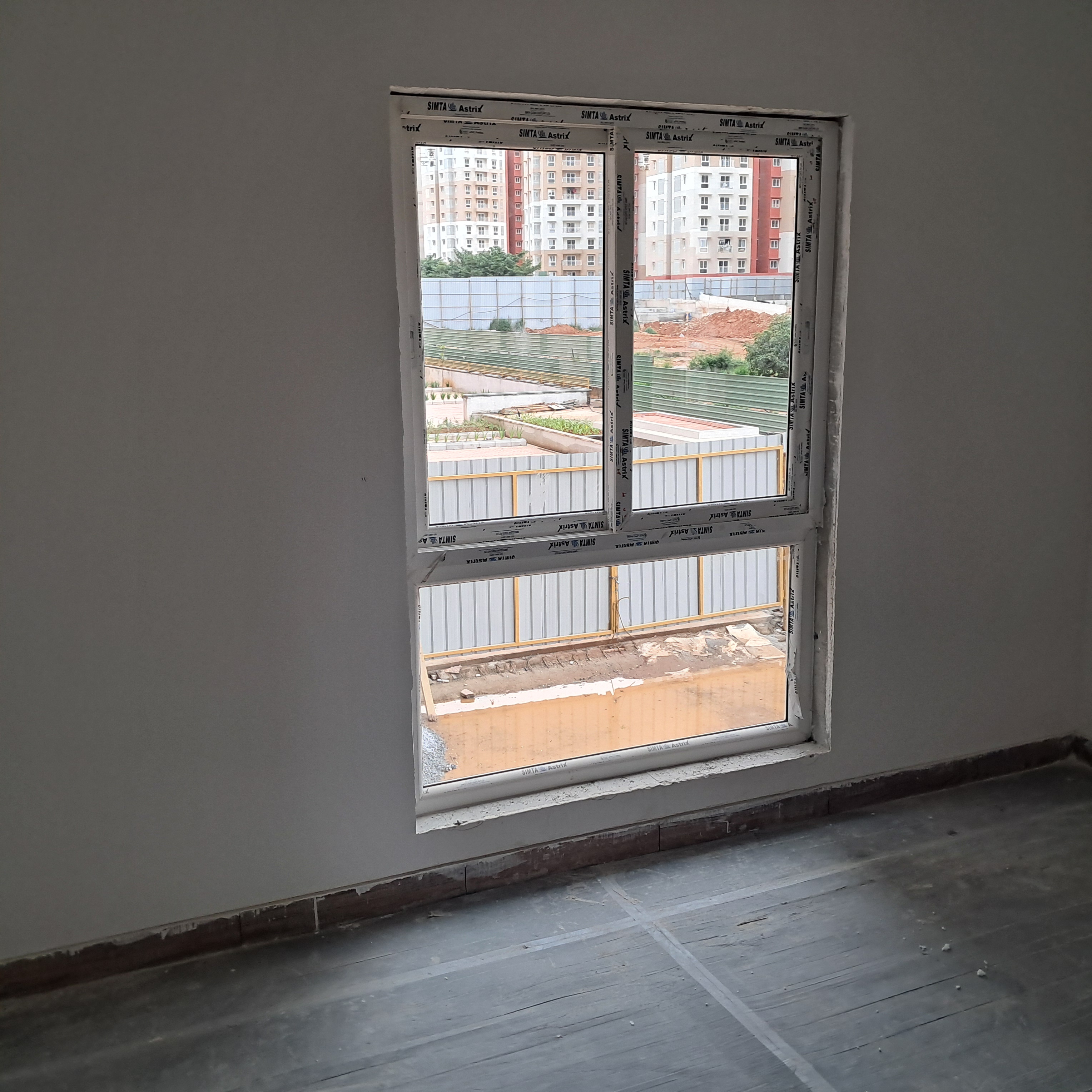

UPVC doors and windows –work in progress - Jun 2025

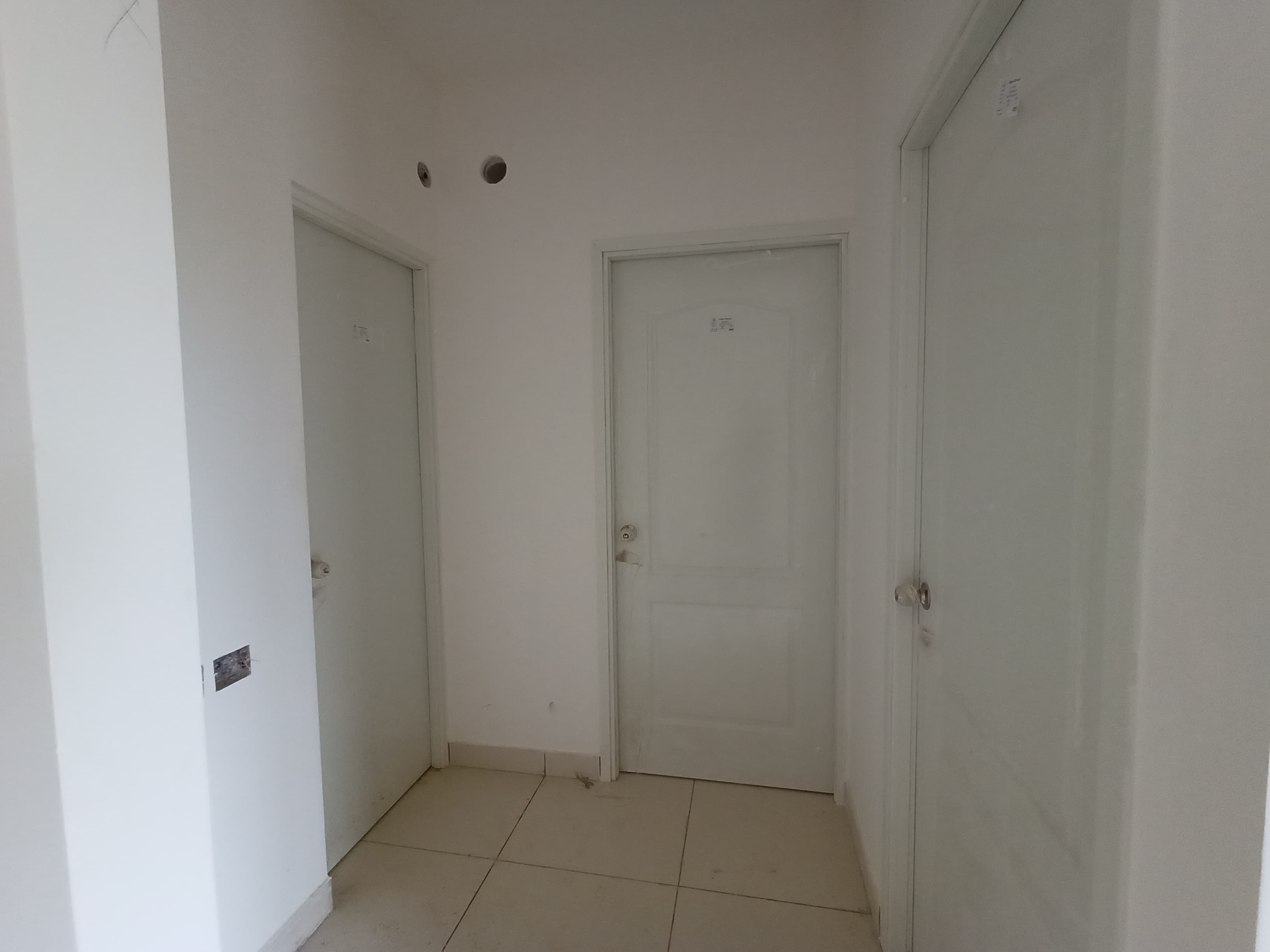

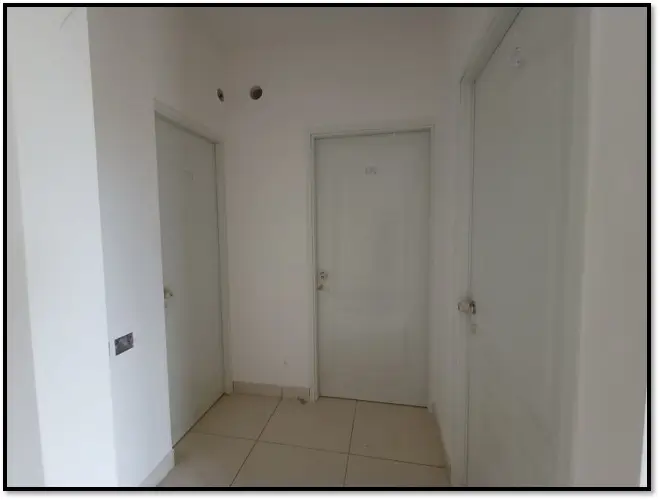

Fixing of doors –work in progress - Jun 2025

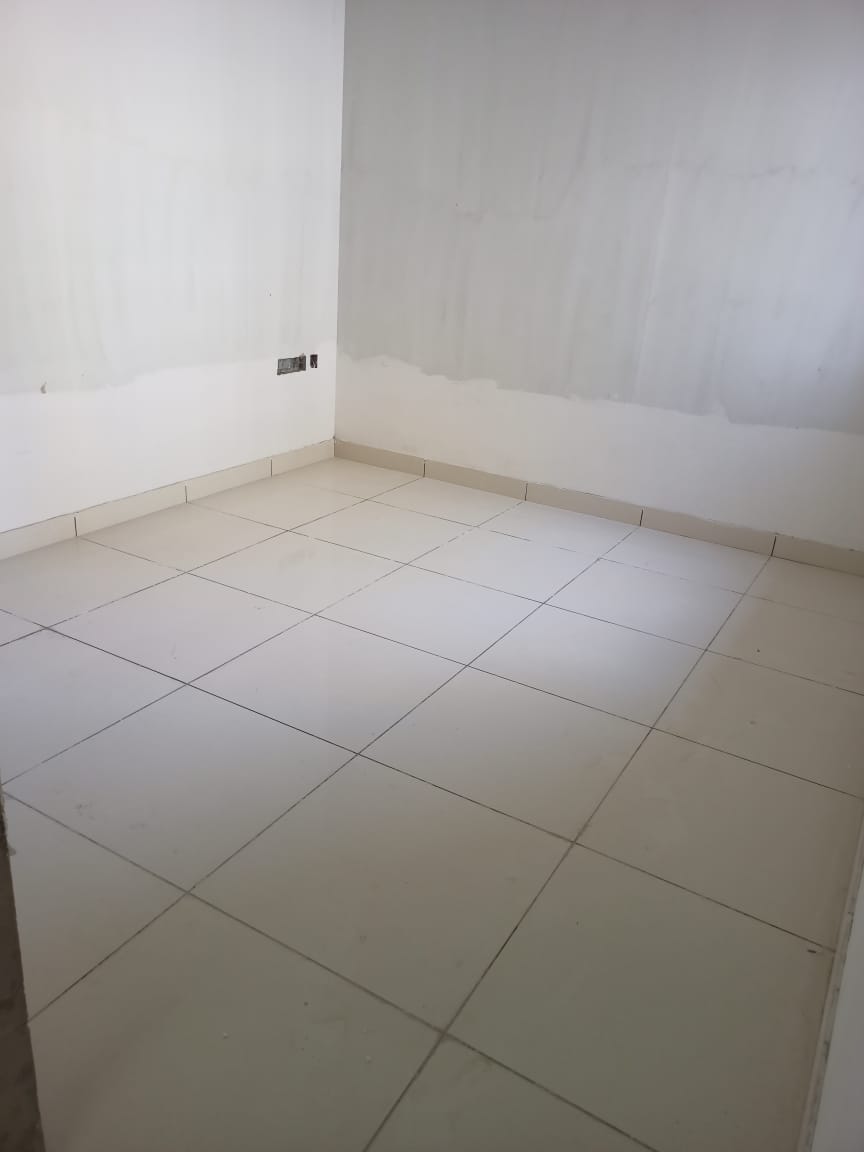

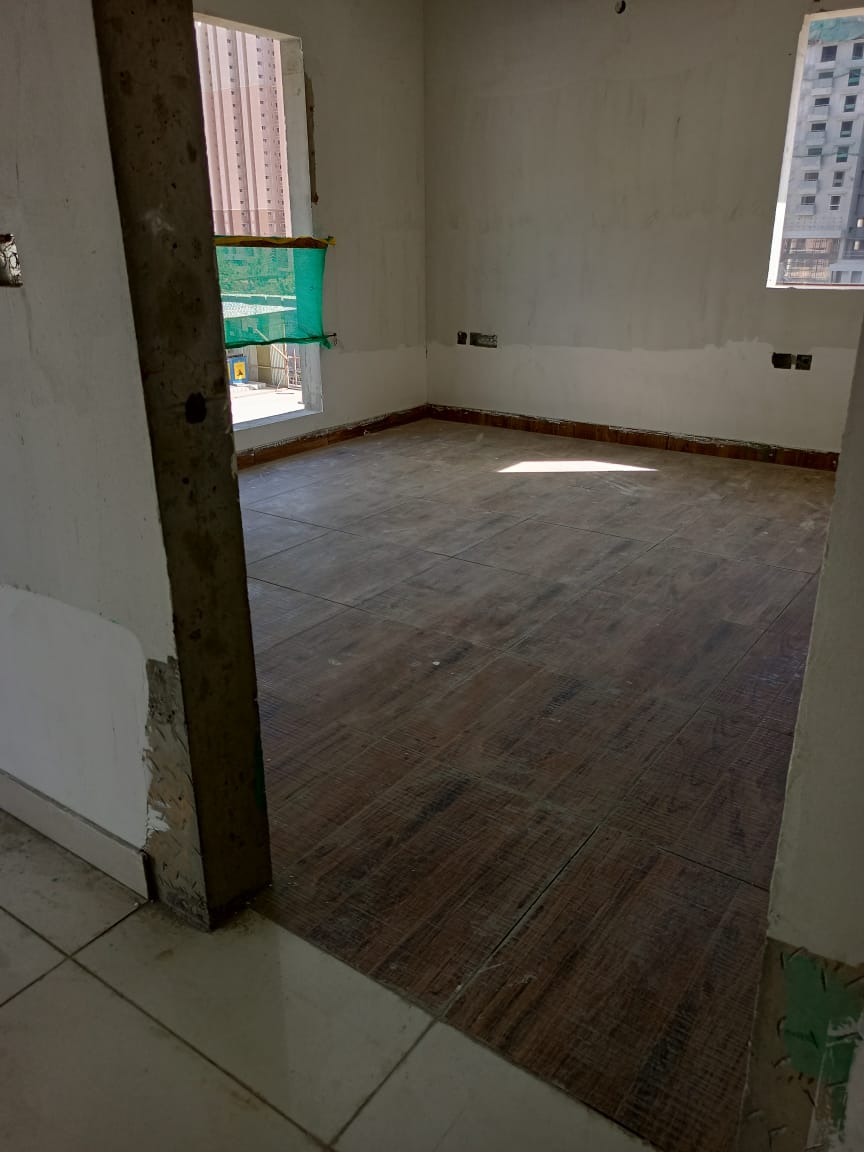

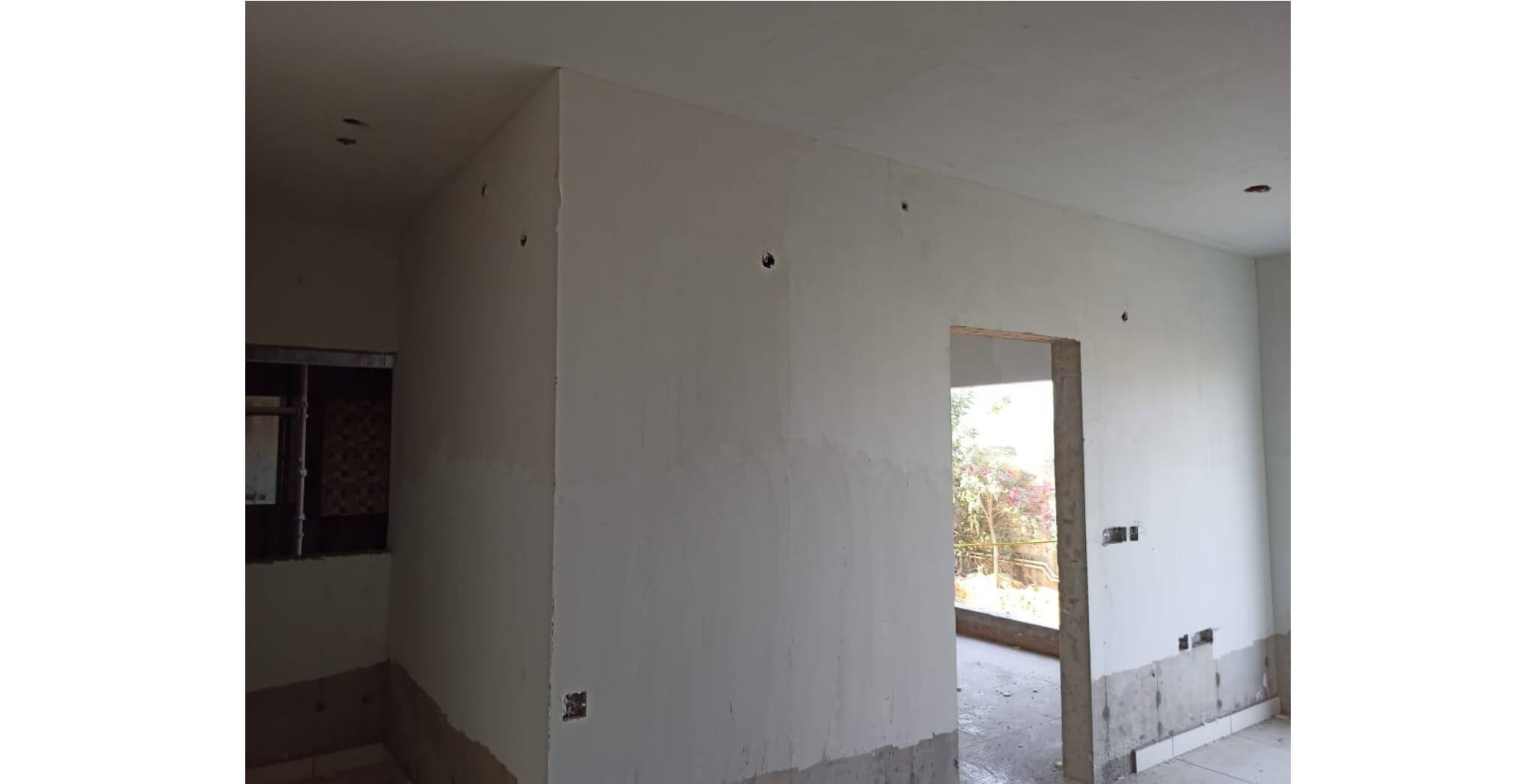

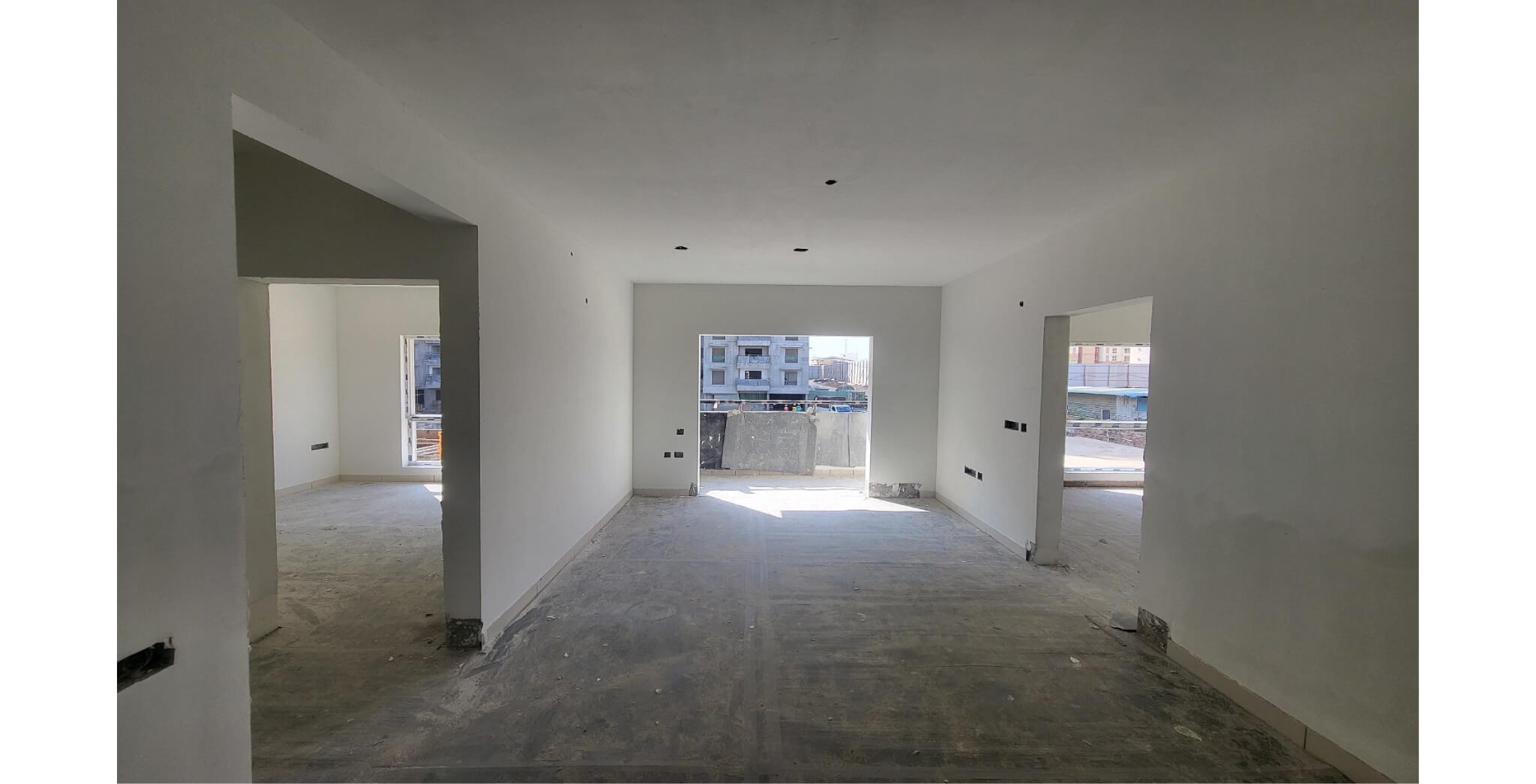

Painting (Putty) –work in progress - Jun 2025

Painting (Putty) –work in progress - Jun 2025

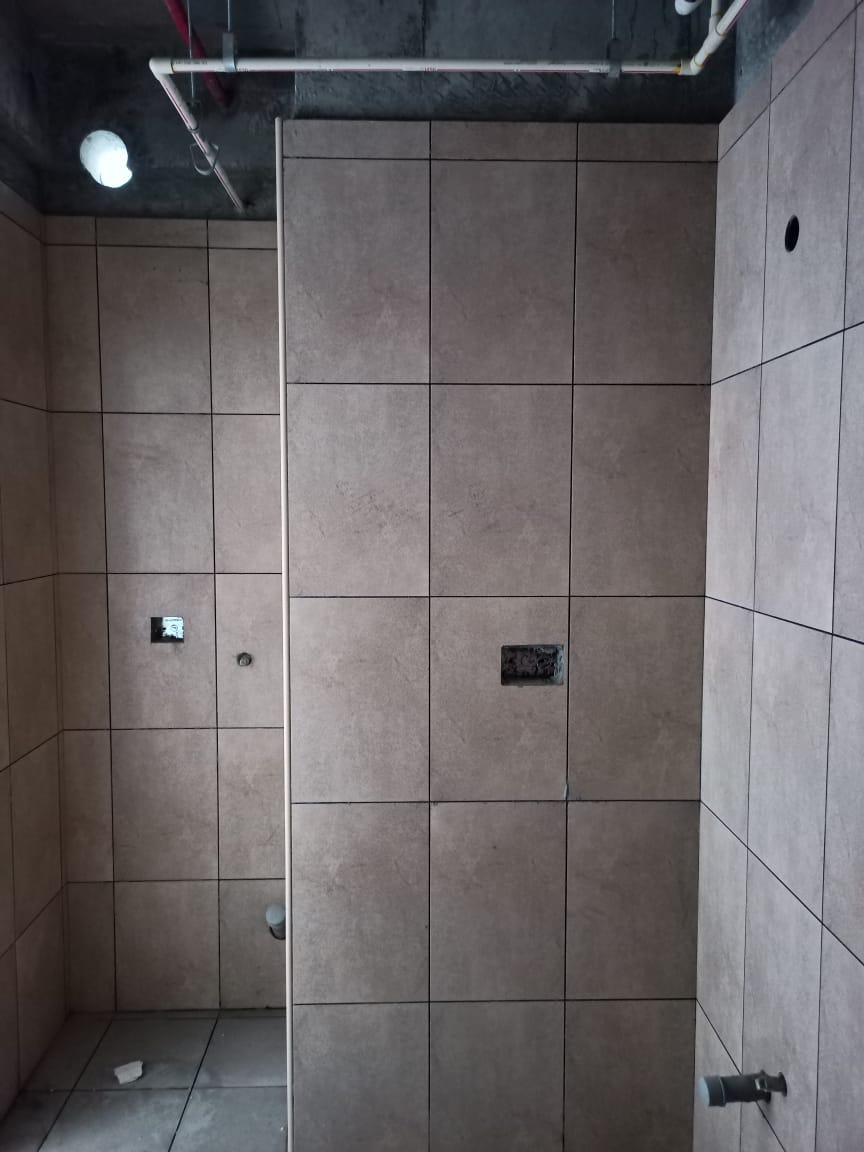

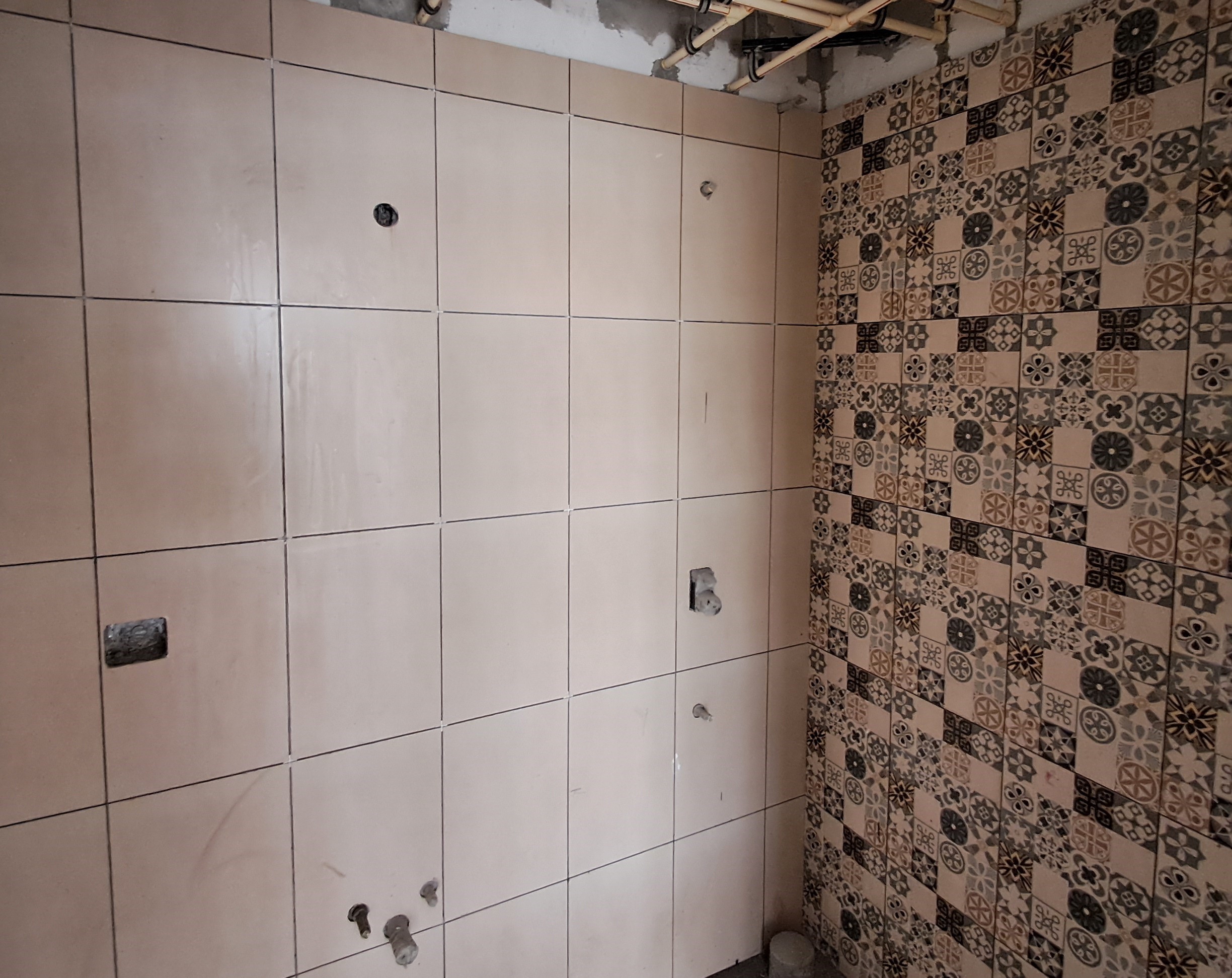

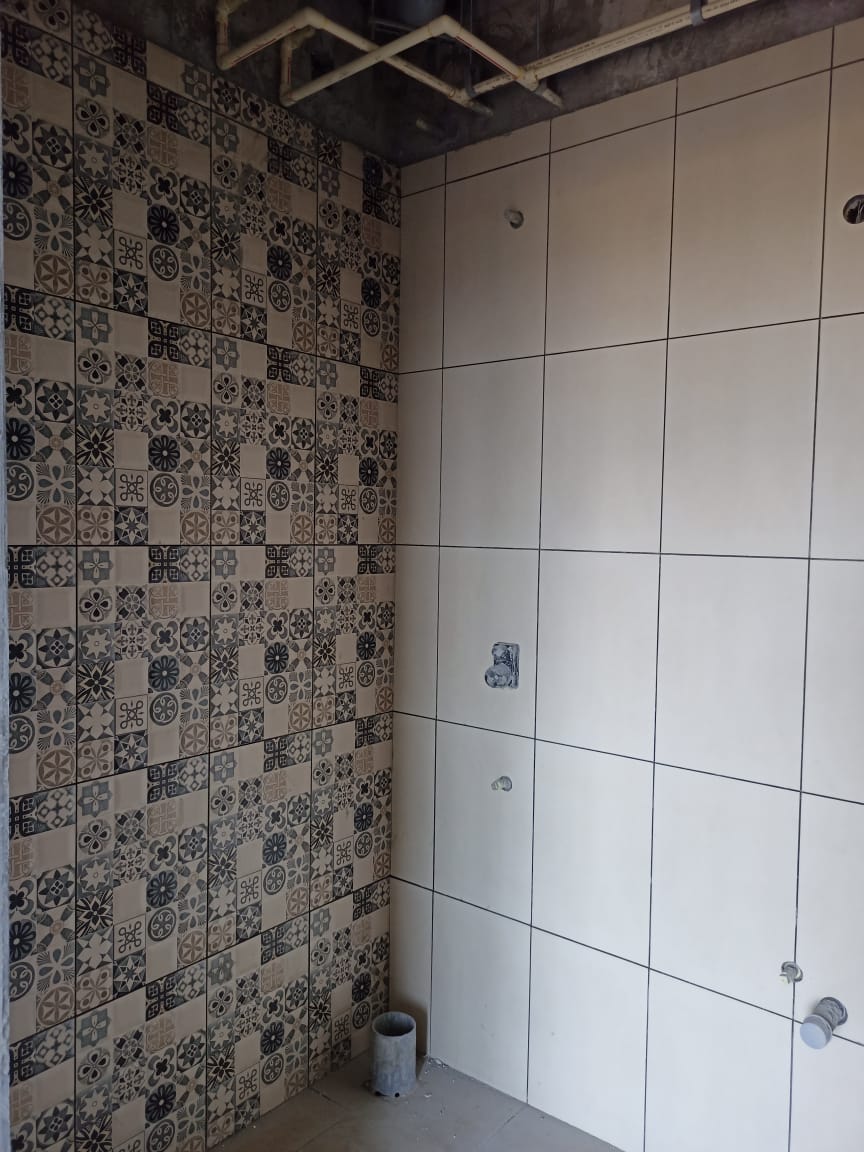

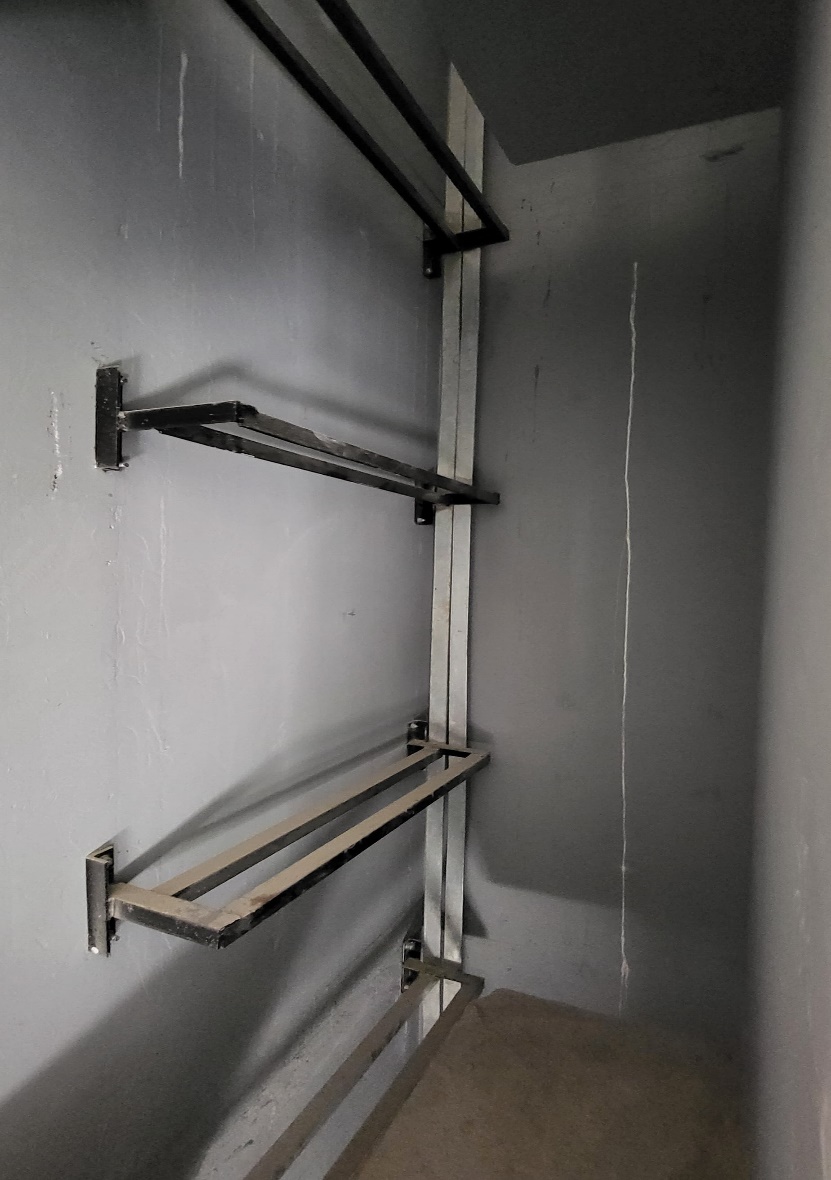

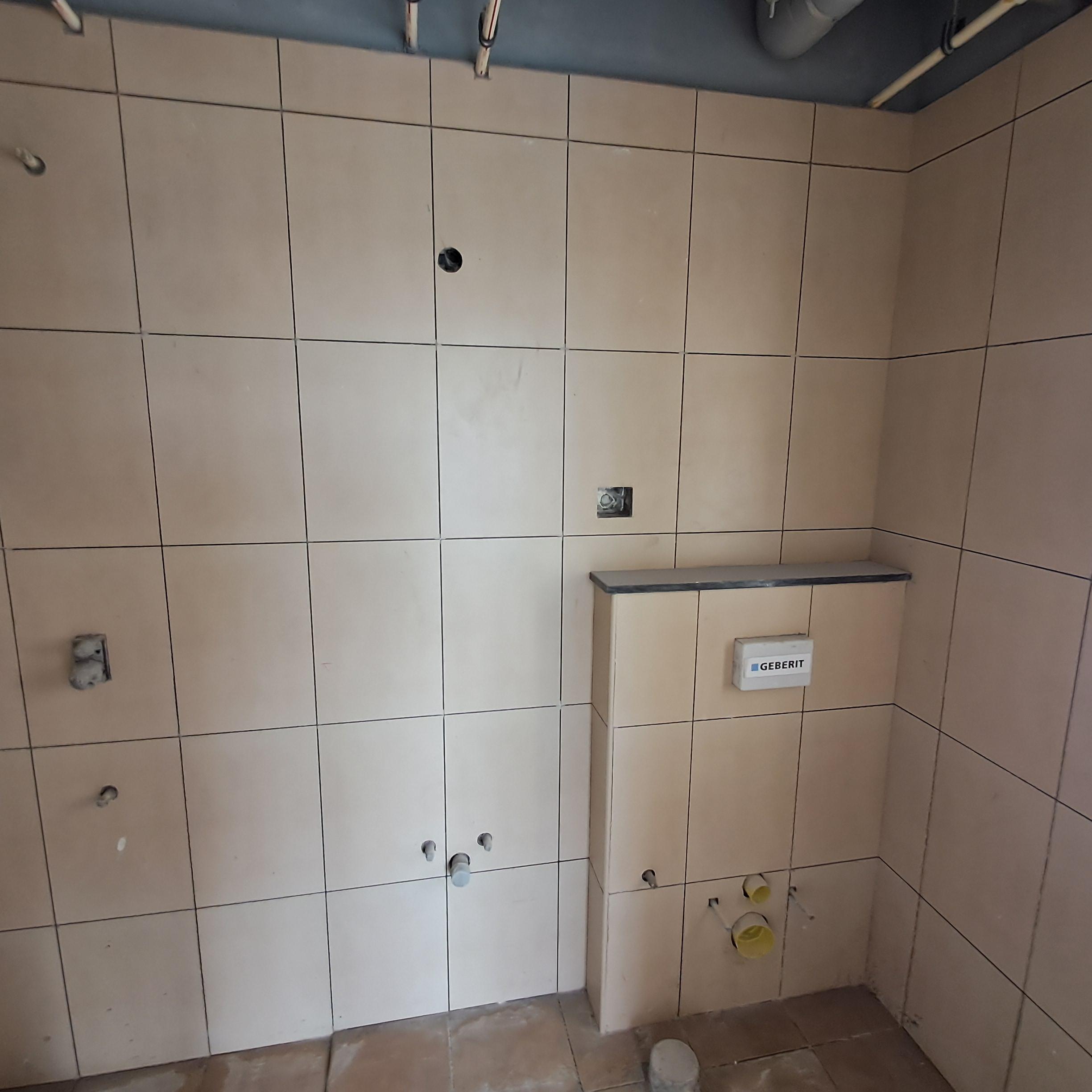

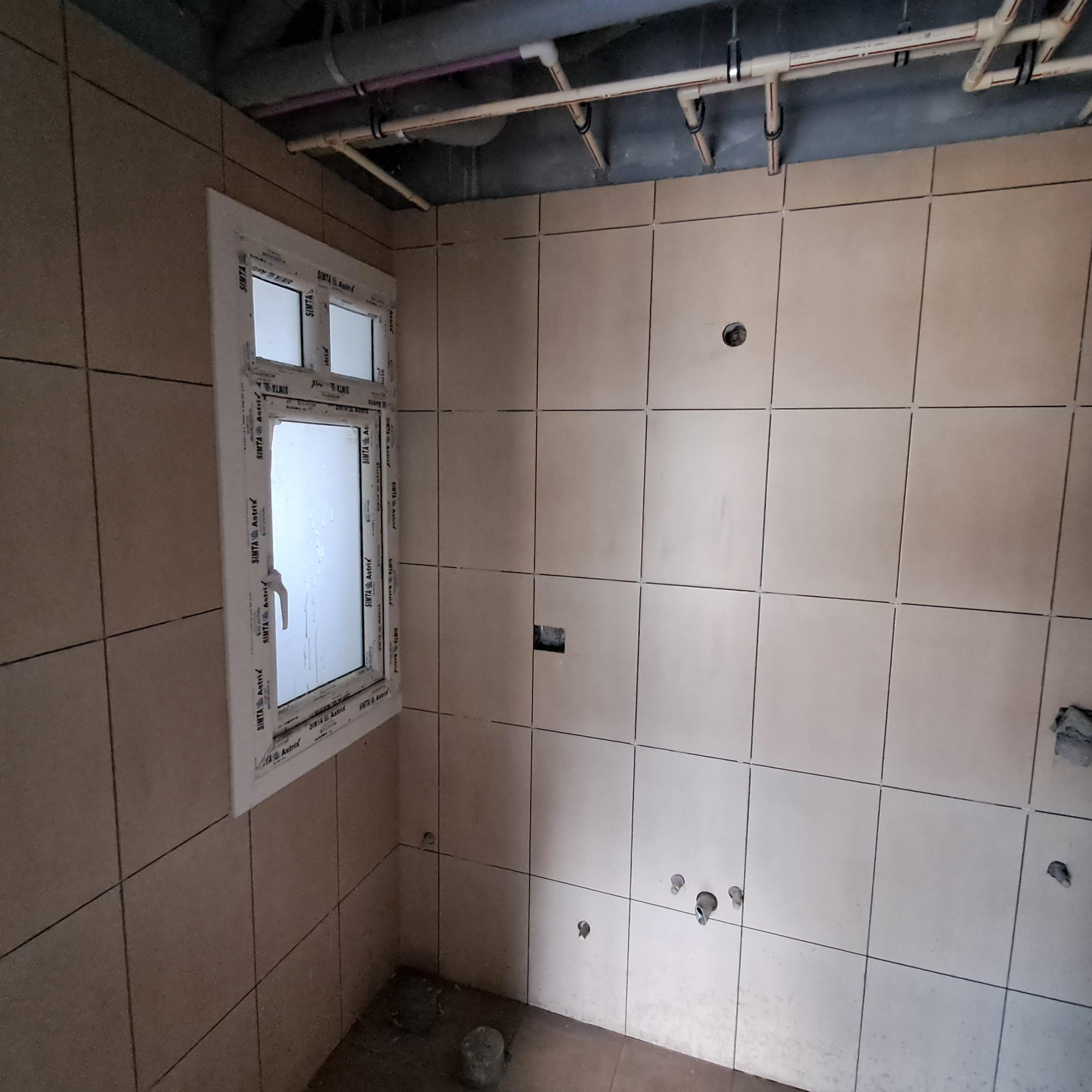

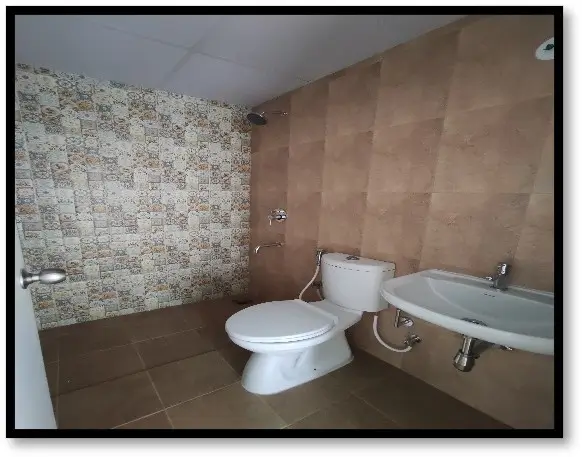

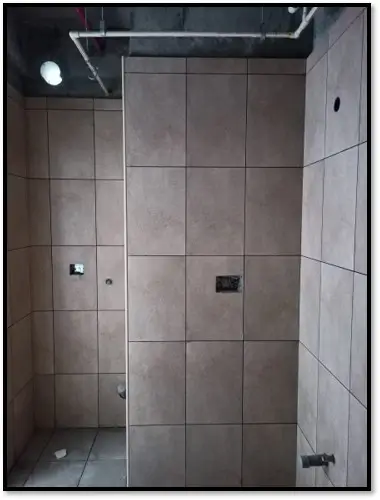

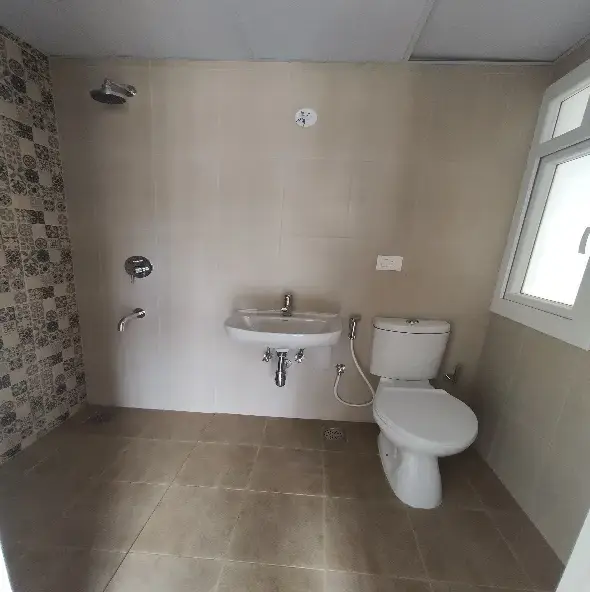

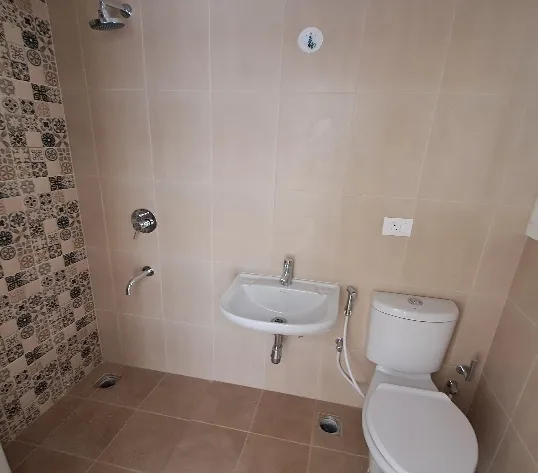

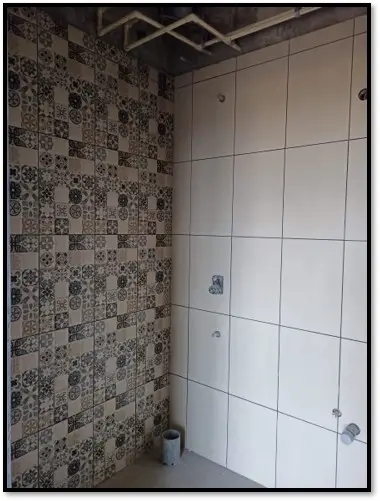

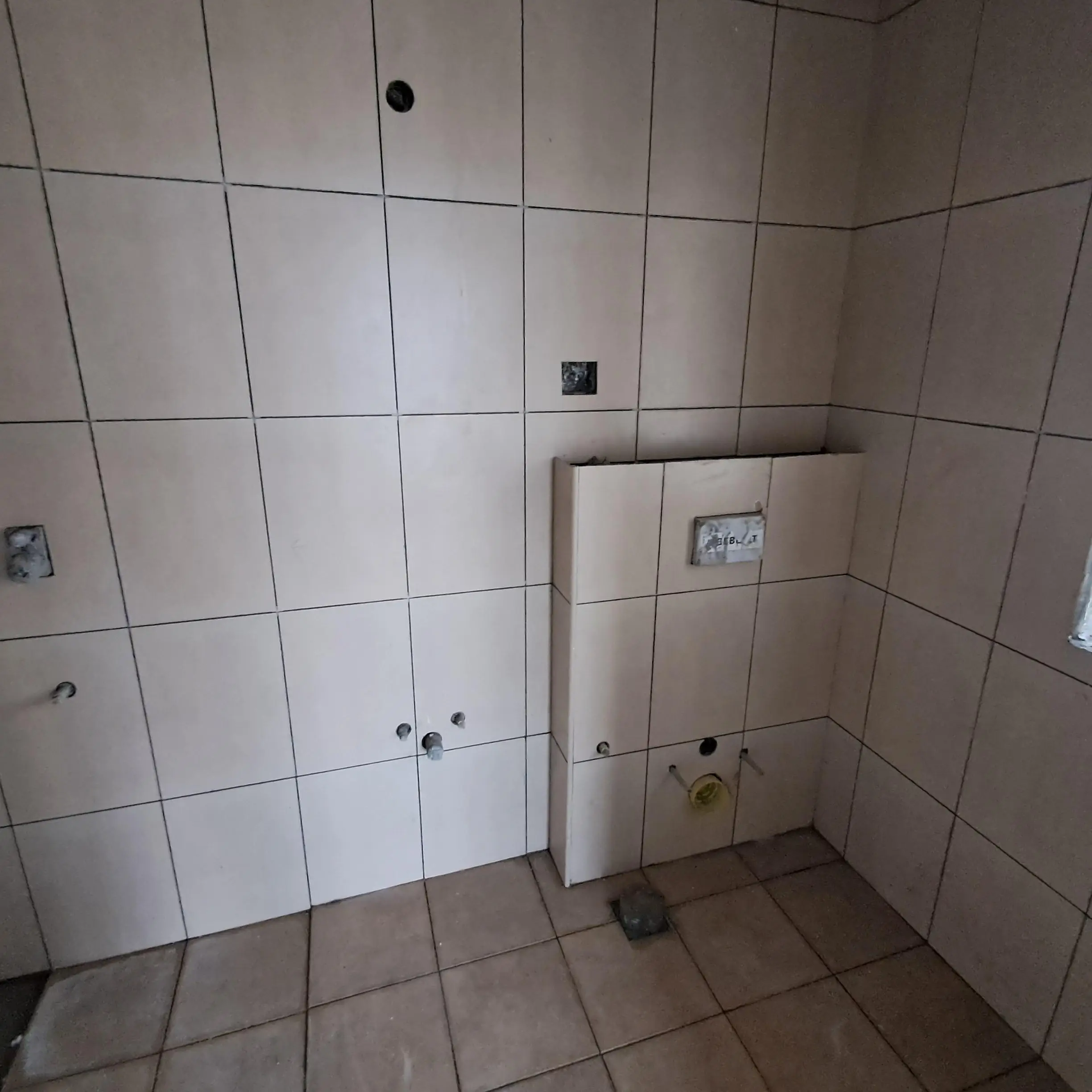

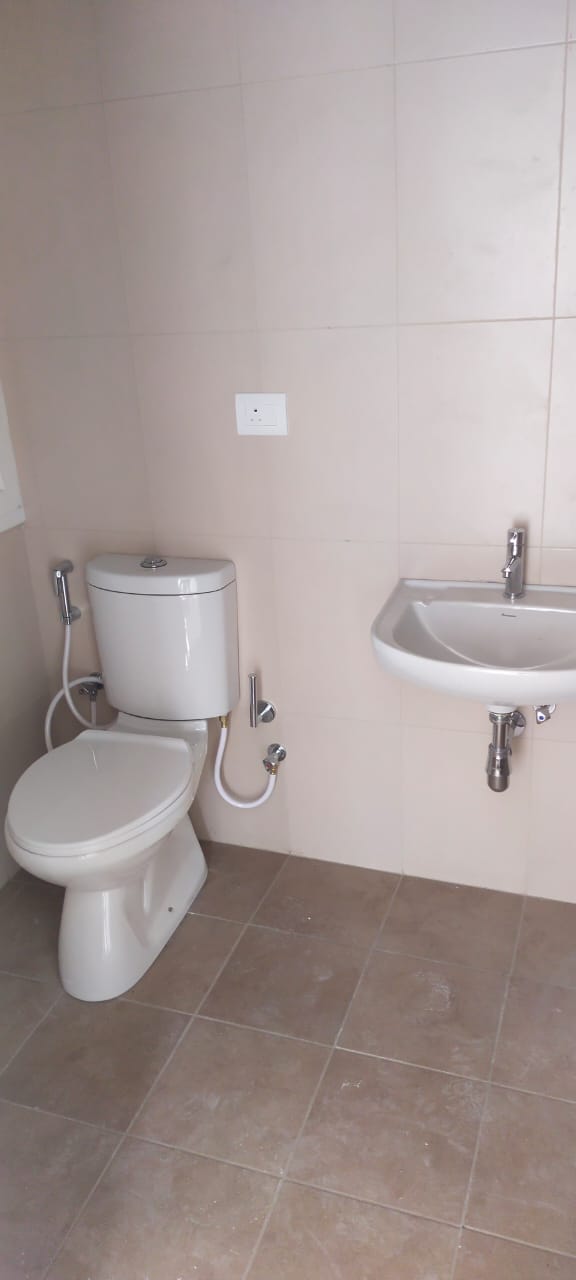

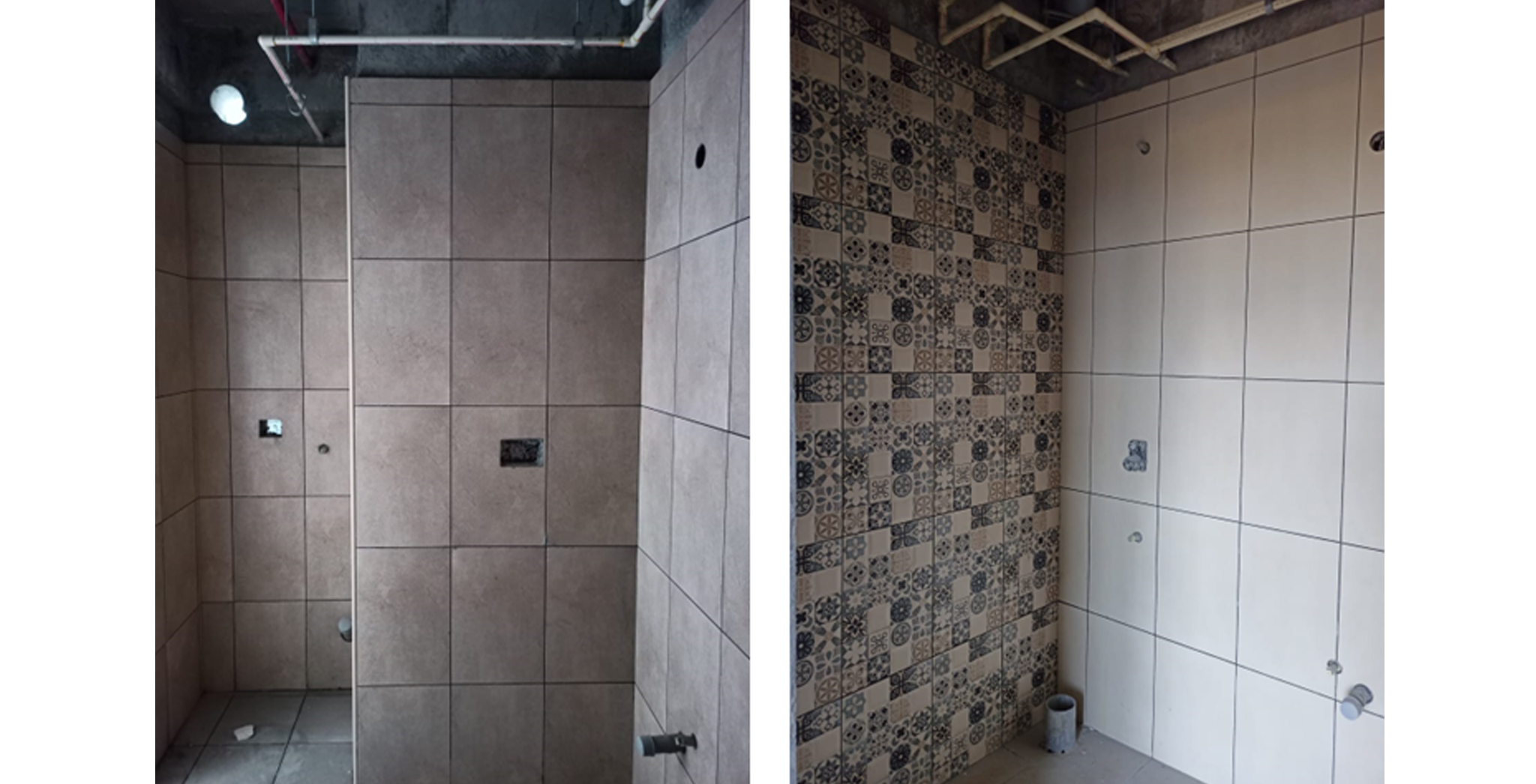

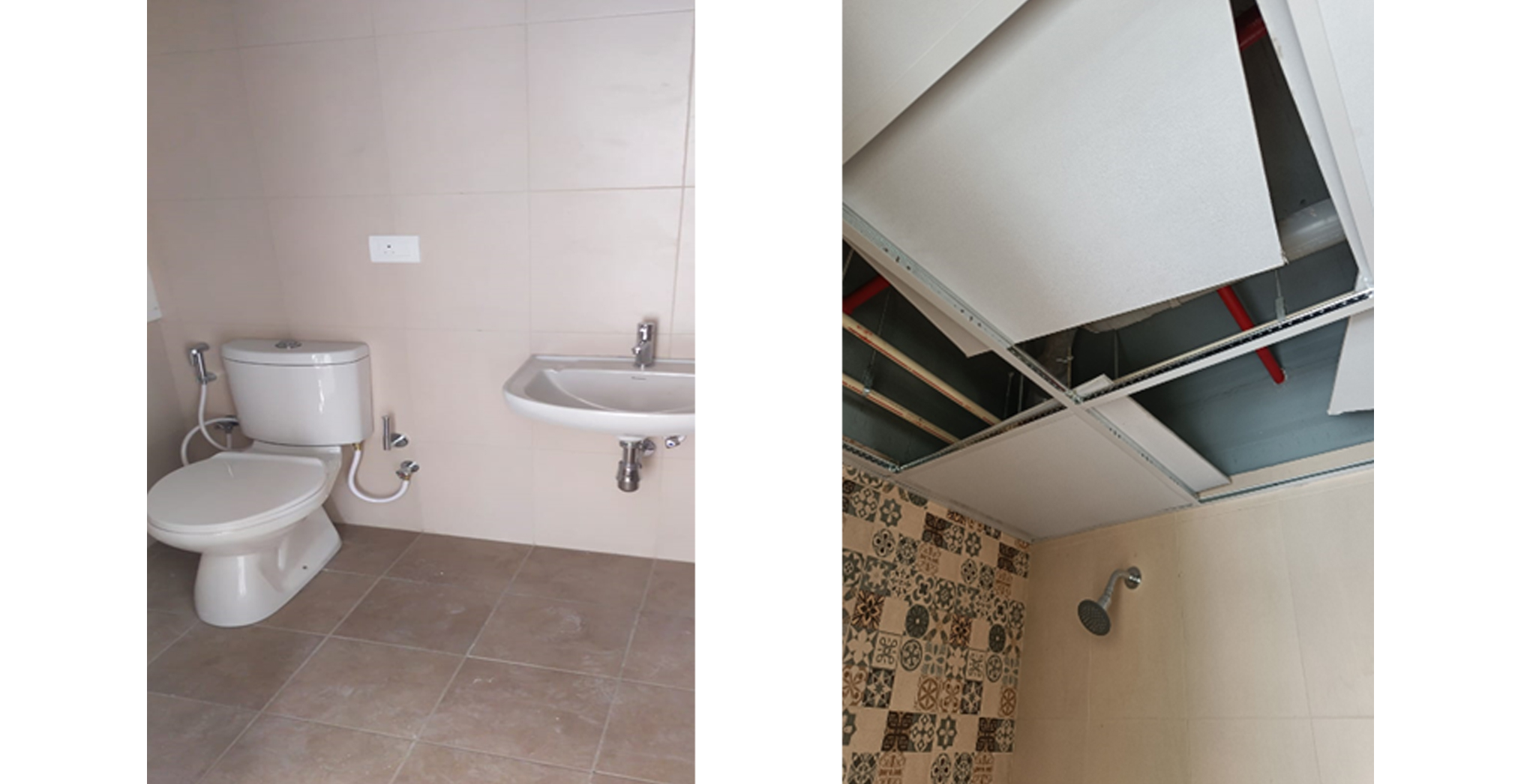

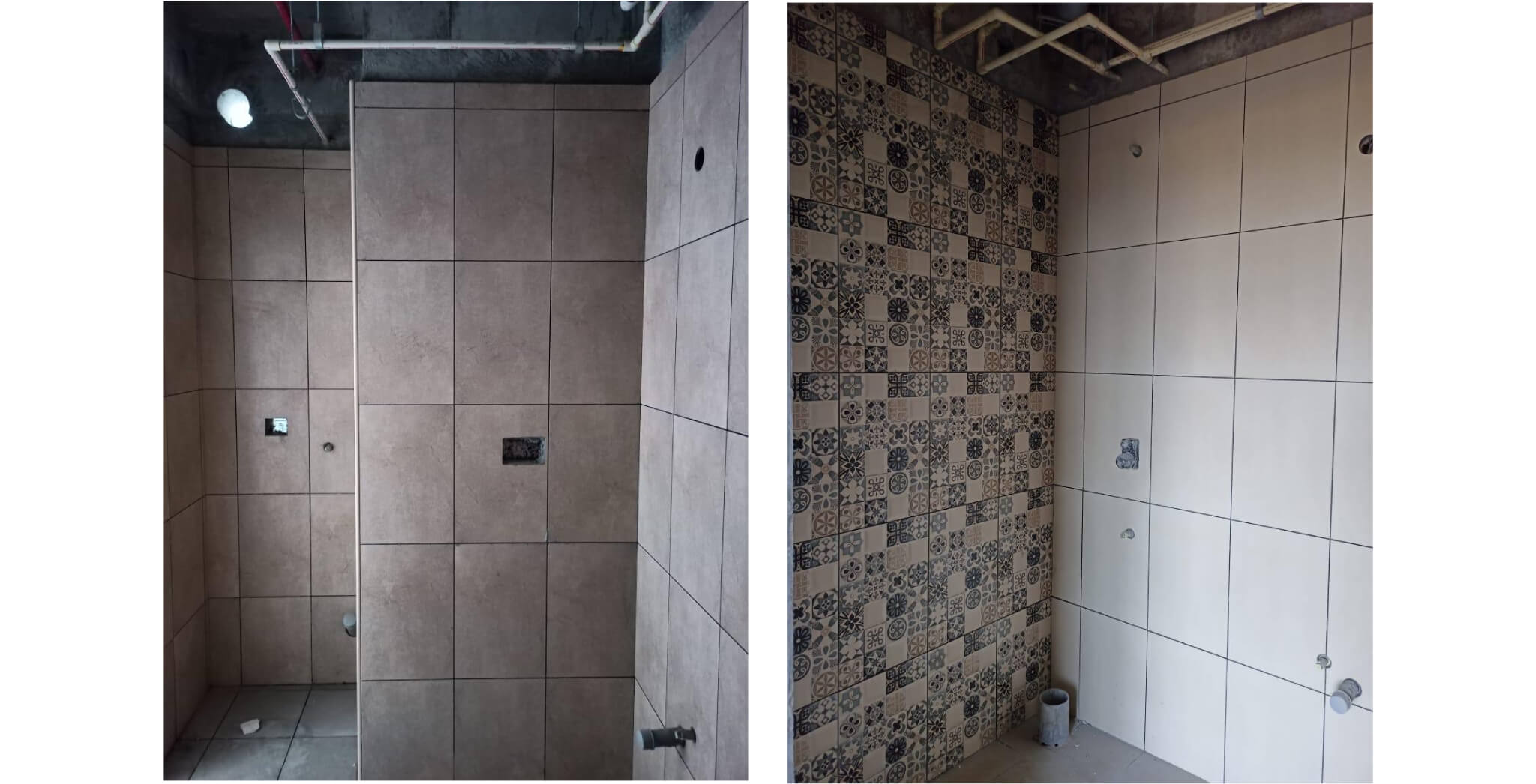

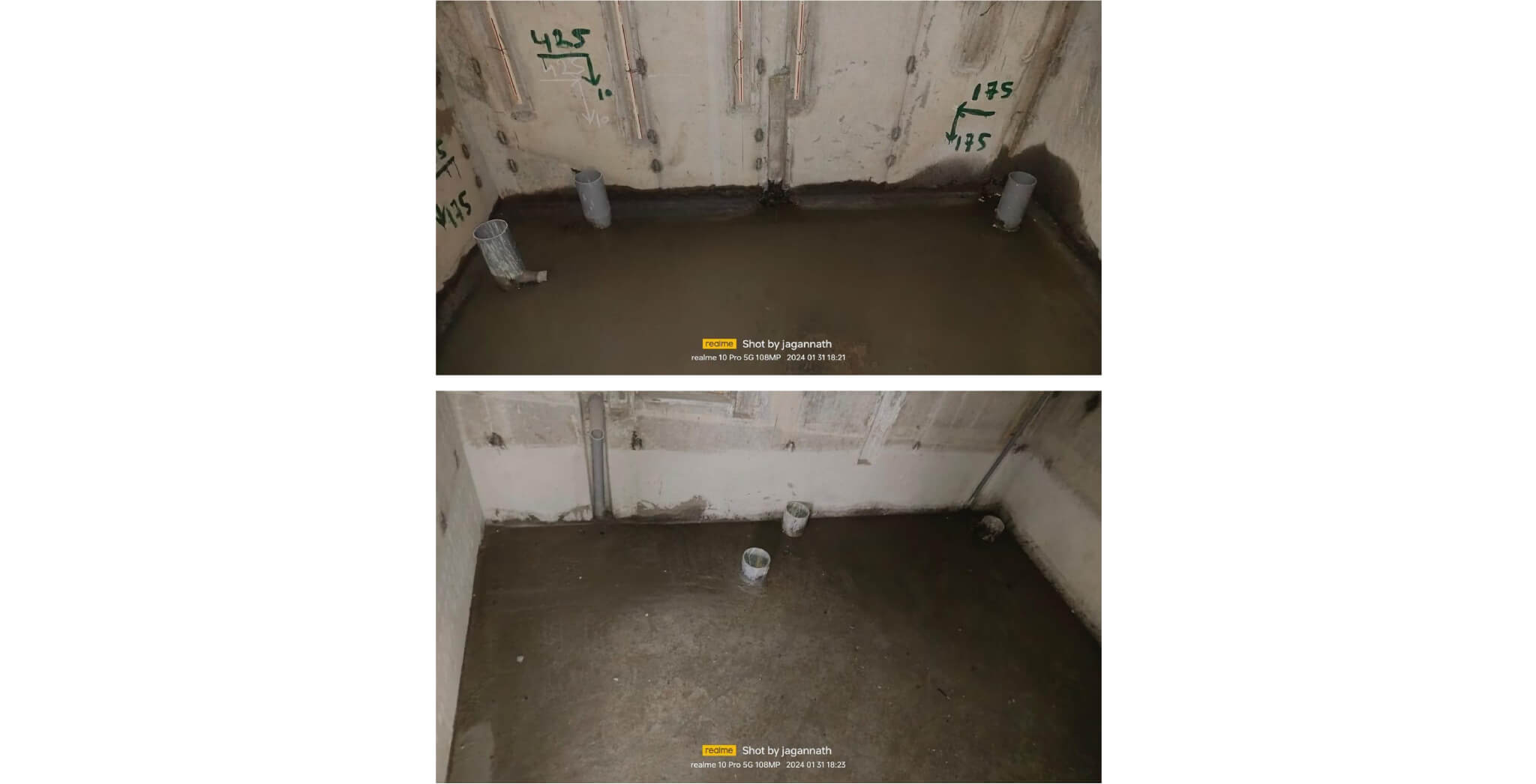

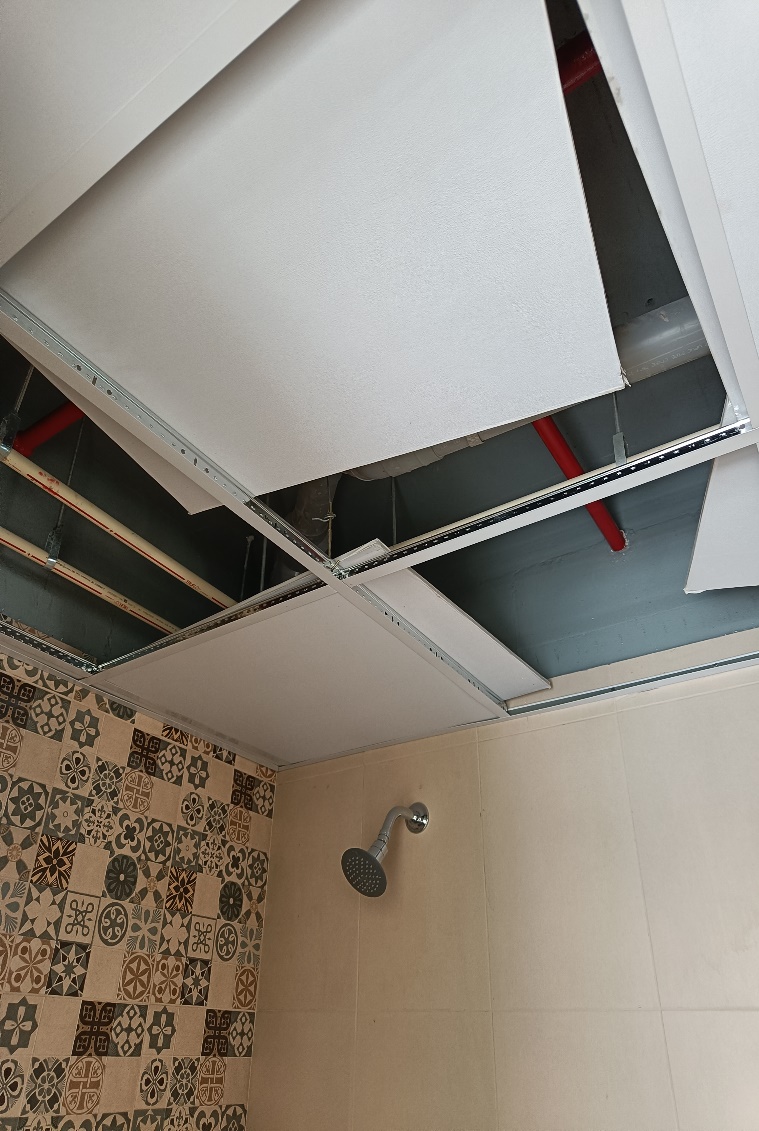

Toilet dado – work in progress. Plumbing works completed - Jun 2025

Toilet dado – work in progress. Plumbing works completed - Jun 2025

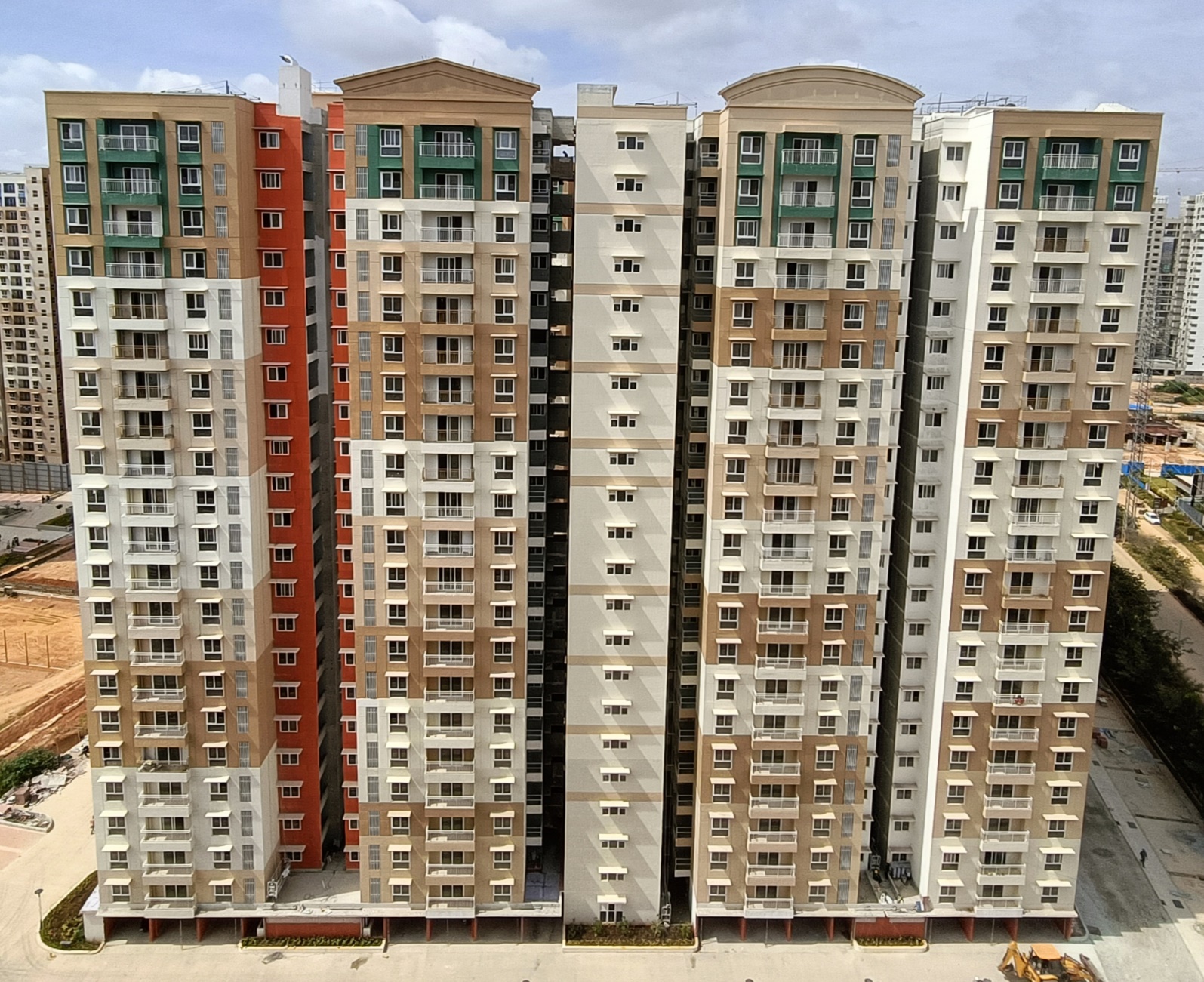

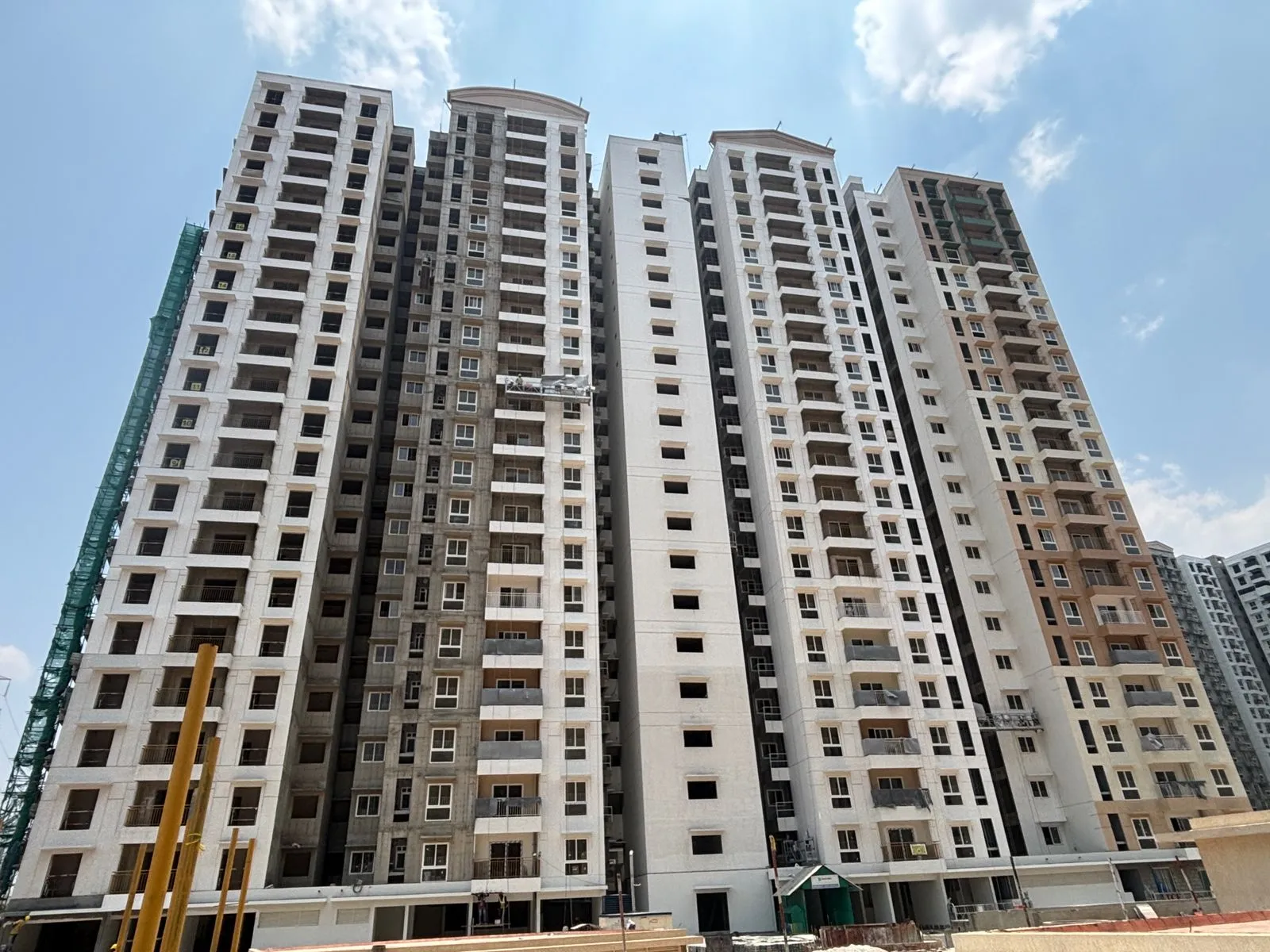

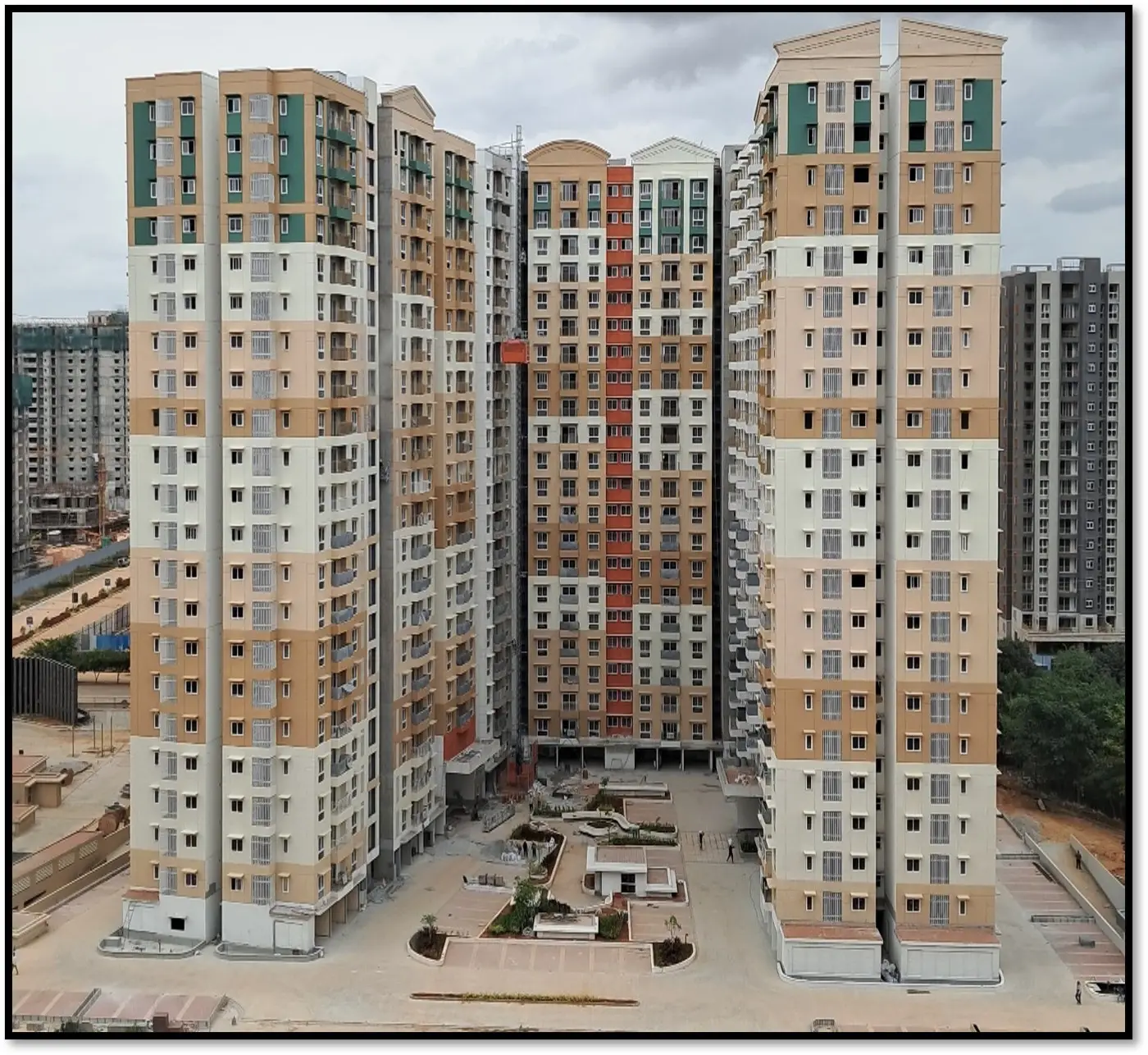

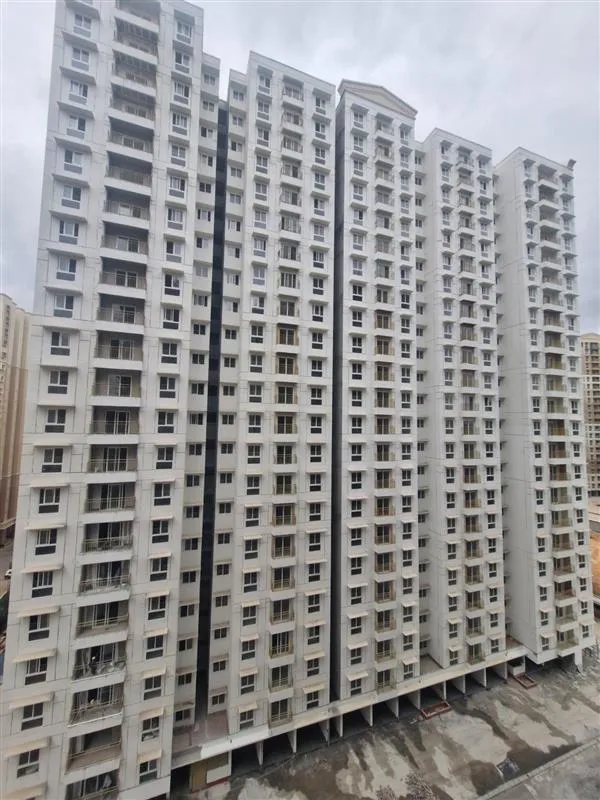

External painting work in progress - Jun 2025

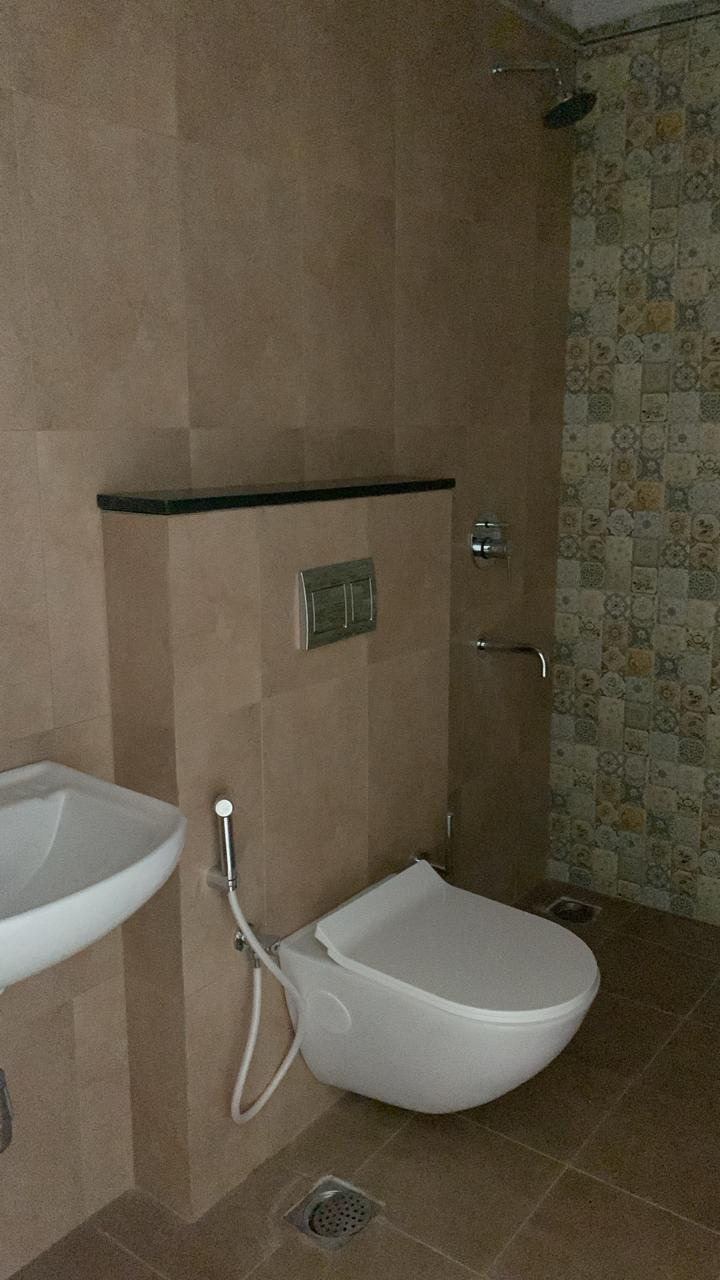

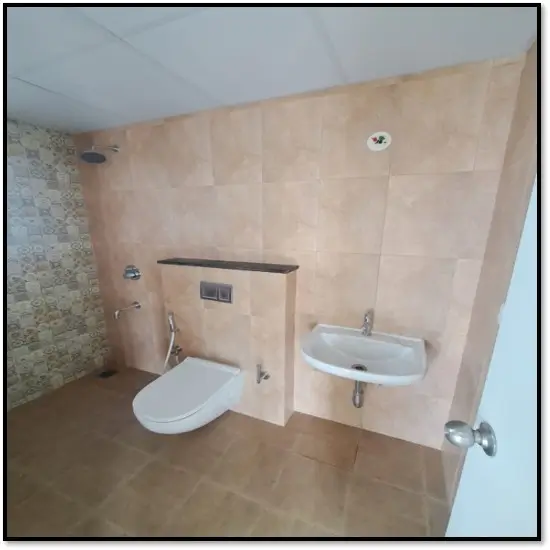

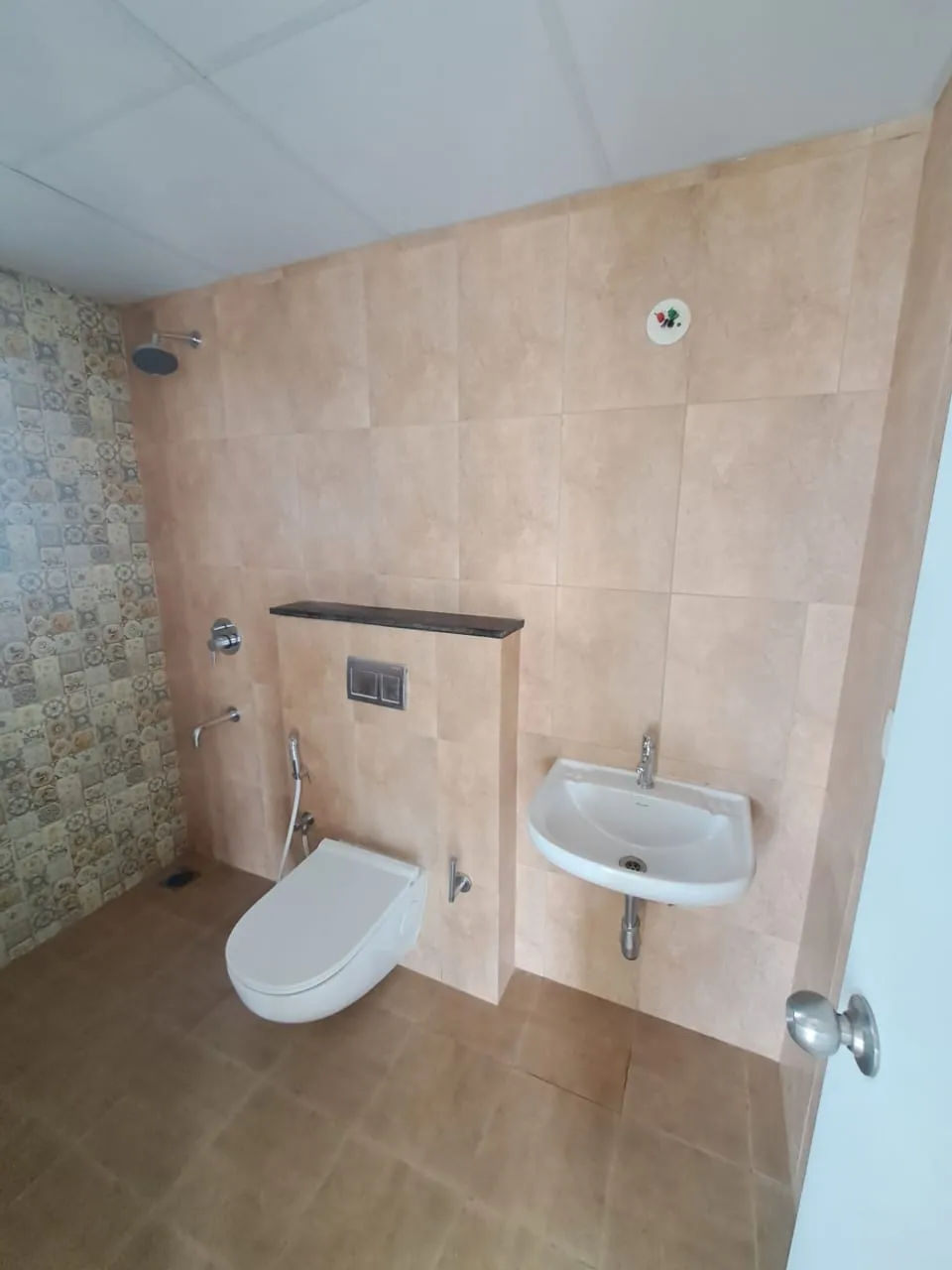

Sanitary fixtures –work in progress - Jun 2025

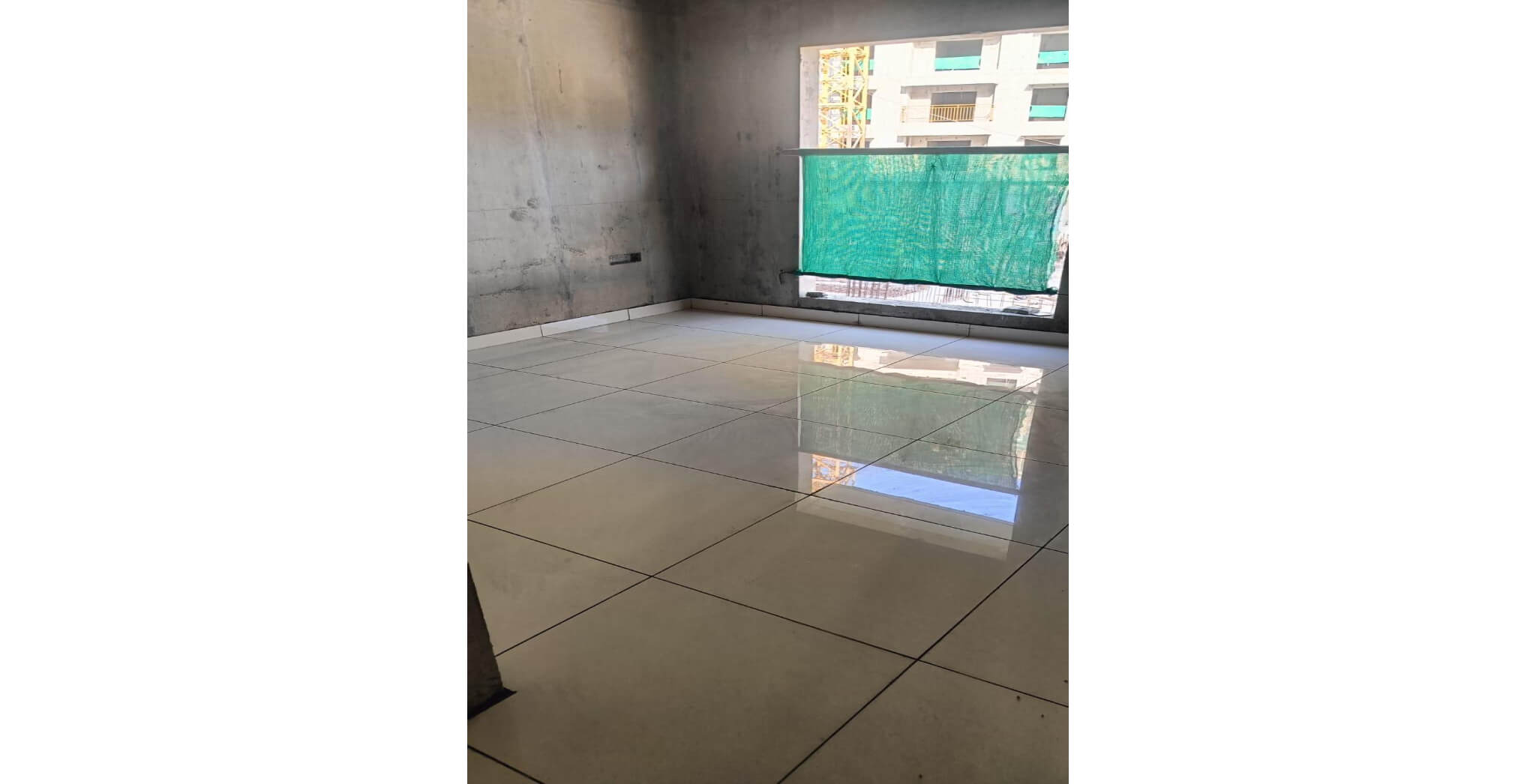

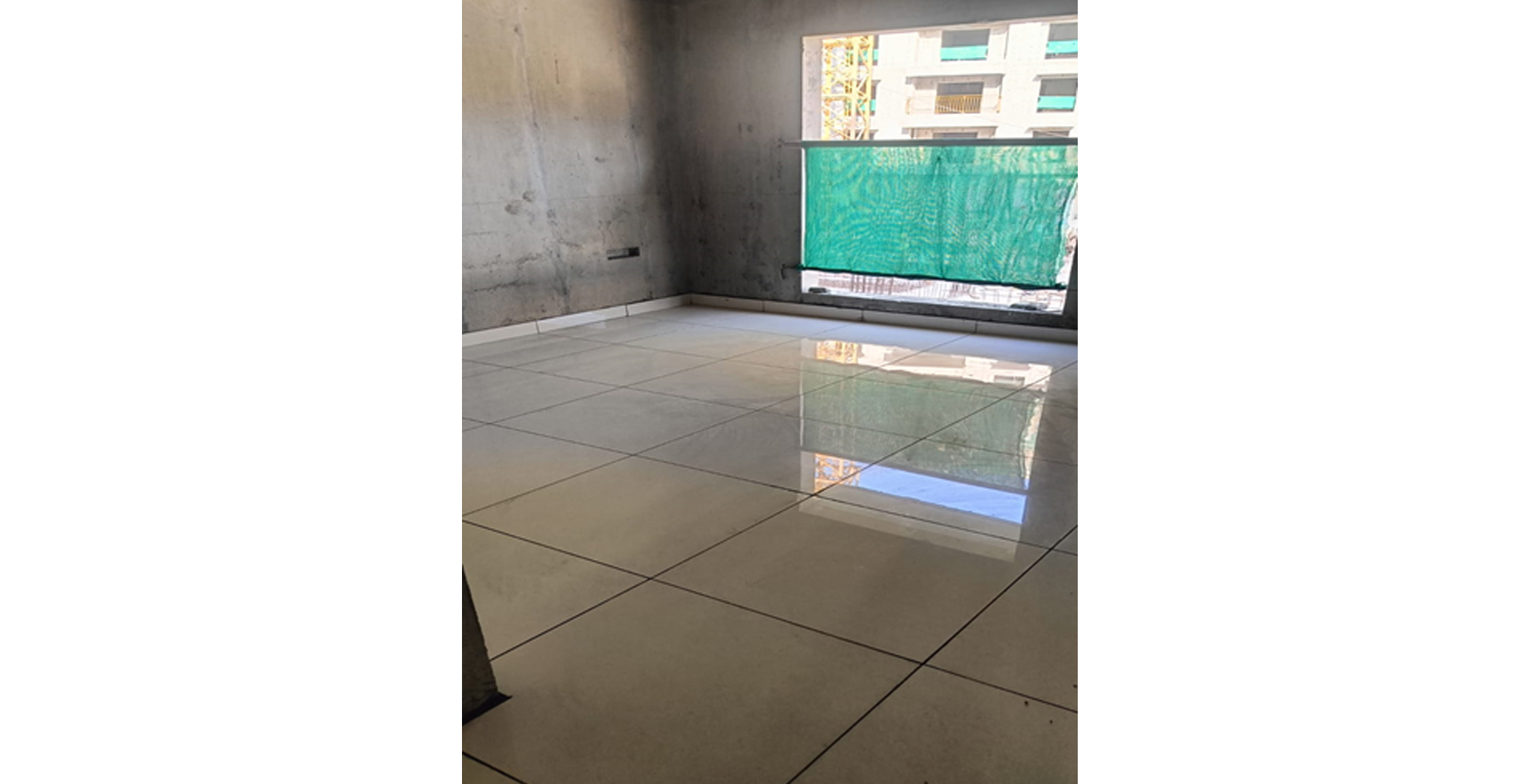

Flooring – work in progress - Jun 2025

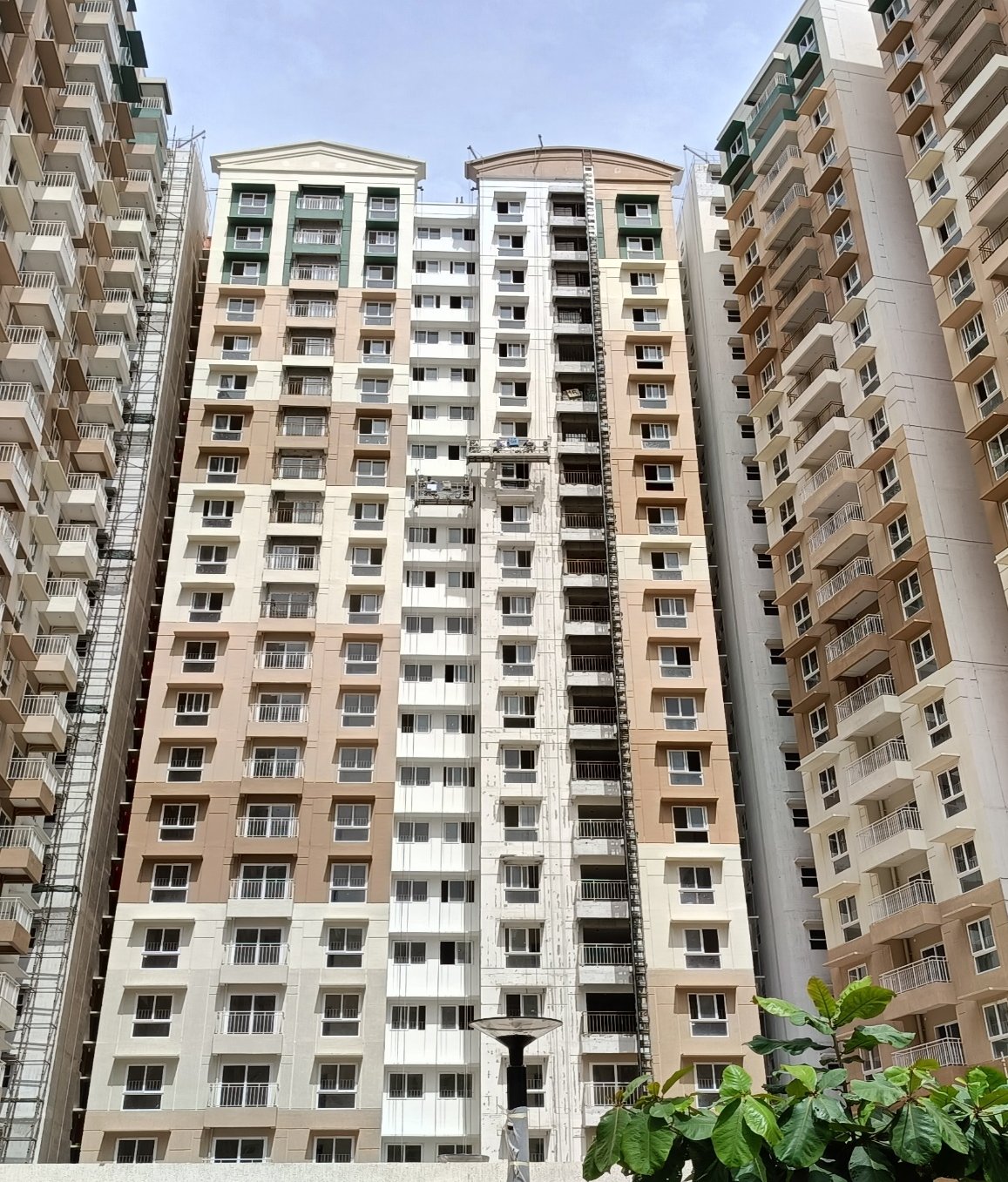

Wing B: Above Terrace level painting work in progress - Jun 2025

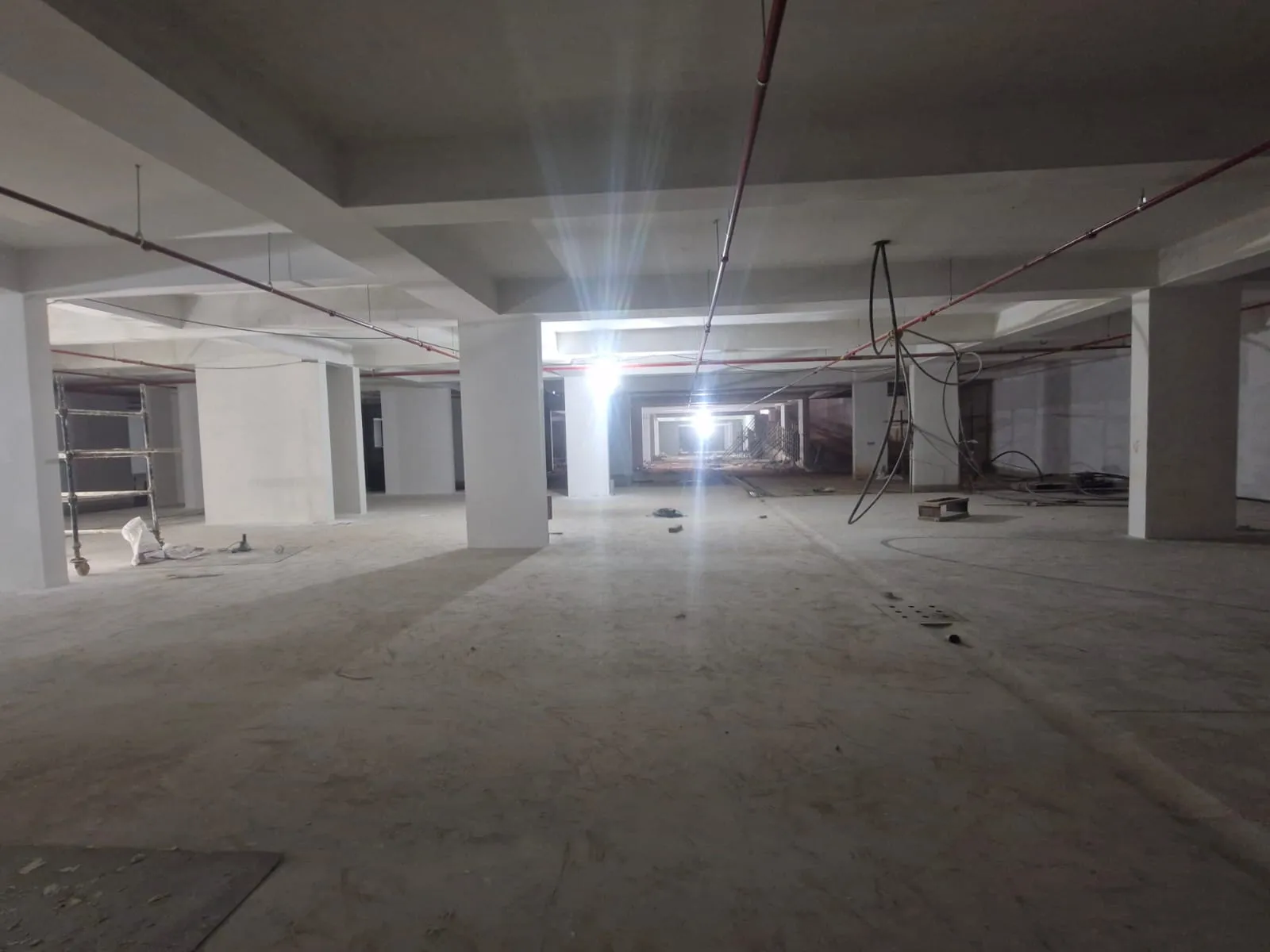

Basement work in progress - Jun 2025

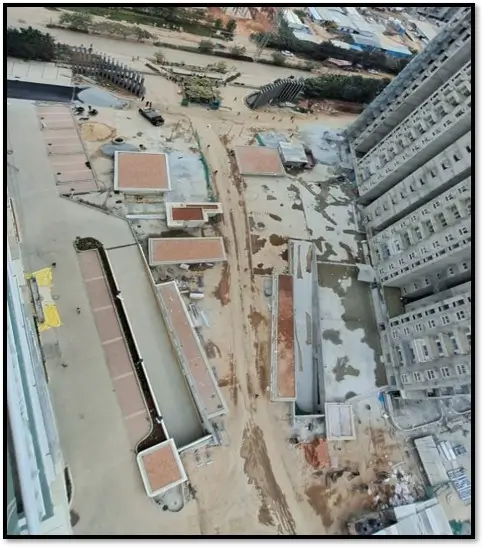

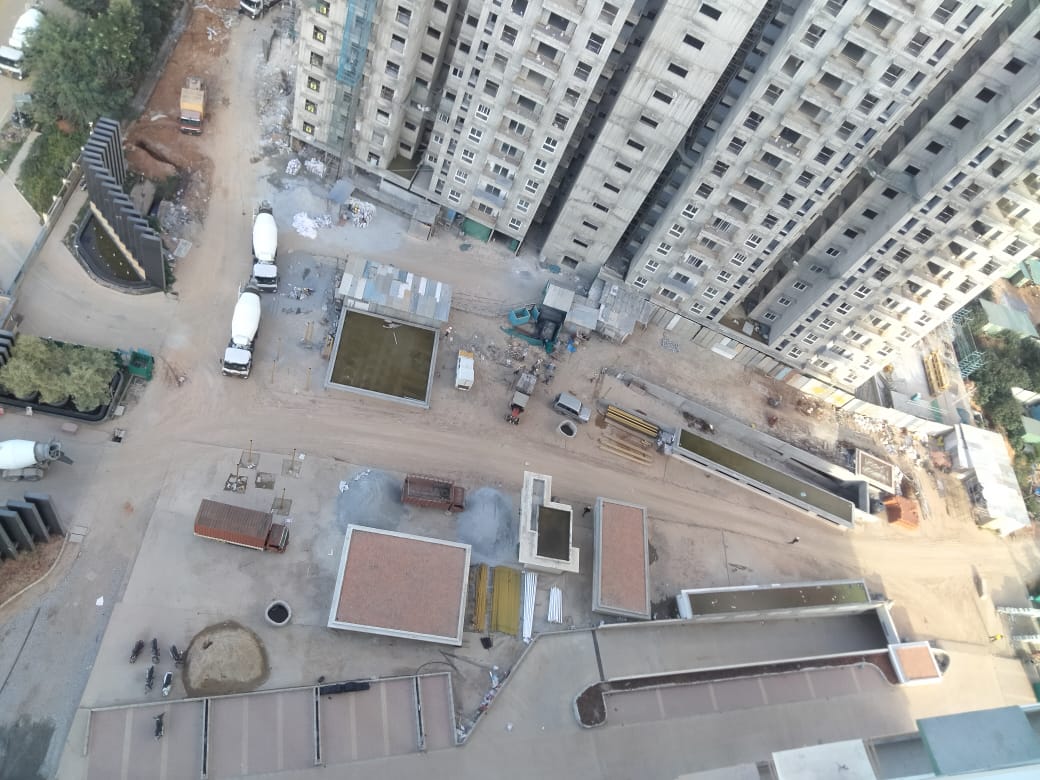

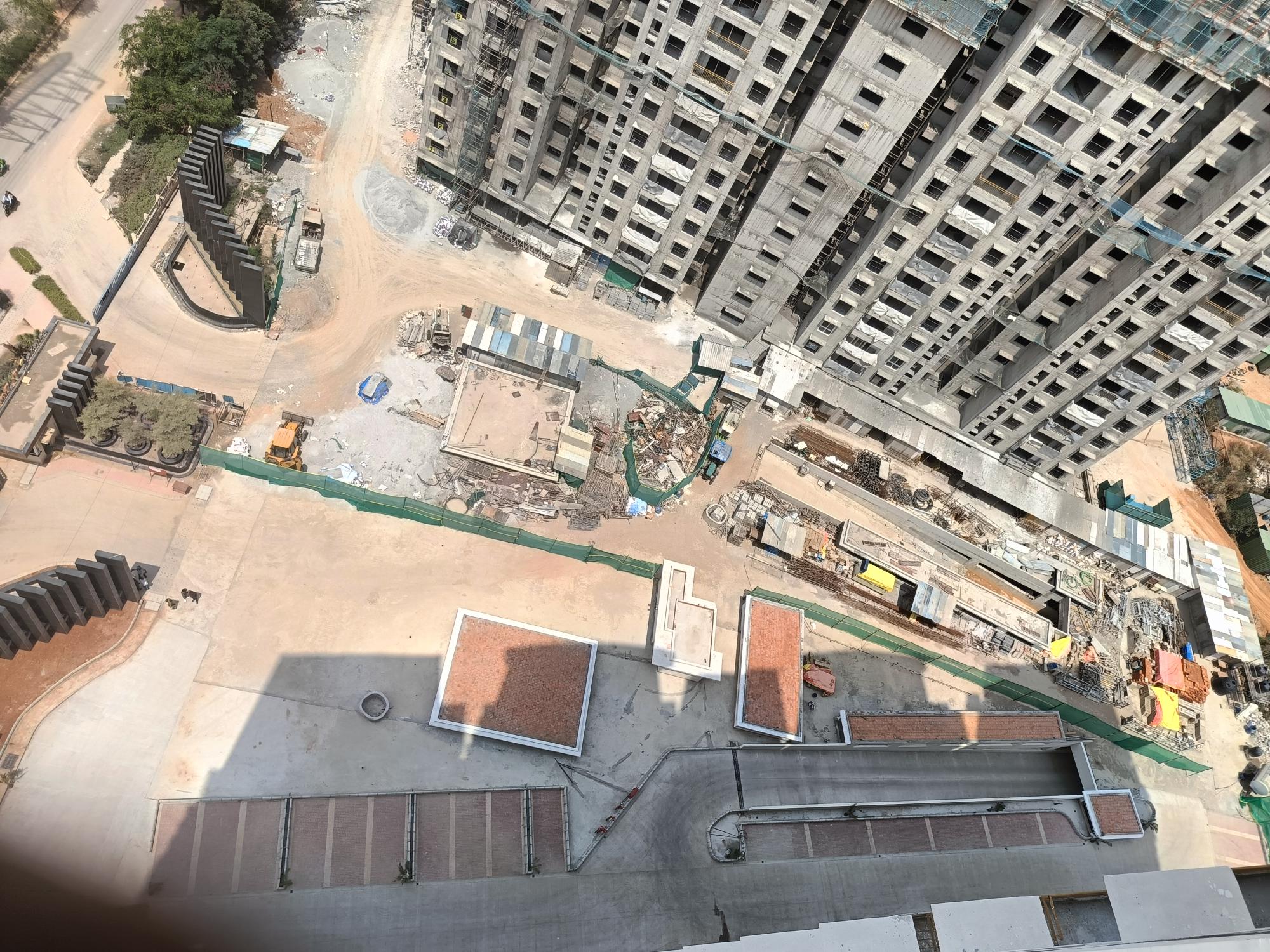

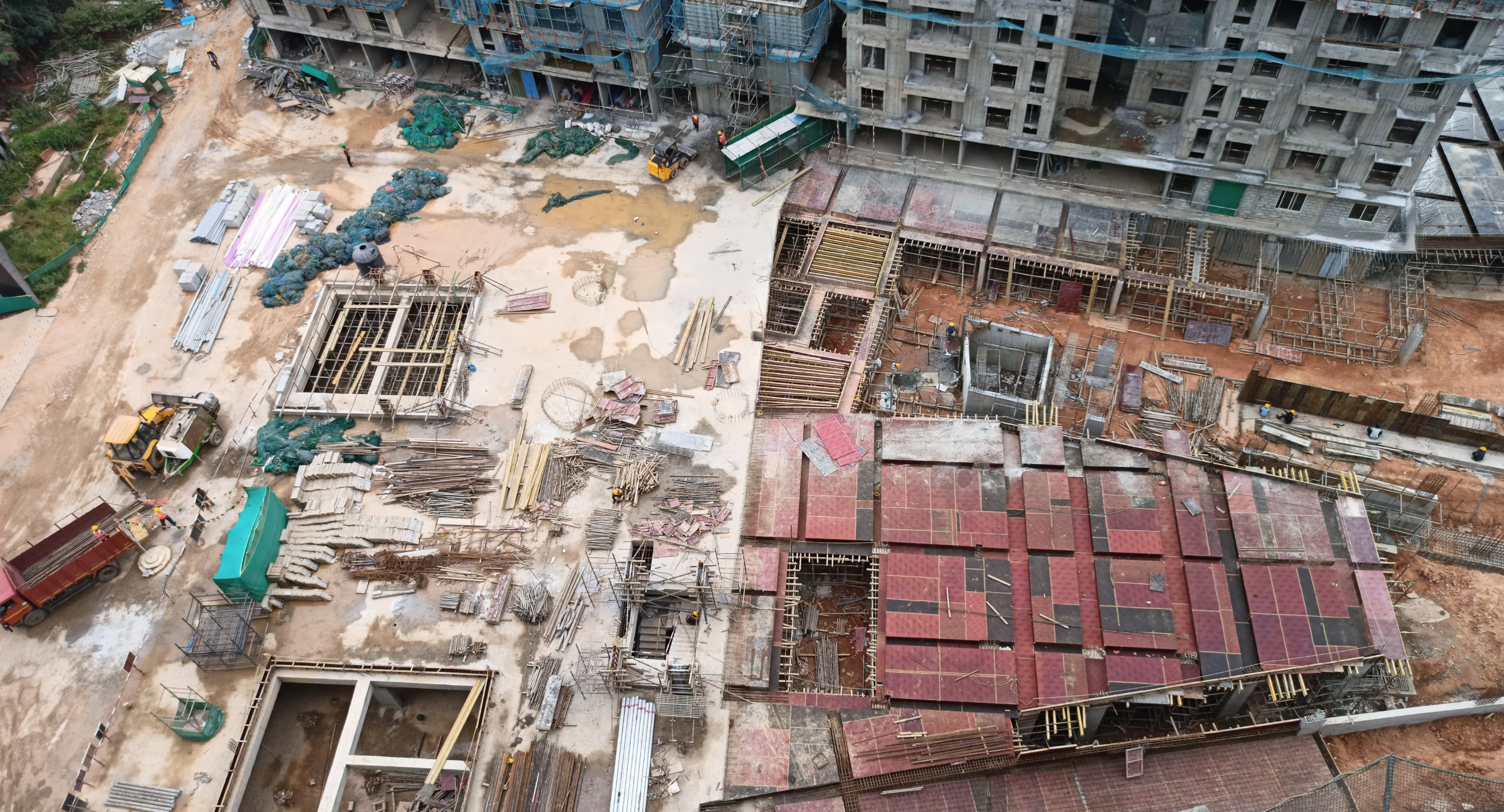

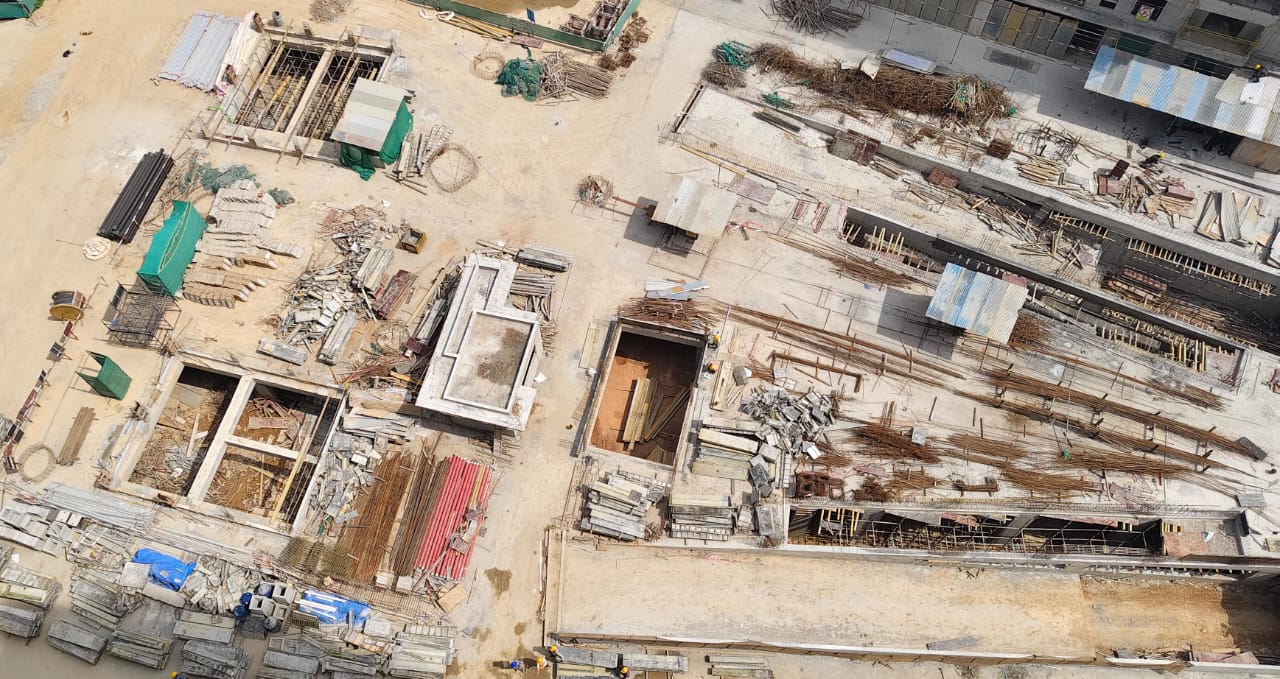

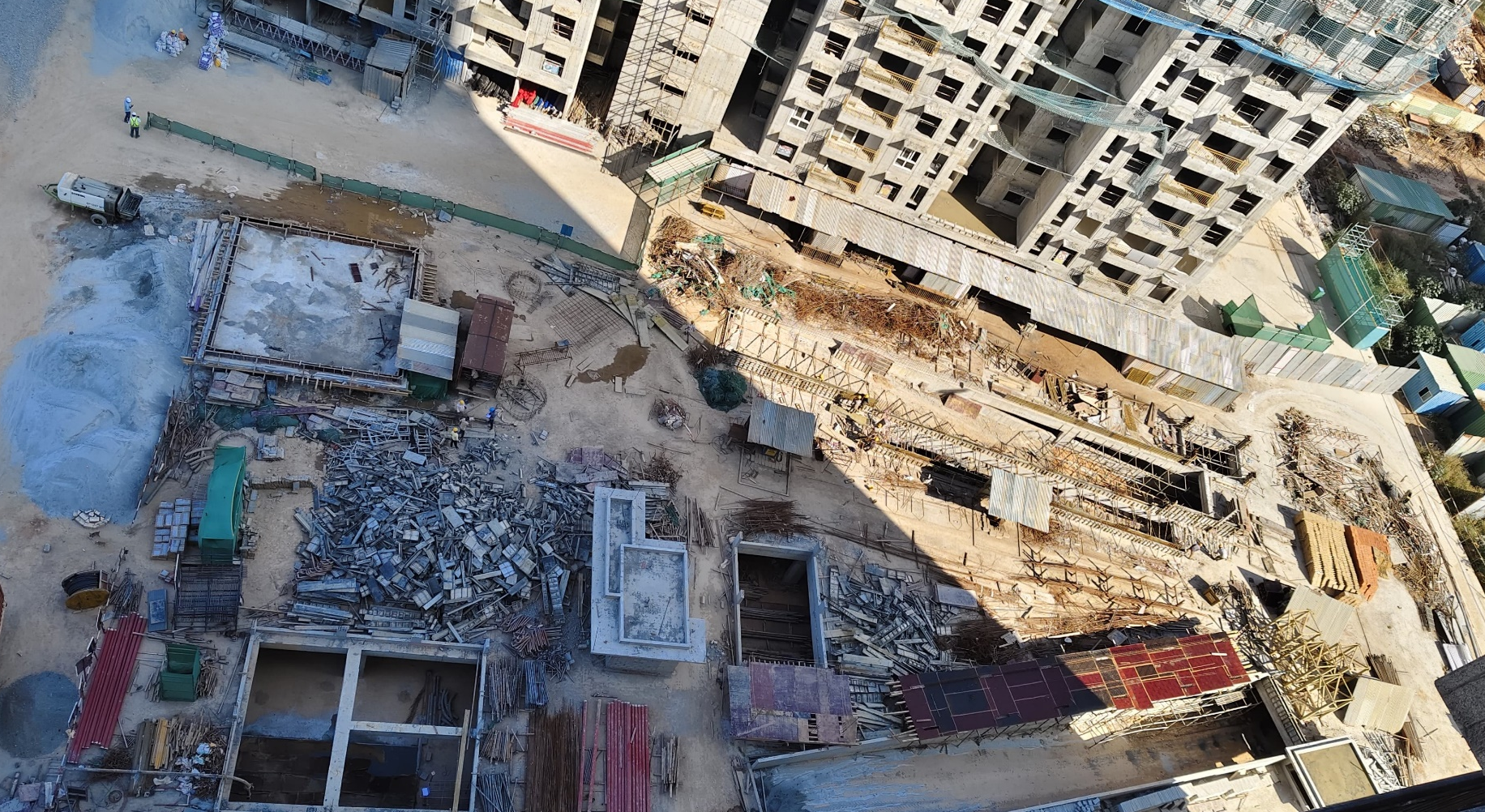

Between L and A tower podium finishing work in progress - Jun 2025

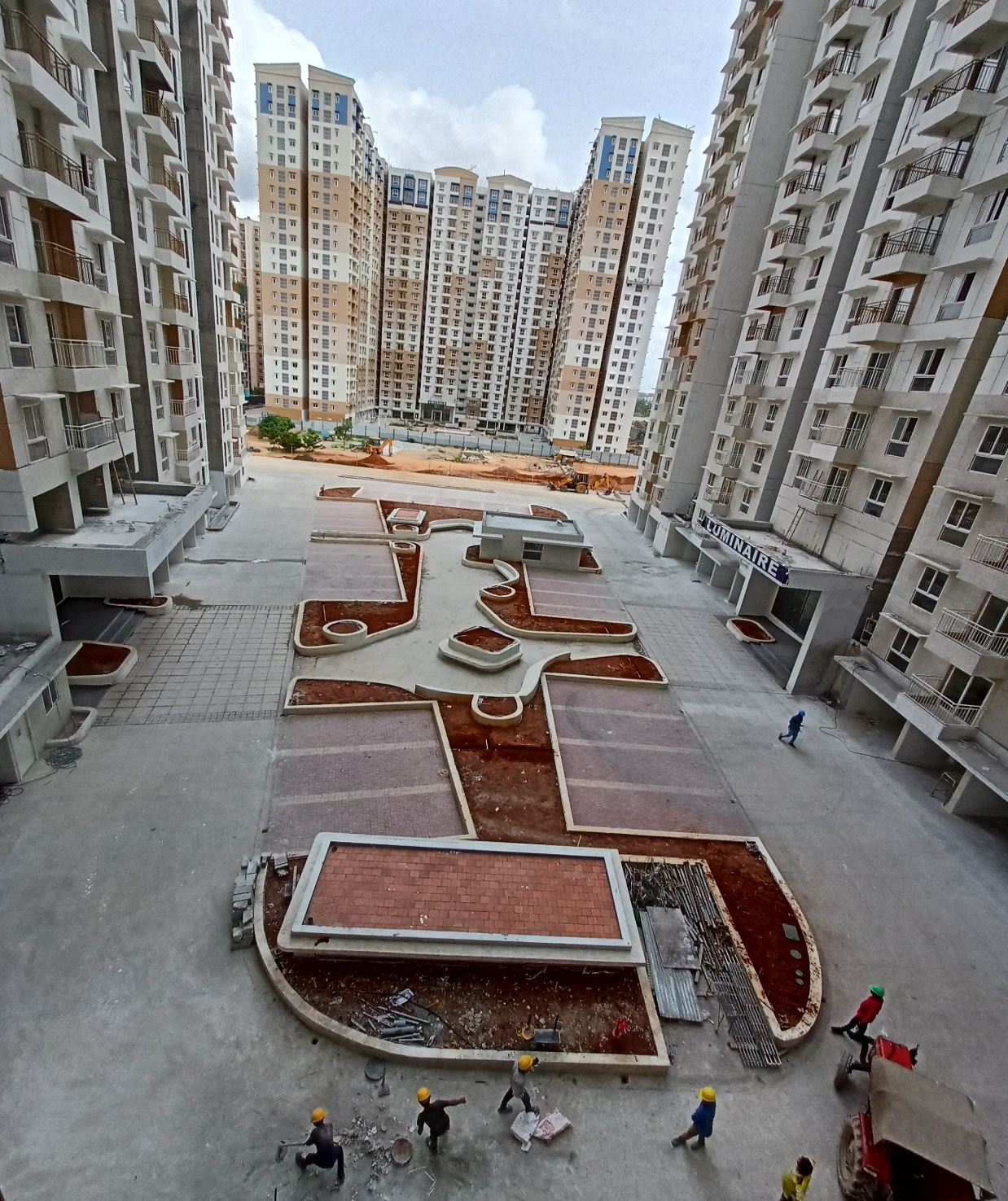

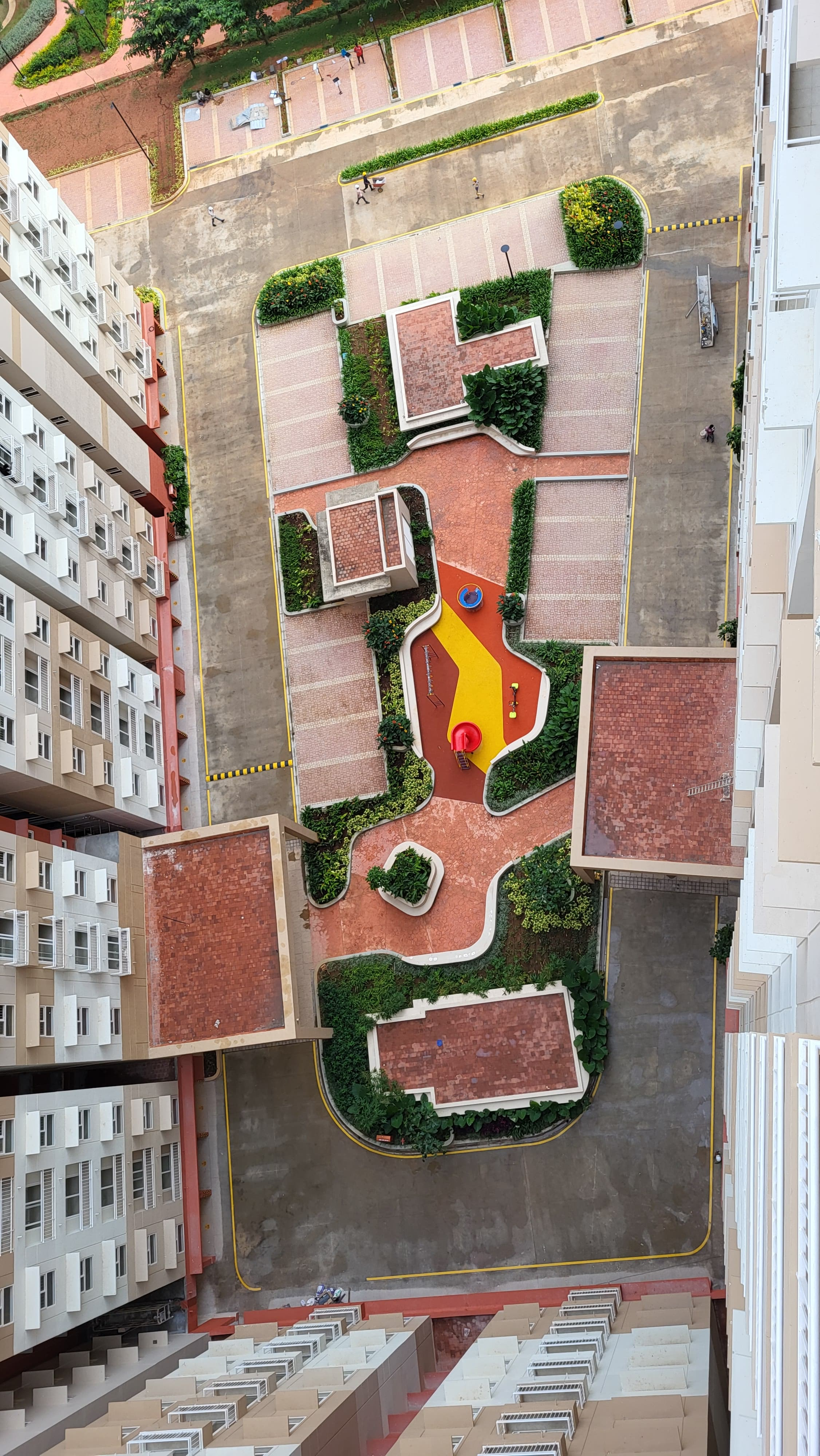

Central podium Landscape work in progress - Jun 2025

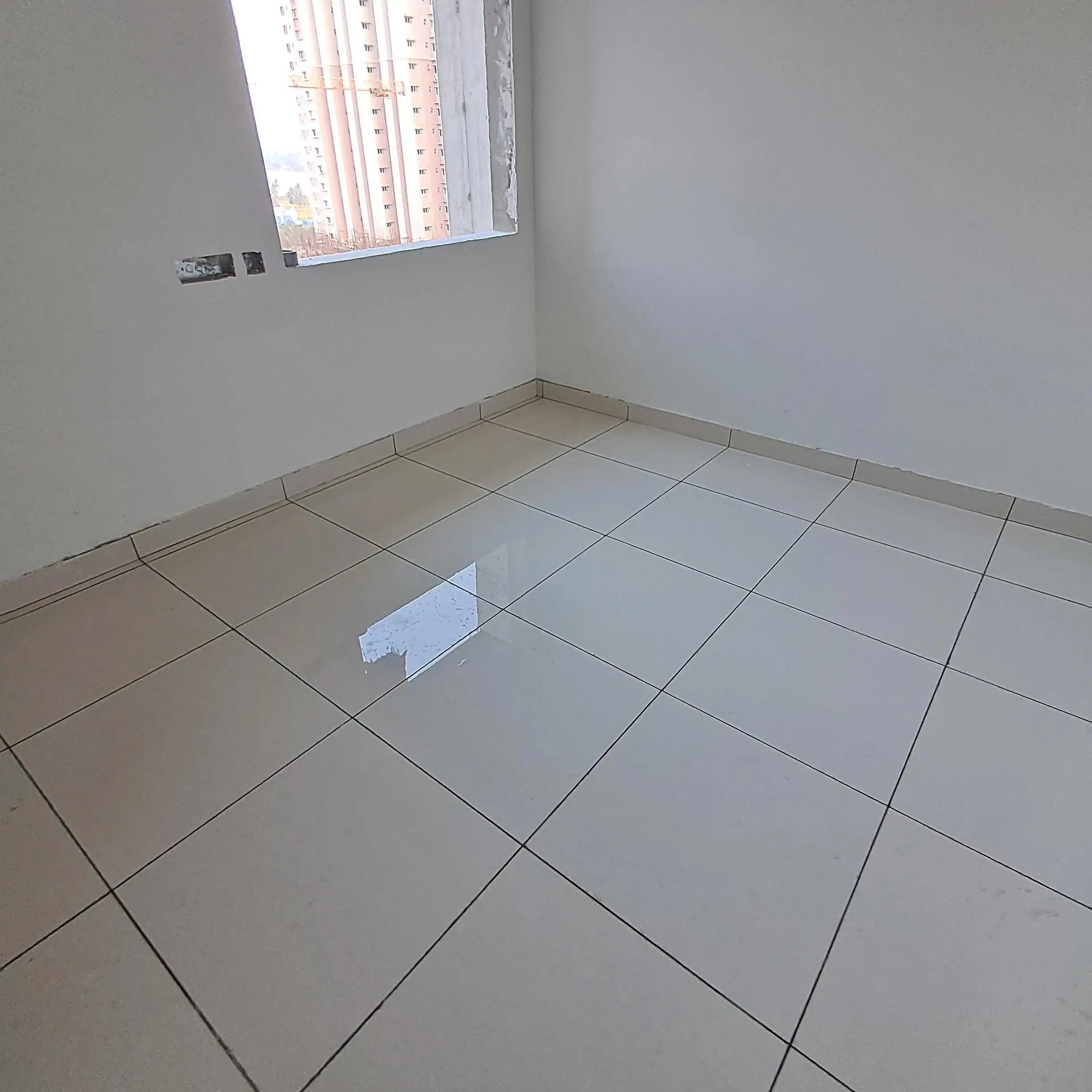

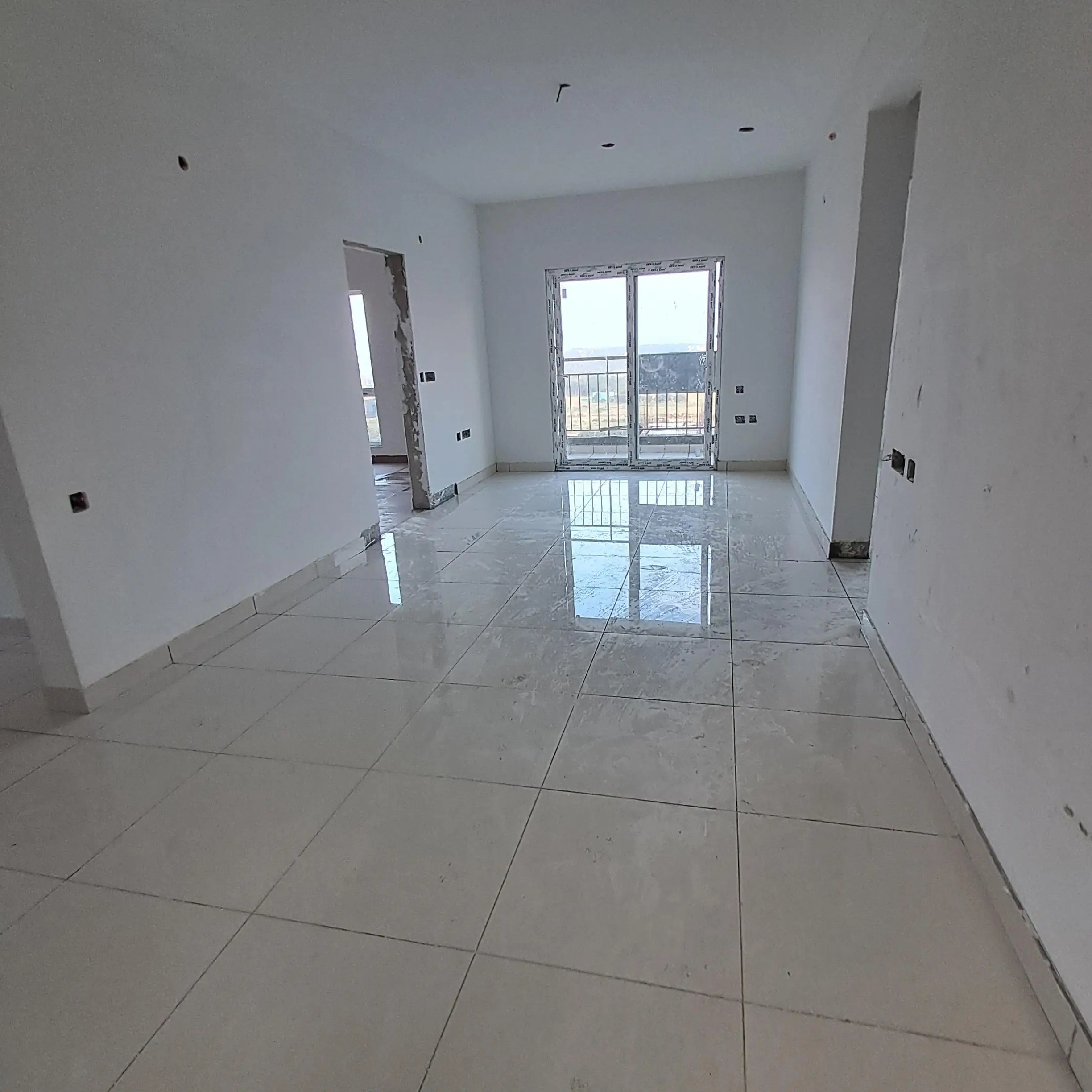

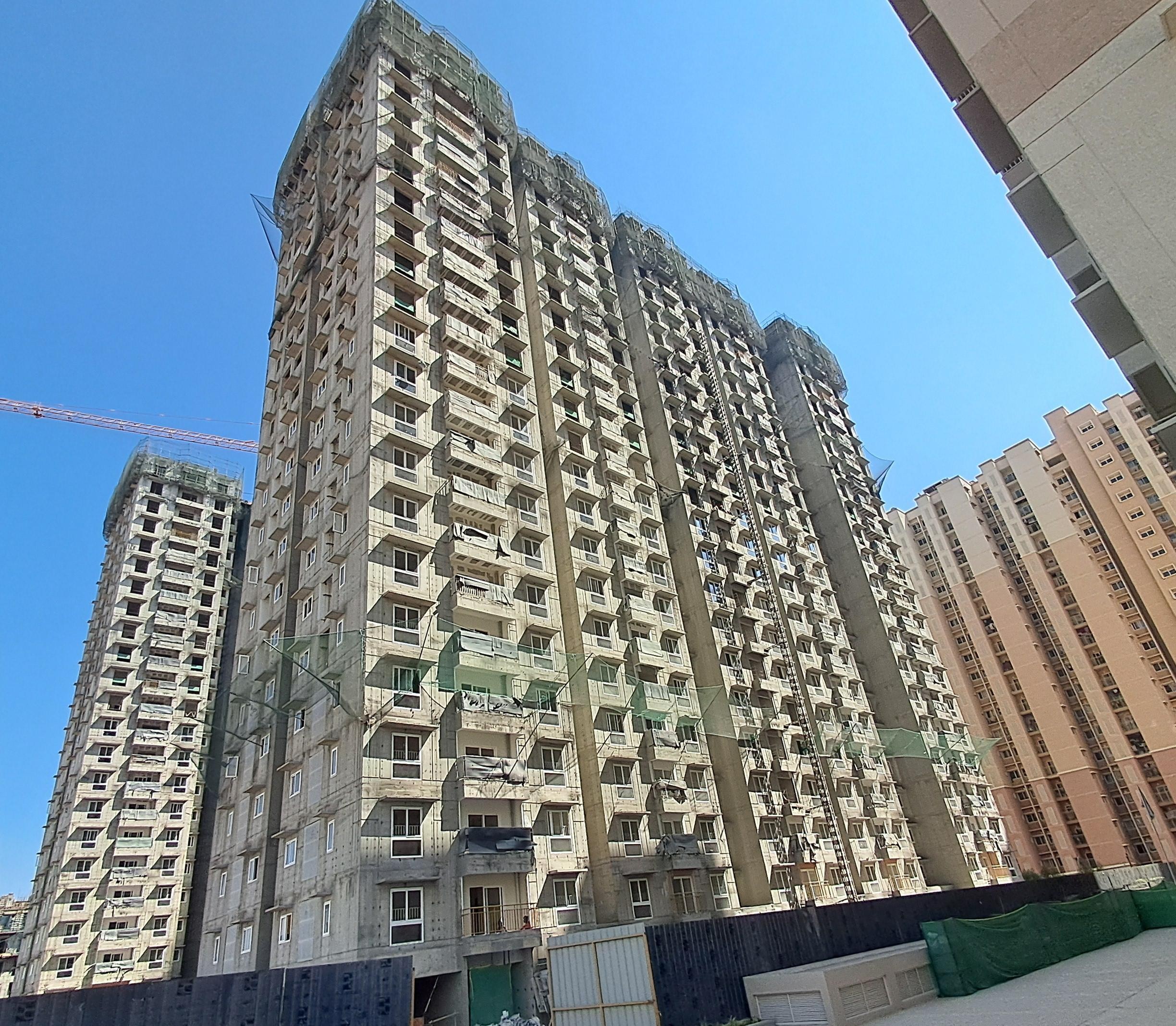

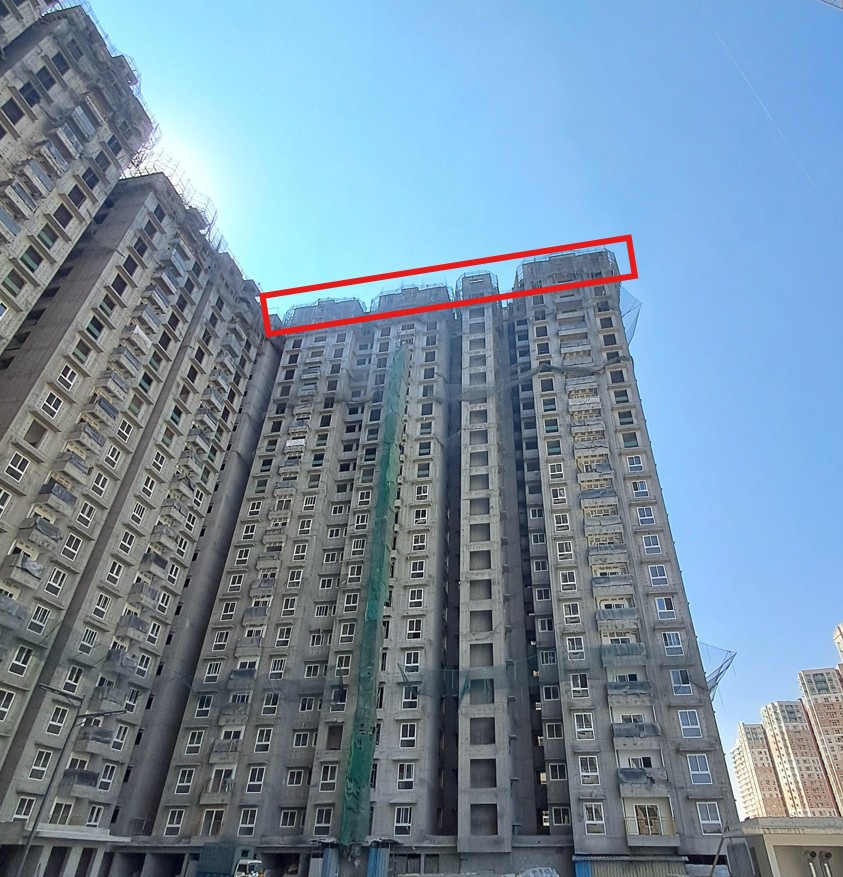

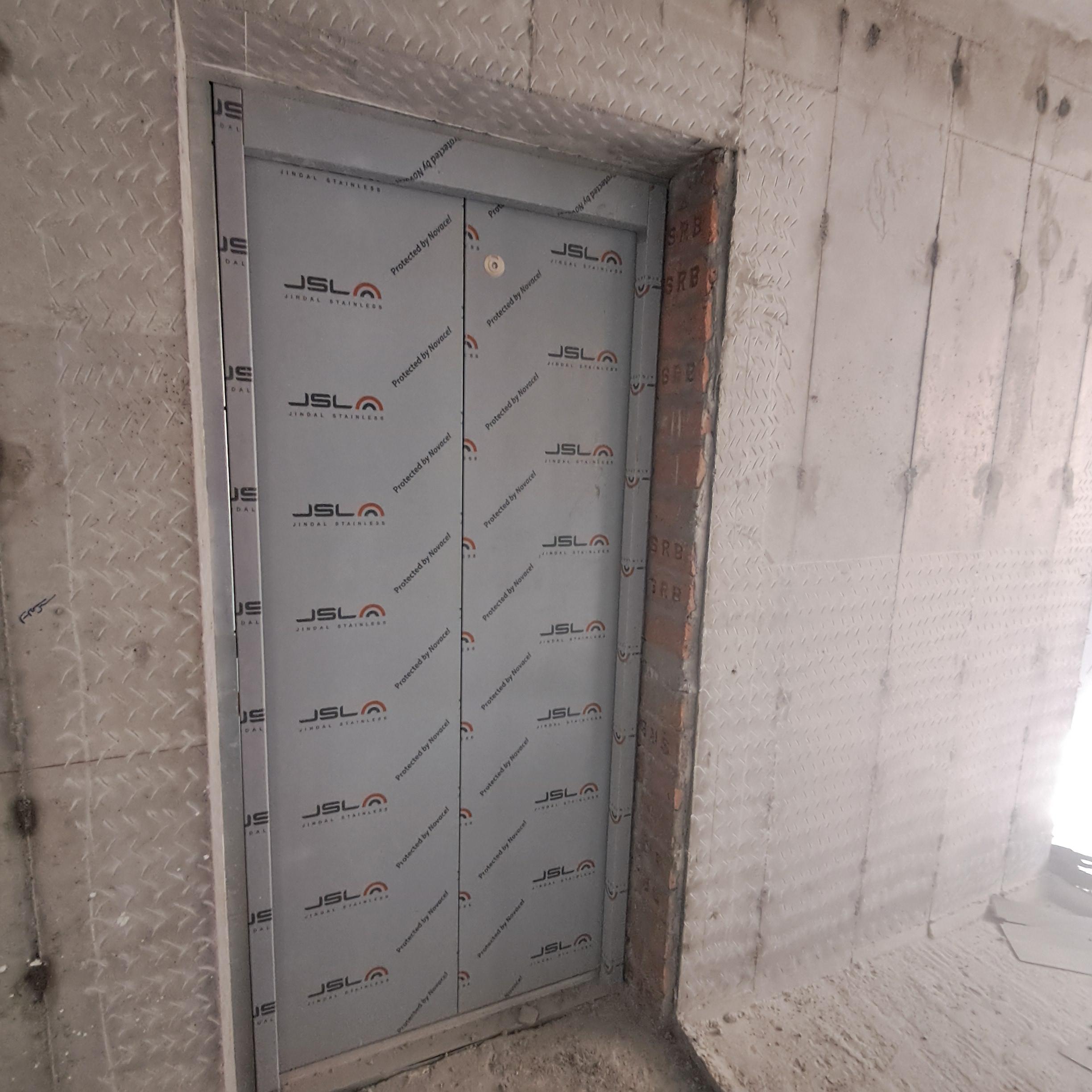

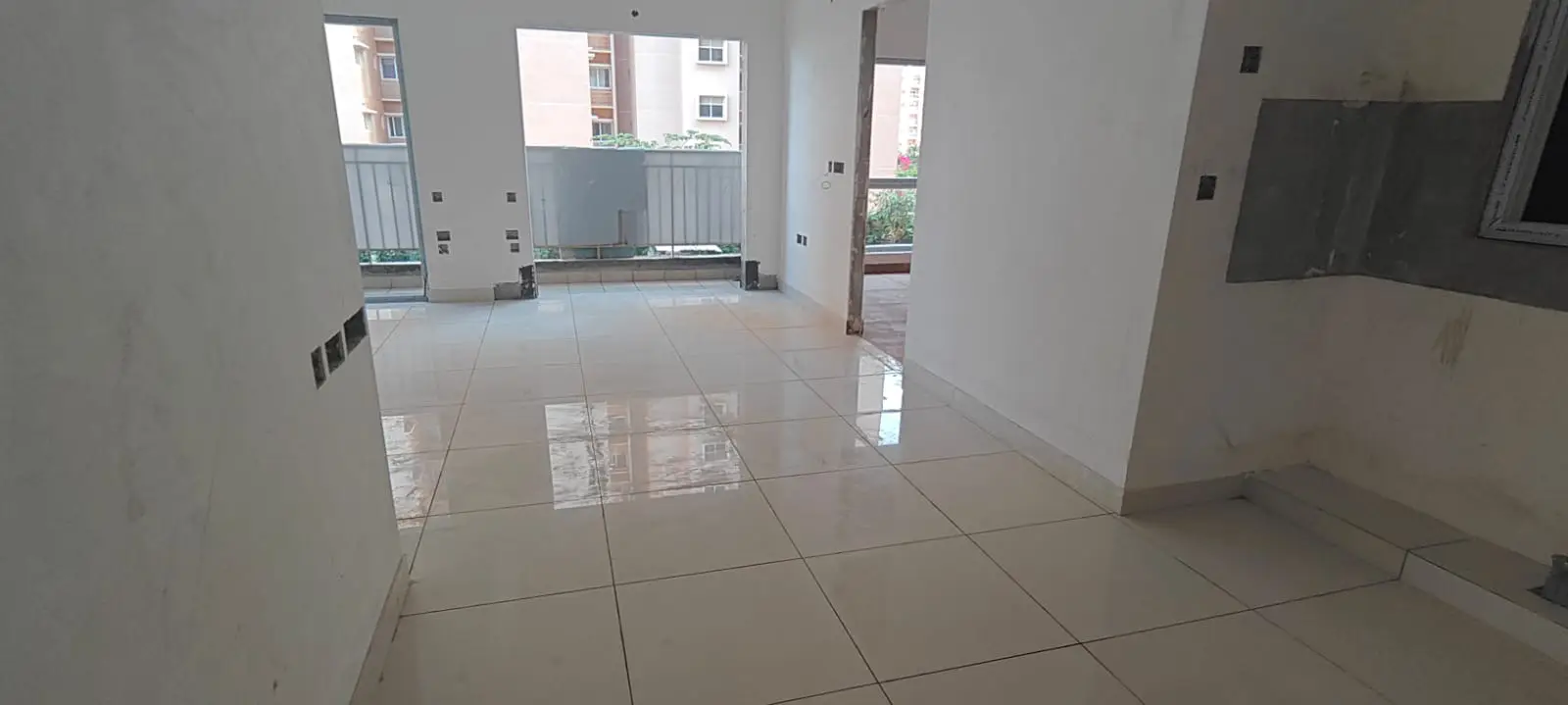

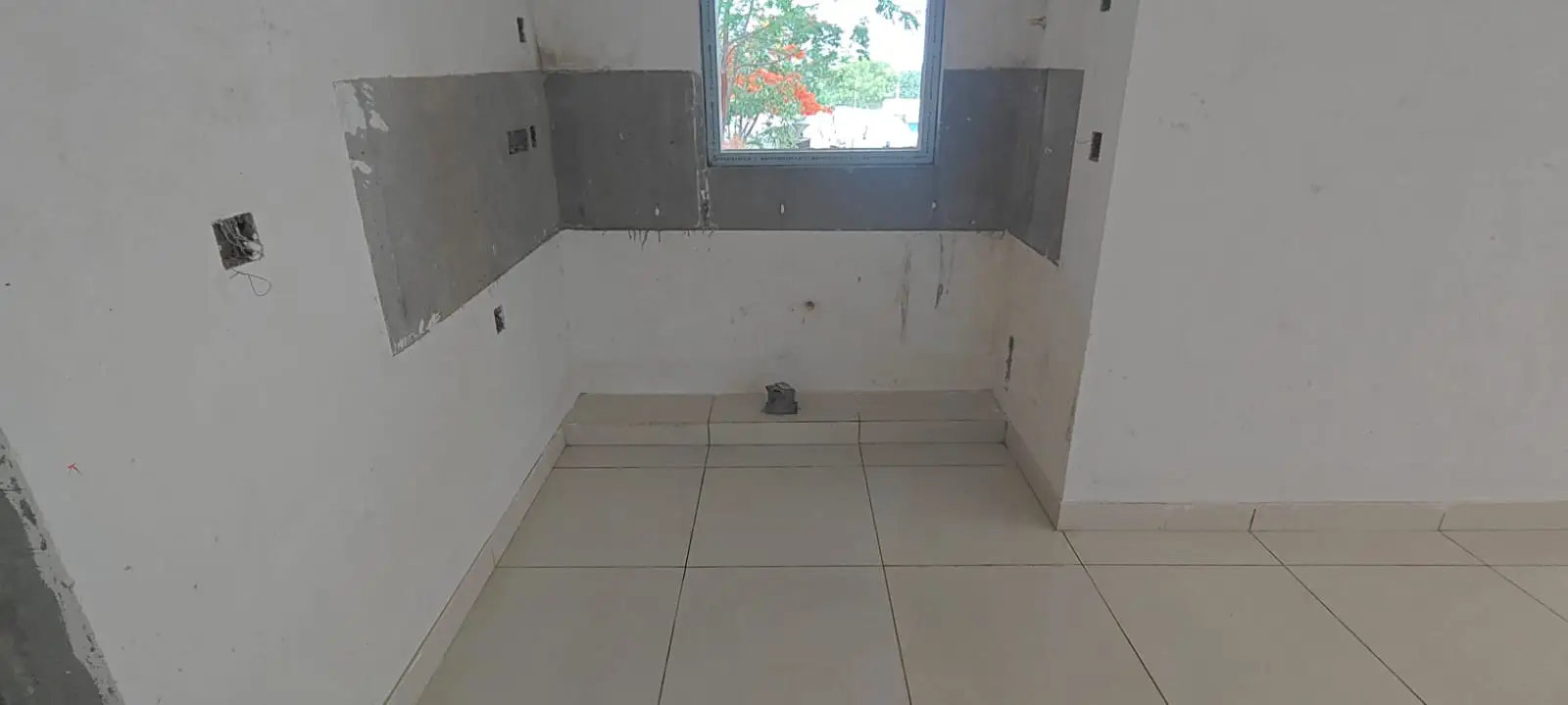

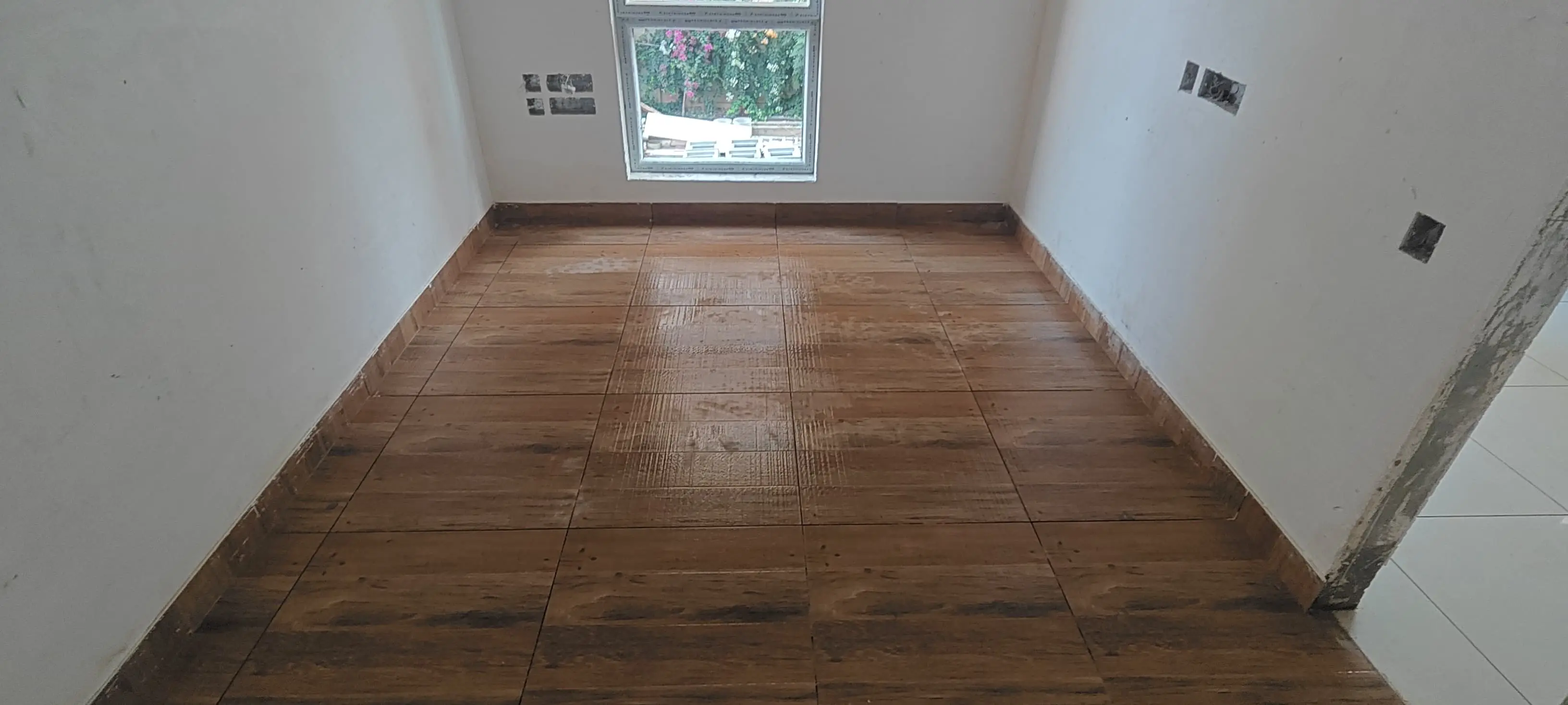

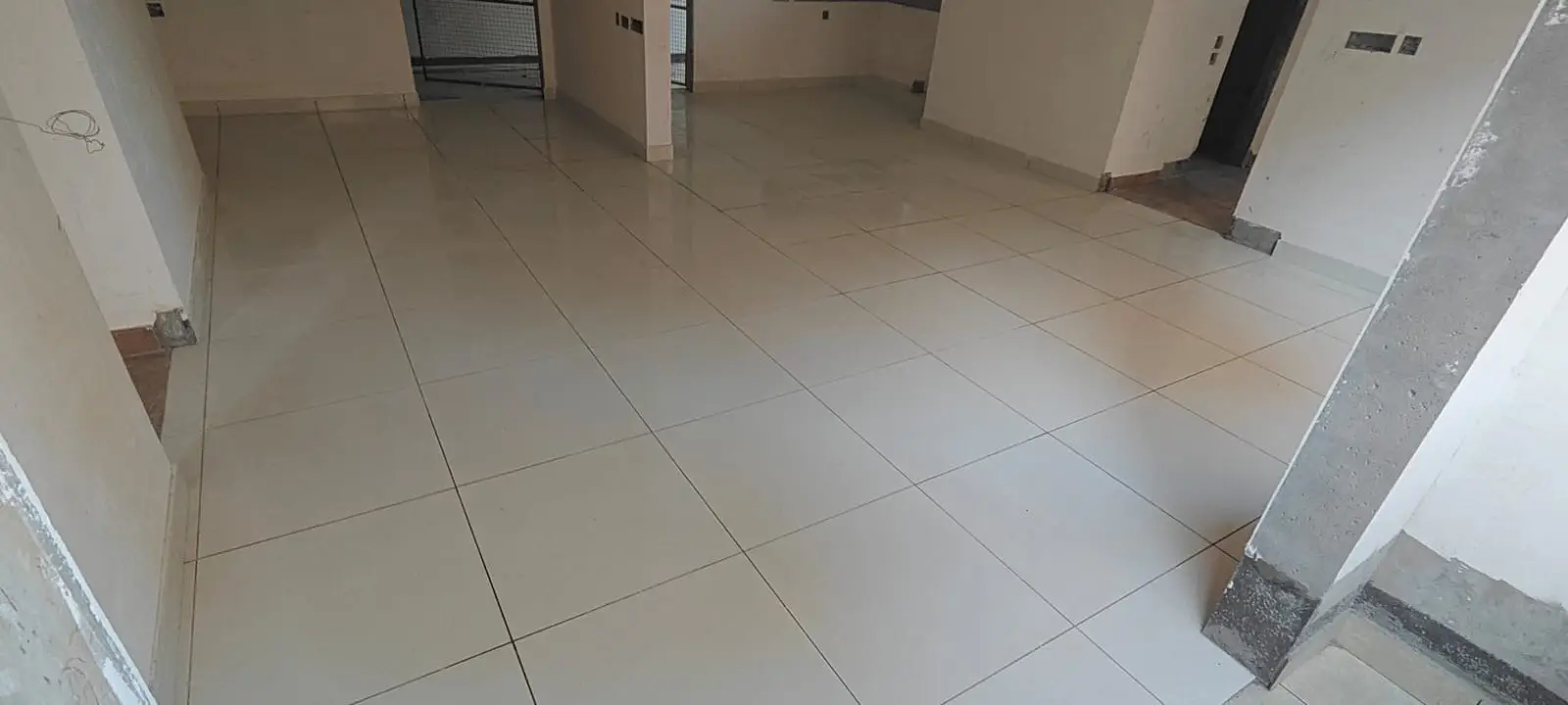

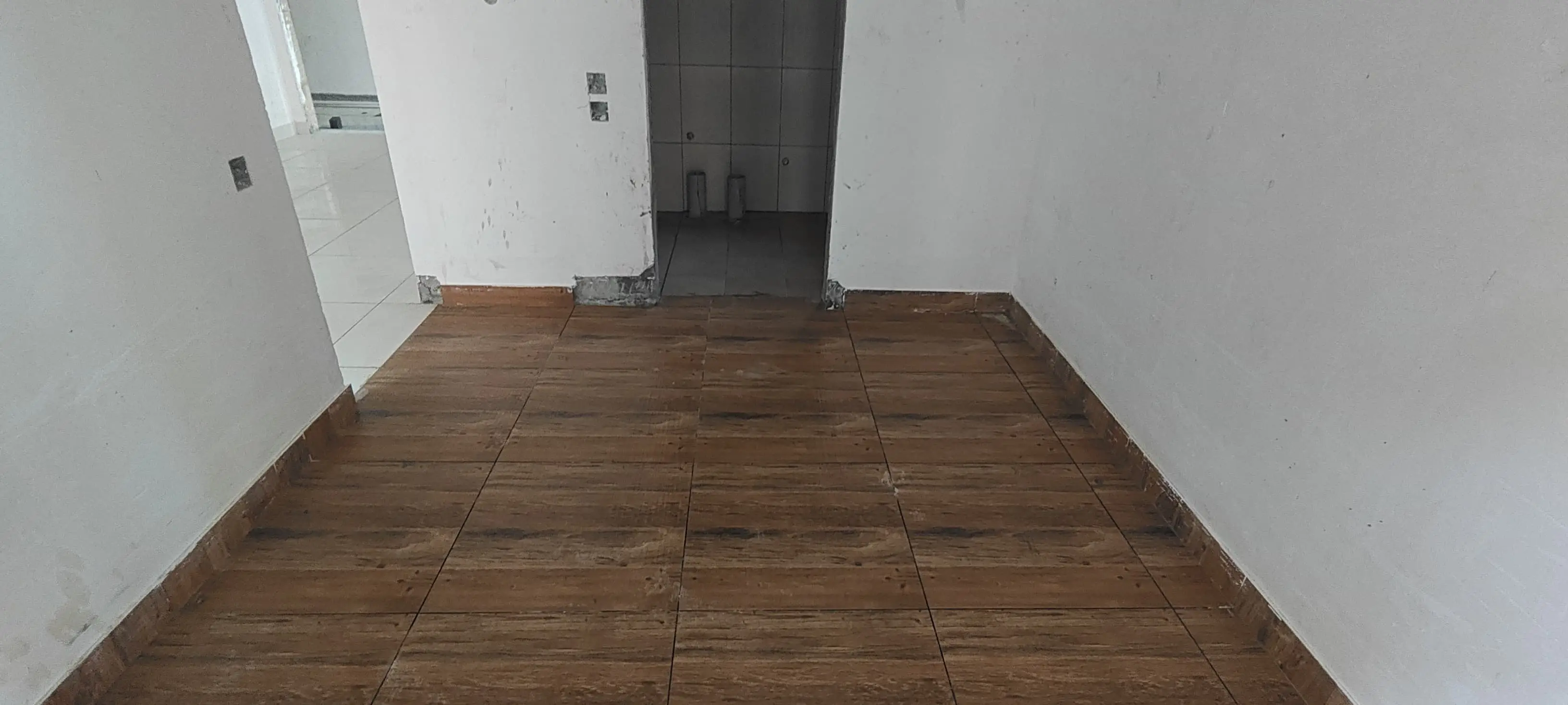

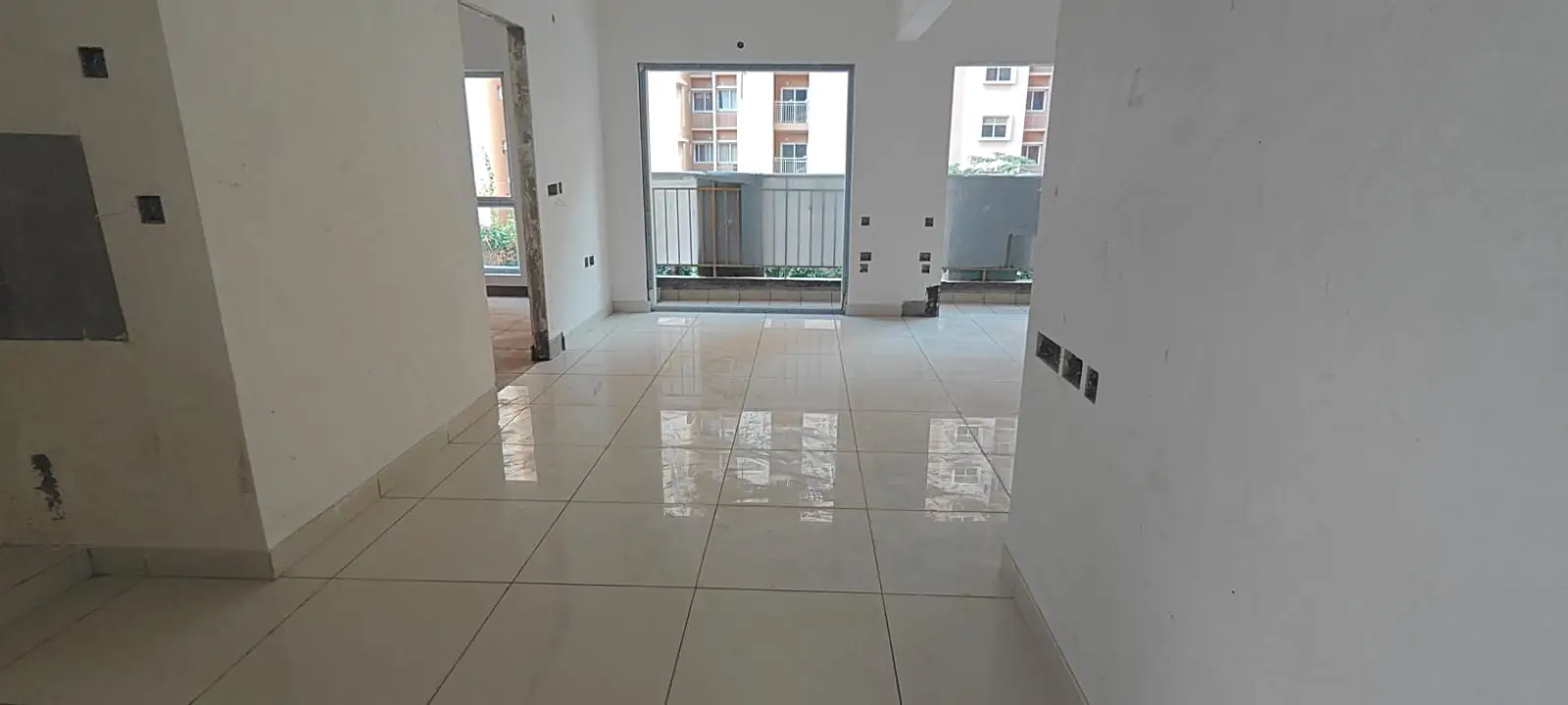

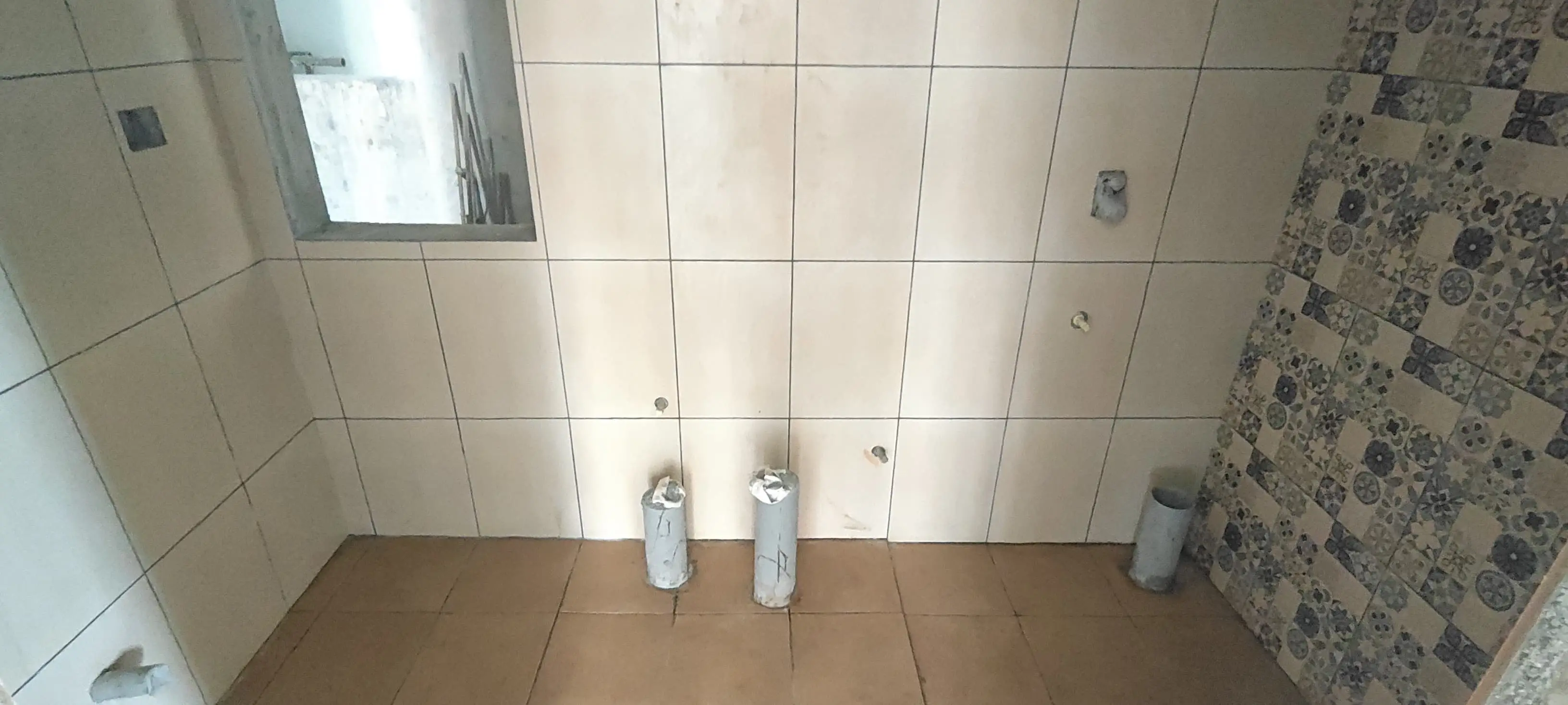

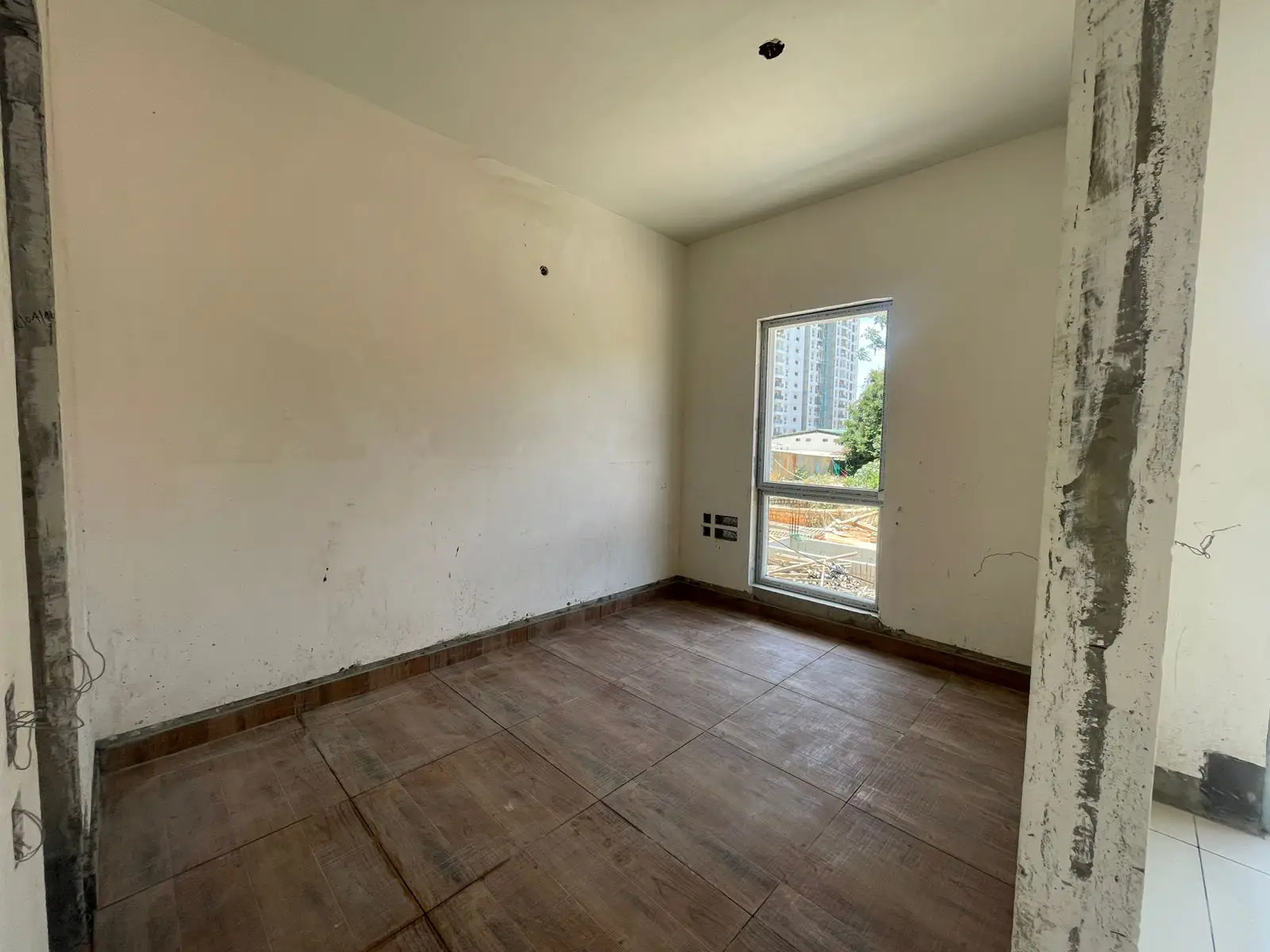

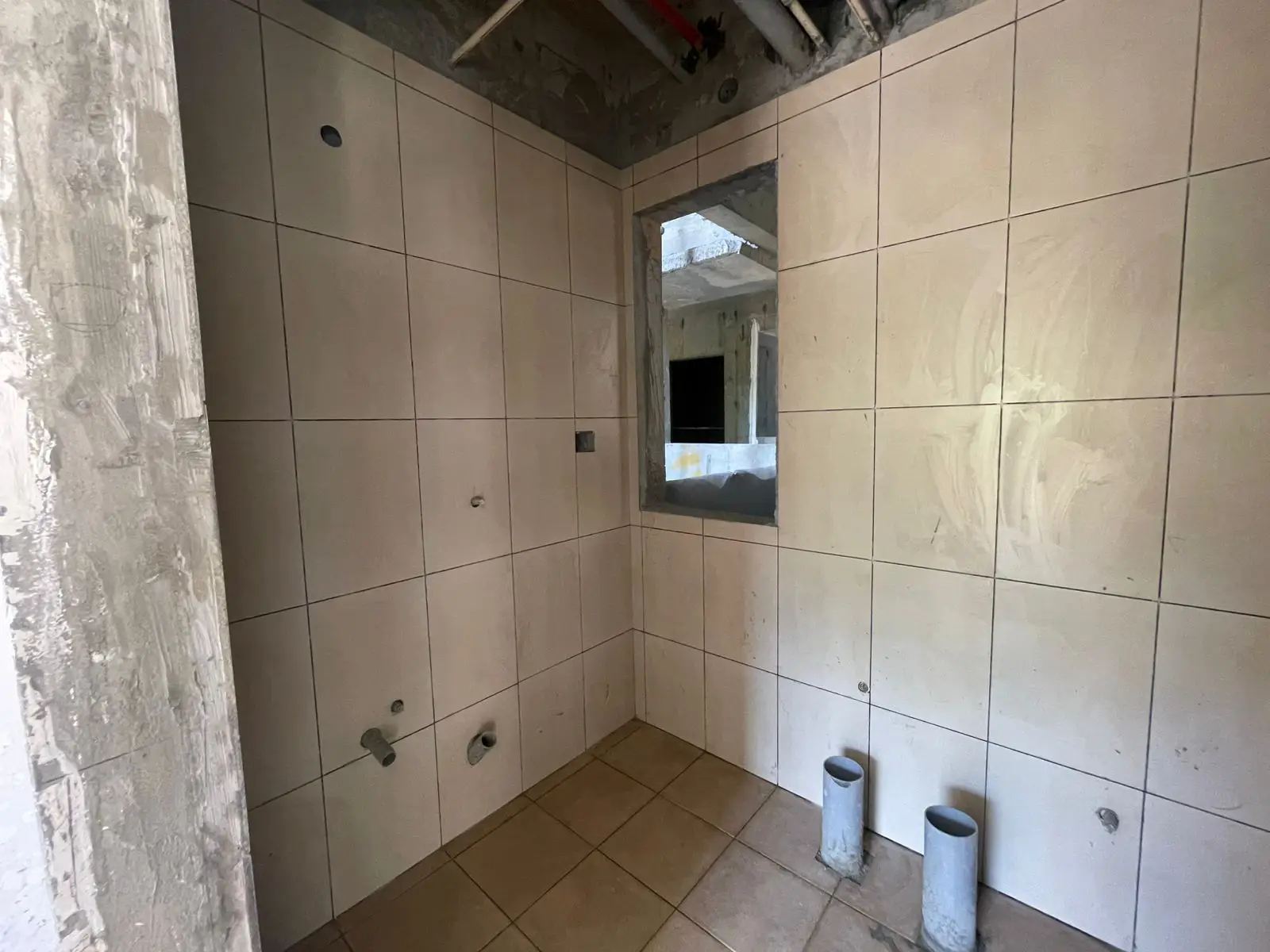

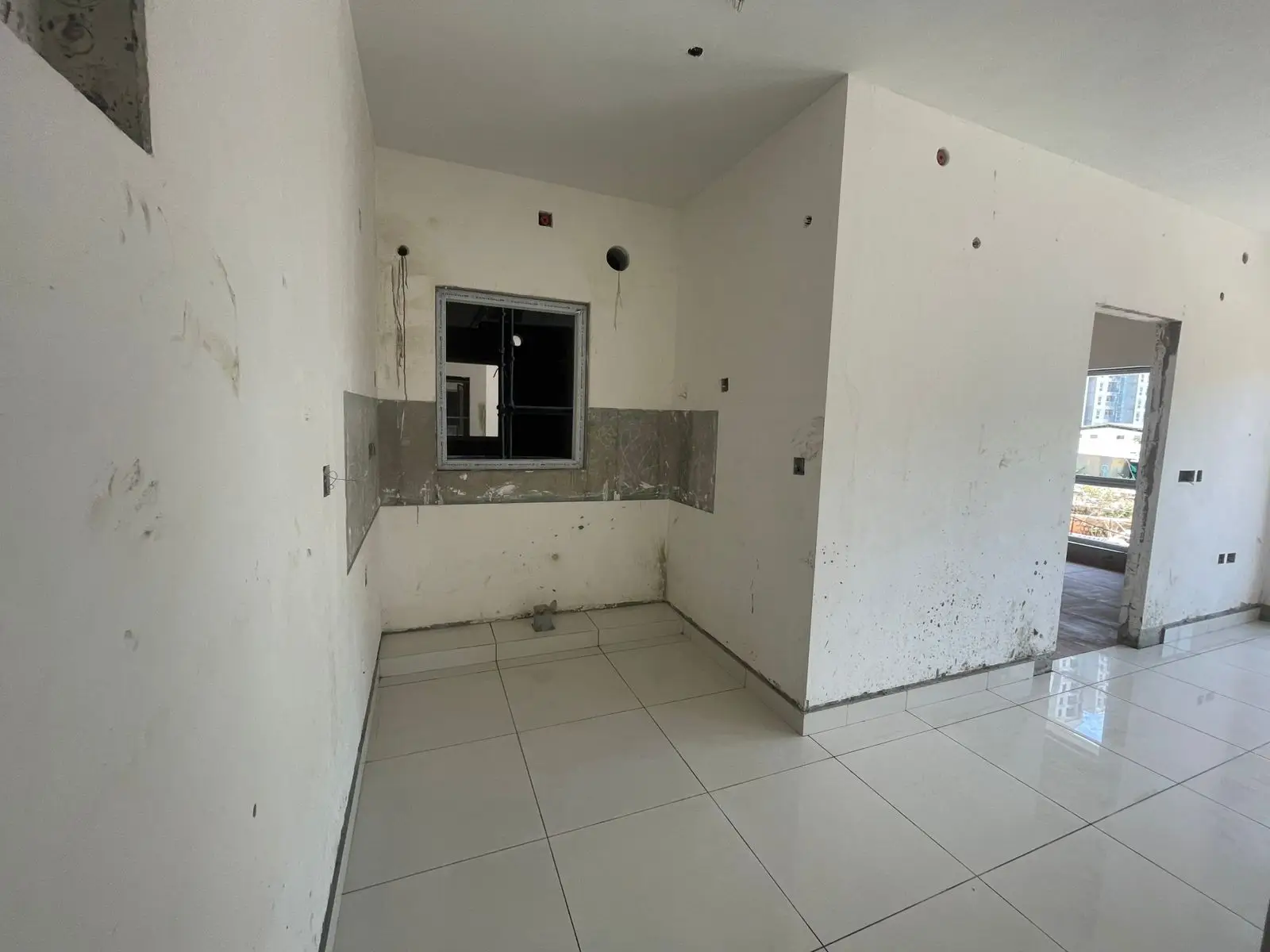

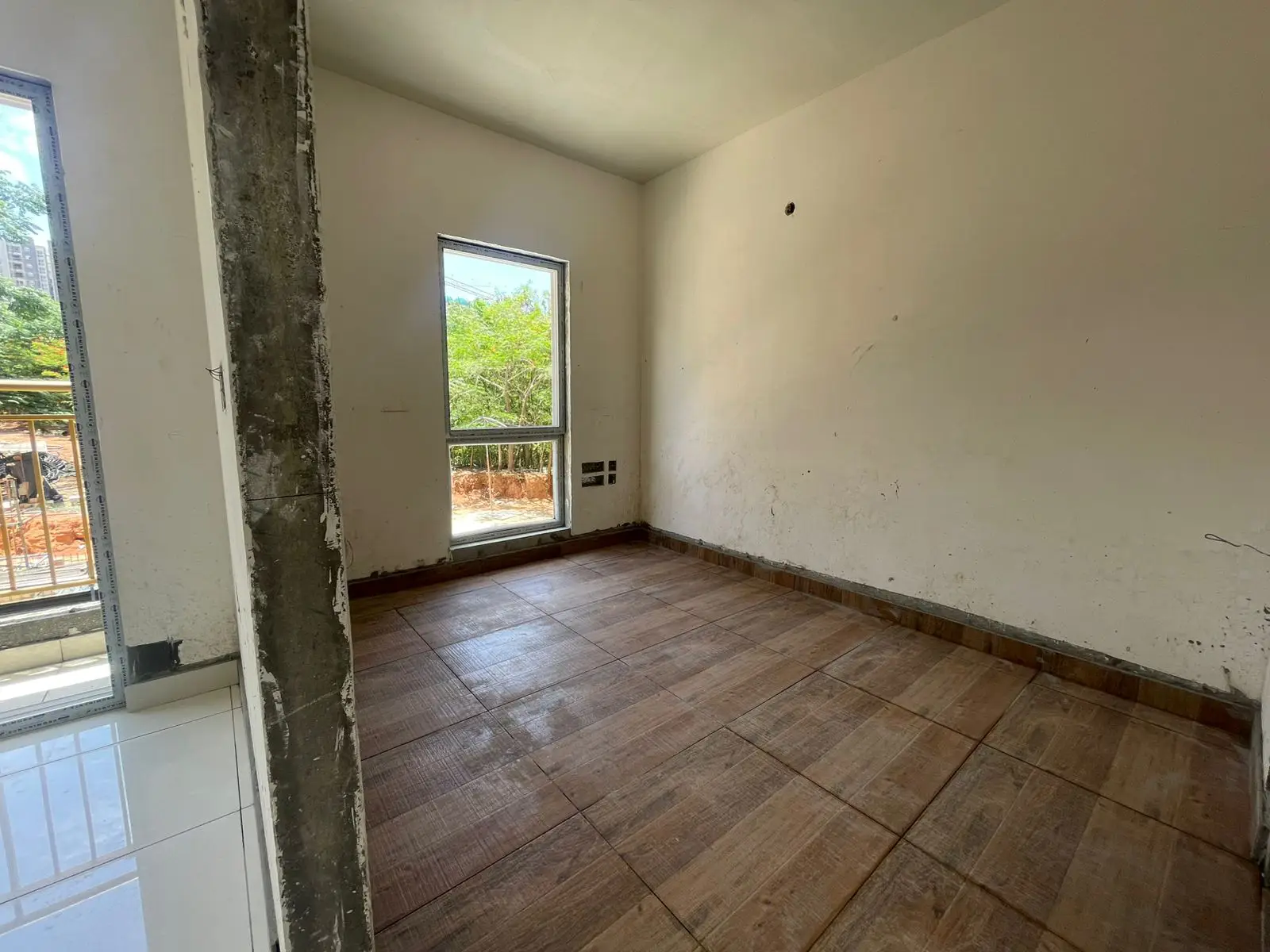

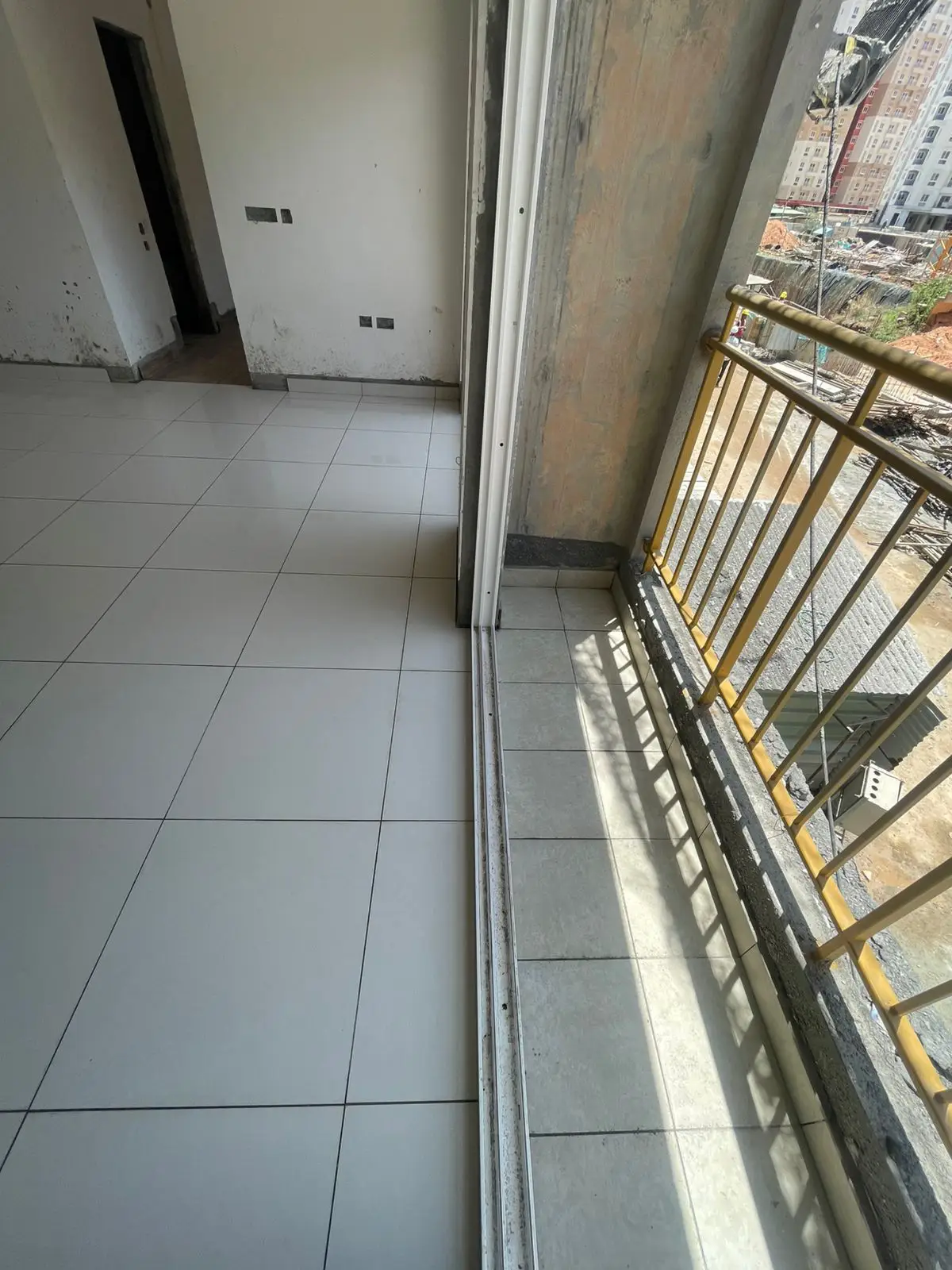

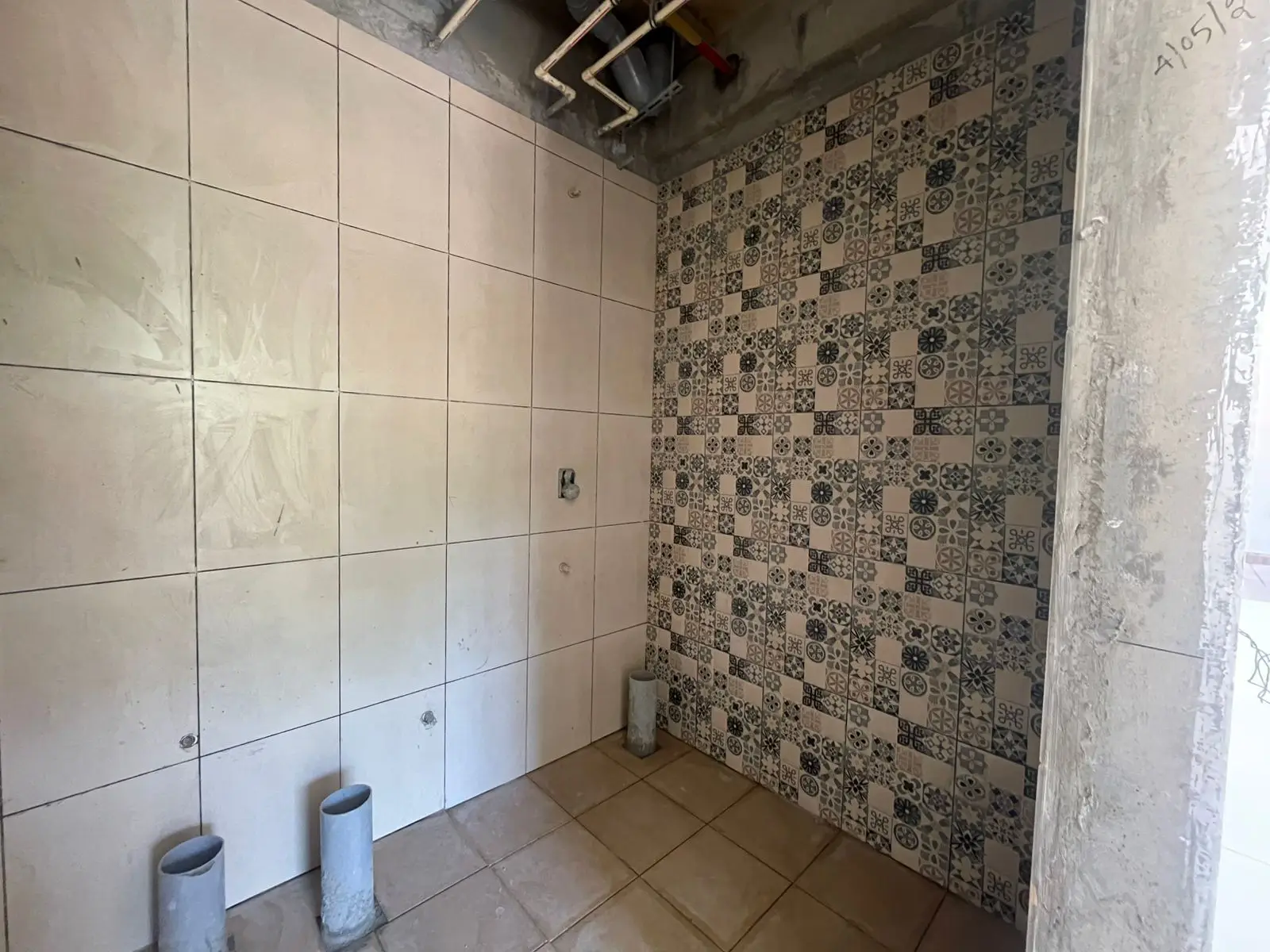

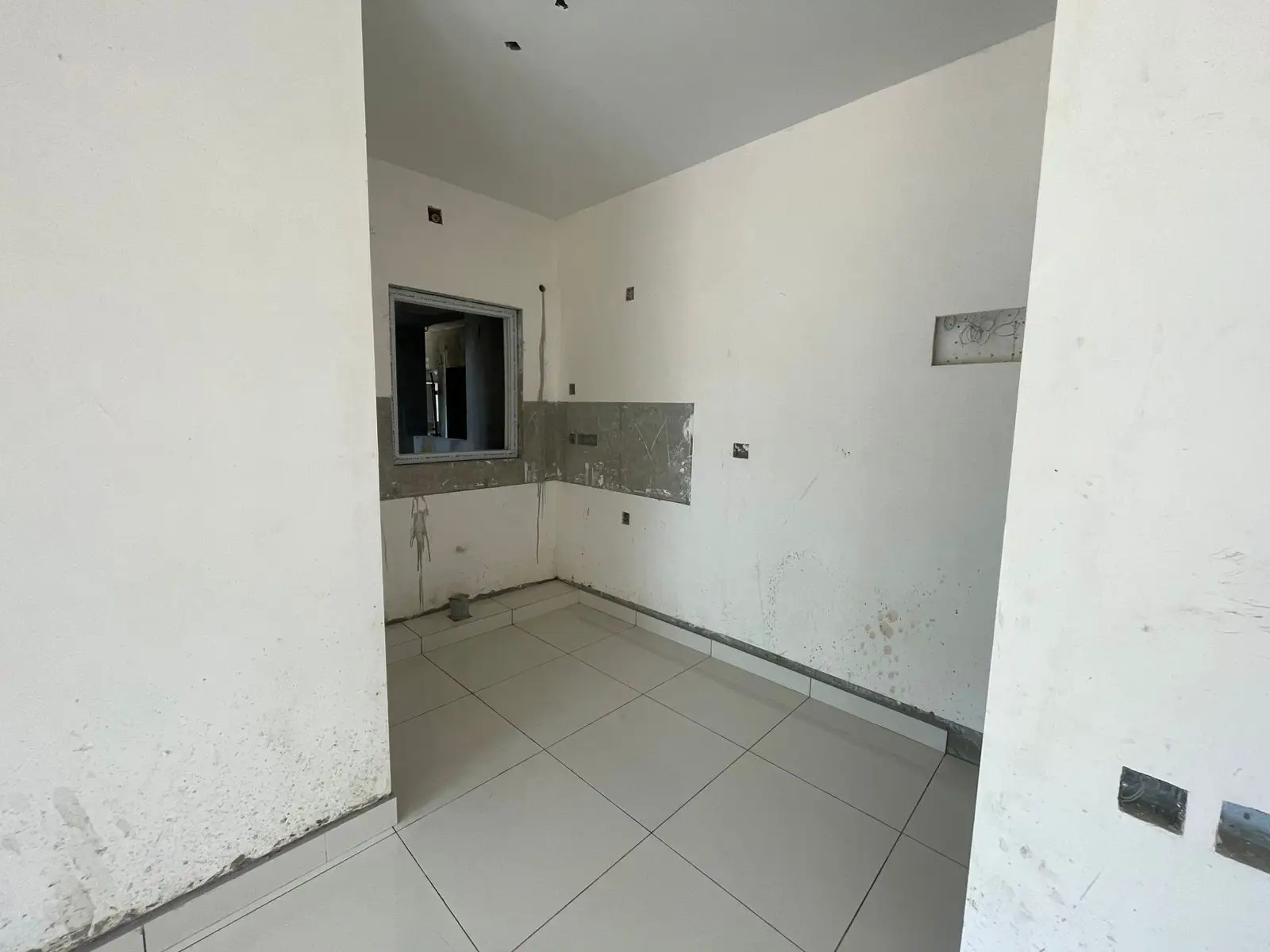

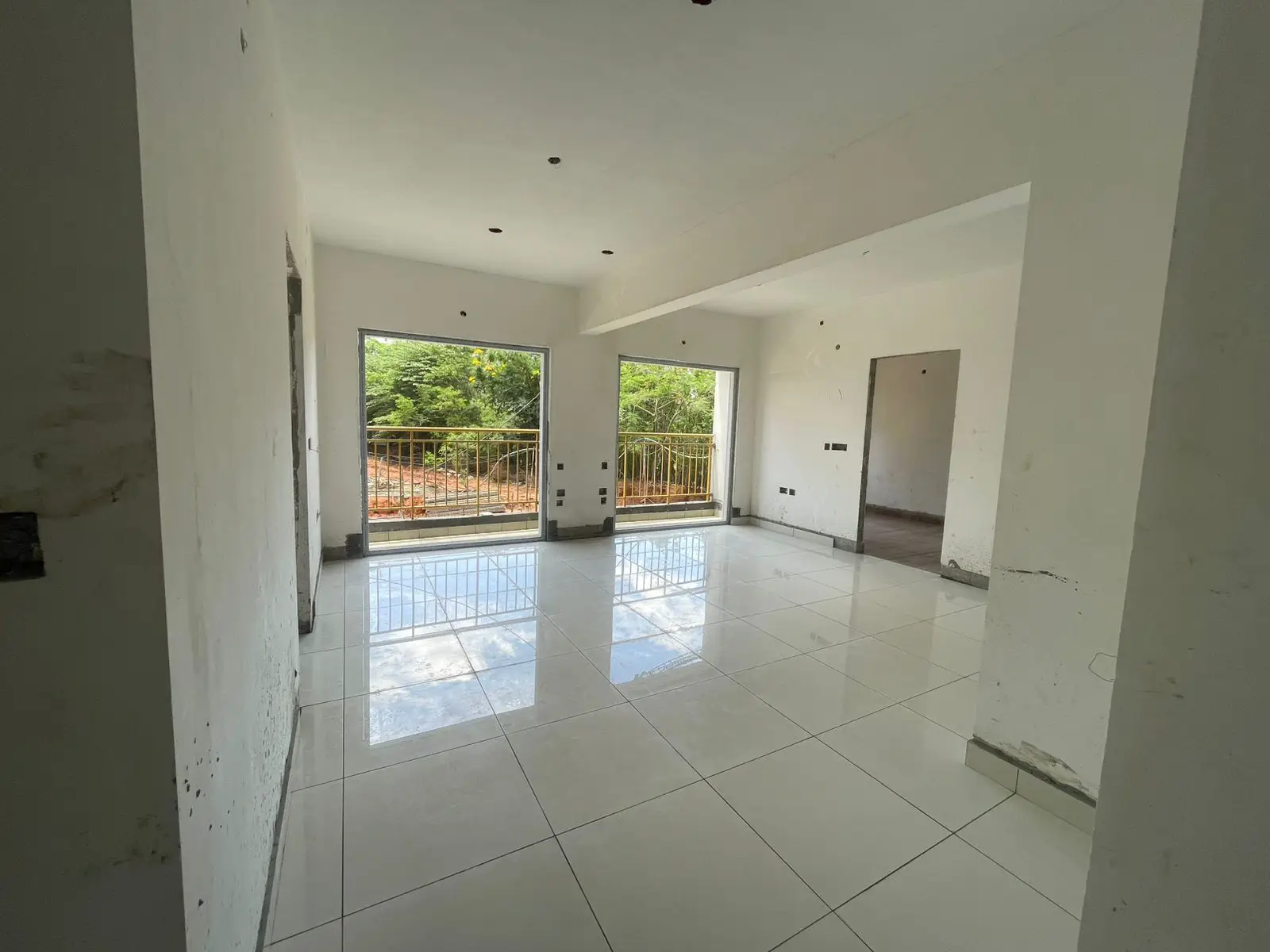

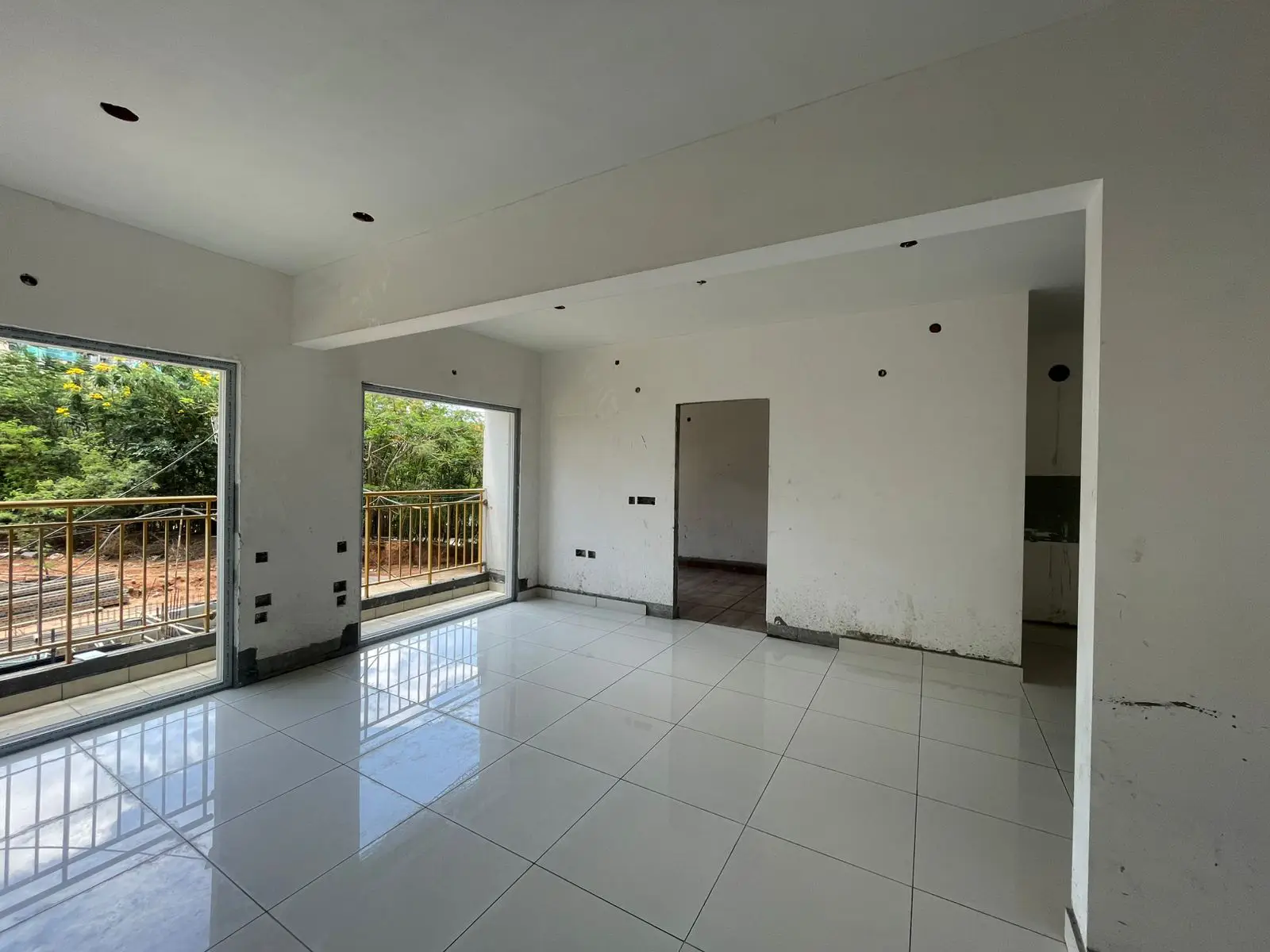

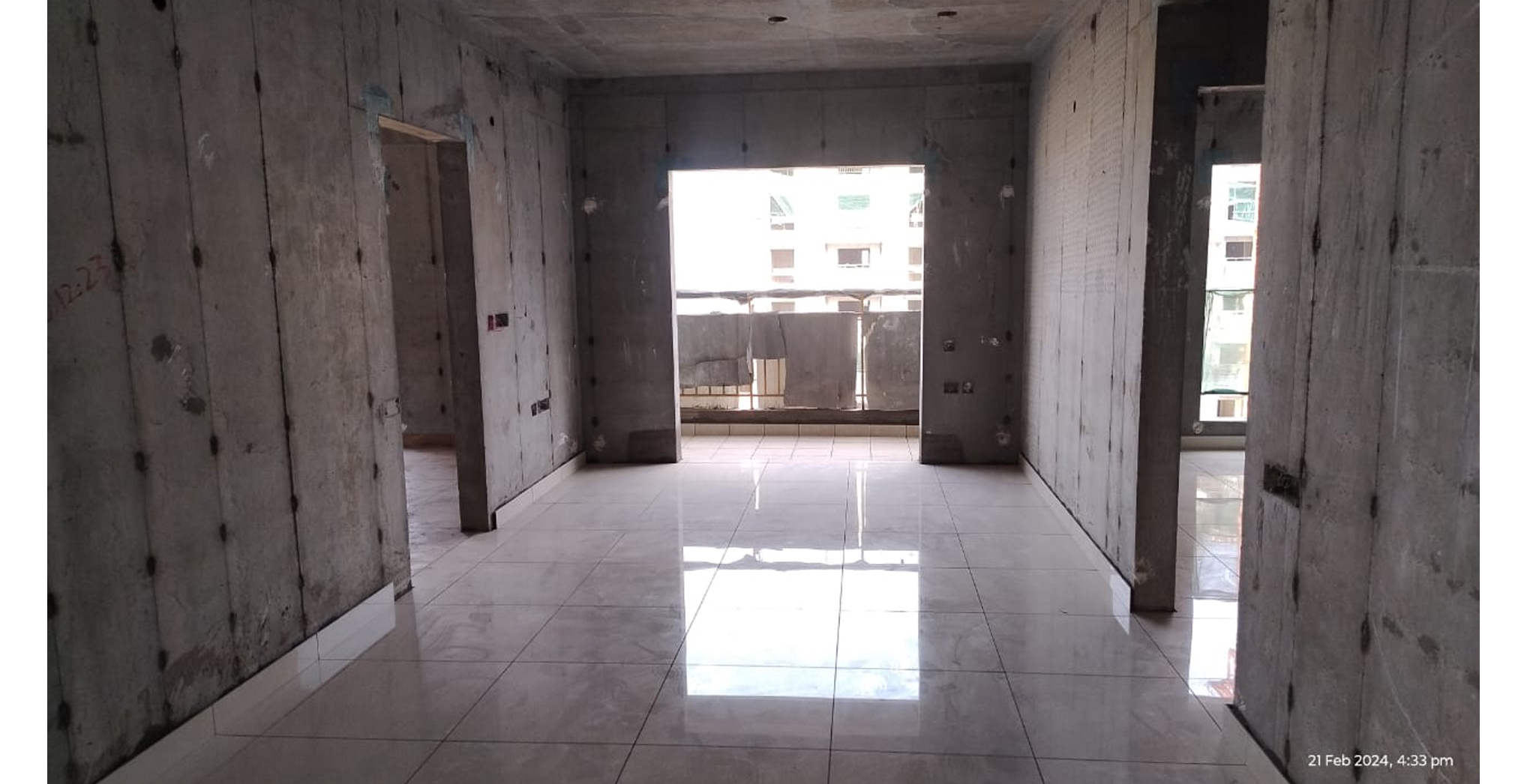

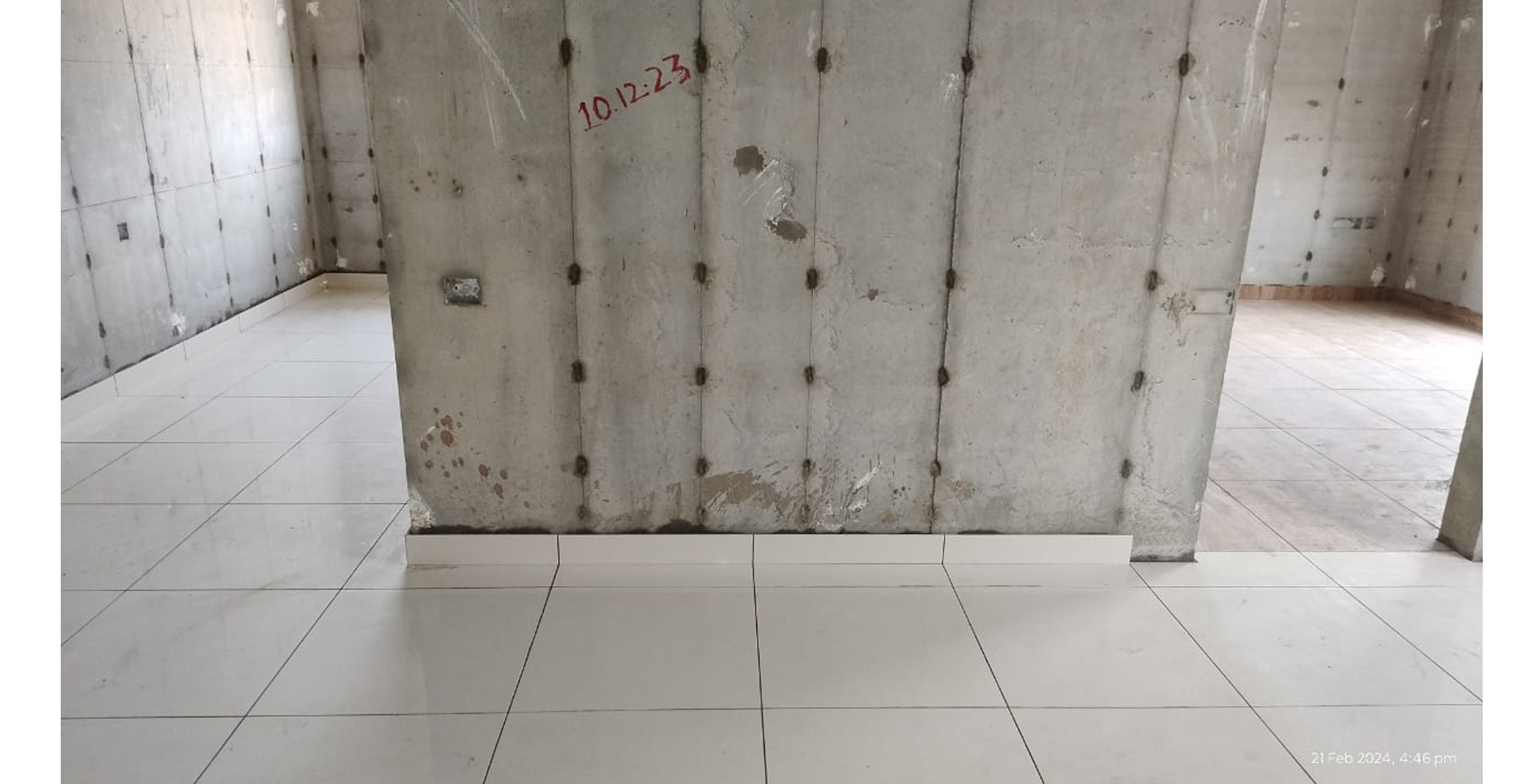

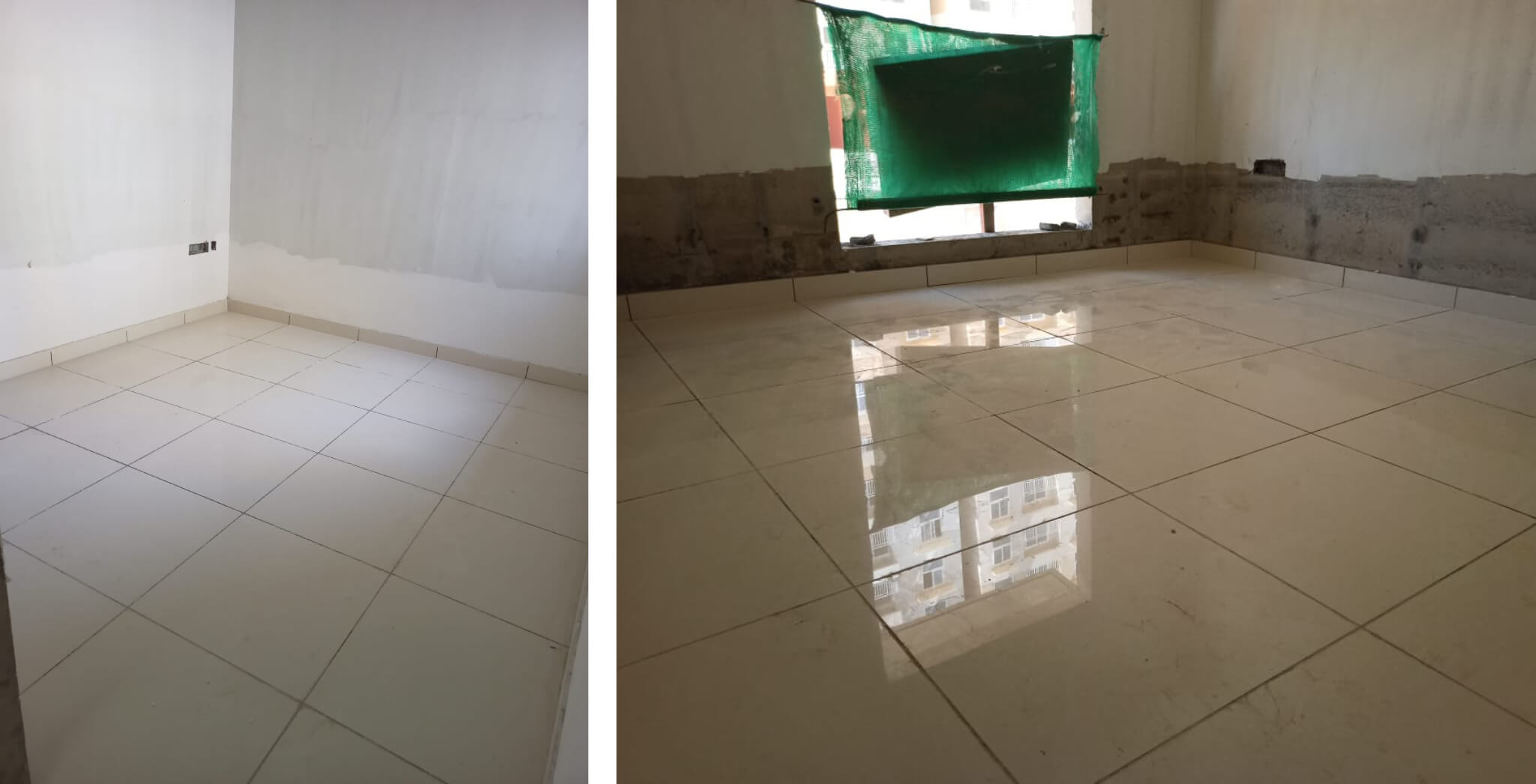

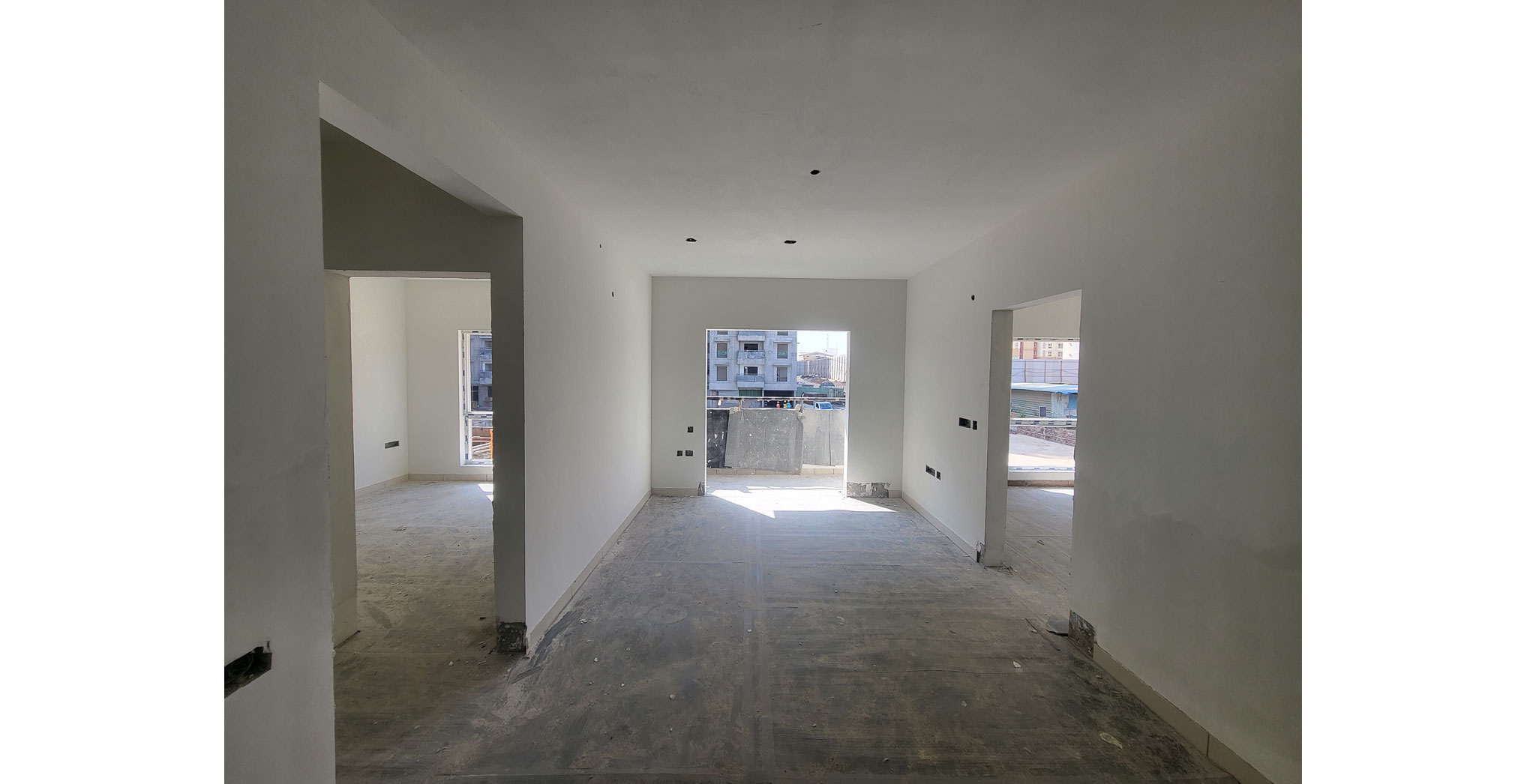

Dioro – Wing A – Milestone Release –“On commencement of Flooring GF to 6F ' – Status as on 24th - Jun 2025

Dioro – Wing A – Milestone Release –“On commencement of Flooring GF to 6F ' – Status as on 24th - Jun 2025

Dioro – Wing A – Milestone Release –“On commencement of Flooring GF to 6F ' – Status as on 24th - Jun 2025

Dioro – Wing A – Milestone Release –“On commencement of Flooring GF to 6F ' – Status as on 24th - Jun 2025

Dioro – Wing A – Milestone Release –“On commencement of Flooring GF to 6F ' – Status as on 24th - Jun 2025

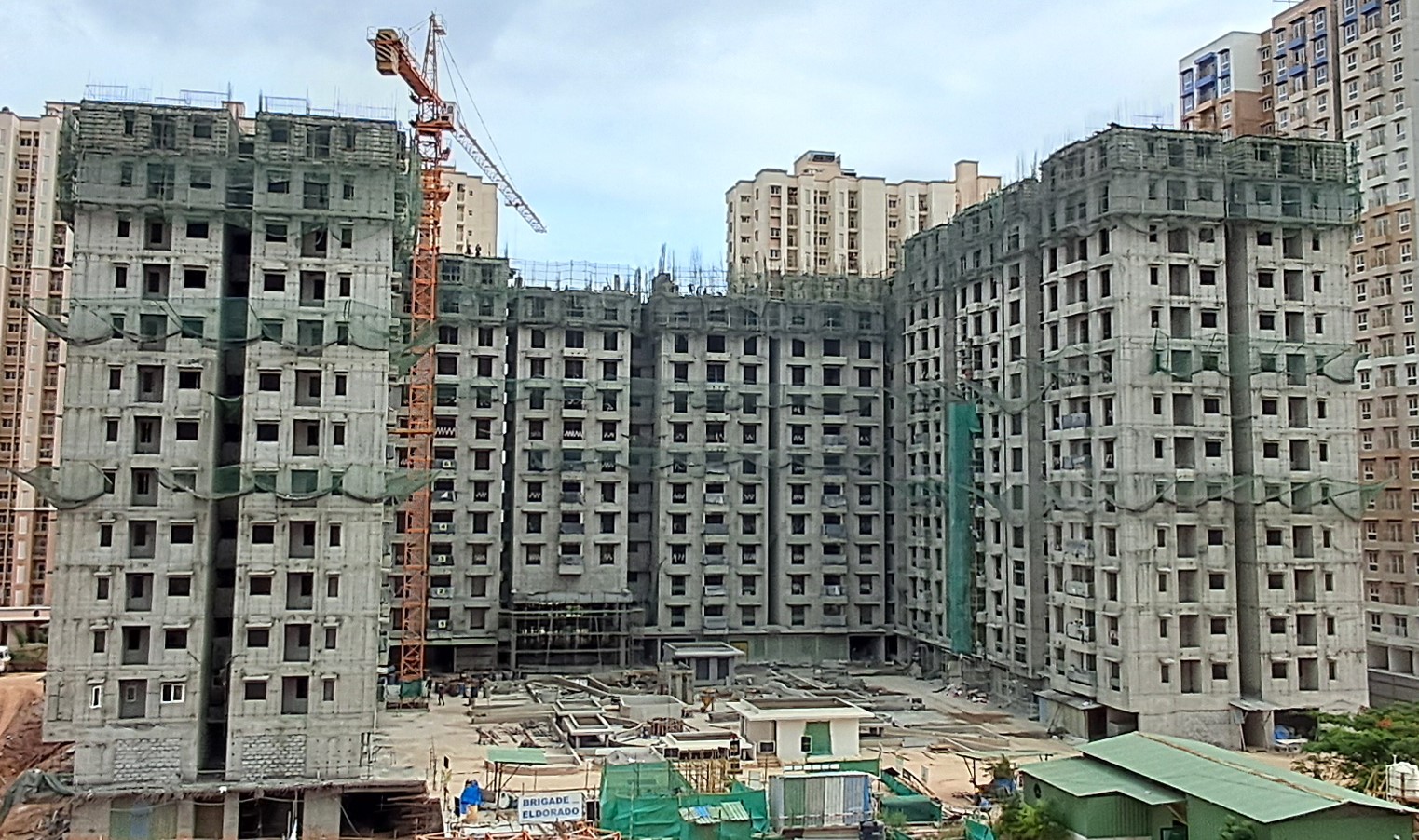

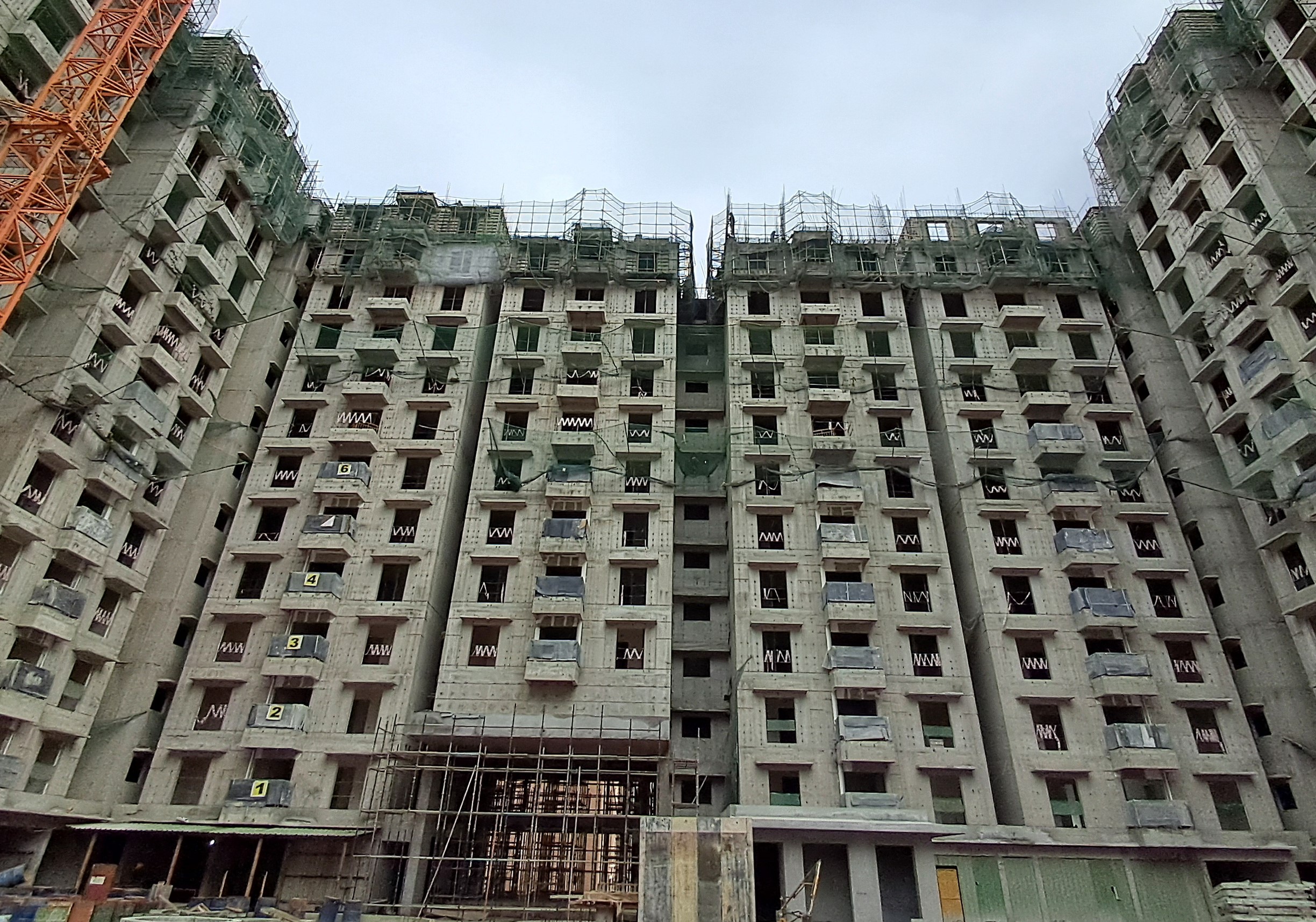

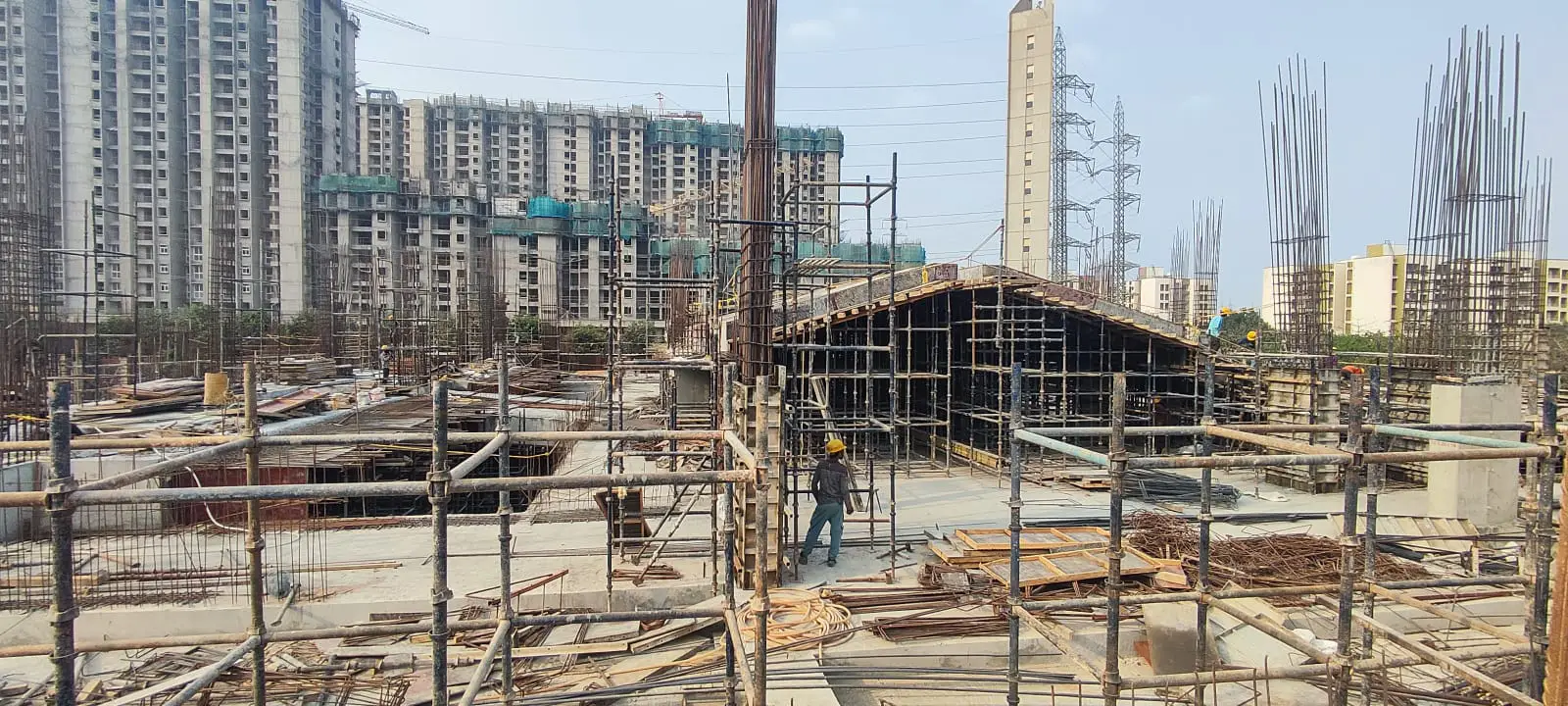

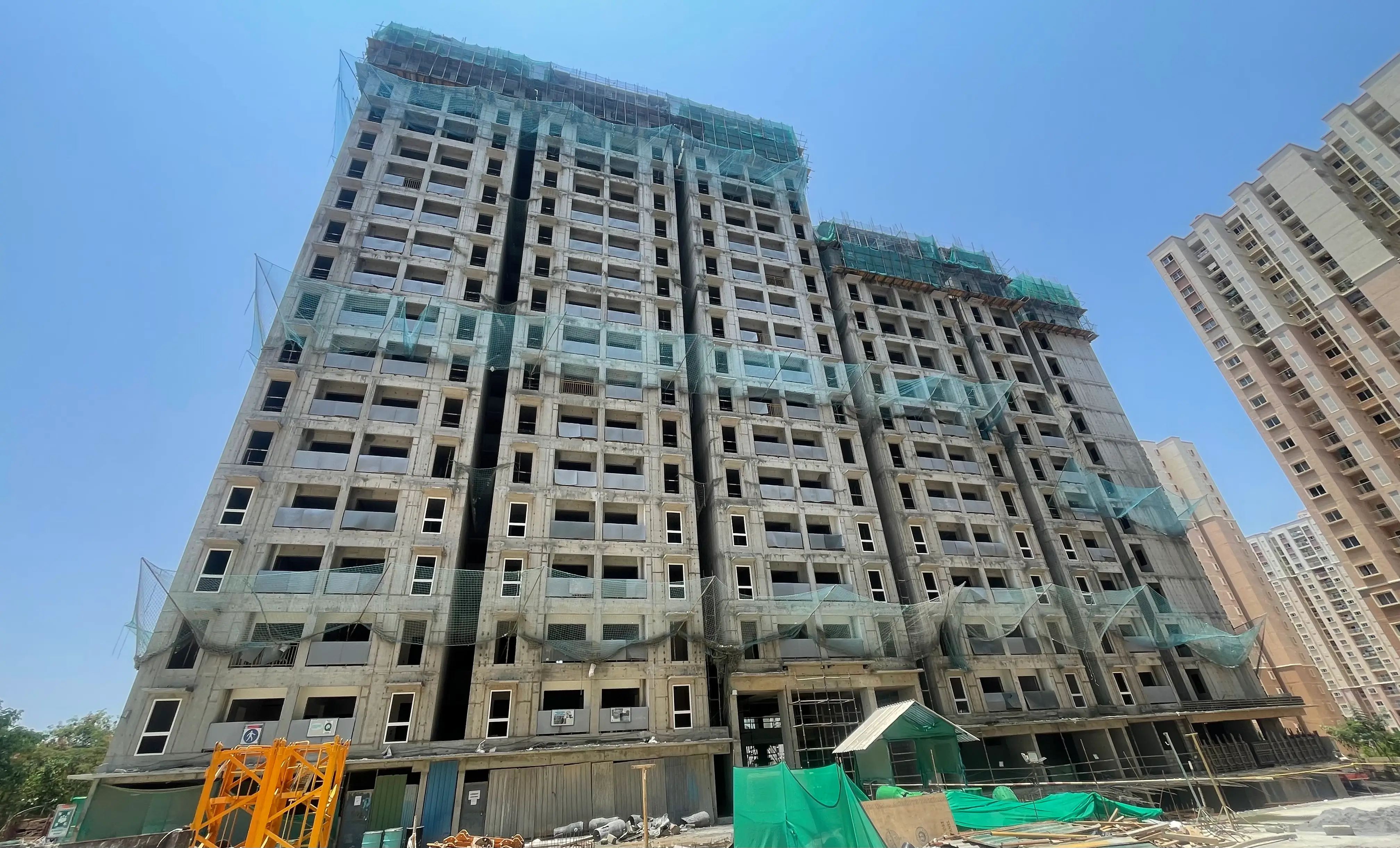

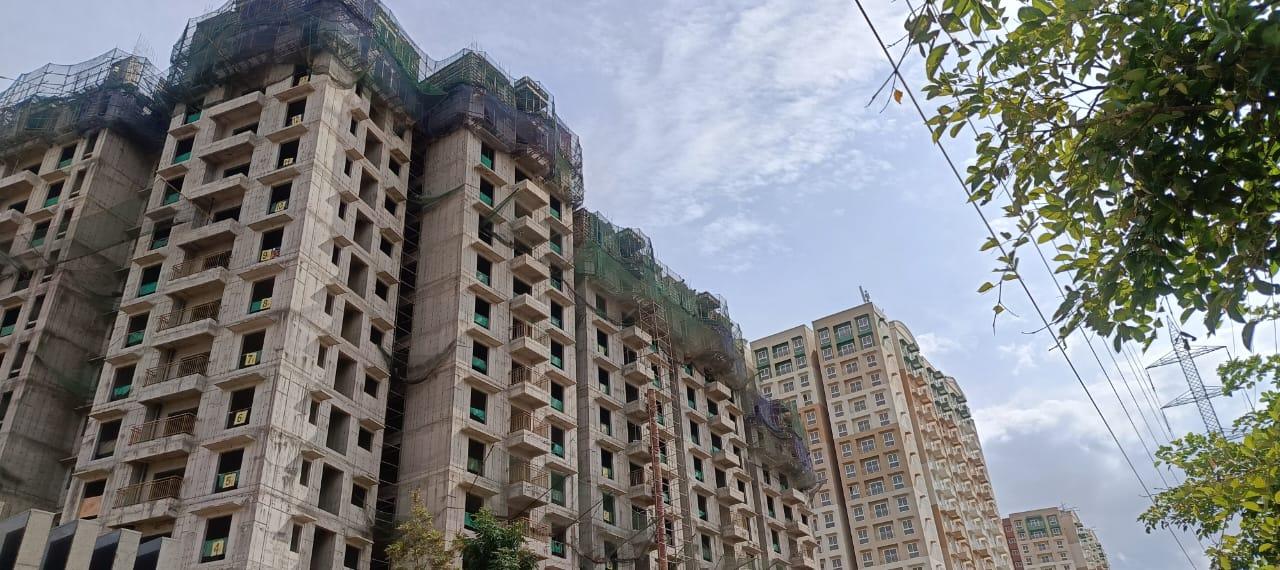

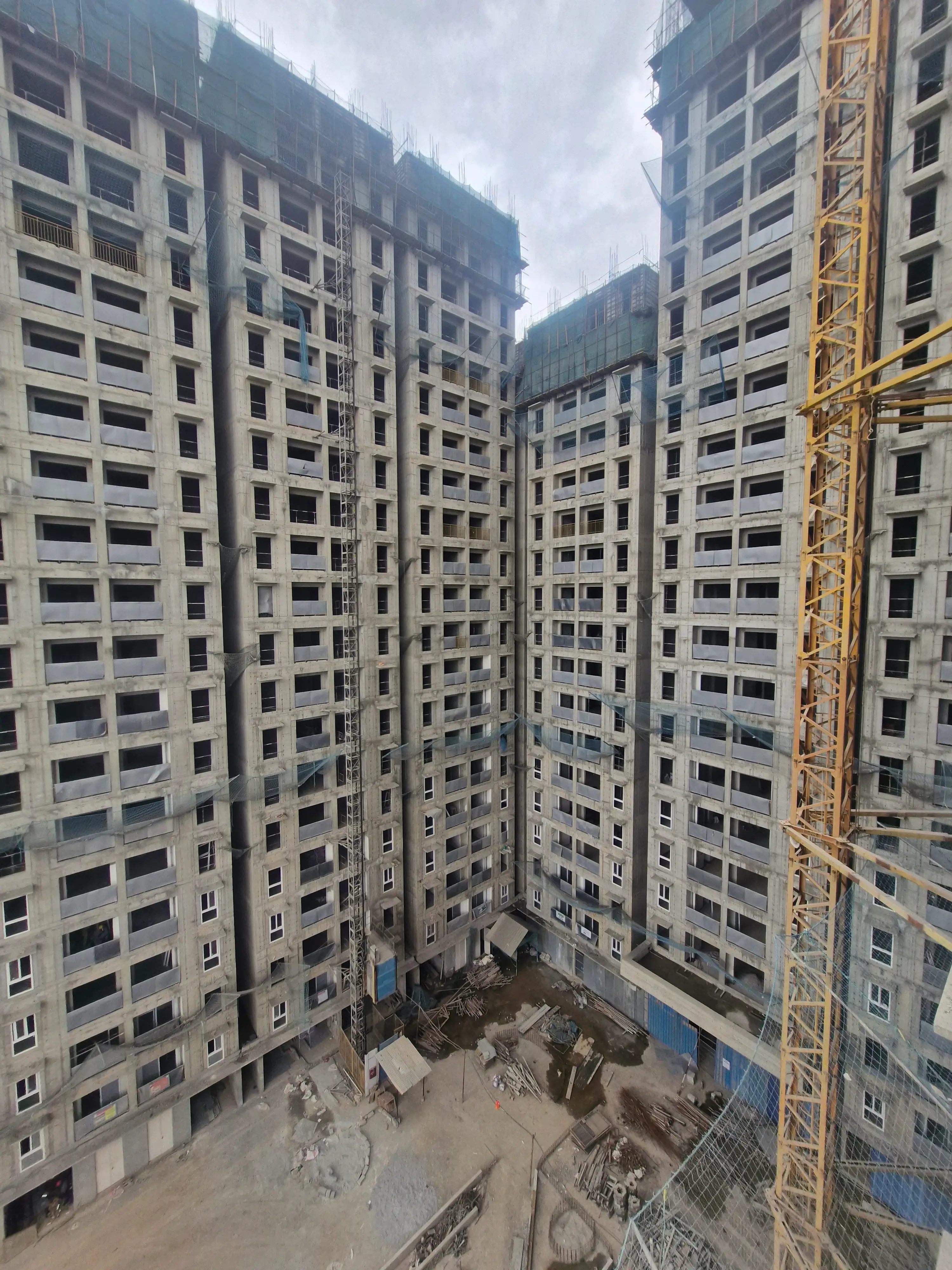

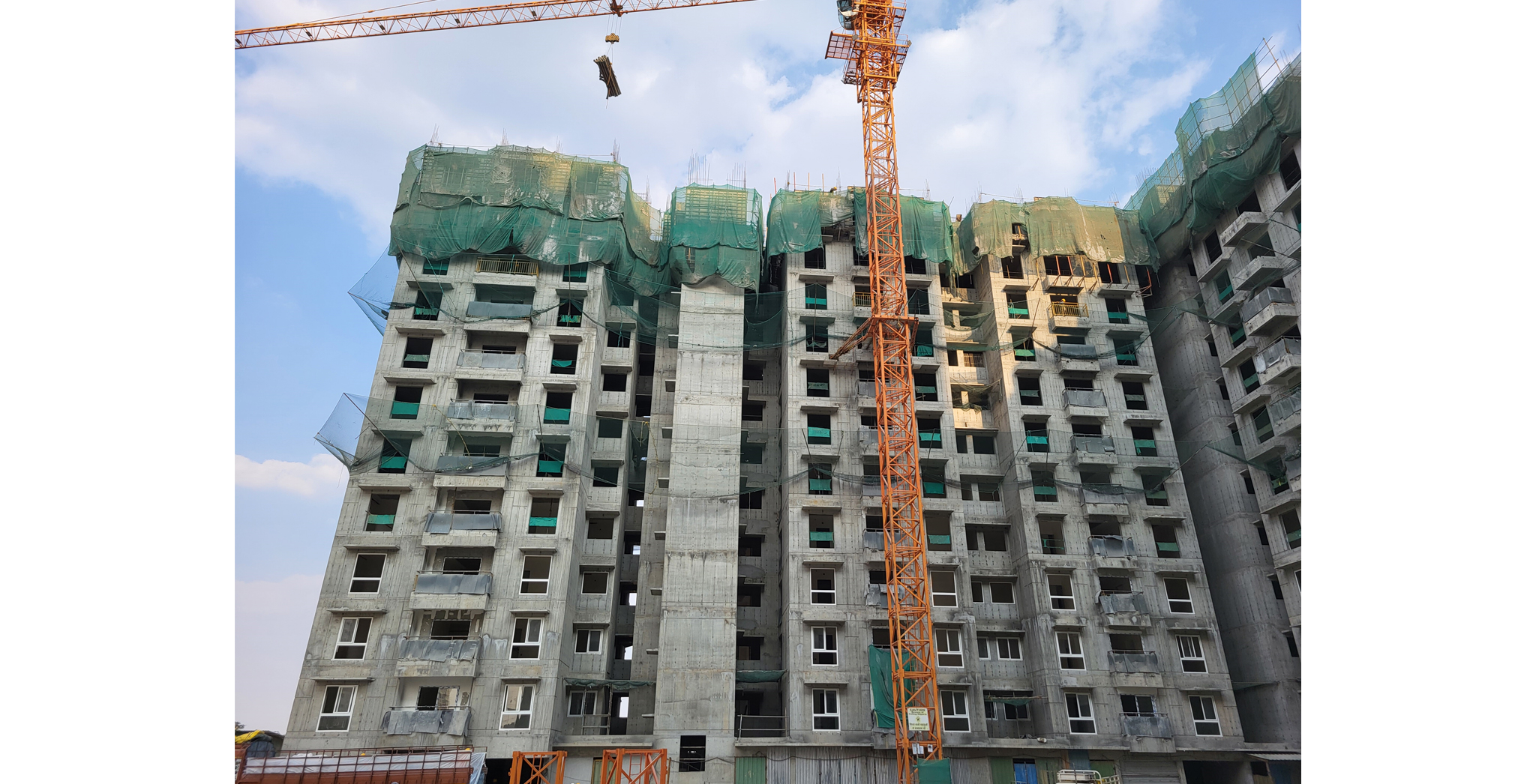

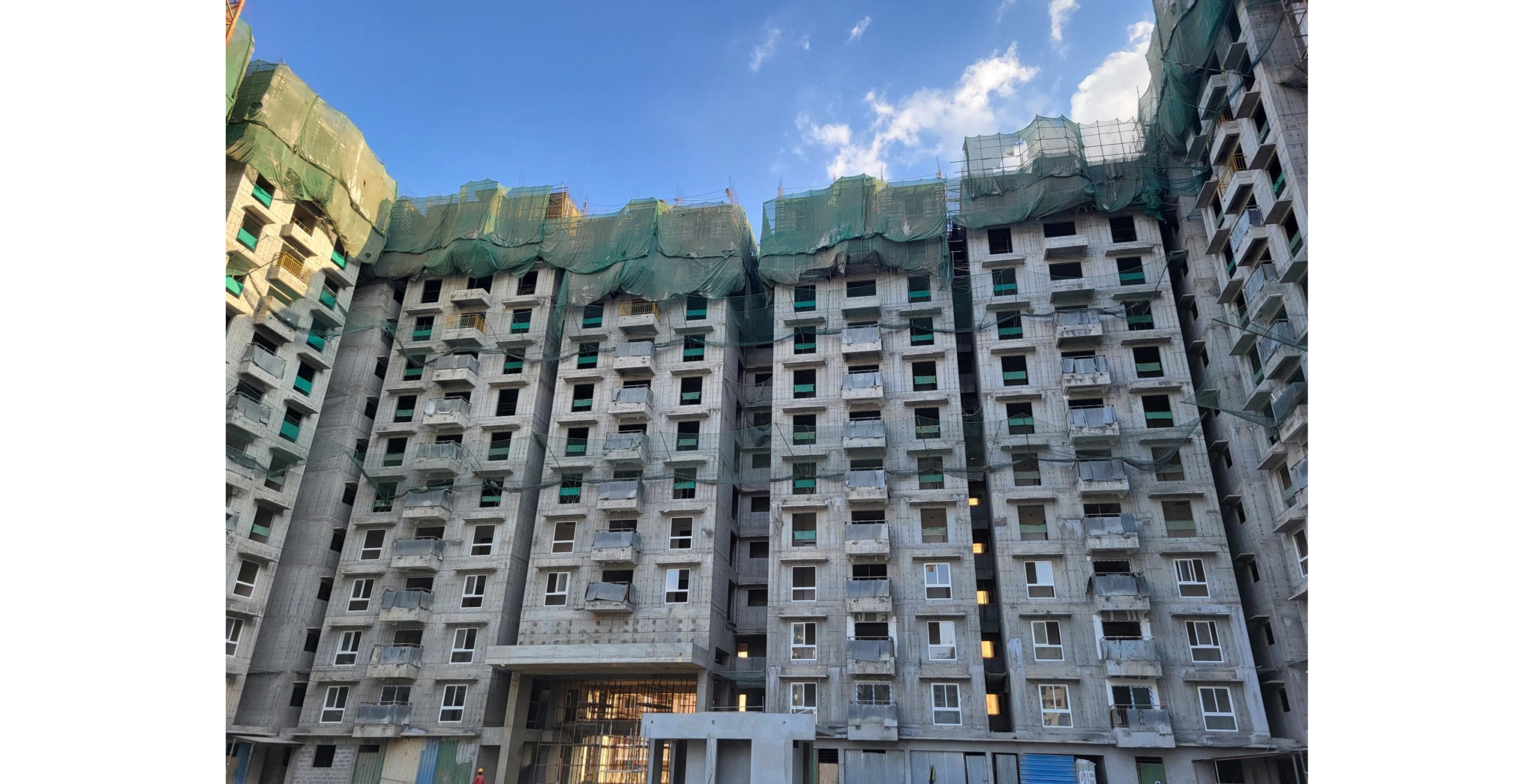

Wing B – Milestone Release –“ On Casting of Twelfth floor slab” – Status as on 17th - Jun 2025

Wing B – Milestone Release –“ On Casting of Twelfth floor slab” – Status as on 17th - Jun 2025

Wing B – Milestone Release – “On Casting of Sixteenth Floor Slab” - Status as on 16th - Jun 2025

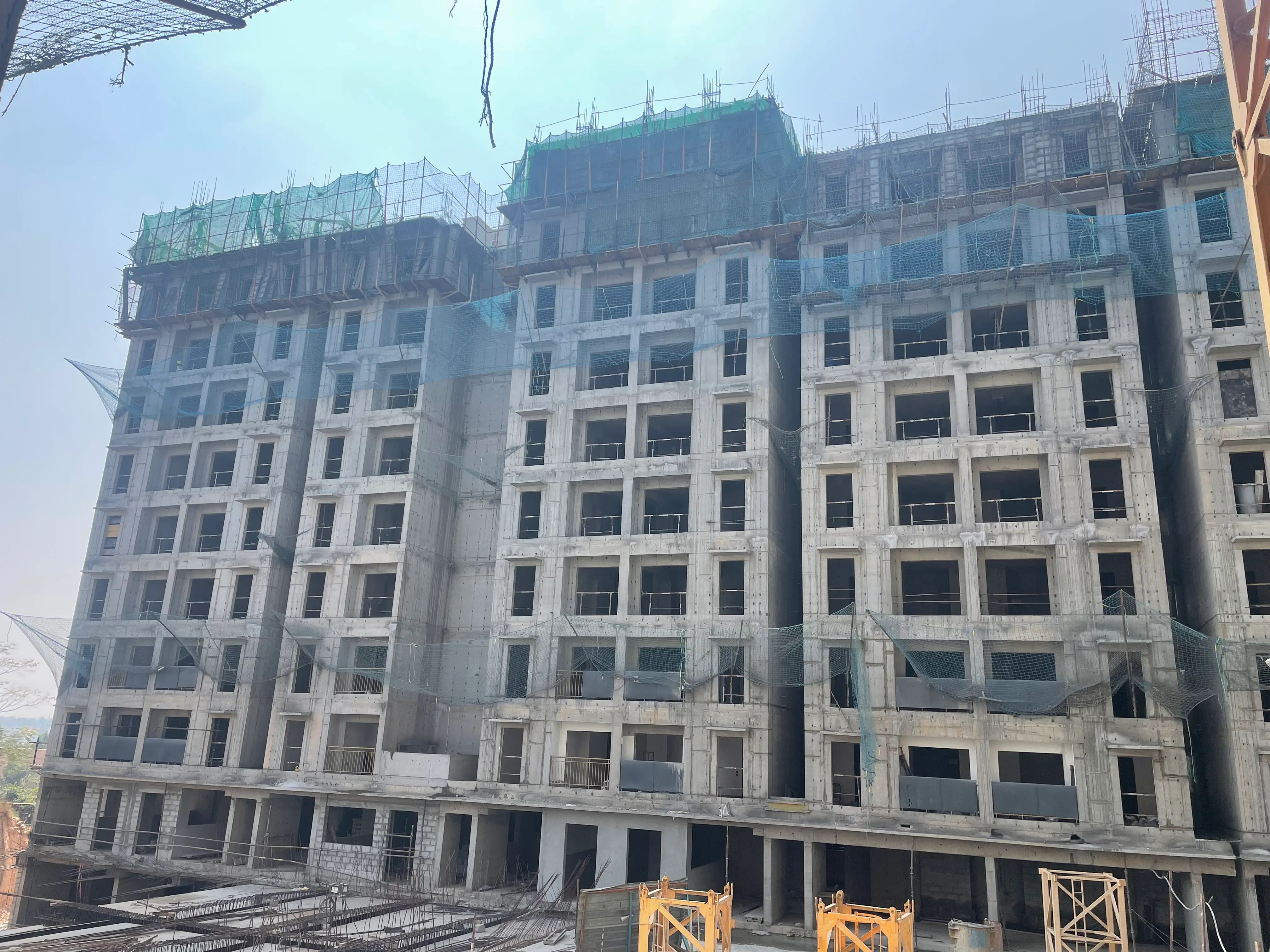

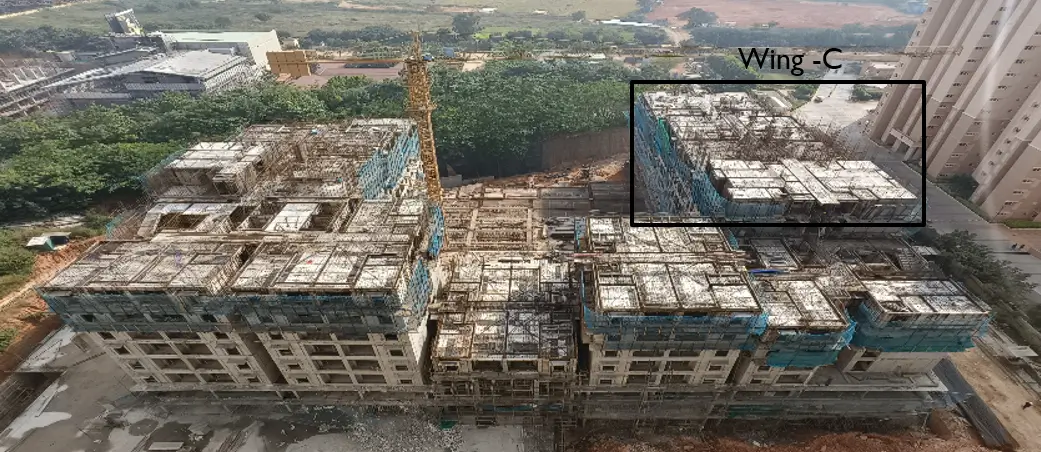

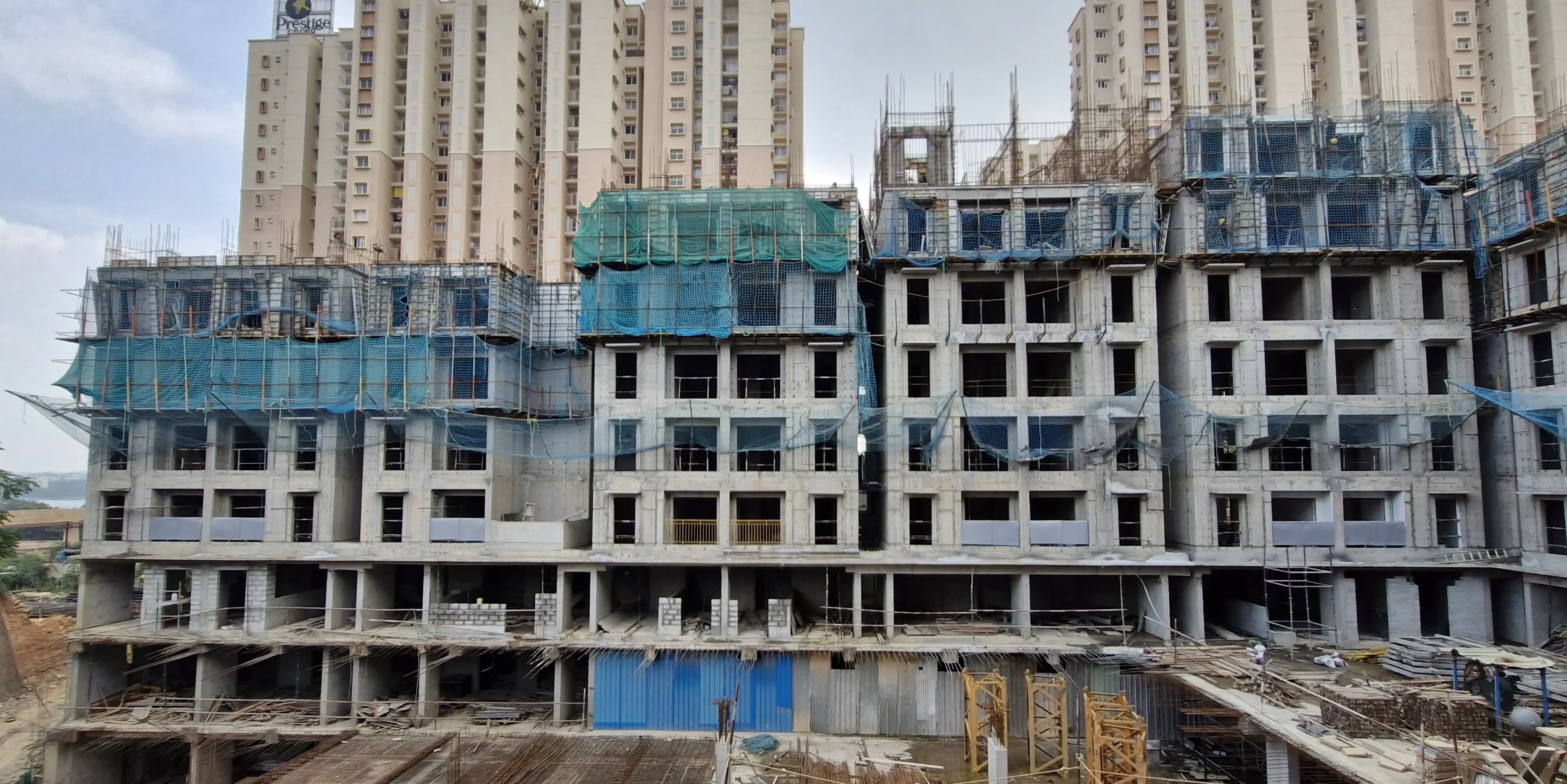

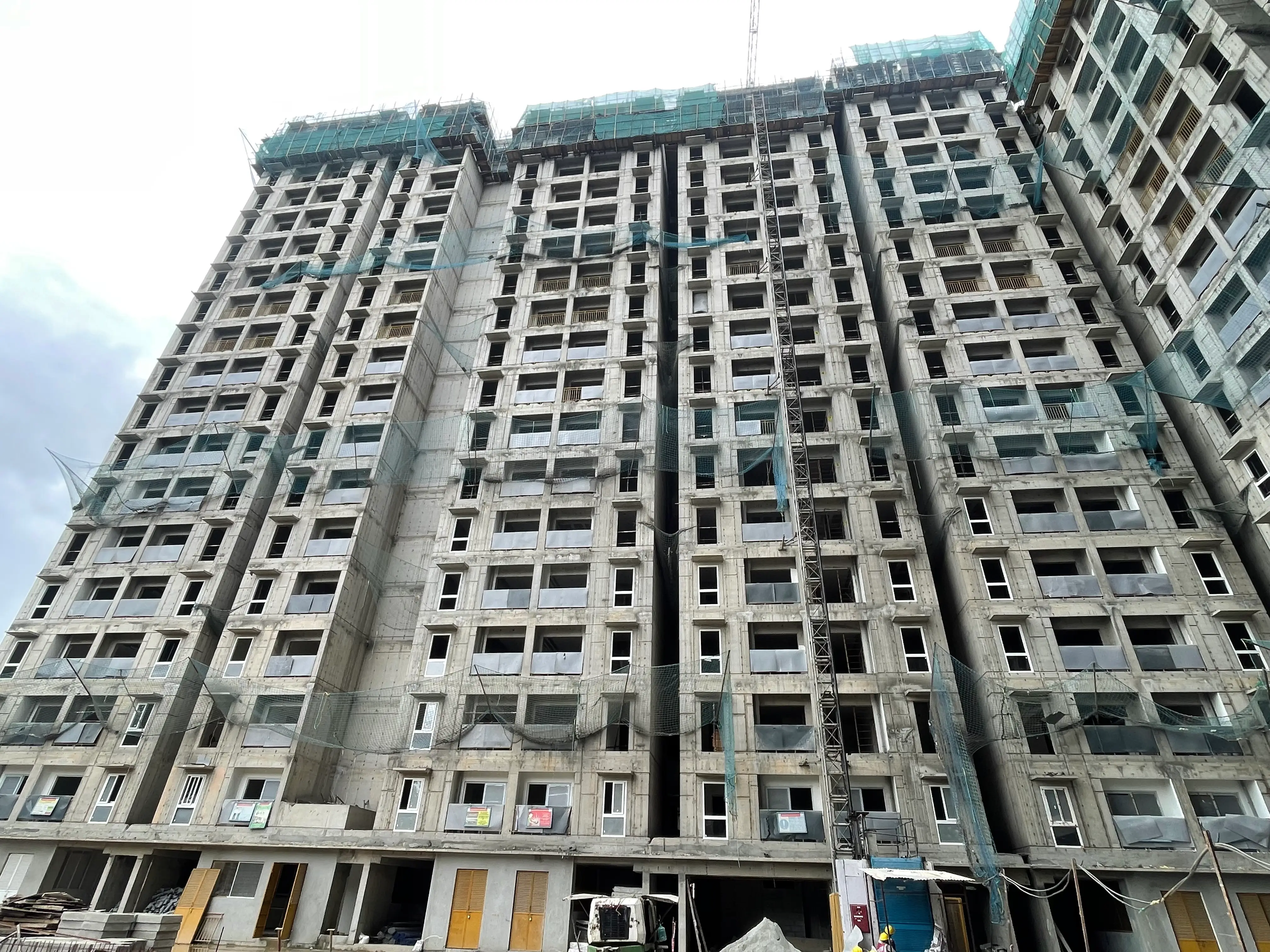

Wing C – Milestone Release –“ On Commencement Installation of Lift” – Status as on 12th - Jun 2025

Wing C – Milestone Release –“ On Commencement Installation of Lift” – Status as on 12th - Jun 2025

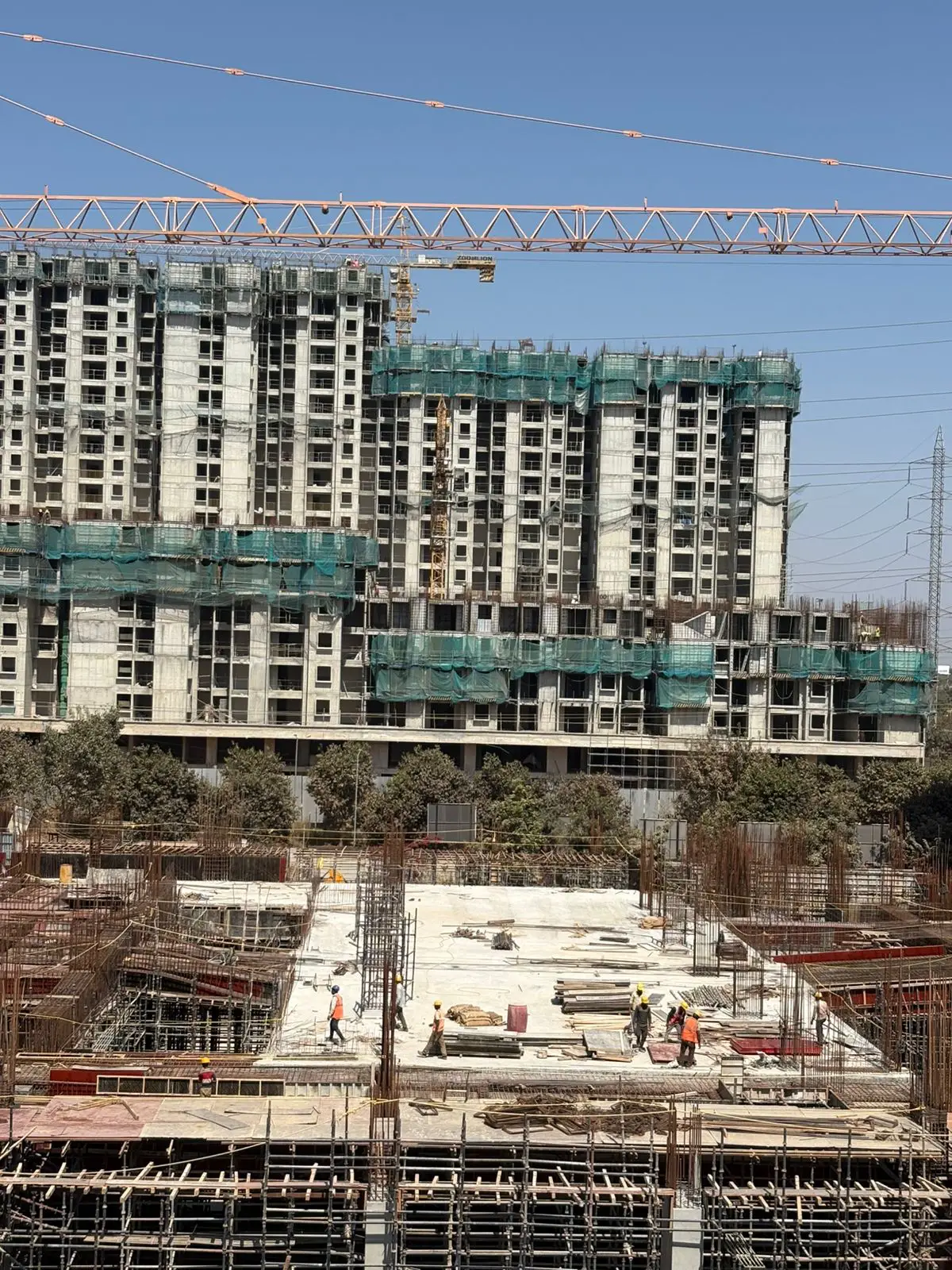

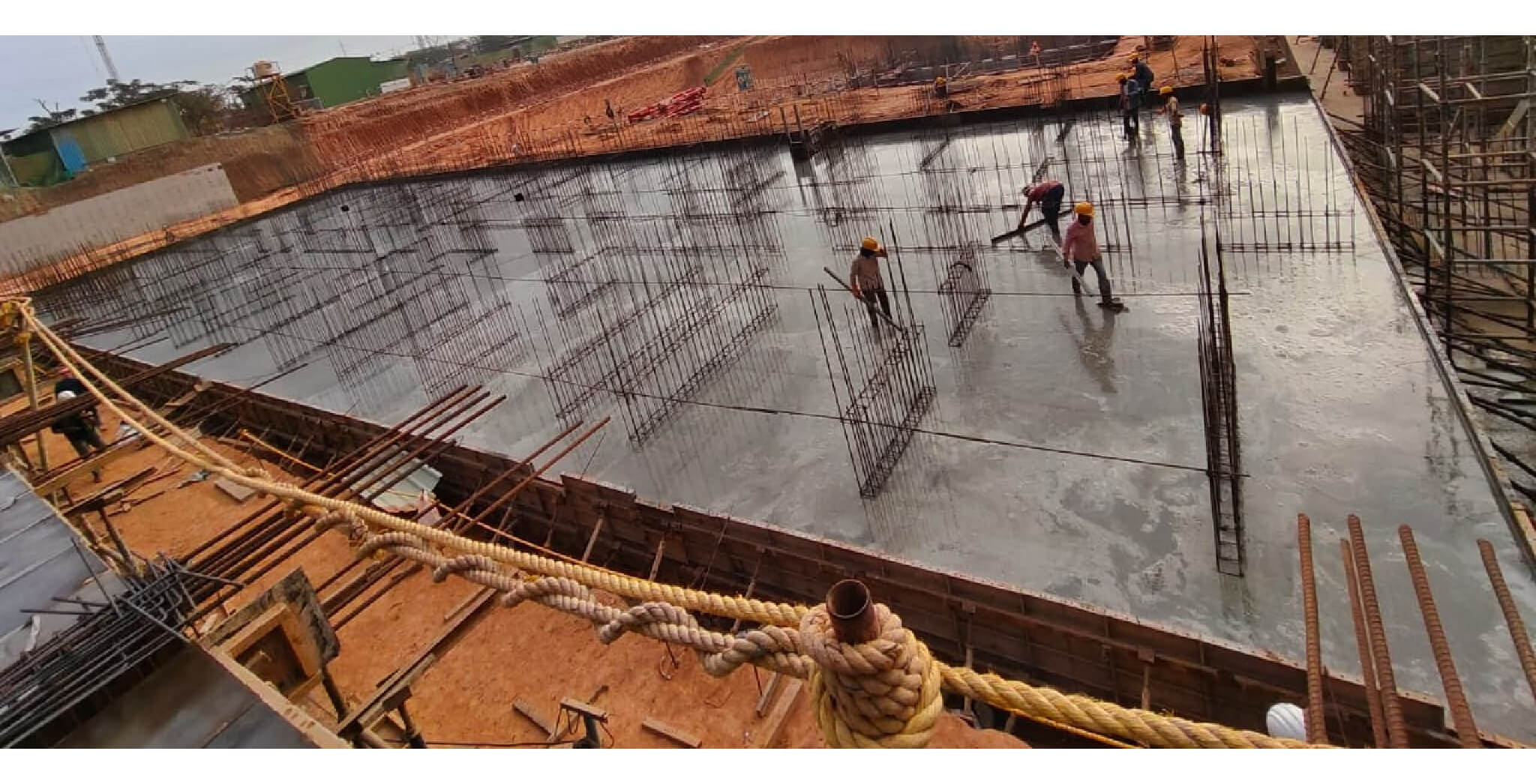

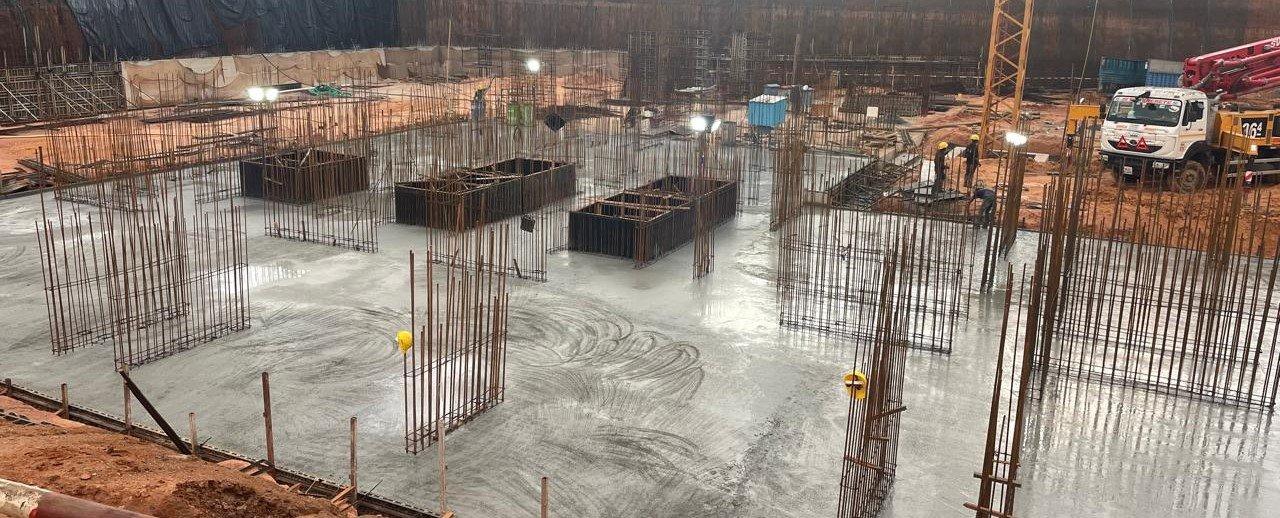

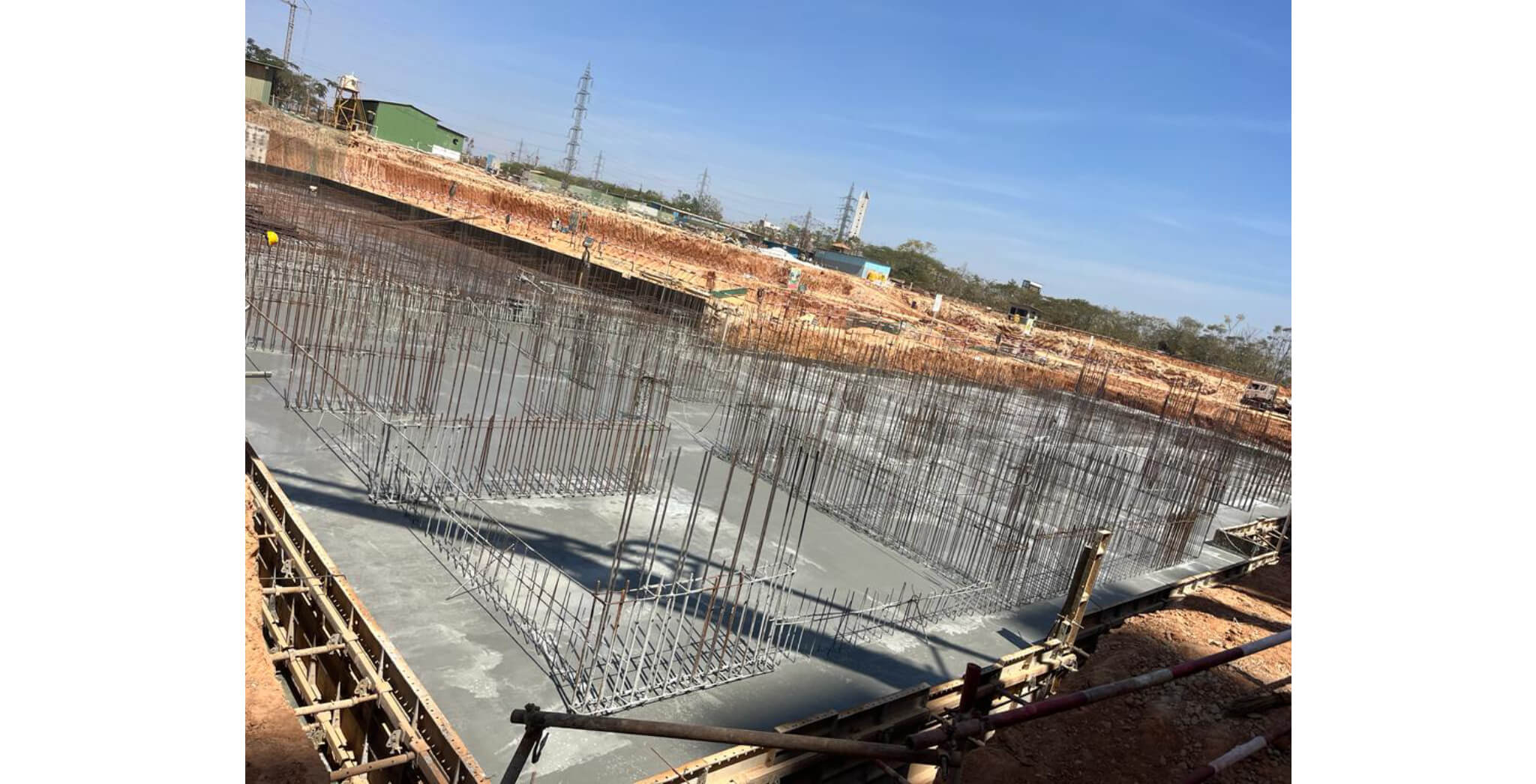

Wing A – Milestone Release –“ On Casting of Footing/raft” – Status as on 09th - Jun 2025

Wing C – Milestone Release “ On casting of Twelfth floor slab” – Status as on 10th - Jun 2025

Wing C – Milestone Release “ On casting of Twelfth floor slab” – Status as on 10th - Jun 2025

Dioro – Wing A – Milestone Release –“ On casting of Twelfth floor slab” – Status as on 02nd - Jun 2025

Dioro – Wing A – Milestone Release –“ On casting of Twelfth floor slab” – Status as on 02nd - Jun 2025

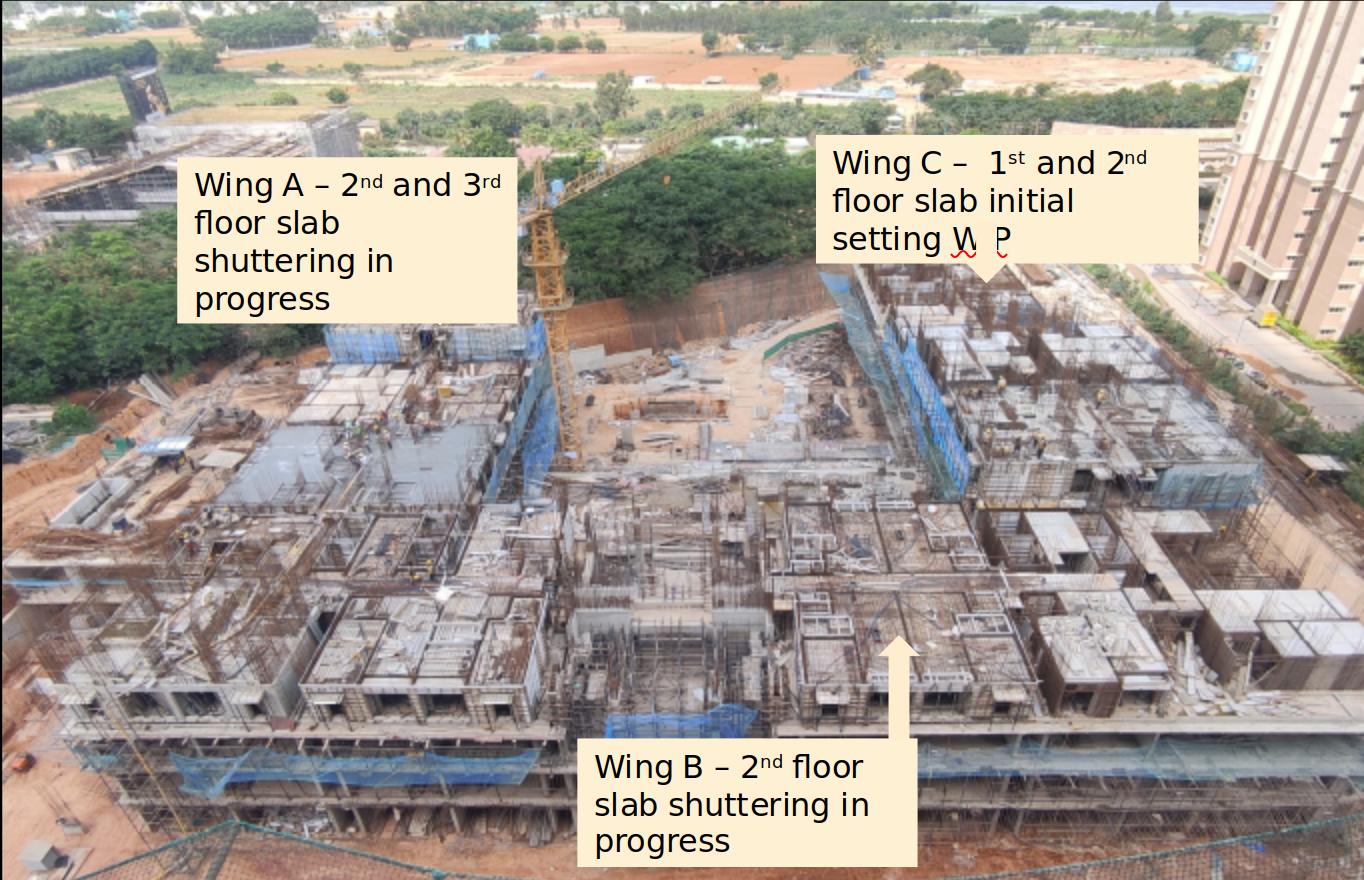

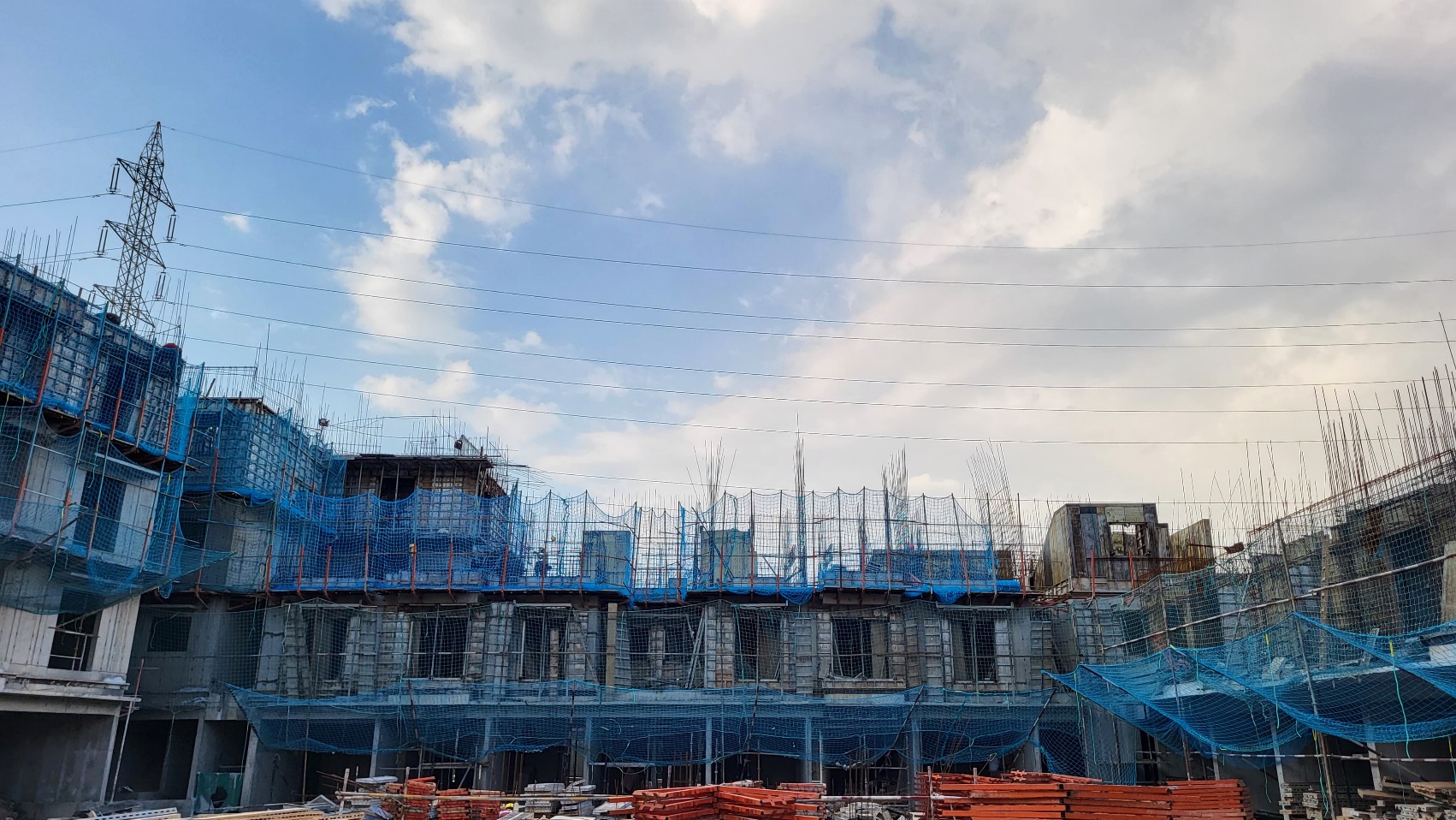

Wing B - Pour 3- 16th floor slab concrete work in progress Pour 4- 15th floor slab concrete work in progress - May 2025

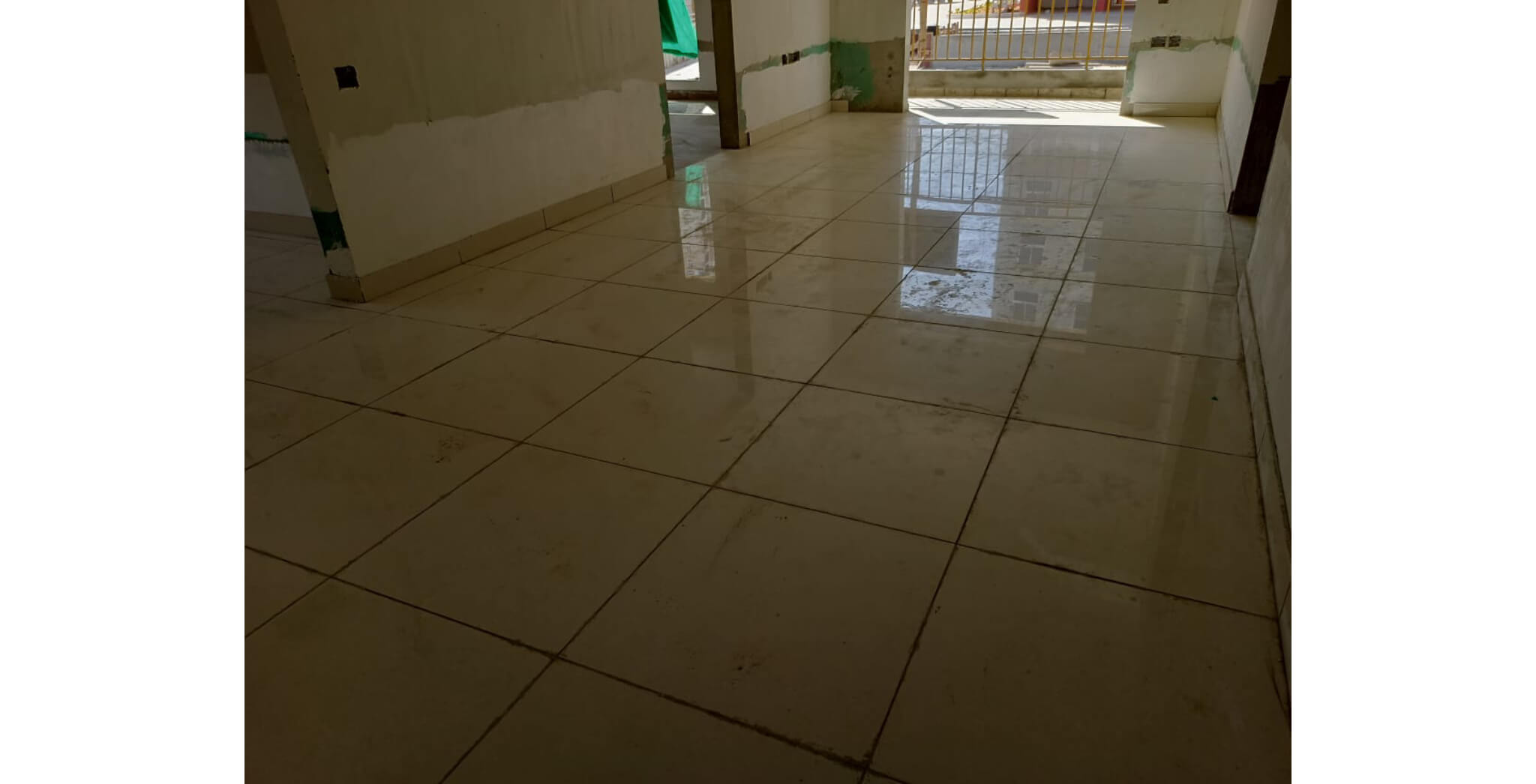

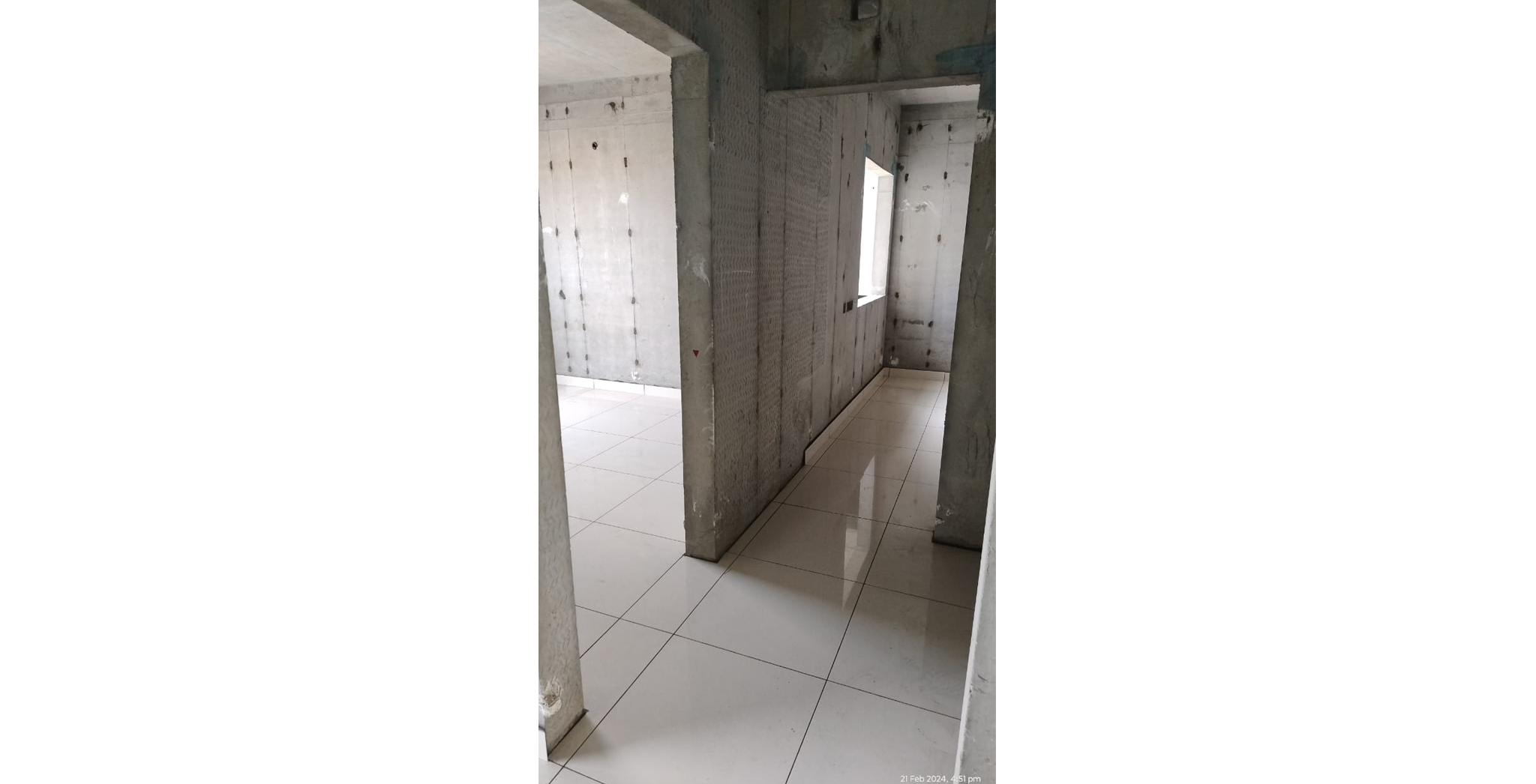

Aurum – Wing A – Milestone Release –“ On Commencement of Flooring-7 to 13Floor” – Status as on 31st - May 2025

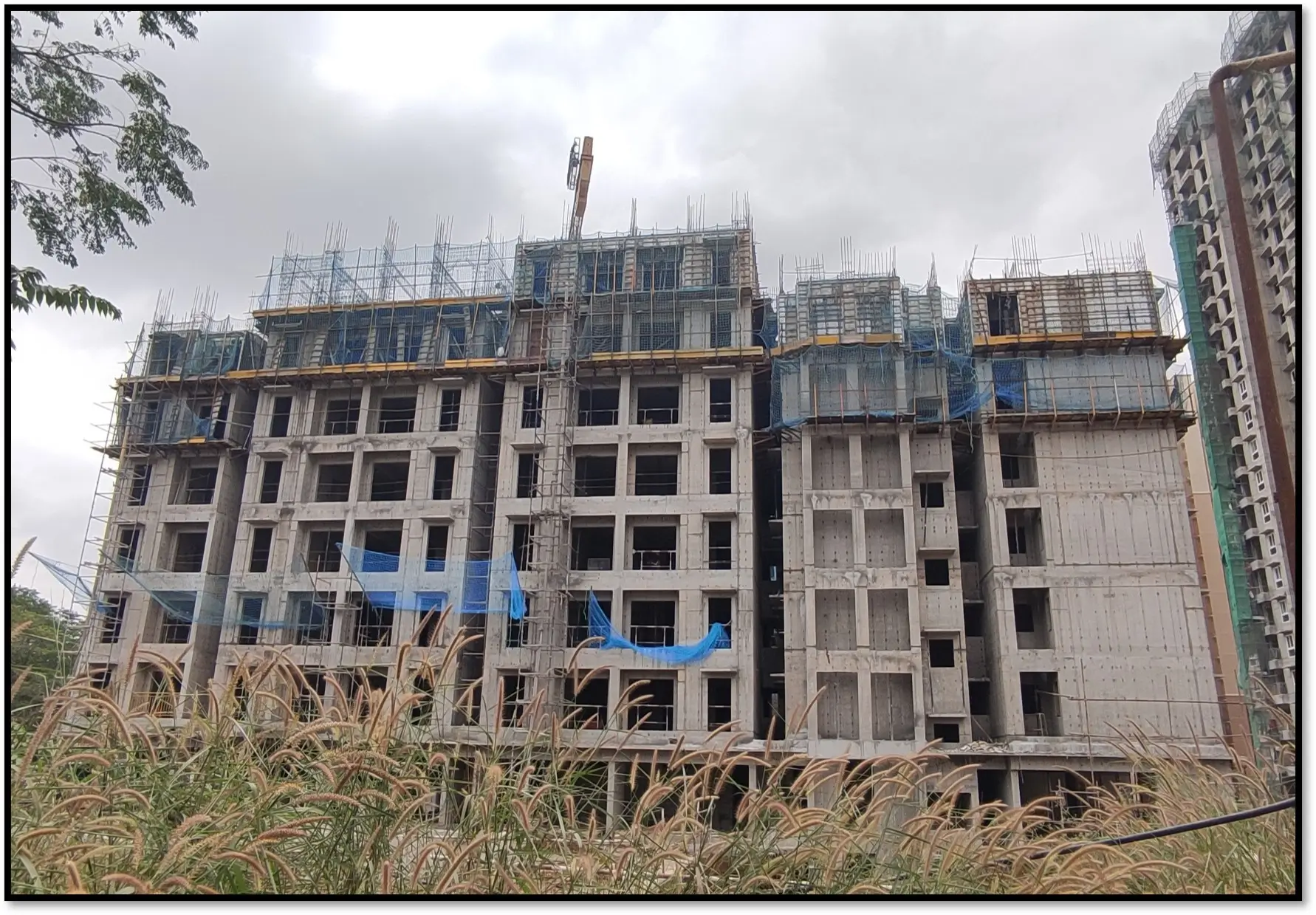

Tiling works – 131/477 Wing A: 7th floor work in progress Wing B: 7th floor work in progress Wing C: 7th floor work in progress - May 2025

Non tower Area –Planter wall concrete work in progress. - May 2025

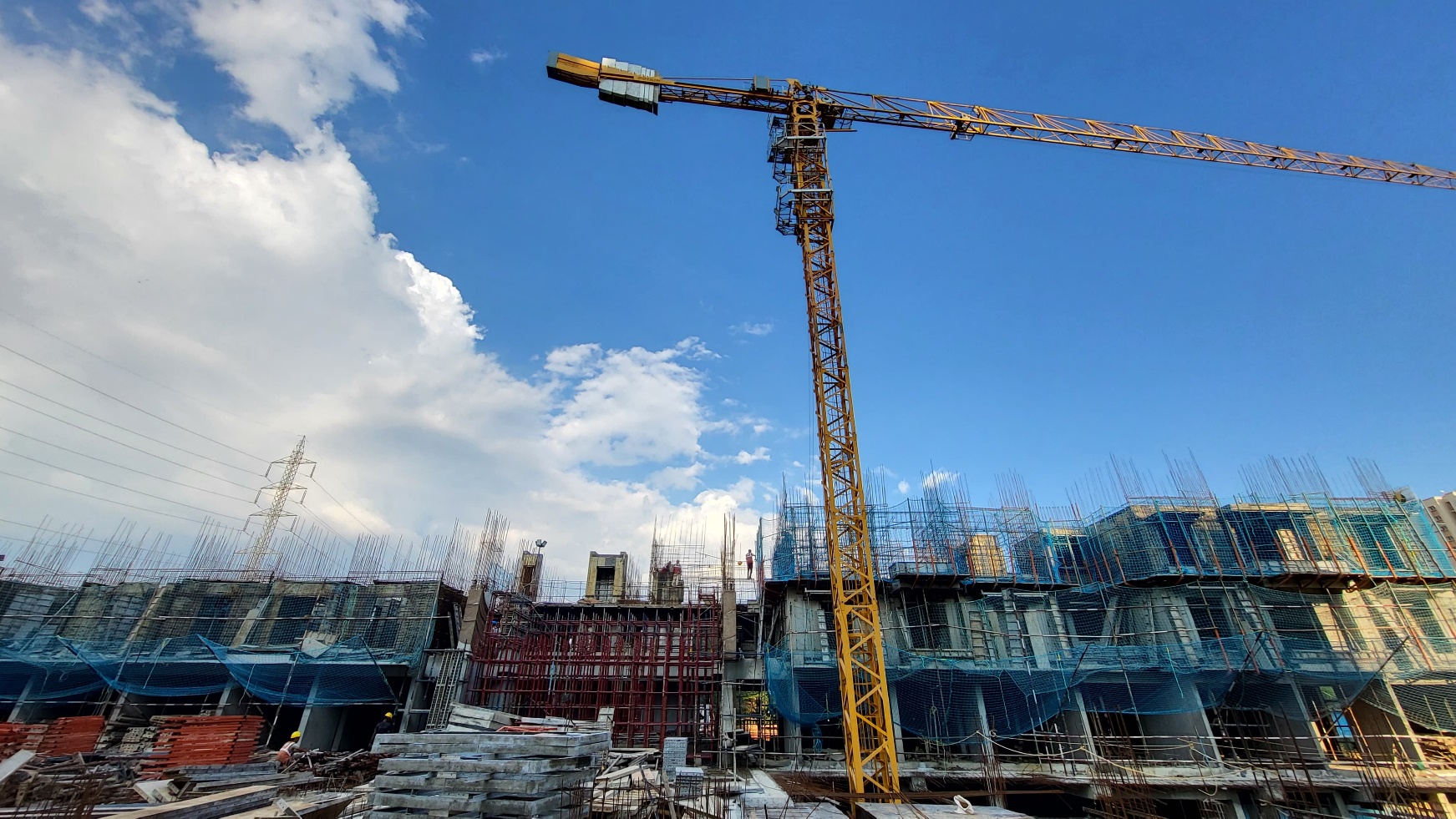

Wing C - Pour 5- 14th floor slab reinforcement work in progress. Pour 6- 18th floor wall shuttering work in progress. - May 2025

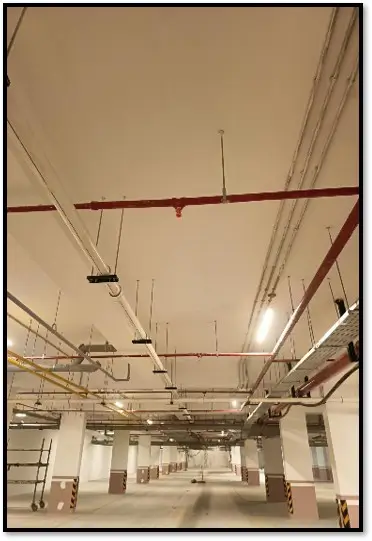

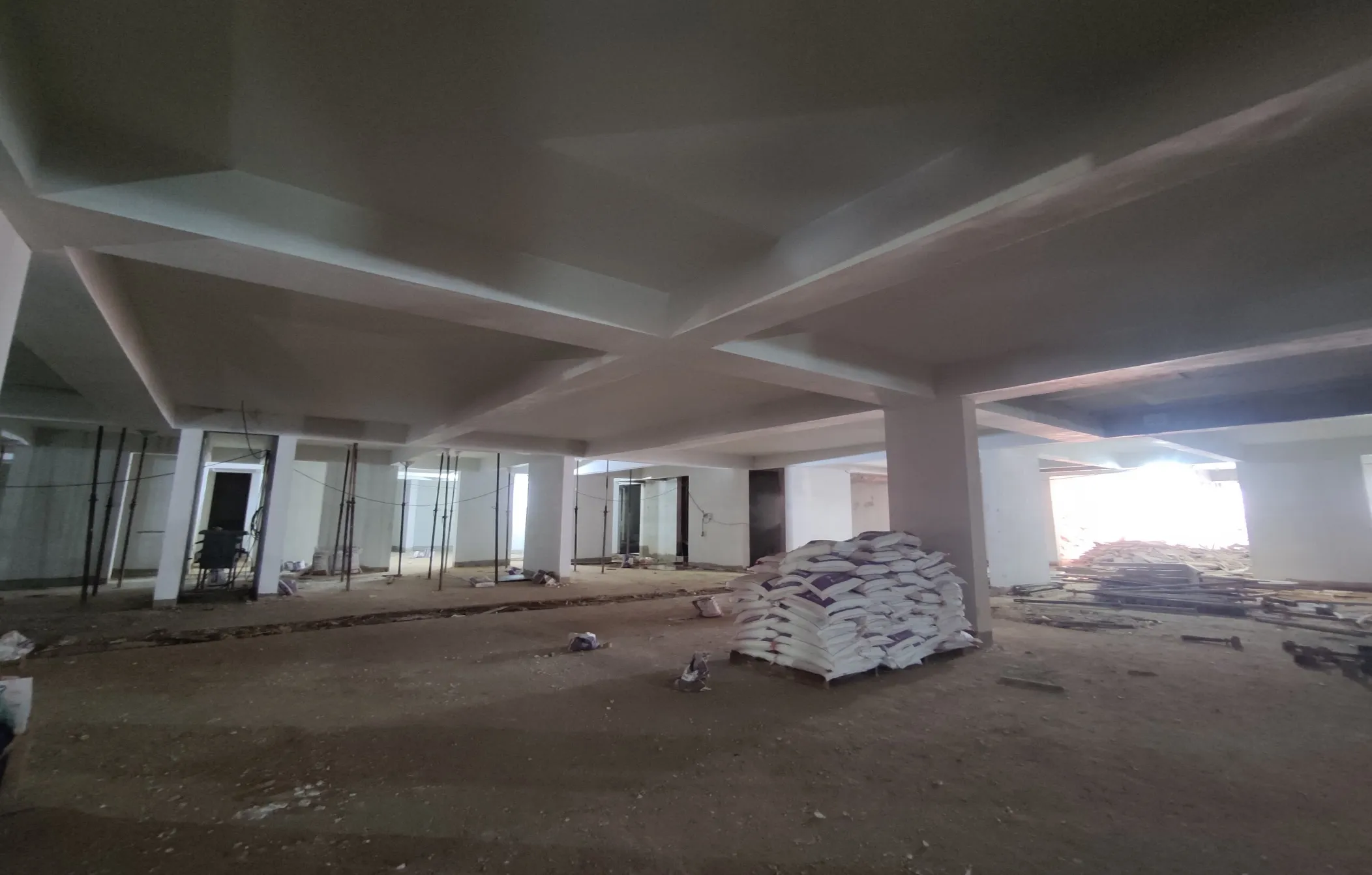

Basement painting and DWG work in progress - May 2025

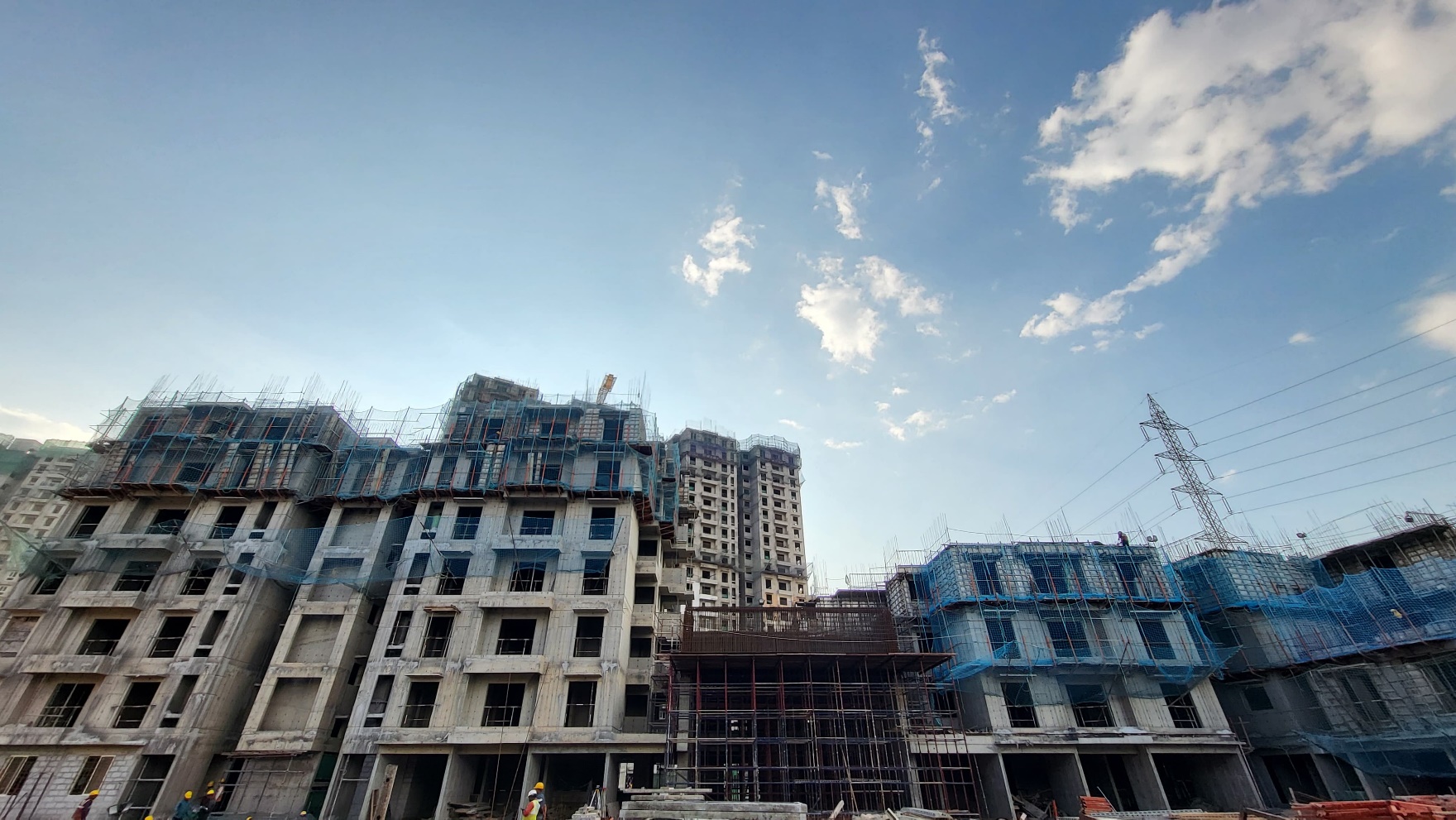

Wing A - Pour 1- 18th floor wall reinforcement work in progress. Pour 2- 16th floor wall shuttering work in progress. - May 2025

Aurum – Wing C – Milestone Release –“ On Commencement of Flooring-7 to 13Floor” – Status as on 31st - May 2025

Aurum – Wing A – Milestone Release –“ On Casting of Sixteenth Floor Slab” – Status as on 31st - May 2025

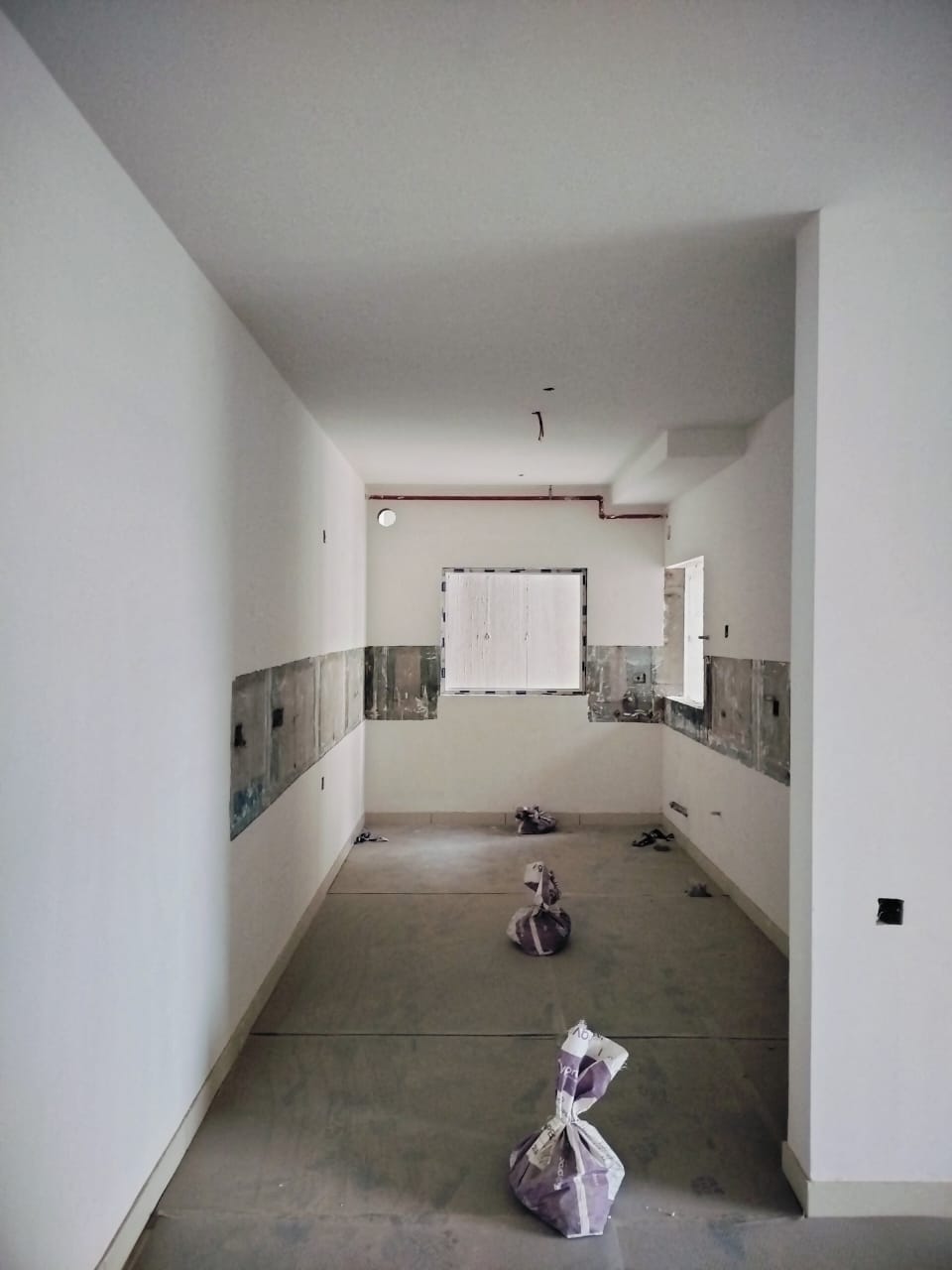

Aurum – Wing B – Milestone Release –“ On Commencement of Flooring-7 to 13Floor” – Status as on 31st - May 2025

Basement painting and DWG work in progress - May 2025

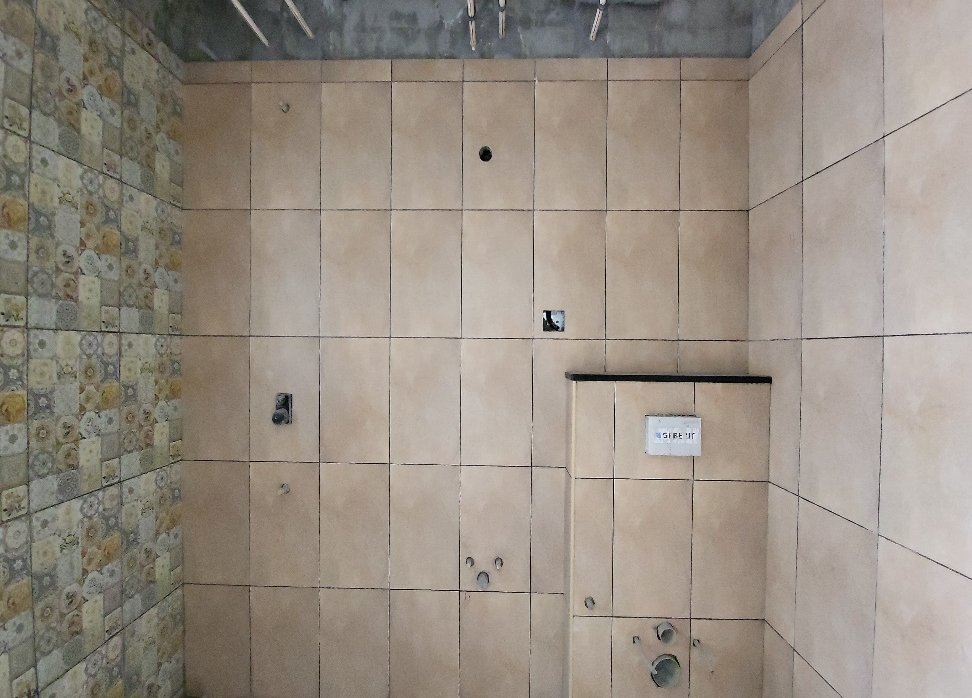

Painting works – 156/477 (upto putty) Wing A: 8th floor work in progress Wing B: 7th floor work in progress Wing C: 7th floor work in progress - May 2025

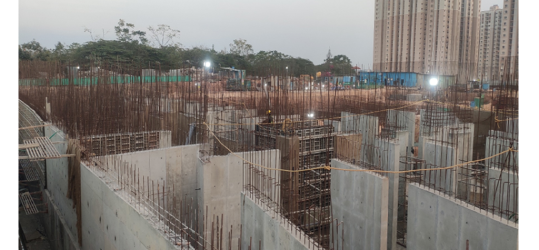

Tiling works – 131/477 Wing A: 7th floor work in progress Wing B: 7th floor work in progress Wing C: 7th floor work in progress - May 2025

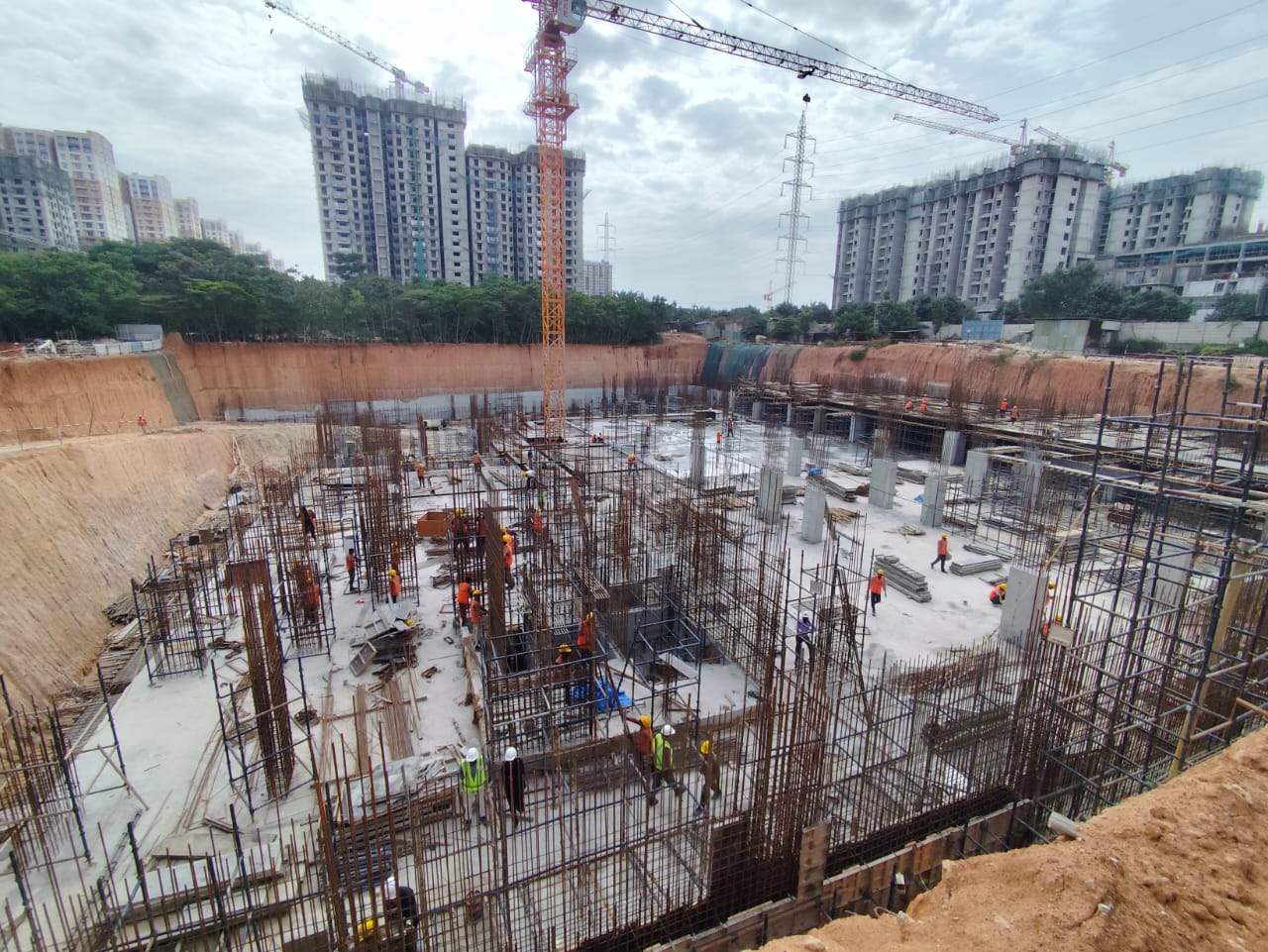

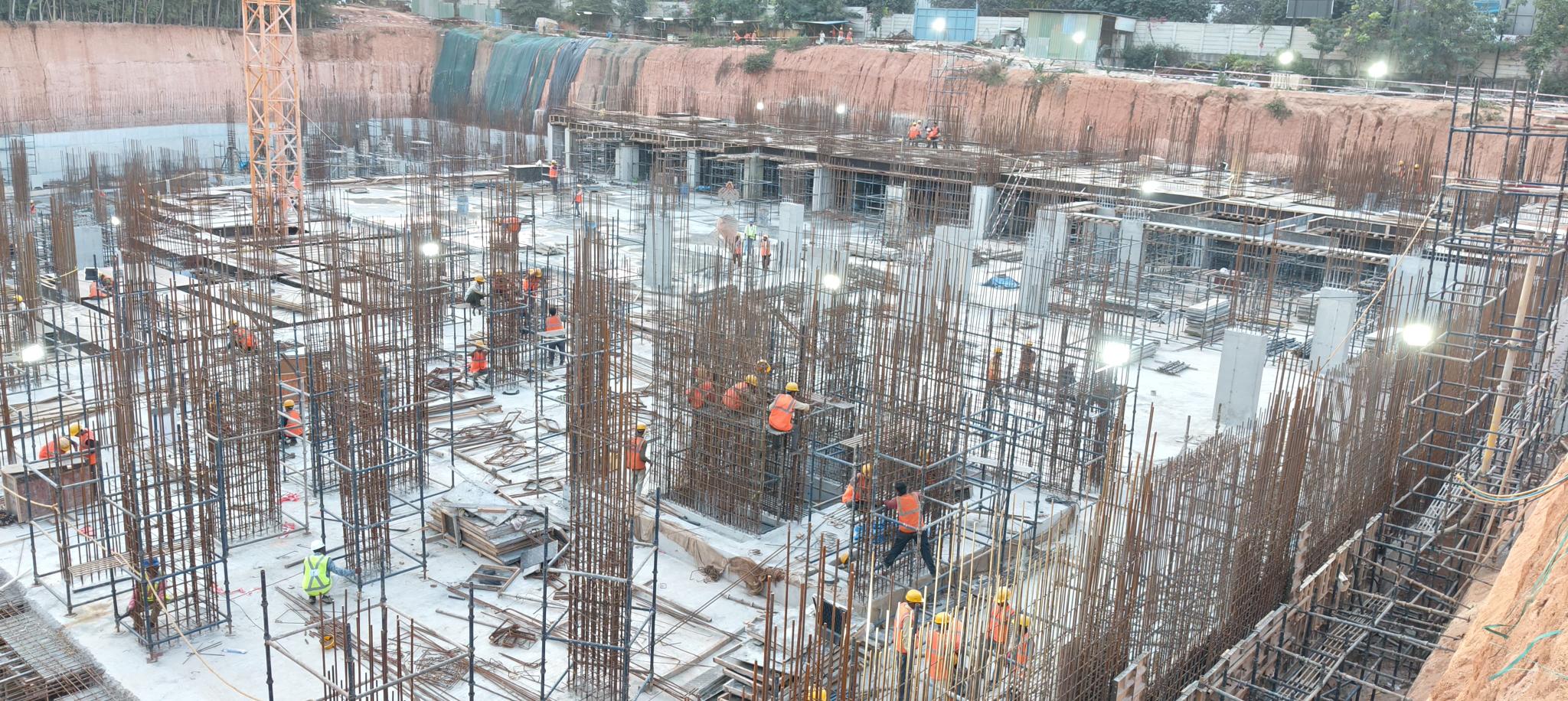

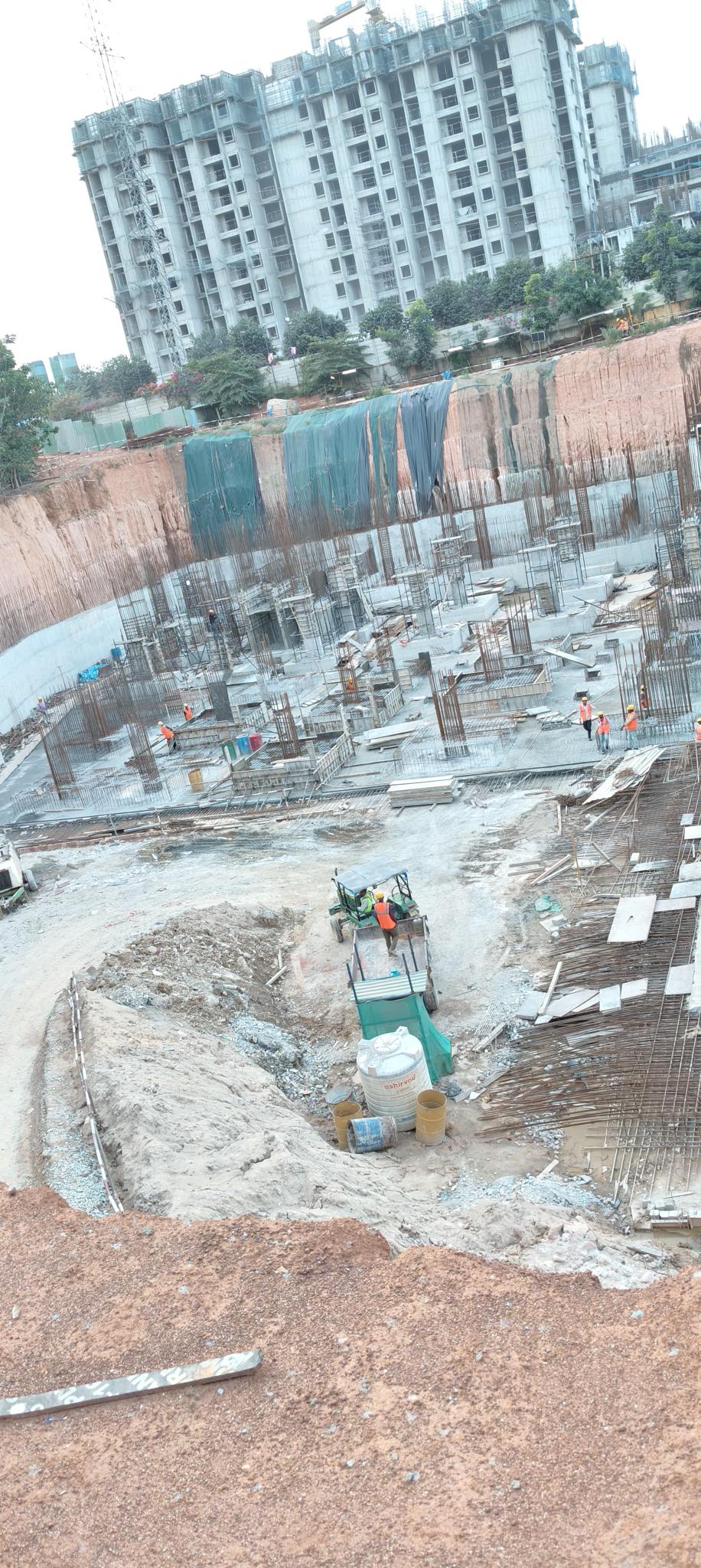

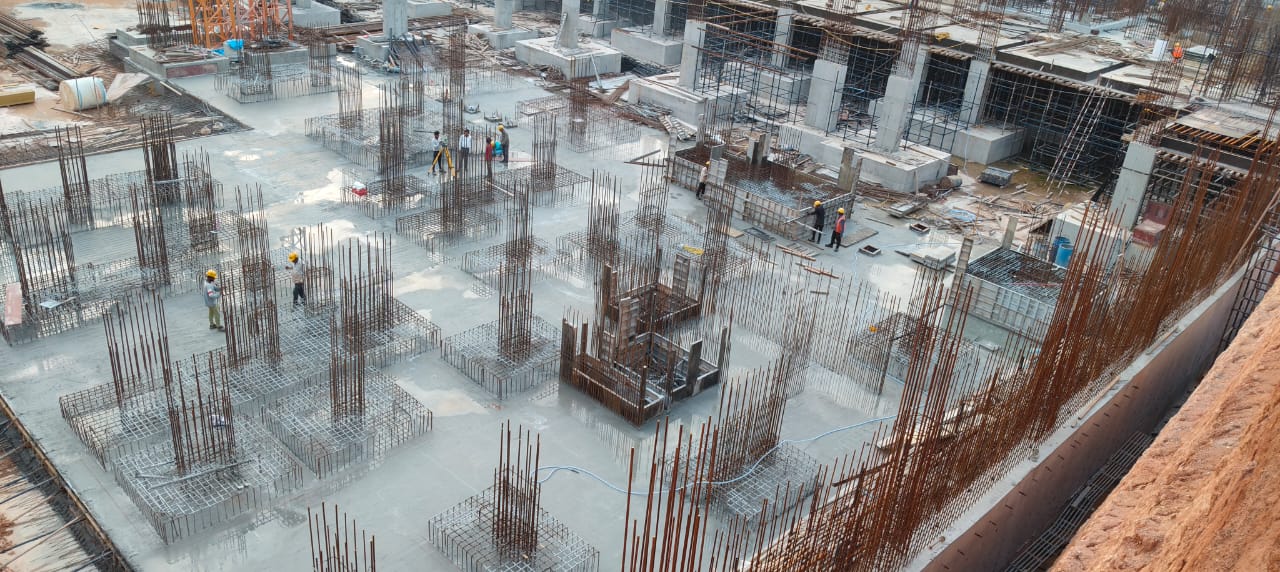

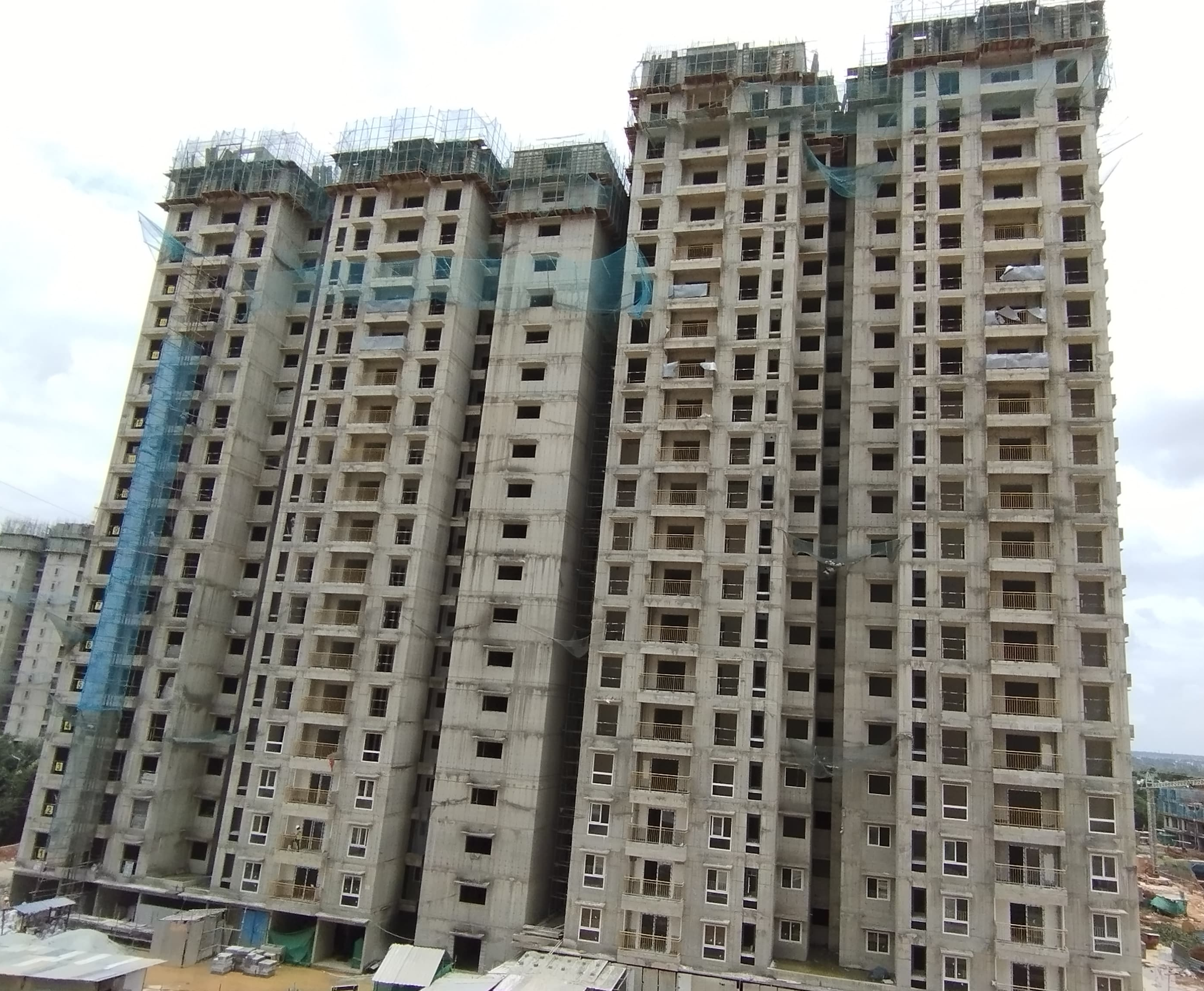

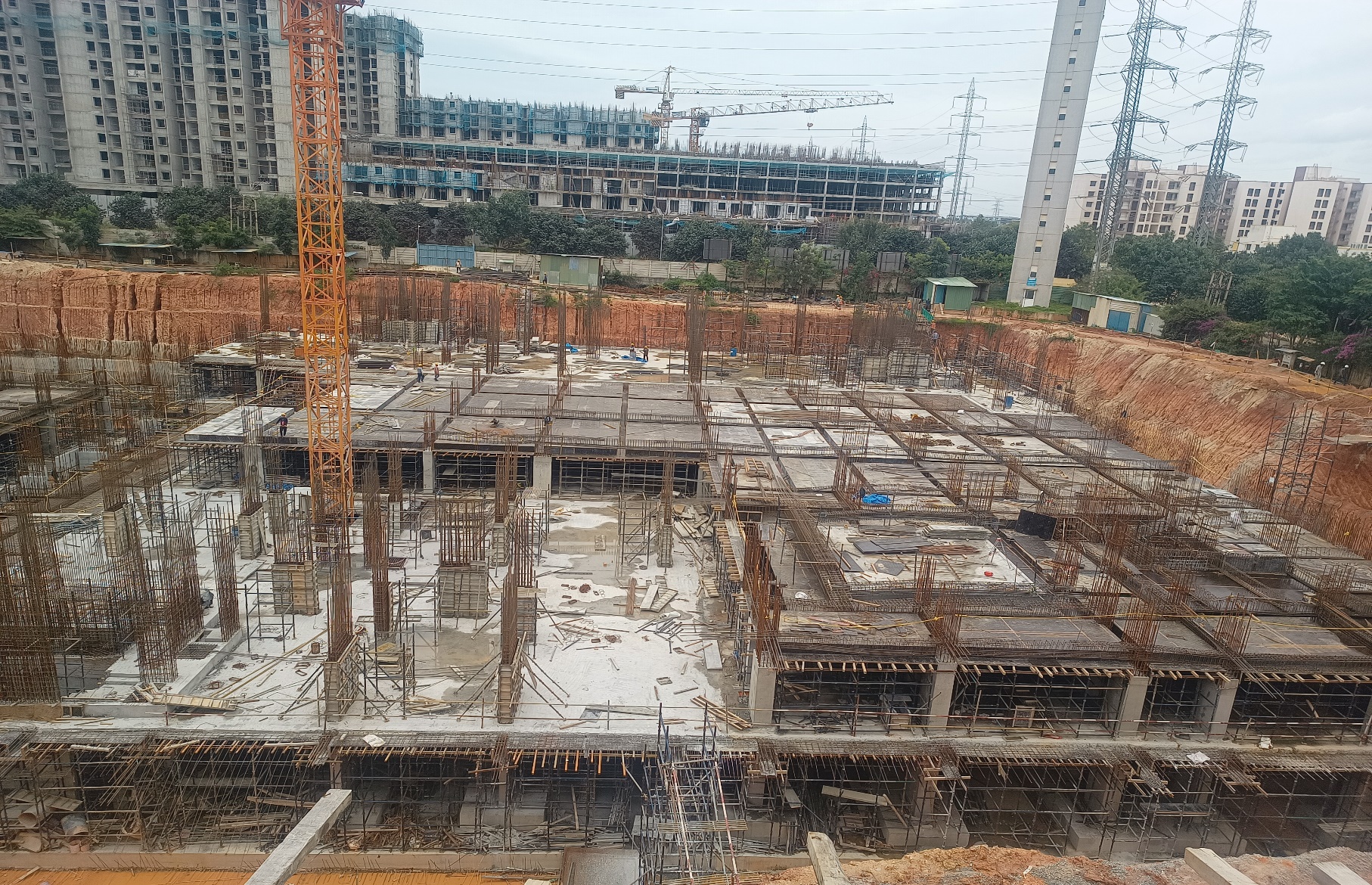

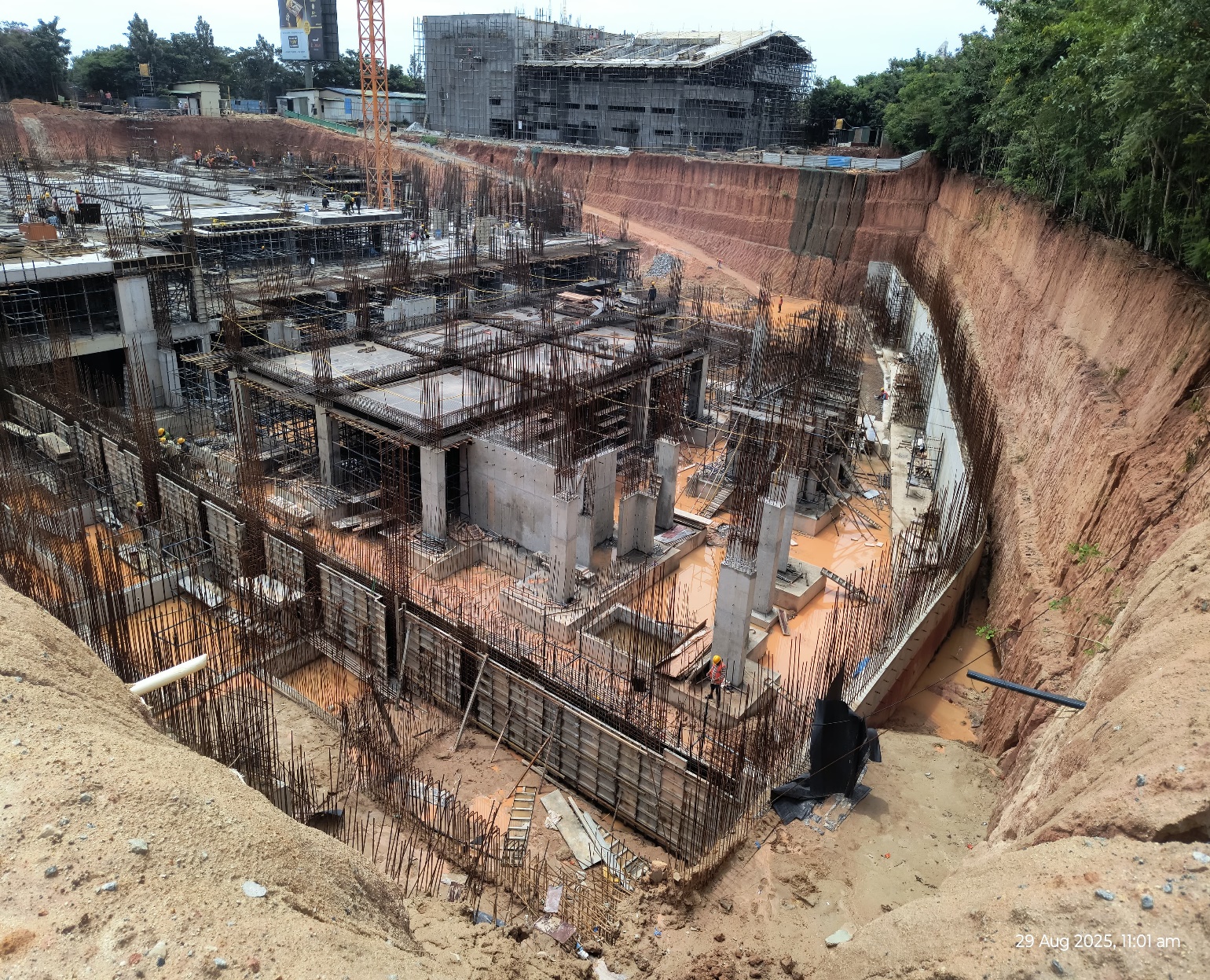

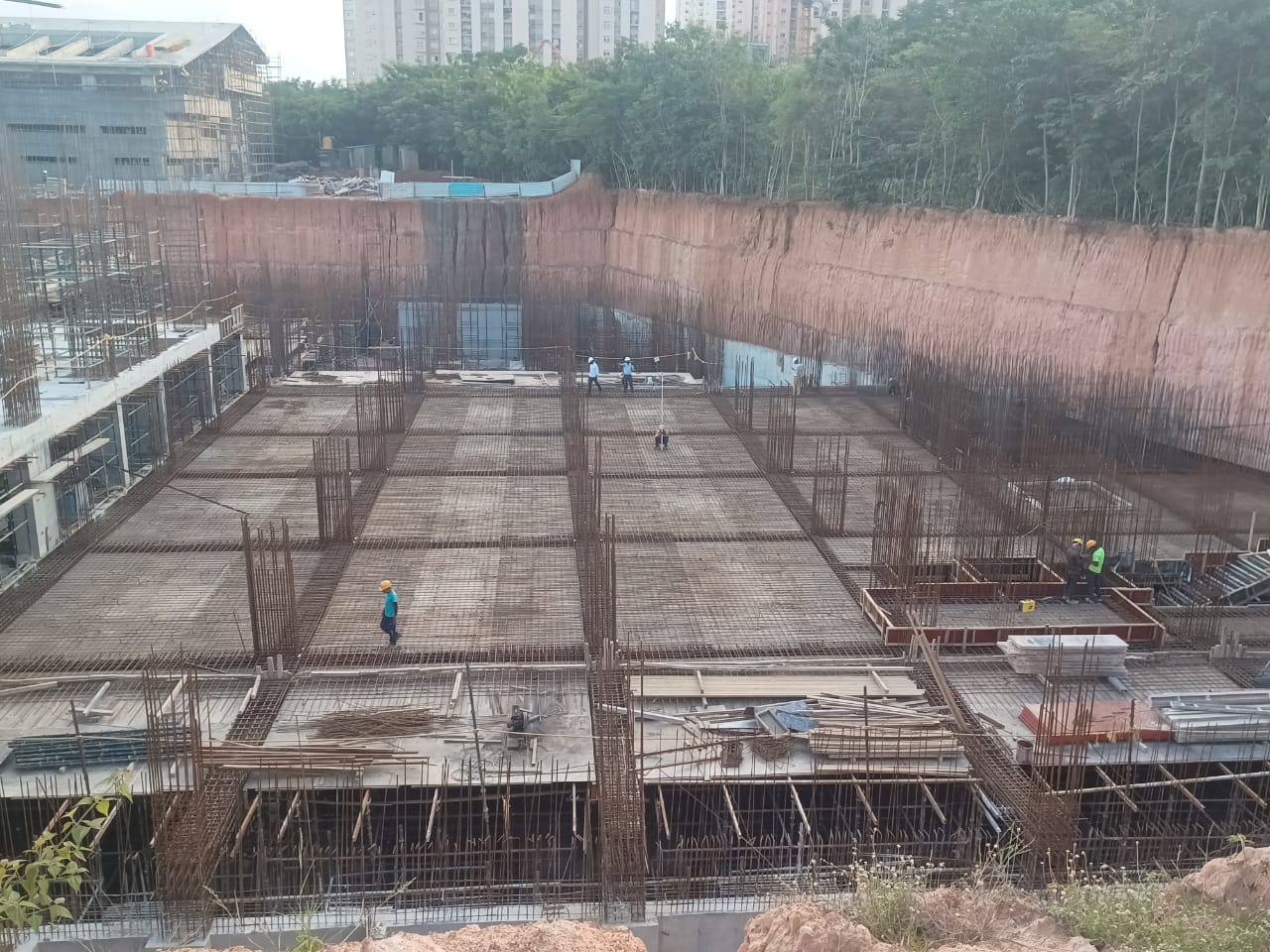

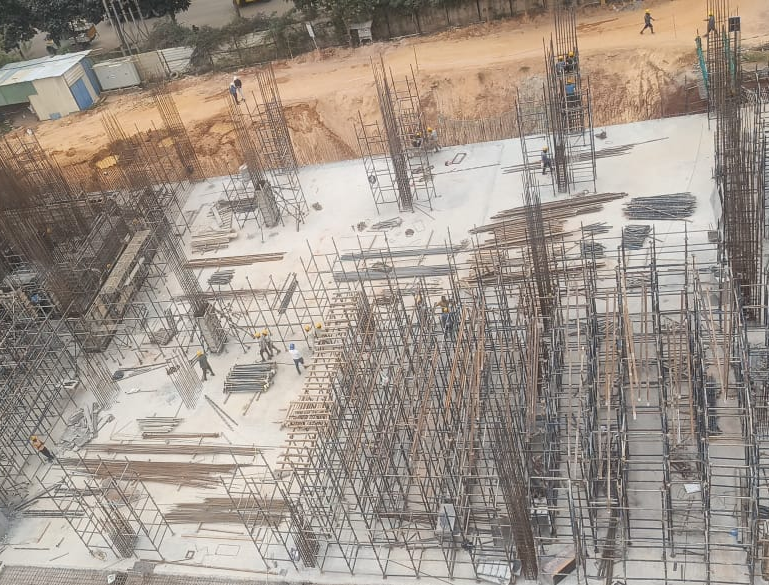

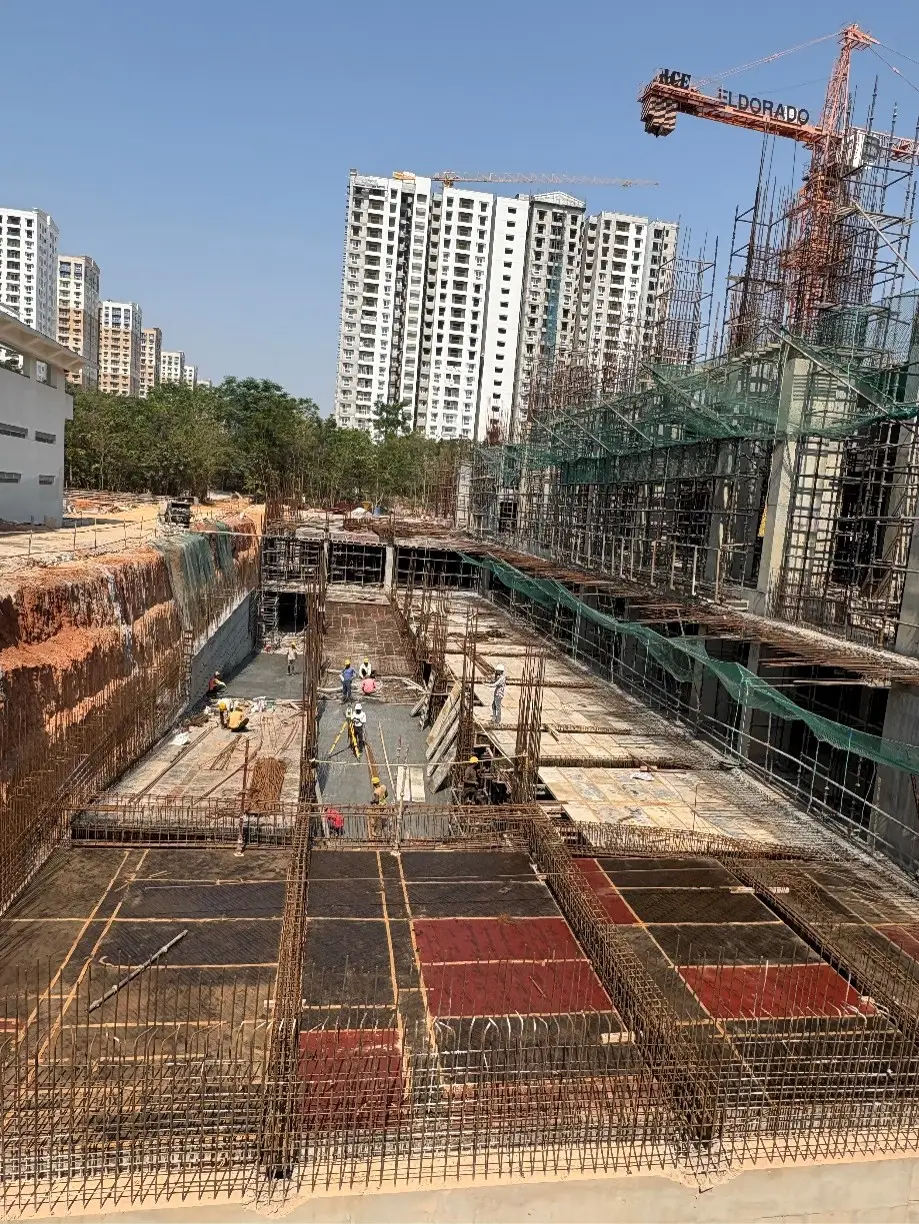

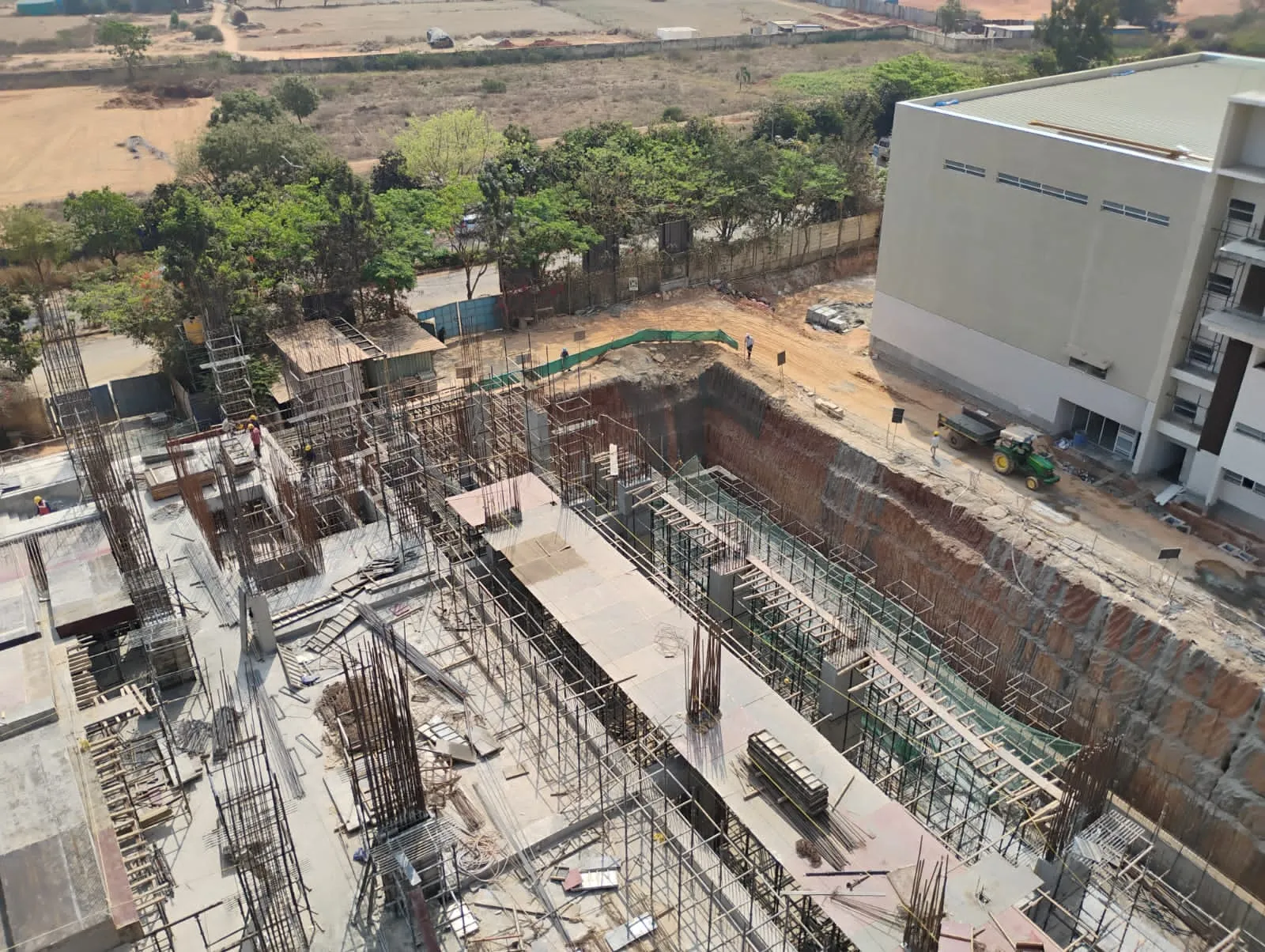

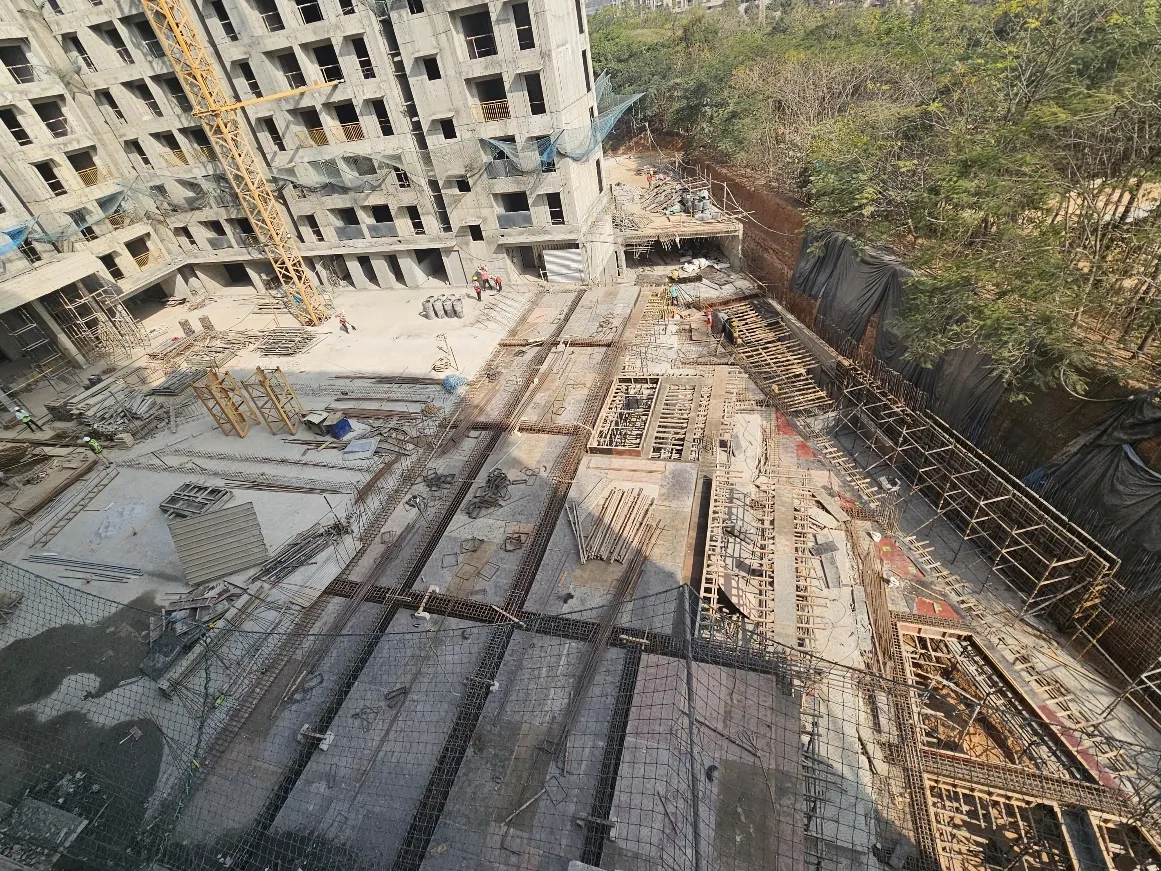

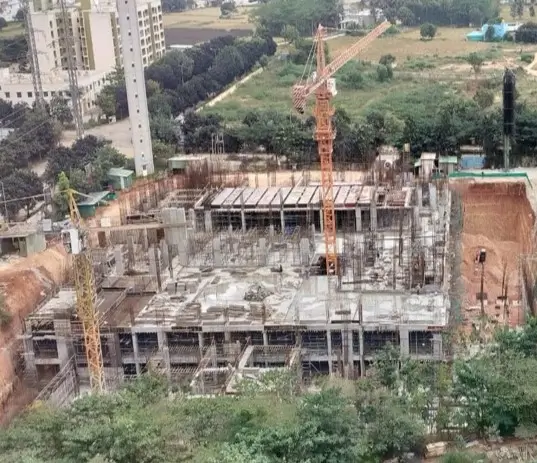

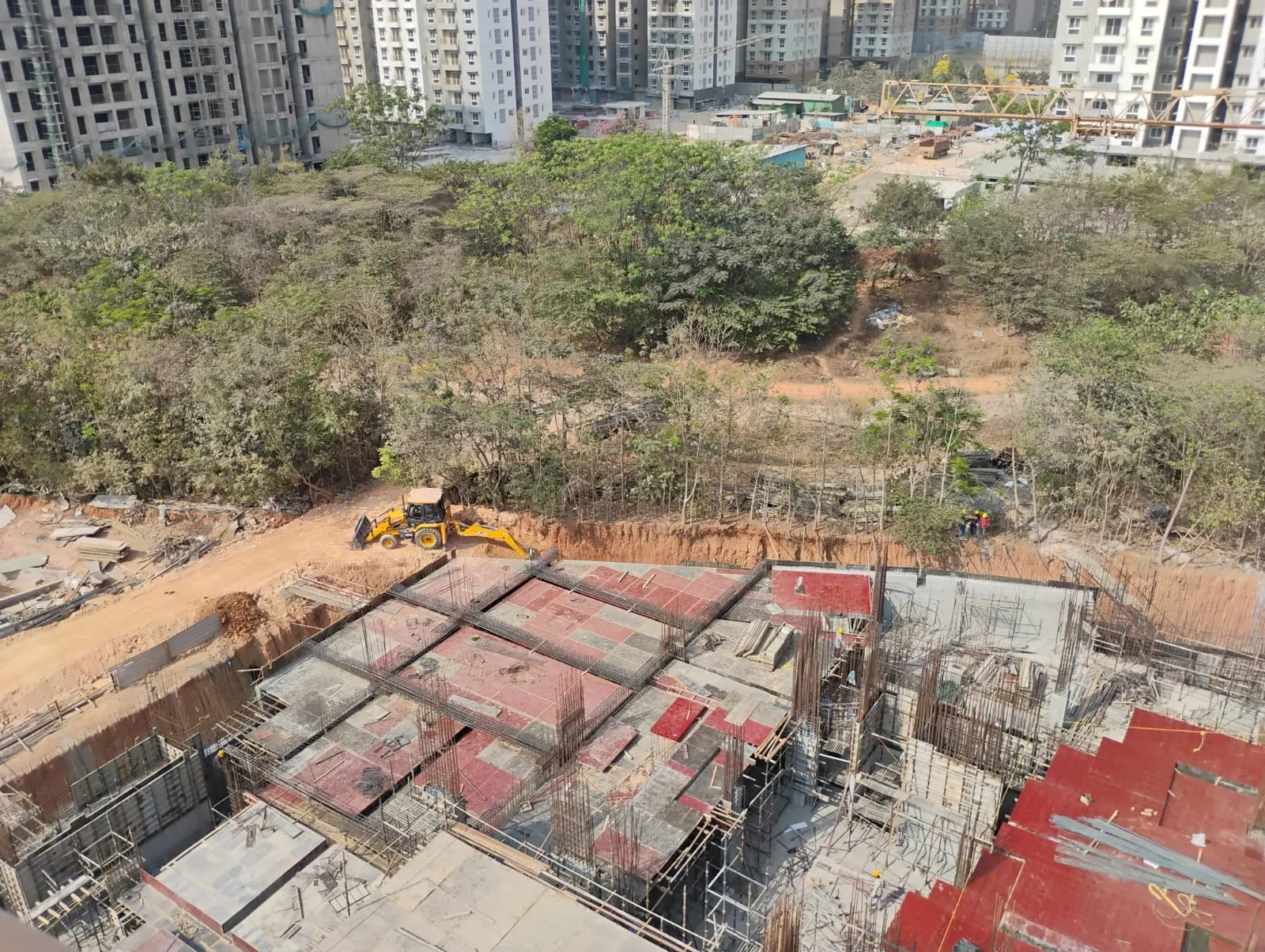

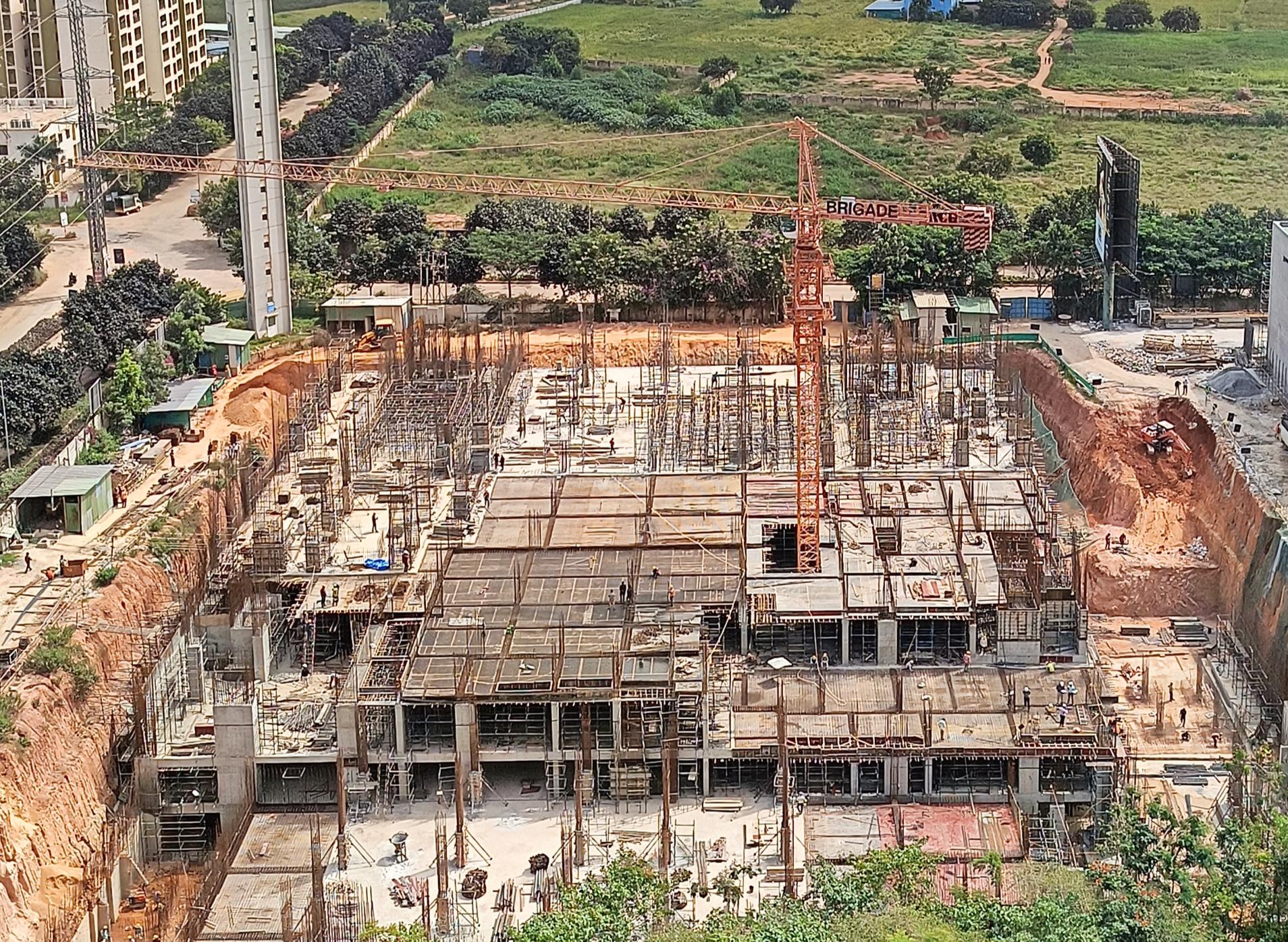

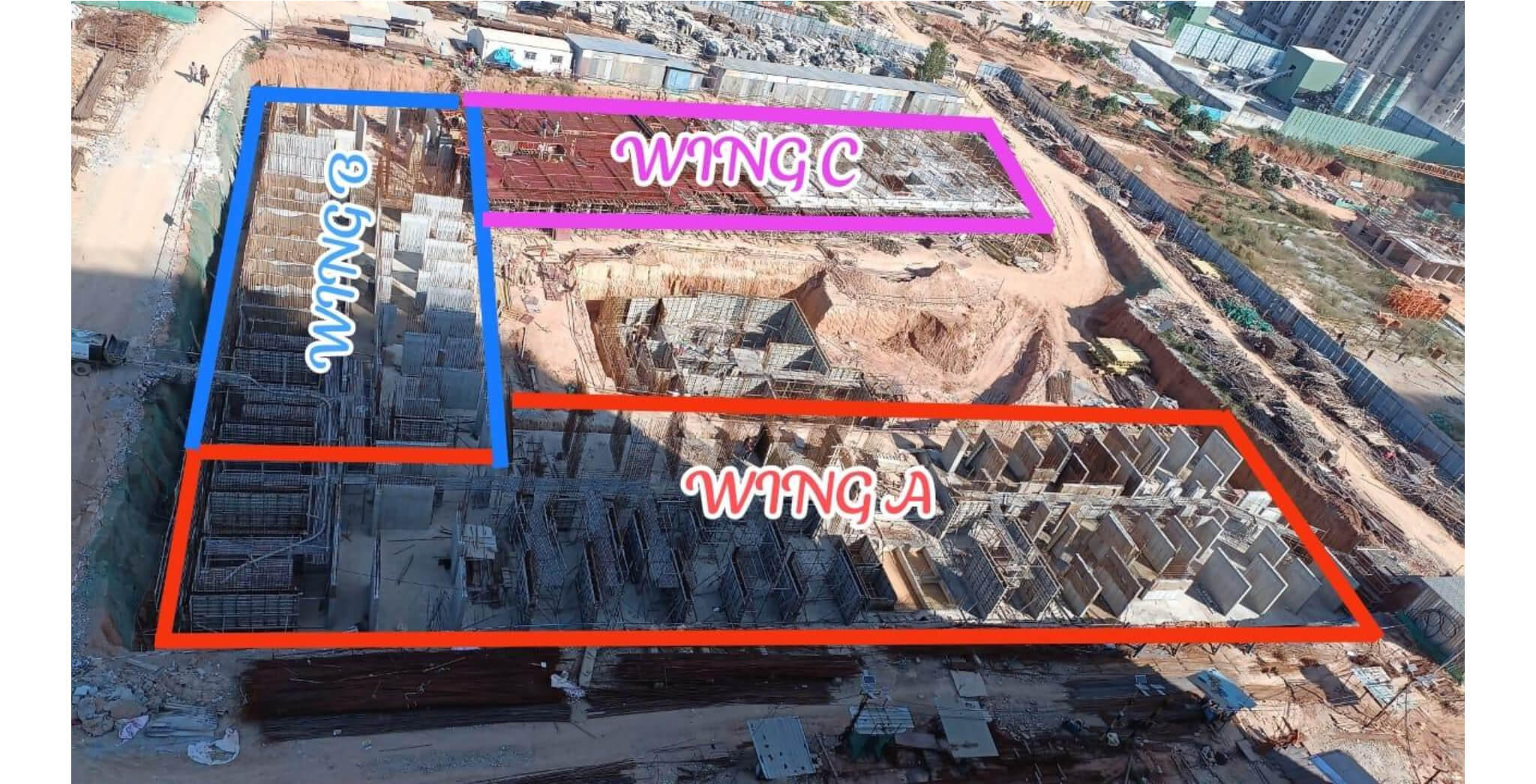

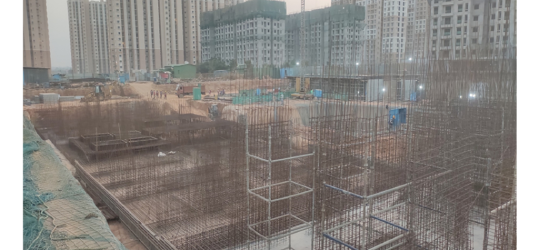

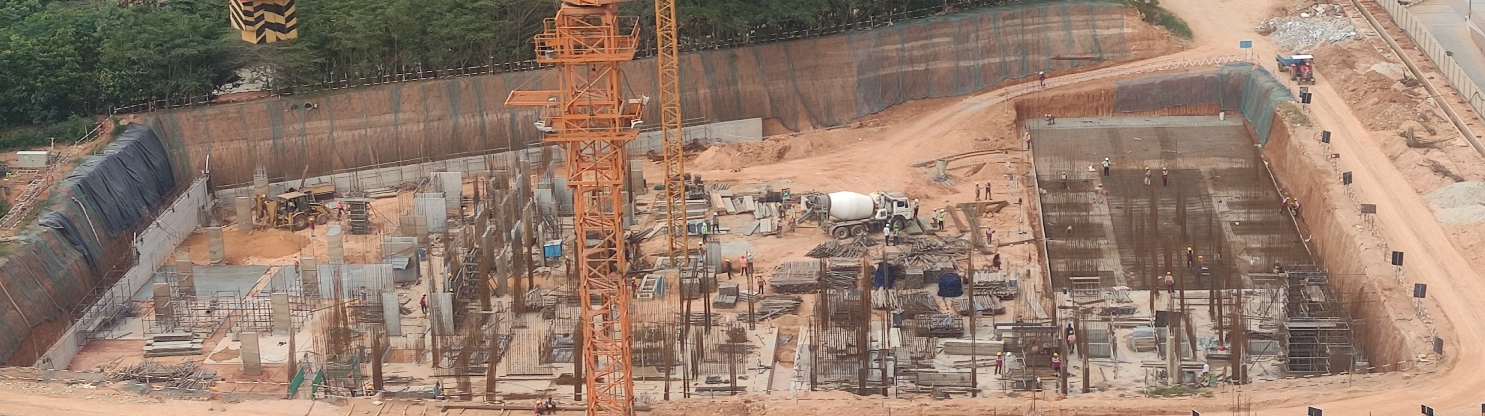

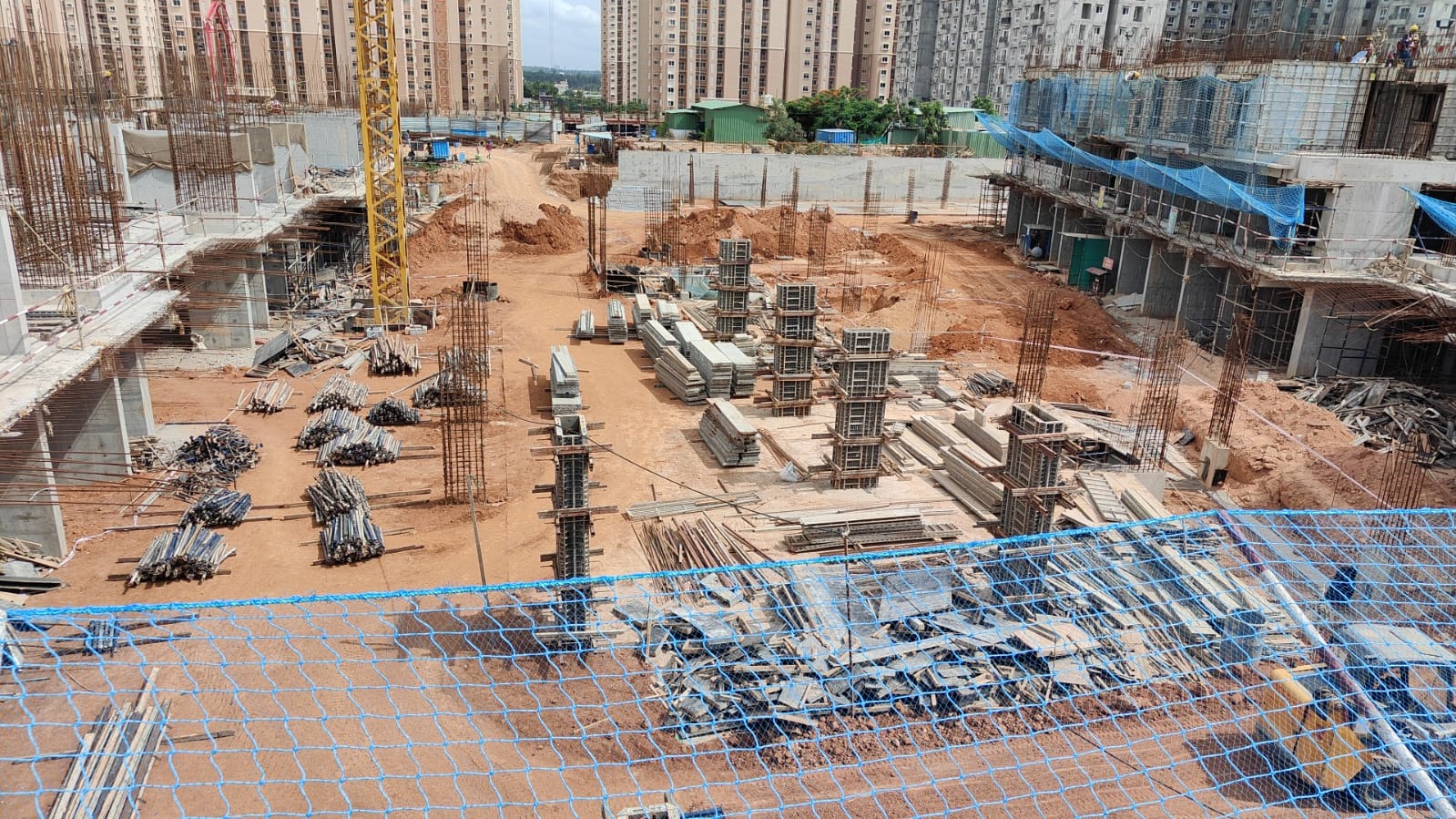

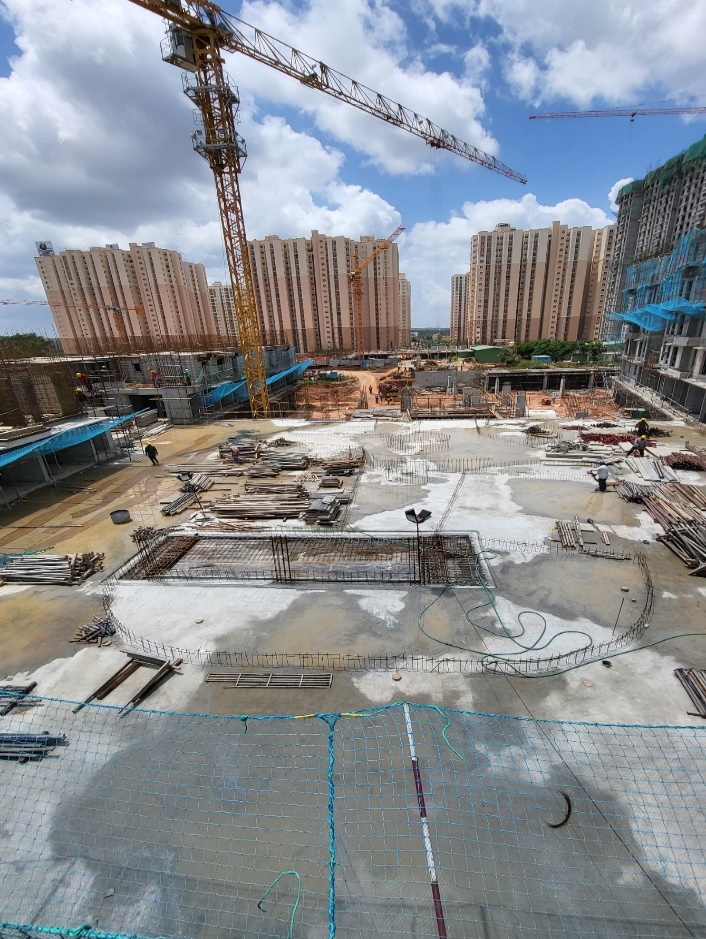

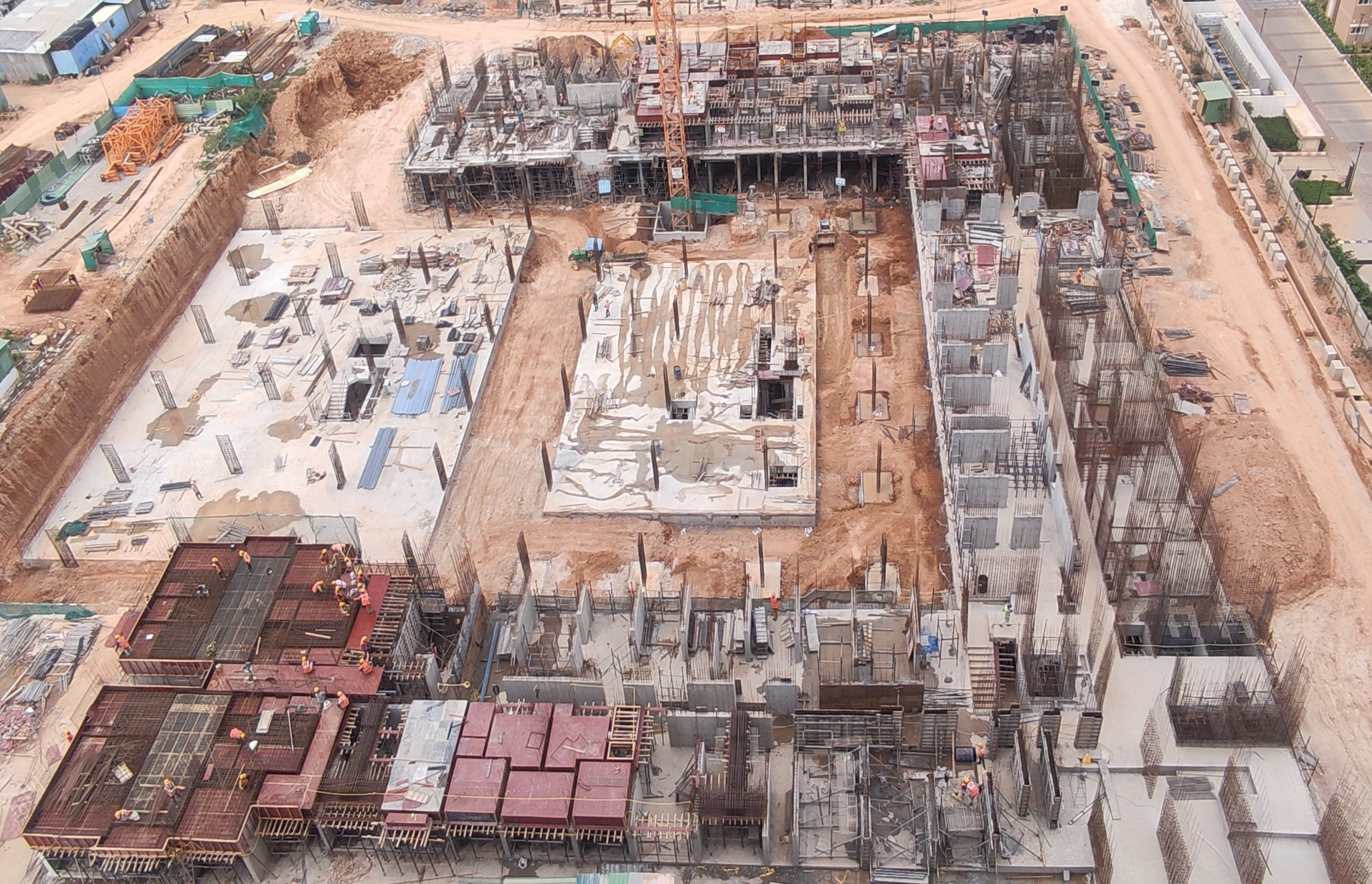

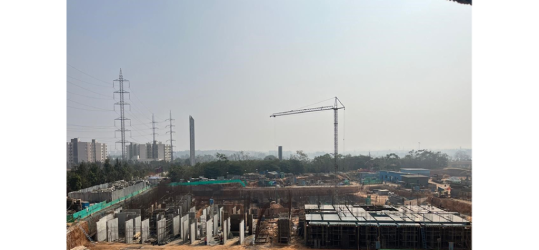

Mass excavation - 90% work completed Tower area Raft -80% work completed Hospital area Raft concreting work in progress Basement floor slab shuttering work in progress - May 2025

STP – Raft completed, wall reinforcement and concrete in progress - May 2025

Wing B -Ground floor– (S & Q unit) concrete completed , Wing C –(M & K unit) Aluminium initial setting in progress - May 2025

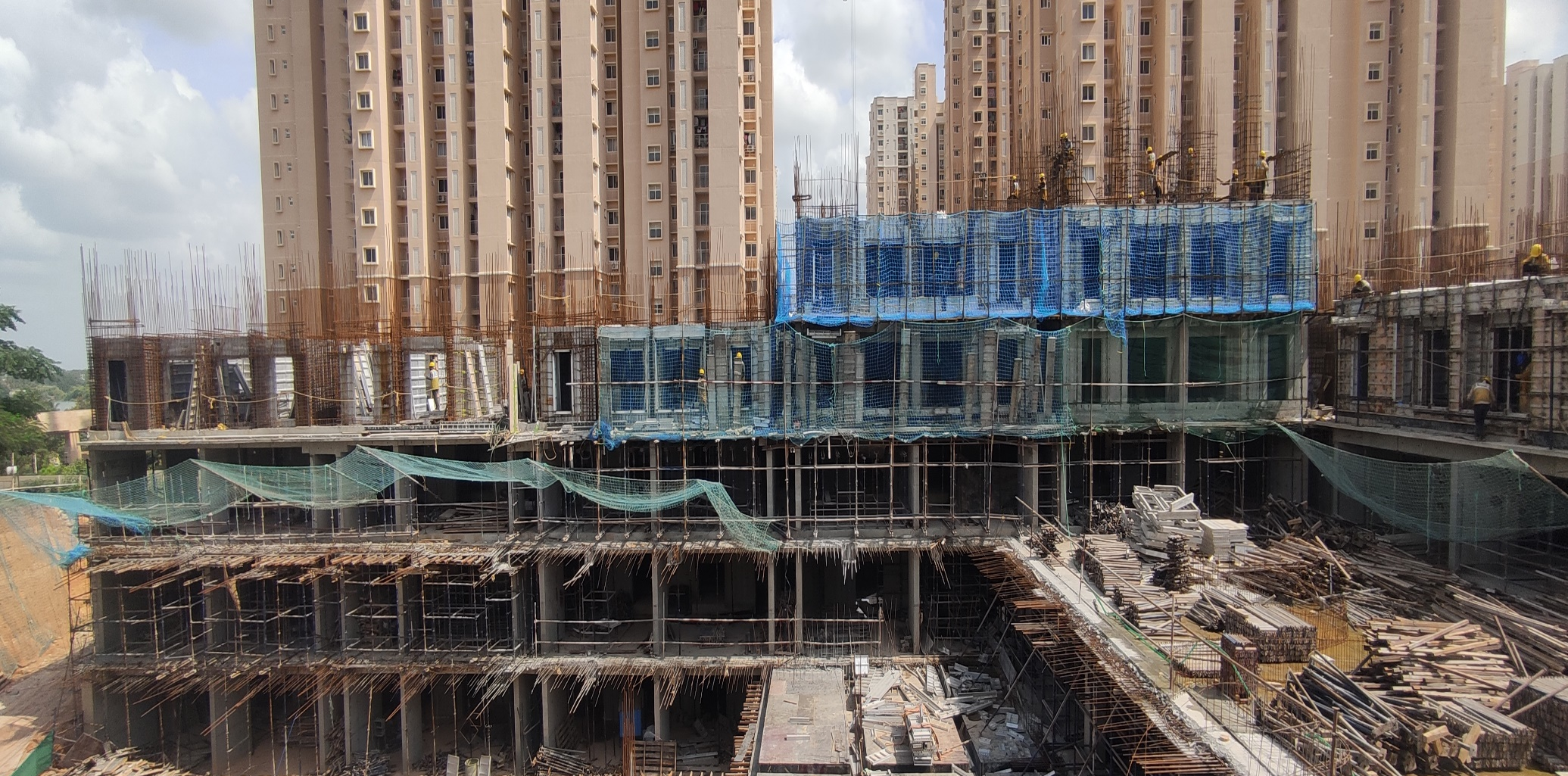

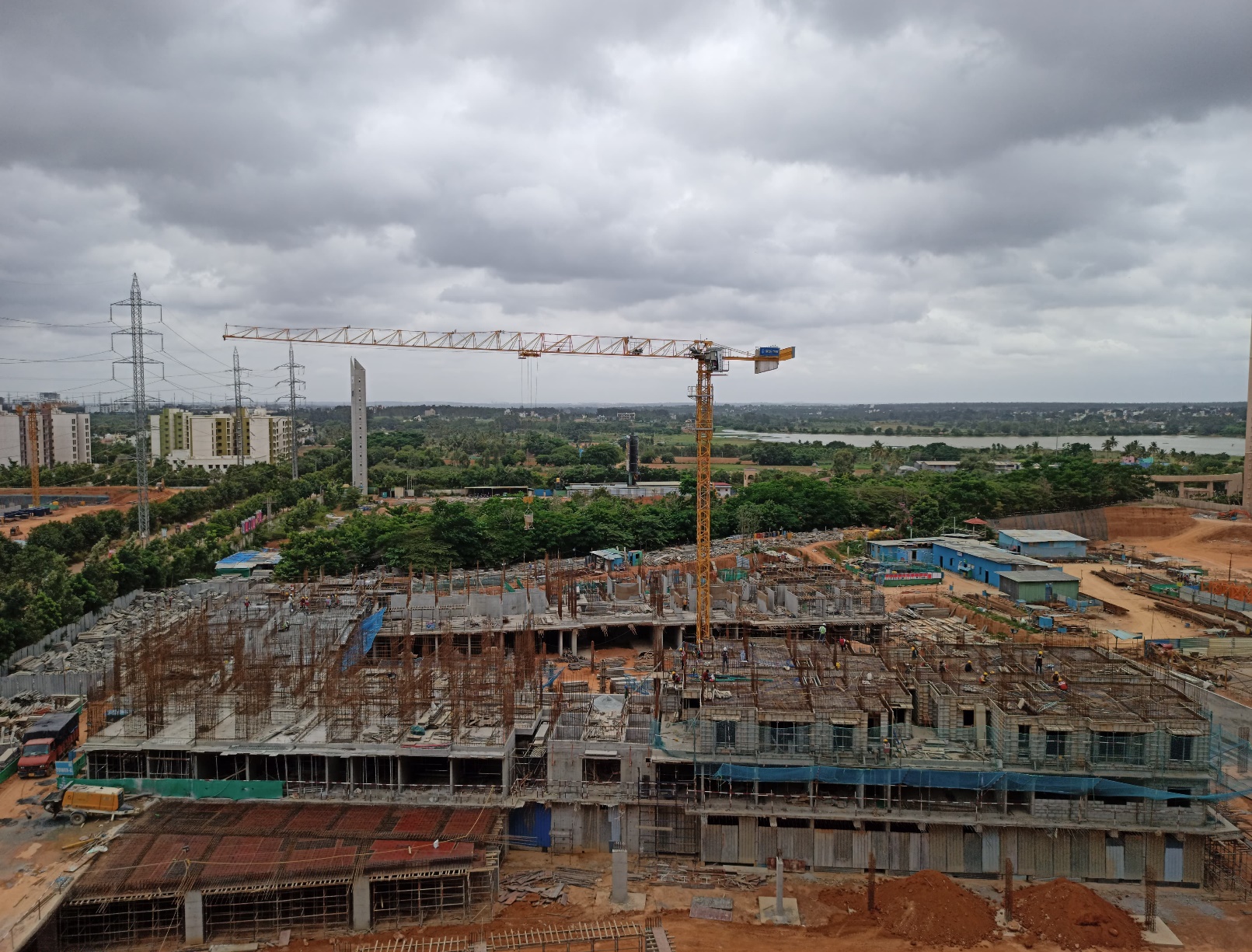

Wing A – First floor 2 flats (ZS,ZR) Aluminium initial setting WIP - May 2025

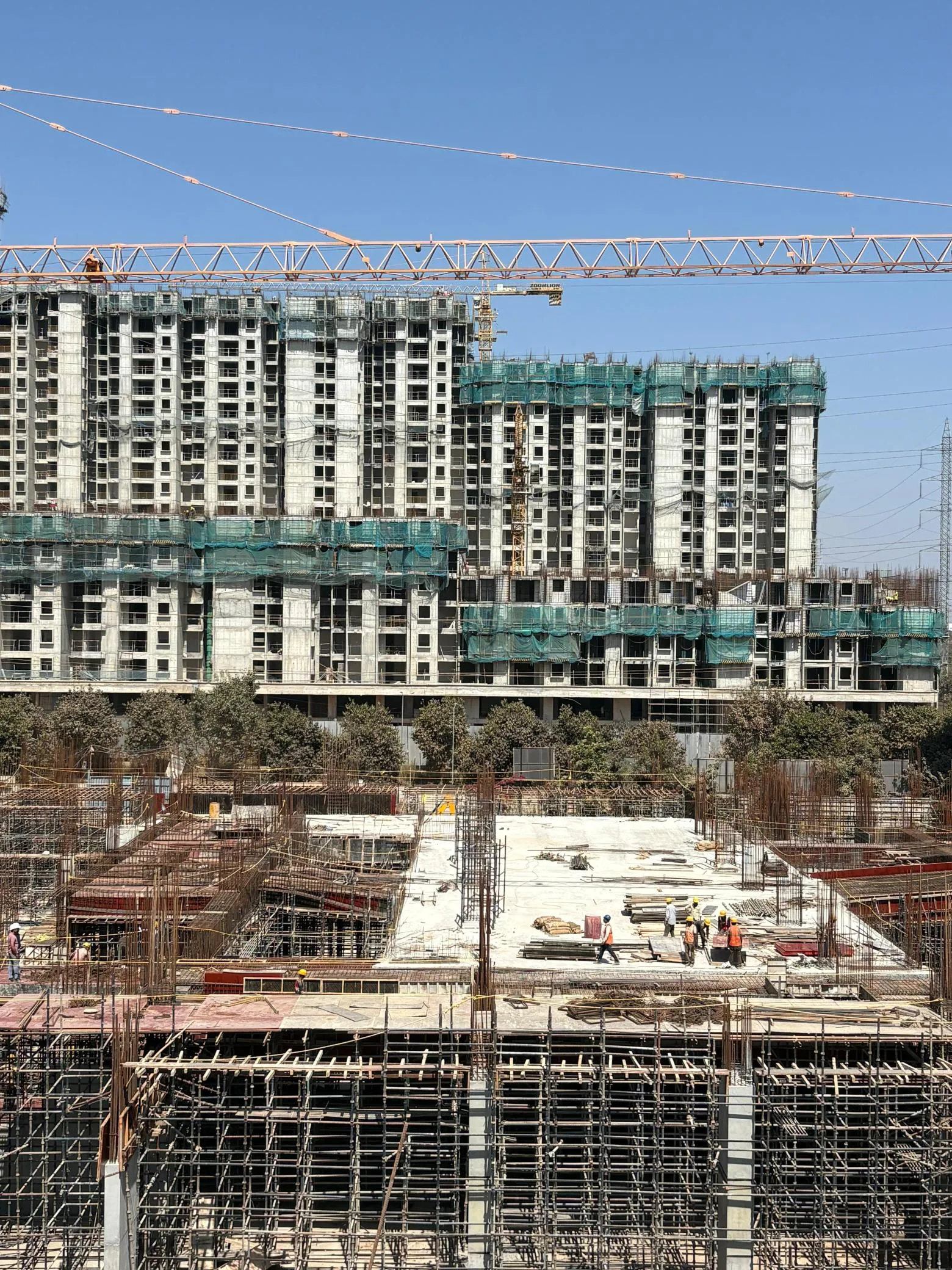

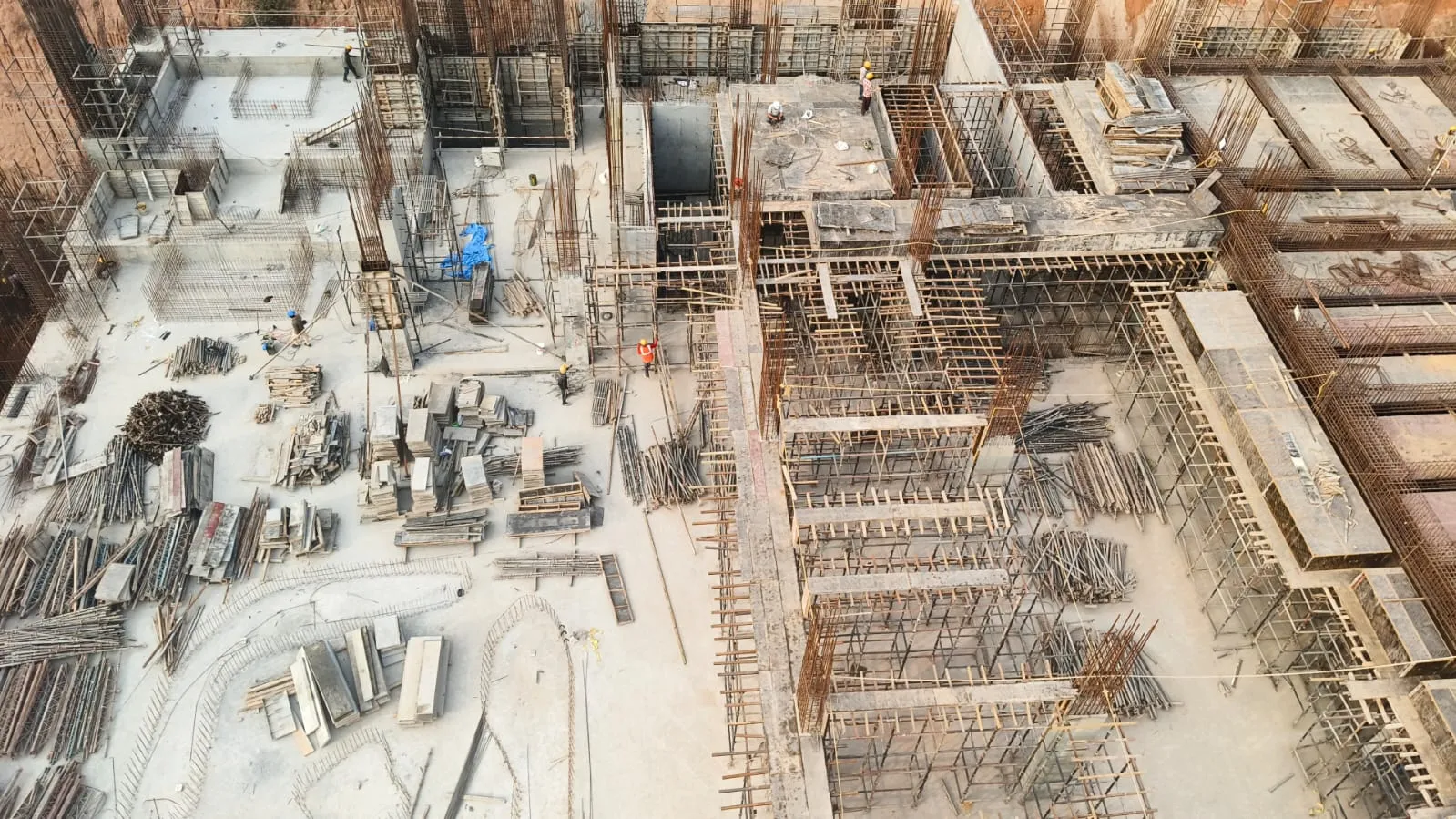

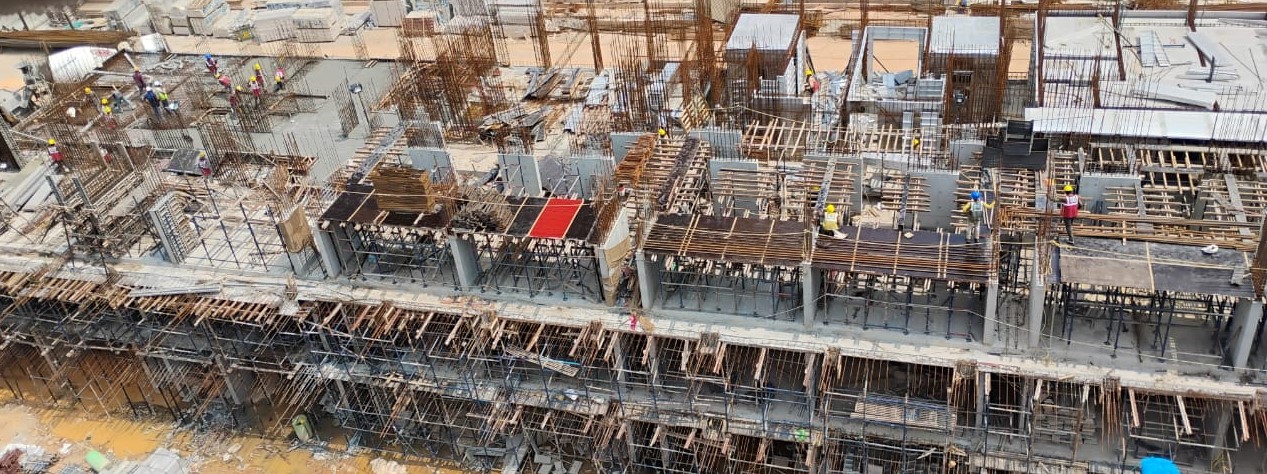

1.Wing A&B – First floor slab concrete completed and First floor 4 flats Aluminium initial setting WIP 2. Wing – C – GF Slab completed ,2 Flats initial setting WIP - May 2025

Wing B -Ground floor– (S & Q unit) concrete completed , Wing C –(M & K unit) Aluminium initial setting in progress - May 2025

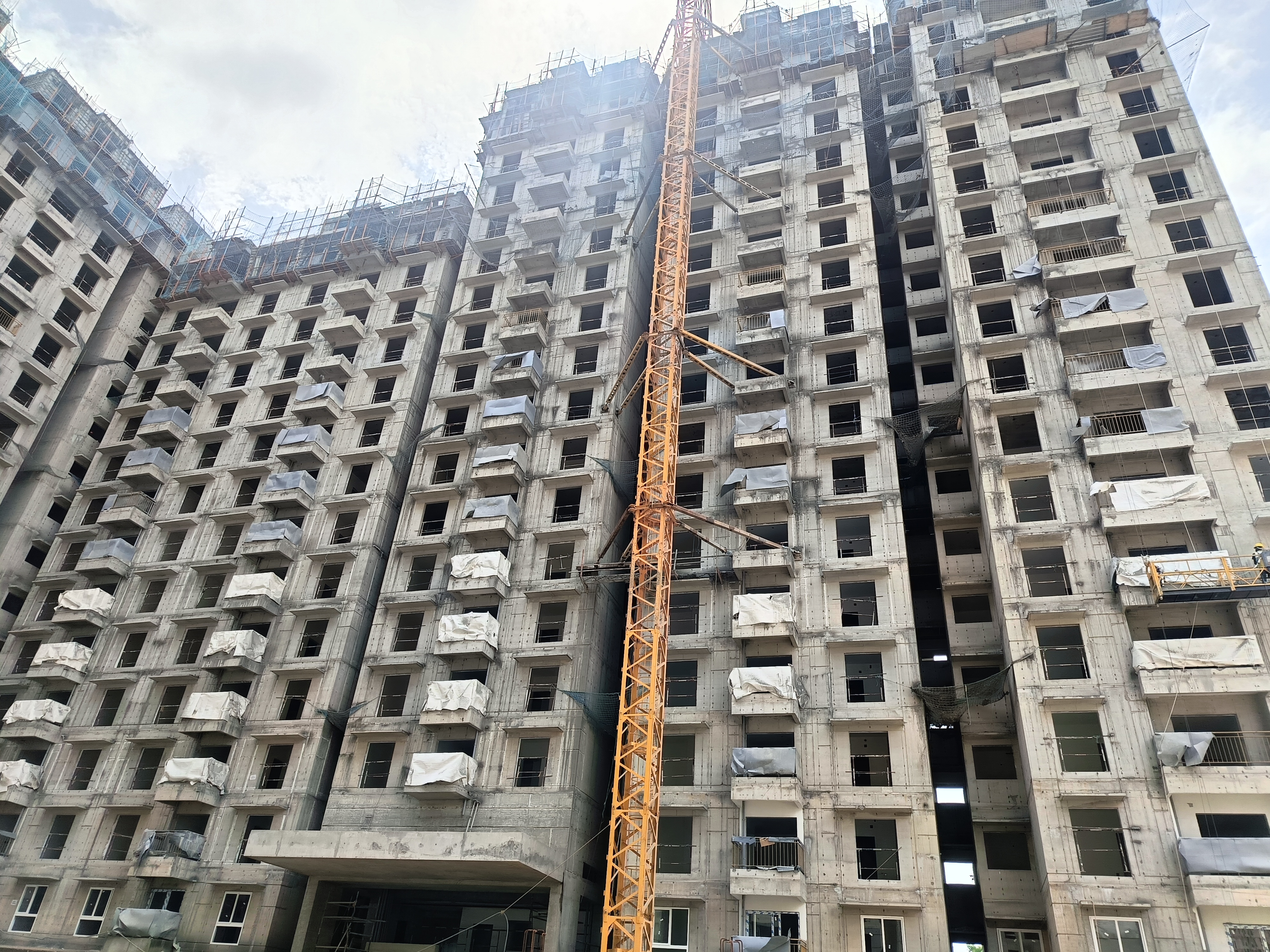

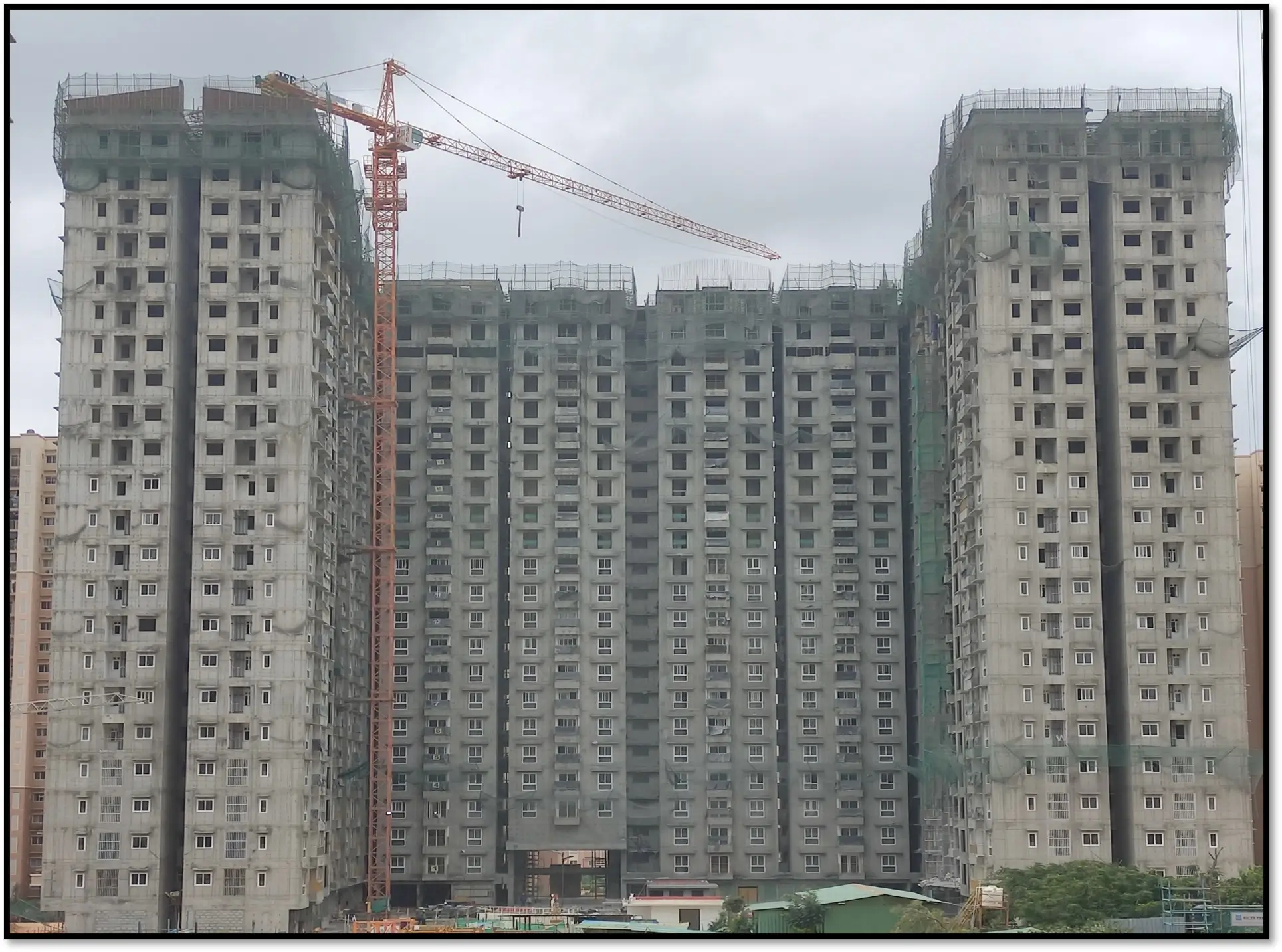

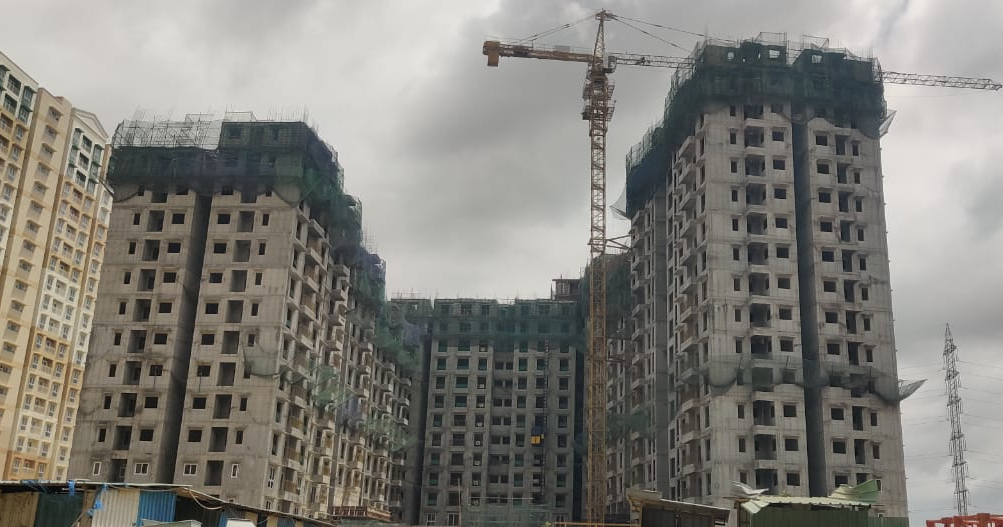

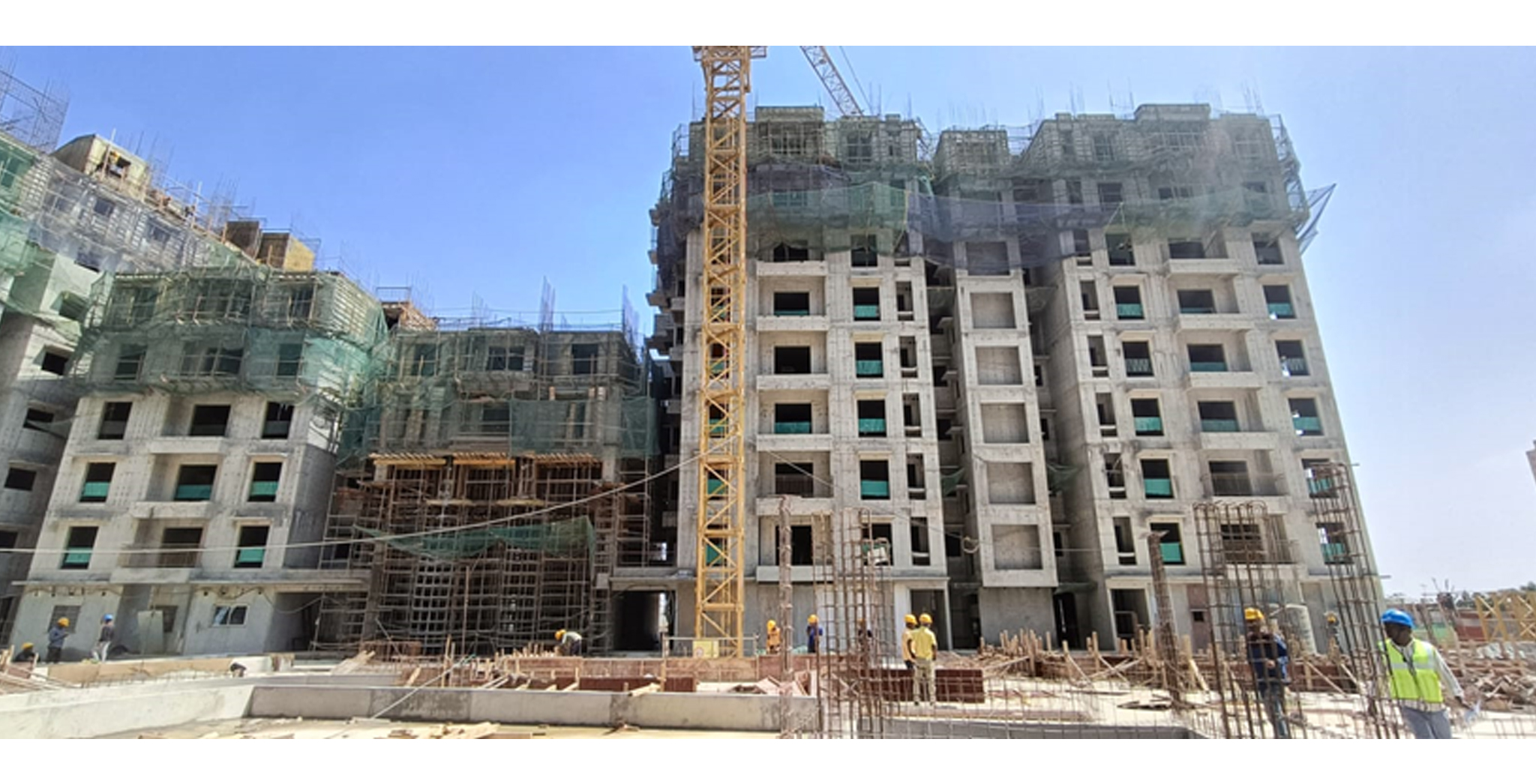

Structure -248/525 Flats Casted - May 2025

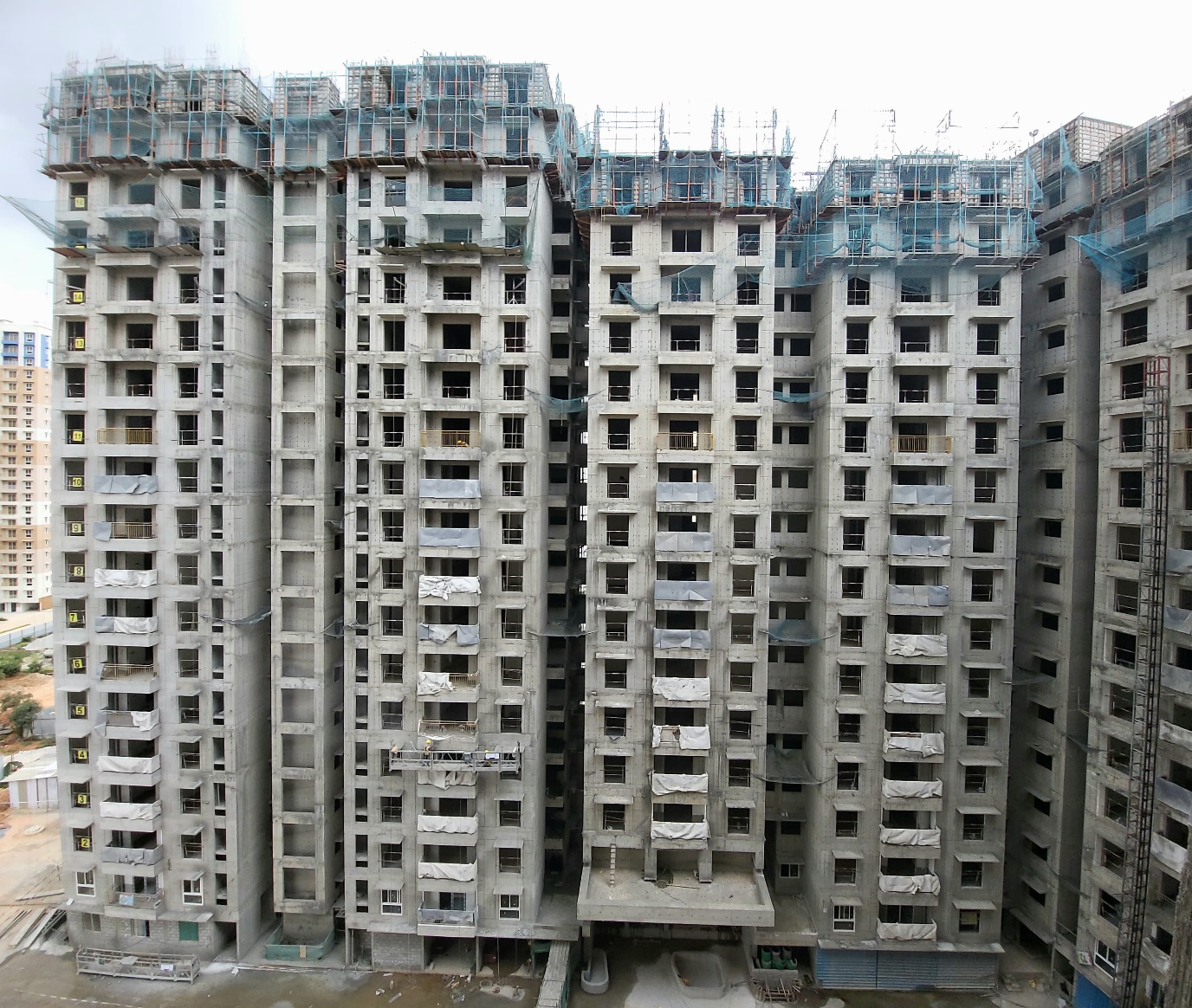

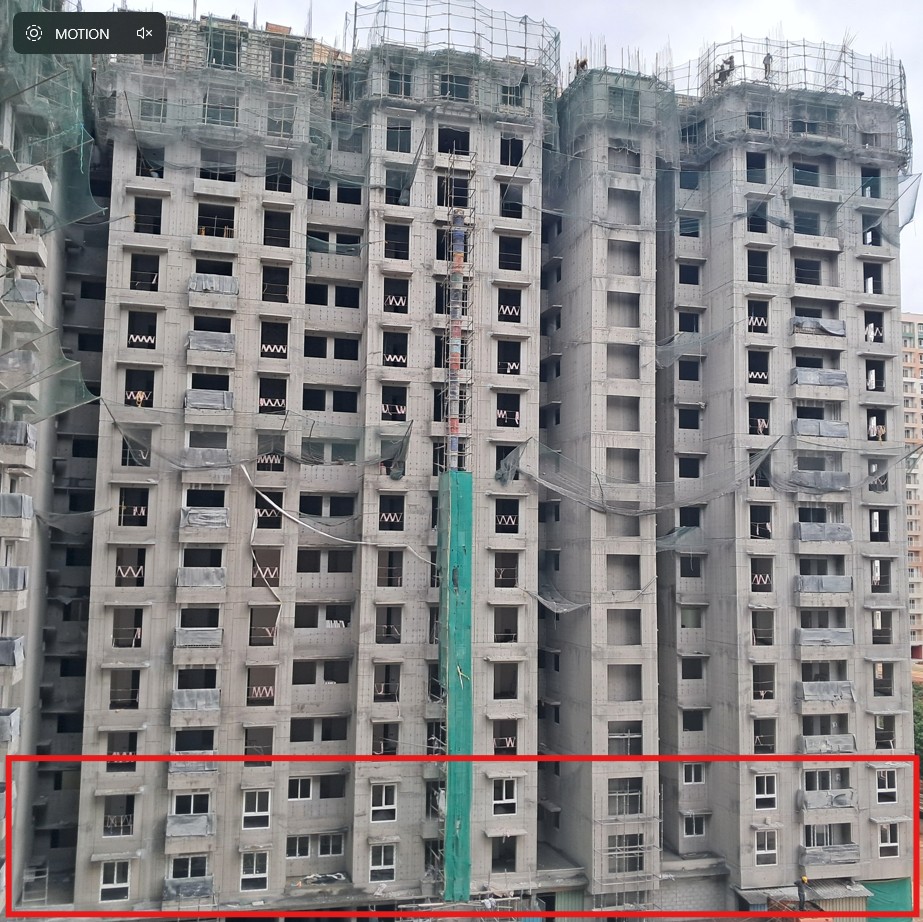

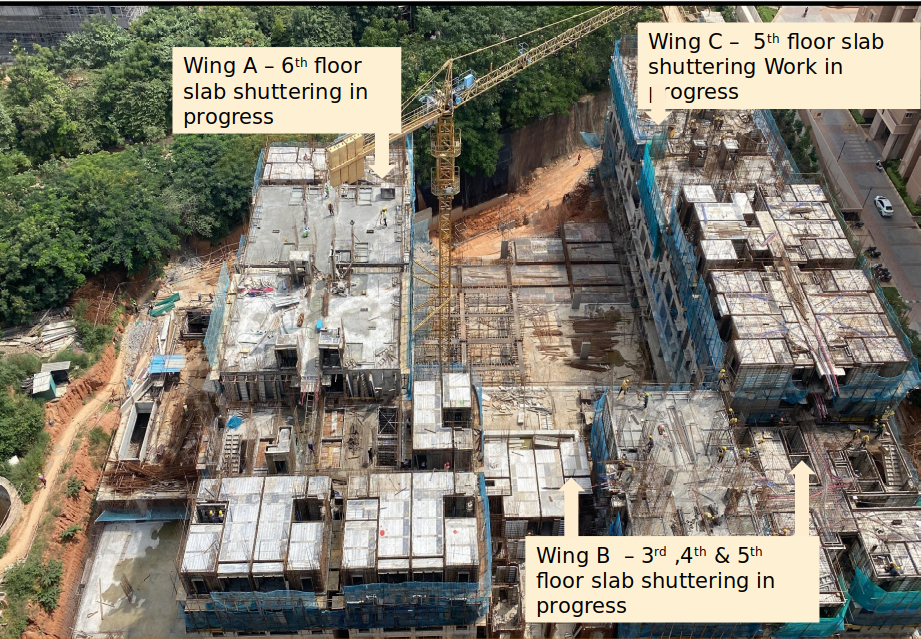

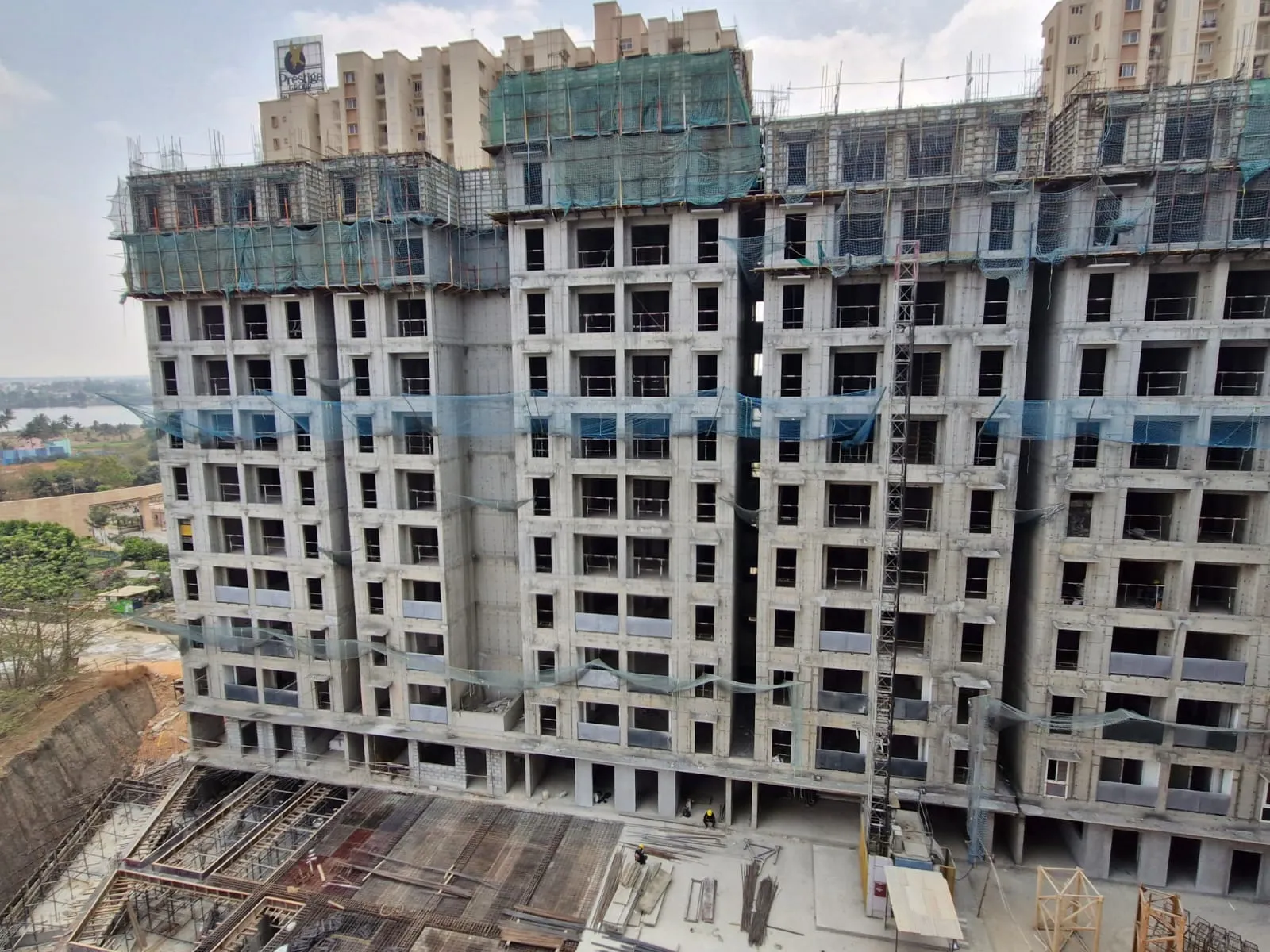

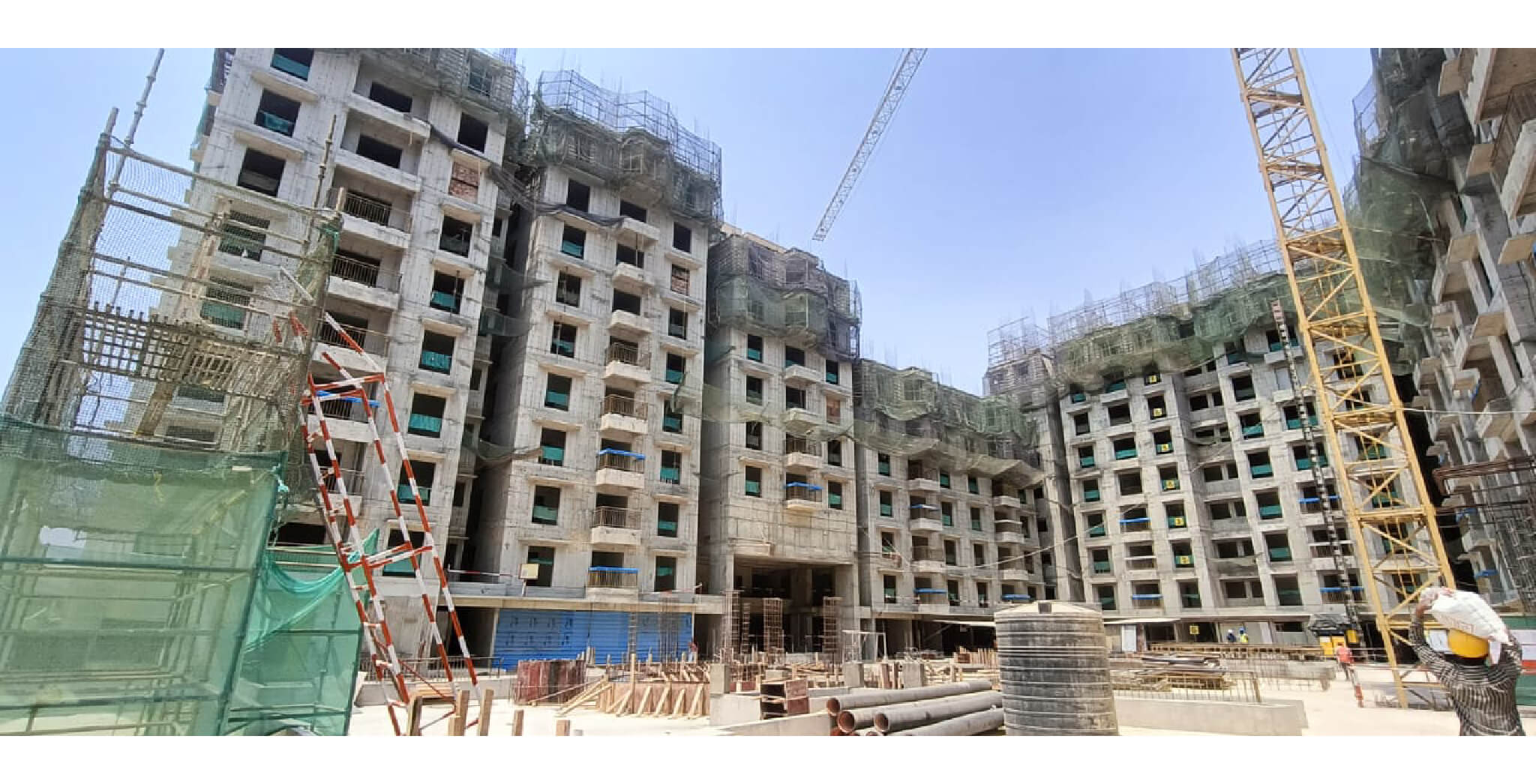

11th floor 12th Floor and 13th Floor area structure WIP Structure -248/525 Flats Casted - May 2025

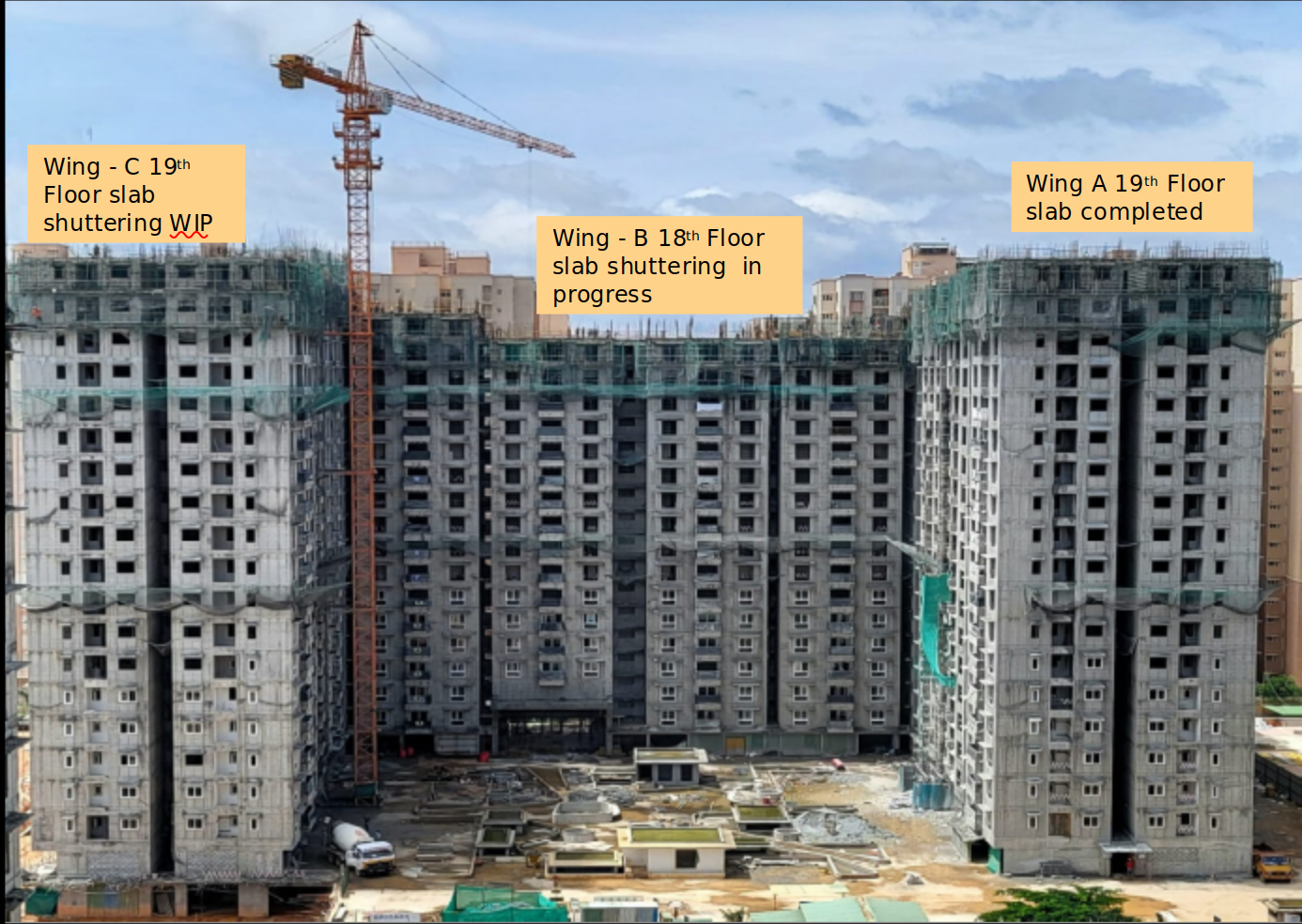

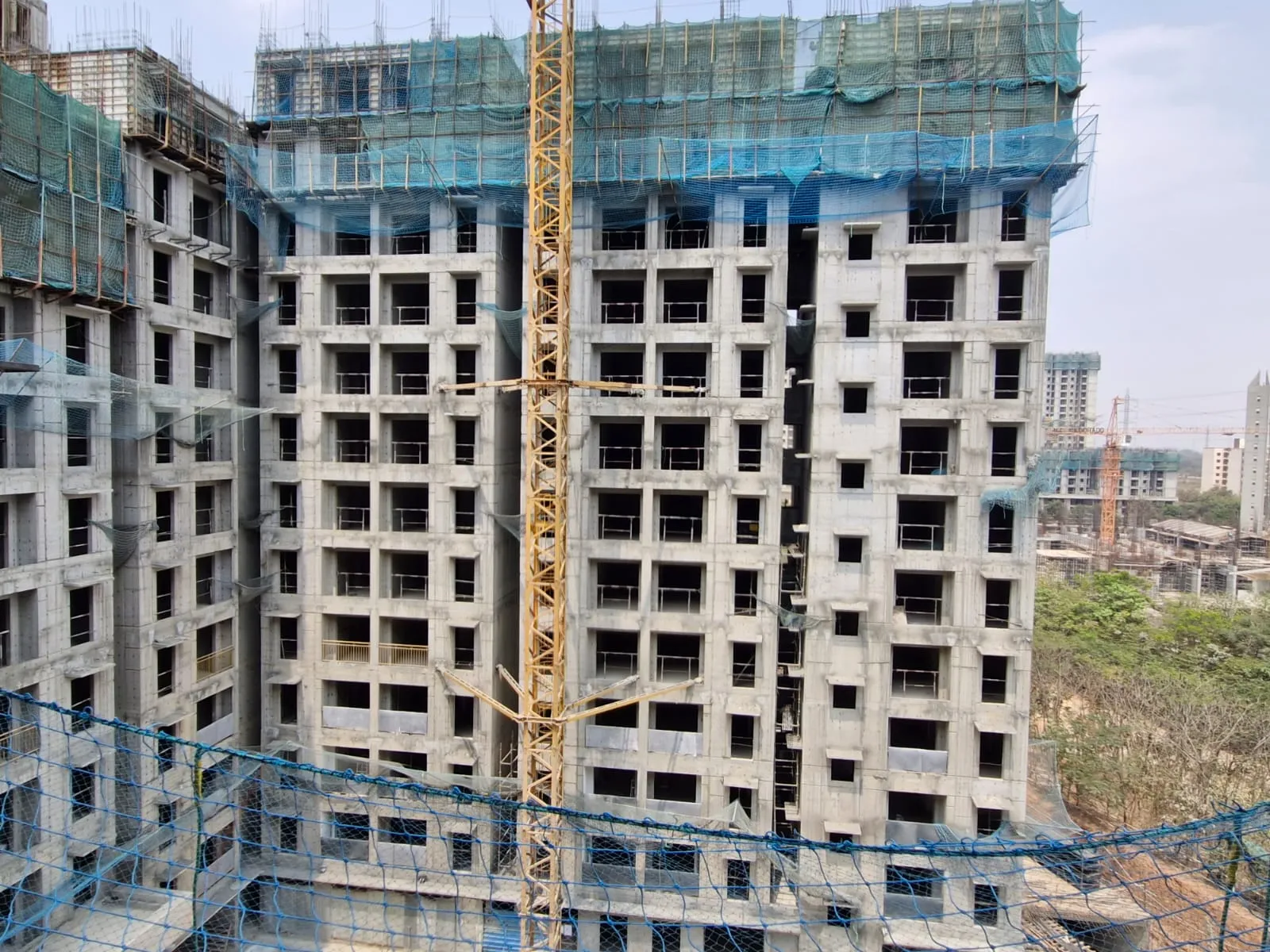

Wing A - 13th Floor slab shuttering WIP - May 2025

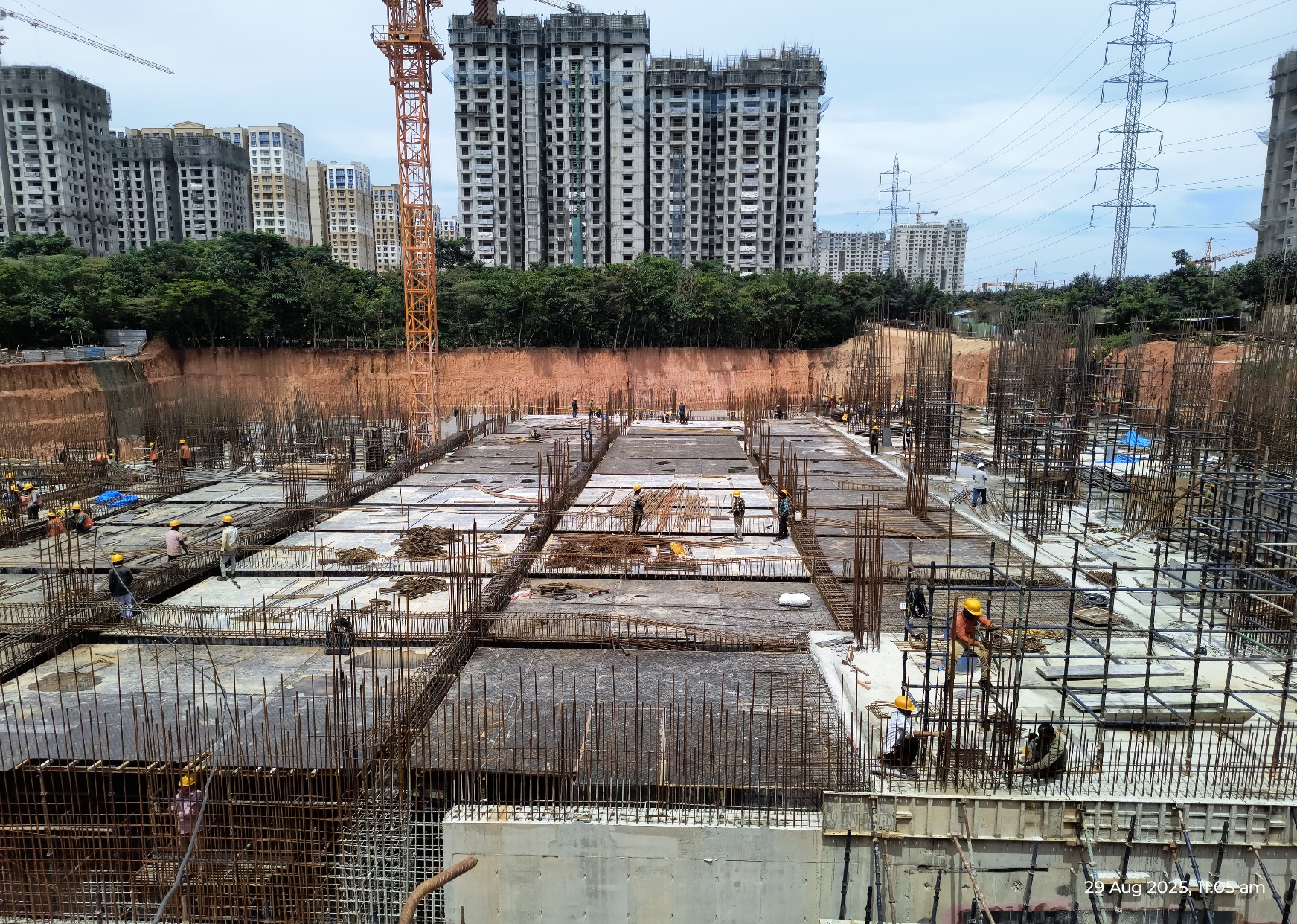

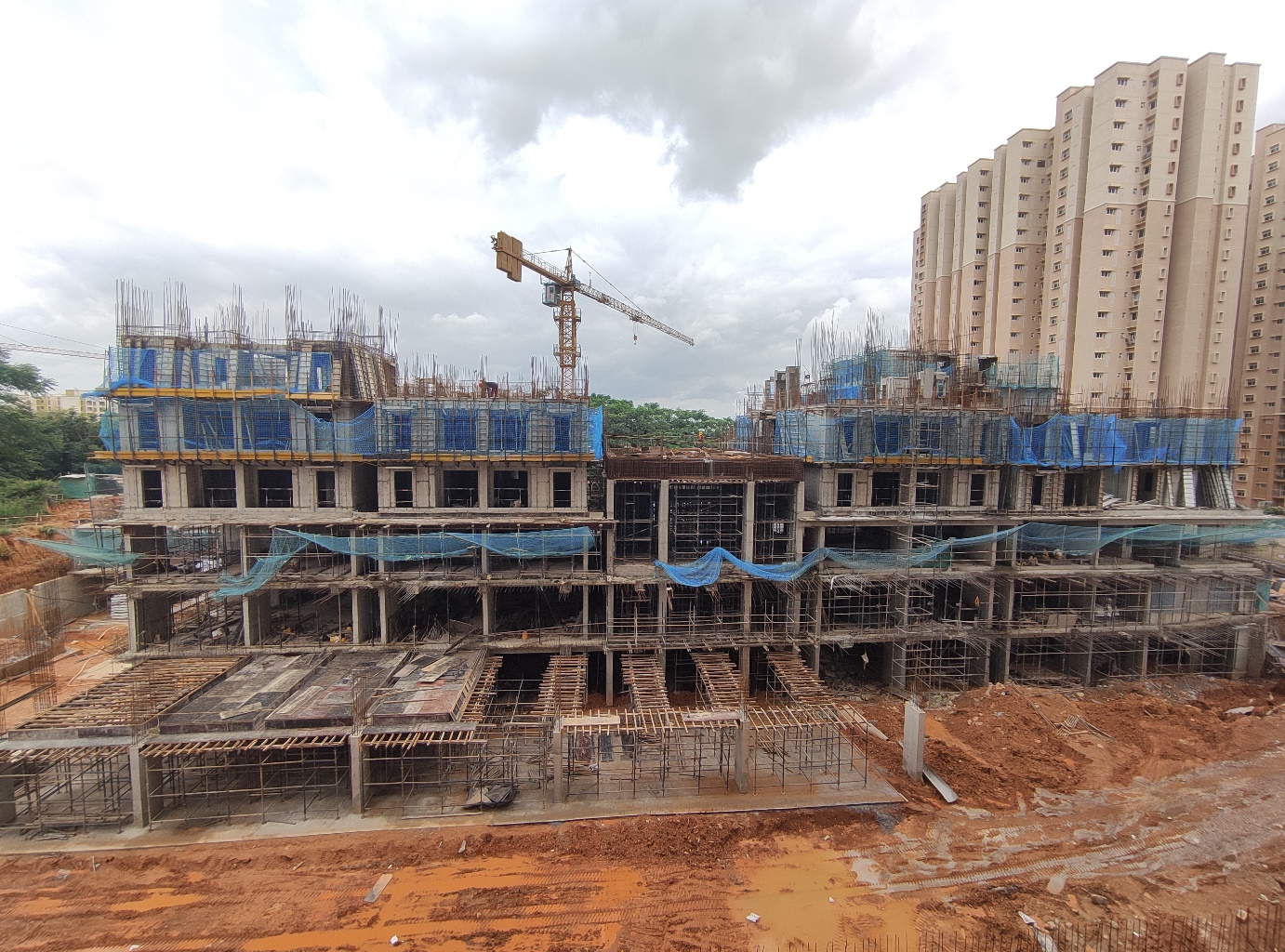

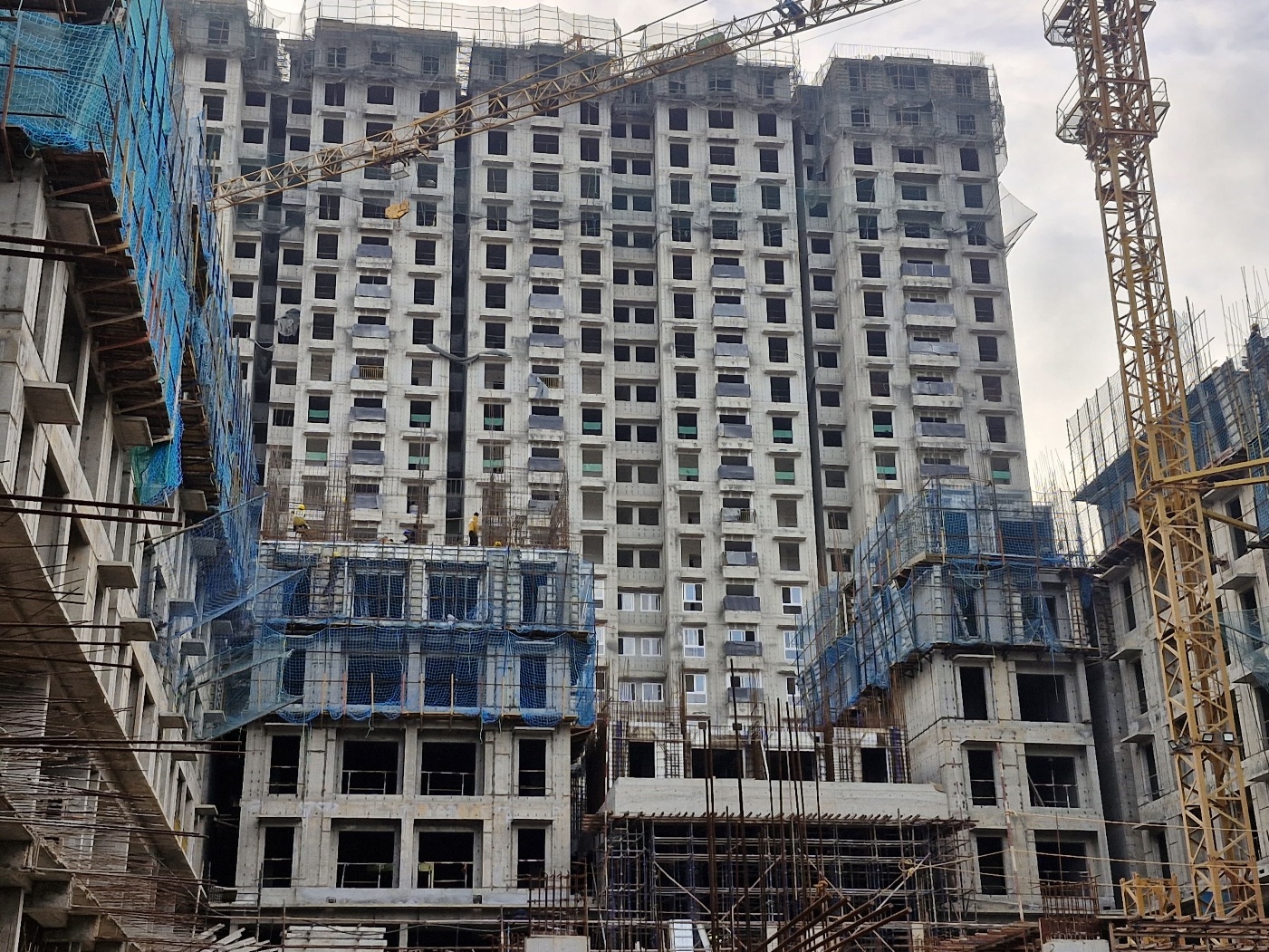

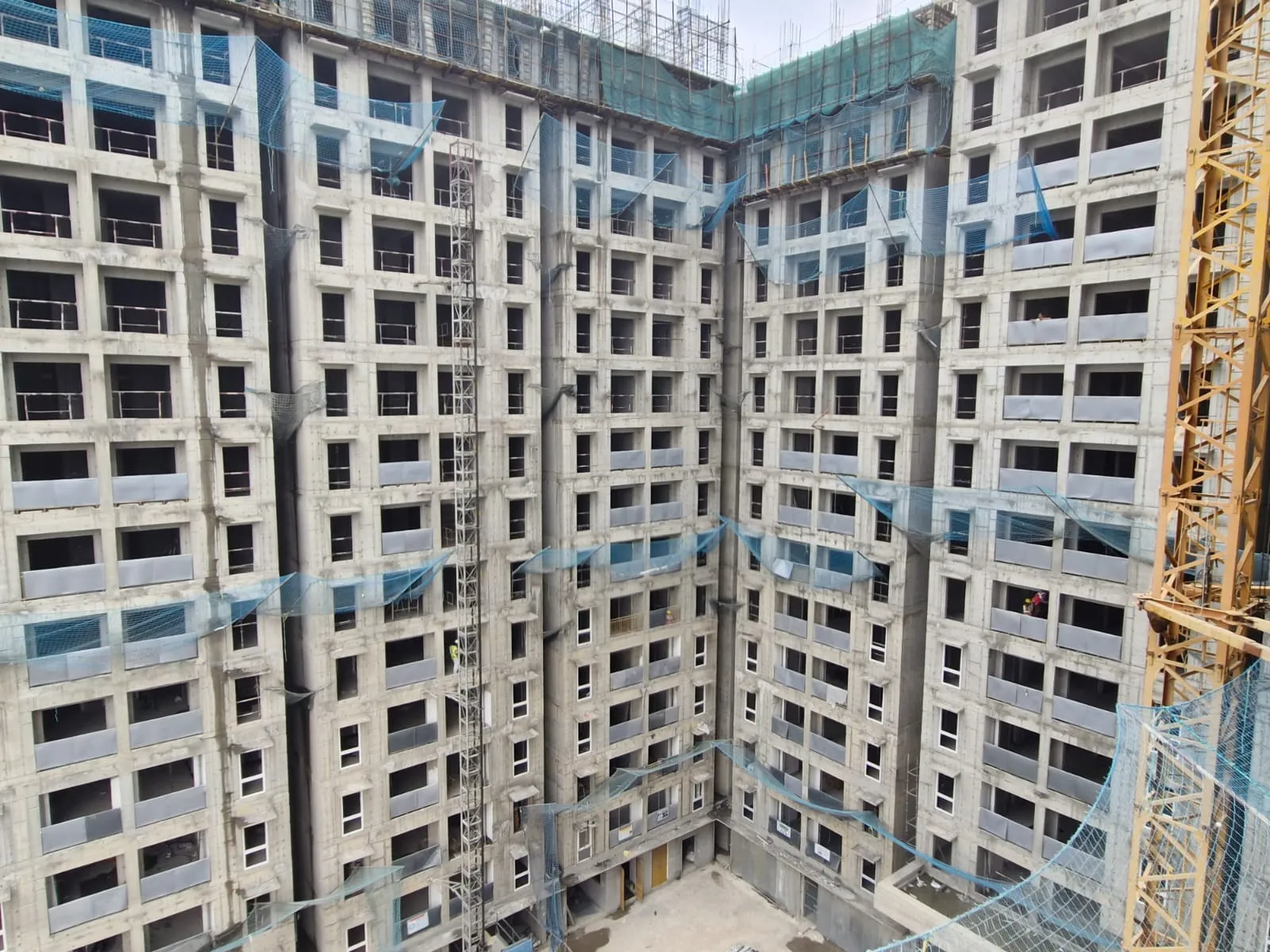

Wing B – 11 th Floor slab concrete in progress - May 2025

Wing C- 12th Floor slab shuttering WIP - May 2025

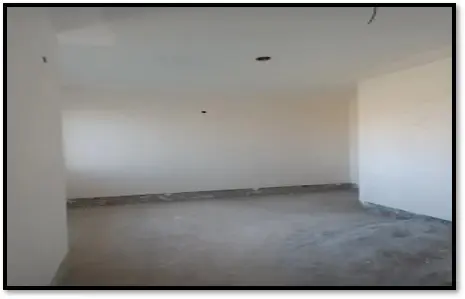

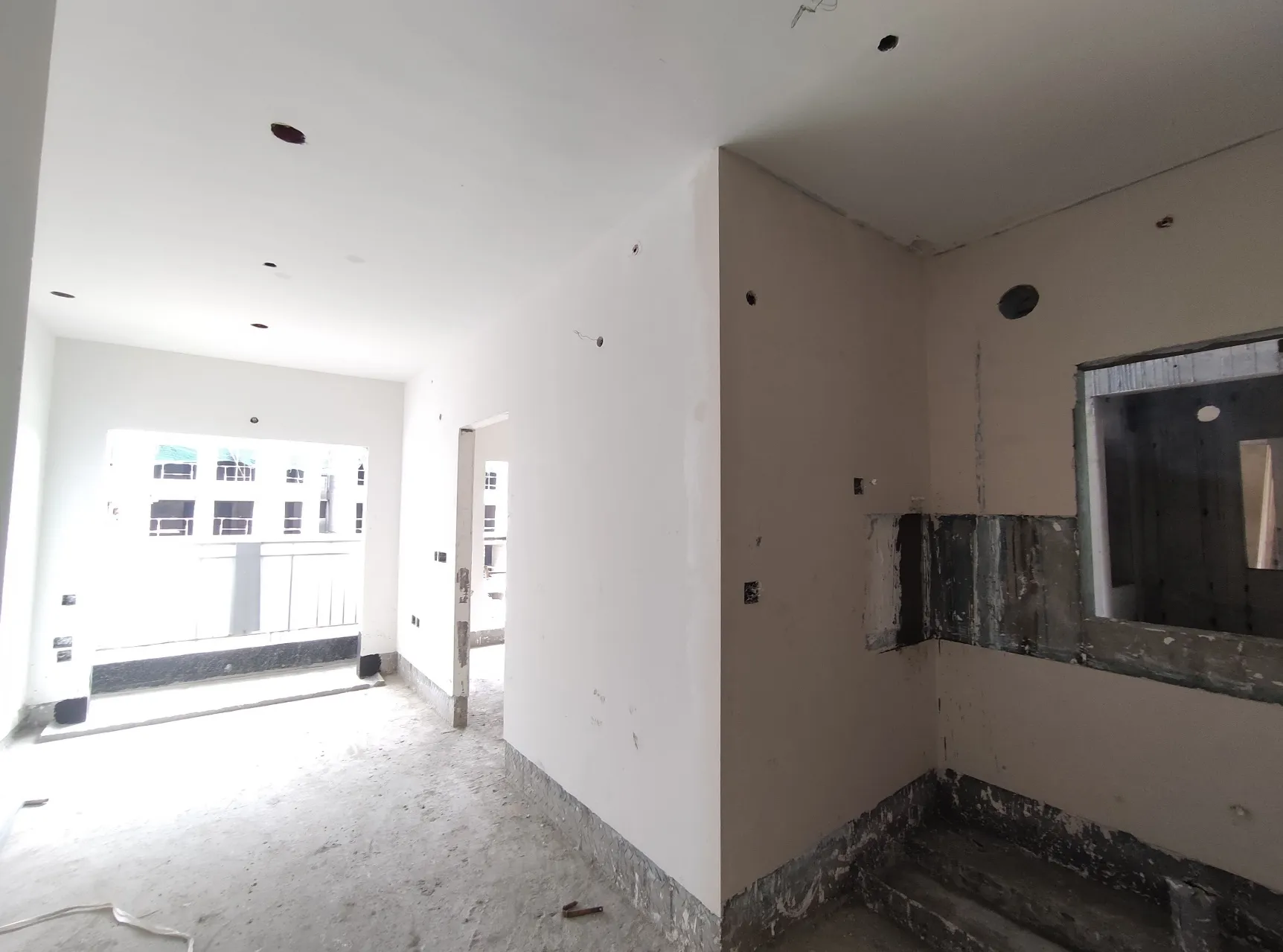

3rd floor Internal flats Gypsum punning work in progress ( 47/525) flats completed - May 2025

Internal flats Toilet Dado (24/525) flats completed - May 2025

Internal flats Toilet Dado (24/525) flats completed - May 2025

3rd Floor Toilet Waterproofing works in progress - May 2025

Finishing Work in Progress QA Certification – 374/530 completed - May 2025

Painting work in progress (530/530 Flats primer completed) - May 2025

Windows and Doors fixing work is completed - May 2025

PHE shaft door fixing is completed - May 2025

Windows and Doors fixing work is completed - May 2025

Lift wall Texture WIP - May 2025

Finishing Work in Progress QA Certification – 374/530 completed - May 2025

Corridor light fixing and Painting WIP - May 2025

PHE shaft door fixing is completed - May 2025

Finishing Work in Progress QA Certification – 374/530 completed - May 2025

South Wing - May 2025

Finishing Work in Progress QA Certification – 374/530 completed - May 2025

East face( between E and D tower) driveway and car parking work is completed - May 2025

Finishing Work in Progress QA Certification – 374/530 completed - May 2025

East ,South and West wing External Painting works Started - May 2025

Basement Painting and Services WIP - May 2025

STP HVAC duct and Plumbing Work is in progress - May 2025

Podium Central Courtyard Area Hardscape and Softscape WIP - May 2025

Podium Central Courtyard Area Hardscape and Softs cape WIP - May 2025

Structure -530/530 Flats completed - May 2025

Terrace Waterproofing Works is completed - May 2025

Terrace Waterproofing Works is completed - May 2025

Tiling Work In Progress (530/530 Flats Completed) - May 2025

Staircase Painting WIP - May 2025

Wing B: Above Terrace level painting work in progress - May 2025

Terrace clay tile and painting work in progress - May 2025

Toilet dado – 465/477 work in progress. Plumbing works completed - May 2025

Central podium Landscape work in progress - May 2025

Painting (Putty) – 438/477 work in progress - May 2025

Painting (Putty) – 438/477 work in progress - May 2025

Flooring – 470/477 work in progress - May 2025

Internal flats finishing work in progress - May 2025

Sanitary fixtures –98/477 work in progress - May 2025

Balcony railing – 469/477 work in progress - May 2025

UPVC doors and windows – 460/477 work in progress - May 2025

Toilet dado – 465/477 work in progress. Plumbing works completed - May 2025

Between L and A tower podium finishing work in progress - May 2025

UPVC doors and windows – 460/477 work in progress - May 2025

Wing C: Above Terrace floor level painting work in progress - May 2025

Basement work in progress - May 2025

Wing B: Above Terrace level painting work in progress - May 2025

Basement work in progress - May 2025

Wing A: Above terrace level painting work in progress - May 2025

Lift installation work in progress - May 2025

External painting Works in progress - May 2025

Lift installation work in progress - May 2025

External painting work in progress - May 2025

Fixing of doors – 445/477 work in progress - May 2025

West Wing - May 2025

East ,South and West wing External Painting works Started - May 2025

East Wing - May 2025

Tiling works Wing A: 6th floor work in progress Wing B: 6th floor work in progress Wing C: 6th floor work in progress - Apr 2025

Painting works Wing A: 8th floor work in progress Wing B: 7th floor work in progress Wing C: 7th floor work in progress - Apr 2025

Basement work in progress - Apr 2025

Tiling works Wing A: 6th floor work in progress Wing B: 6th floor work in progress Wing C: 6th floor work in progress - Apr 2025

Aurum - Wing C – Milestone Release –“ On Casting of 12th Floor Slab” – Status as on 30th - Apr 2025

OWC slab concreting completed, retaining wall work in progress - Apr 2025

AURUM – Front elevation - Apr 2025

Wing A - Pour 1; 16th floor slab shuttering work in progress. Pour 2; 15th floor wall reinforcement work in progress. - Apr 2025

Wing B - Pour 3; 15th floor wall reinforcement work in progress Pour 4; 14th floor wall reinforcement work in progress. - Apr 2025

Basement work in progress - Apr 2025

Wing C - Pour 5; 13th floor wall reinforcement work in progress. Pour 6; 16th floor wall shuttering work in progress. - Apr 2025

Non tower Area -Podium planter box work in progress - Apr 2025

Mass excavation - 90% work completed Tower area Raft -21% work completed Hospital area Raft concreting work in progress Basement floor slab shuttering work in progress - Apr 2025

OVERALL VIEW – 1.Wing A&B – First floor slab concrete completed and First floor 2 flats Aluminium initial setting WIP 2. Wing – C – GF Slab completed ,2 Flats initial setting WIP - Apr 2025

Wing A – First floor flats Aluminium initial setting WIP - Apr 2025

Wing B – 50% First floor slab completed remaining 50% slab reinforcement WIP - Apr 2025

Wing C – GF 2 flats Aluminium Initial setting WIP Balance 50% First floor slab (Conventional Area)shuttering and reinforcement WIP - Apr 2025

Ground floor Wing B – (S & Q unit),Wing C –(M & K unit) Aluminium shuttering works started - Apr 2025

Ground floor Wing B – (S & Q unit),Wing C –(M & K unit) Aluminium shuttering works started - Apr 2025

BRIGADE EL DORADO – DIORO 9th floor 10th Floor and 11th Floor area structure WIP Structure -194/525 Flats Casted - Apr 2025

Internal flats Gypsum punning works started - Apr 2025

1st Floor and 2nd Floor Toilet Waterproofing works in progress - Apr 2025

Wing C- 10th Floor slab shuttering WIP - Apr 2025

Wing A - 11th Floor slab shuttering WIP - Apr 2025

Wing B - 9th Floor slab shuttering WIP - Apr 2025

Internal flats Toilet Dado works started - Apr 2025

Internal flats Toilet Dado works started - Apr 2025

Corridor and Staircase Flooring and Painting Completed - Apr 2025

Painting work in progress (530/530 Flats primer completed) - Apr 2025

Corridor and Staircase Flooring and Painting Completed - Apr 2025

PHE shaft door fixing is completed - Apr 2025

East face( between E and D tower) driveway and car parking work is completed - Apr 2025

Podium Central Courtyard Area Hardscape and Softscape WIP - Apr 2025

Structure -530/530 Flats completed - Apr 2025

East ,South and West wing External Painting works Started - Apr 2025

East ,South and West wing External Painting works Started - Apr 2025

Basement Painting and Services WIP - Apr 2025

Basement Painting and Services WIP - Apr 2025

Tiling Work In Progress (530/530 Flats Completed) - Apr 2025

Podium Central Courtyard Area Hardscape and Softs cape WIP - Apr 2025

PHE shaft door fixing is completed - Apr 2025

Finishing Work in Progress QA Certification – 324/530 completed - Apr 2025

Finishing Work in Progress QA Certification – 324/530 completed - Apr 2025

Finishing Work in Progress QA Certification – 324/530 completed - Apr 2025

Structure -530/530 Flats completed - Apr 2025

South Wing - Apr 2025

Windows and Doors fixing work is completed - Apr 2025

West Wing - Apr 2025

Windows and Doors fixing work is completed - Apr 2025

Finishing Work in Progress QA Certification – 324/530 completed - Apr 2025

Finishing Work in Progress QA Certification – 324/530 completed - Apr 2025

STP HVAC duct and Plumbing Work is in progress - Apr 2025

Central podium Landscape work in progress - Apr 2025

Lift installation work in progress - Apr 2025

Flooring – 454/477 work in progress - Apr 2025

Internal flats finishing work in progress - Apr 2025

Fixing of doors – 440/477 work in progress - Apr 2025

UPVC doors and windows – 450/477 work in progress - Apr 2025

UPVC doors and windows – 450/477 work in progress - Apr 2025

Balcony railing – 467/477 work in progress - Apr 2025

Basement work in progress - Apr 2025

Wing B: Above Terrace level structural work in progress - Apr 2025

Structure Works in progress - Apr 2025

Wing A: Above terrace floor level structural work in progress - Apr 2025

Between L and A tower podium finishing work in progress - Apr 2025

Terrace clay tile and OHT finishing work in progress - Apr 2025

External painting work in progress - Apr 2025

Lift installation work in progress - Apr 2025

Sanitary fixtures – 60/477 work in progress - Apr 2025

Toilet dado – 465/477 work in progress. Plumbing works completed - Apr 2025

Painting (Putty) – 410/477 work in progress - Apr 2025

Painting (Putty) – 410/477 work in progress - Apr 2025

Toilet dado – 465/477 work in progress. Plumbing works completed - Apr 2025

Wing B: Above Terrace level structural work in progress - Apr 2025

Wing C: Above Terrace floor level structural work in progress - Apr 2025

Basement work in progress - Apr 2025

Wing C – Milestone Release –“ On casting of Ground floor slab” – Status as on 21st - Apr 2025

Wing C – Milestone Release –“ On casting of Ground floor slab” – Status as on 21st - Apr 2025

Dioro - Wing B – Milestone Release –“ On casting of Eight floor slab” – Status as on 22nd - Apr 2025

Dioro - Wing B – Milestone Release –“ On casting of Eight floor slab” – Status as on 22nd - Apr 2025

DIORO – Wing C – Milestone Release –“On casting of Eight floor slab” – Status as on 12th - Apr 2025

DIORO – Wing C – Milestone Release –“On casting of Eight floor slab” – Status as on 12th - Apr 2025

Dioro Wing A – “‘On casting of Eight floor slab” – Status as on 02nd - Apr 2025

Dioro Wing A – “‘On casting of Eight floor slab” – Status as on 02nd - Apr 2025
Frequently Asked Questions
Brigade El Dorado is situated within the Aerospace Park in North Bengaluru, just 15 minutes before the international airport.
Designed by one of Spain's most celebrated architects, Brigade El Dorado is a sprawling 50-acre residential enclave with 80+ Amenities
Our 80+ amenities include multiplex, tennis court, mini-golf green, football field, basketball, skating rink, mini-cricket field, clubhouse, multiple swimming pools, kid’s play area, farm cafe, and more.
Brigade El Dorado boasts excellent connectivity, with the airport just 15 minutes away. It is also near to the Manyata Tech Park, a prominent IT hub, and corporate offices like Shell Technology Center.
RERA NUMBERS
Gallium at Brigade El Dorado: PRM/KA/RERA/1251/472/PR/190427/002540
Helio at Brigade El Dorado: PRM/KA/RERA/1251/472/PR/190913/002889
Jasper at Brigade El Dorado: PRM/KA/RERA/1250/303/PR/200618/003458
Feldspar at Brigade El Dorado: PRM/KA/RERA/1251/309/PR/210216/003909
Krypton at Brigade El Dorado: PRM/KA/RERA/1251/309/PR/210518/004158
Iridium at Brigade El Dorado: PRM/KA/RERA/1250/303/PR/200618/003458
Emerald at Brigade El Dorado: PRM/KA/RERA/1251/309/PR/190722/005089
Aurum at Brigade El Dorado: PRM/KA/RERA/1250/303/PR/230623/006018
Luminaire at Brigade El Dorado: PRM/KA/RERA/1251/309/PR/190722/005089
Dioro at Brigade El Dorado: PRM/KA/RERA/1251/309/PR/160224/006634
Cobalt at Brigade El Dorado: PRM/KA/RERA/1251/309/PR/160524/006878
Looking for something specific?
We'd be delighted to help you.
