Exterior
Elevate Your Living Experience with Unmatched Luxury and Scenic Vistas
Imagine living next to a 125-acre lake bustling with rich flora and fauna. Picture a home that is replete with modern amenities and luxuries. Well, you can now make it a reality.
Welcome to Brigade Laguna, an abode of peace nestled in a vibrant neighbourhood off Hebbal. The property is conveniently located next to all the major social infrastructures you could ever need.
These spacious lakeside residences come with superior specifications for a life, a class apart. 3 bedroom homes in a gated apartment community, decked with luxurious amenities and lifestyle experiences.
Land Area
3 Acres
Type
3 BHK Apartments
Units
212
Super Built-up Area
110.92 Sq.m. - 175.40 Sq.m. (1194 Sq.ft - 1888 Sq.ft.)
Carpet Area
70.91 Sq.m. - 112.25 Sq.m. (763 Sq.ft. - 1208 Sq.ft.)
Amenities
Experience the epitome of serenity and luxury with the wealth of well-thought-out amenities at these stunning apartments in Hebbal.

*Images are for representation purpose.
Gallery

Exterior

Exterior

Interior

Tranquil Lawn

Tranquil Lawn

Tranquil Lawn

Tranquil Lawn
*Images are for representation purpose.
Videos

Master Plan
Embark on a visual journey to your dream space! Fill out the form to access the exclusive apartment unit plan and envision your life in a Brigade Home.
View Unit Plans
Price
3 BHK + 3T
3 BHK + 3T + P + ST + SR
INR 2.7 Crore Onwards*
INR 3.3 Crore Onwards*
*Government Charges, Other Charges and Taxes Applicable
*The prices are subject to change.
EMI Calculator
Price
3 BHK + 3T
3 BHK + 3T + P + ST + SR
INR 2.7 Crore Onwards*
INR 3.3 Crore Onwards*
*Government Charges, Other Charges and Taxes Applicable
* The prices are subject to change.
Location

Know Your Neighbourhood
ViewKnow Your Neighbourhood
ViewKidzee
4.6 km
Mallya Aditi
6.6 km
Vibgyor High
2.4 km
Vidya Niketan School
3.2 km
Presidency College Reva University
9.5 kms
Kidzee
4.6 km
Mallya Aditi
6.6 km
Vibgyor High
2.4 km
Vidya Niketan School
3.2 km
Presidency College Reva University
9.5 kms
Manipal Hospital, Hebbal
3.8 km
Aster CMI Hospital
4.8 km
Bangalore Baptist Hospital
6.2 kms
Motherhood Hospital
3.3 km
Cloud Nine Hospital
3.3 km
Manipal Hospital, Hebbal
3.8 km
Aster CMI Hospital
4.8 km
Bangalore Baptist Hospital
6.2 kms
Motherhood Hospital
3.3 km
Cloud Nine Hospital
3.3 km
Manyata Business Park
3 kms
Kirloskar Tech Park
3.4 km
KIADB Aerospace SEZ and Hardware Park
24.7 km
Karle Tech Park
2.6 km
IFCI Financial City
20 km
Manyata Business Park
3 kms
Kirloskar Tech Park
3.4 km
KIADB Aerospace SEZ and Hardware Park
24.7 km
Karle Tech Park
2.6 km
IFCI Financial City
20 km
Garuda Mall, Yelahanka
6.2 km
RMZ Galleria Mall
5.4 km
Mall of Bengaluru
6.6 km
Elements Mall
4.6 km
Esteem Mall
3.7 km
Phoenix Mall of Asia
2.7 km
Garuda Mall, Yelahanka
6.2 km
RMZ Galleria Mall
5.4 km
Mall of Bengaluru
6.6 km
Elements Mall
4.6 km
Esteem Mall
3.7 km
Phoenix Mall of Asia
2.7 km
Project Status
The entire project exudes a rare sense of completeness.

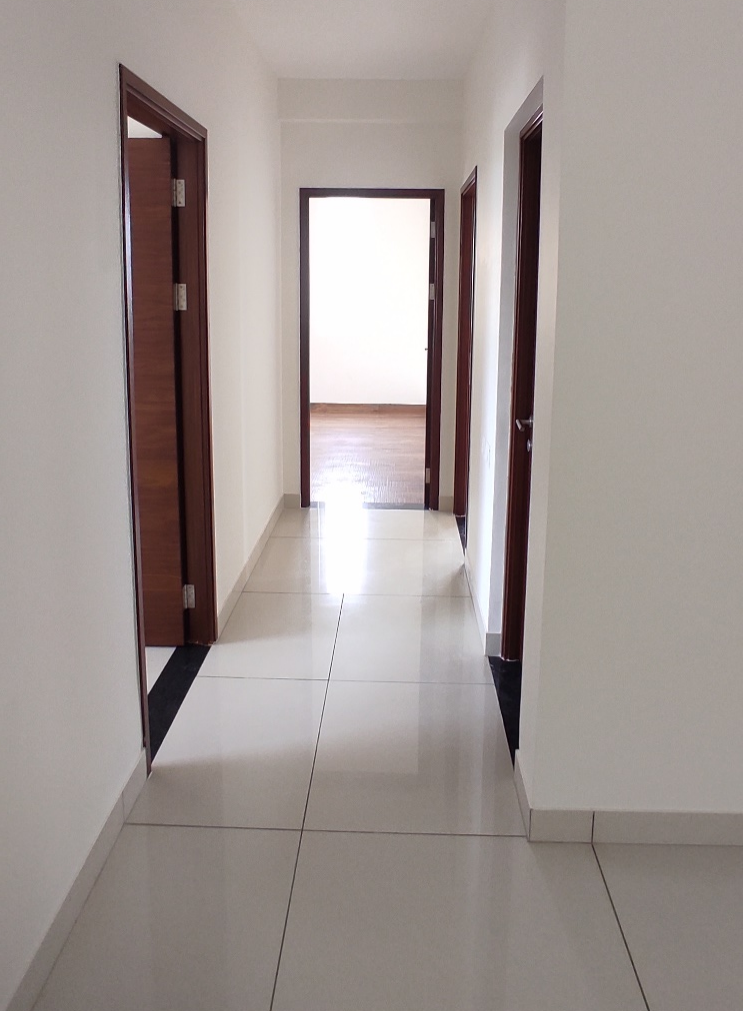

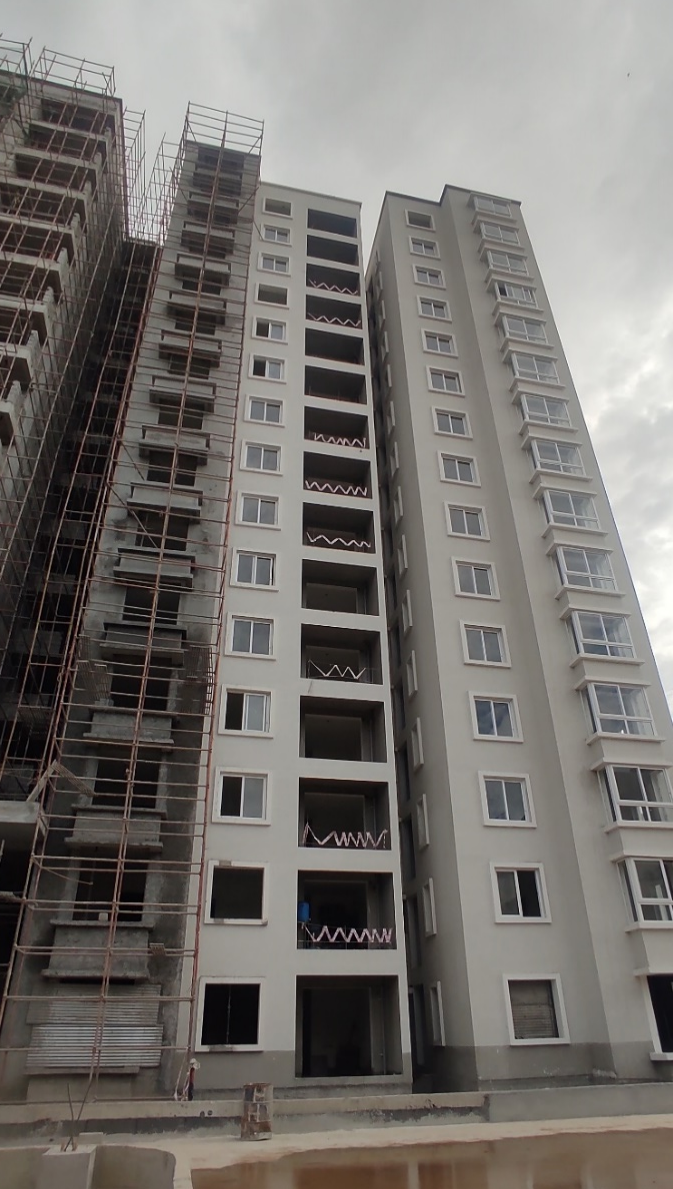

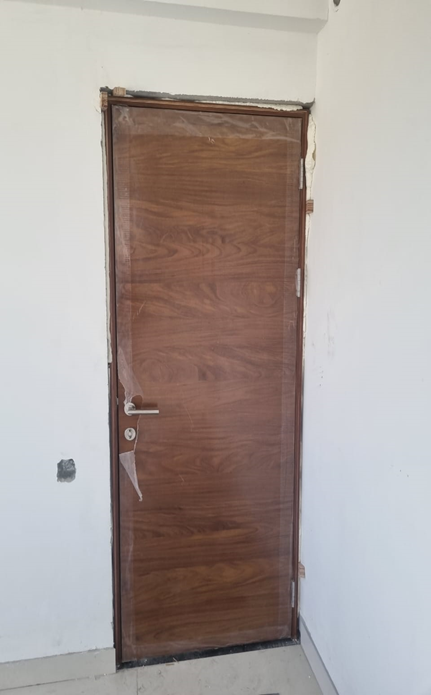

Tower B: Windows & Door installation. -

Swimming pool works completed - Oct 2025

EV Charging shed work completed - Oct 2025

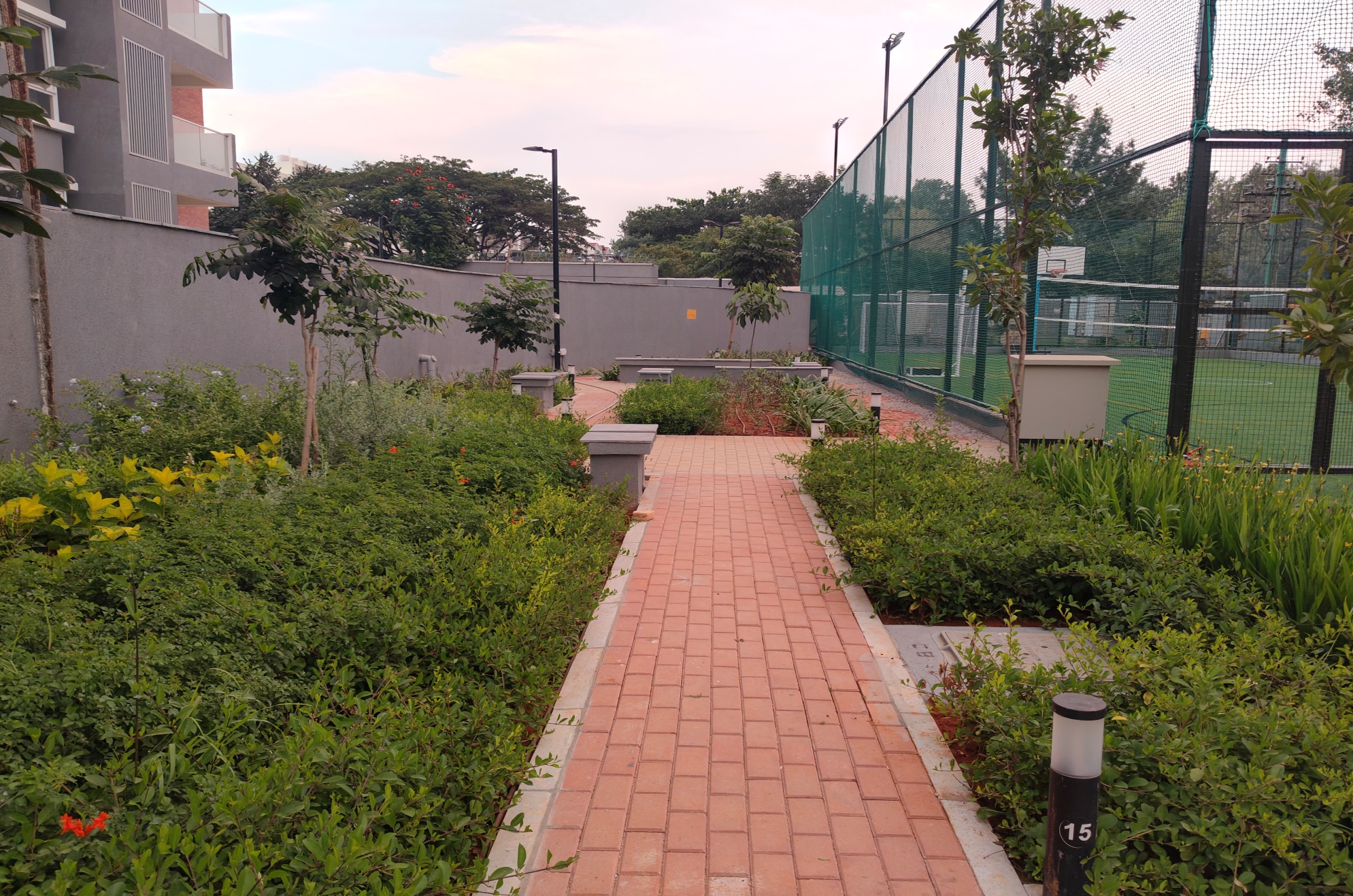

Landscape works completed - Oct 2025

Clubhouse – TT Room - Oct 2025

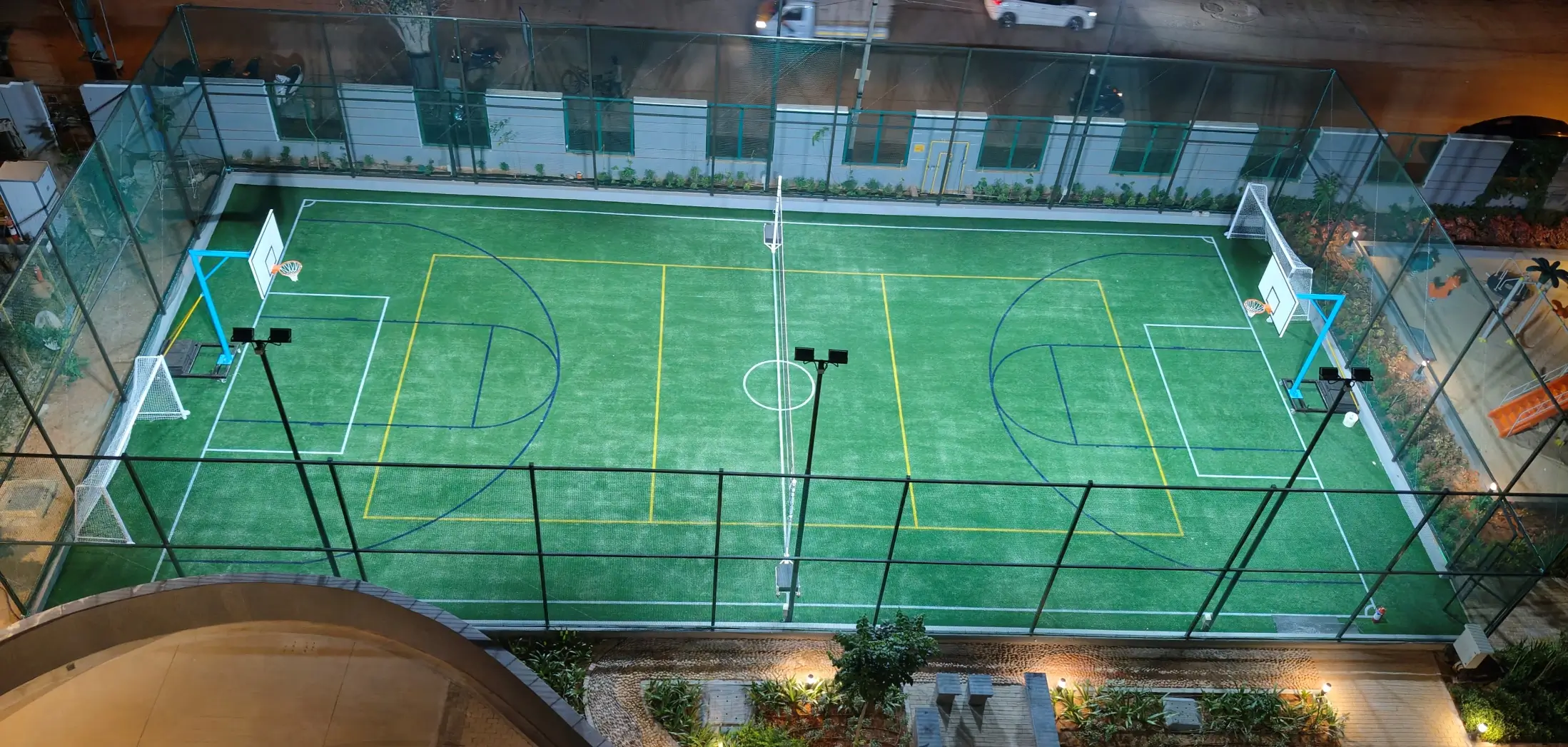

Multipurpose court work completed - Oct 2025

Driveway works completed - Oct 2025

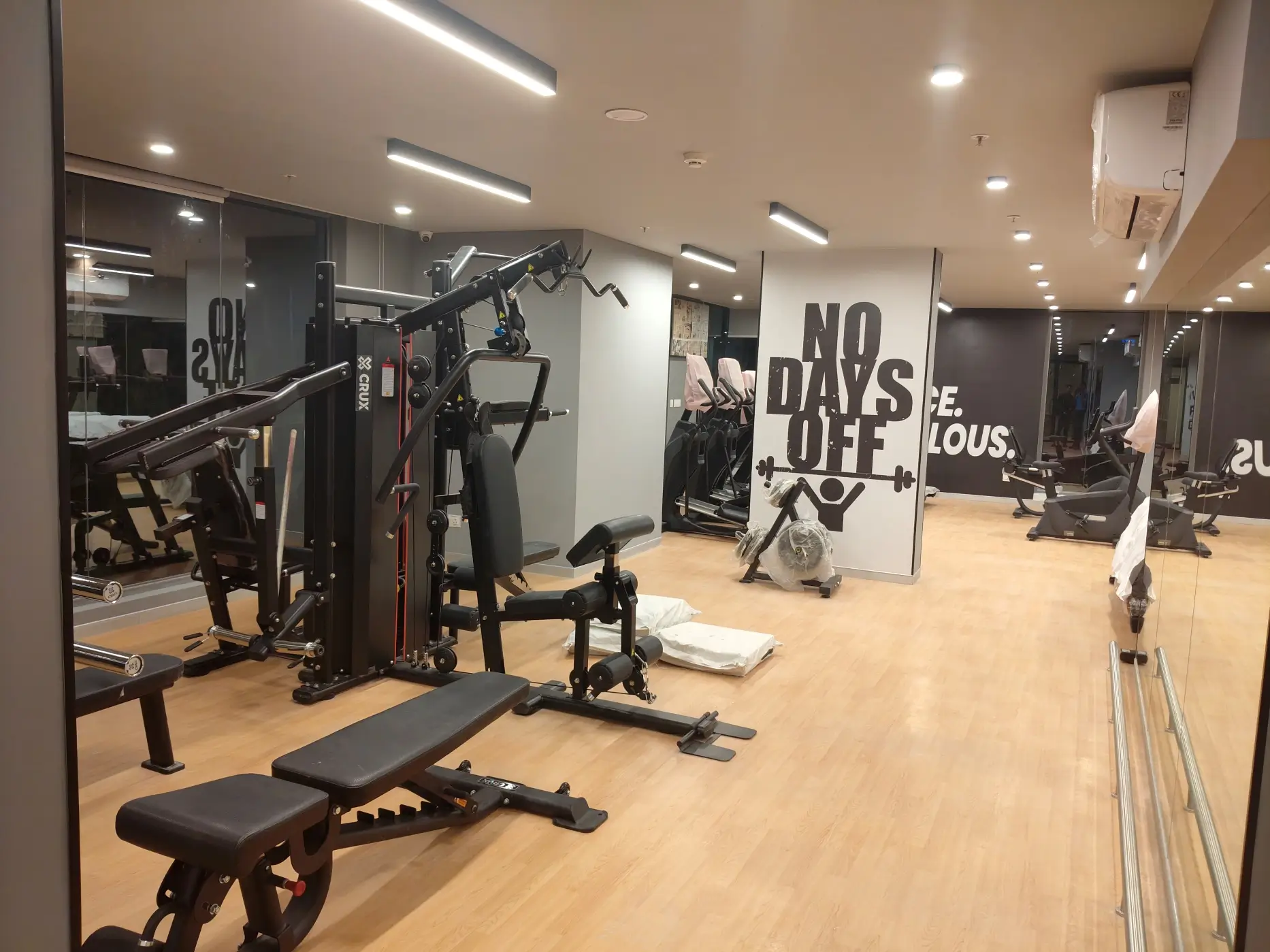

Clubhouse – Indoor Gym - Oct 2025

Club house external painting work completed - Oct 2025

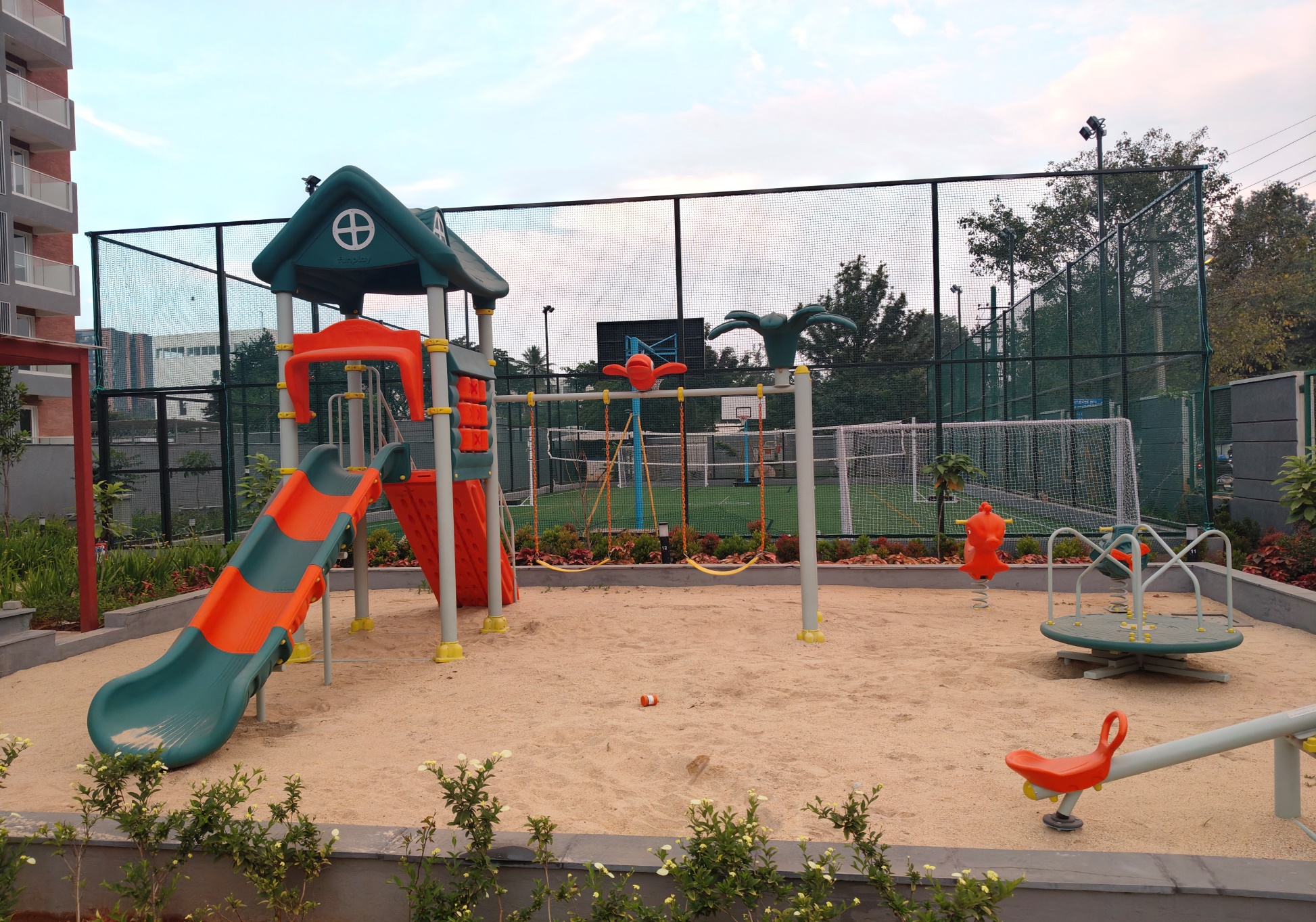

Kids play area works completed - Oct 2025

Clubhouse – E Game Room - Oct 2025

Clubhouse – Reception - Oct 2025

Outdoor gym work completed - Oct 2025

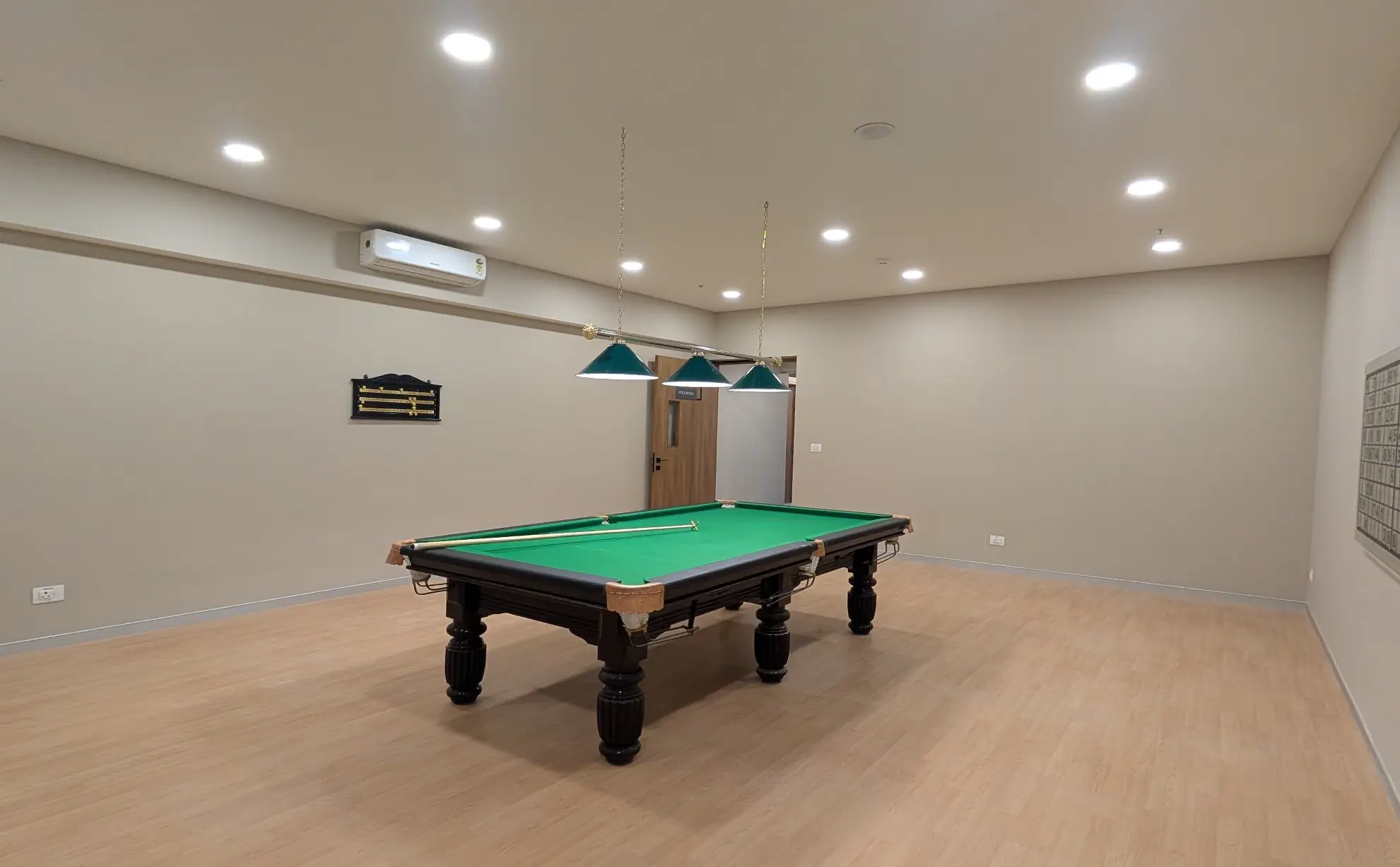

Clubhouse – Pool Room - Oct 2025

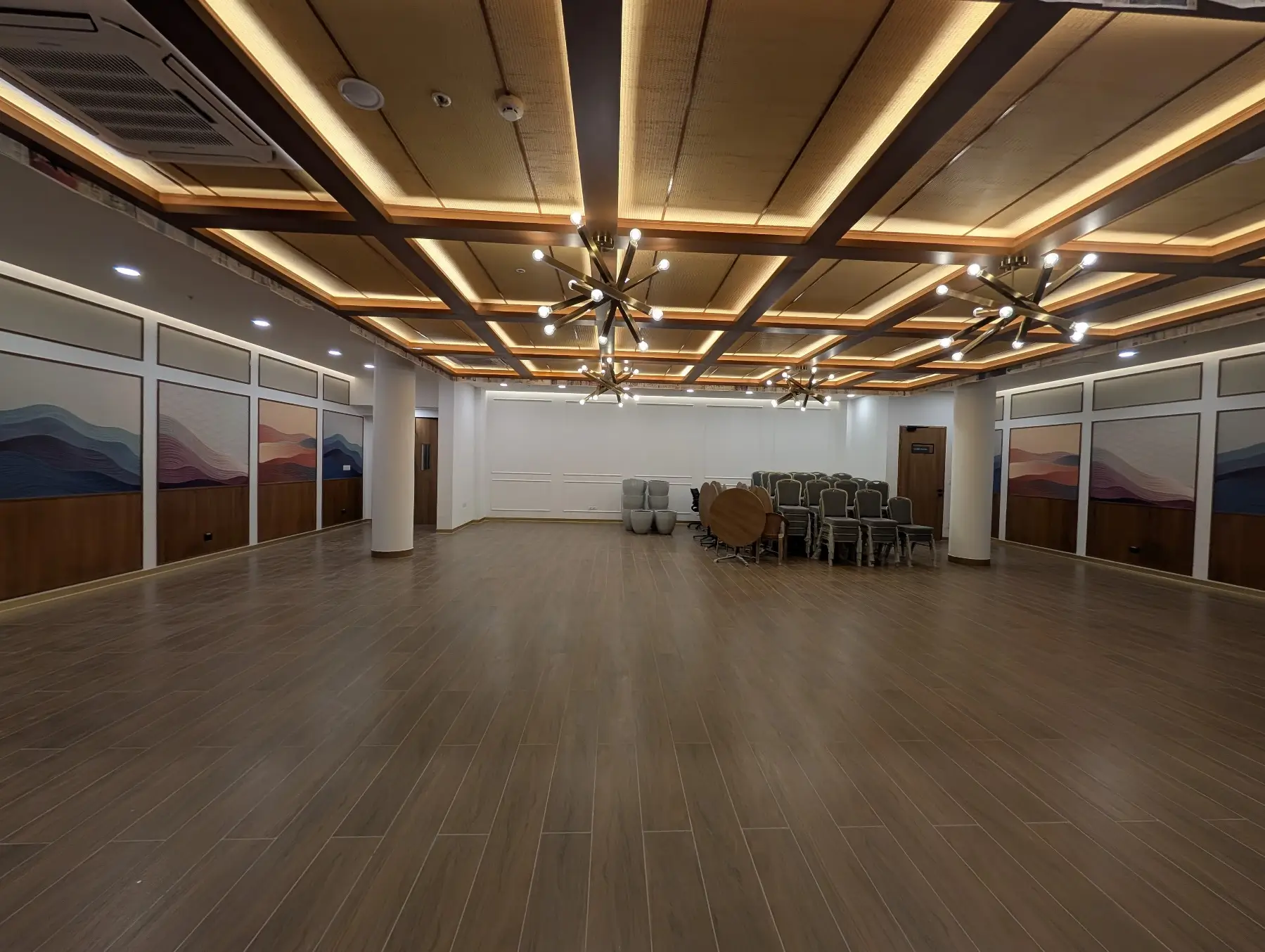

Clubhouse – Multipurpose hall - Oct 2025

Swimming pool water commissioning completed - Sep 2025

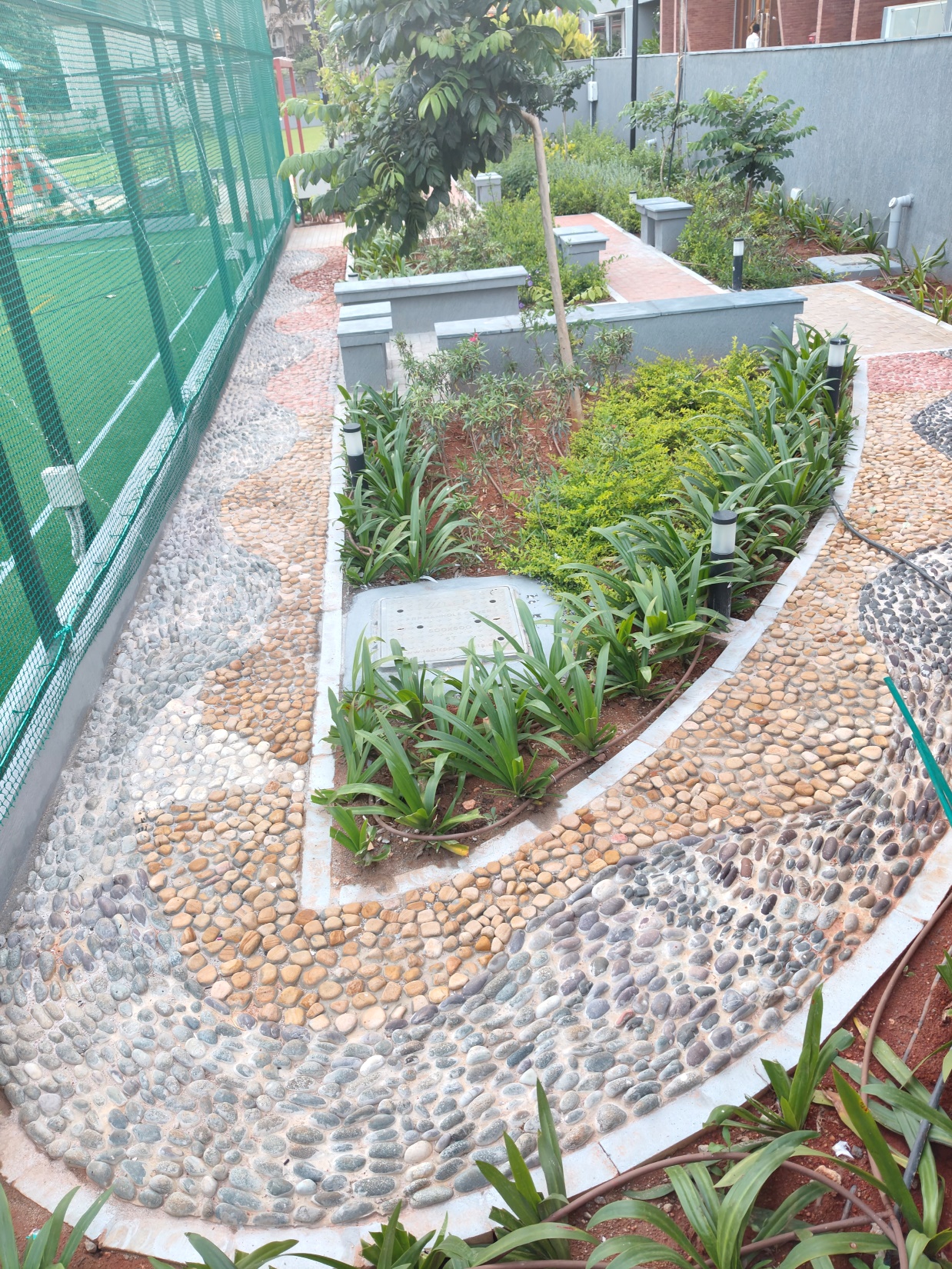

Reflexology pathway work completed - Sep 2025

Club house external painting work completed - Sep 2025

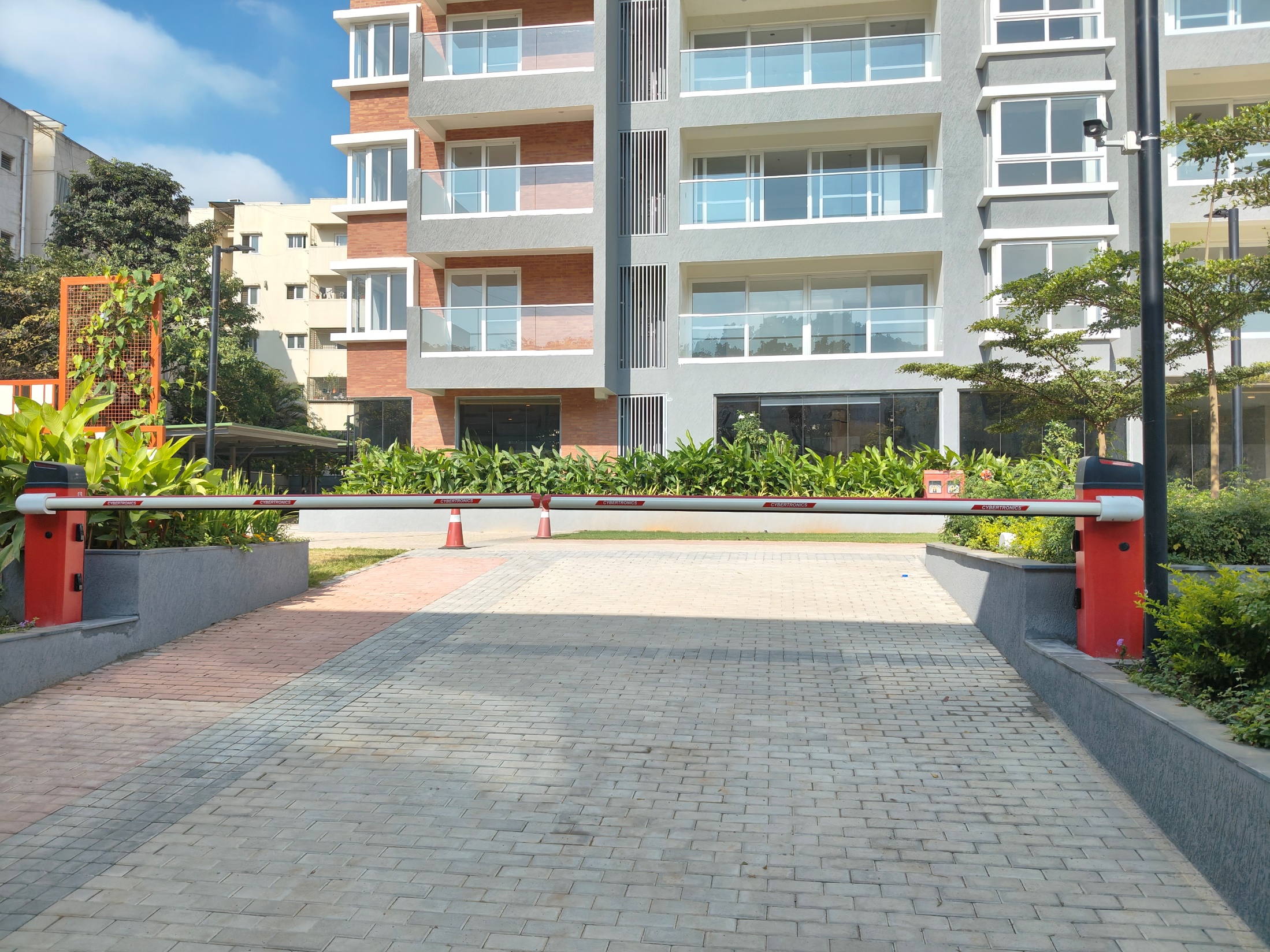

Boom barrier installation work completed - Sep 2025

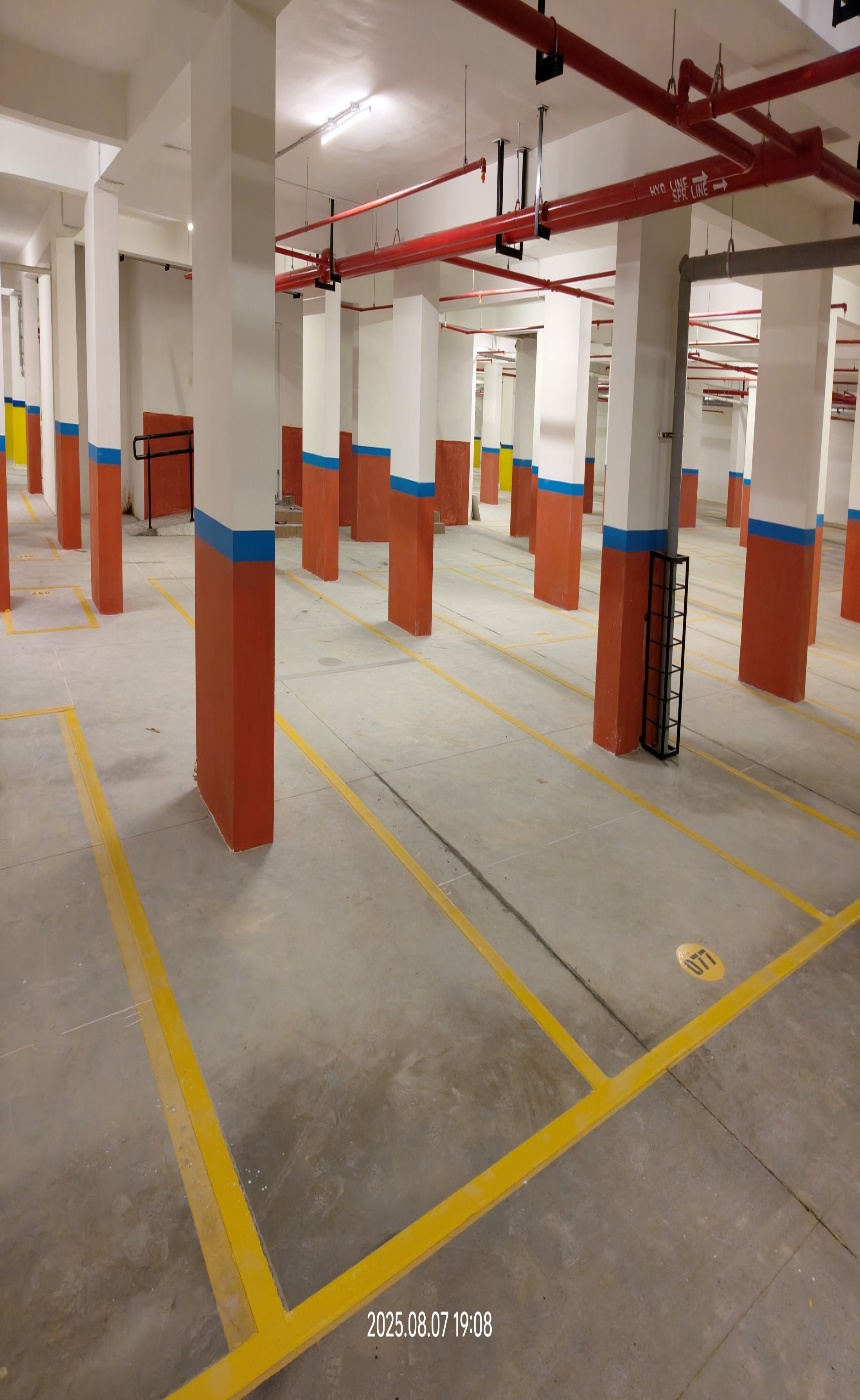

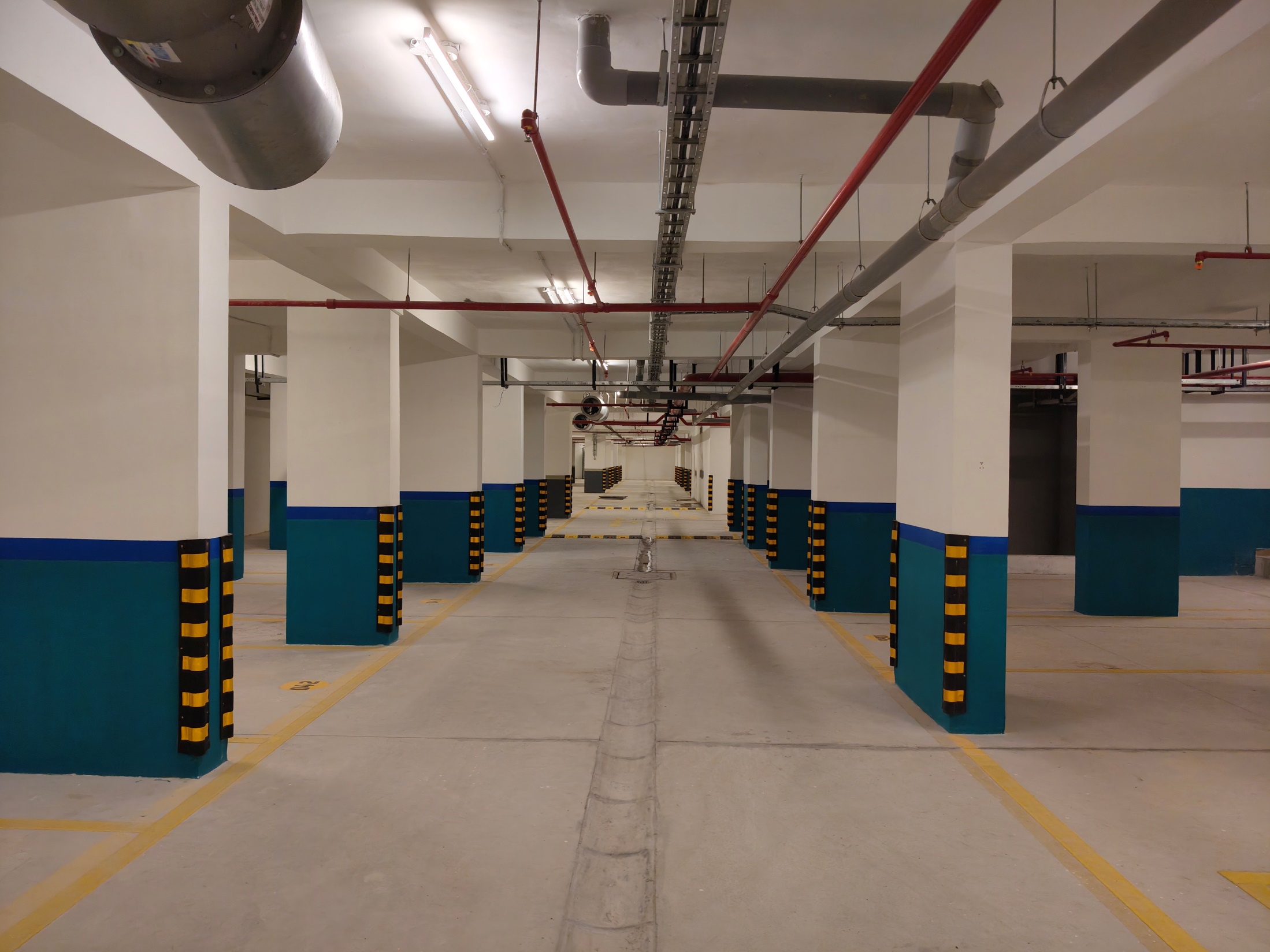

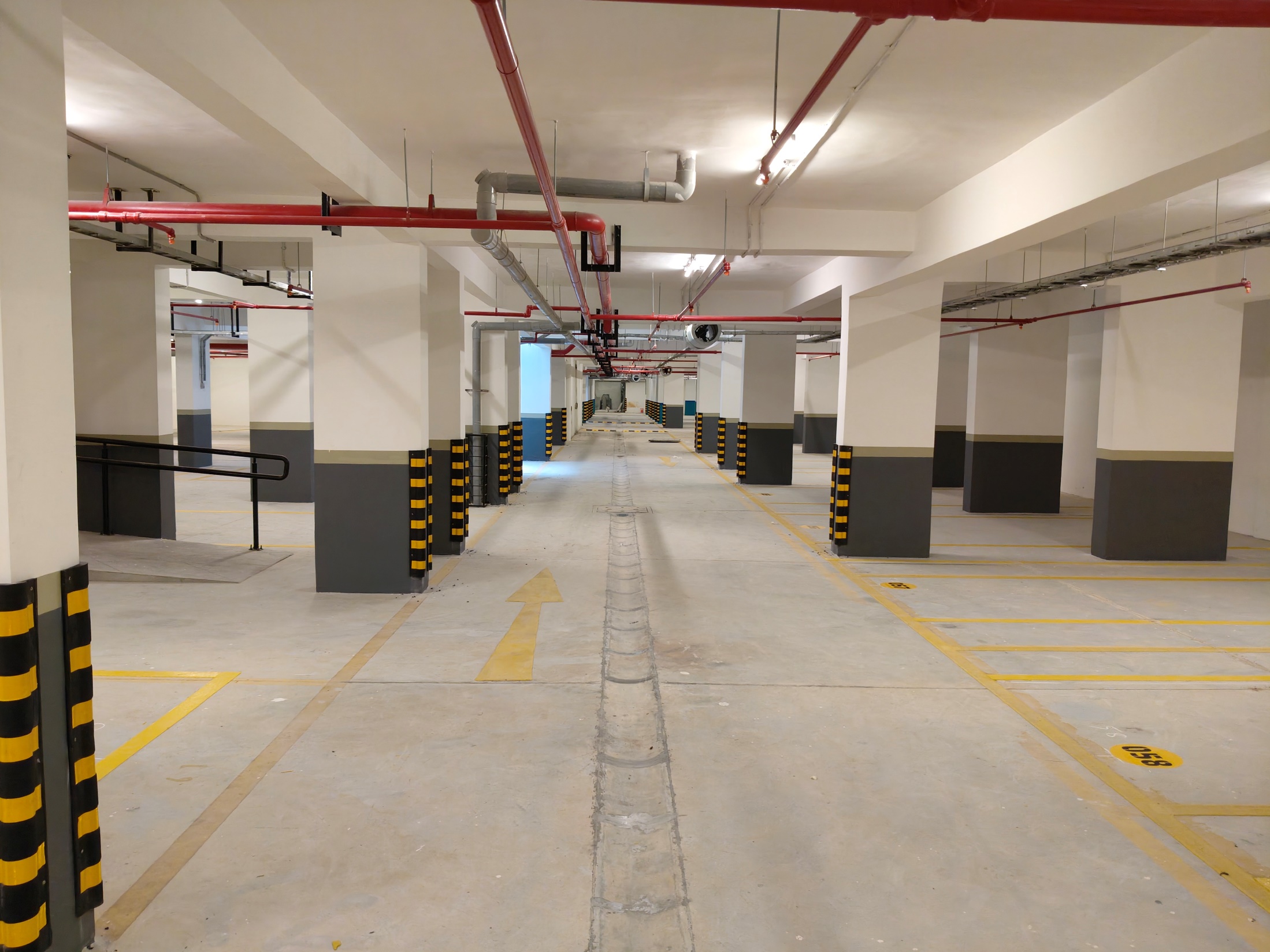

Basement painting & parking marking completed - Sep 2025

EV Charging shed work completed - Sep 2025

Basement painting & parking marking completed - Sep 2025

Basement painting & parking marking completed - Sep 2025

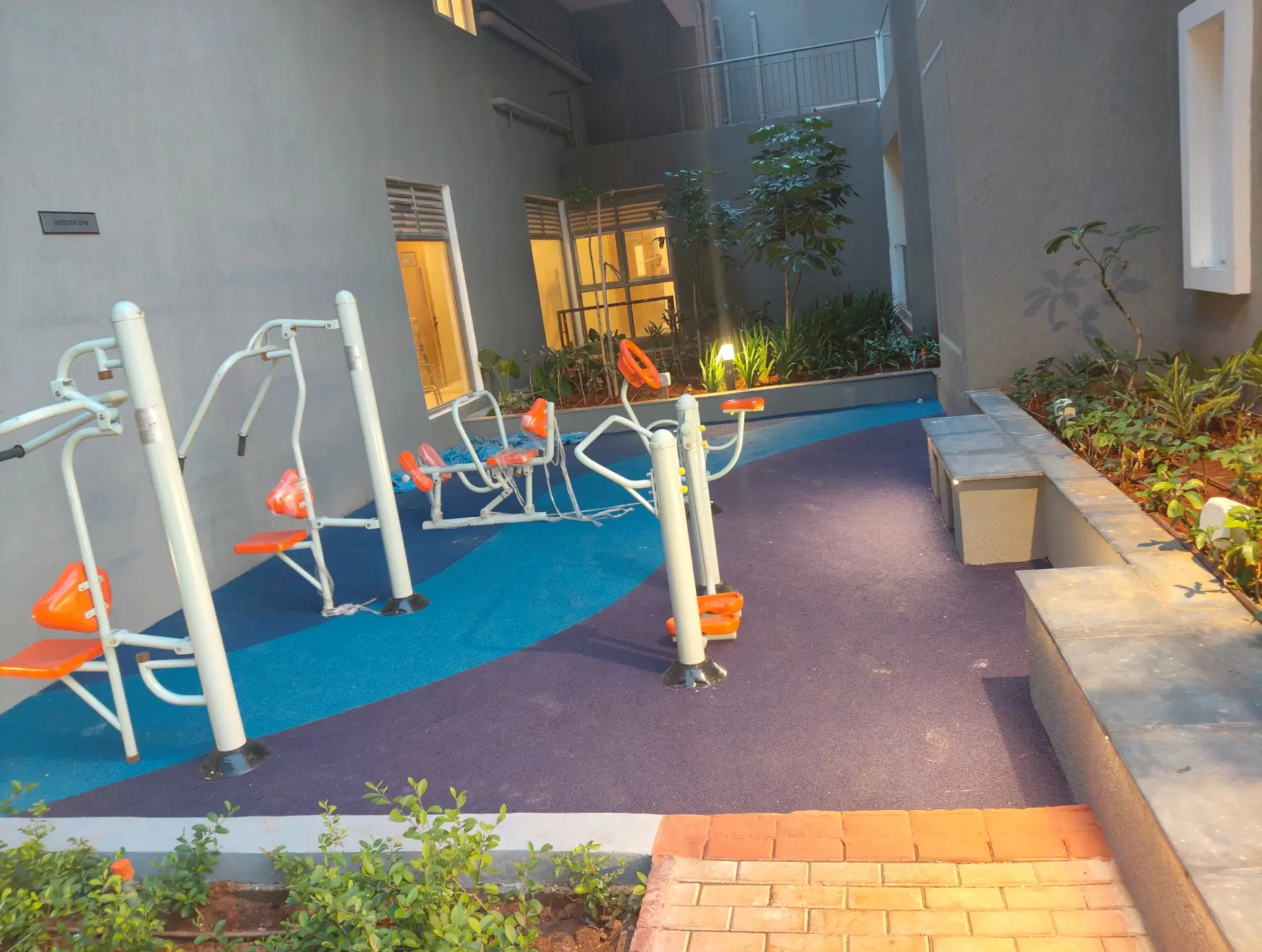

Outdoor gym EPDM flooring work completed - Sep 2025

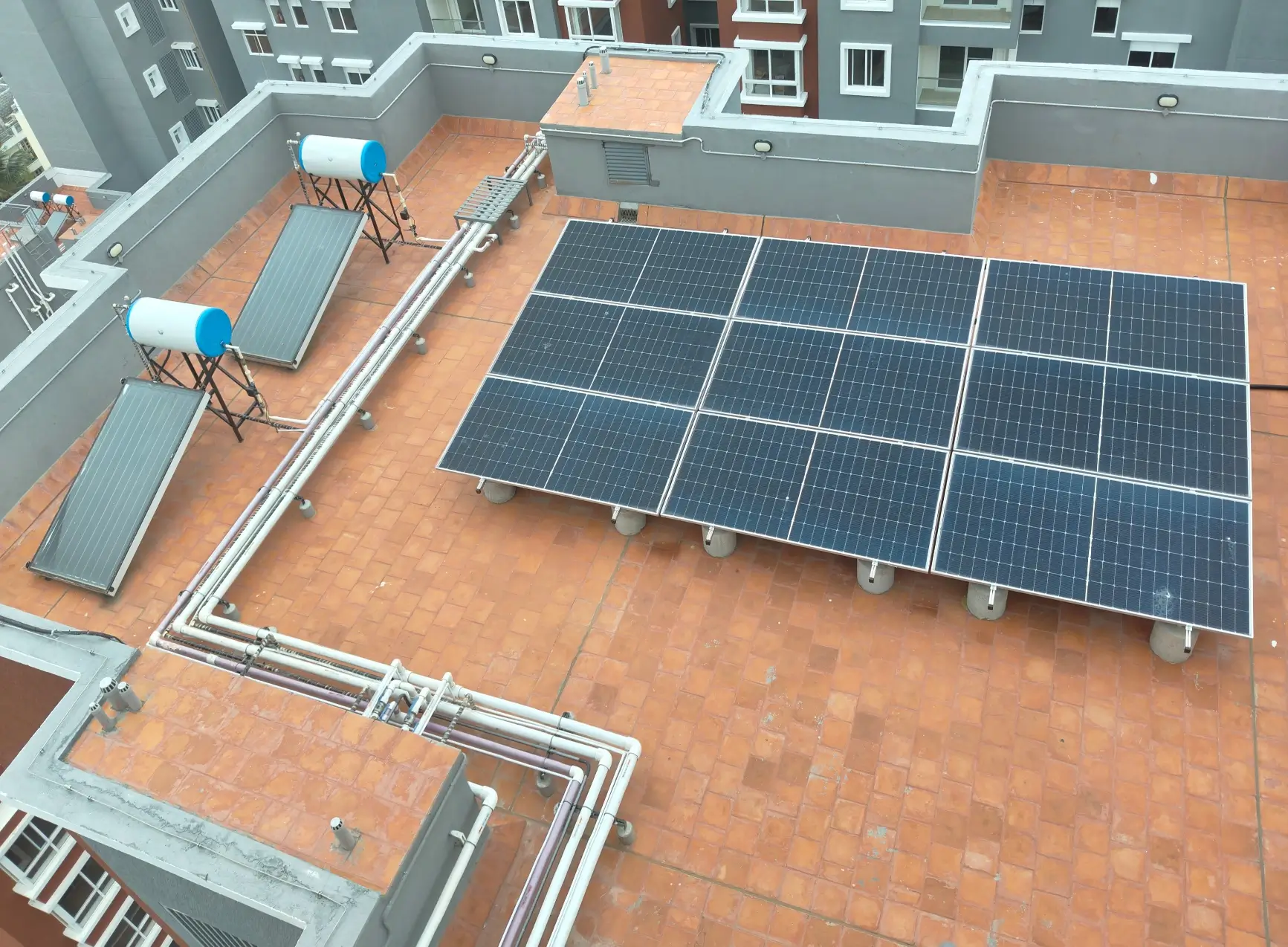

Terrace solar panel commissioning completed - Sep 2025

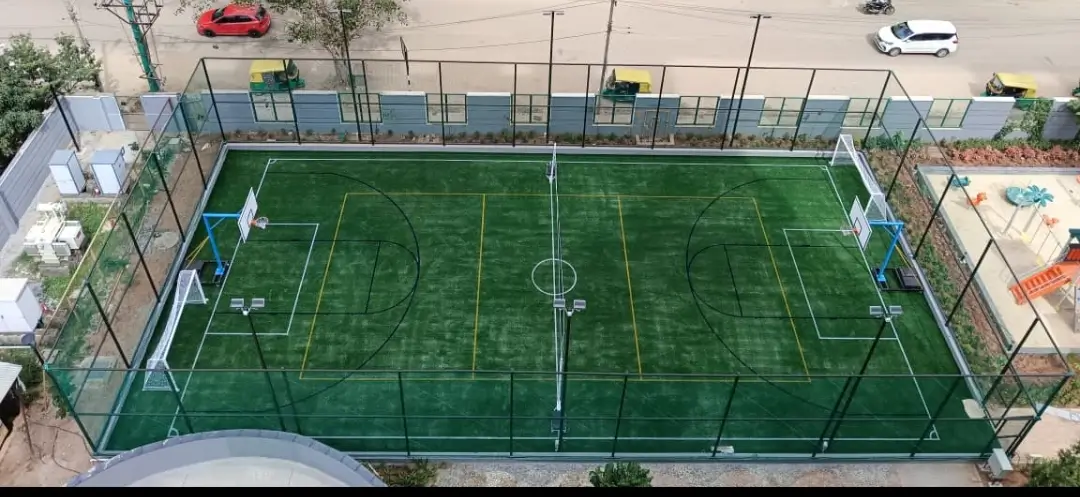

Multipurpose court work completed - Sep 2025

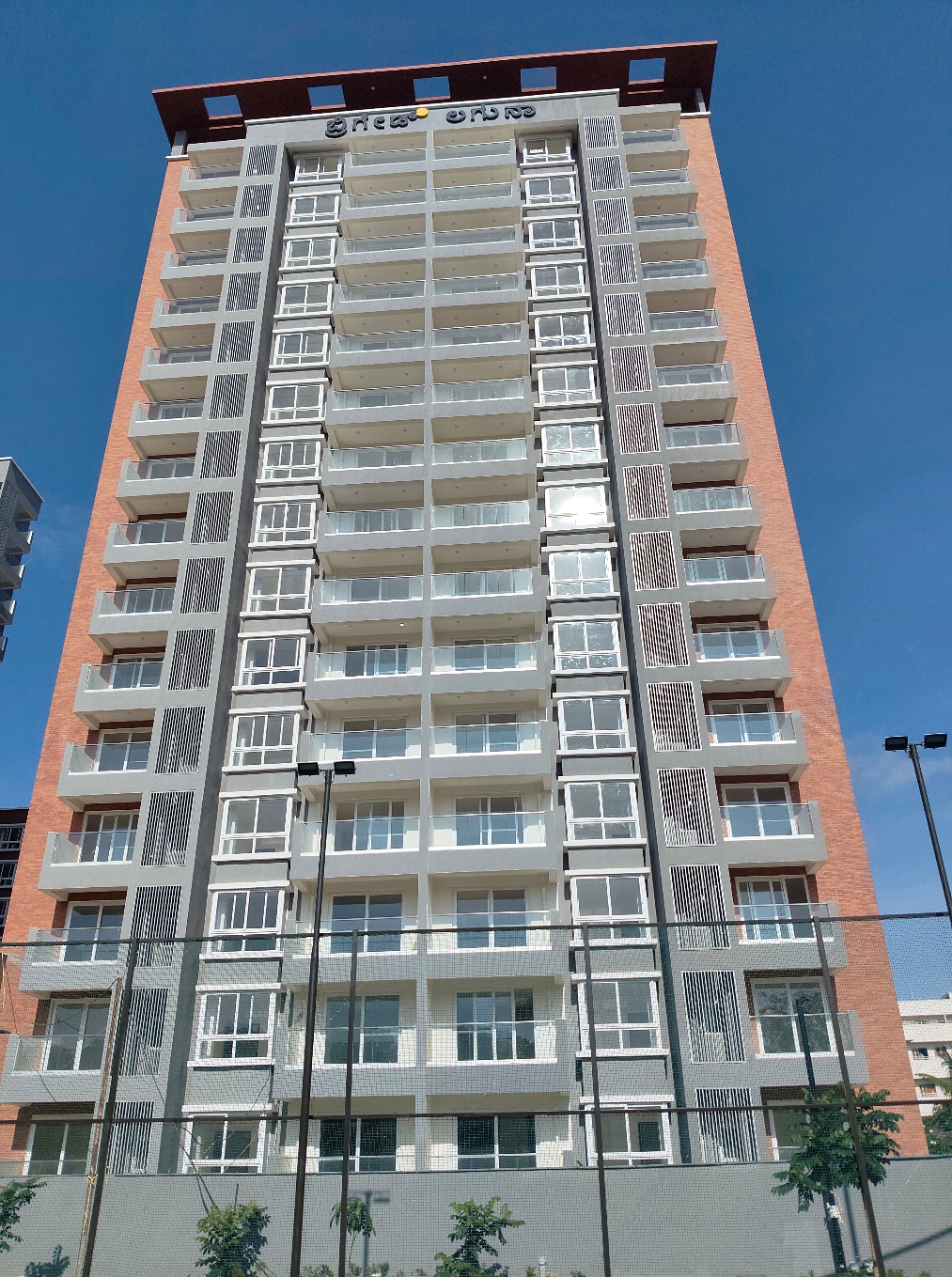

Tower D External painting completed - Aug 2025

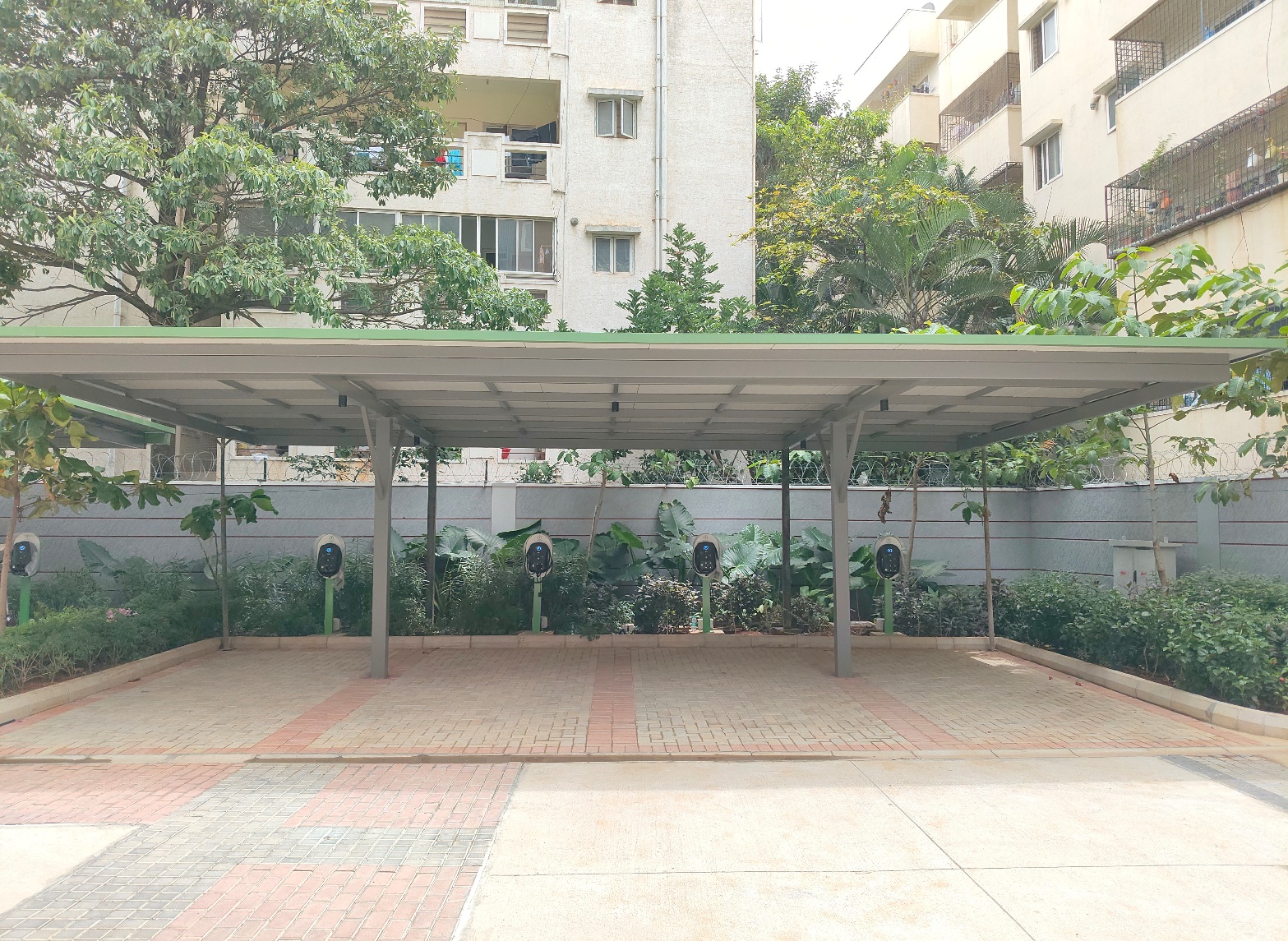

East side elevation - Aug 2025

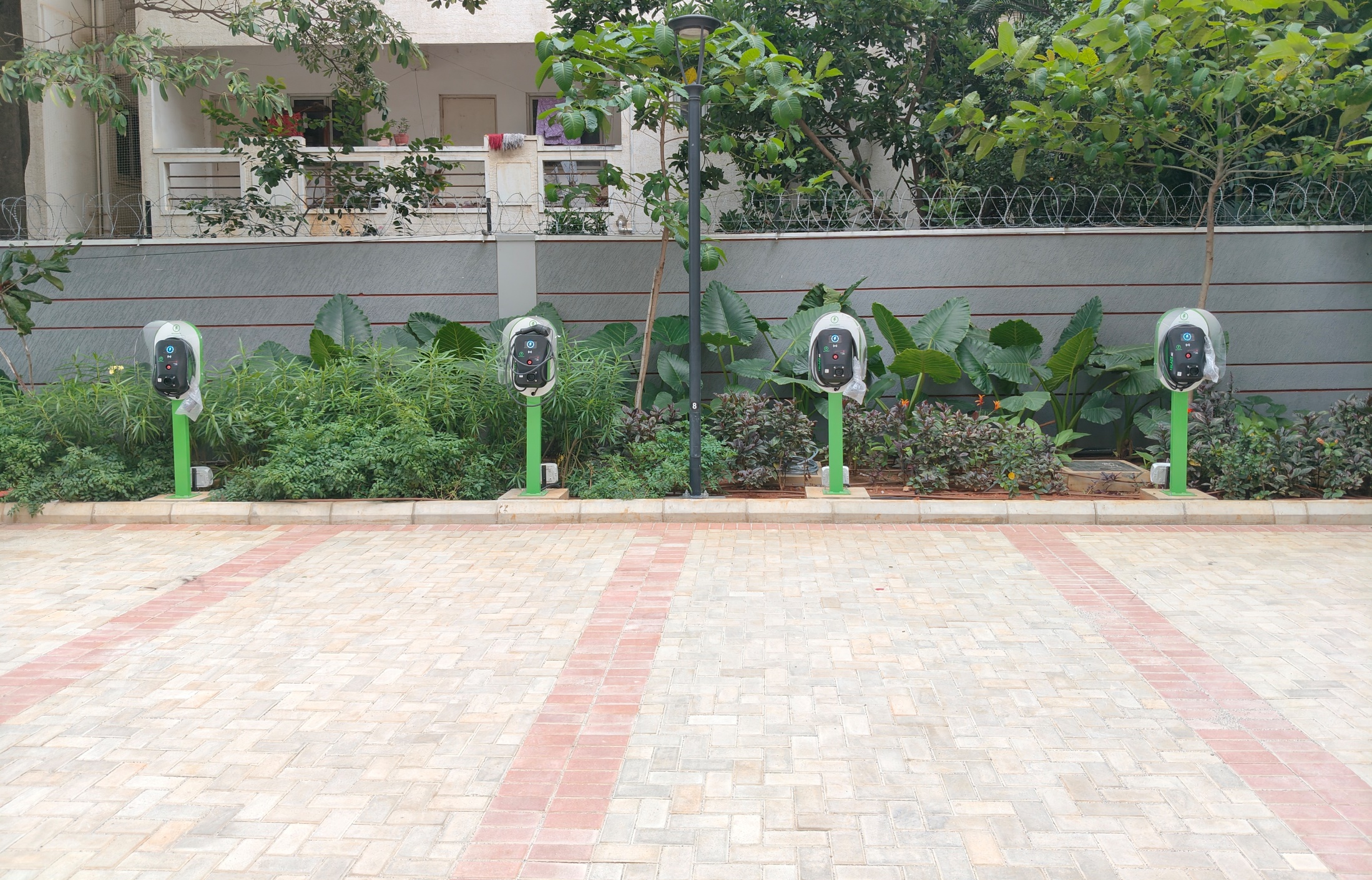

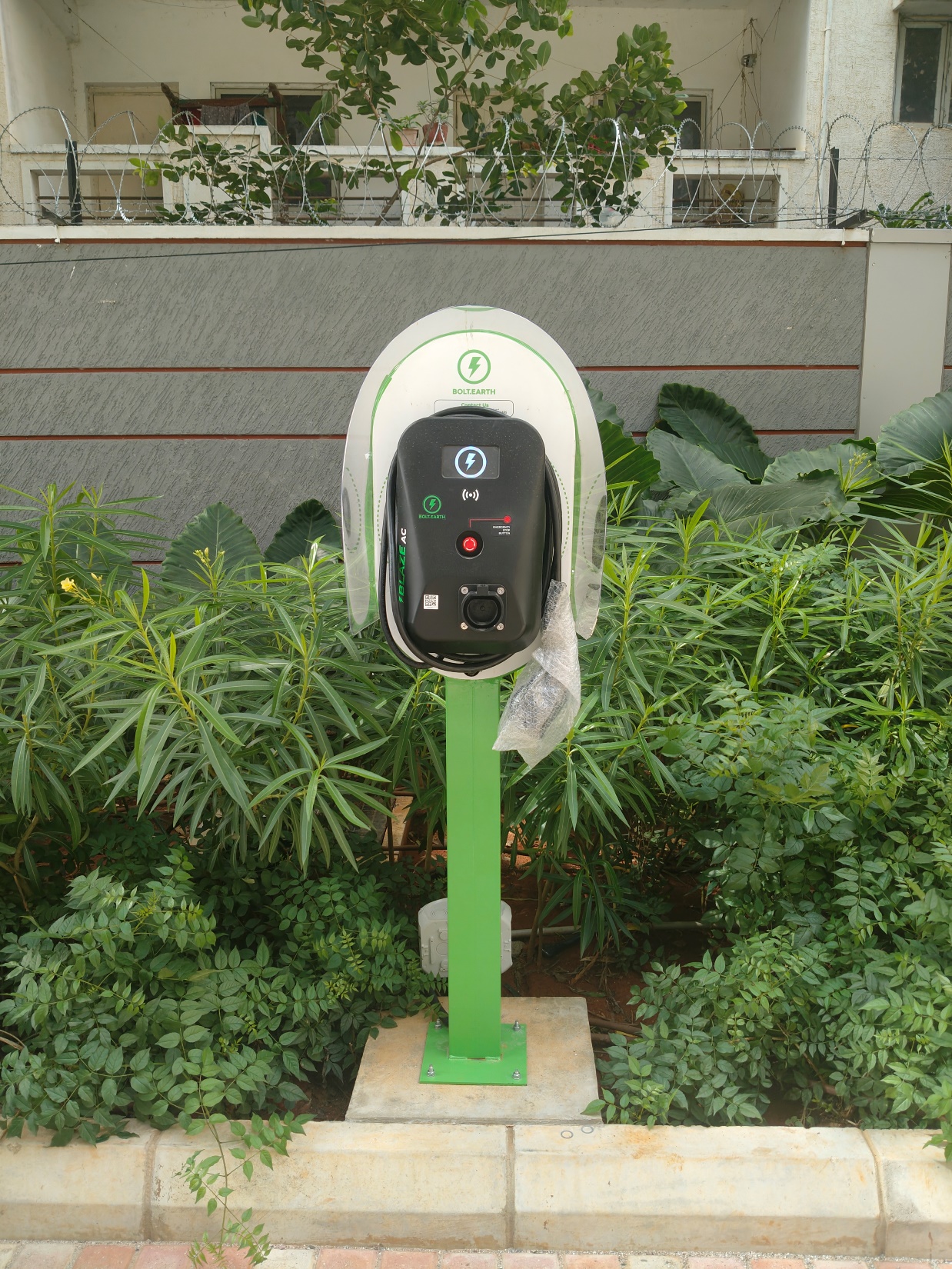

EV Charging facility provided - Aug 2025

EV Charging facility provided - Aug 2025

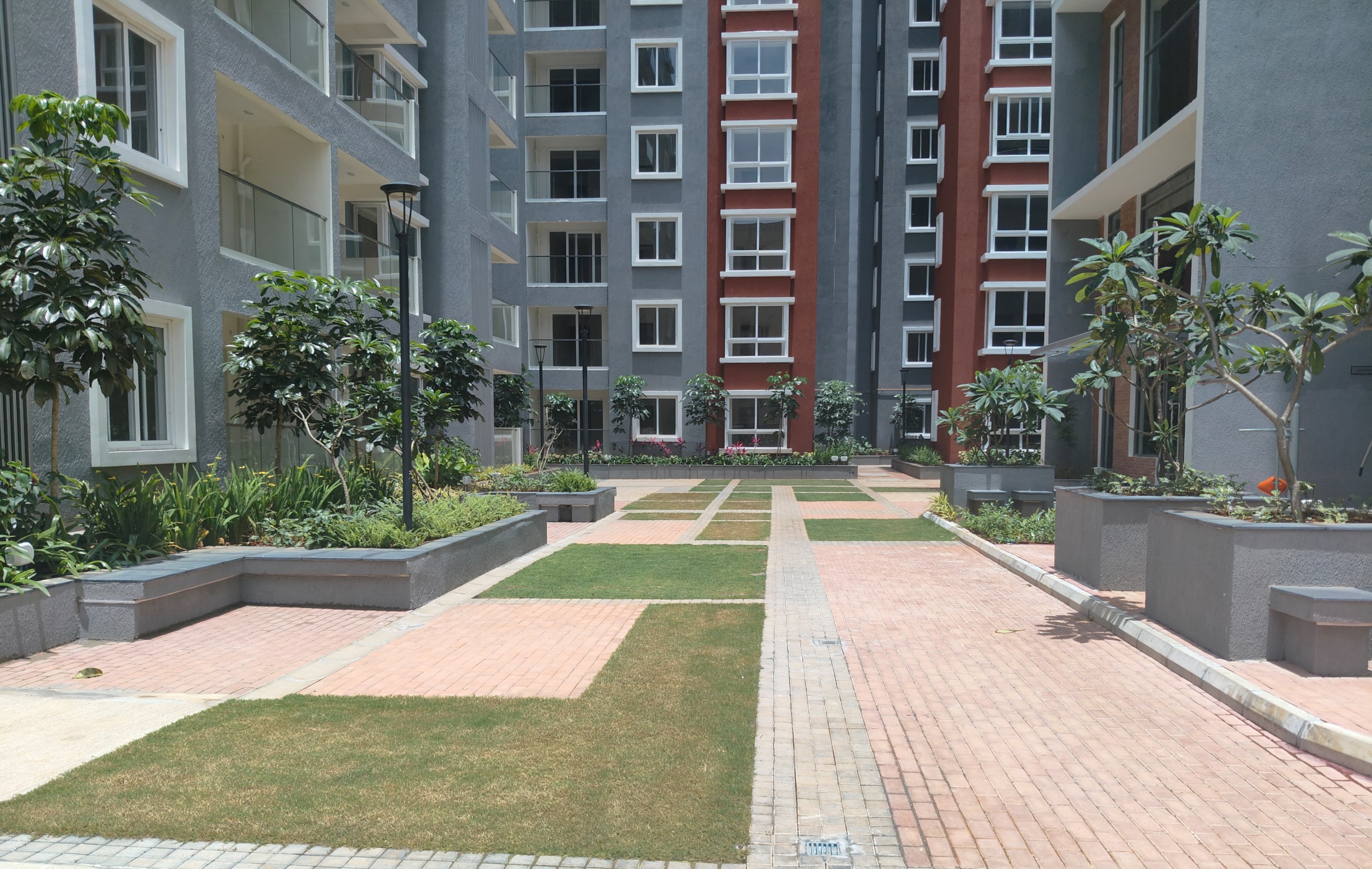

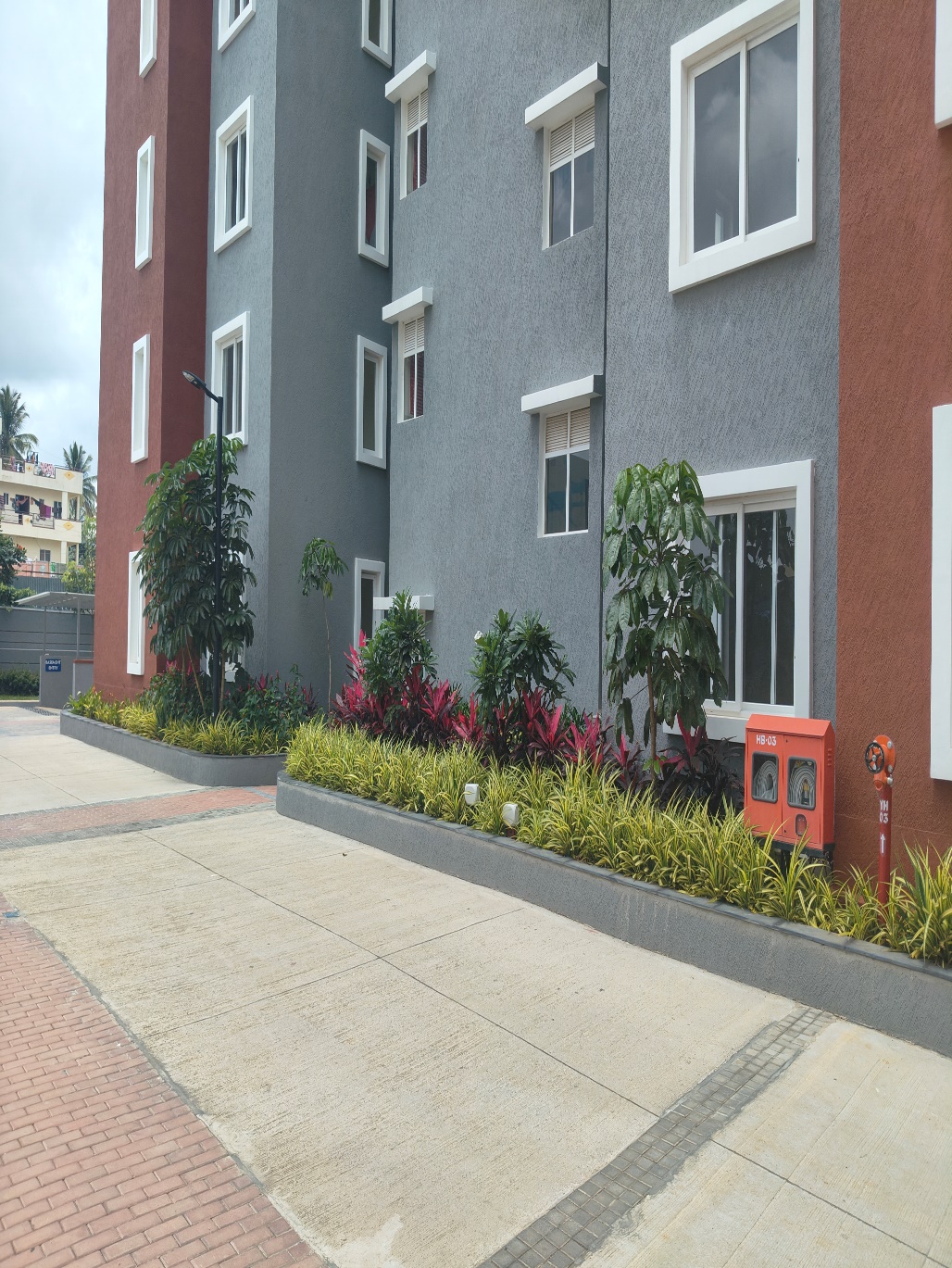

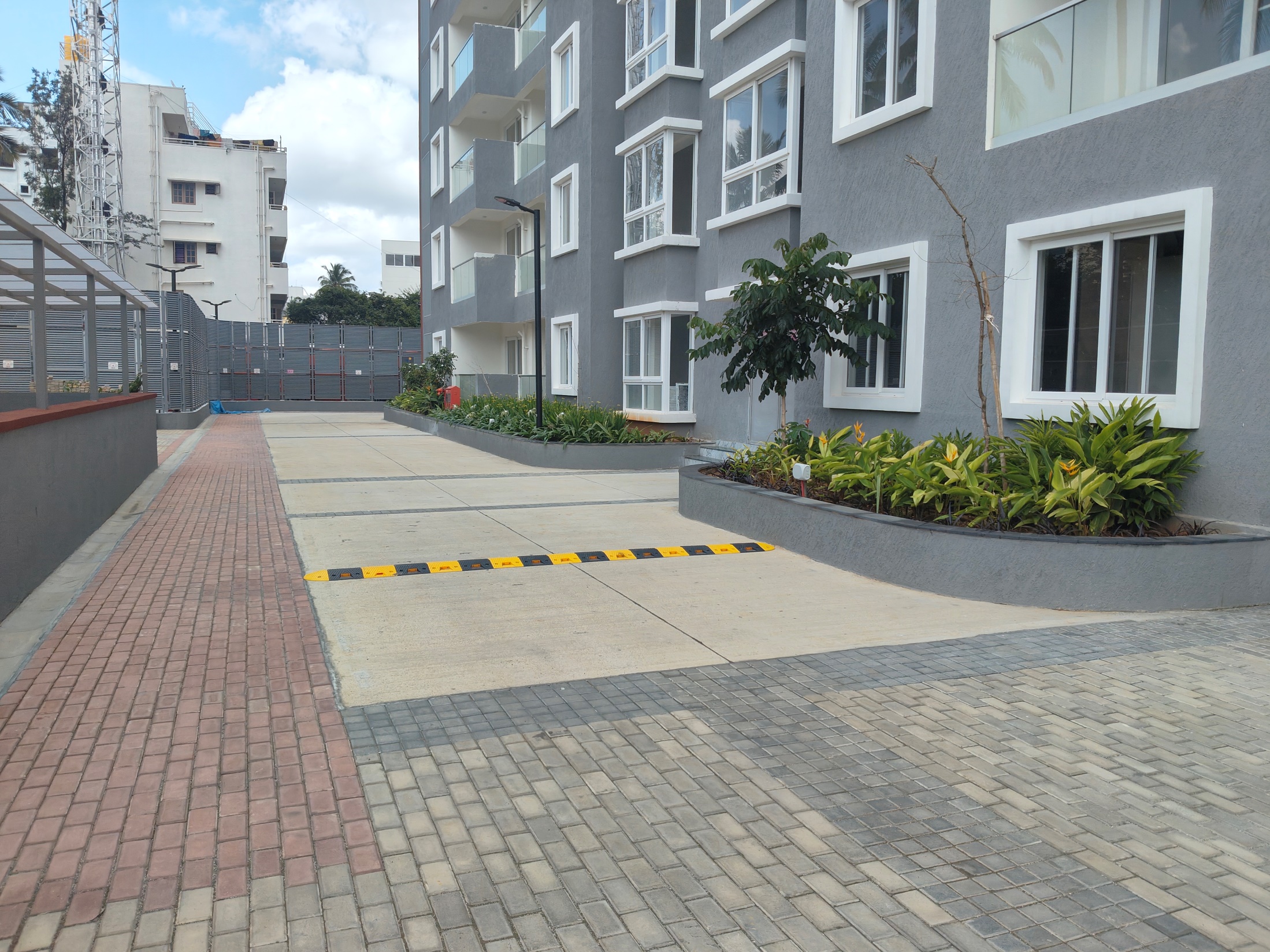

External Development works completed - Aug 2025

External Development works completed - Aug 2025

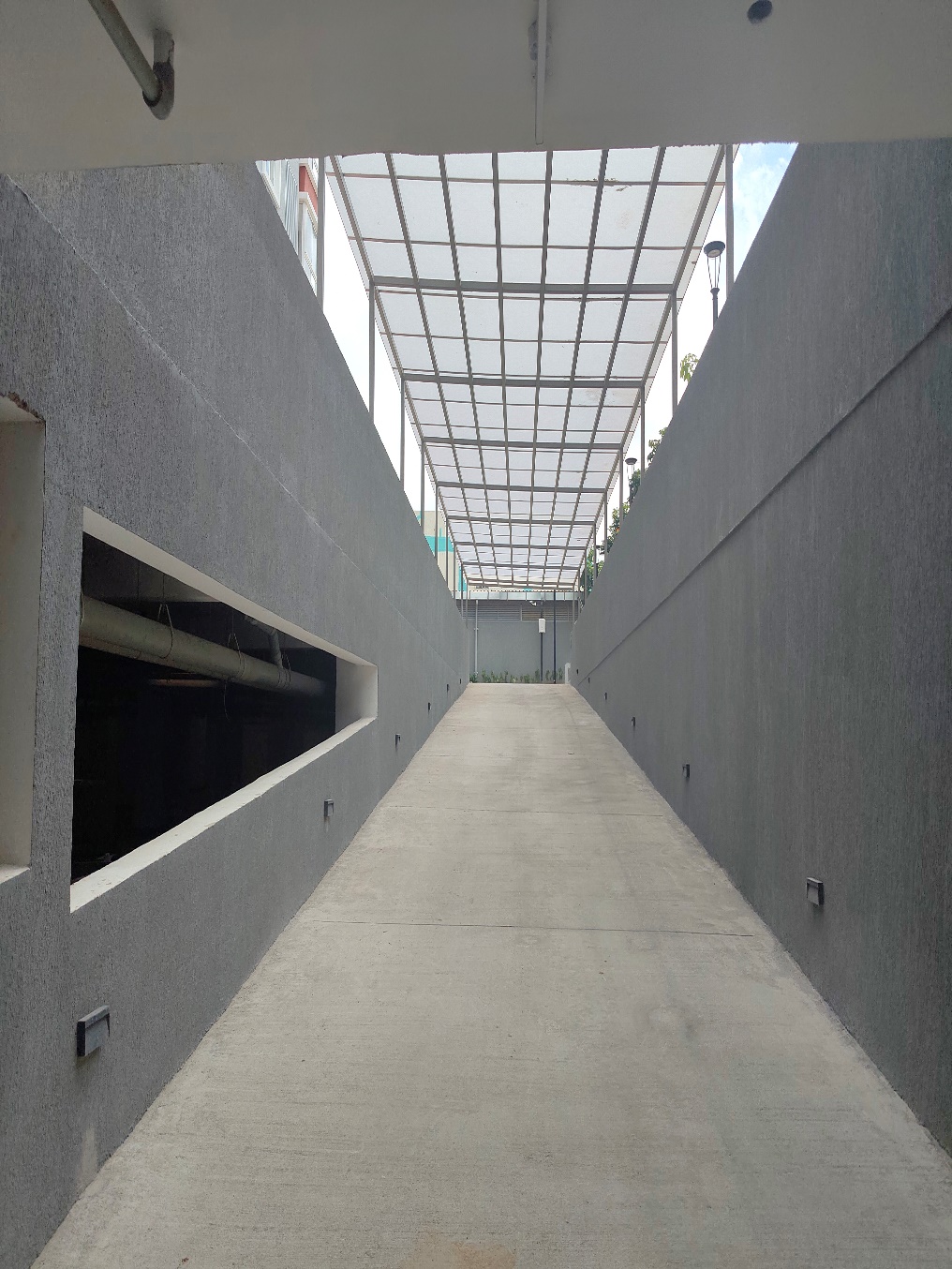

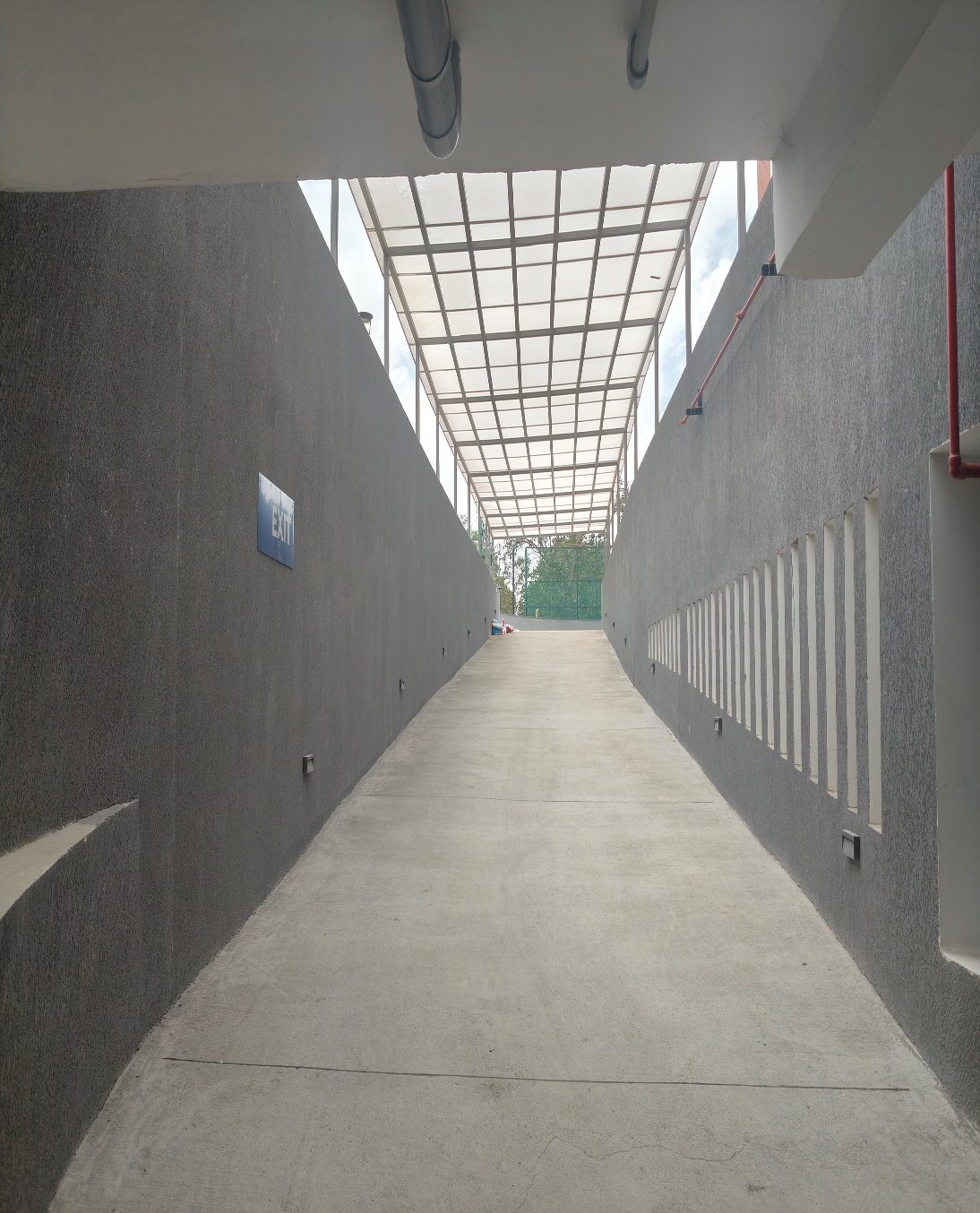

Entry & Exit ramp - Aug 2025

Entry & Exit ramp - Aug 2025

External Development works completed - Aug 2025

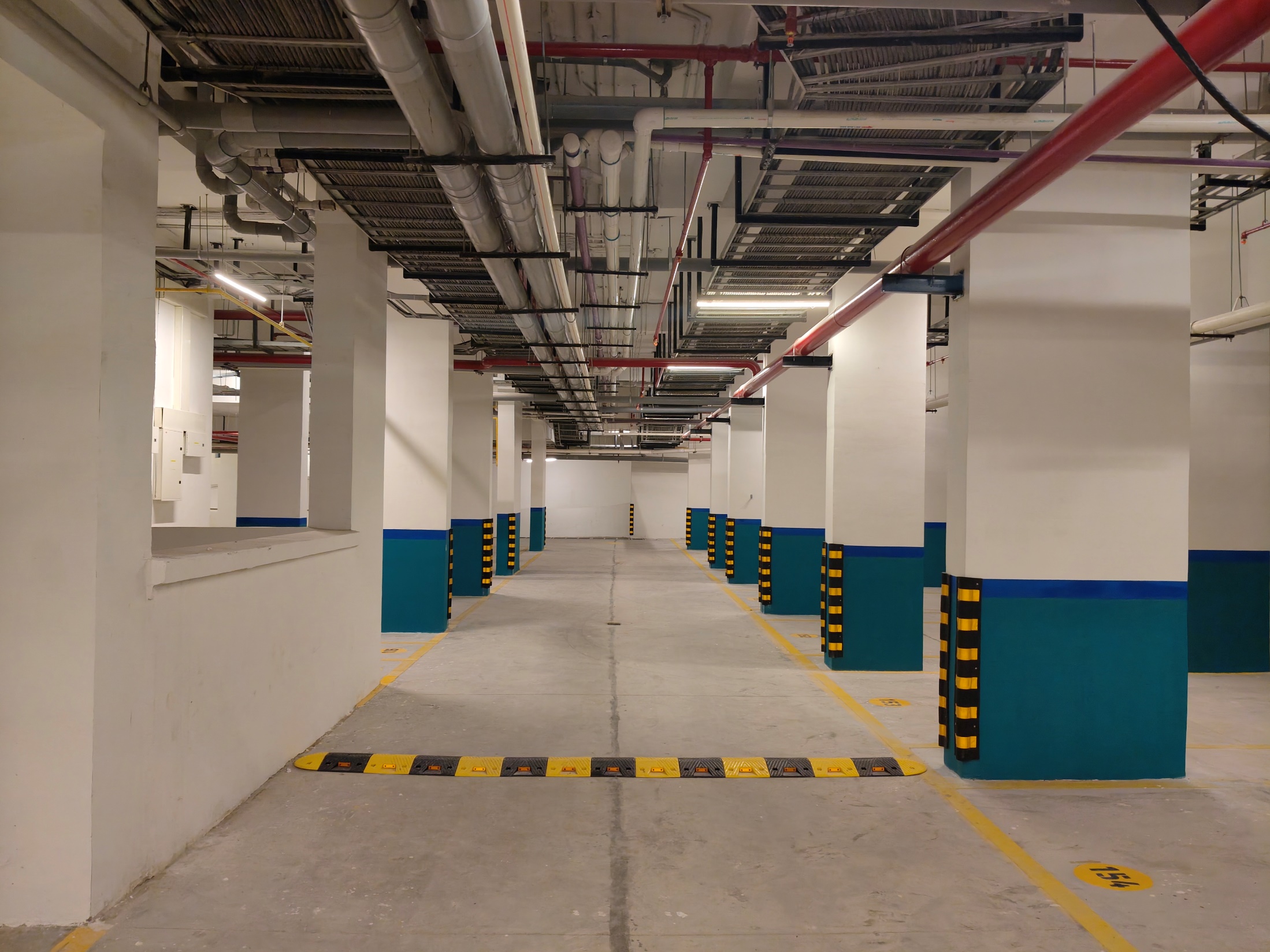

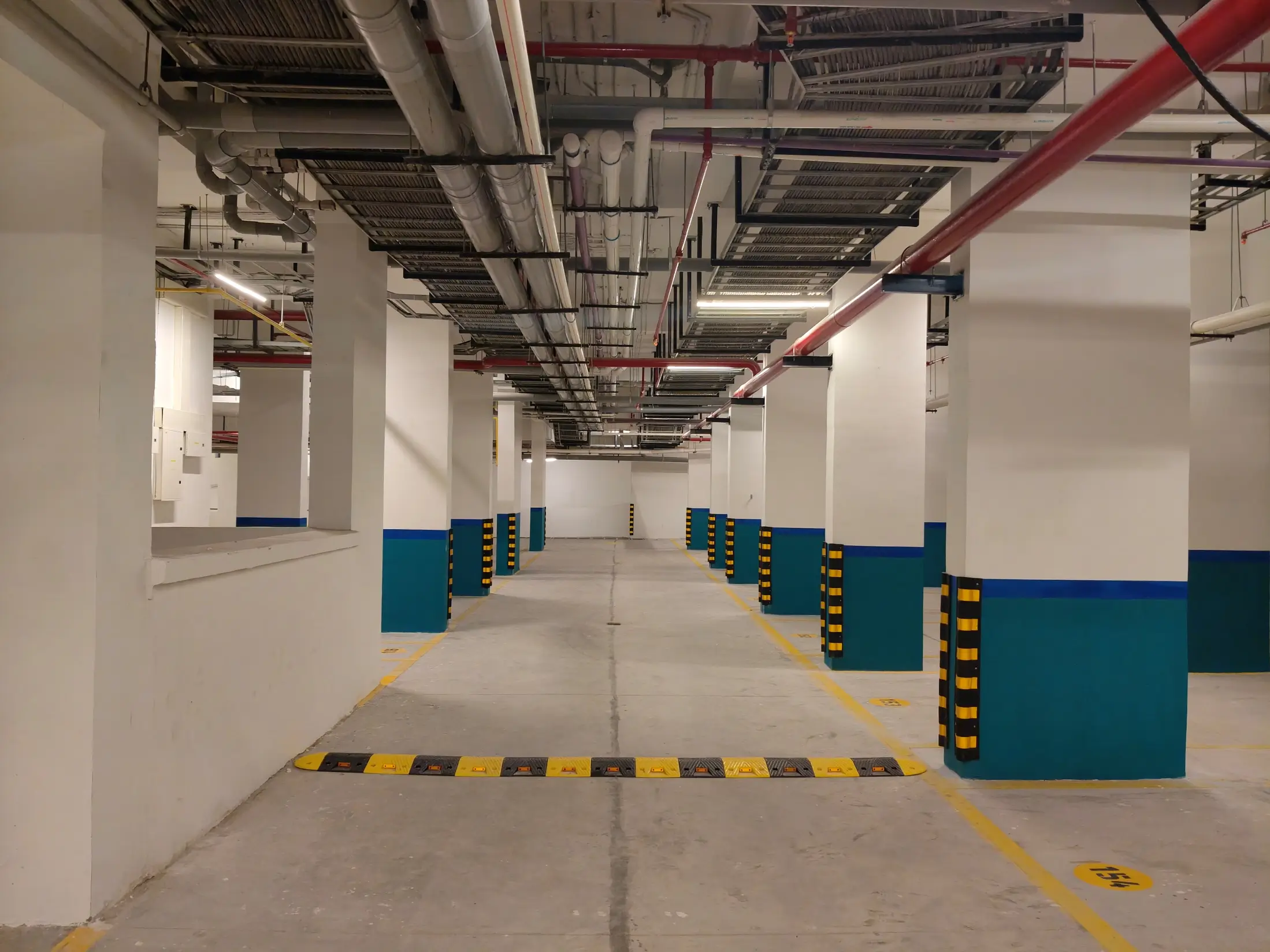

Basement Car parking marking, painting column guard fixing completed - Aug 2025

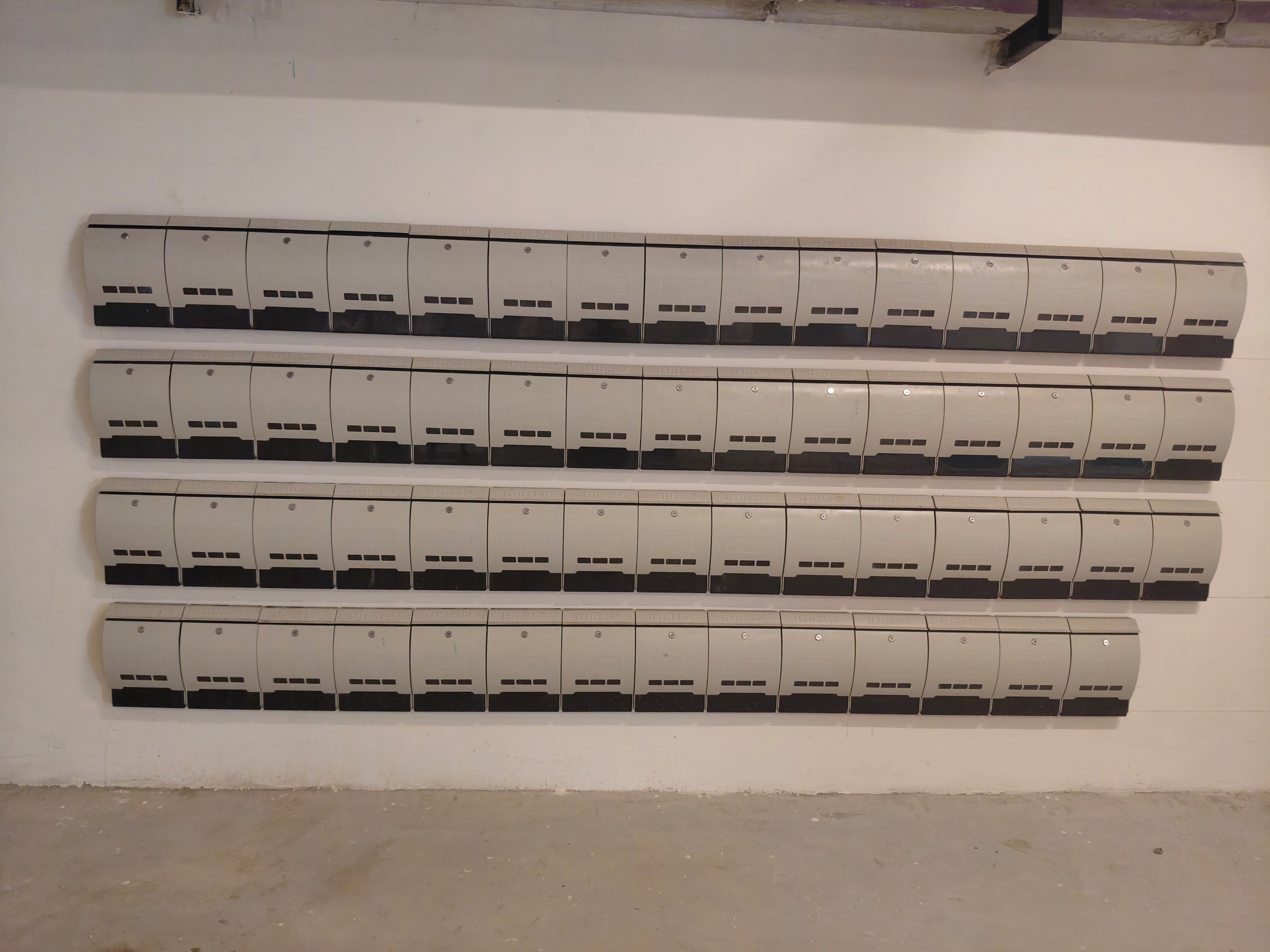

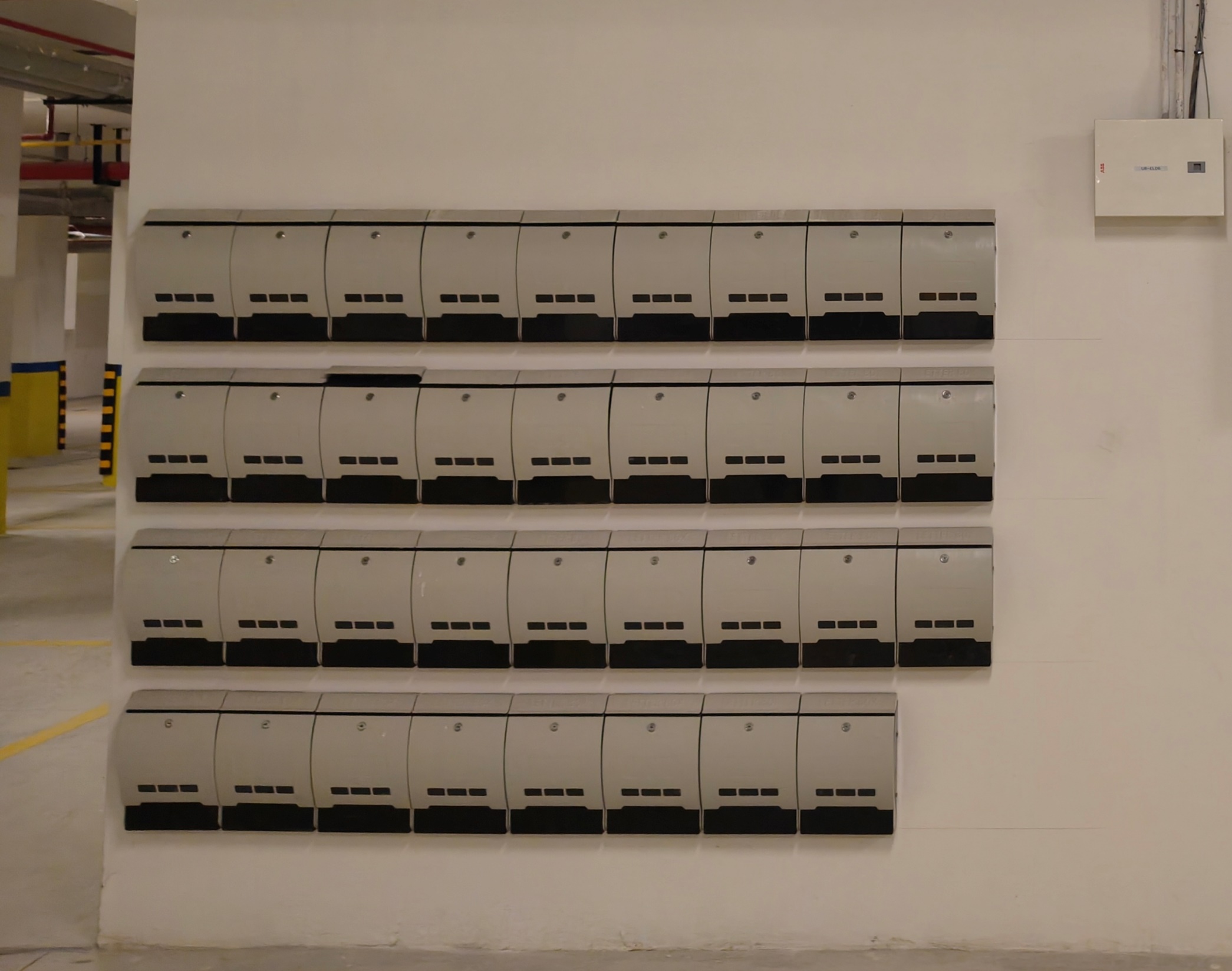

Letter box fixing work completed - Aug 2025

Letter box fixing work completed - Aug 2025

External Development works completed - Aug 2025

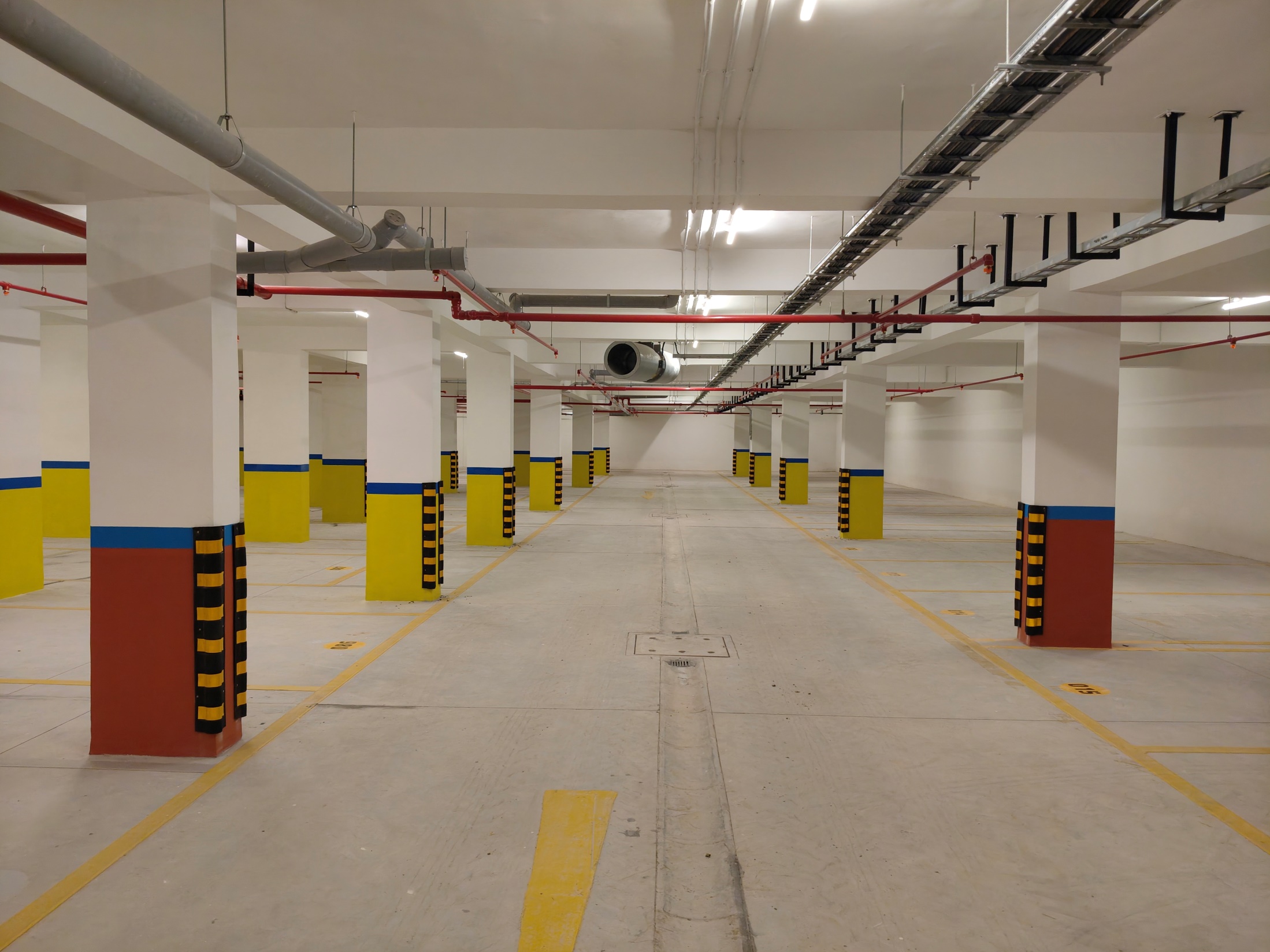

Basement Car parking marking, painting column guard fixing completed - Aug 2025

External Development works completed - Aug 2025

Tower entrance reception area - Aug 2025

Tower entrance reception area - Aug 2025

Tower entrance reception area - Aug 2025

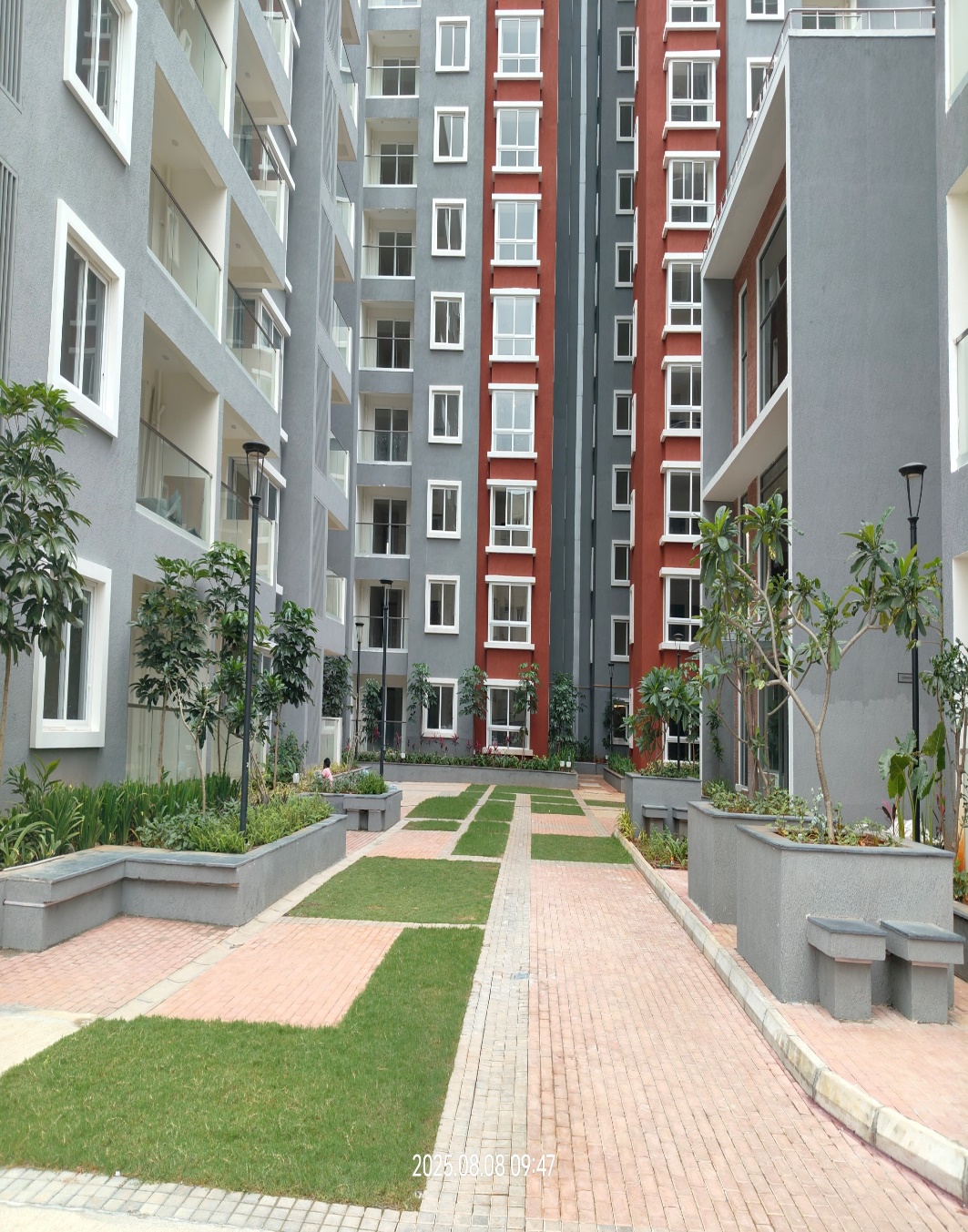

External Development works completed - Aug 2025

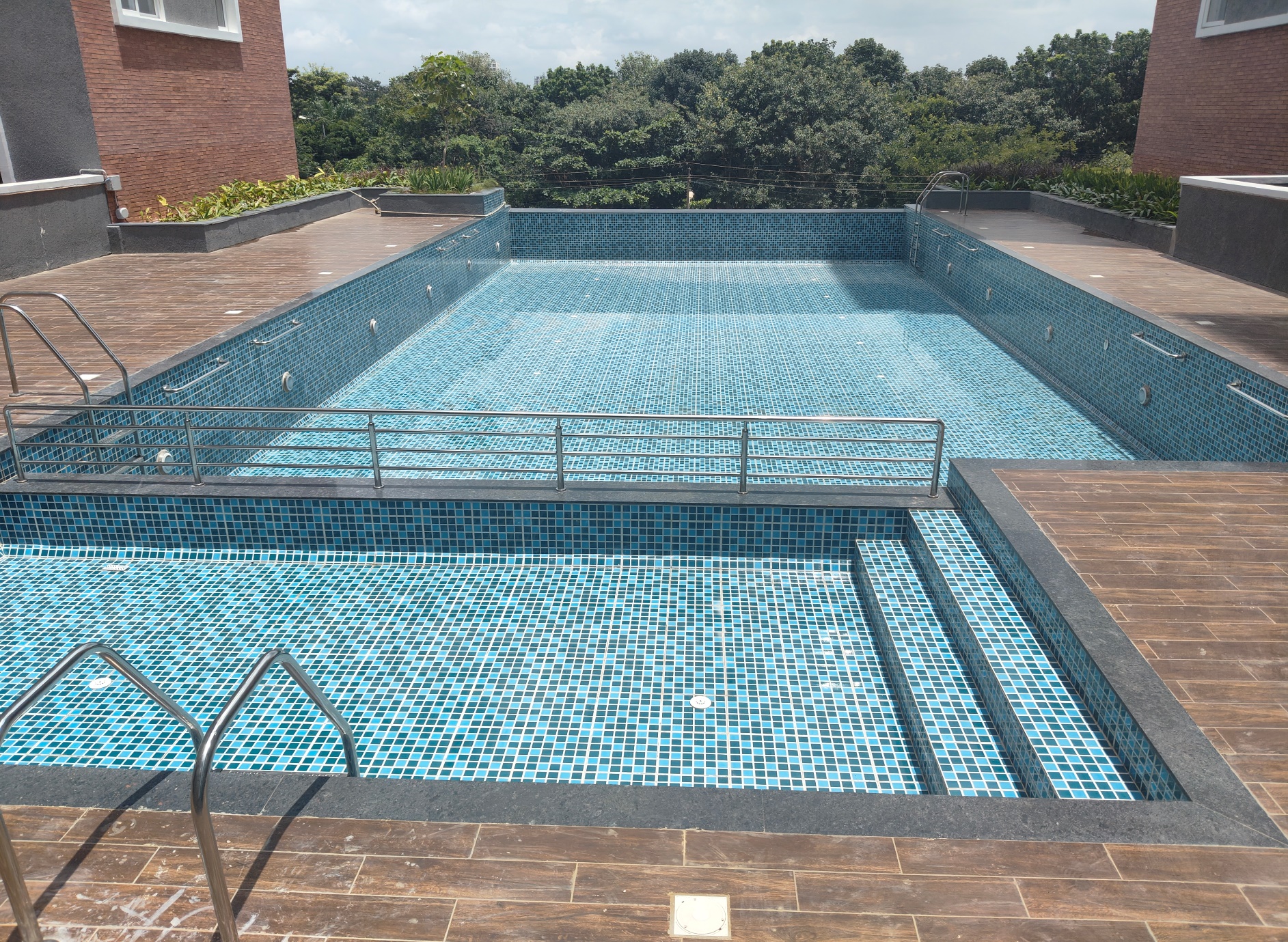

Swimming pool - Finishing work completed - Aug 2025

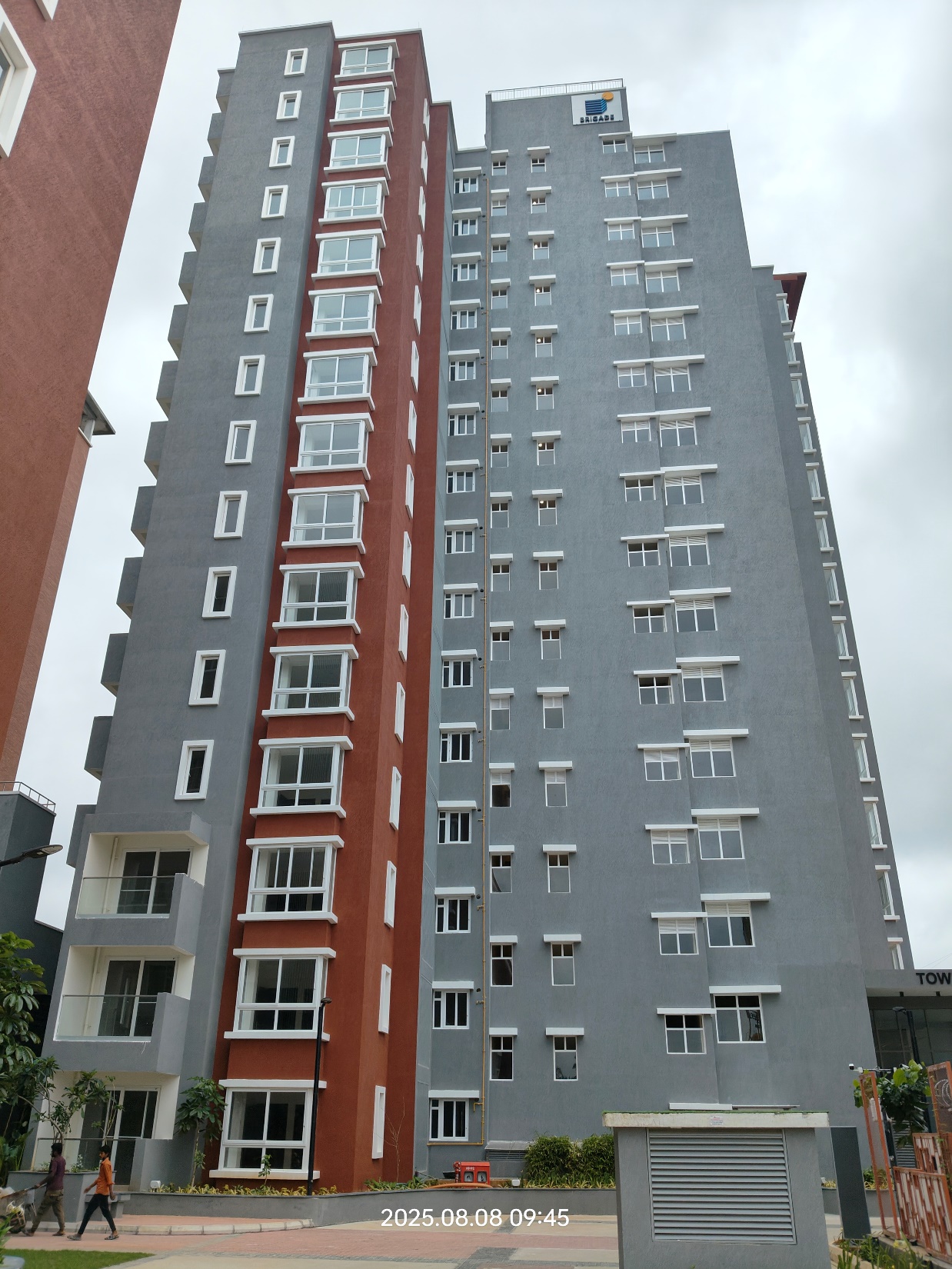

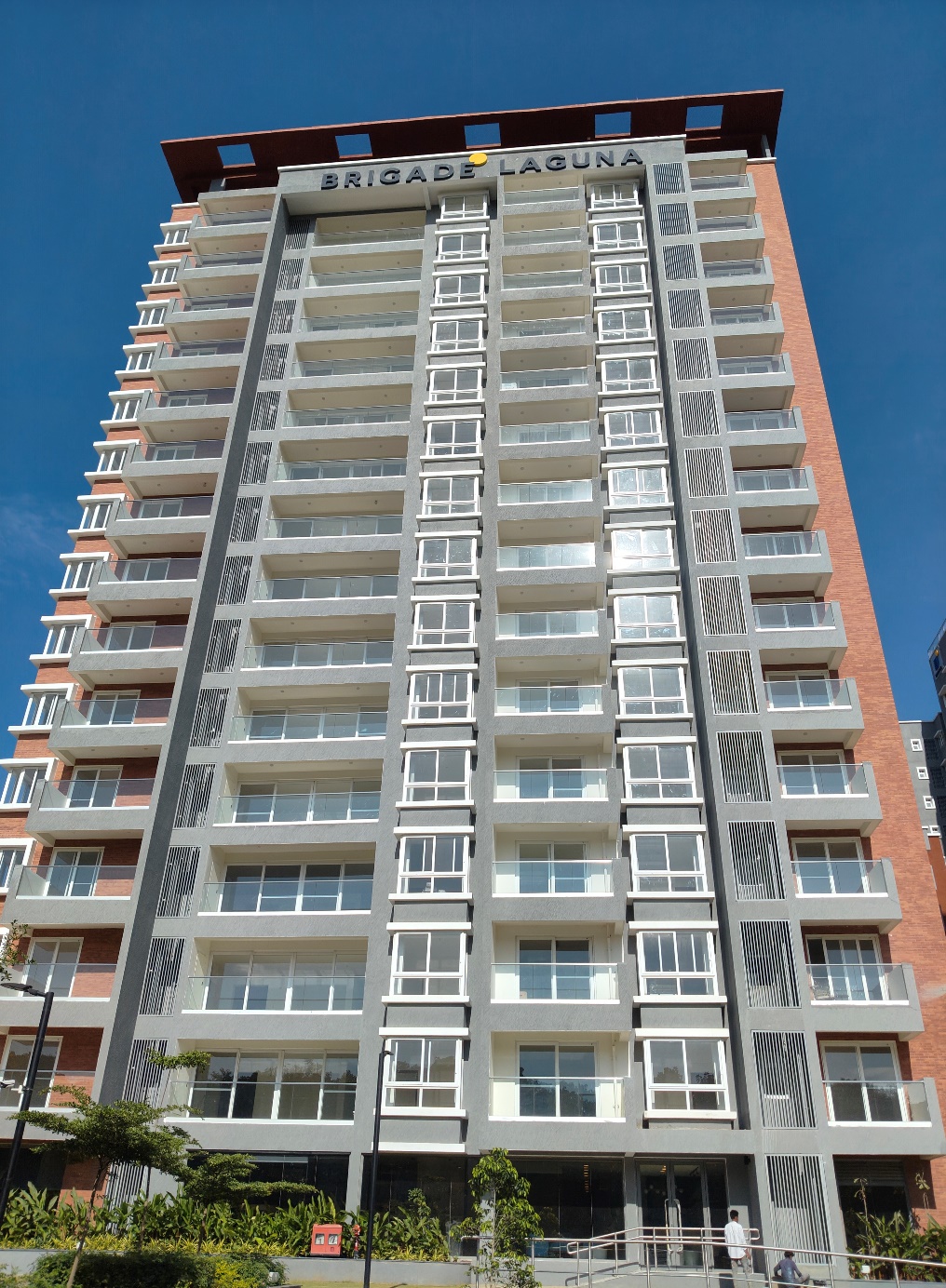

Tower A – External painting completed - Aug 2025

Tower D External painting completed - Aug 2025

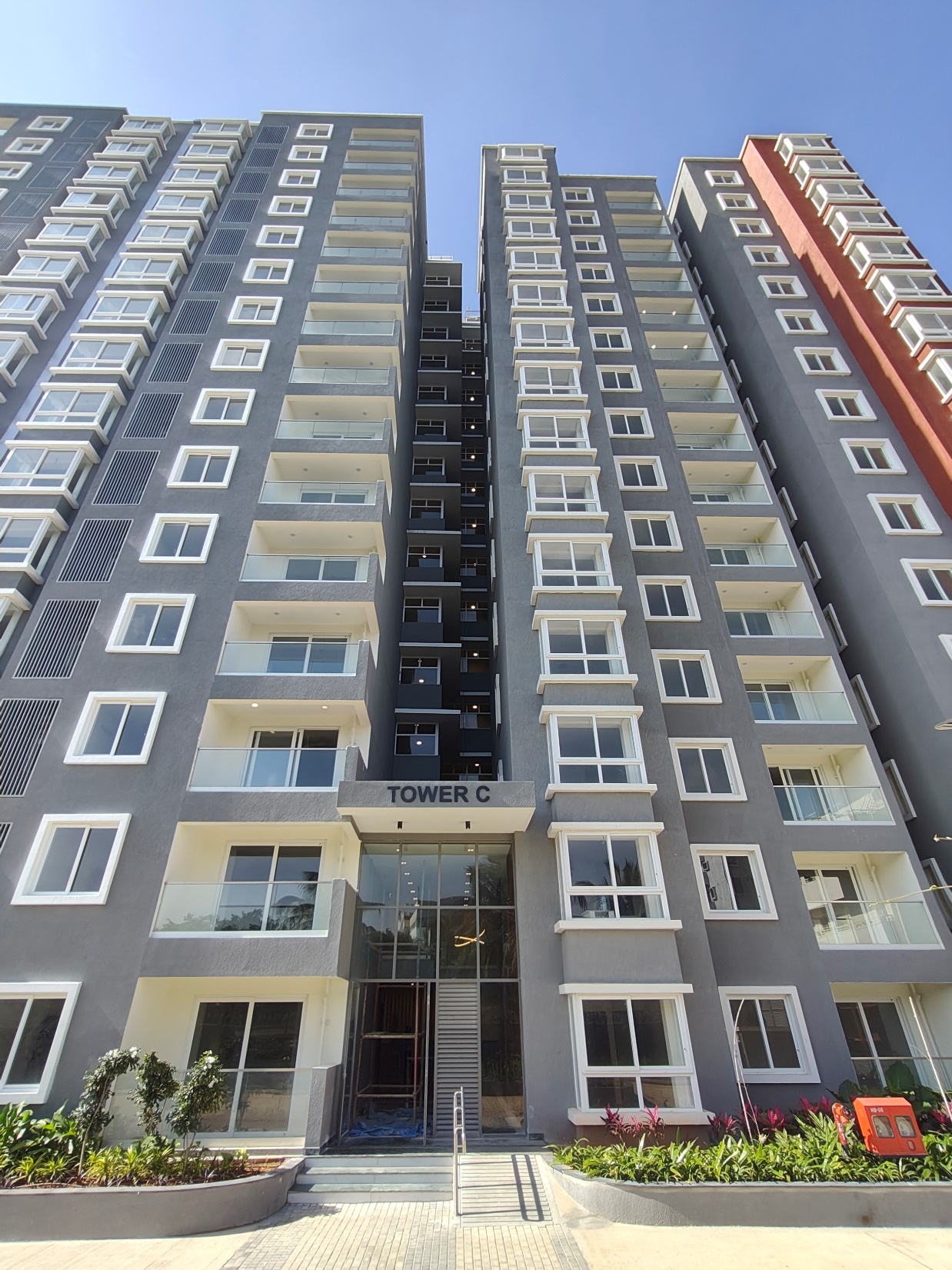

Tower C External painting completed - Aug 2025

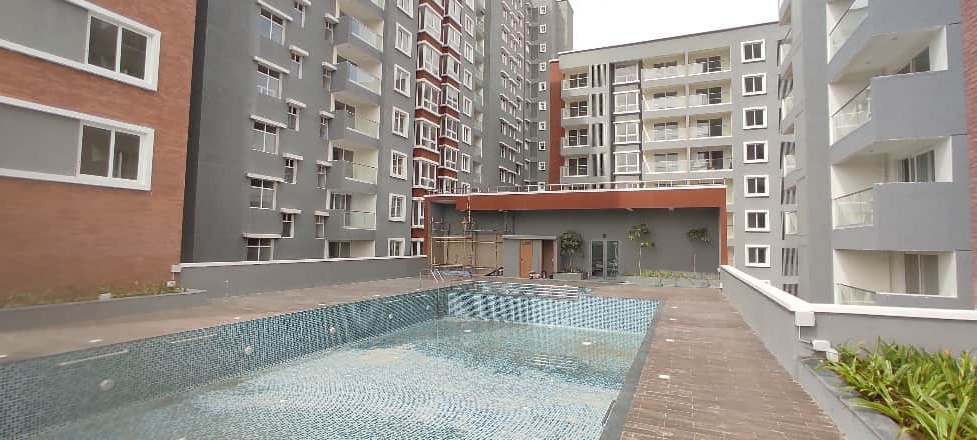

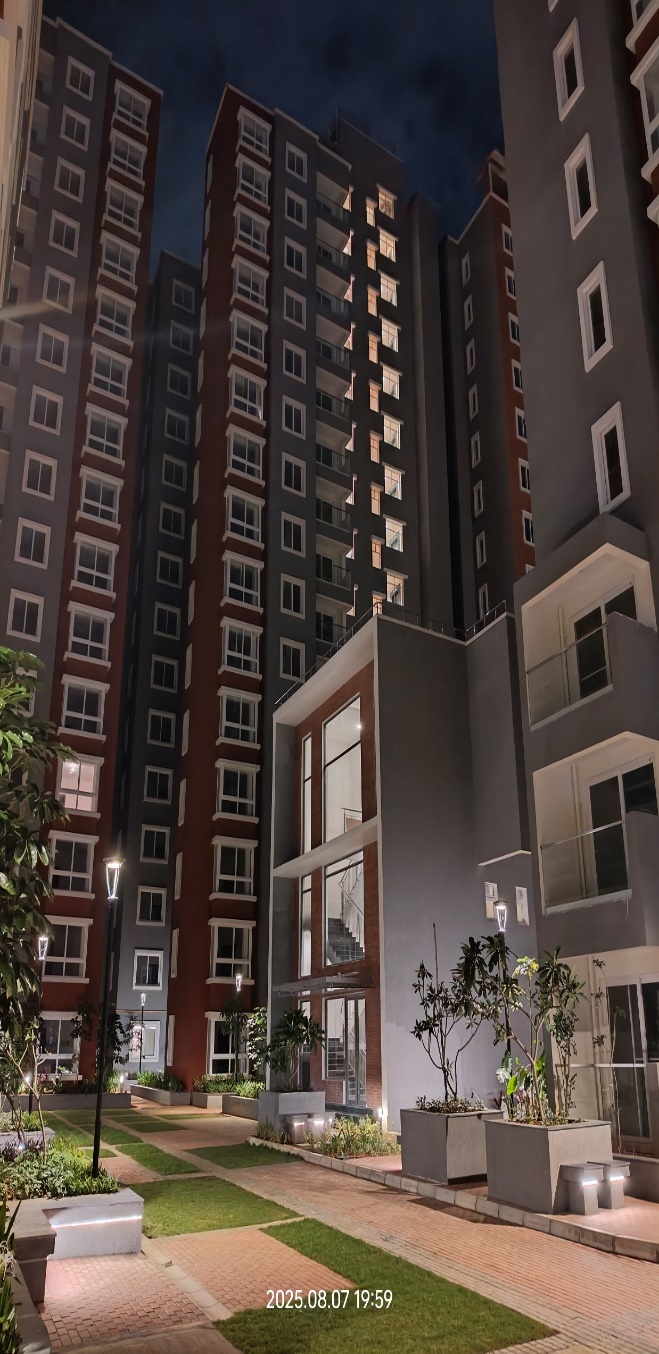

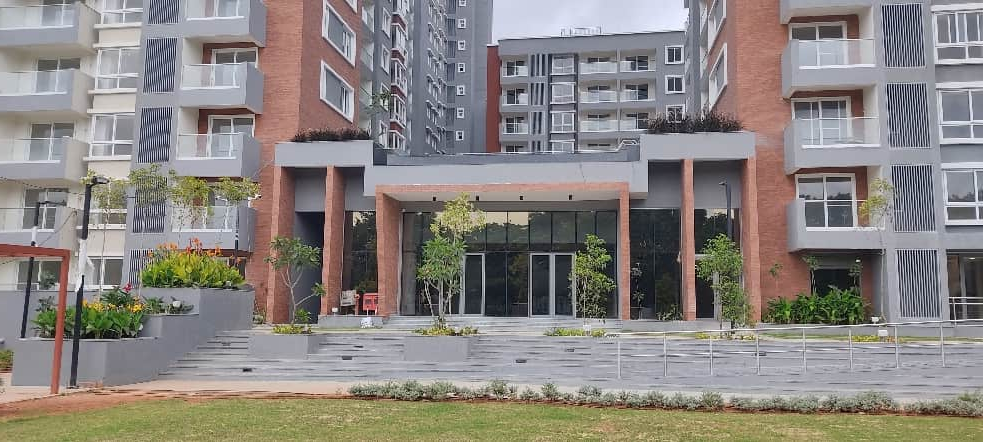

Clubhouse - Finishing work completed - Jul 2025

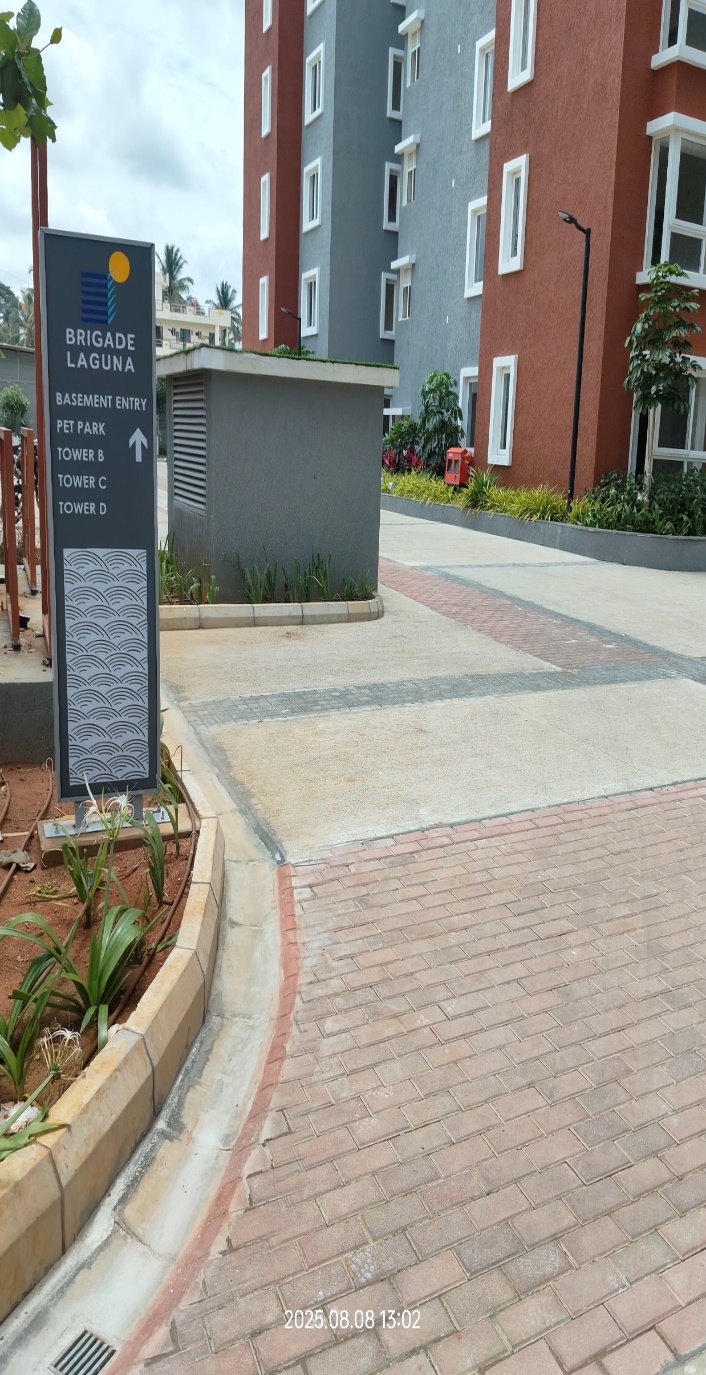

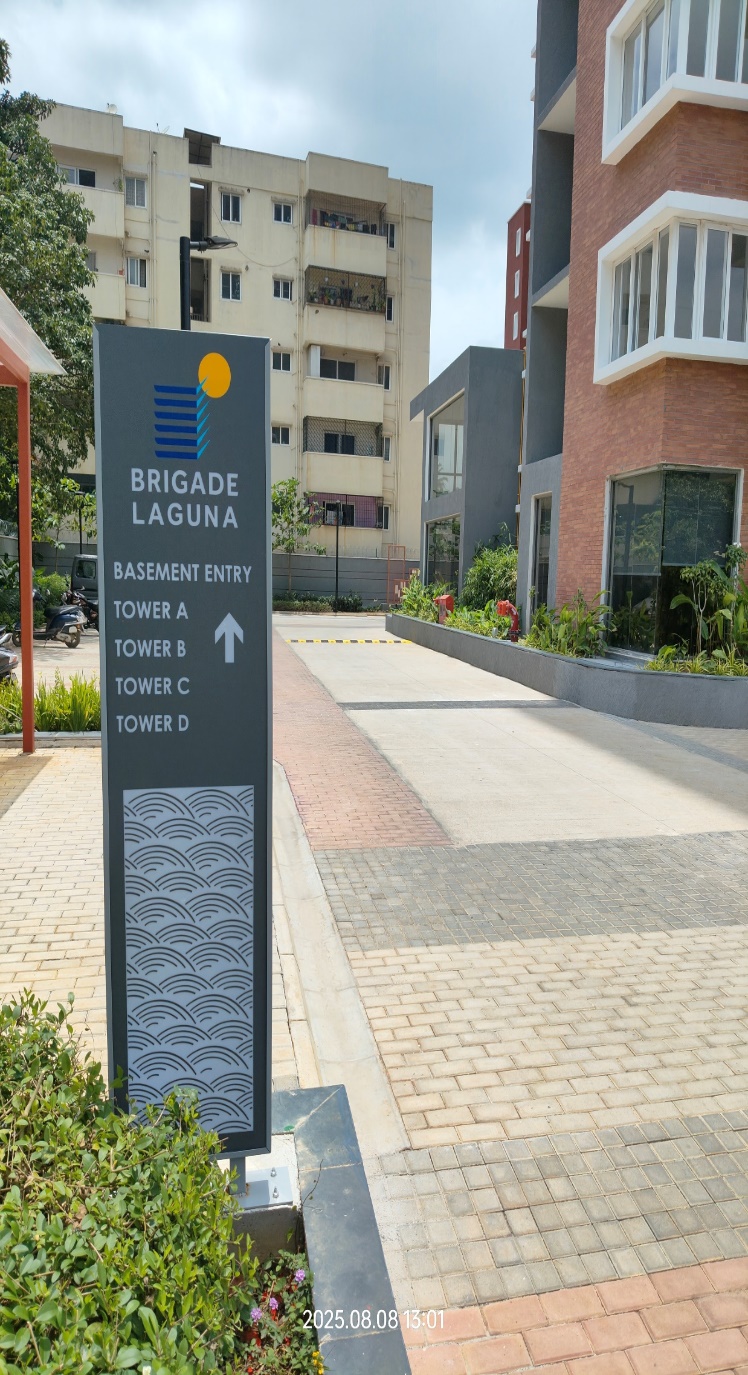

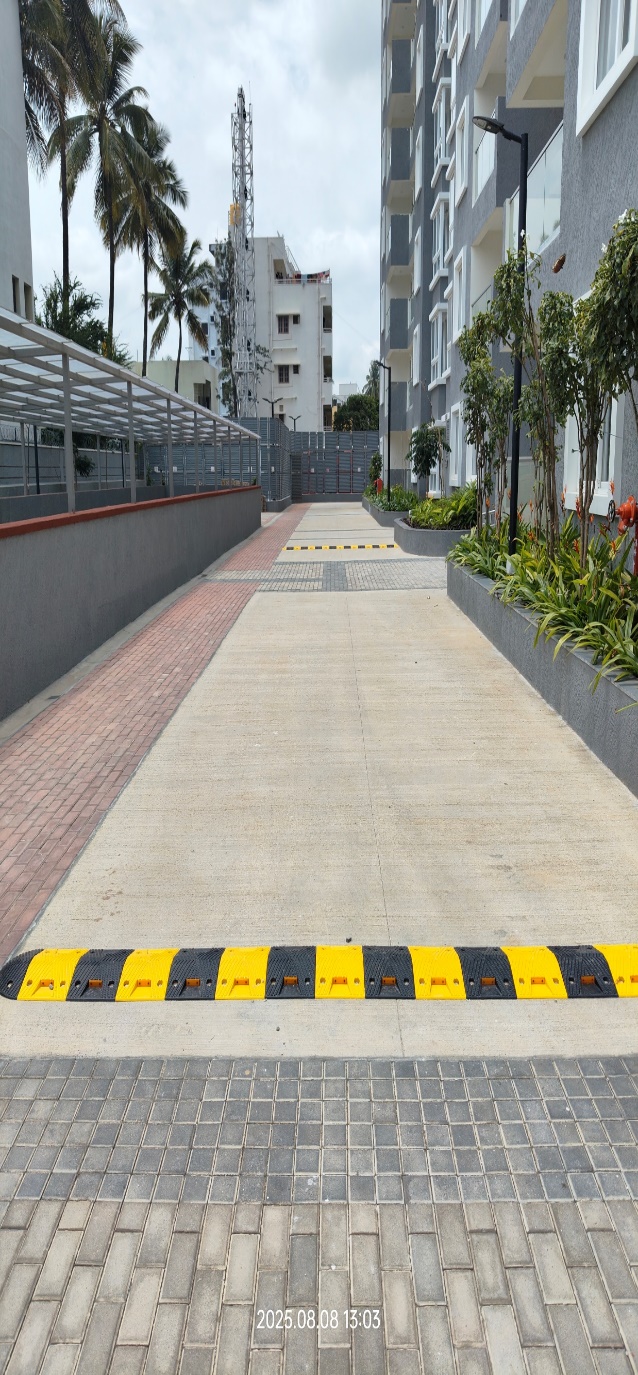

Podium driveway external development work completed - Jul 2025

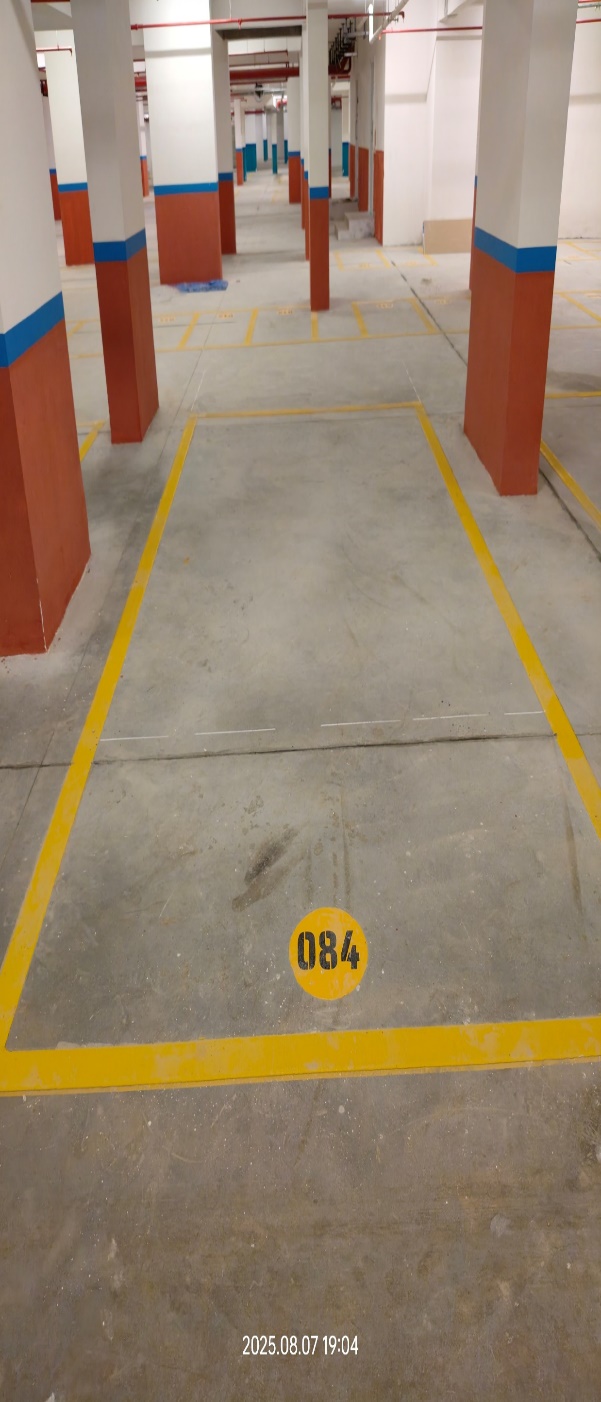

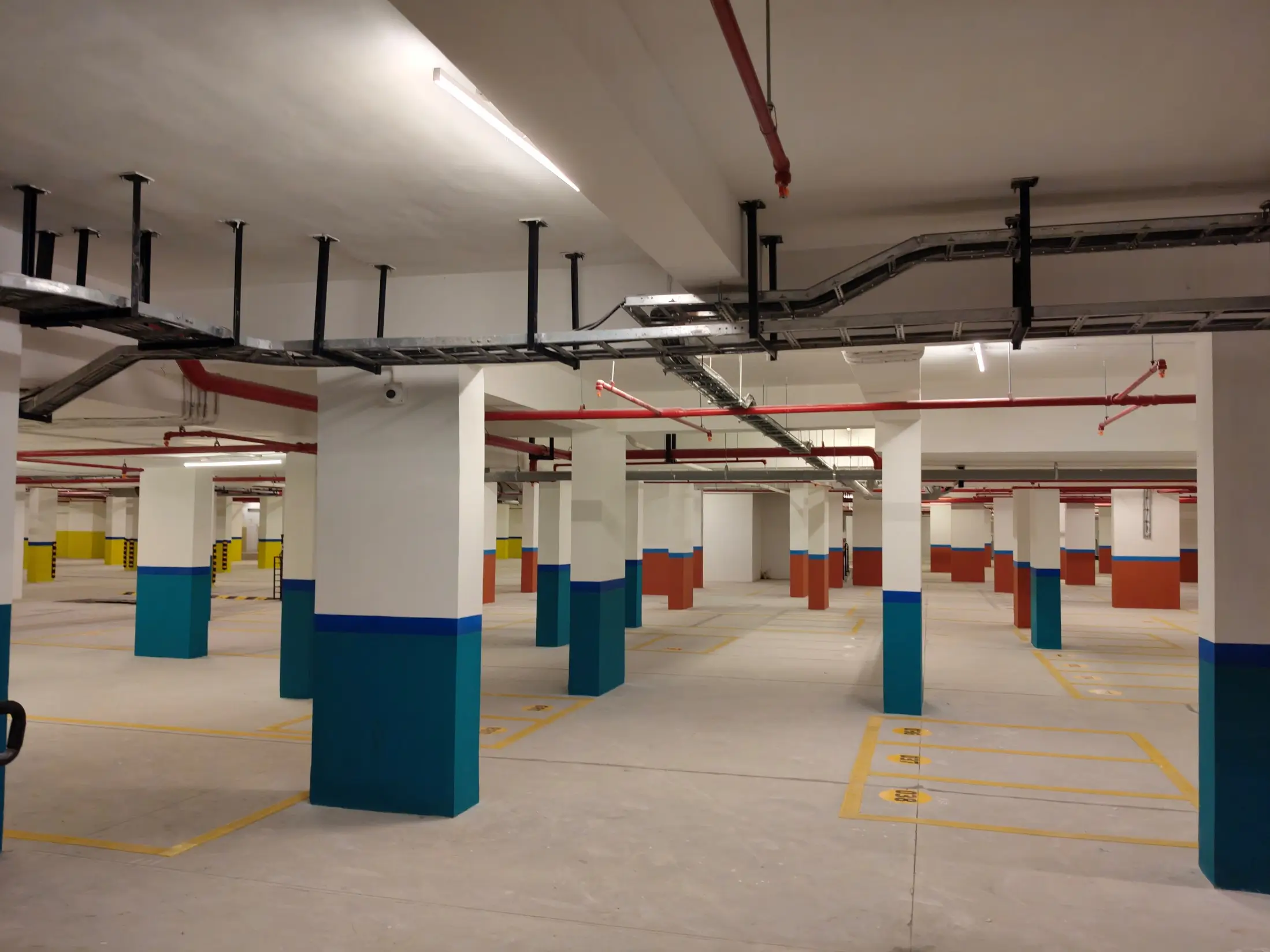

Basement Car parking marking & painting completed - Jul 2025

Podium driveway external development work completed - Jul 2025

Basement Car parking marking & painting completed - Jul 2025

Podium driveway external development work completed - Jul 2025

Basement Car parking marking & painting completed - Jul 2025

External painting work at Tower D & C - Jul 2025

External Development works completed - Jul 2025

External painting work at Tower D & C - Jul 2025

External Development works completed - Jul 2025

Tower B – External painting completed - Jul 2025

External Development works completed - Jul 2025

Tower A – External painting completed - Jul 2025

External Development works completed - Jul 2025

External Development works completed - Jul 2025

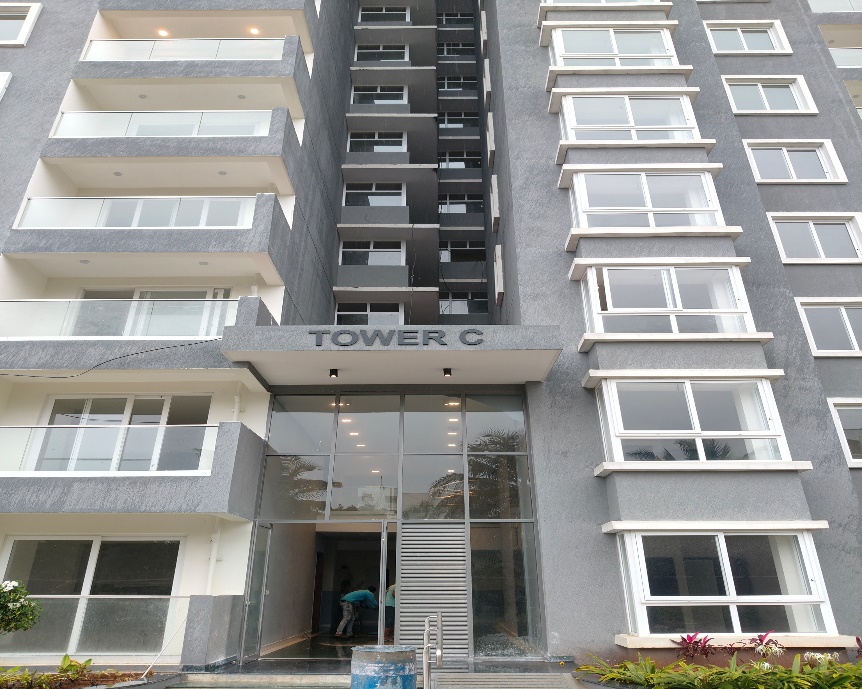

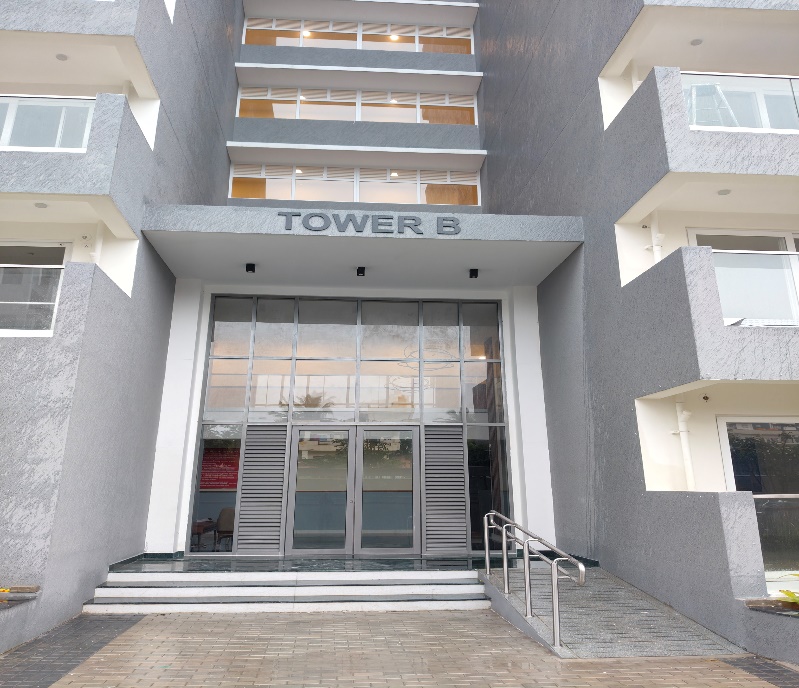

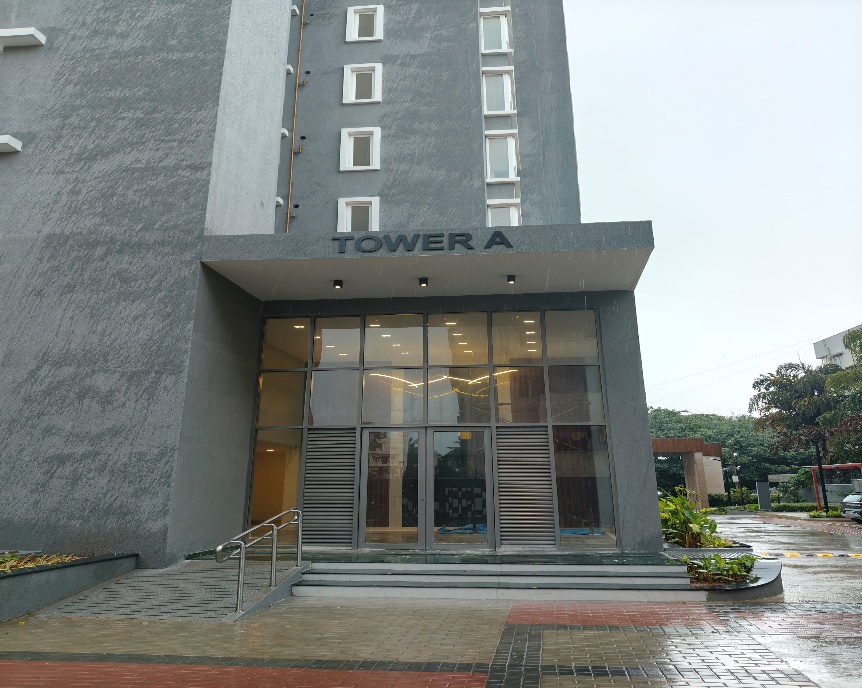

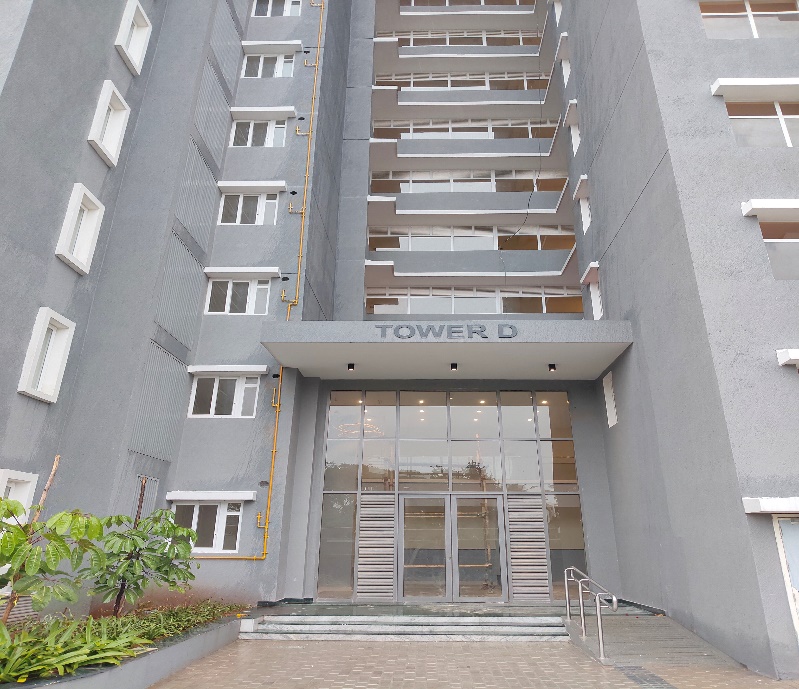

Tower entrances - Jul 2025

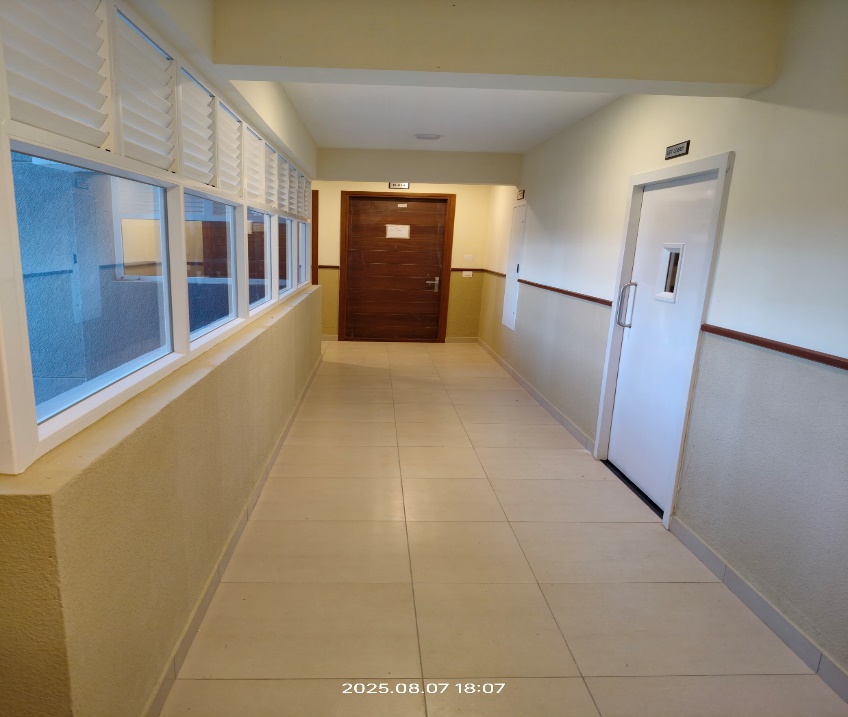

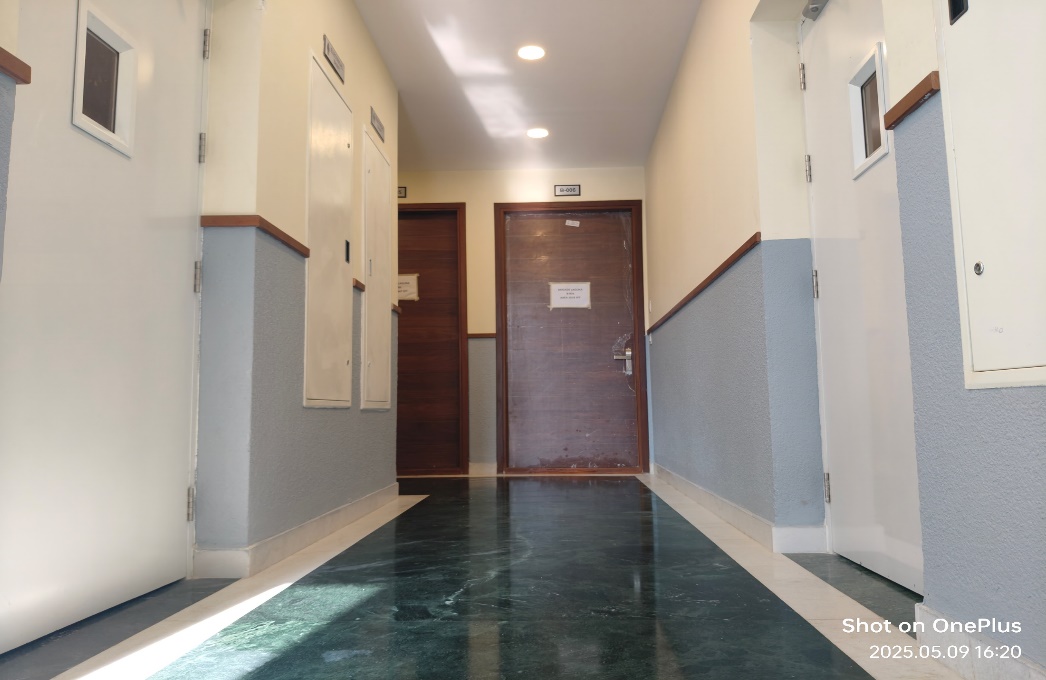

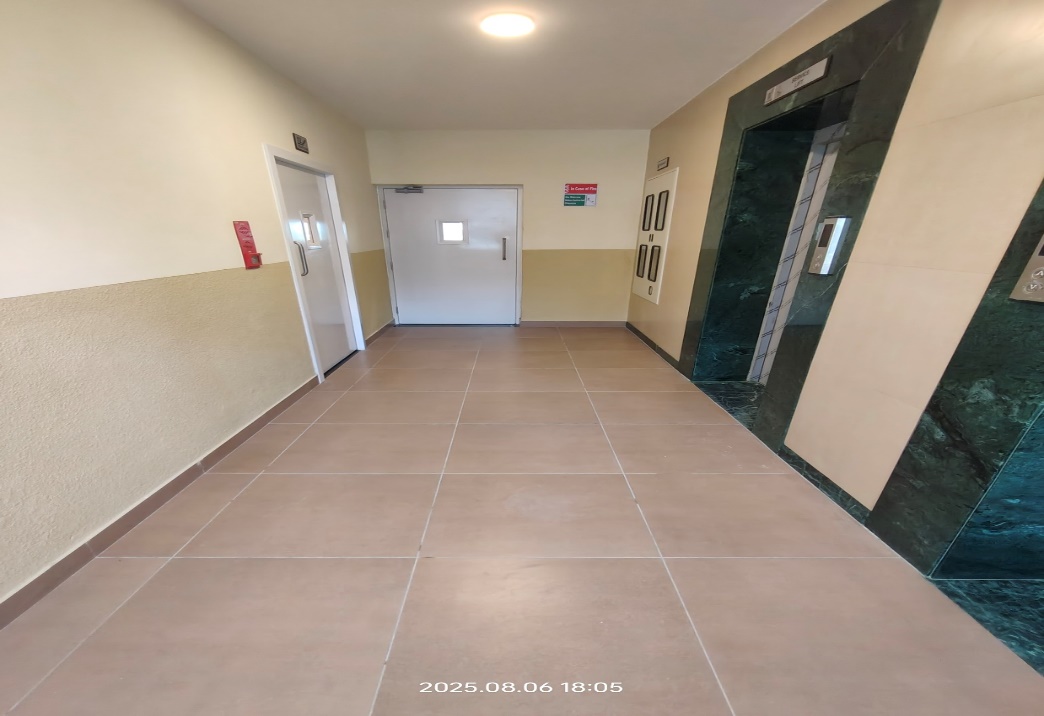

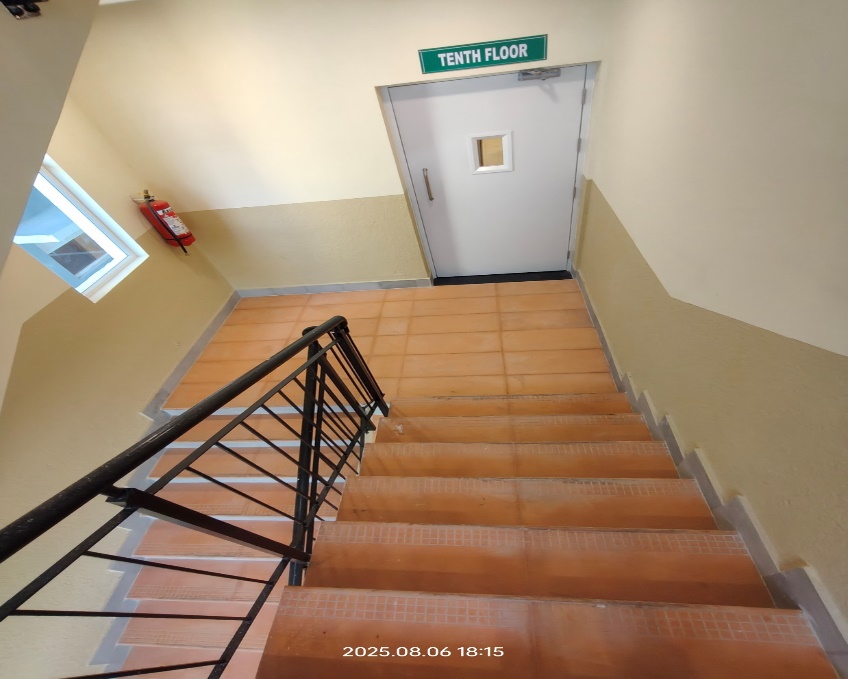

Common Area finishing works completed at Tower A,B&D - Jul 2025

Tower entrances - Jul 2025

Tower entrances - Jul 2025

Common Area finishing works completed at Tower A,B&D - Jul 2025

Tower A Pergola painting completed - Jul 2025

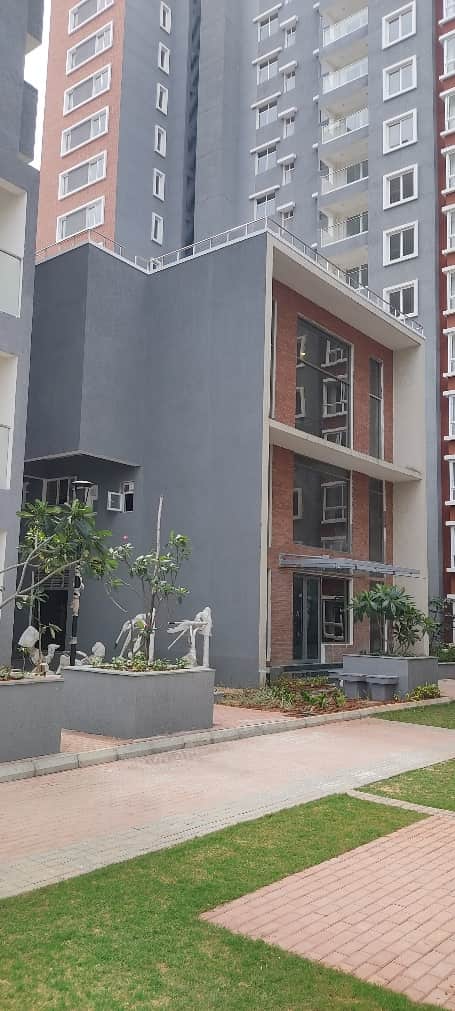

Clubhouse - Finishing work completed - Jul 2025

Common Area finishing works completed at Tower A,B&D - Jul 2025

Common Area finishing works completed at Tower A,B&D - Jul 2025

Tower entrances - Jul 2025

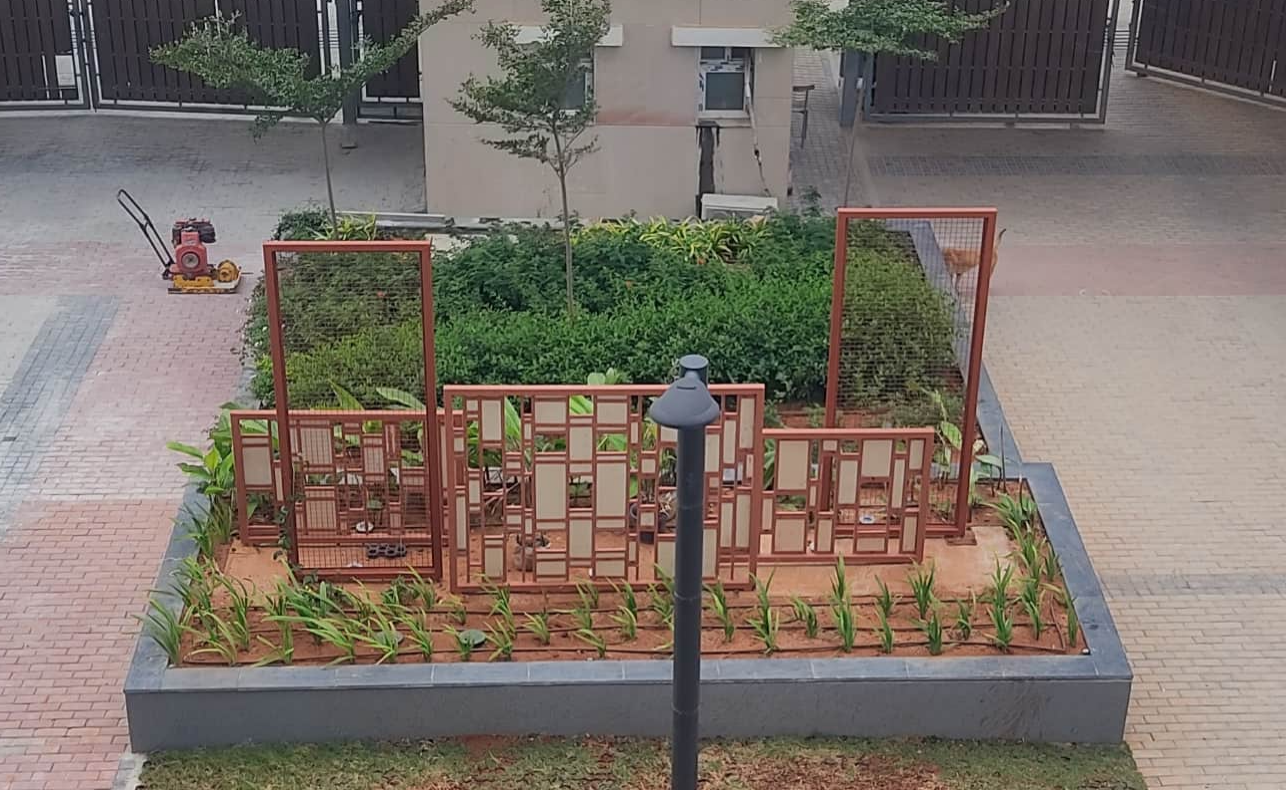

External Development works – In-progress - Jun 2025

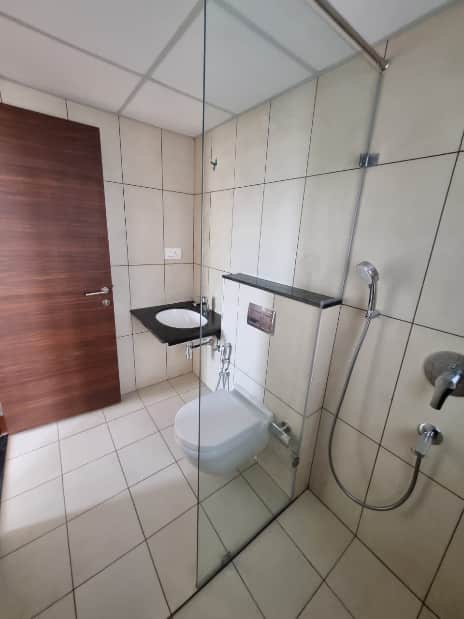

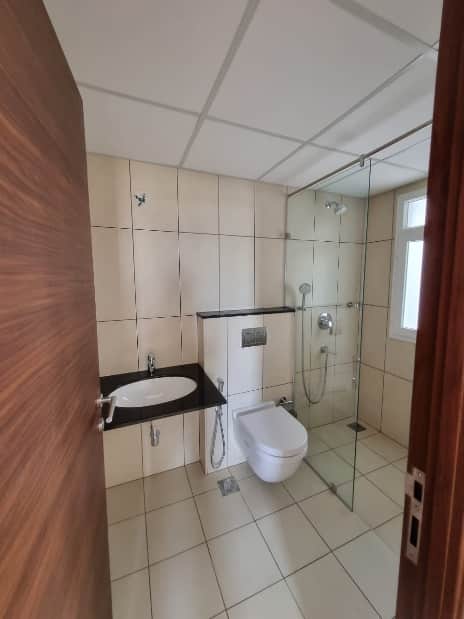

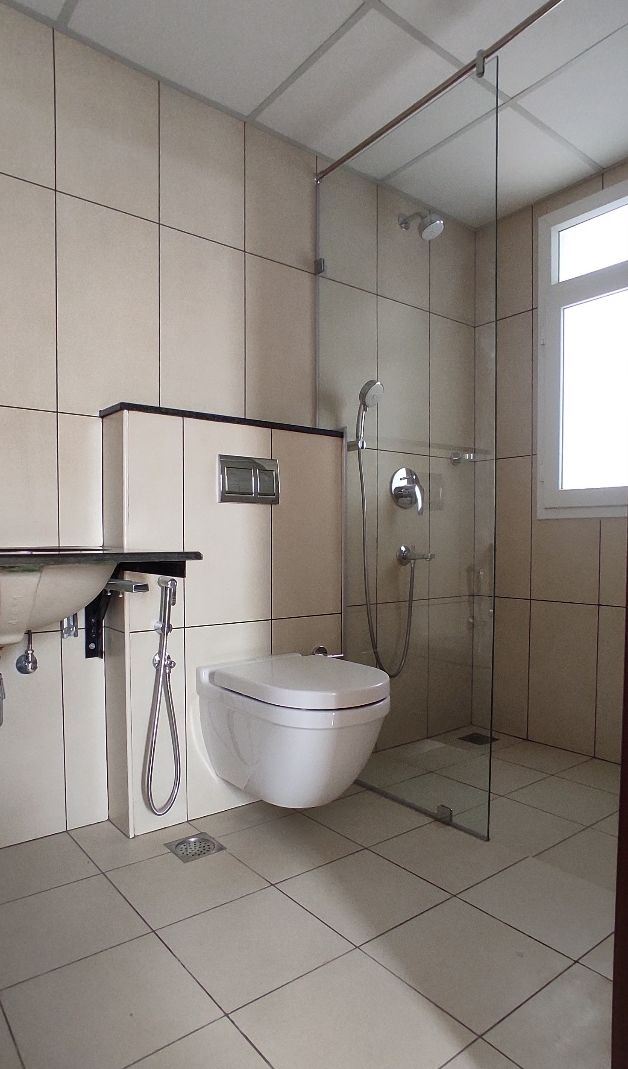

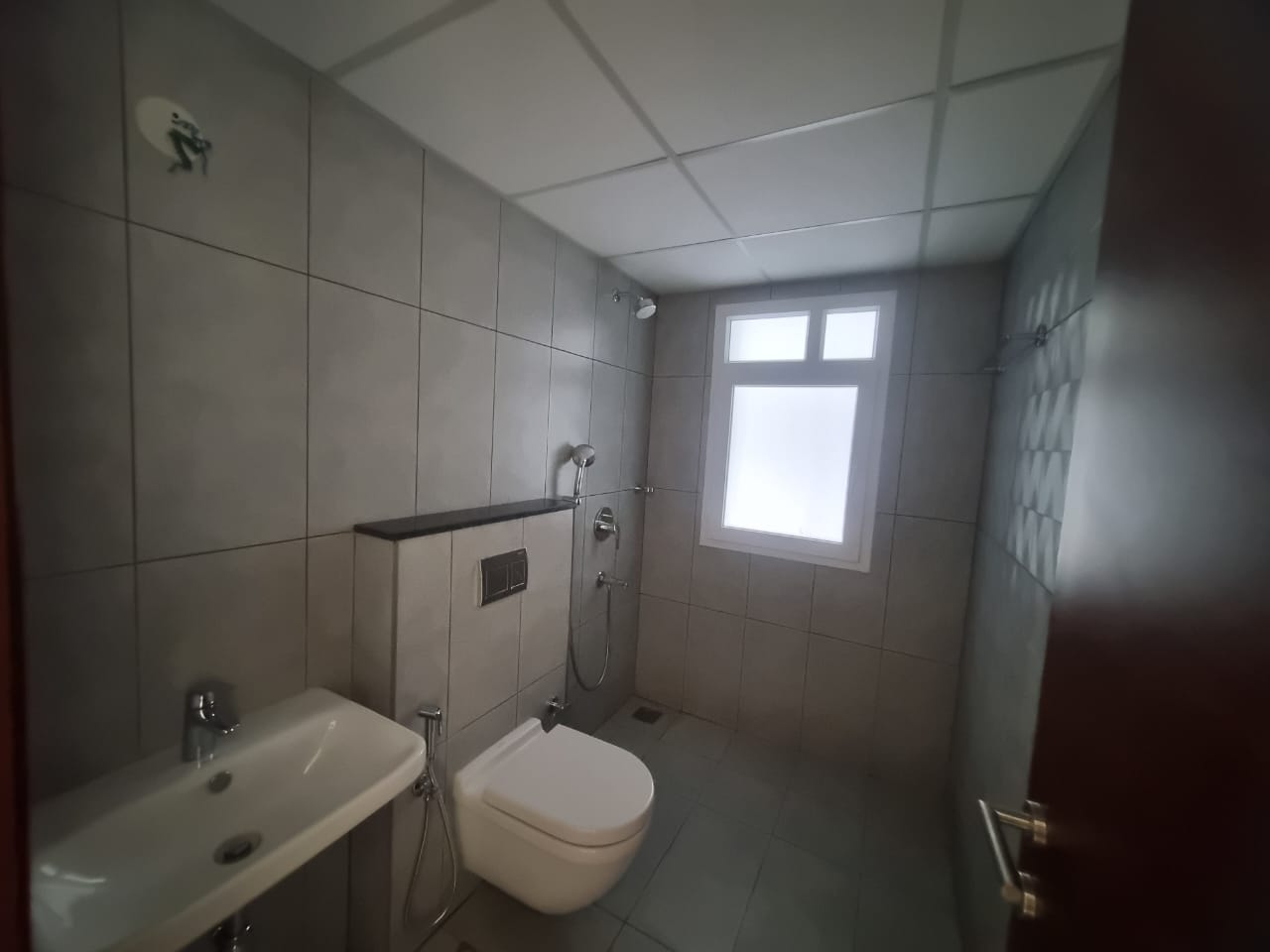

Tower B Tiling works completed - Jun 2025

Tower D – External 2nd coat painting work in progress. - Jun 2025

Tower A - External 2nd coat Painting in progress - Jun 2025

Tower B south side Driveway - Jun 2025

Central podium south side - Jun 2025

Tower A south side landscape - Jun 2025

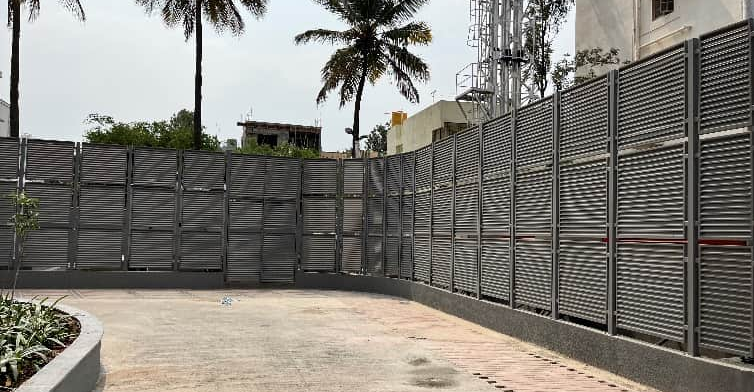

DG & Transformer yard - Jun 2025

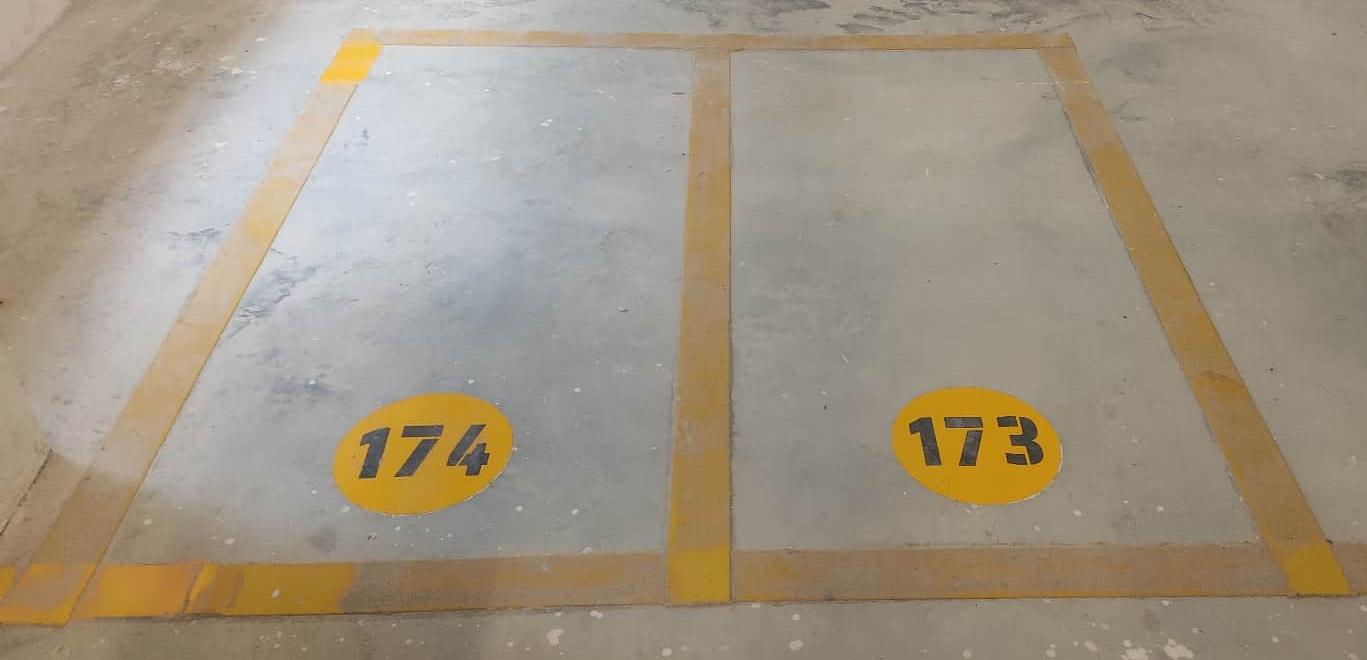

Basement Car parking marking in progress - Jun 2025

Basement Car parking marking in progress - Jun 2025

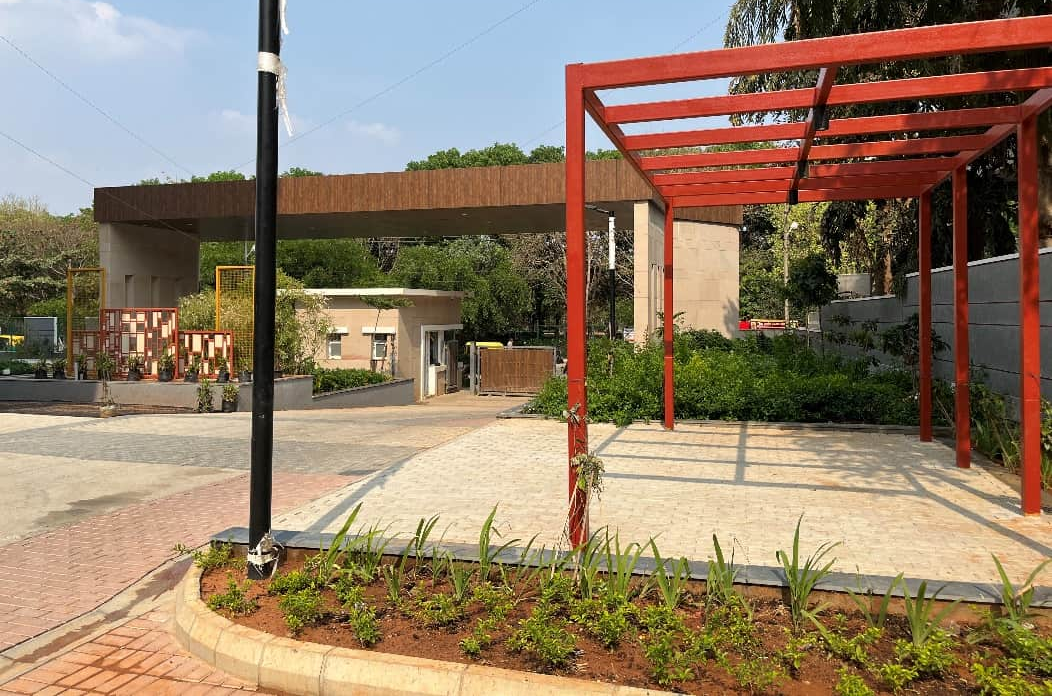

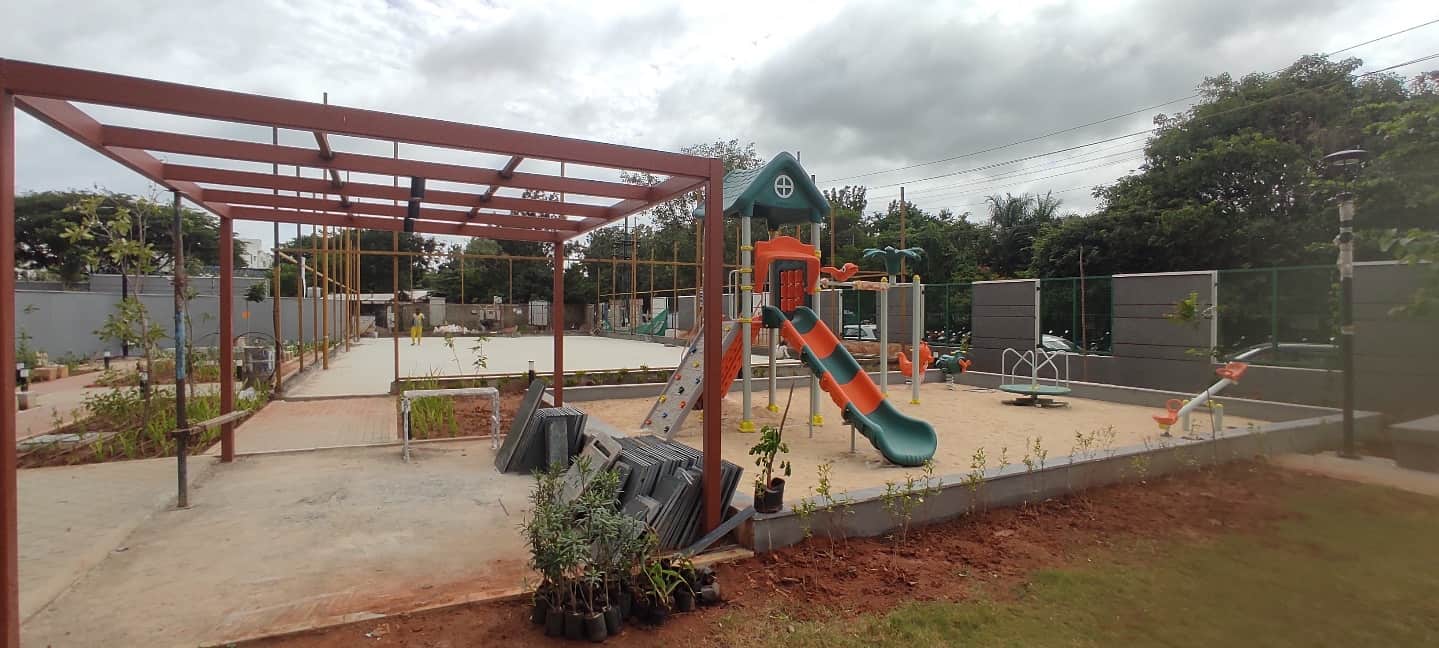

External Development works – In-progress - Jun 2025

External Development works in progress - Jun 2025

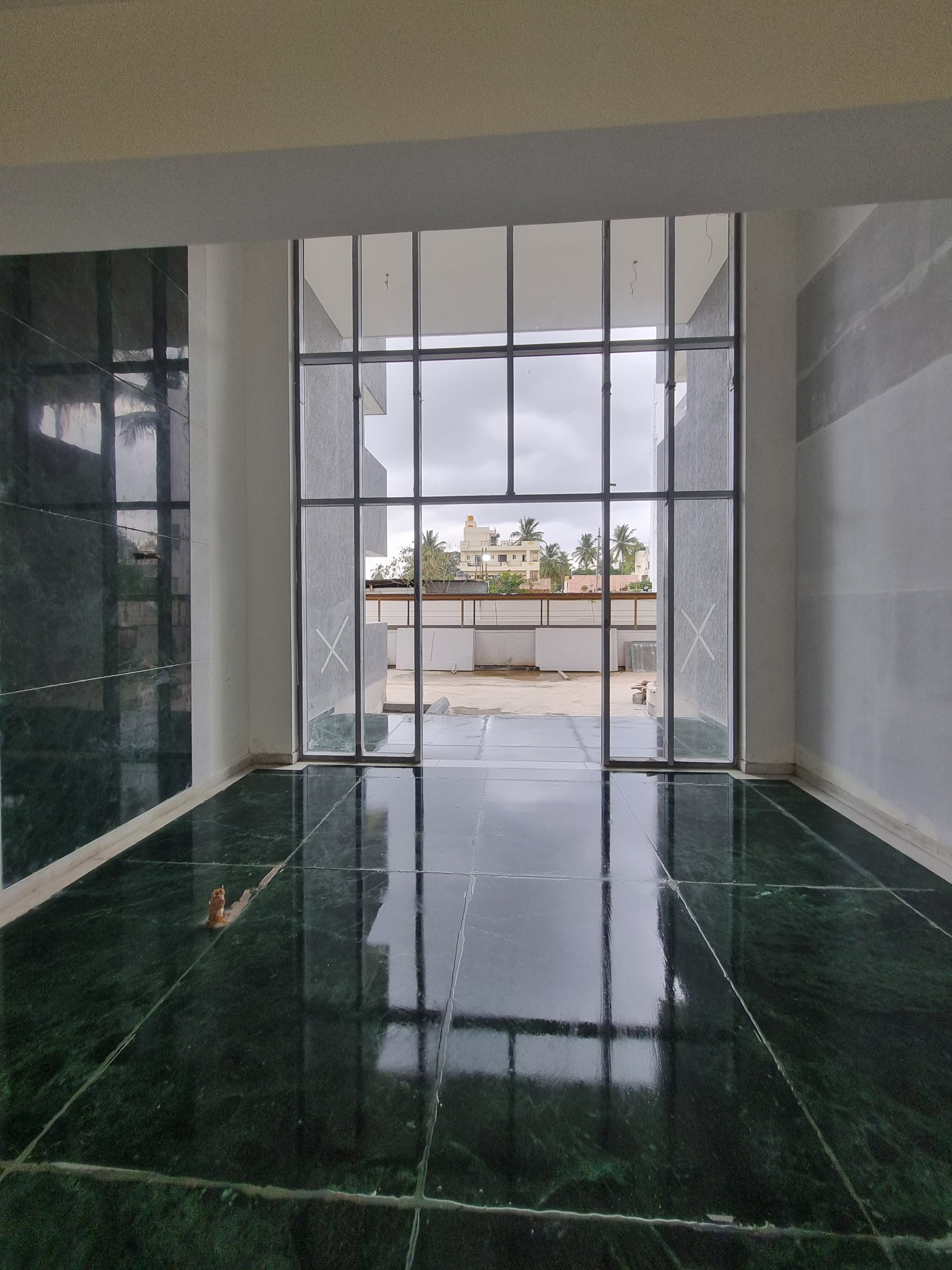

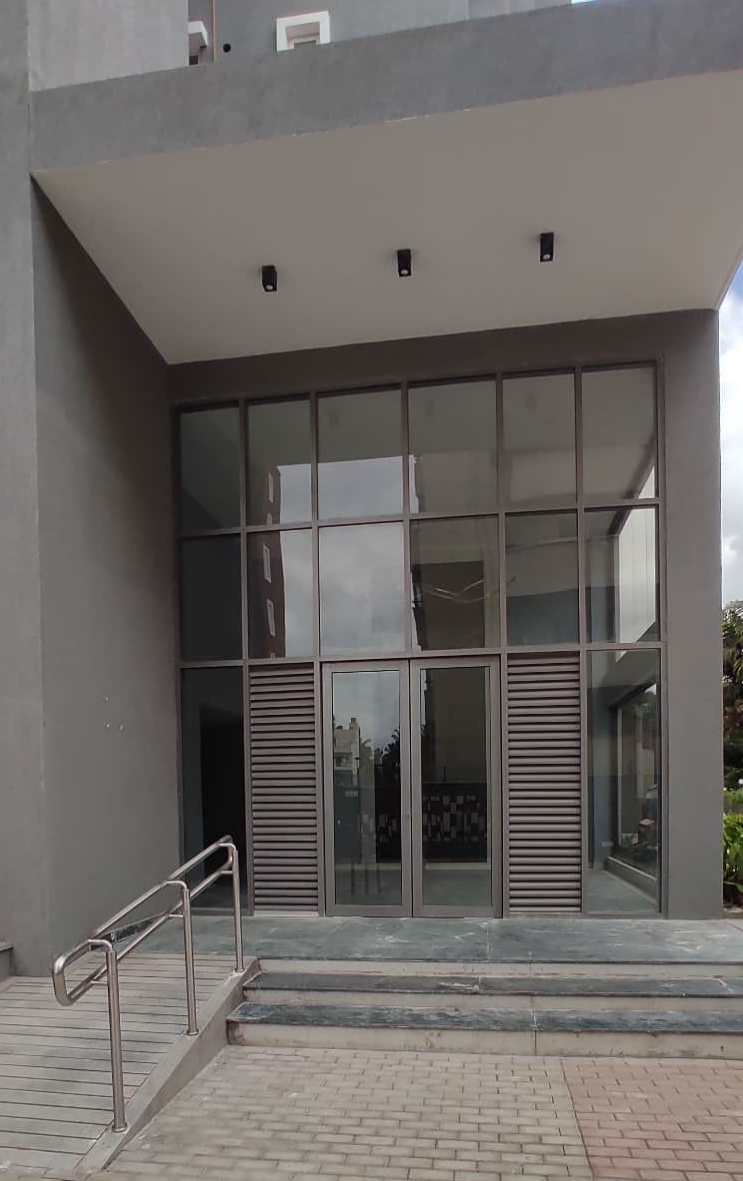

Tower A,C,D – Entrance lobby finishes in progress - Jun 2025

External Development works in progress - Jun 2025

Tower- A Common Area finishing in progress - Jun 2025

Tower A,C,D – Entrance lobby finishes in progress - Jun 2025

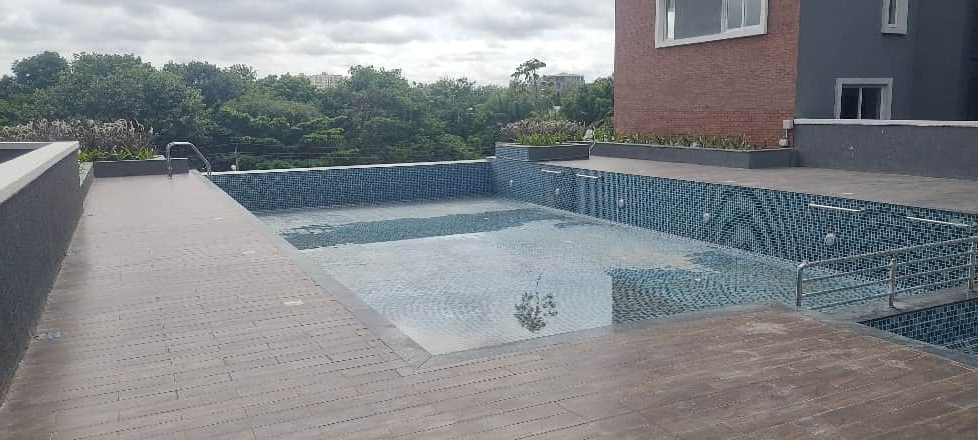

Clubhouse - Finishing works in progress - Jun 2025

Clubhouse - Finishing works in progress - Jun 2025

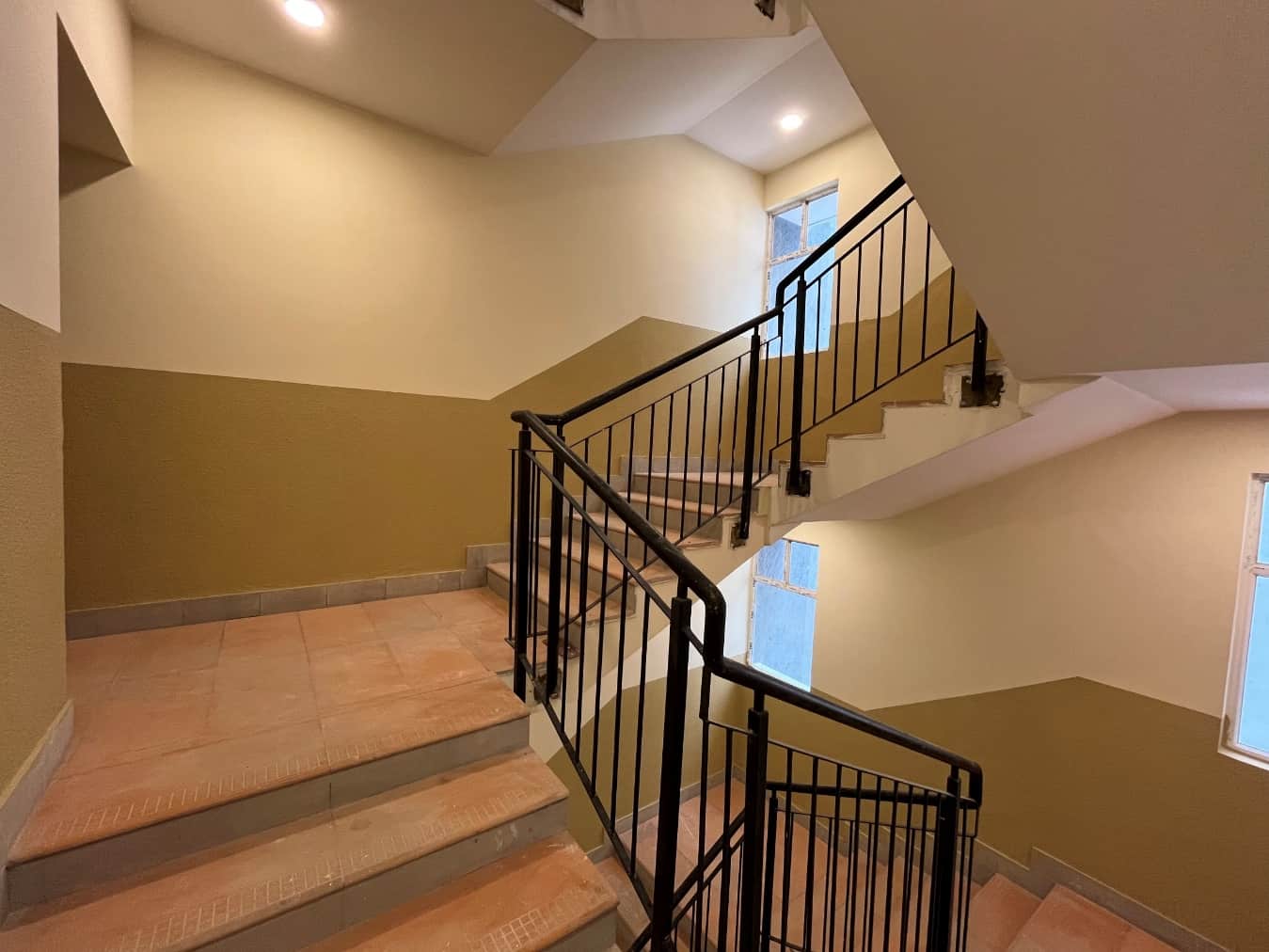

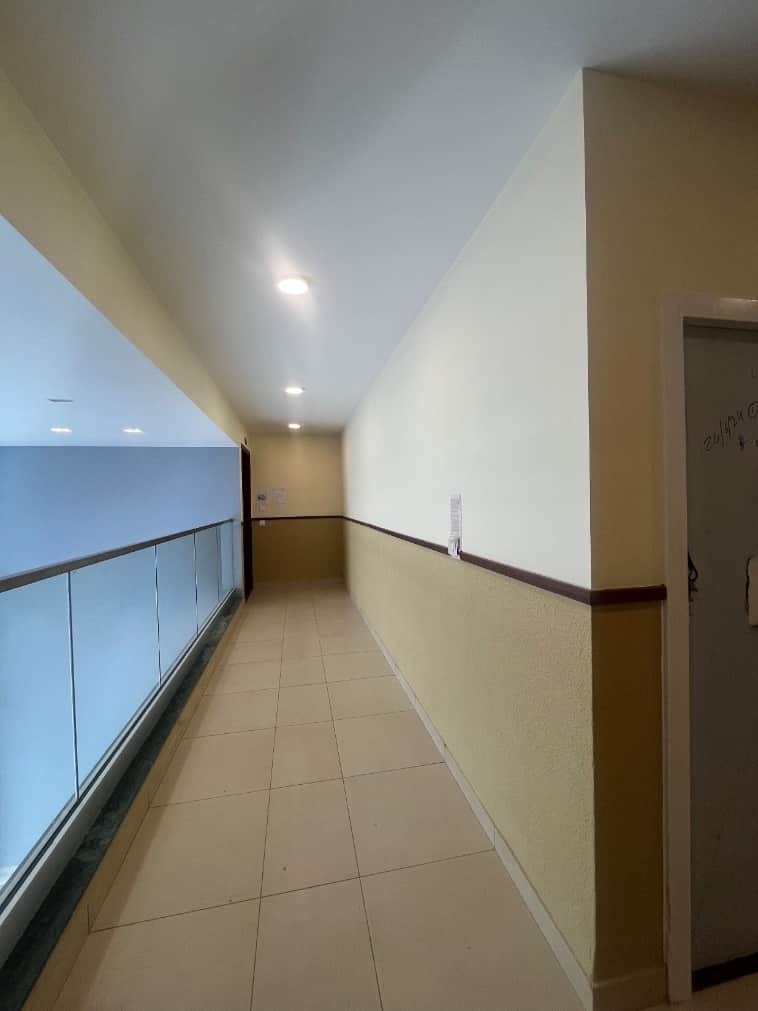

Tower- B Common Area finishing completed - Jun 2025

Tower- B Common Area finishing completed - Jun 2025

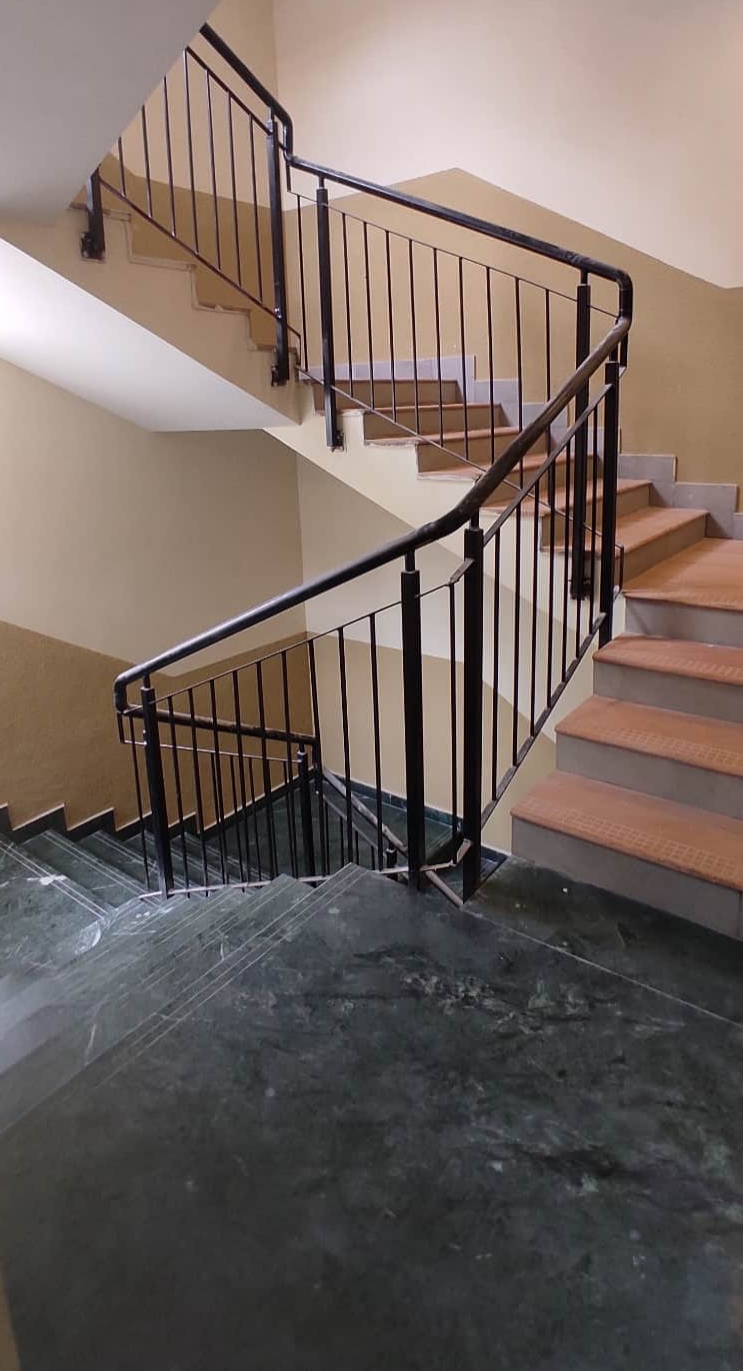

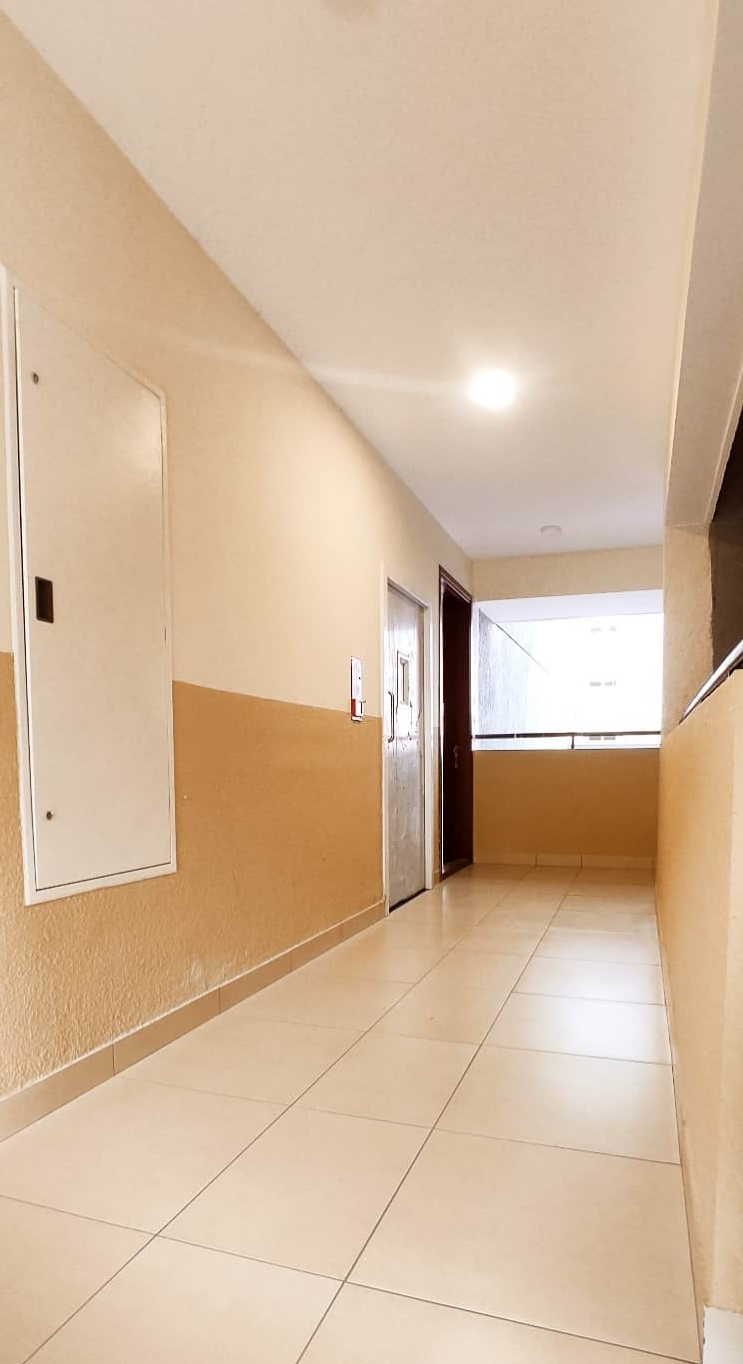

Tower- A Common Area finishing in progress - Jun 2025

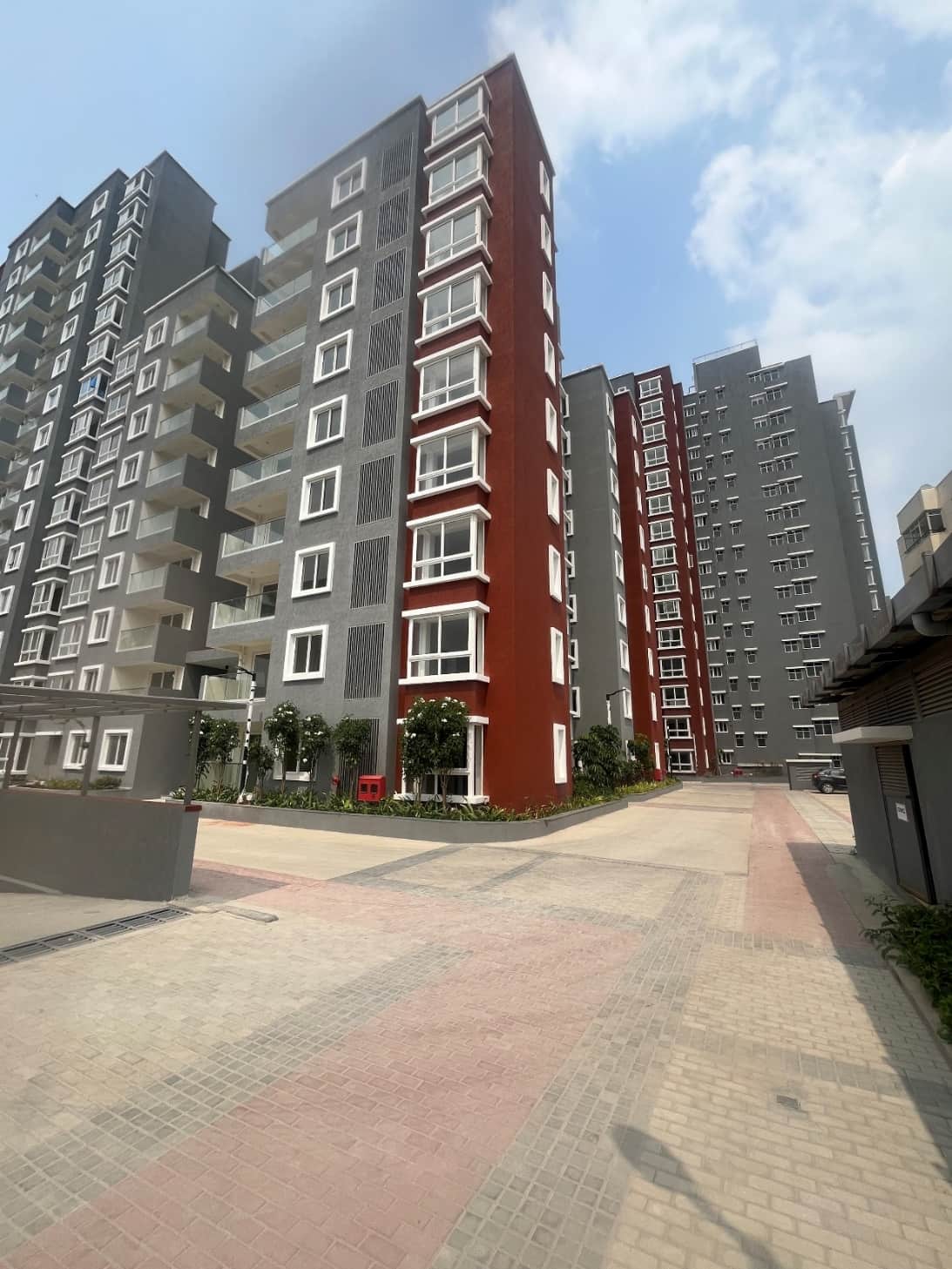

Tower B: External Painting Elevation - Jun 2025

Tower D – External 2nd coat painting work in progress. - Jun 2025

Tower D – External 2nd coat painting work in progress. - Jun 2025

Clubhouse - Finishing works in progress - Jun 2025

Tower A - External 2nd coat Painting in progress - Jun 2025

Tower B Tiling works completed - Jun 2025

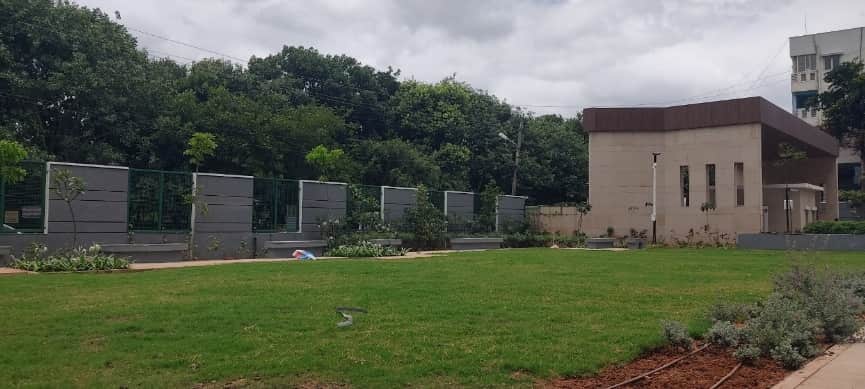

Open lawn and Kids play area - Jun 2025

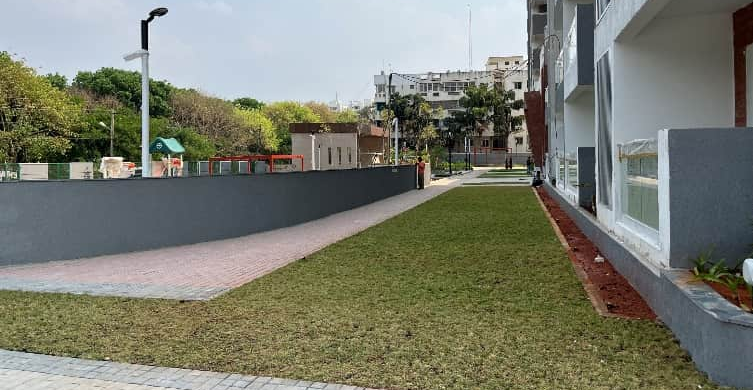

Tower A East side Driveway - Jun 2025

DG & Transformer yard - May 2025

Tower B Tiling works completed - May 2025

Basement Car parking marking in progress - May 2025

Basement Car parking marking in progress - May 2025

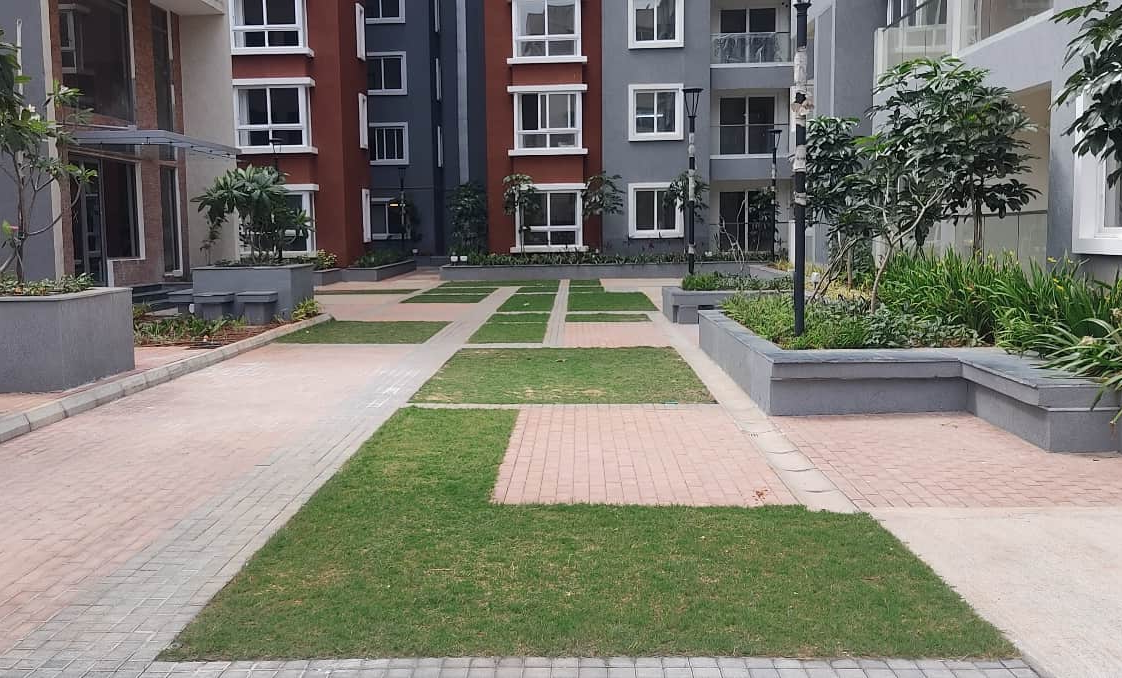

External Development works in progress - May 2025

Clubhouse - External finishing works in progress - May 2025

External Development works in progress - May 2025

Tower A south side landscape - May 2025

Central podium south side - May 2025

A TOWER : External 2nd coat Painting in progress - May 2025

Tower B south side Driveway - May 2025

Tower A,C,D – Entrance lobby finishes in progress - May 2025

Tower- A Common Area finishing in progress - May 2025

Tower- A Common Area finishing in progress - May 2025

Tower- B Common Area finishing completed - May 2025

TOWER B: External Painting Elevation - May 2025

Open lawn and Kids play area - May 2025

Tower D - External 2nd coat painting work in progress. - May 2025

Tower A,C,D – Entrance lobby finishes in progress - May 2025

Tower- B Common Area finishing completed - May 2025

Tower C - External 2nd coat painting work in progress. - May 2025

Tower D - External 2nd coat painting work in progress. - May 2025

Clubhouse - External finishing works in progress - May 2025

Tower B Tiling works completed - May 2025

Tower A East side Driveway - May 2025

Tower- B Common Area finishing in progress - Apr 2025

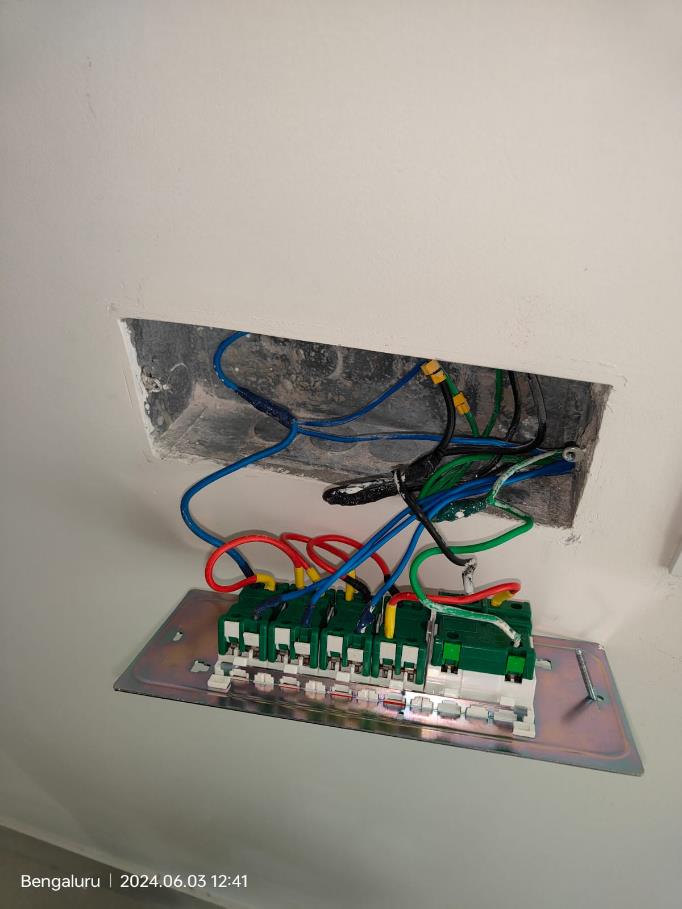

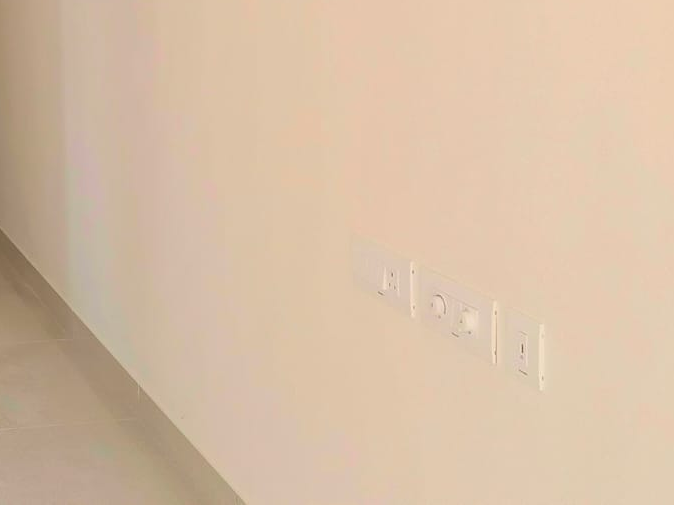

Tower- B: Switch-plate and wiring in progress - Apr 2025

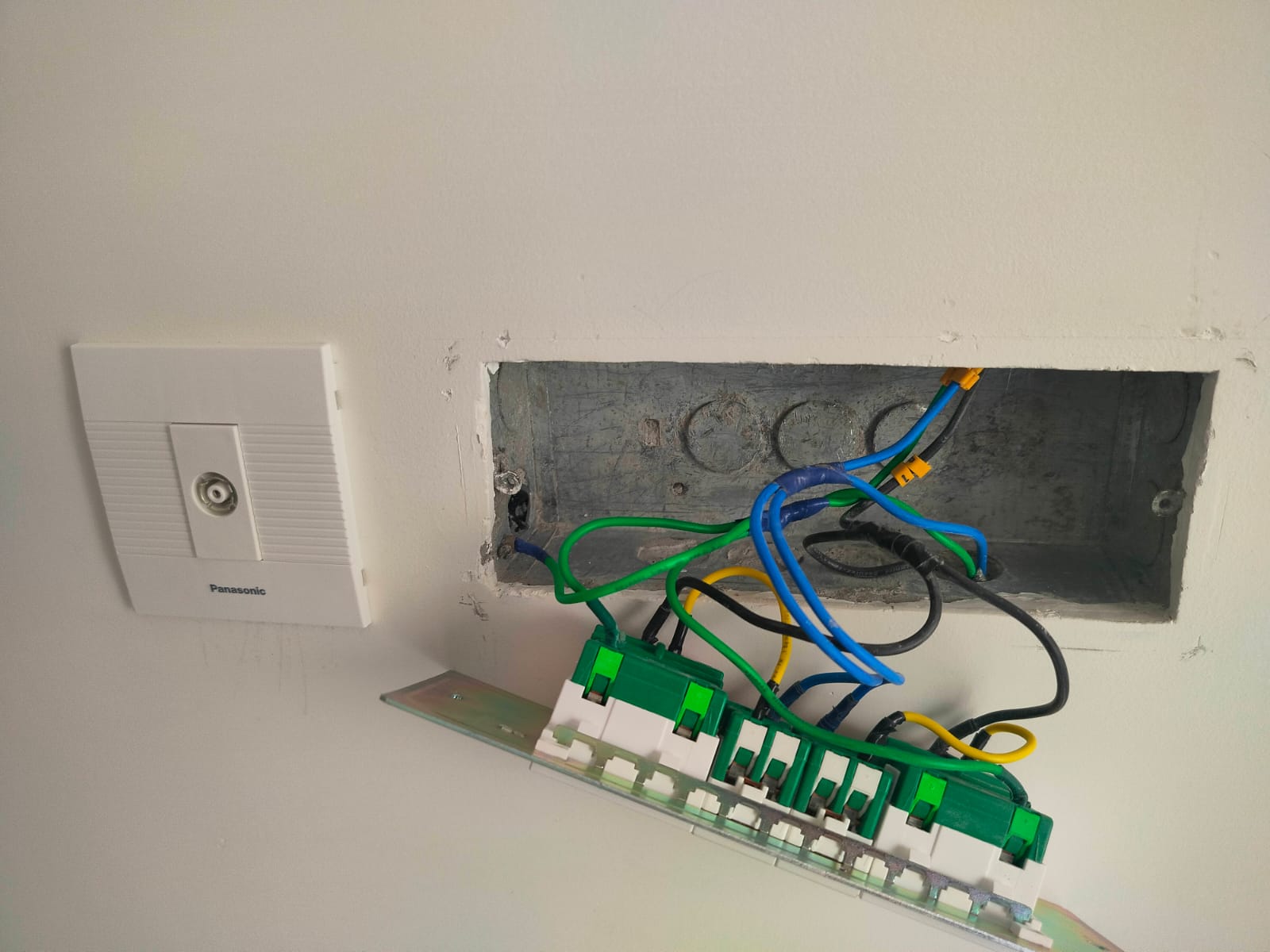

Tower- B: Switch-plate and wiring in progress - Apr 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Apr 2025

Tower B south side Driveway - Apr 2025

Tower D - External painting work in progress. - Apr 2025

TOWER B: External Painting Elevation - Apr 2025

A TOWER : External Painting in progress - Apr 2025

A TOWER : External Painting in progress - Apr 2025

Tower C - External painting work in progress. - Apr 2025

Open lawn and Kids play area - Apr 2025

Tower D - External painting work in progress. - Apr 2025

Clubhouse - External finishing works in progress - Apr 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Apr 2025

Basement Car parking marking in progress - Apr 2025

DG & Transformer yard - Apr 2025

Tower A south side landscape - Apr 2025

Tower A East side Driveway - Apr 2025

Central podium south side - Apr 2025

External Development works in progress - Apr 2025

External Development works in progress - Apr 2025

Basement Car parking marking in progress - Apr 2025

Clubhouse - External finishing works in progress - Apr 2025

Tower B Tiling works completed - Apr 2025

Tower B Tiling works completed - Apr 2025

Tower- B Common Area finishing in progress - Apr 2025

Open lawn and Kids play area - Mar 2025

Tower F External painting work in progress. - Mar 2025

Tower D External painting work in progress. - Mar 2025

Clubhouse - External finishing works in progress - Mar 2025

Tower- B: Switch-plate and wiring in progress - Mar 2025

A TOWER : External Painting in progress - Mar 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Mar 2025

Clubhouse - External finishing works in progress - Mar 2025

TOWER B: External Painting Elevation - Mar 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Mar 2025

Tower B south side Driveway - Mar 2025

External Development works in progress - Mar 2025

Central podium south side - Mar 2025

Tower- B Common Area finishing in progress - Mar 2025

A TOWER : External Painting in progress - Mar 2025

Tower- B Common Area finishing in progress - Mar 2025

External Development works in progress - Mar 2025

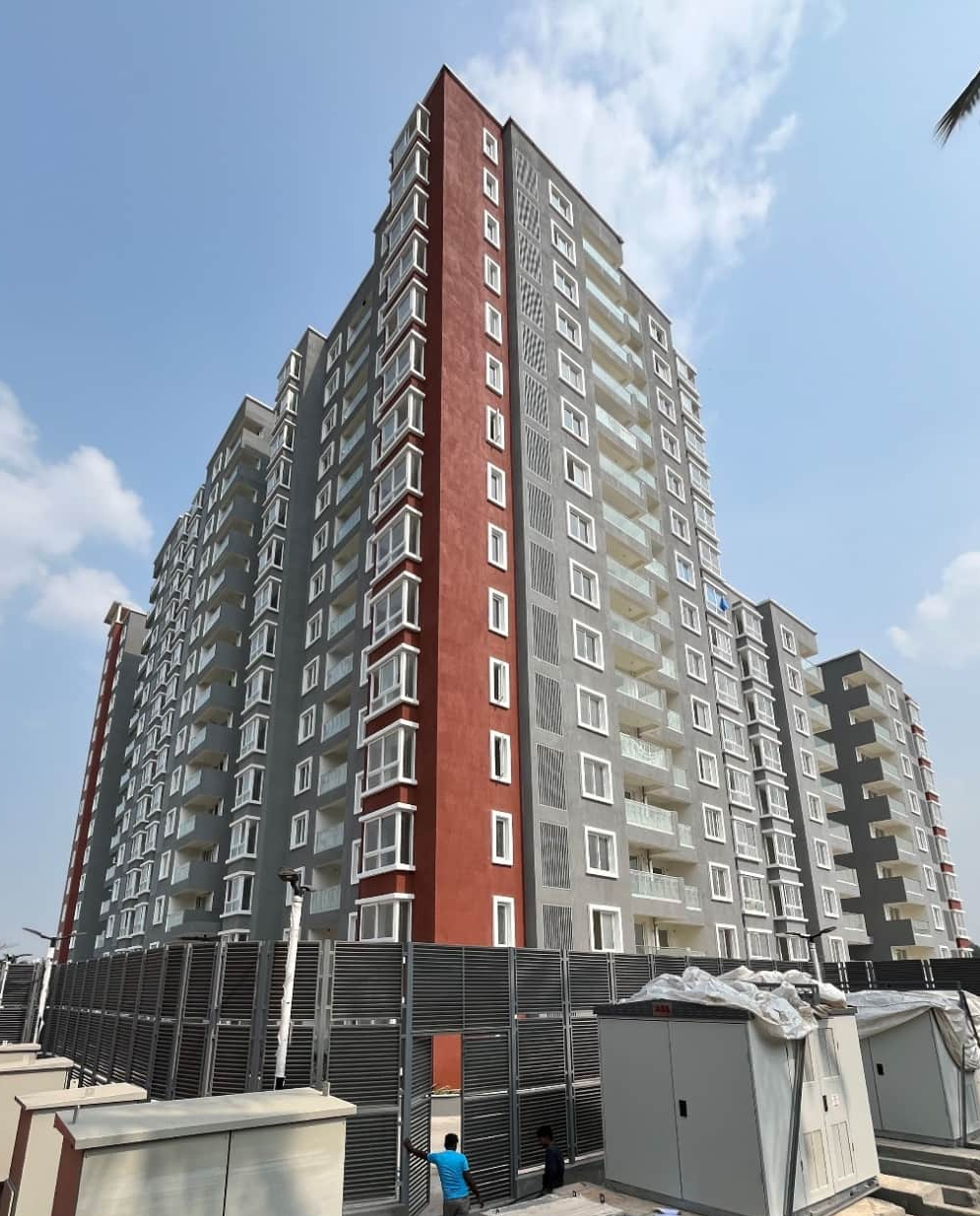

Tower D External painting work in progress. - Mar 2025

Tower B Tiling works completed - Mar 2025

Tower A East side Driveway - Mar 2025

Tower- B: Switch-plate and wiring in progress - Mar 2025

Tower A south side landscape - Mar 2025

DG & Transformer yard - Mar 2025

Tower B Tiling works completed - Mar 2025

Tower- A,C & D: Common area flooring/tiling completed - Feb 2025

Tower- A,C & D: Common area flooring/tiling completed - Feb 2025

Tower- B: Switch-plate and wiring in progress - Feb 2025

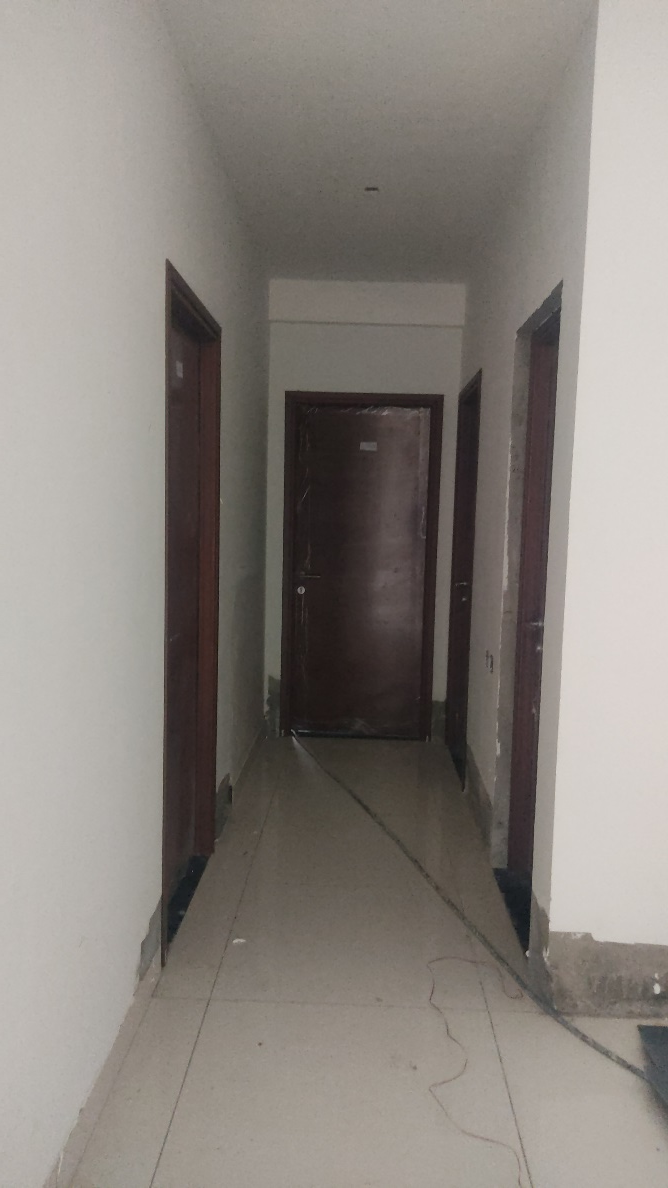

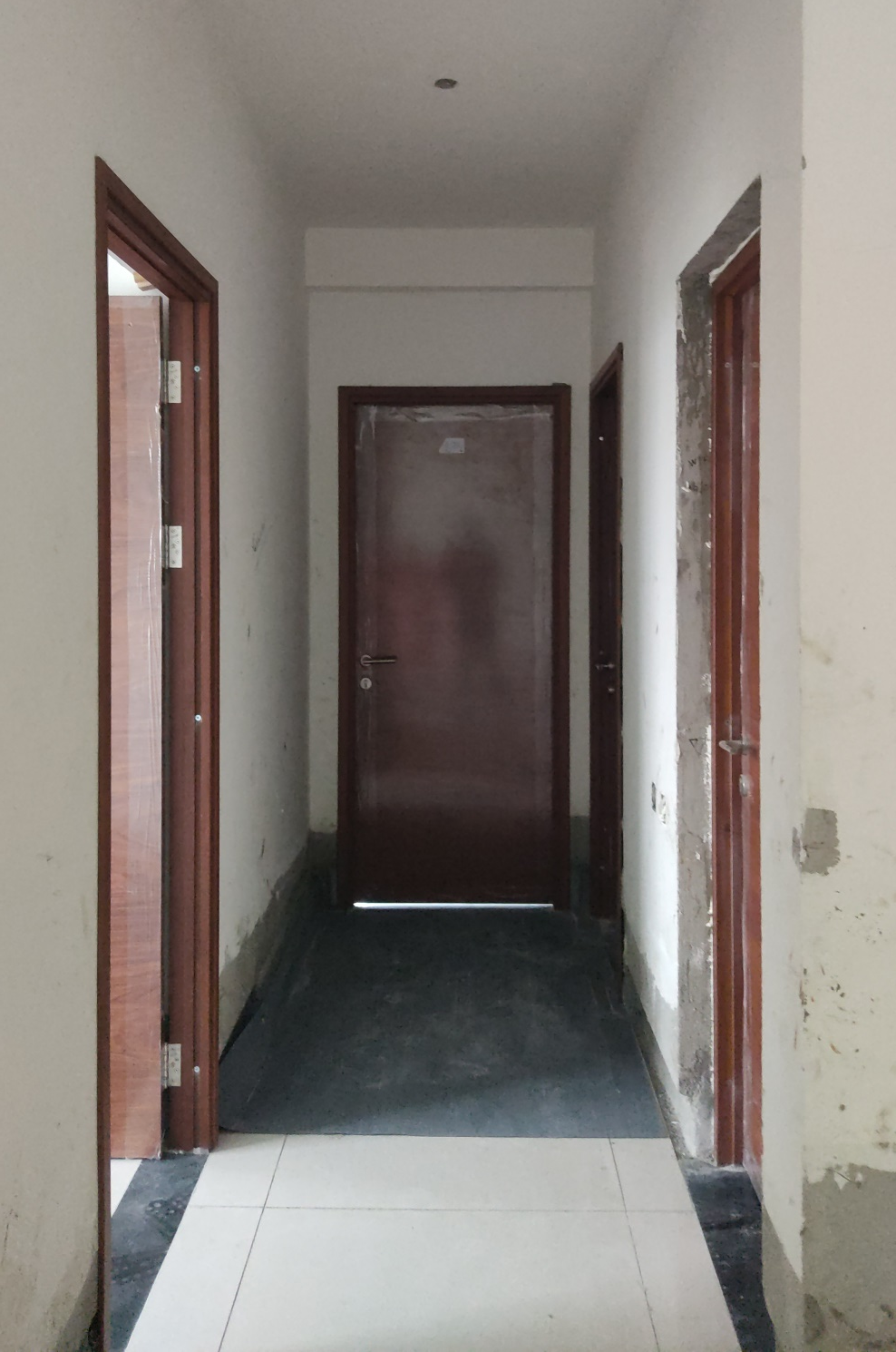

Tower- C: Windows & Door installation in progress. - Feb 2025

Tower- B: Switch-plate and wiring in progress - Feb 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Feb 2025

External Development works in progress - Feb 2025

External Development works in progress - Feb 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Feb 2025

Tower B south side Driveway - Feb 2025

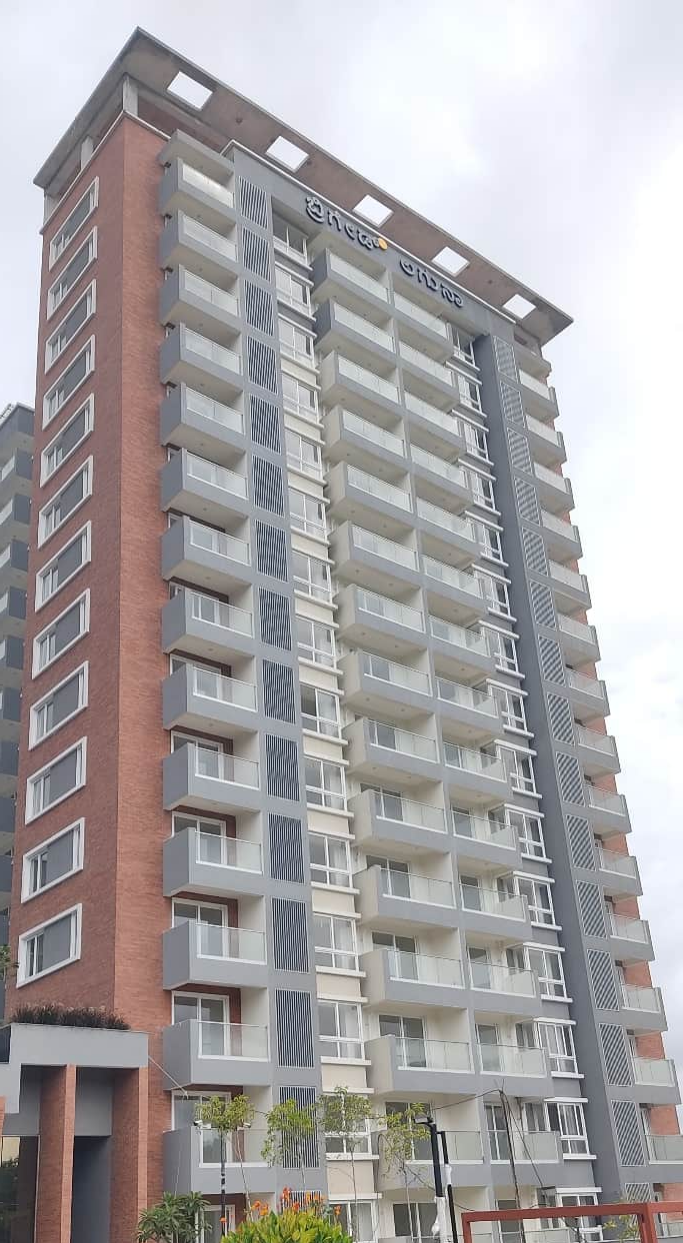

A TOWER : External Painting in progress - Feb 2025

A TOWER : External Painting in progress - Feb 2025

TOWER B: External Painting Elevation - Feb 2025

TOWER B: External Painting Elevation - Feb 2025

Tower C External painting work in progress - Feb 2025

Tower C External painting work in progress - Feb 2025

Central podium south side - Feb 2025

Tower D External painting work in progress - Feb 2025

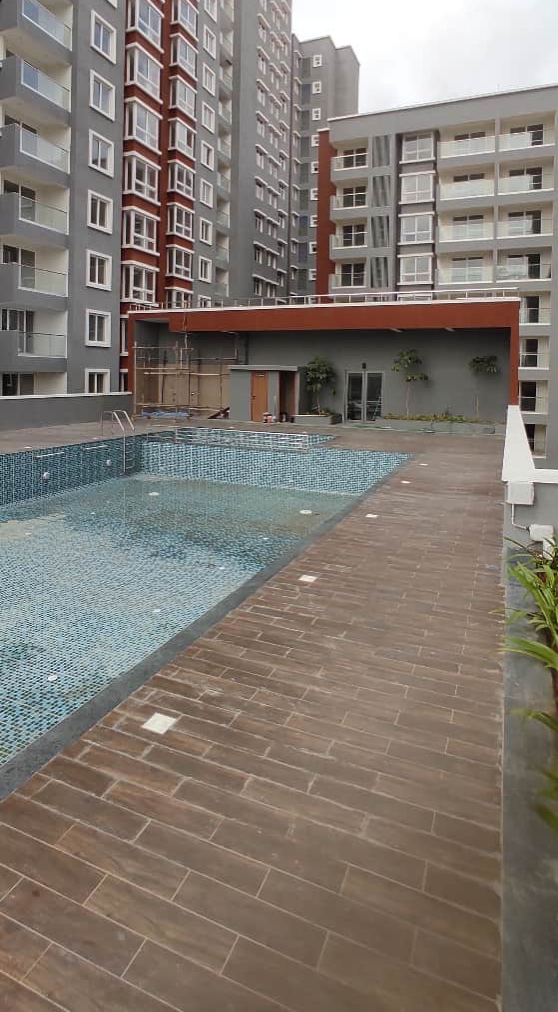

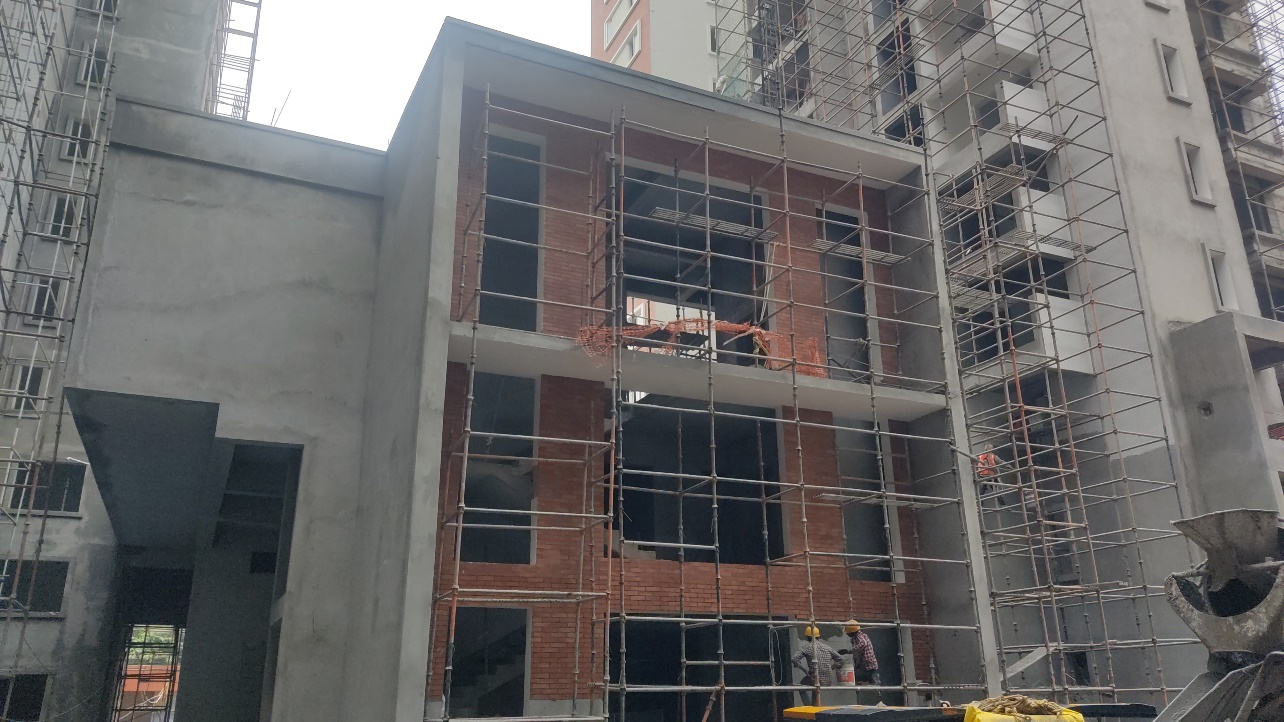

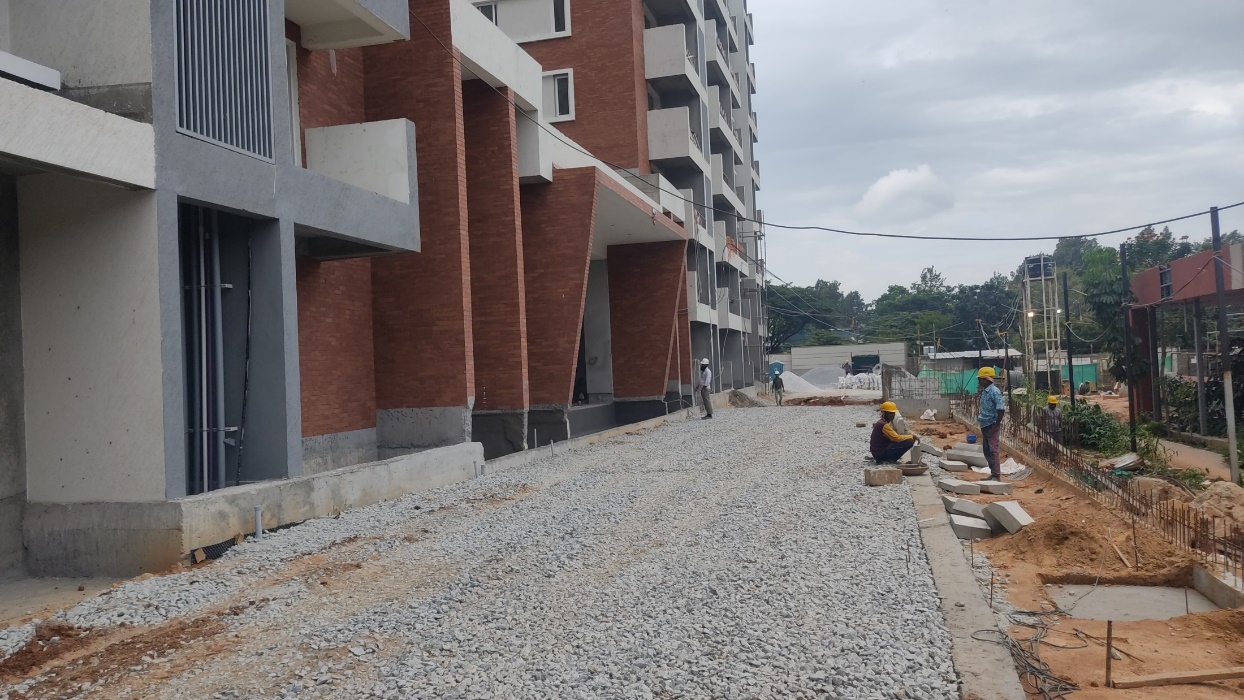

Clubhouse - External finishing and MCM works in progress - Feb 2025

DG & Transformer yard - Feb 2025

Tower A south side landscape - Feb 2025

Tower B Tiling works completed - Feb 2025

Tower B Tiling works completed - Feb 2025

Clubhouse - External finishing and MCM works in progress - Feb 2025

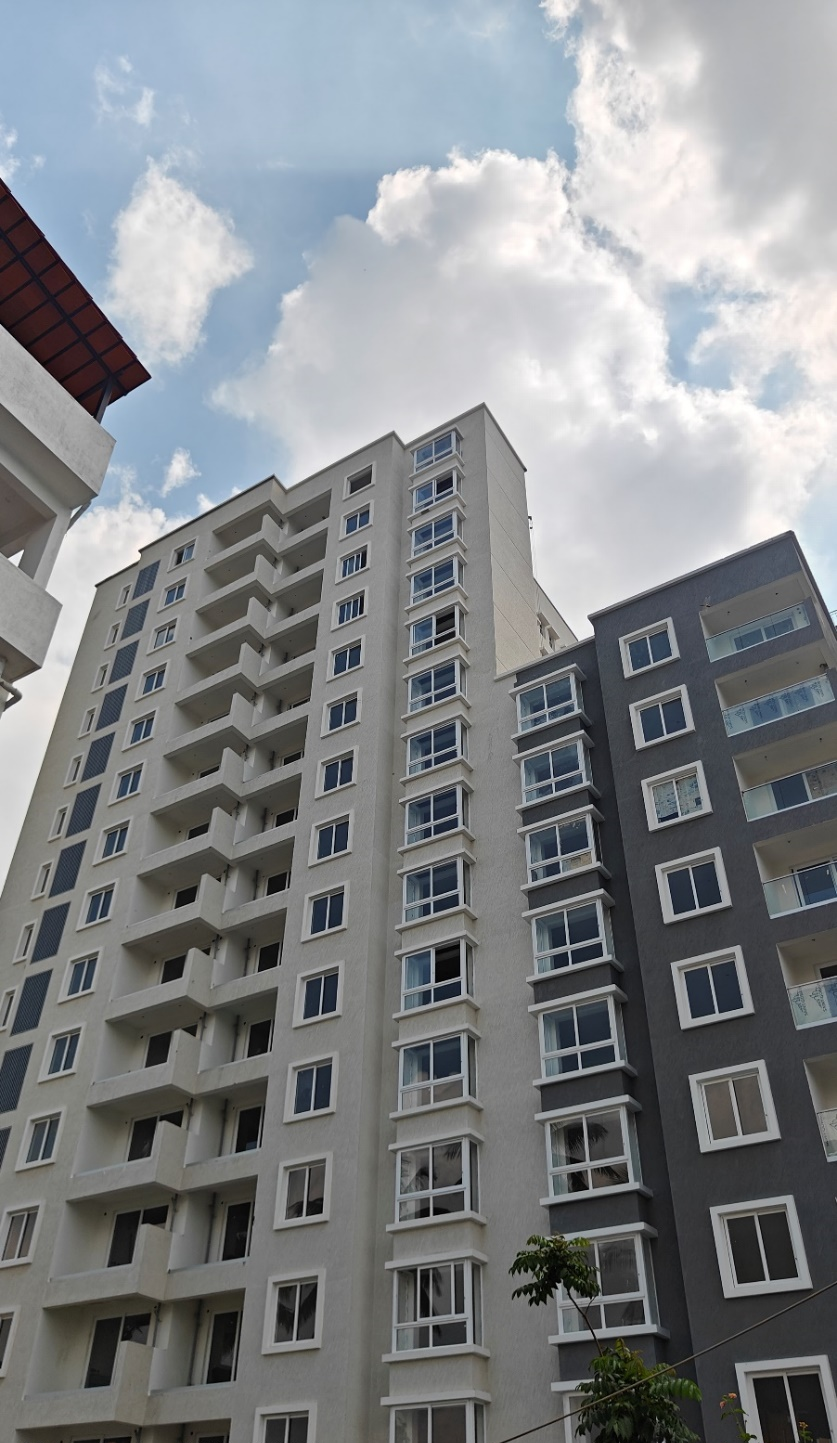

Tower- C: Windows & Door installation in progress. - Feb 2025

Tower- B: Windows & Door installation completed. - Feb 2025

Tower- B: Windows & Door installation completed. - Feb 2025

A TOWER : External Painting in progress - Jan 2025

A TOWER : External Painting in progress - Jan 2025

TOWER B: External Painting Elevation - Jan 2025

TOWER B: External Painting Elevation - Jan 2025

Tower- B: Windows & Door installation completed. - Jan 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Jan 2025

Tower- B: Switch-plate and wiring in progress - Jan 2025

Tower- B: Switch-plate and wiring in progress - Jan 2025

Tower- A,C & D: Common area flooring/tiling completed - Jan 2025

Tower- A,C & D: Common area flooring/tiling completed - Jan 2025

Tower- C: Windows & Door installation in progress. - Jan 2025

Tower- C: Windows & Door installation in progress. - Jan 2025

External Development works in progress - Jan 2025

Tower A,B,C,D – Entrance lobby finishes works in progress - Jan 2025

External Development works in progress - Jan 2025

Tower- B: Windows & Door installation completed. - Jan 2025

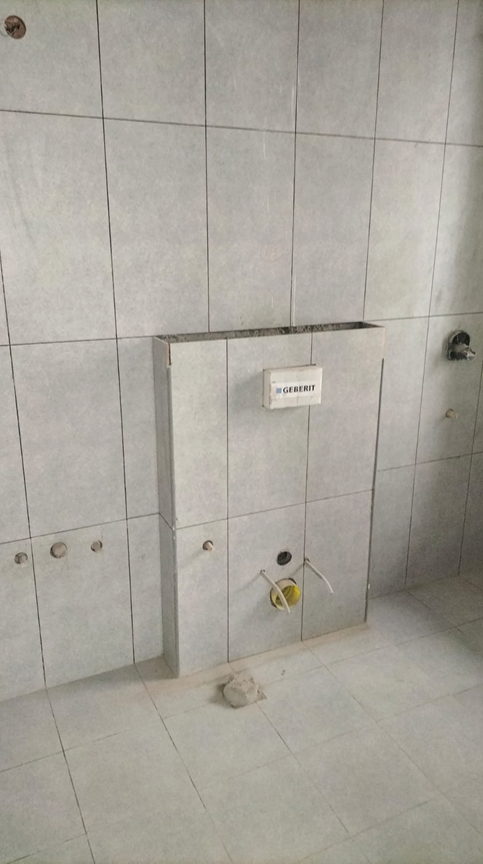

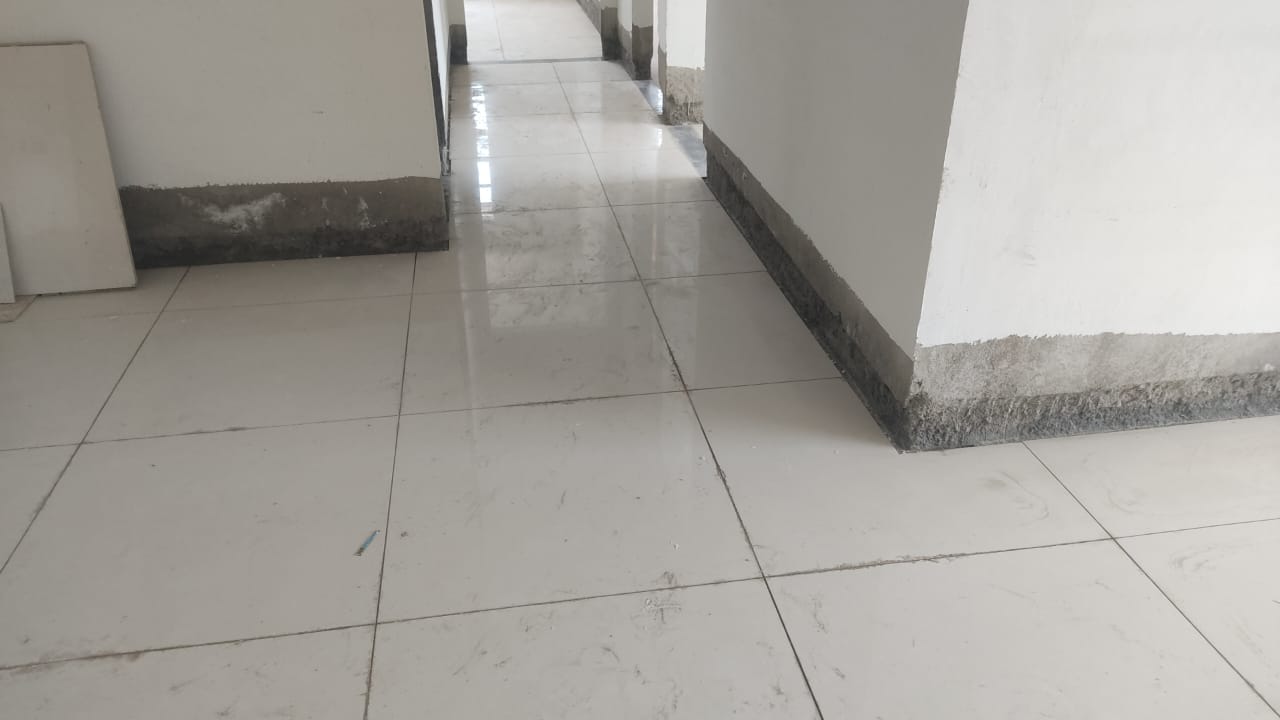

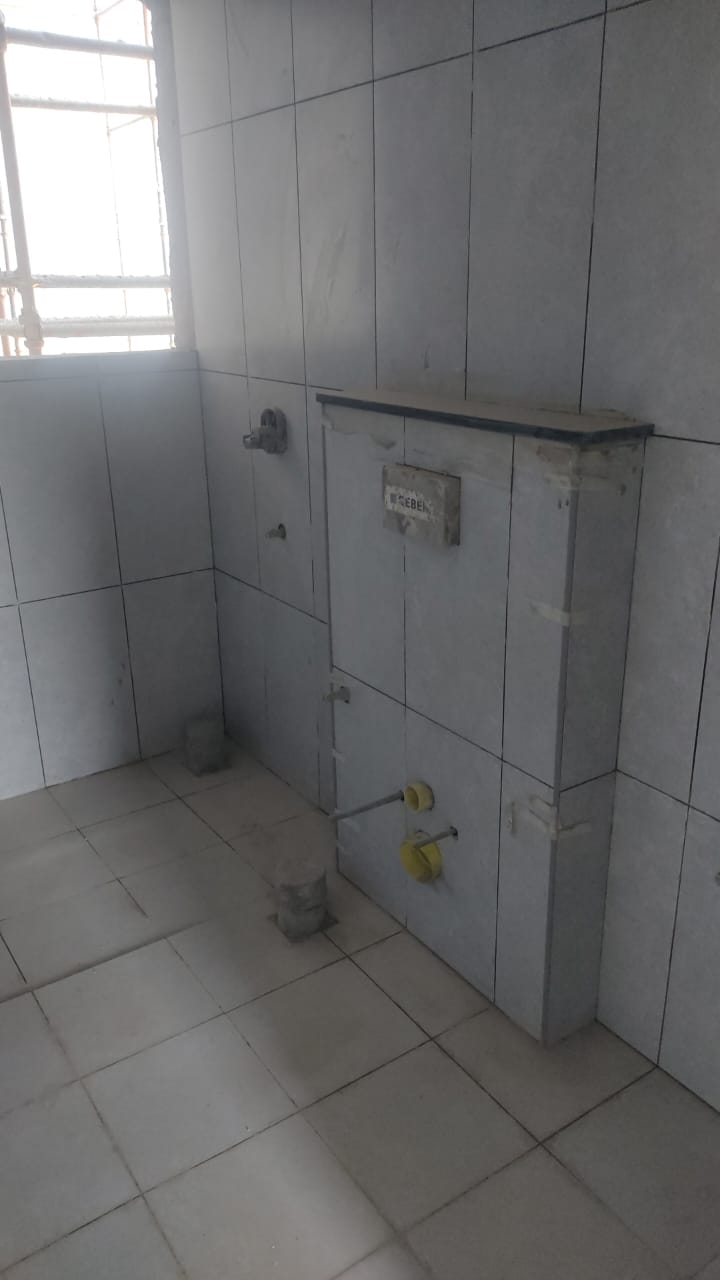

Tower A,C & D Tiling works are in progress. - Jan 2025

Tower A,C & D Tiling works are in progress. - Jan 2025

Tower A,C & D Tiling works are in progress. - Jan 2025

Tower B Tiling works completed - Jan 2025

Tower B Tiling works completed - Jan 2025

Clubhouse - External finishing and MCM works in progress - Jan 2025

Clubhouse - External finishing and MCM works in progress - Jan 2025

Tower D External painting work in progress. - Jan 2025

External painting work in progress. - Jan 2025

External painting work in progress. - Jan 2025

DG & Transformer yard - Jan 2025

Tower A South side Driveway - Jan 2025

Entrance Compound wall RCC works completed - Dec 2024

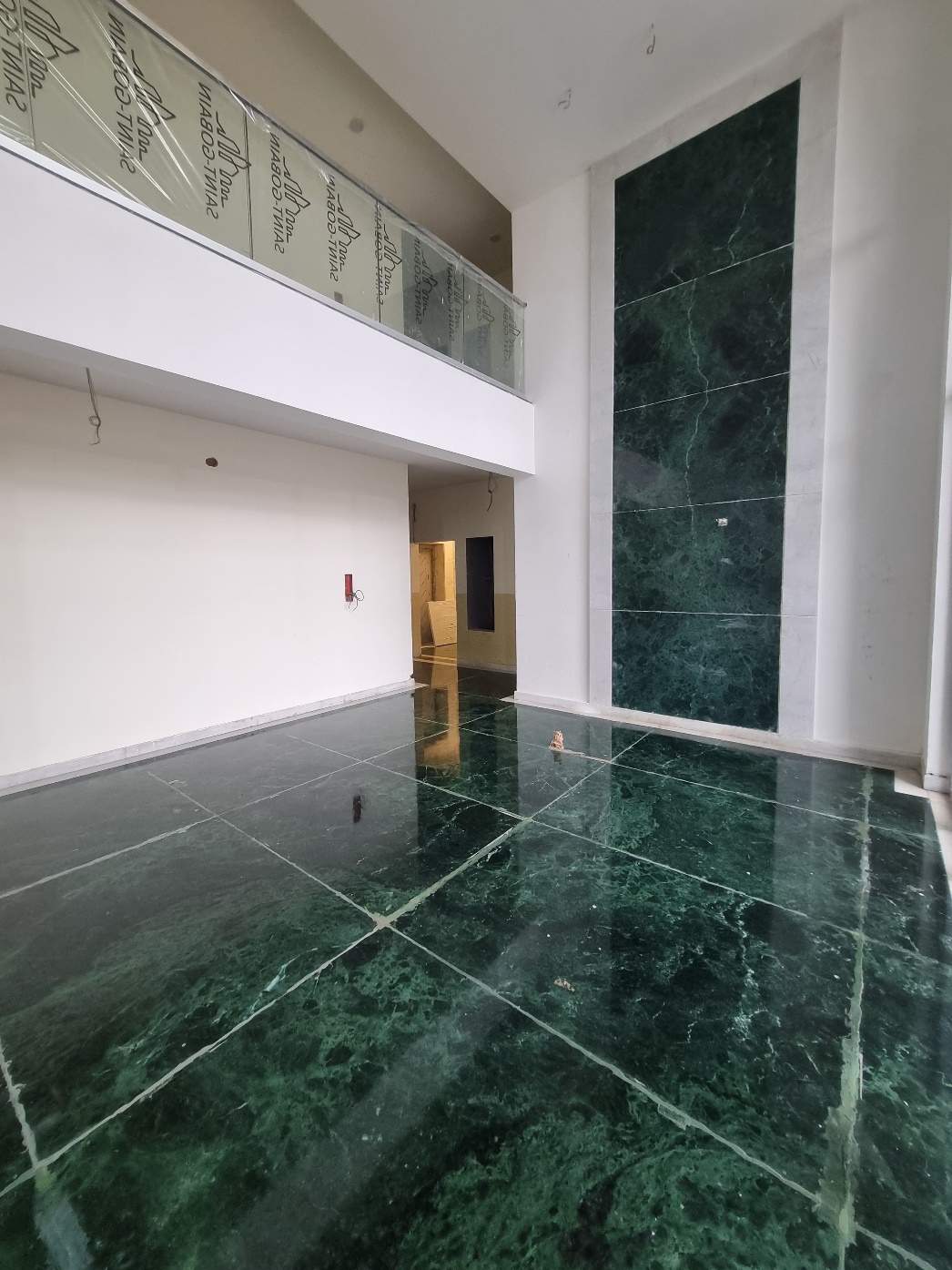

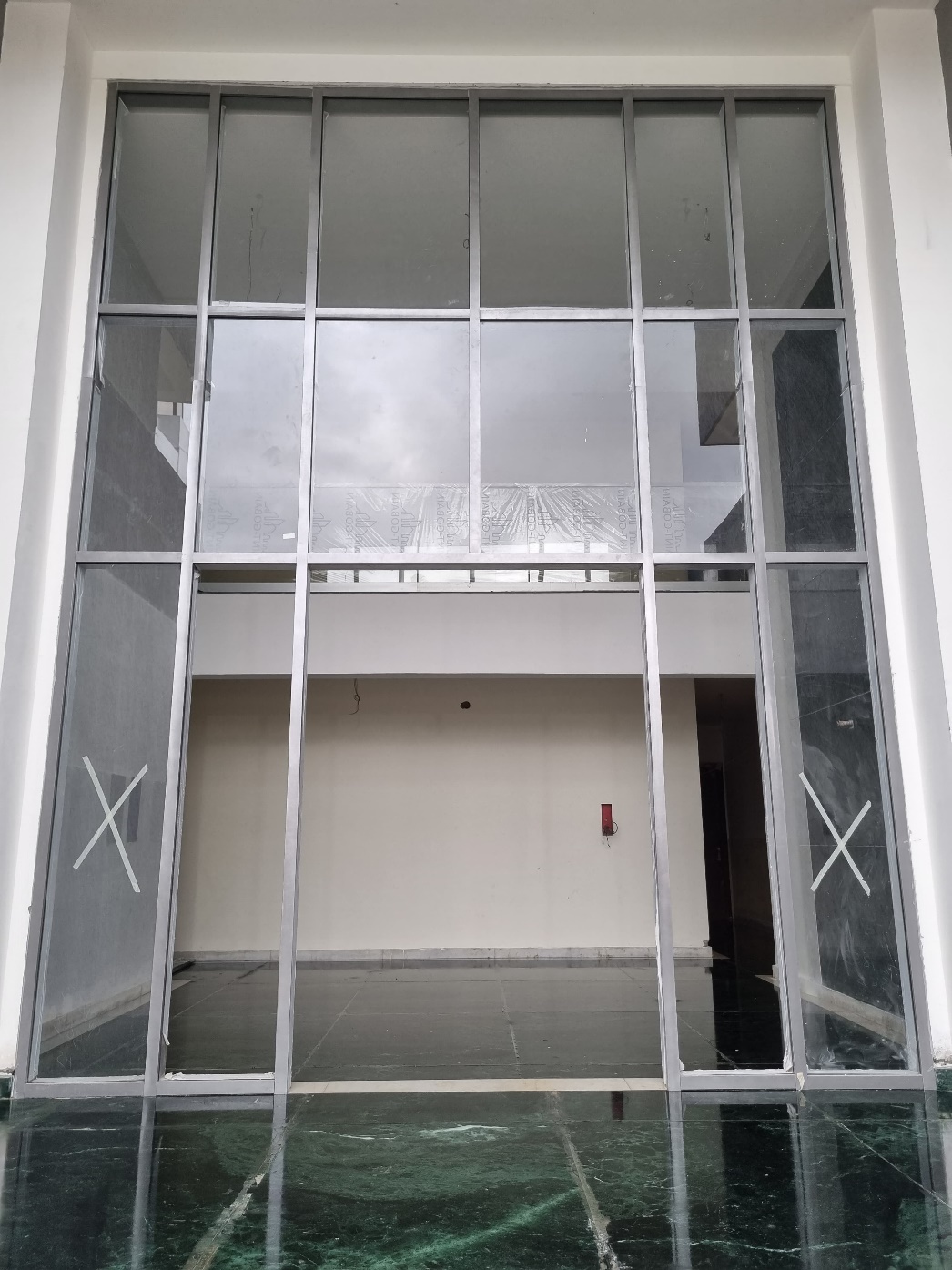

Tower B – Entrance lobby finishes works in progress - Dec 2024

Driveway finishing work in progress - Dec 2024

Driveway finishing south side - Dec 2024

Parking area pavers - Dec 2024

Entrance Compound wall Masonry works - Dec 2024

Tower- B: Switch-plate and wiring in progress - Dec 2024

Tower B – Entrance lobby finishes works in progress - Dec 2024

Tower- C: Windows & Door installation in progress. - Dec 2024

Tower- C: Windows & Door installation in progress. - Dec 2024

Tower- A,C & D: Common area flooring/tiling completed - Dec 2024

Tower C External painting work in progress. - Dec 2024

Tower- B: Windows & Door installation completed. - Dec 2024

Tower- B: Windows & Door installation completed. - Dec 2024

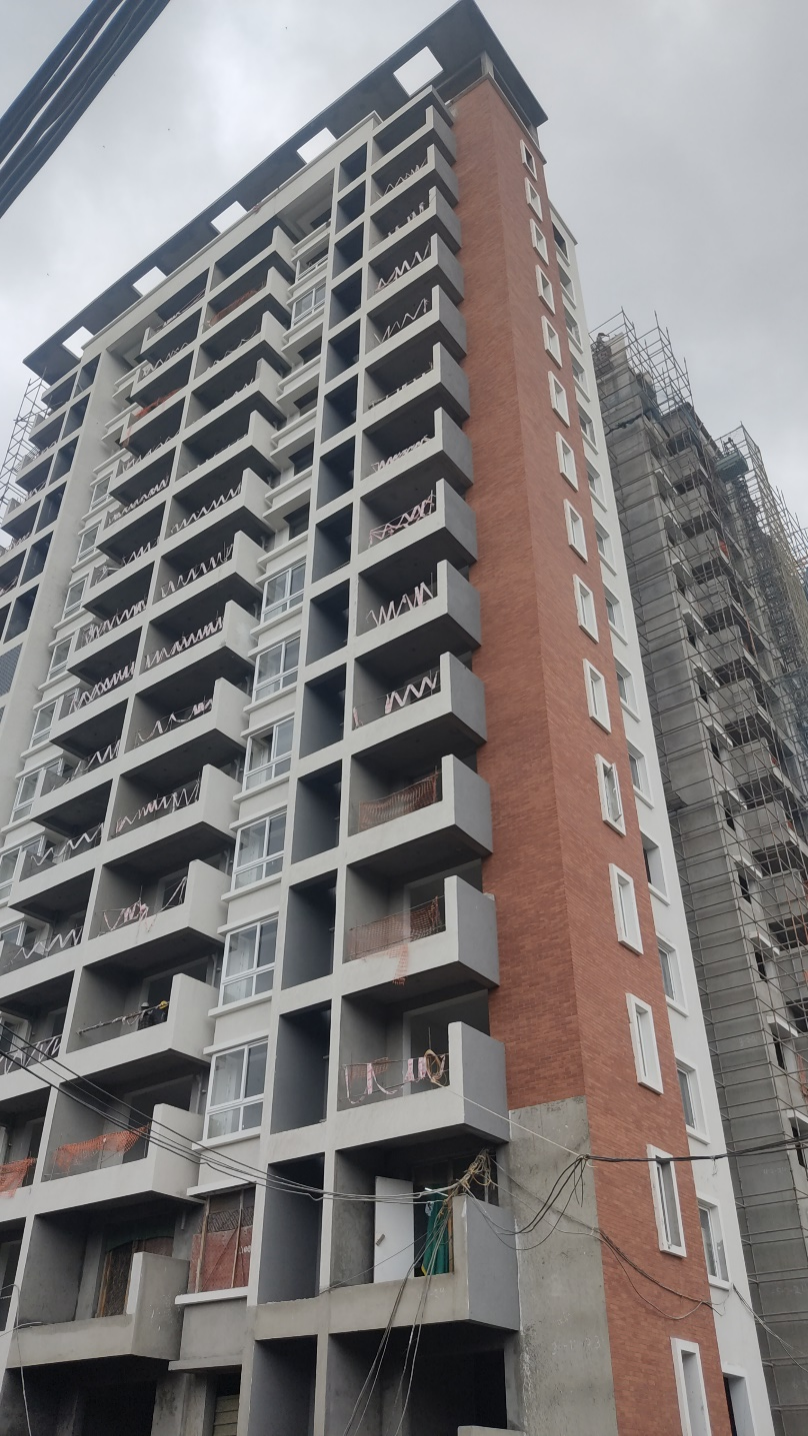

A TOWER :External plastering in progress & MCM cladding works are completed - Dec 2024

B TOWER : Planting in progress - Dec 2024

Tower A External painting work in progress. - Dec 2024

Tower A,C & D Tiling works are in progress. - Dec 2024

Tower C External painting work in progress. - Dec 2024

Tower B Tiling works completed - Dec 2024

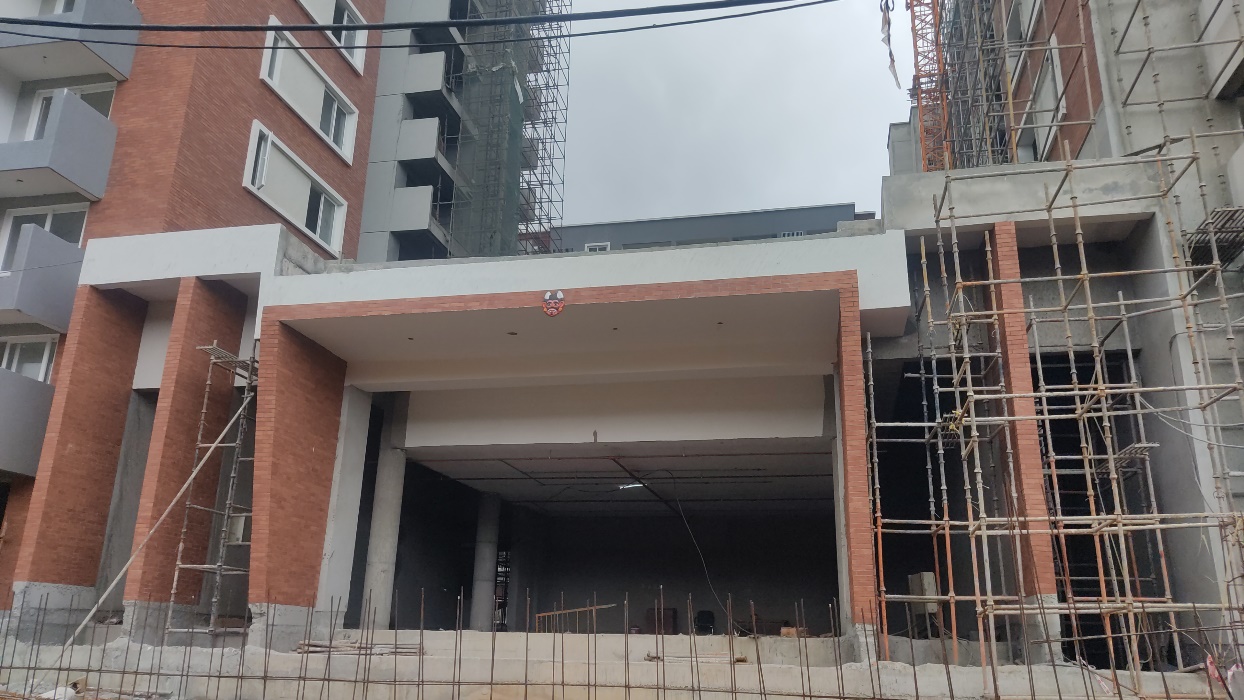

Clubhouse - External finishing and MCM works in progress - Dec 2024

Tower B Tiling works completed - Dec 2024

Clubhouse - External finishing and MCM works in progress - Dec 2024

Tower A,C & D Tiling works are in progress. - Dec 2024

Tower A,C & D Tiling works are in progress. - Dec 2024

Tower- A,C & D: Common area flooring/tiling completed - Dec 2024

Tower- B: Switch-plate and wiring in progress - Dec 2024

Entrance Compound Wall RCC Works - Nov 2024

Tower A,C & D Tiling Works are in Progress. - Nov 2024

Tower B Tiling Works Completed - Nov 2024

Tower B Tiling Works Completed - Nov 2024

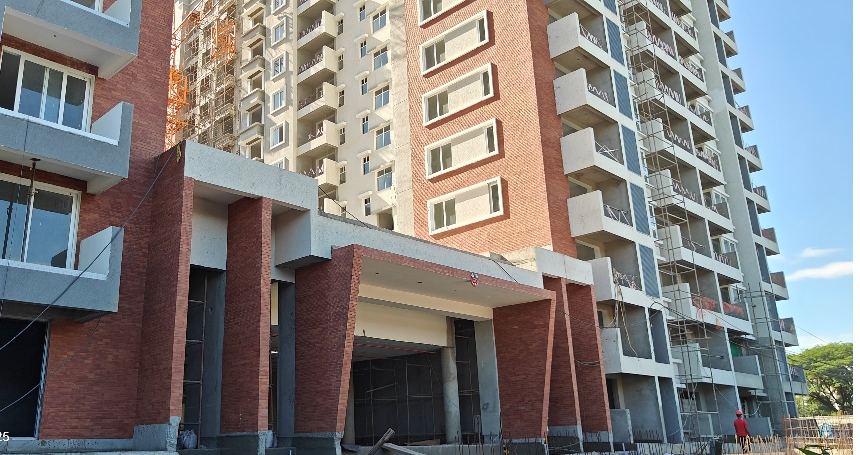

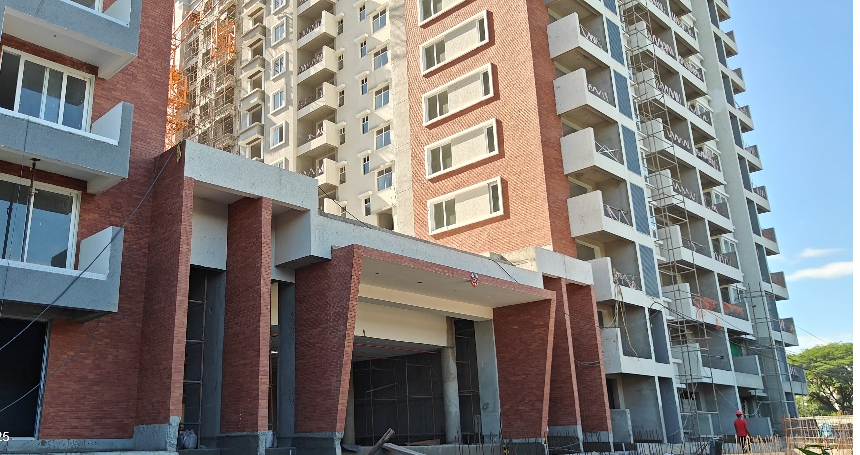

Clubhouse - External Finishing and Mcm Works in Progress - Nov 2024

Clubhouse - External Finishing and Mcm Works in Progress - Nov 2024

Tower D: External Plastering in Progress. - Nov 2024

Entrance Compound Wall Masonry Works - Nov 2024

Driveway Finishing Work in Progress - Nov 2024

Compound Wall Finishing Works - Nov 2024

Driveway Finishing South Side - Nov 2024

Parking Area Pavers - Nov 2024

Tower B – Entrance Lobby Finishes Works in Progress - Nov 2024

Tower B – Entrance Lobby Finishes Works in Progress - Nov 2024

Tower- B: Switch-plate and Wiring in Progress - Nov 2024

Tower- B: Switch-plate and Wiring in Progress - Nov 2024

Tower- B: Switch-plate and Wiring in Progress - Nov 2024

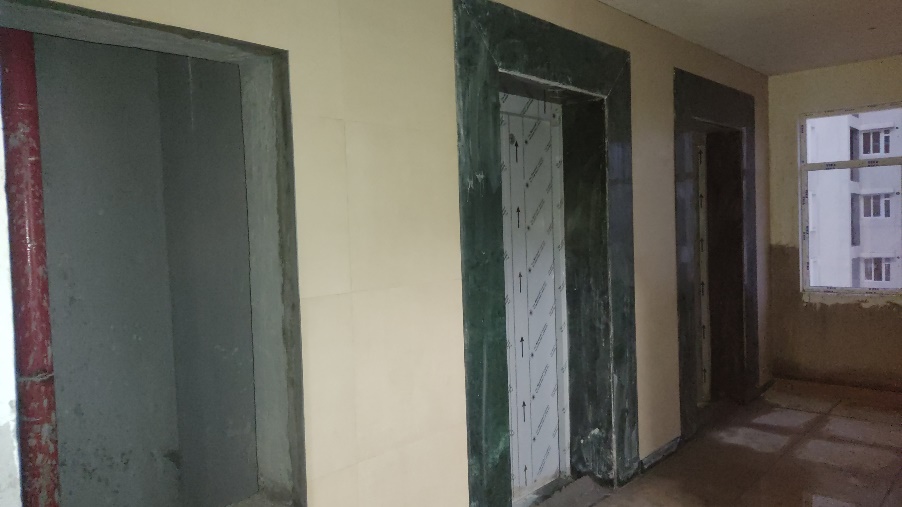

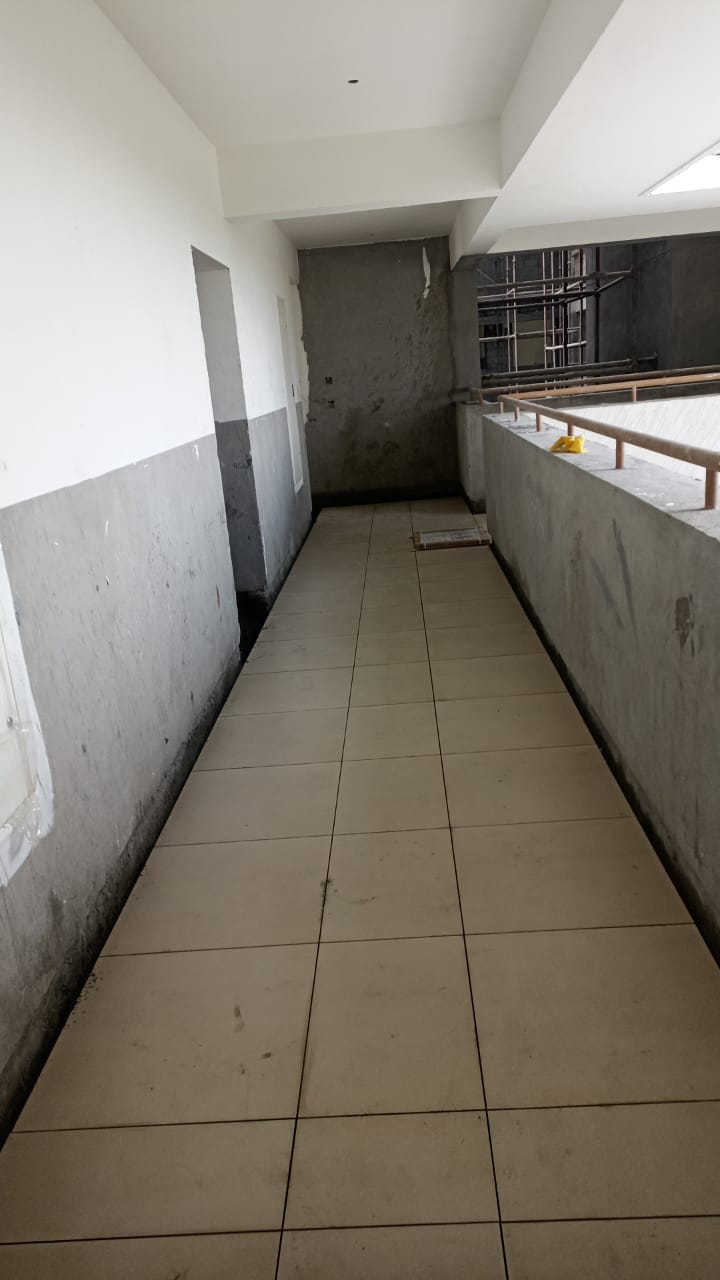

Tower- C & D: Common Area Flooring/tiling in Progress - Nov 2024

Tower- C & D: Common Area Flooring/tiling in Progress - Nov 2024

Tower- C & D: Common Area Flooring/tiling in Progress - Nov 2024

Tower- C & D: Common Area Flooring/tiling in Progress - Nov 2024

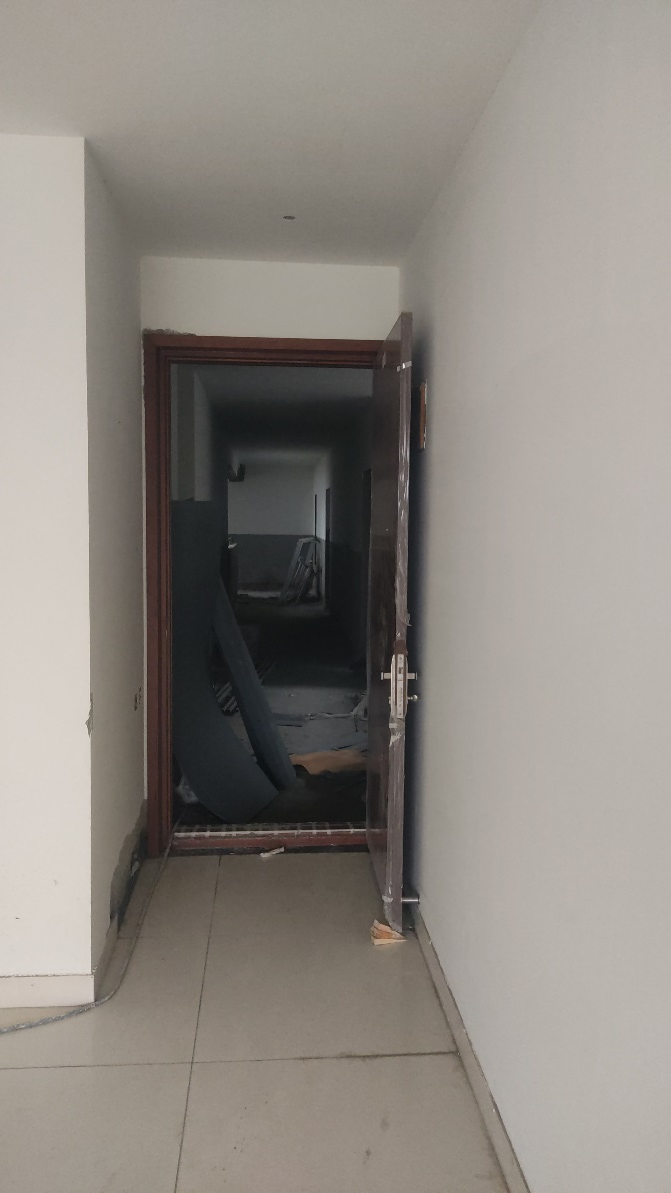

Tower- C: Windows & Door Installation in Progress. - Nov 2024

Tower- C: Windows & Door Installation in Progress. - Nov 2024

Tower- B: Windows & Door Installation Completed. - Nov 2024

Tower- B: Windows & Door Installation Completed. - Nov 2024

Tower A,C & D Tiling Works are in Progress. - Nov 2024

Tower C: External Plastering in Progress. - Nov 2024

External Plastering in Progress. - Nov 2024

B Tower : Planter Box Planting in Progress - Nov 2024

Tower A,C & D Tiling Works are in Progress. - Nov 2024

B Tower : Planter Box Planting in Progress - Nov 2024

B Tower : Planter Box Planting in Progress - Nov 2024

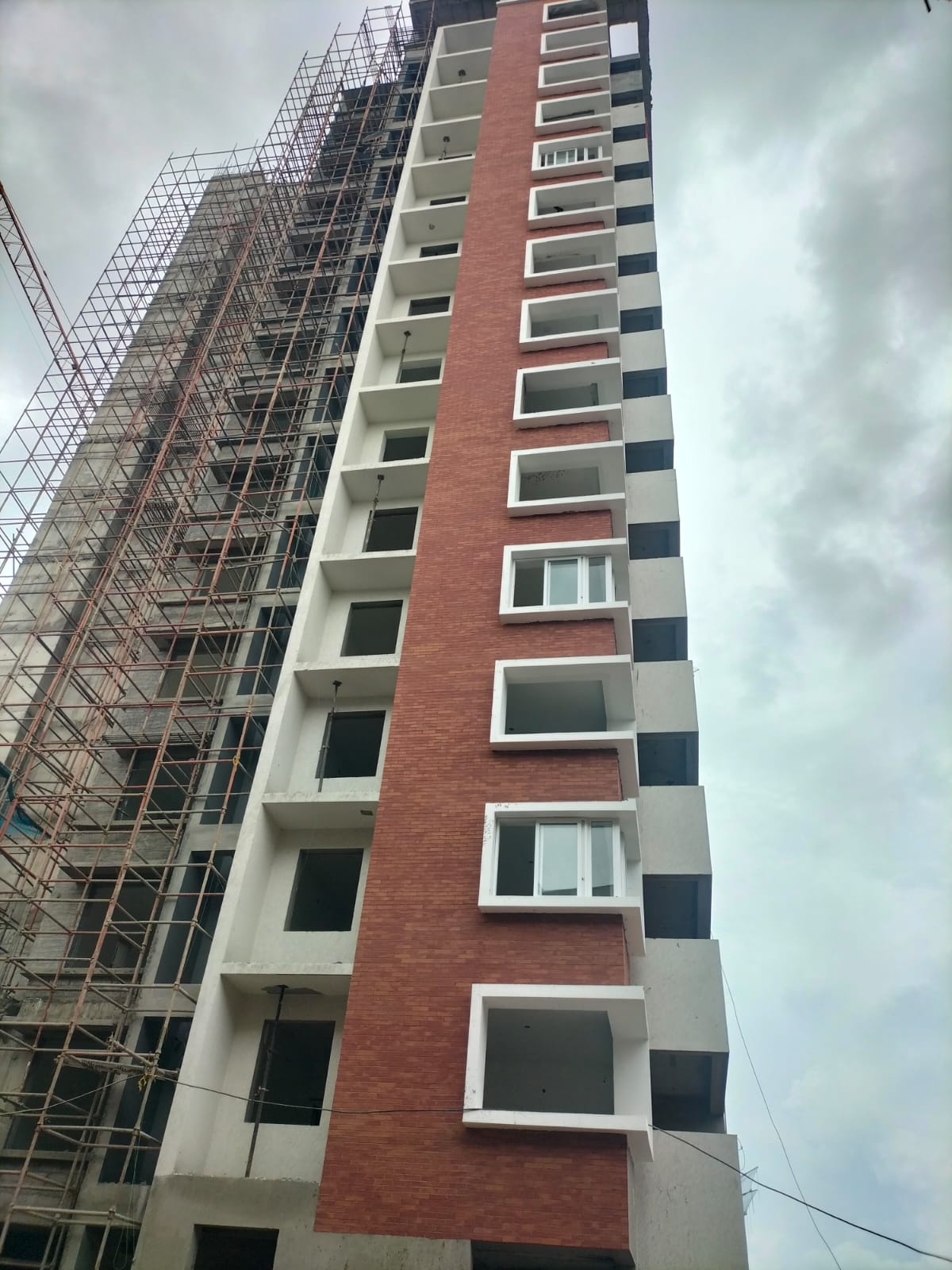

A Tower :external Plastering in Progress & Mcm Cladding Works Are Completed - Nov 2024

Tower A,C & D Tiling Works are in Progress. - Nov 2024

Tower D External texture work in progress. - Nov 2024

B TOWER : Planting in progress - Nov 2024

A TOWER :External plastering in progress & MCM cladding works are completed - Nov 2024

Tower C External plastering in progress. - Nov 2024

External texture work in progress. - Nov 2024

Clubhouse - External finishing and MCM works in progress - Nov 2024

Tower- C: Windows & Door installation in progress. - Nov 2024

South side – Driveway works in progress - Nov 2024

Tower- A,C & D: Common area flooring/tiling completed - Nov 2024

Entrance Compound wall Masonry works - Nov 2024

South side – Driveway works in progress - Nov 2024

Tower A,C & D Tiling works are in progress. - Nov 2024

Tower B – Entrance lobby finishes works in progress - Nov 2024

Tower- A,C & D: Common area flooring/tiling completed - Nov 2024

Tower B Tiling works completed - Nov 2024

Entrance Compound wall RCC works - Nov 2024

Tower- B: Switch-plate and wiring in progress - Nov 2024

Tower B – Entrance lobby finishes works in progress - Nov 2024

Tower- B: Windows & Door installation completed. - Nov 2024

Tower- C: Windows & Door installation in progress. - Nov 2024

Tower B Tiling works completed - Nov 2024

Tower- B: Switch-plate and wiring in progress - Nov 2024

Tower A,C & D Tiling works are in progress. - Nov 2024

Clubhouse - External finishing and MCM works in progress - Nov 2024

Tower A,C & D Tiling works are in progress. - Nov 2024

Driveway finishing work in progress - Nov 2024

B TOWER : Planter box Planting in progress - Oct 2024

Tower C – Milestone Release –“On Commencement of Fixing of Doors and windows 11th to 14th Floor” – Status as on 30th - Oct 2024

Tower- C: Windows & Door installation in progress. - Oct 2024

Tower- C: Windows & Door installation in progress. - Oct 2024

Tower- B: Windows & Door installation completed. - Oct 2024

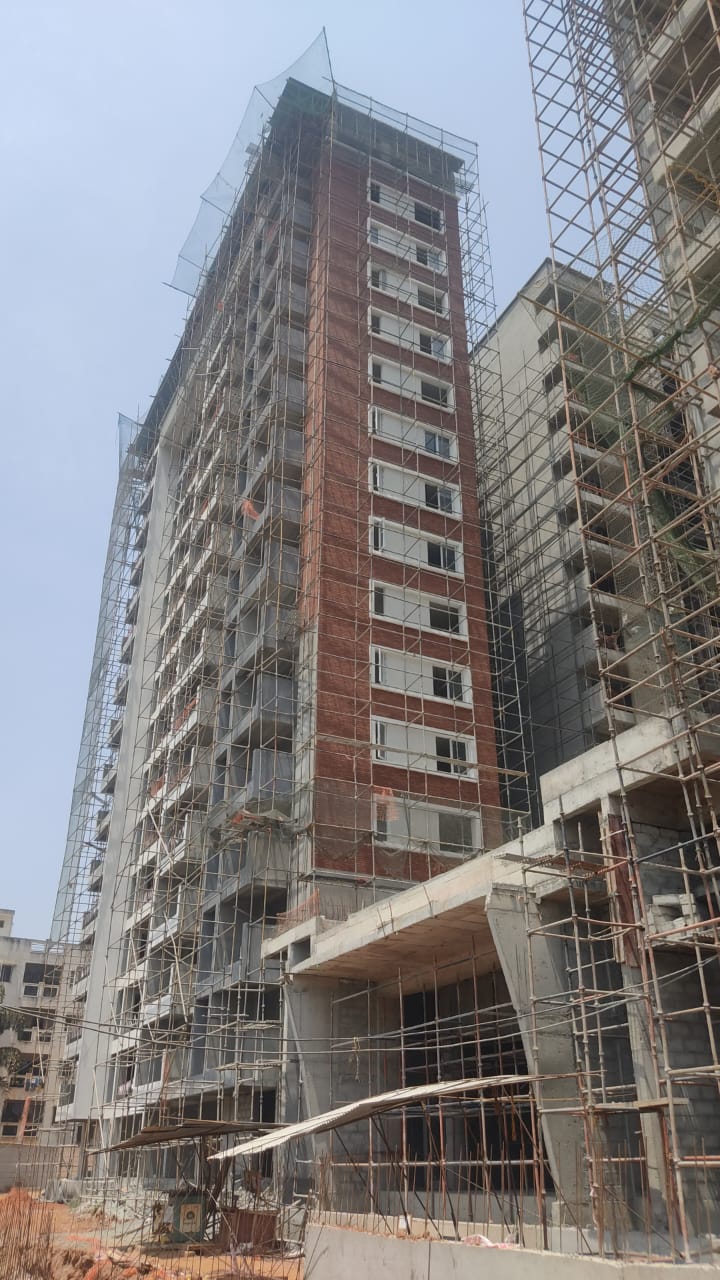

A TOWER :External plastering in progress & MCM cladding works are completed - Oct 2024

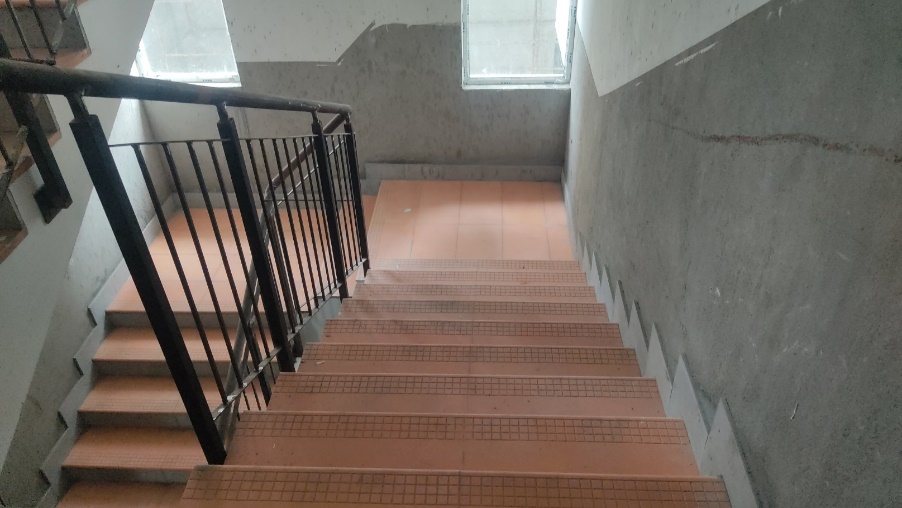

Tower- C & D: Common area flooring/tiling in progress - Oct 2024

Tower- C & D: Common area flooring/tiling in progress - Oct 2024

B TOWER : Planter box Planting in progress - Oct 2024

External plastering in progress. - Oct 2024

Tower C - External texture work in progress. - Oct 2024

Tower D - External texture work in progress. - Oct 2024

Clubhouse - External finishing and MCM works in progress - Oct 2024

Clubhouse - External finishing and MCM works in progress - Oct 2024

Tower B Tiling works completed - Oct 2024

Tower B Tiling works completed - Oct 2024

Tower A,C & D Tiling works are in progress. - Oct 2024

Tower A,C & D Tiling works are in progress. - Oct 2024

Tower A,C & D Tiling works are in progress. - Oct 2024

Tower A,C & D Tiling works are in progress. - Oct 2024

Tower- C & D: Common area flooring/tiling in progress - Oct 2024

Tower- B: Switch-plate and wiring in progress - Oct 2024

Tower- B: Switch-plate and wiring in progress - Oct 2024

Tower- C & D: Common area flooring/tiling in progress - Oct 2024

Tower- B: Switch-plate and wiring in progress - Oct 2024

South side – Driveway works in progress Parking area pavers - Oct 2024

South side – Driveway works in progress Driveway finishing south side - Oct 2024

External Development works - Compound wall finishing works - Oct 2024

External Development works Driveway finishing work in progress - Oct 2024

Tower B – Entrance lobby finishes works in progress - Oct 2024

Tower B – Entrance lobby finishes works in progress - Oct 2024

Tower C – Milestone Release –“On Commencement of Fixing of Doors and windows 11th to 14th Floor” – Status as on 30th - Oct 2024

Tower- B: Windows & Door installation completed. - Oct 2024

A TOWER :External plastering in progress & MCM cladding works are completed - Oct 2024

B TOWER : Planter box Planting in progress - Oct 2024

A TOWER :External plastering in progress & MCM cladding works are completed - Sep 2024

External plastering in progress - Sep 2024

B TOWER : Planter box Planting in progress - Sep 2024

Tower D External texture work in progress. - Sep 2024

Tower- C: Windows & Door installation in progress. - Sep 2024

B TOWER : Planter box Planting in progress - Sep 2024

B TOWER : Planter box Planting in progress - Sep 2024

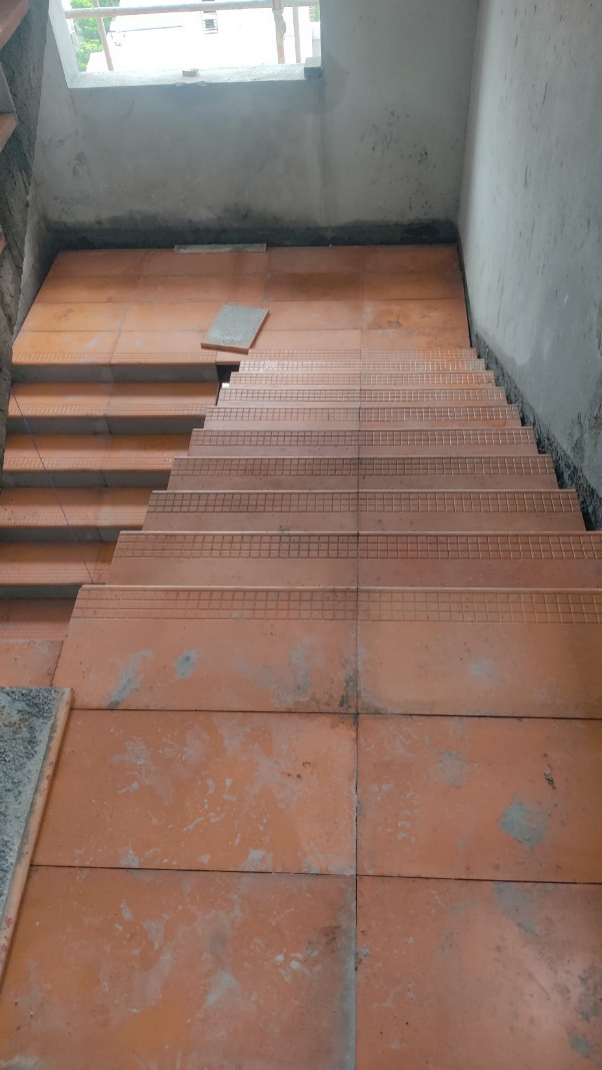

Tower- C & D: Common area flooring/tiling in progress - Sep 2024

Tower A,C & D Tiling works are in progress. - Sep 2024

External plastering in progress - Sep 2024

Tower B Tiling works completed - Sep 2024

A TOWER :External plastering in progress & MCM cladding works are completed - Sep 2024

Tower- B: Switch-plate and wiring in progress - Sep 2024

Tower B – Entrance lobby finishes works in progress - Sep 2024

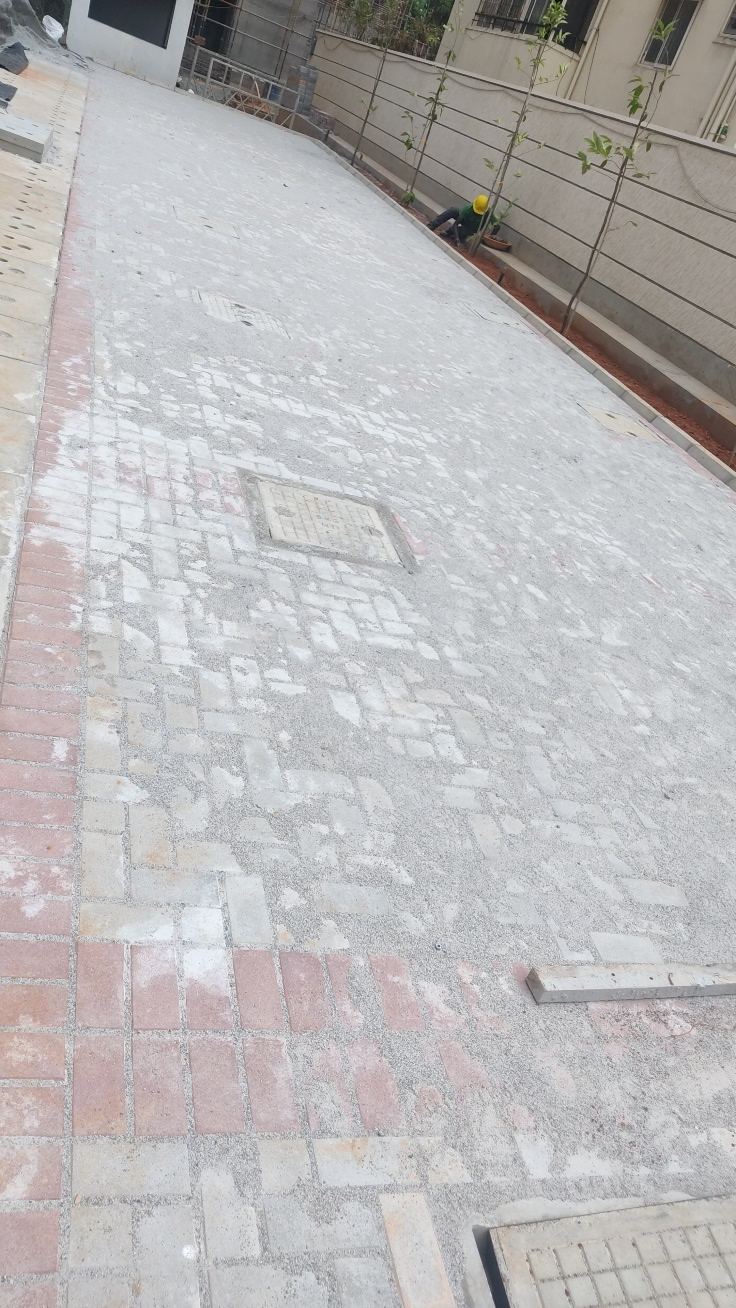

South side – Driveway works in progress Parking area pavers - Sep 2024

South side – Driveway works in progress Driveway waterproofing - Sep 2024

Tower B – Entrance lobby finishes works in progress - Sep 2024

External Development works - Compound wall finishing works - Sep 2024

External Development works - Driveway finishing work in progress - Sep 2024

Tower- B: Switch-plate and wiring in progress - Sep 2024

Tower - C & D: Common area flooring/tiling in progress - Sep 2024

Tower - C & D: Common area flooring/tiling in progress - Sep 2024

Tower- B: Switch-plate and wiring in progress - Sep 2024

Tower - C & D: Common area flooring/tiling in progress - Sep 2024

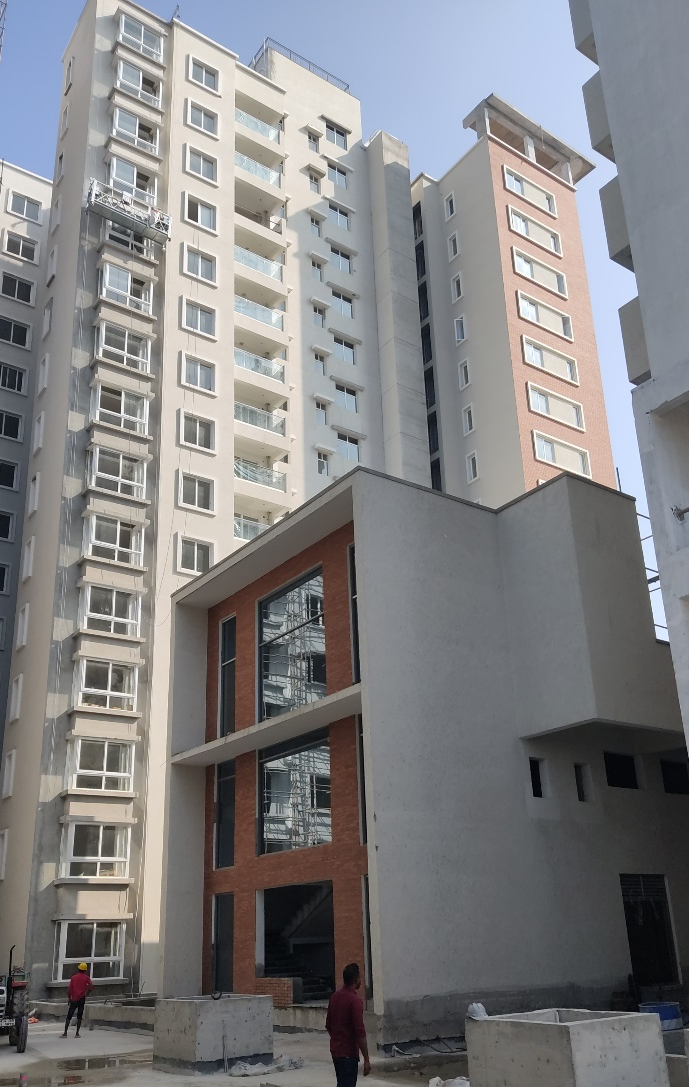

Clubhouse - External finishing and MCM works in progress - Sep 2024

Tower C External texture work in progress. - Sep 2024

Tower- B: Windows & Door installation completed. - Sep 2024

Tower- C: Windows & Door installation in progress. - Sep 2024

Tower B Tiling works completed - Sep 2024

Tower A,C & D Tiling works are in progress. - Sep 2024

Tower- B: Windows & Door installation completed. - Sep 2024

Tower A,C & D Tiling works are in progress. - Sep 2024

Tower A,C & D Tiling works are in progress. - Sep 2024

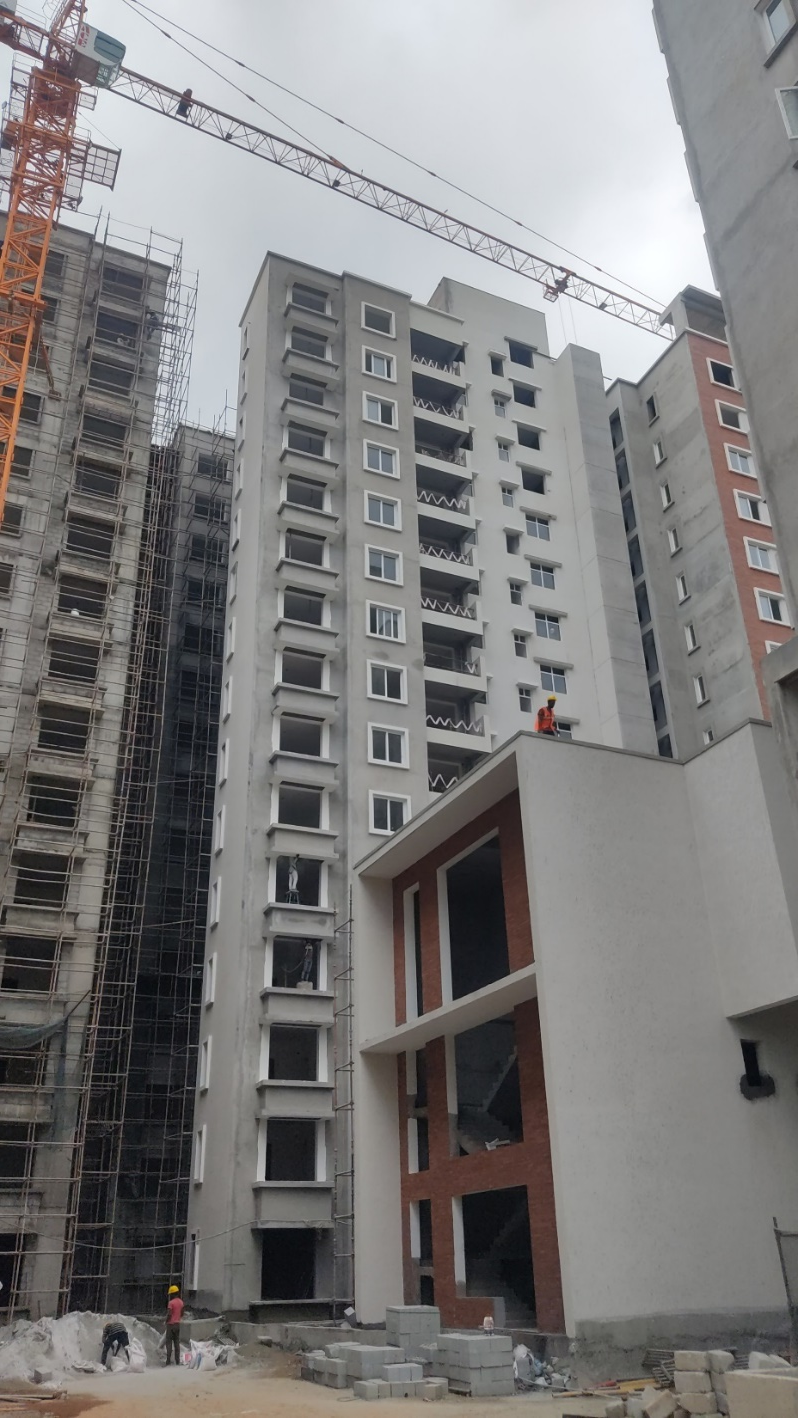

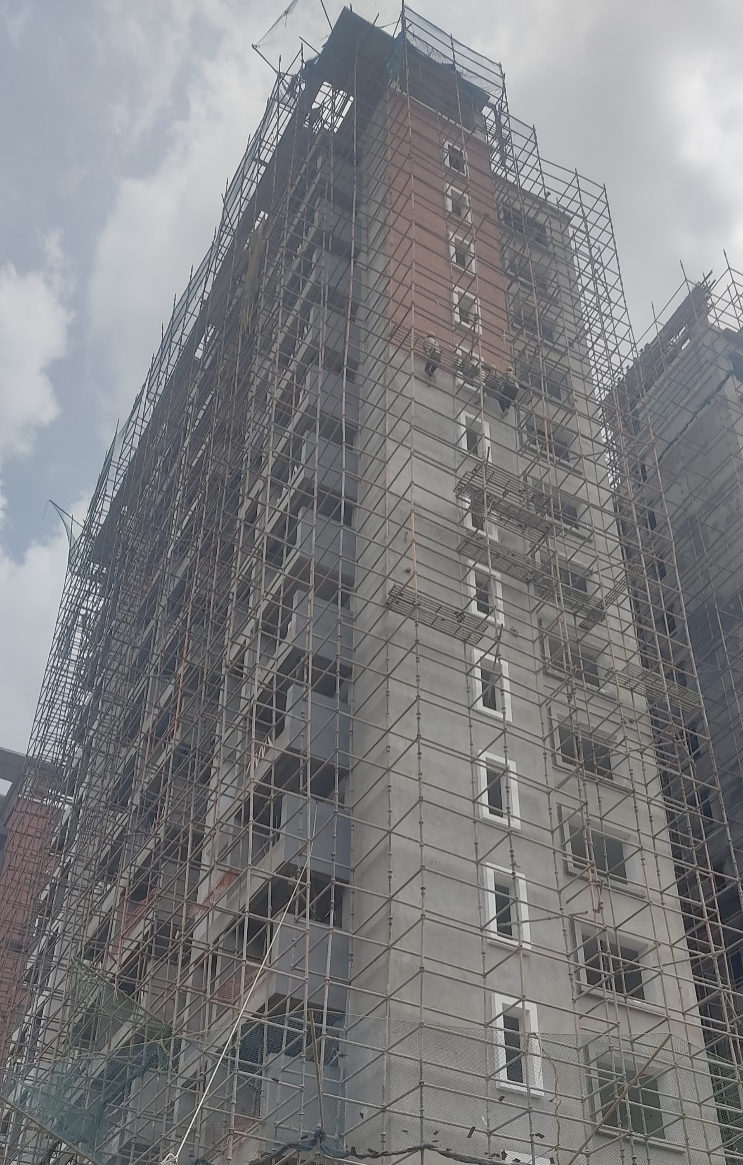

D TOWER :External plastering & MCM cladding works are in progress: - Aug 2024

Tower- C & D: Common area flooring tiling in progress - Aug 2024

B TOWER : Planter box Planting in progress - Aug 2024

Tower- C: Windows & Door installation in progress. - Aug 2024

A TOWER :External plastering & MCM cladding works are in completed - Aug 2024

Tower- C: Windows & Door installation in progress. - Aug 2024

Driveway Waterproofing - Aug 2024

Parking Area Pavers - Aug 2024

External plastering & texture work in progress. - Aug 2024

B TOWER : Planter box Planting in progress - Aug 2024

B TOWER : Planter box Planting in progress - Aug 2024

Tower- B: Switch-plate and wiring in progress - Aug 2024

Tower- B: Switch-plate and wiring in progress - Aug 2024

Tower B – Entrance lobby finishes works in progress - Aug 2024

Tower- B: Switch-plate and wiring in progress - Aug 2024

Tower- C & D: Common area flooring tiling in progress - Aug 2024

Tower- C & D: Common area flooring tiling in progress - Aug 2024

Tower- C & D: Common area flooring tiling in progress - Aug 2024

Tower- C: Windows & Door installation in progress. - Aug 2024

Driveway finishing work in progress - Aug 2024

D TOWER :External plastering & MCM cladding works are in progress: - Aug 2024

Compound wall finishing works - Aug 2024

Tower B – Entrance lobby finishes works in progress - Aug 2024

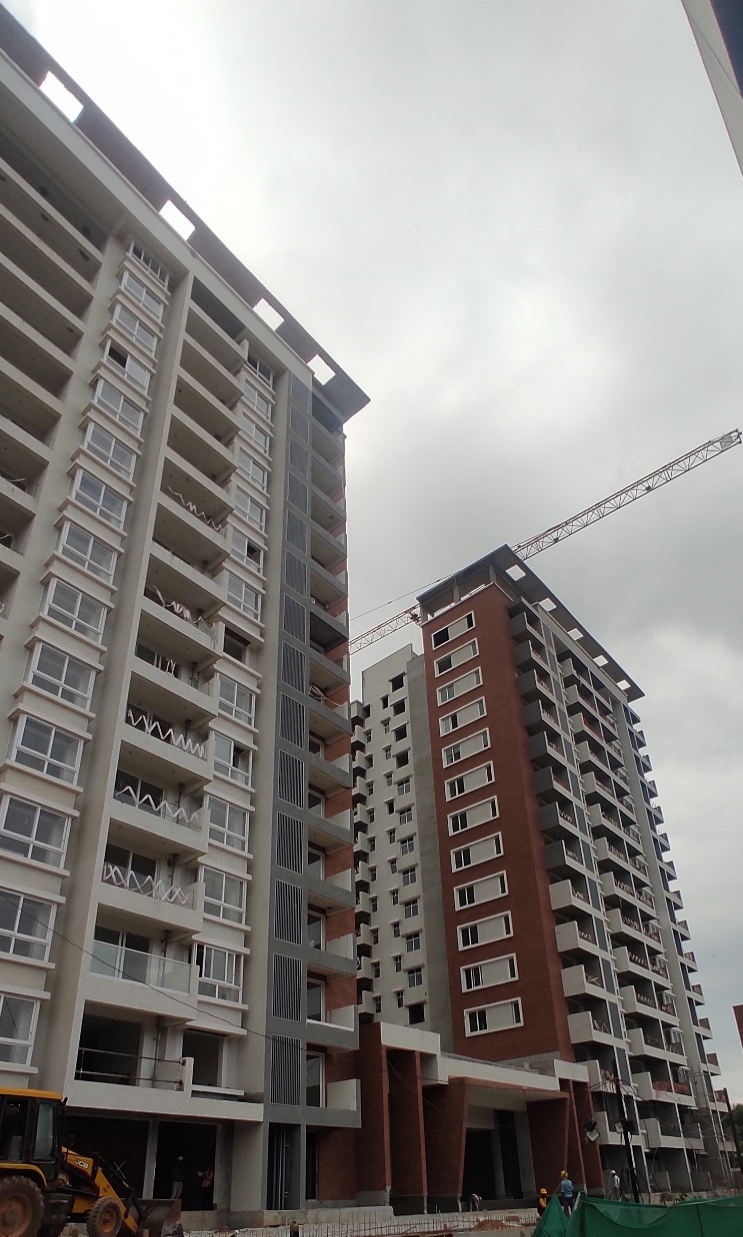

A TOWER :External plastering & MCM cladding works are in completed - Aug 2024

D TOWER : Terrace Tiling completed - Aug 2024

C TOWER : Terrace tiling works completed - Aug 2024

Clubhouse - External finishing and MCM works in progress - Aug 2024

Clubhouse - External finishing and MCM works in progress - Aug 2024

Tower B Tiling works completed - Aug 2024

Tower B Tiling works completed - Aug 2024

Tower A,C & D Tiling works are in progress. - Aug 2024

Tower A,C & D Tiling works are in progress. - Aug 2024

Tower A,C & D Tiling works are in progress. - Aug 2024

Tower A,C & D Tiling works are in progress. - Aug 2024

Tower- B: Windows & Door installation completed. - Aug 2024

Tower- B: Windows & Door installation completed. - Aug 2024

External plastering & texture work in progress. - Aug 2024

Tower C – Milestone Release –“ Commencement of fixing of door & Windows 06th to 10th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows 06th to 10th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows Ground to 5th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows Ground to 5th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows 06th to 10th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows Ground to 5th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows Ground to 5th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows Ground to 5th Floor” – Status as on 12th - Aug 2024

Tower C – Milestone Release –“ Commencement of fixing of door & Windows Ground to 5th Floor” – Status as on 12th - Aug 2024

Tower D – Milestone Release –“ Commencement of fixing of door & Windows 06th to 10th Floor” – Status as on 12th - Aug 2024

Tower C – Milestone Release –“ Commencement of fixing of door & Windows 06th to 10th Floor” – Status as on 12th - Aug 2024

Clubhouse - External Finishing and MCM Works in Progress - Jul 2024

Clubhouse - External Finishing and MCM Works in Progress - Jul 2024

Tower B Tiling Works Completed - Jul 2024

Tower A, C & D Tiling Works Are in Progress - Jul 2024

Tower A, C & D Tiling Works Are in Progress - Jul 2024

D Tower :External Plastering & MCM Cladding Works Are in Progress - Jul 2024

External Plastering & Texture Work in Progress - Jul 2024

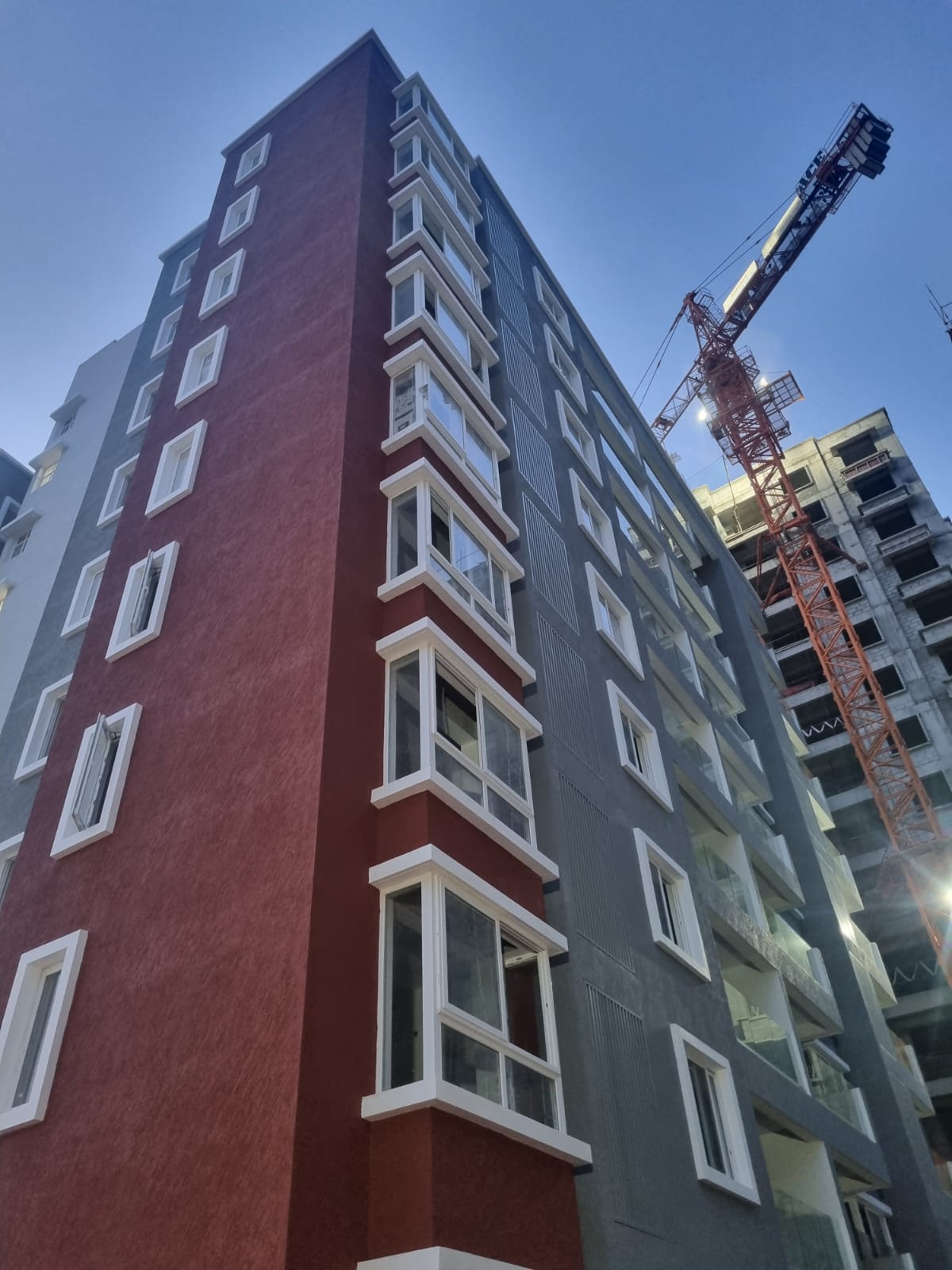

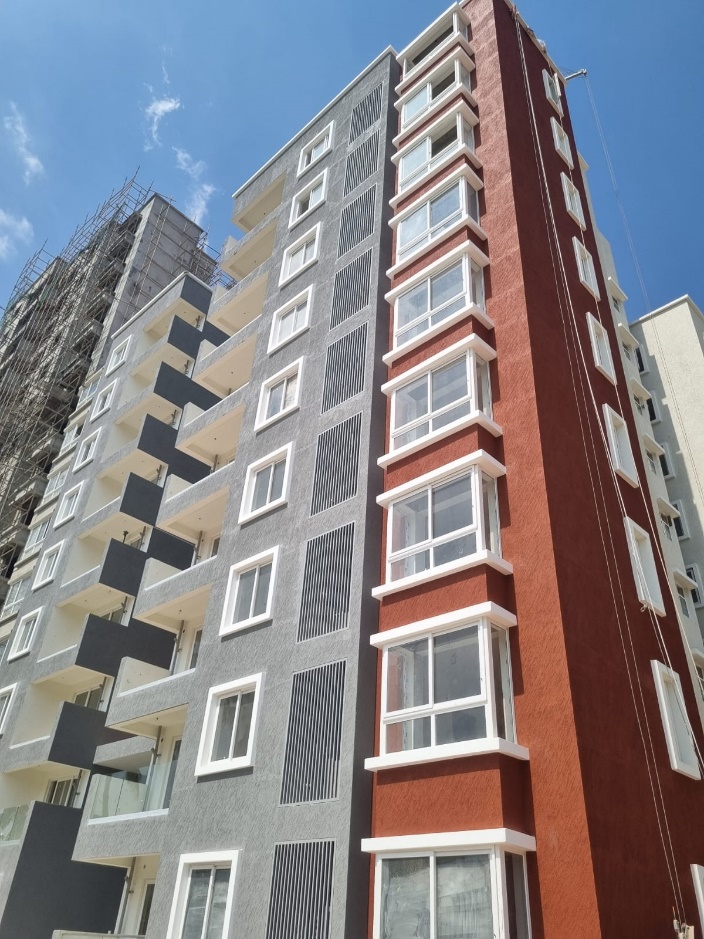

B Tower :Texture and Painting Works Completed - Jul 2024

Tower A, C & D Tiling Works Are in Progress - Jul 2024

External Plastering & Texture Work in Progress - Jul 2024

B Tower :Texture and Painting Works Completed - Jul 2024

Tower- B: Switch-plate and Wiring in Progress - Jul 2024

Tower- B: Switch-plate and Wiring in Progress - Jul 2024

Tower- C: Windows & Door Installation in Progress - Jul 2024

A Tower : Terrace Pergola and Tanks Completed - Jul 2024

C Tower : Terrace Waterproofing Works Completed - Jul 2024

A Tower :External Plastering & Mcm Cladding Works Are in Progress - Jul 2024

A Tower :External Plastering & Mcm Cladding Works Are in Progress - Jul 2024

Tower B Tiling Works Completed - Jul 2024

Tower- B: Switch-plate and Wiring in Progress - Jul 2024

Tower B – Entrance Lobby Finishes Works - Jul 2024

Tower B – Entrance Lobby Finishes Works - Jul 2024

South Side – Pavers and Kerb Work - Jul 2024

Compound Wall Finishing in Progress - Jul 2024

Tower A, C & D Tiling Works Are in Progress - Jul 2024

Tower- B: Windows & Door Installation Completed - Jul 2024

Tower- B: Windows & Door Installation Completed - Jul 2024

Tower- C: Windows & Door Installation in Progress - Jul 2024

Tower- C: Windows & Door Installation in Progress - Jul 2024

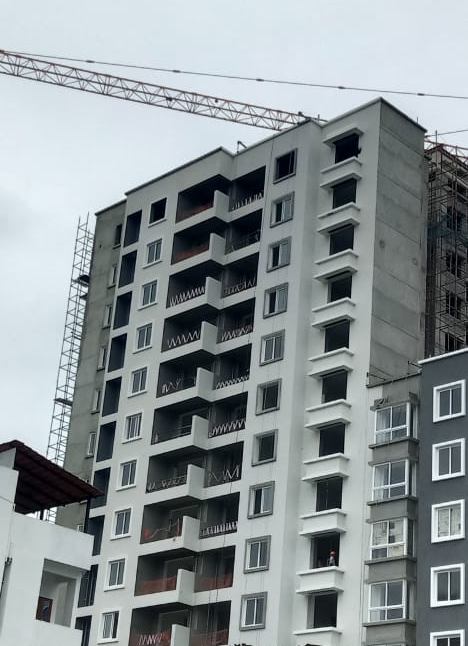

Tower C - External plastering & texture work in progress. - Jun 2024

D TOWER :External plastering & MCM cladding works are in progress: - Jun 2024

Tower B Tiling works completed - Jun 2024

Tower- B: Windows & Door installation - Jun 2024

Tower- B: Windows & Door installation - Jun 2024

Tower B Tiling works completed - Jun 2024

D TOWER : Terrace works are in progress. - Jun 2024

Tower- B: Switch-plate and wiring in progress - Jun 2024

A TOWER :External plastering & MCM cladding works are in progress: - Jun 2024

Tower B – Entrance lobby finishes works - Jun 2024

A TOWER :External plastering & MCM cladding works are in progress: - Jun 2024

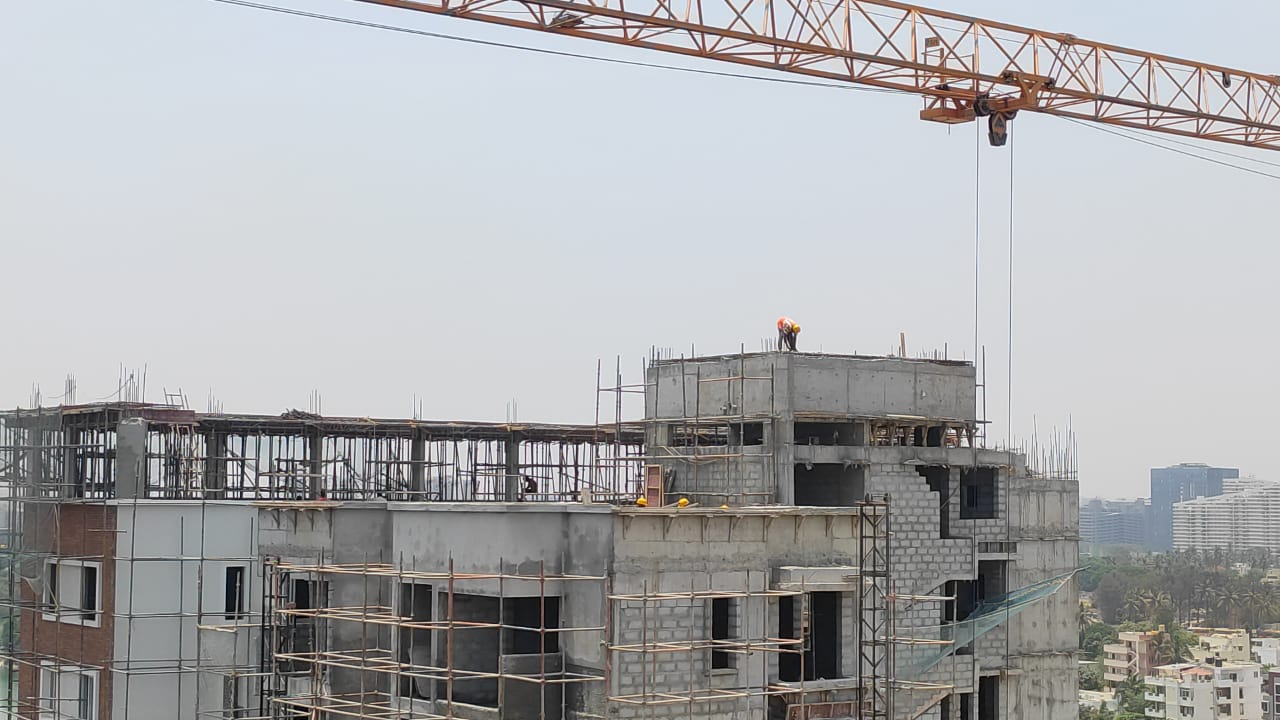

A TOWER : Terrace pergola and tanks completed - Jun 2024

Tower C - External plastering & texture work in progress. - Jun 2024

Tower D - External plastering & texture work in progress. - Jun 2024

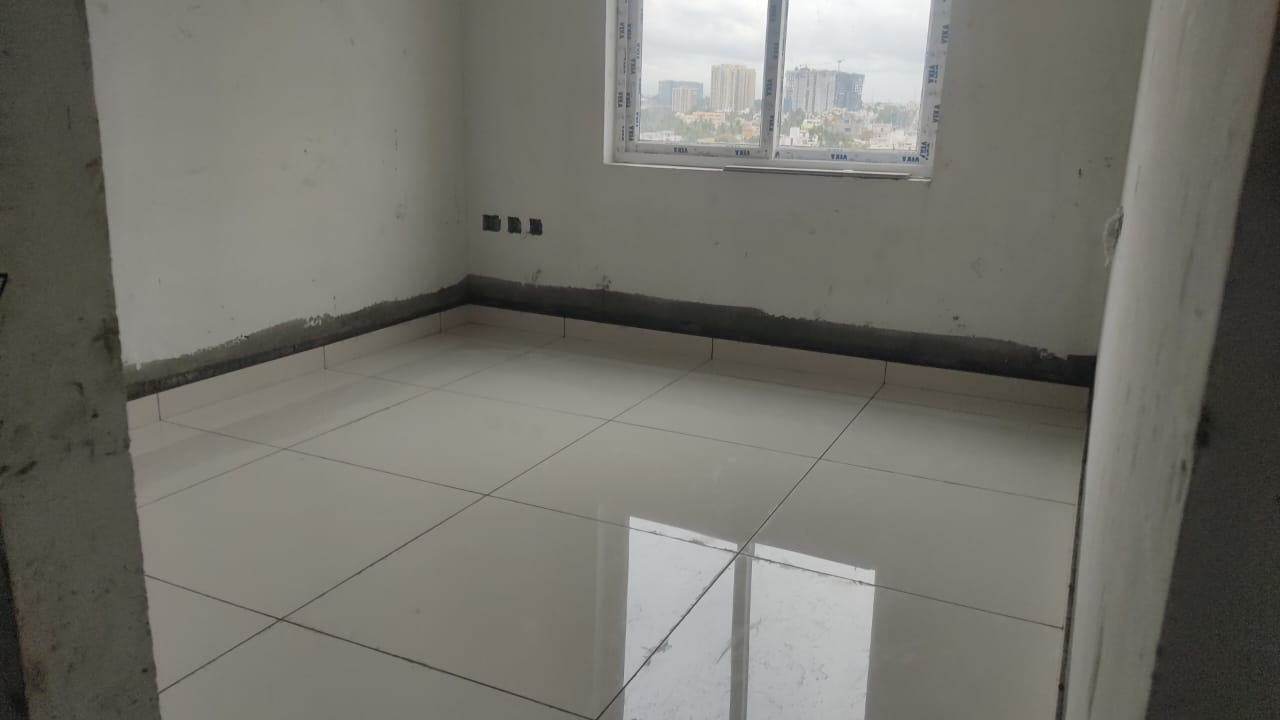

Tower C – Milestone Release - On Commencement of flooring – 11th to14th Floor – Status as on 05th - Jun 2024

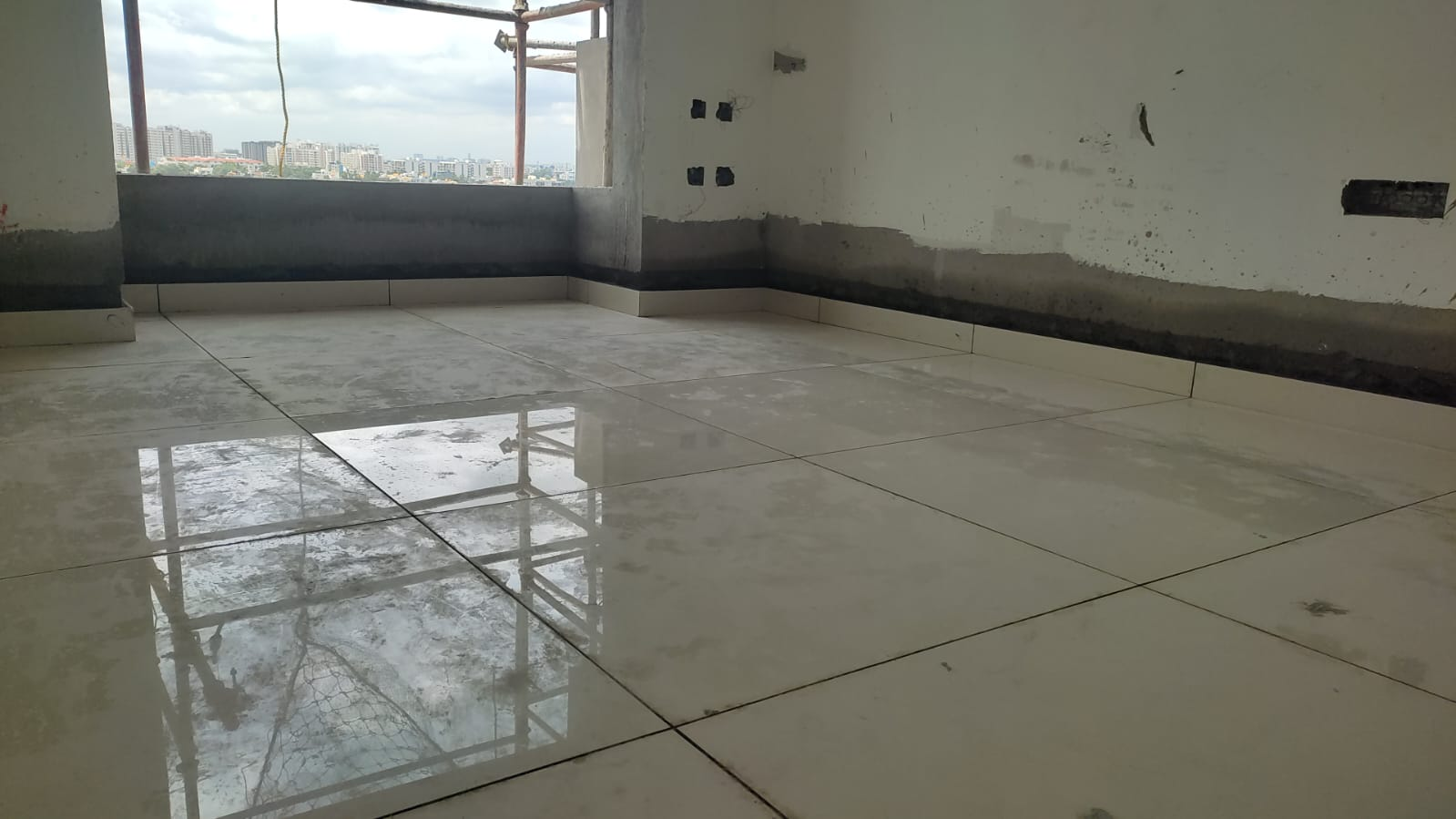

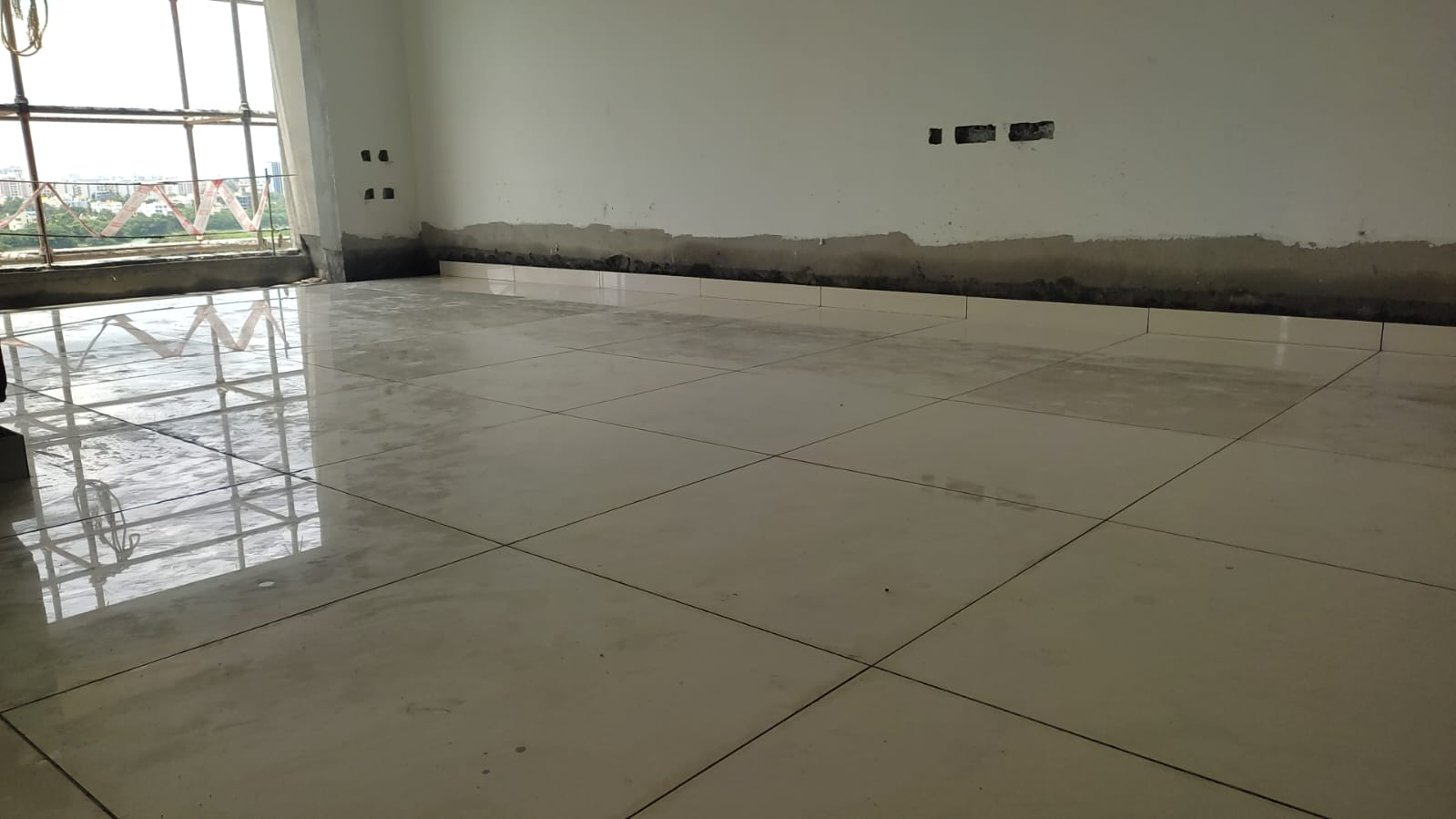

Tower D – Milestone Release - On Commencement of flooring – 11th to 14th Floor – Status as on 05th - Jun 2024

Tower D – Milestone Release - On Commencement of flooring – 11th to 14th Floor – Status as on 05th - Jun 2024

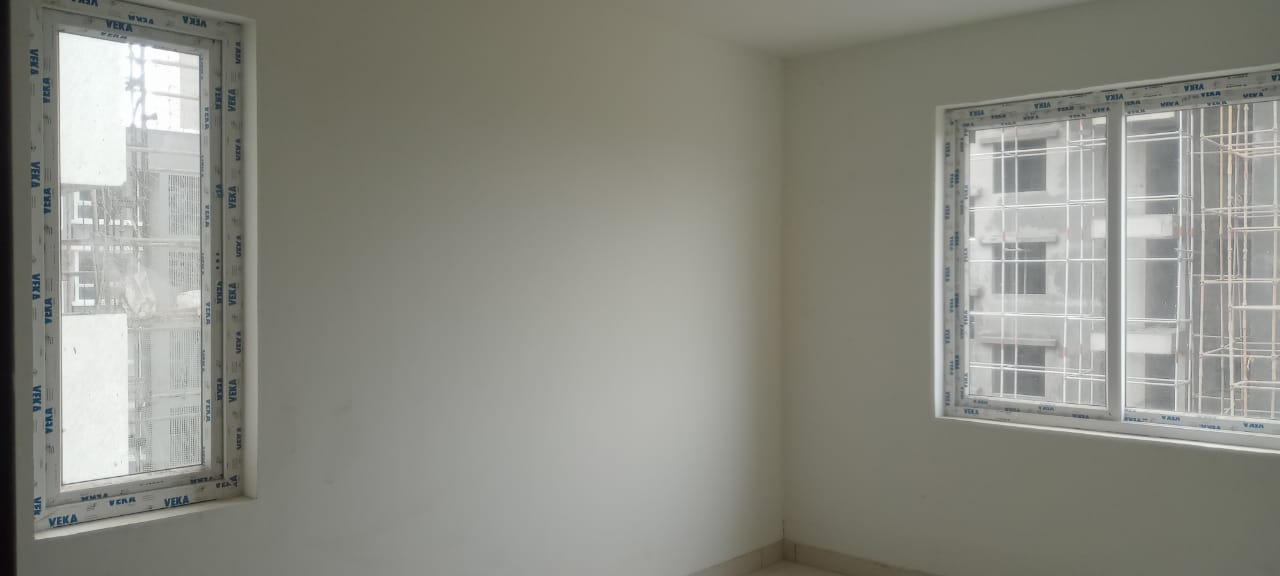

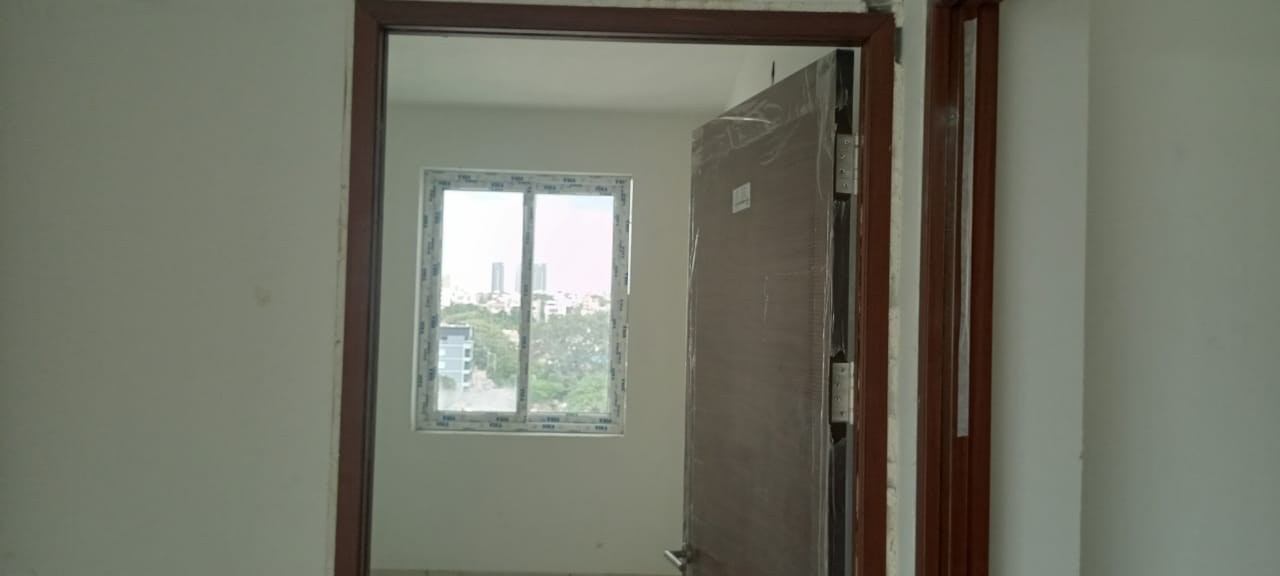

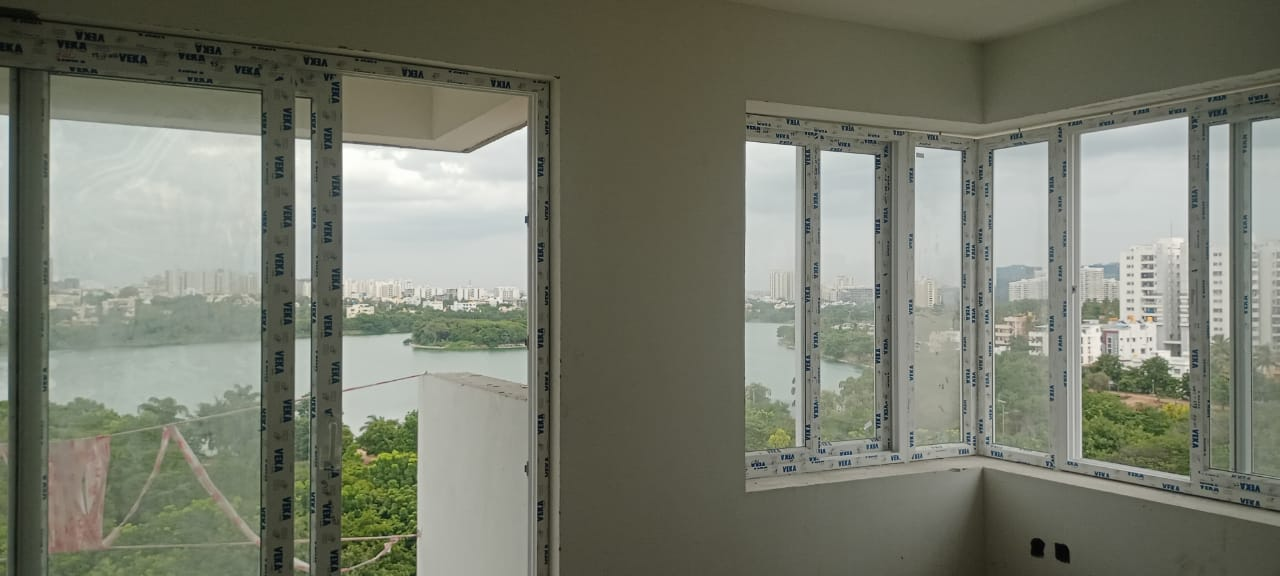

Tower A – Milestone Release -On Commencement of fixing of Doors &windows 6th to 10th Floor – Status as on 05th - Jun 2024

Tower B – Entrance lobby finishes works - Jun 2024

South side – Pavers and kerb work - Jun 2024

Compound wall finishing in progress - Jun 2024

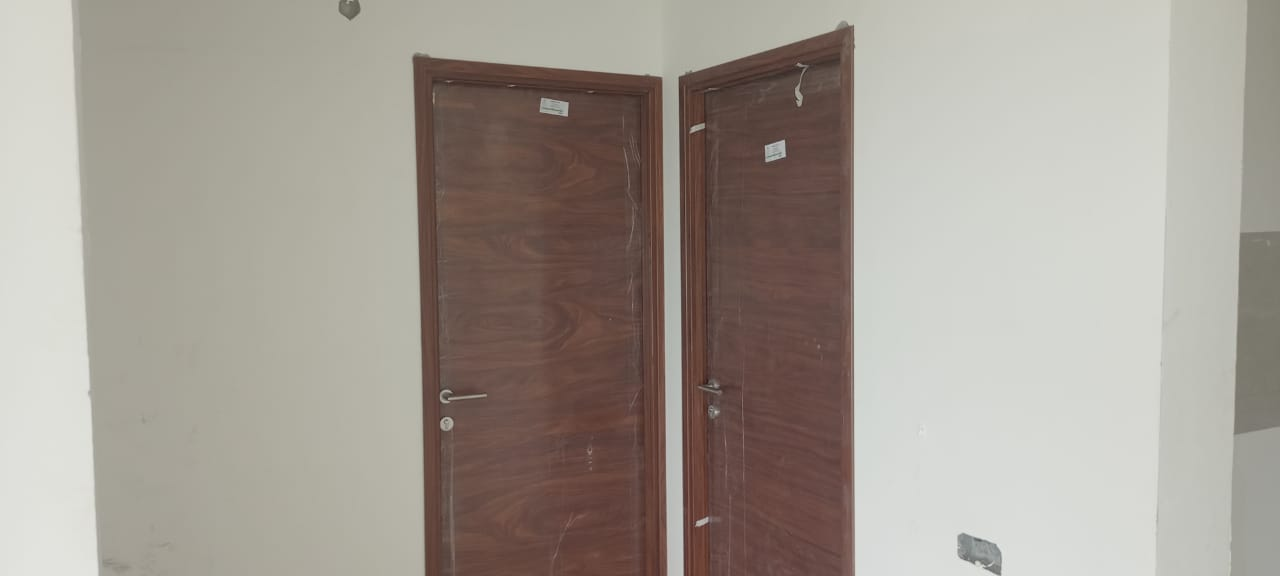

Tower A – Milestone Release - On Commencement of fixing of Doors & windows 11th to 14th Floor – Status as on 05th - Jun 2024

Tower A – Milestone Release - On Commencement of fixing of Doors & windows 11th to 14th Floor – Status as on 05th - Jun 2024

Tower- B: Switch-plate and wiring in progress - Jun 2024

Tower A,C & D Tiling works are in progress. - Jun 2024

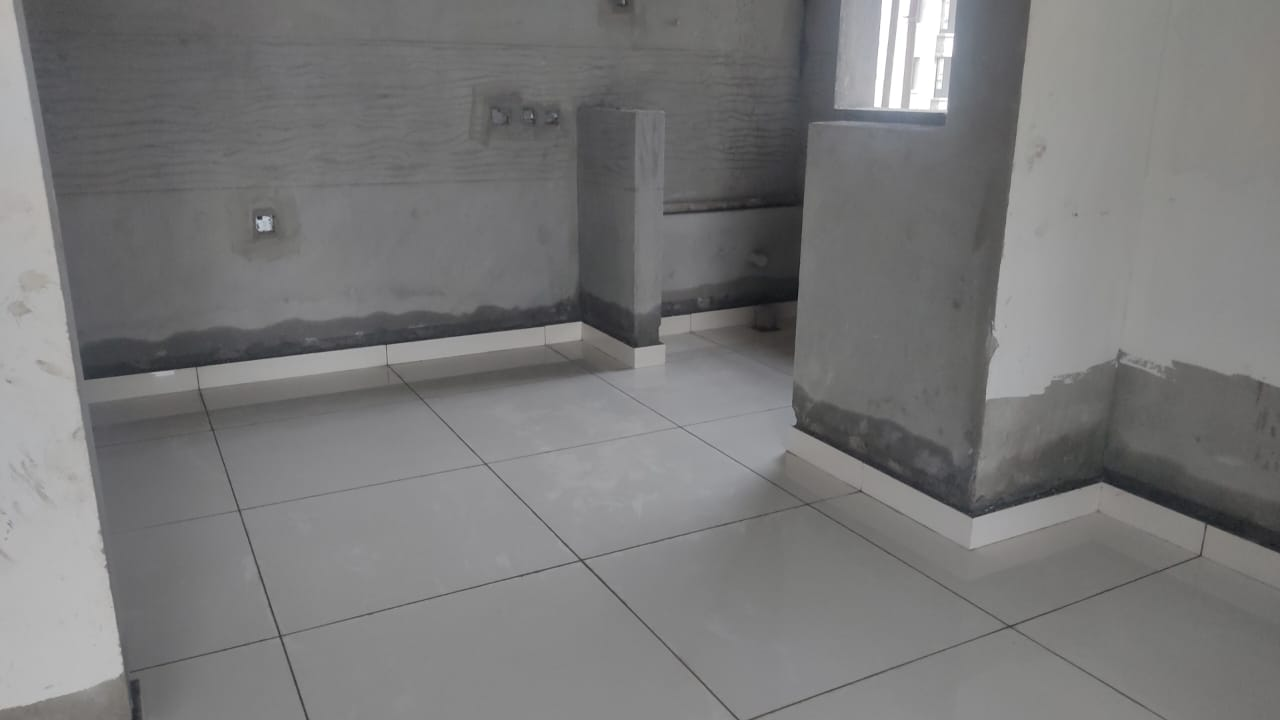

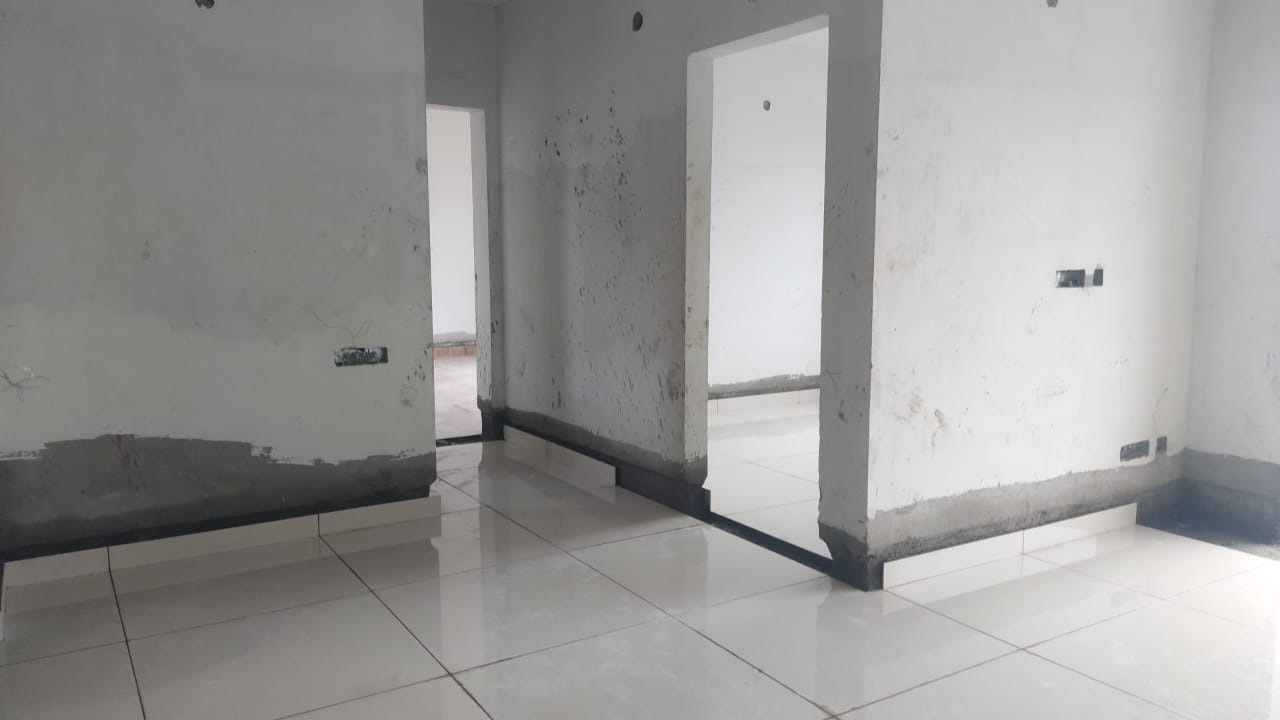

Tower C – Milestone Release - On Commencement of flooring – 11th to14th Floor – Status as on 05th - Jun 2024

Tower C – Milestone Release - On Commencement of flooring – 11th to14th Floor – Status as on 05th - Jun 2024

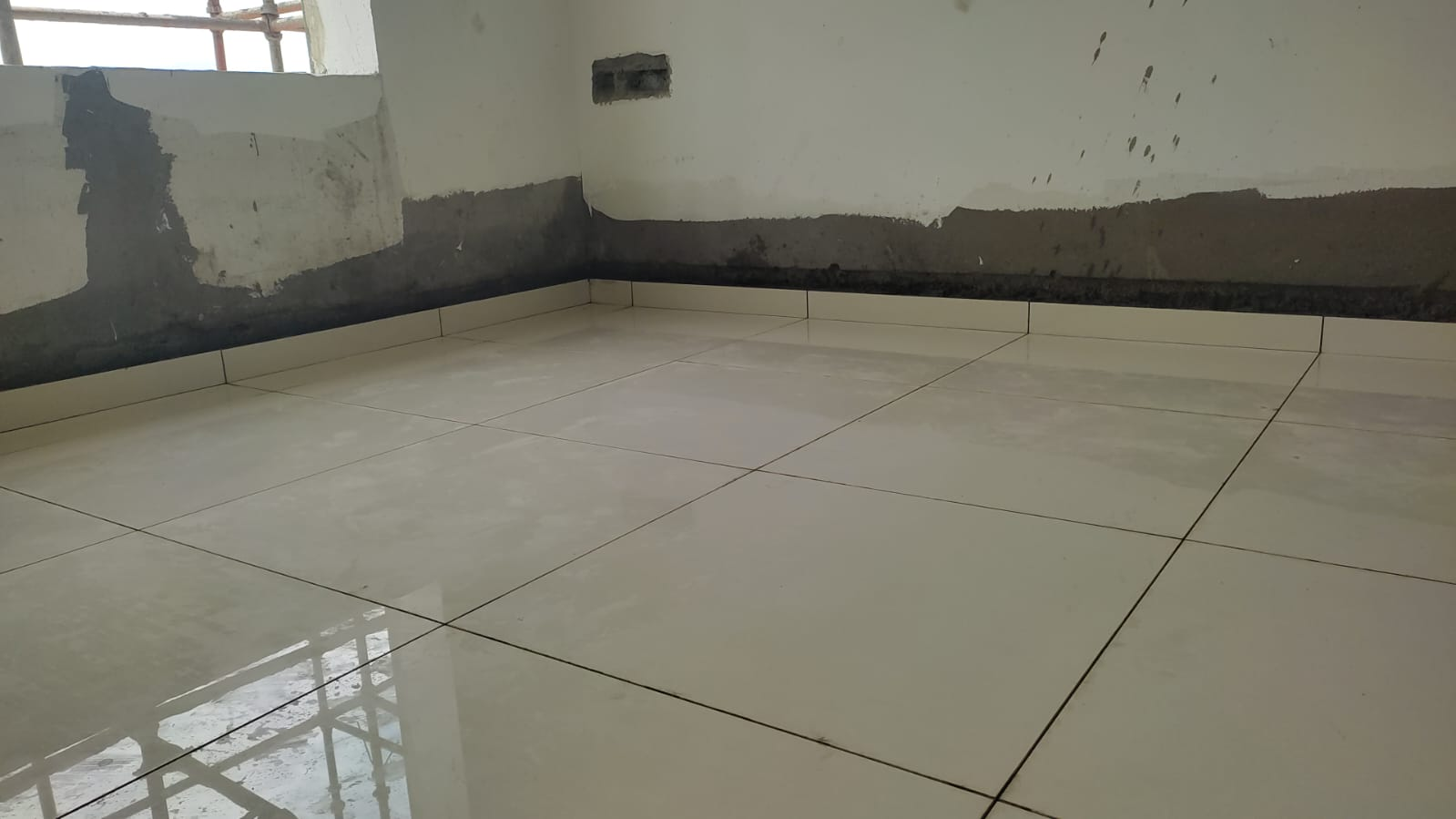

Tower D – Milestone Release - On Commencement of flooring – 11th to 14th Floor – Status as on 05th - Jun 2024

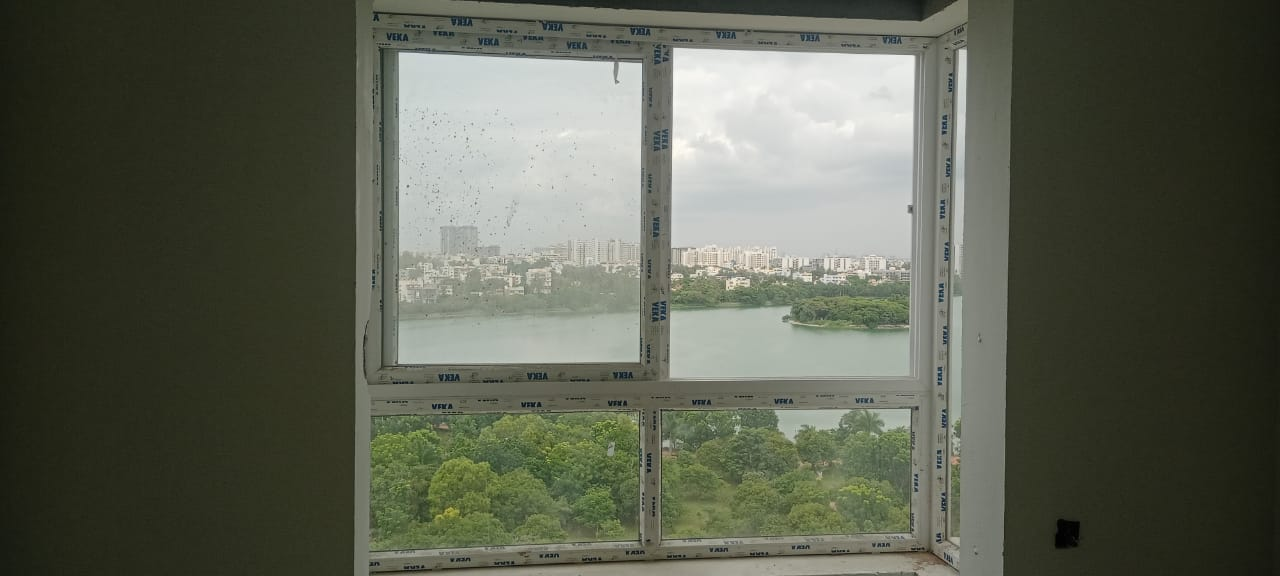

Tower A – Milestone Release -On Commencement of fixing of Doors &windows 6th to 10th Floor – Status as on 05th - Jun 2024

Tower A – Milestone Release -On Commencement of fixing of Doors &windows 6th to 10th Floor – Status as on 05th - Jun 2024

Tower A,C & D Tiling works are in progress - Jun 2024

Tower A – Milestone Release - On Commencement of fixing of Doors & windows 11th to 14th Floor – Status as on 05th - Jun 2024

Tower A,C & D Tiling works are in progress. - Jun 2024

C TOWER : Terrace waterproofing works in progress - Jun 2024

Tower- B: Switch-plate and wiring in progress - Jun 2024

Tower A,C & D Tiling works are in progress - Jun 2024

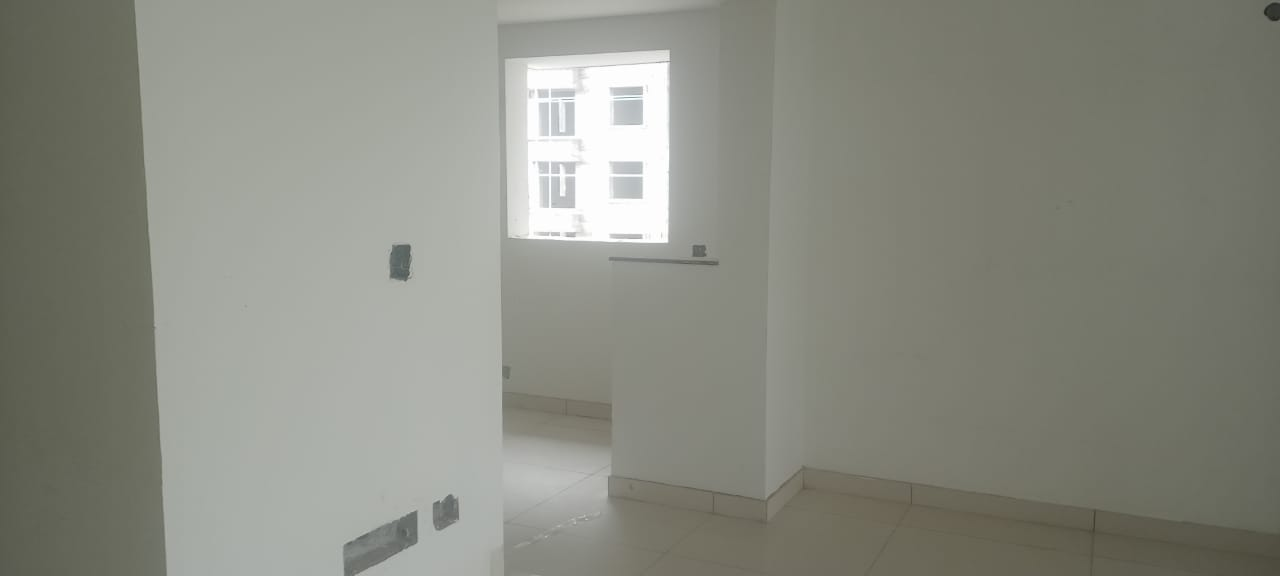

Tower A – Milestone Release –“On Commencement of Painting – 6F-10th Floor” – Status as on 20th - Jun 2024

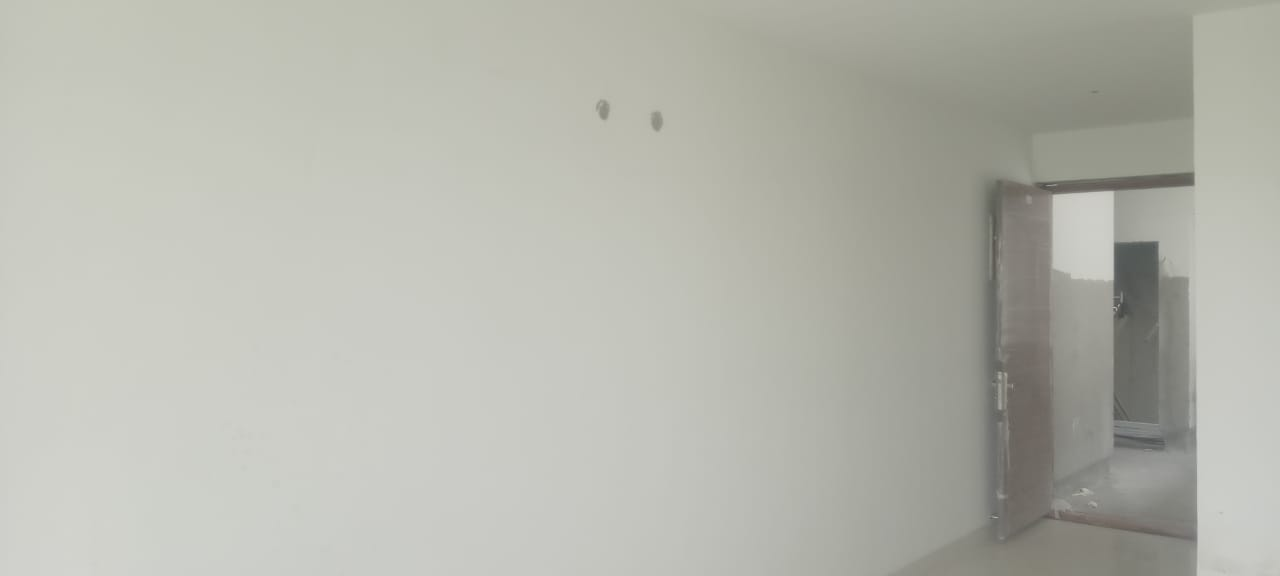

Tower A – Milestone Release –“On Commencement of Painting – 6F-10th Floor” – Status as on 20th - Jun 2024

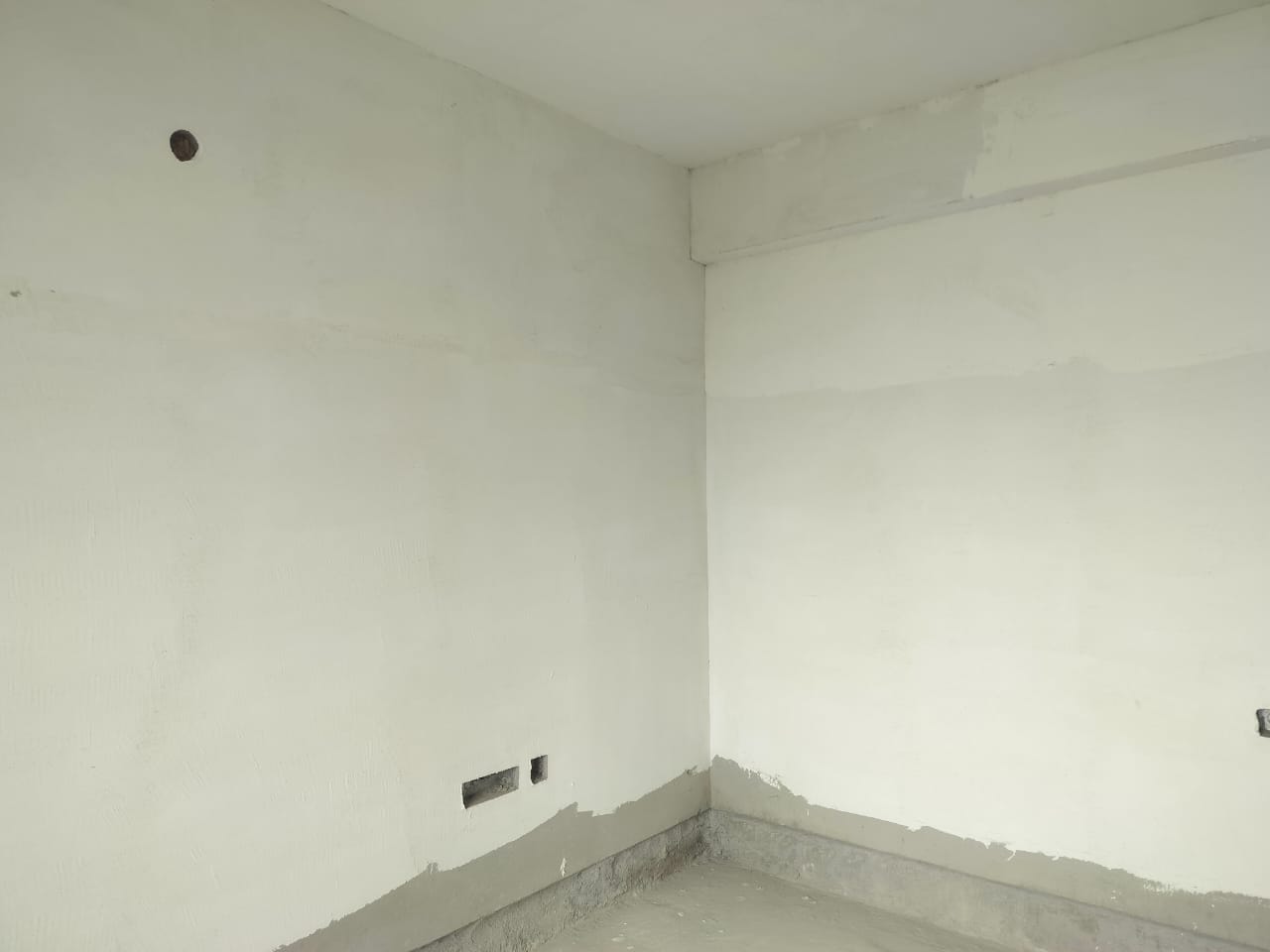

Tower A – Milestone Release –“ On Commencement of Painting – 11F-14thFloor” – Status as on 20th - Jun 2024

Tower D – Milestone Release –“ On Commencement of Painting – 11F-14thFloor” – Status as on 20th - Jun 2024

Tower D – Milestone Release –“ On Commencement of Painting – 6F-10th Floor” – Status as on 20th - Jun 2024

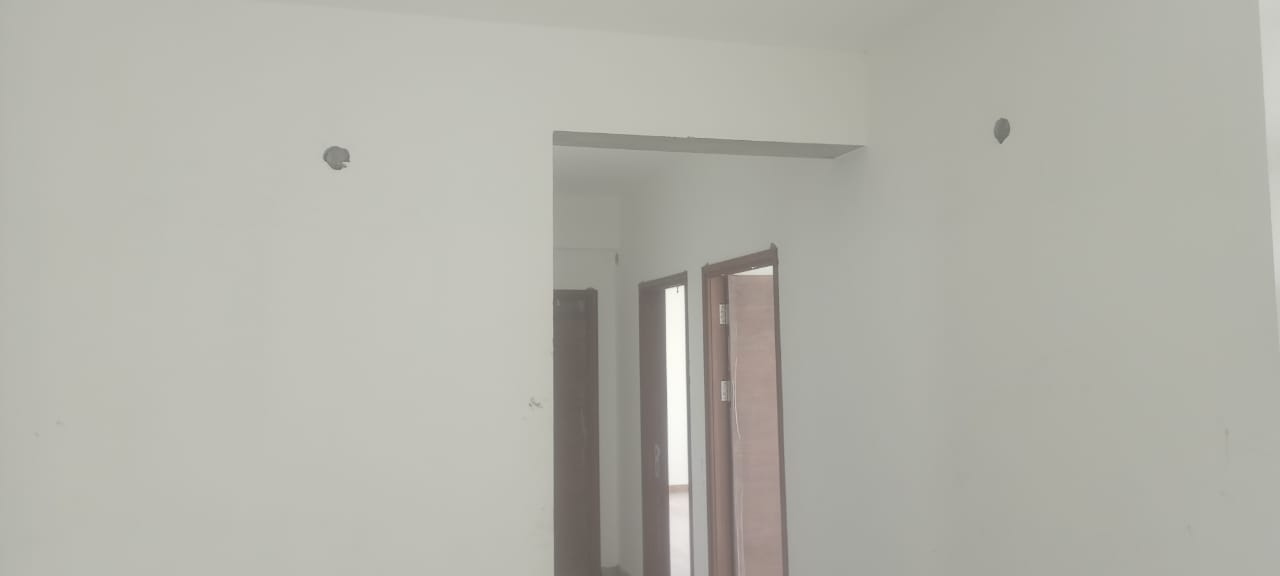

Tower A – Milestone Release –“ On Commencement of Painting – 11F-14thFloor” – Status as on 20th - Jun 2024

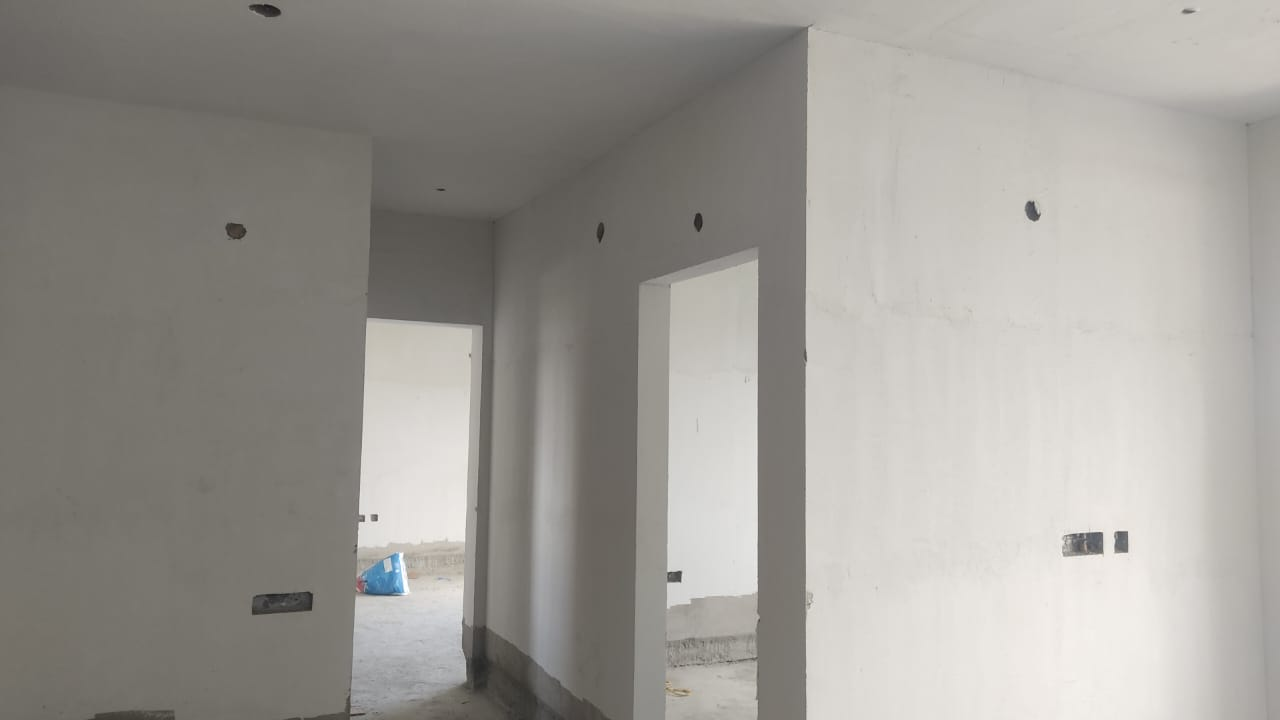

Tower C – Milestone Release –“ On Commencement of Painting – 11F-14thFloor” – Status as on 20th June 2024

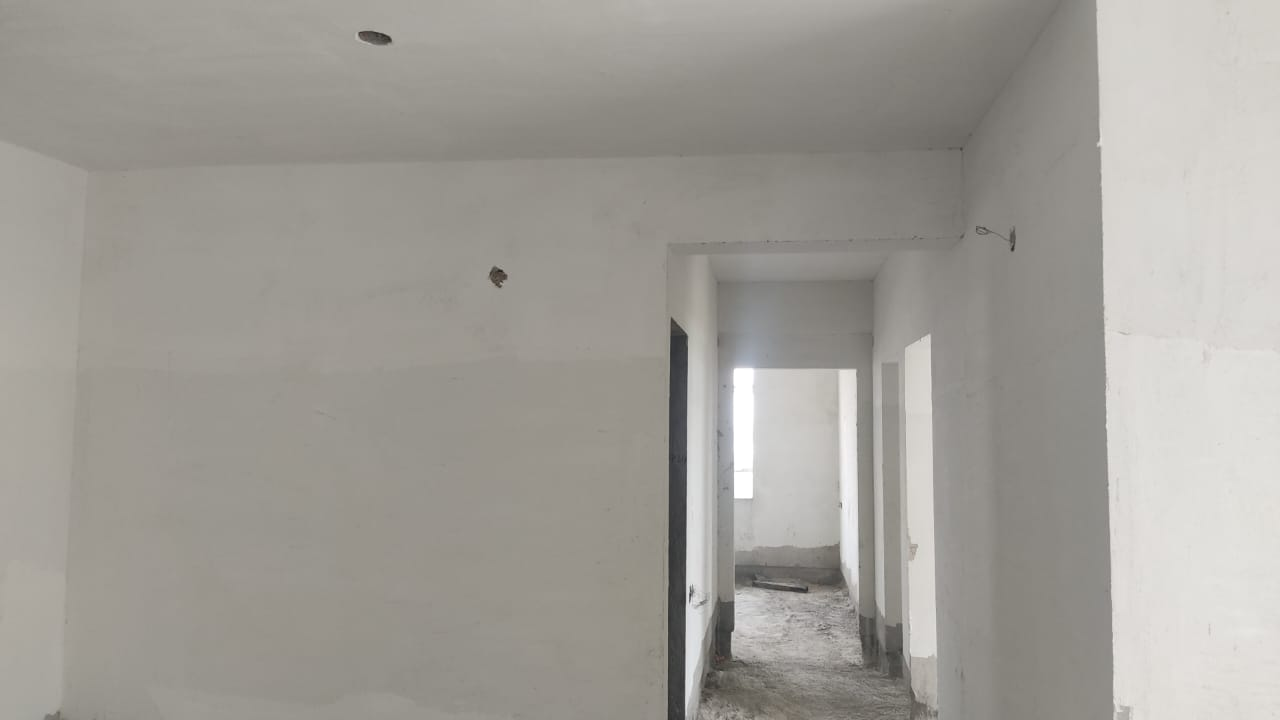

Tower D – Milestone Release –“ On Commencement of Painting – 11F-14thFloor” – Status as on 20th - Jun 2024

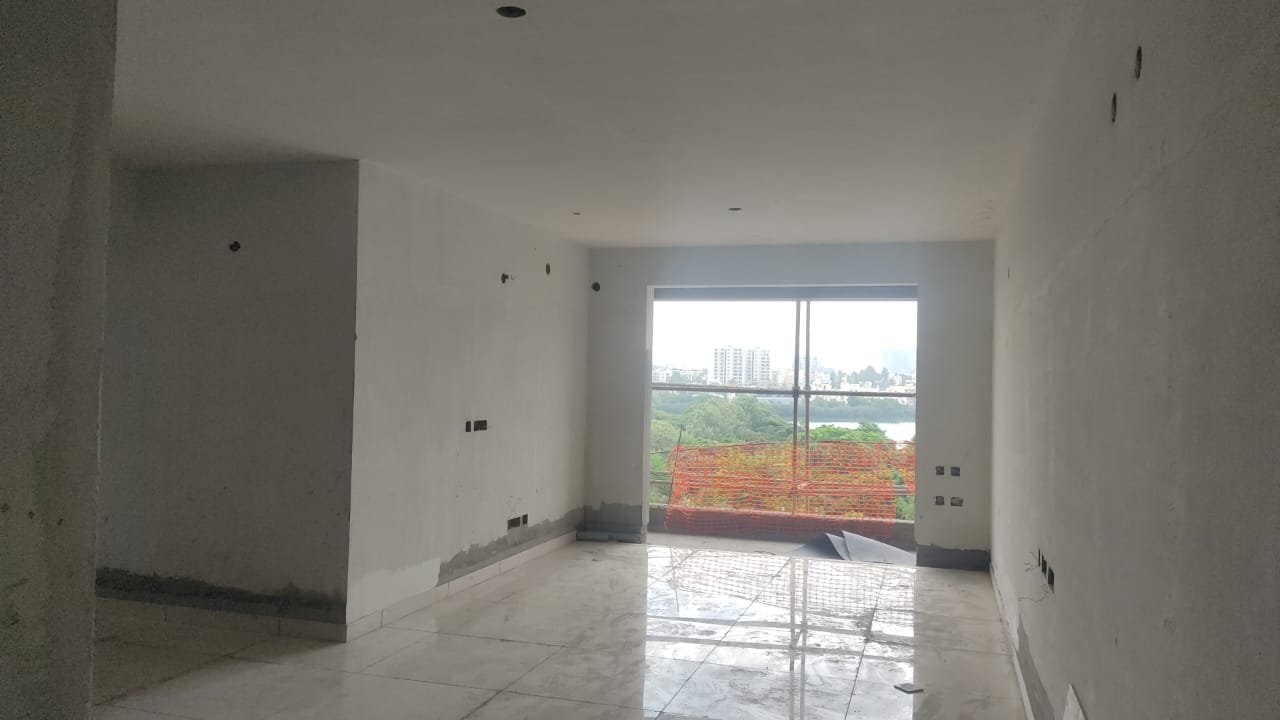

Tower D – Milestone Release –“ On Commencement of Painting – 6F-10th Floor” – Status as on 20th - Jun 2024

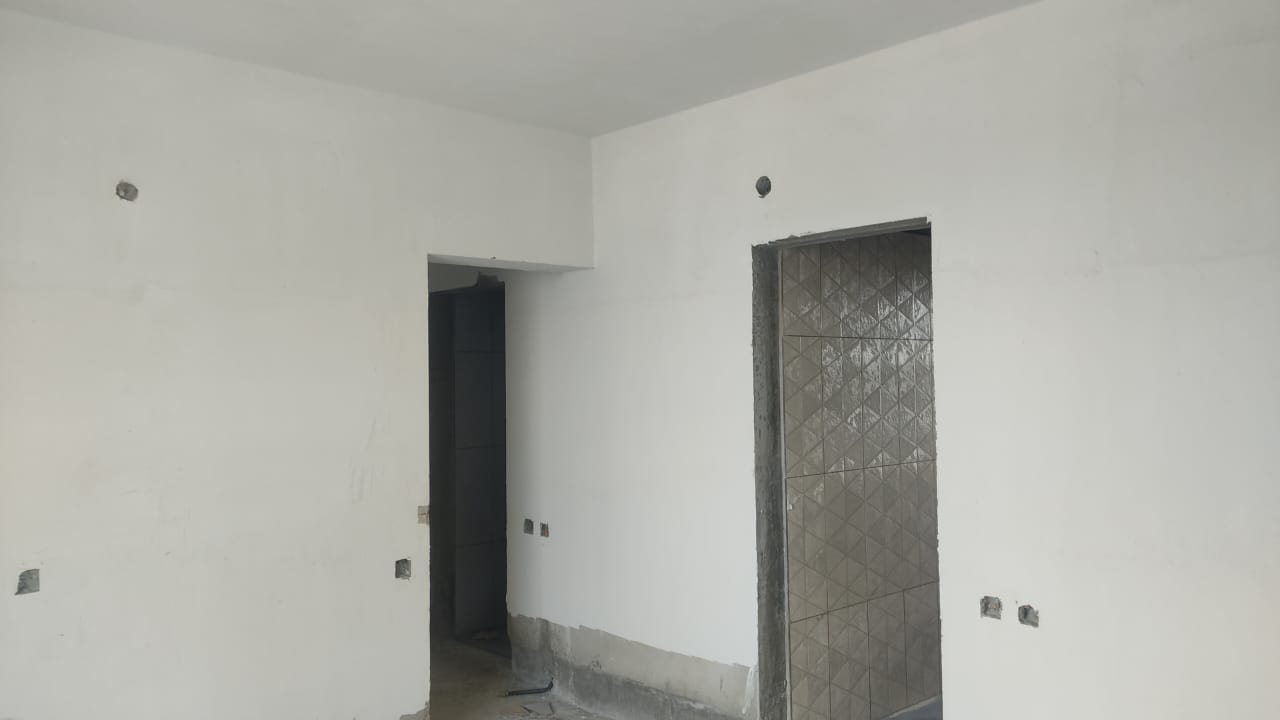

Tower C – Milestone Release –“ On Commencement of Painting – 11F-14thFloor” – Status as on 20th - Jun 2024

Tower B: Windows & Door installation. - May 2024

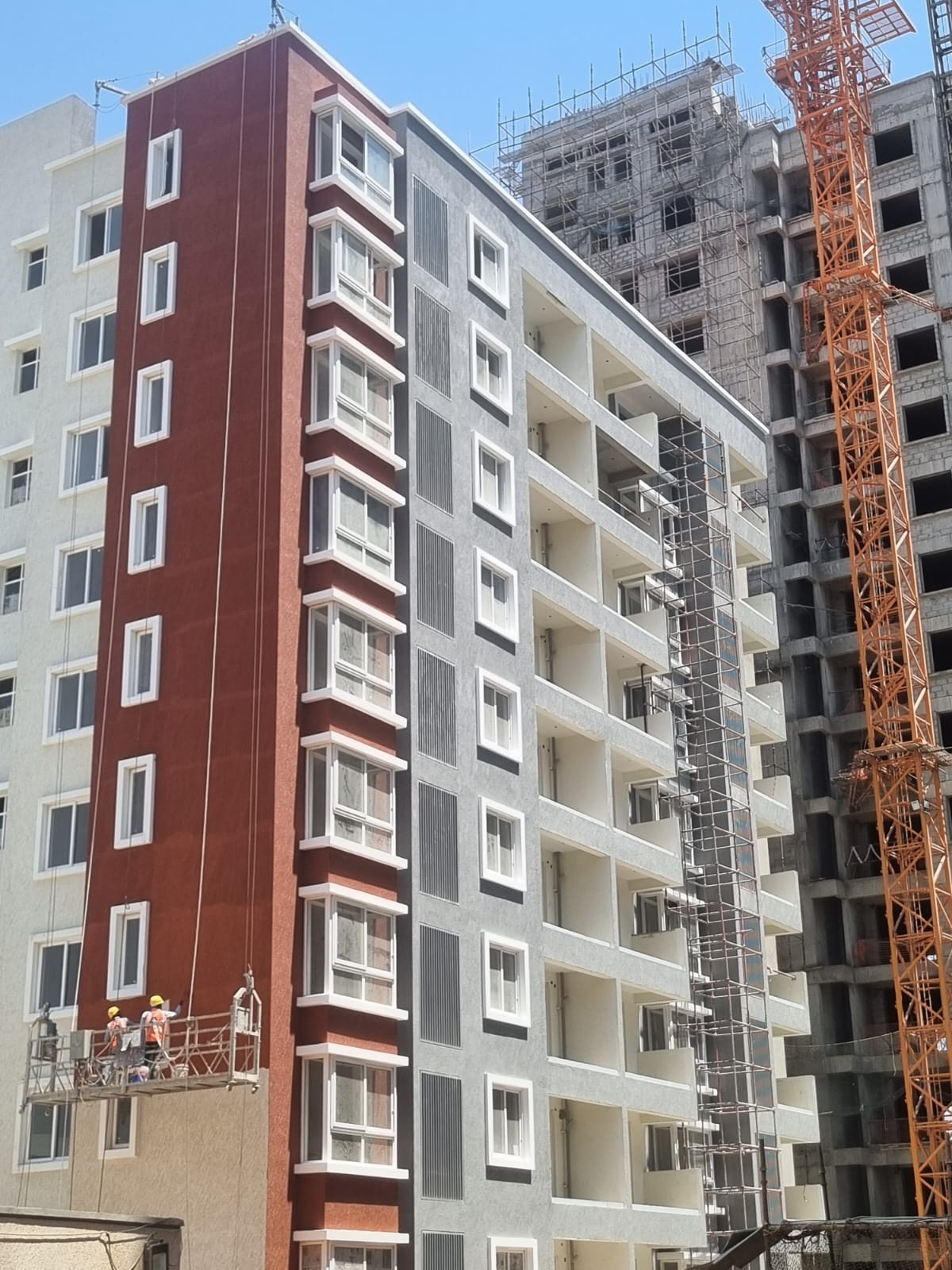

Tower B Texture painting work in progress - May 2024

Tower B Texture painting work in progress - May 2024

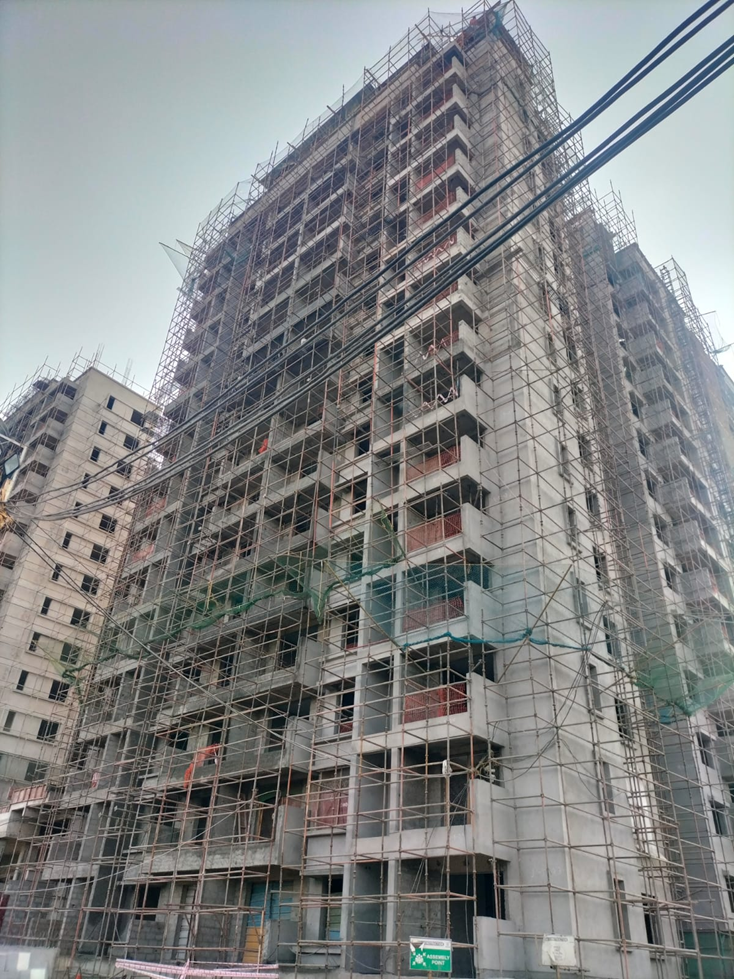

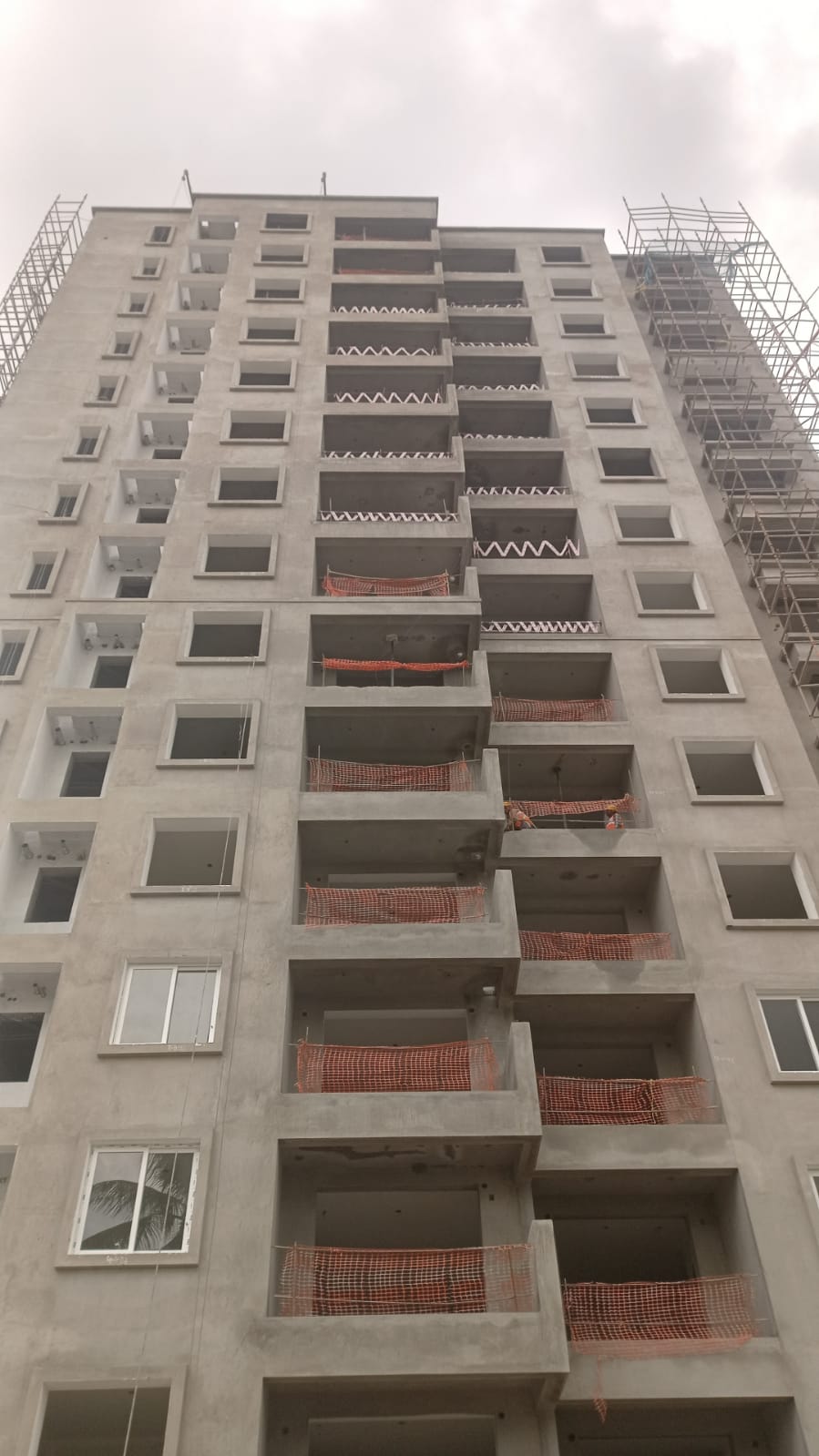

Tower C External plastering work in progress - May 2024

Tower - B: Switch- plate and wiring in progress - May 2024

Tower B: Windows & Door installation. - May 2024

Tower - B: Switch- plate and wiring in progress - May 2024

Tower D External plastering work in progress - May 2024

Tower B: Switch- plate and wiring in progress - May 2024

Compound wall finishing in progress - May 2024

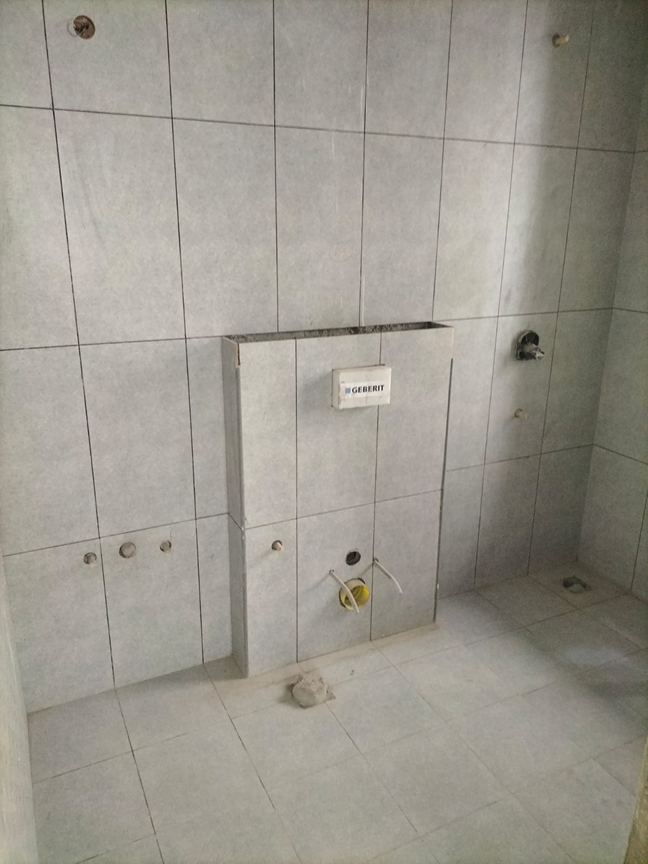

Tiling works are in progress. - May 2024

Tiling works are in progress. - May 2024

Tiling works are in progress. - May 2024

Tower B Texture painting work in progress - May 2024

Tower A External plastering & MCM cladding works are in progress - May 2024

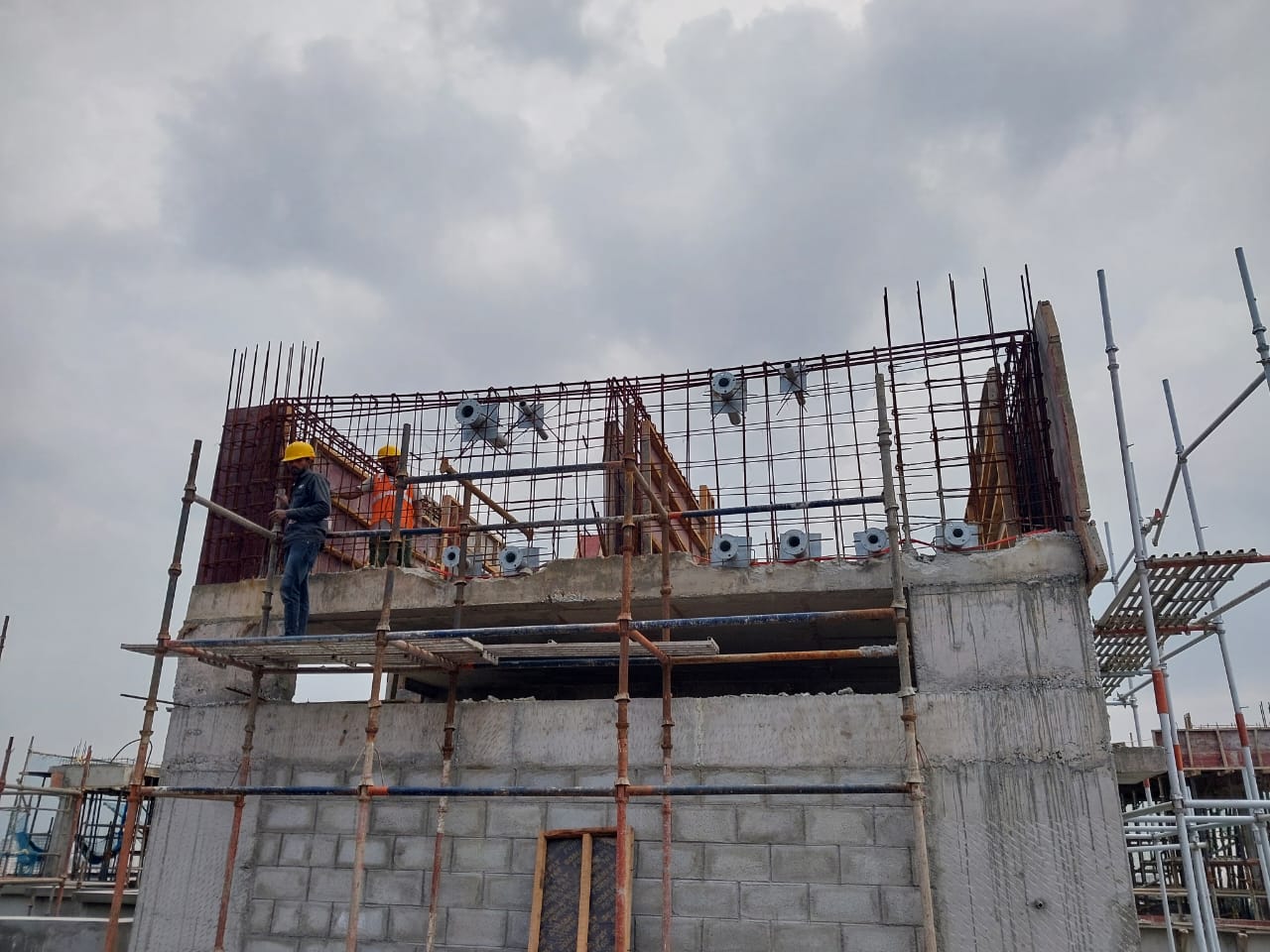

Tower D Terrace work are in progress - May 2024

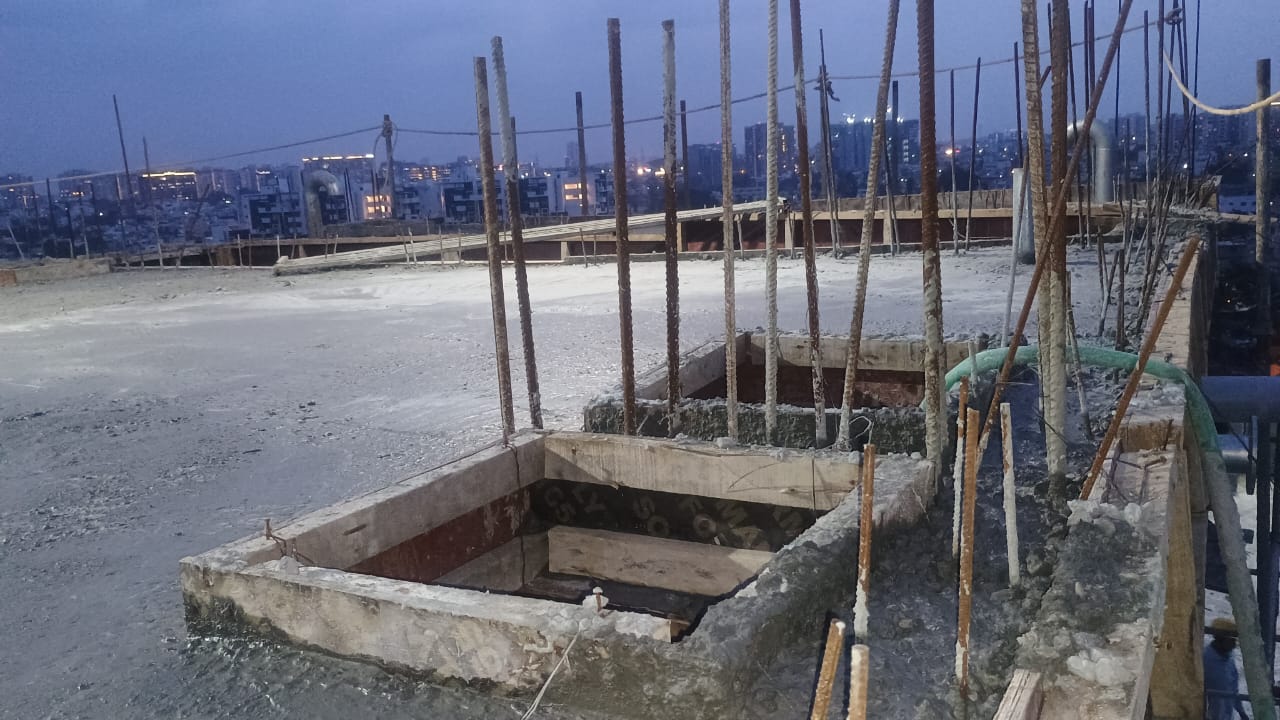

Tower C Terrace Tank completed - May 2024

Tower A : Terrace works are in progress - May 2024

May 2024 - Brigade Laguna Tower C: Milestone Release On Commencement of Painting 6th to 10th Floor

May 2024 - Brigade Laguna Tower C: Milestone Release On Commencement of Painting 6th to 10th Floor

Apr 2024 - Brigade Laguna Tower A: Milestone Release On commencement of Painting GF to 4th floor

Apr 2024 - Brigade Laguna Tower A: Milestone Release On commencement of Painting GF to 4th floor

Apr 2024 - Brigade Laguna Tower C: Milestone Release On commencement of External plastering

Apr 2024 - Brigade Laguna Tower C: Milestone Release On commencement of External plastering

Mar 2024 - Brigade Laguna: Tiling works are in progress

Mar 2024 - Brigade Laguna Tower A: Terrace works are in progress

Mar 2024 - Brigade Laguna Tower A: External plastering and MCM cladding works are in progress

Mar 2024 - Brigade Laguna Tower B: Windows and Door installation

Mar 2024 - Brigade Laguna Tower B: Terrace clay tile grouting in progress

Mar 2024 - Brigade Laguna Tower B: Texture painting work in progress

Mar 2024 - Brigade Laguna Tower C: Terrace works are in progress

Mar 2024 - Brigade Laguna Tower C and D: External plastering work in progress

Mar 2024 - Brigade Laguna Tower D: Terrace works are in progress

Feb 2024 - Brigade Laguna Tower A: East side external plastering work in progress

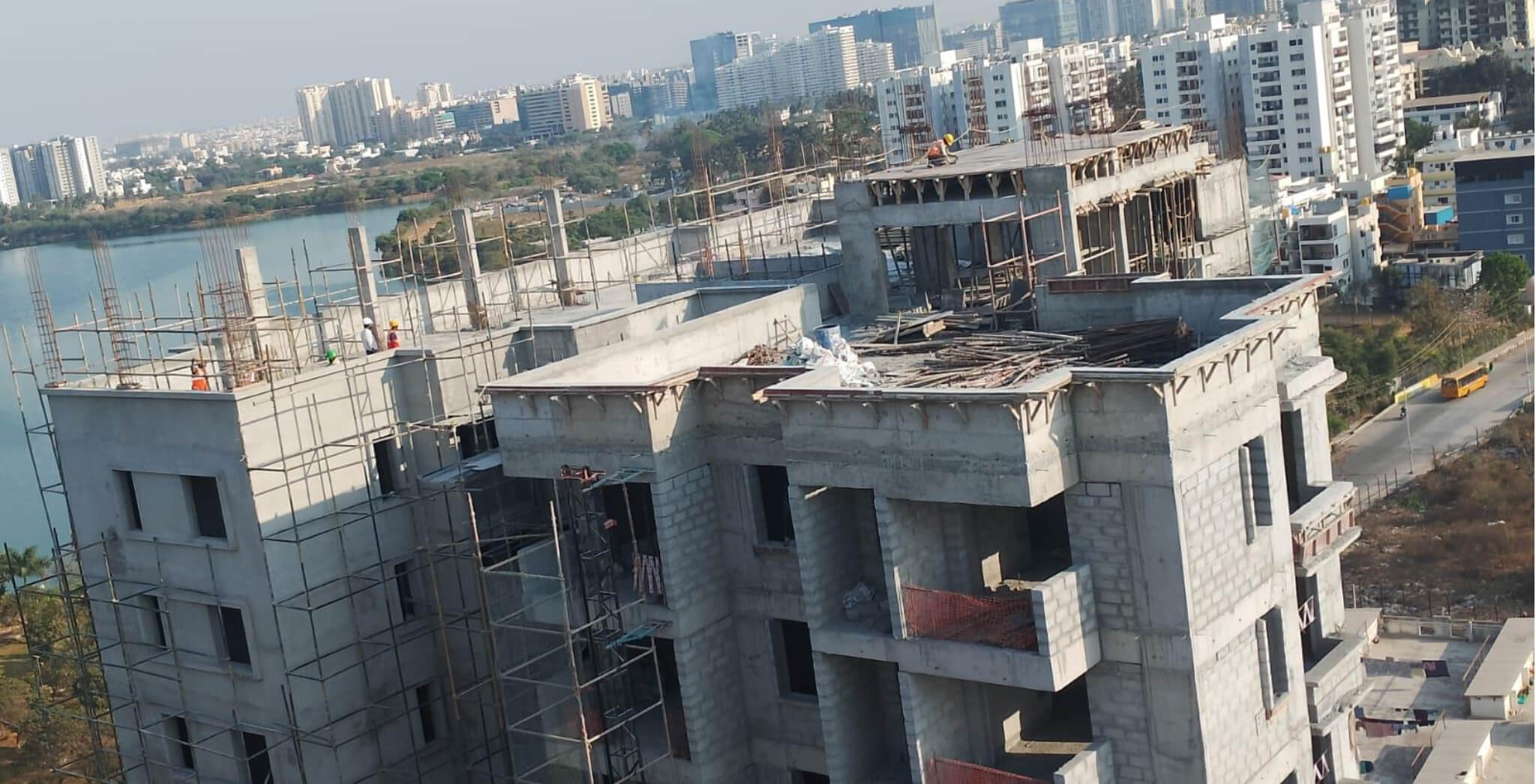

Feb 2024 - Brigade Laguna TOWER A: Terrace OHT Reinforcement works are in progress

Feb 2024 - Brigade Laguna Tower A: Milestone Release On Commencement of External Plastering

Feb 2024 - Brigade Laguna Tower A,C and D: Toilet Dado tiling work in progress

Brigade Laguna Tower B: Texture painting work in progress - Feb 2024

Feb 2024 - Brigade Laguna Tower B: Milestone Release On Commencement of Doors and Windows 5th to 8th Floor

Brigade Laguna Tower B: Milestone Release On Commencement of Doors & Windows 5th & 8th Floor - Feb 2024

Brigade Laguna Tower B: Terrace clay tile grouting in progress - Feb 2024

Brigade Laguna Tower C: Terrace OHT Reinforcement work in progress - Feb 2024

Feb 2024 - Brigade Laguna Tower C: Terrace OHT reinforcement work in progress

Brigade Laguna Tower D: Terrace OHT Reinforcement work in progress - Feb 2024
Frequently Asked Questions
Brigade Laguna is situated opposite Rachenahalli Lake, Hebbal, North Bengaluru.
Brigade Laguna is spread across 3 acres of land.
Some of the amenities at Brigade Laguna include the gymnasium, multipurpose hall, table tennis, pool table, swimming pool, kids play area, meditation deck, reflexology path, senior citizen court and pet park.
The nearest recreation spots to Brigade Laguna are located at the Mall of Asia, Esteem Mall, Elements Mall, Mall of Bengaluru and RMZ Galleria Mall.
RERA NUMBER
PRM/KA/RERA/1251/309/PR/170322/004775
