Exterior
Residences that Embody the Timeless Elegance of Bengaluru
Ivory Phase 2 at Brigade Orchards is the smartest solution money can buy. Not only is it a part of one of the highest rated smart townships in India, it is also one of the first smart-tech enabled homes. Located at a vantage point within the lush township, it commands a stellar view of Devanahalli in all its glory. With its intelligently designed 1, 1.5, 2 and 3 bedroom apartments with smart interiors, it offers a lifestyle that is truly miles ahead of the rest.
Smart Home Features
Amazon Echo
Smart Switches for Lights and Fans
Energy Efficient Bathrooms
RFID Cards for Residents
Gas Leak Detector in Kitchen
Automated Boom Barriers
Land Area
Part of a 135 - Acres Smart Township
Type
1, 1.5, 2 and 3 BHK Apartments
Super Built-up Area
Phase 2 : 46.87 Sq.m -124.32 Sq.m. (505 Sq.ft. - 1338.16 Sq.ft.)Phase 1 : 56.94 Sq.m. - 5123.42 Sq.m. (613 Sq.ft. - 1329 Sq.ft.)
Carpet Area
Phase 2 : 31.00 Sq.m. - 82.52 Sq.m. (333.68 Sq.ft.- 888.23 Sq.ft.)Phase 1 : 32.47 Sq.m .- 81.82 Sq.m. (349.5 Sq.ft. - 880.70 Sq.ft)
Amenities
Immerse yourself in a world of luxury and comfort. Experience unparalleled luxury and convenience with exclusive amenities at Brigade Orchards Ivory.

*Images are for representation purpose.
Gallery

None

Landscape cam2

Landscape camhighres

Exterior

Entrance

None

Kids Room

Interior

Master Bedroom

Kitchen

Tranquil Lawn

Tranquil Lawn

Tranquil Lawn

Tranquil Lawn
*Images are for representation purpose.
Videos

Master Plan
Click on the Master plan to zoom

Embark on a visual journey to your dream space! Fill out the form to access the exclusive apartment unit plan and envision your life in a Brigade Home.
View Unit Plans
EMI Calculator
Price
1 BHK
1.5 BHK
2 BHK
3 BHK
3 BHK + 3T
INR 39 Lakhs Onwards*
INR 56 Lakhs Onwards*
INR 68 Lakhs Onwards*
INR 81 Lakhs Onwards*
INR 1.01 Crore Onwards*
*Government Charges, Other Charges and Taxes Applicable
* The prices are subject to change.
Location
Just 10-minutes away from the Bengaluru International airport, Brigade Orchards is strategically located away from the road and air-traffic related noise and pollution.
North Bengaluru is also witnessing a never-before focus since it is located in the middle of the Aerotropolis region. A six-lane highway from Hebbal to Devanahalli already links the airport to the city which makes commute from Brigade Orchards to Hebbal / Whitefield a mere 30-45 minutes drive.

Know Your Neighbourhood
ViewThe School for Global Minds
Within 20 mins
Euro Kids Pre School
Within 20 mins
Euro School
Within 20 mins
Chanakya University
Within 20 mins
MS College of Engineering
Within 45 mins
Reva College
Within 45 mins
Vidyashilp Academy
Within 45 mins
Carmel English School
Within 20 mins
NAFL NPS North
Within 20 mins
Shanthinikethan Public School
Within 20 mins
Delhi Public School
Within 30 mins
Oxford English School
Within 30 mins
Canadian International School
Within 30 mins
Stonehill International School
Within 30 mins
Gitam University
Within 30 mins
Harrow School
Within 30 mins
Sterling English Residential School
Within 20 mins
Ryan International School
Within 45 mins
Koshys Group of Institutions and Nursing College
Within 45 mins
Atal Bihari Vajpeyee Residential School
Within 20 mins
Akash International School
Within 20 mins
Padukone-Dravid Centre for Sports Excellence
Within 30 mins
Vibgyor School
Within 45 mins
The School for Global Minds
Within 20 mins
Euro Kids Pre School
Within 20 mins
Euro School
Within 20 mins
Chanakya University
Within 20 mins
MS College of Engineering
Within 45 mins
Reva College
Within 45 mins
Vidyashilp Academy
Within 45 mins
Carmel English School
Within 20 mins
NAFL NPS North
Within 20 mins
Shanthinikethan Public School
Within 20 mins
Delhi Public School
Within 30 mins
Oxford English School
Within 30 mins
Canadian International School
Within 30 mins
Stonehill International School
Within 30 mins
Gitam University
Within 30 mins
Harrow School
Within 30 mins
Sterling English Residential School
Within 20 mins
Ryan International School
Within 45 mins
Koshys Group of Institutions and Nursing College
Within 45 mins
Atal Bihari Vajpeyee Residential School
Within 20 mins
Akash International School
Within 20 mins
Padukone-Dravid Centre for Sports Excellence
Within 30 mins
Vibgyor School
Within 45 mins
Ramaiah Health Centre
Within 20 mins
Akash Hospital
Within 20 mins
Manasa Hospital
Within 20 mins
Manipal Hospital
Within 30-45 mins
Aster CMI Hospital
Within 30-45 mins
Dhrishti Eye Care
Within 30-45 mins
Shri Shirdi Sai Hospital
Within 20 mins
Ramaiah Leena Hospital
Within 20 mins
Baptist Hospital
Within 30-45 mins
Motherhood Hospital
Within 30-45 mins
Regal Hospital
Within 30-45 mins
Cratis Hospital
Within 30-45 mins
Ramaiah Hospital
Within 30-45 mins
Ramaiah Health Centre
Within 20 mins
Akash Hospital
Within 20 mins
Manasa Hospital
Within 20 mins
Manipal Hospital
Within 30-45 mins
Aster CMI Hospital
Within 30-45 mins
Dhrishti Eye Care
Within 30-45 mins
Shri Shirdi Sai Hospital
Within 20 mins
Ramaiah Leena Hospital
Within 20 mins
Baptist Hospital
Within 30-45 mins
Motherhood Hospital
Within 30-45 mins
Regal Hospital
Within 30-45 mins
Cratis Hospital
Within 30-45 mins
Ramaiah Hospital
Within 30-45 mins
The Arcade at Brigade Orchards
Within 20 mins
KIADB Aerospace SEZ and Hardware Park
Within 20 mins
IFCI Financial City
Within 30 mins
Boeing International Corporation
Within 30 mins
Wipro Infrastructure Engg
Within 30 mins
Amada India Technical Centre
Within 30 mins
SAP Labs
Within 30 mins
Kirloskar Tech Park
Within 45 mins
Infosys Limited
Within 45 mins
Manyata Business Park
Within 45 mins
Texas Instruments
Within 30 mins
Centum
Within 30 mins
Ecopolis Tech Park
Within 45 mins
Starrag India
Within 30 mins
Shell India Markets
Within 30 mins
The Arcade at Brigade Orchards
Within 20 mins
KIADB Aerospace SEZ and Hardware Park
Within 20 mins
IFCI Financial City
Within 30 mins
Boeing International Corporation
Within 30 mins
Wipro Infrastructure Engg
Within 30 mins
Amada India Technical Centre
Within 30 mins
SAP Labs
Within 30 mins
Kirloskar Tech Park
Within 45 mins
Infosys Limited
Within 45 mins
Manyata Business Park
Within 45 mins
Texas Instruments
Within 30 mins
Centum
Within 30 mins
Ecopolis Tech Park
Within 45 mins
Starrag India
Within 30 mins
Shell India Markets
Within 30 mins
Signature Club Resort
Within 20 mins
RFC Football Academy
Within 20 mins
The Quad by BLR
Within 20 mins
Golfshire Club
Within 20 mins
Esteem Mall
Within 30 mins
Galleria Mall
Within 30 mins
Decathlon
Within 30 mins
Phoenix Mall of Asia
Within 30 mins
Chairman’s Club
Within 45 mins
Clarks Exotica
Within 45 mins
Elements Mall
Within 45 mins
Goldfinch Retreat
Within 45 mins
Sahakarnagar High Street
Within 45 mins
Yelahanka High Street
Within 45 mins
The Leela Palace
Within 45 mins
National Cricket Academy (New campus in KIADB)
Within 20 mins
Sports Arena and Stadium (Brigade Orchards)
Within 20 mins
Old Bangalore
Within 30 mins
Signature Club Resort
Within 20 mins
RFC Football Academy
Within 20 mins
The Quad by BLR
Within 20 mins
Golfshire Club
Within 20 mins
Esteem Mall
Within 30 mins
Galleria Mall
Within 30 mins
Decathlon
Within 30 mins
Phoenix Mall of Asia
Within 30 mins
Chairman’s Club
Within 45 mins
Clarks Exotica
Within 45 mins
Elements Mall
Within 45 mins
Goldfinch Retreat
Within 45 mins
Sahakarnagar High Street
Within 45 mins
Yelahanka High Street
Within 45 mins
The Leela Palace
Within 45 mins
National Cricket Academy (New campus in KIADB)
Within 20 mins
Sports Arena and Stadium (Brigade Orchards)
Within 20 mins
Old Bangalore
Within 30 mins
Nandi Hills
Within 30 mins
Jain Temple
Within 1 hour
Devanahalli Fort
Within 30 mins
Nandi Hills
Within 30 mins
Jain Temple
Within 1 hour
Devanahalli Fort
Within 30 mins
Namma Metro Station
Within 30 mins
Kempegowda International Airport
Within 20 mins
Namma Metro Station
Within 30 mins
Kempegowda International Airport
Within 20 mins

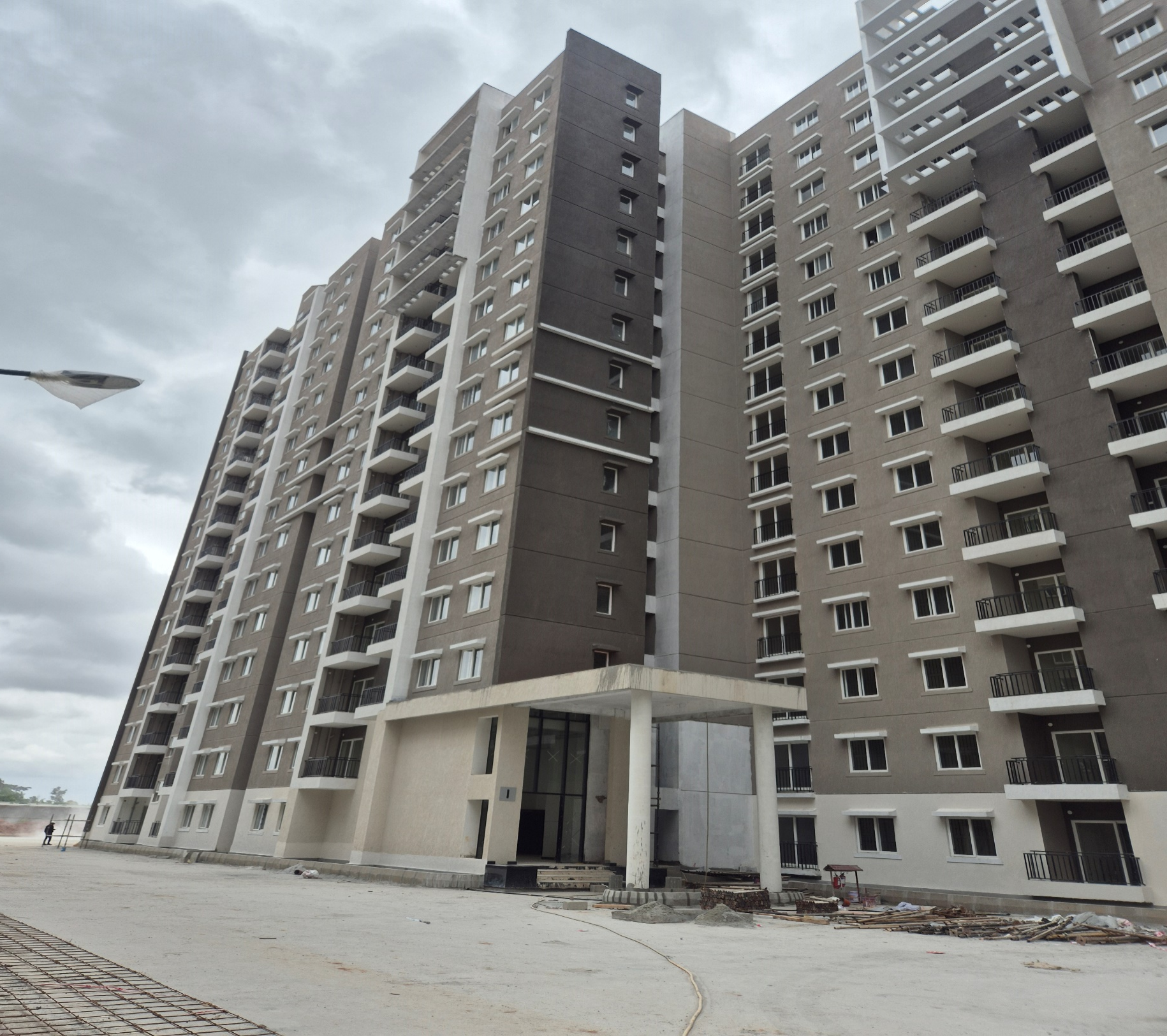

Project Status
The entire project exudes a rare sense of completeness.

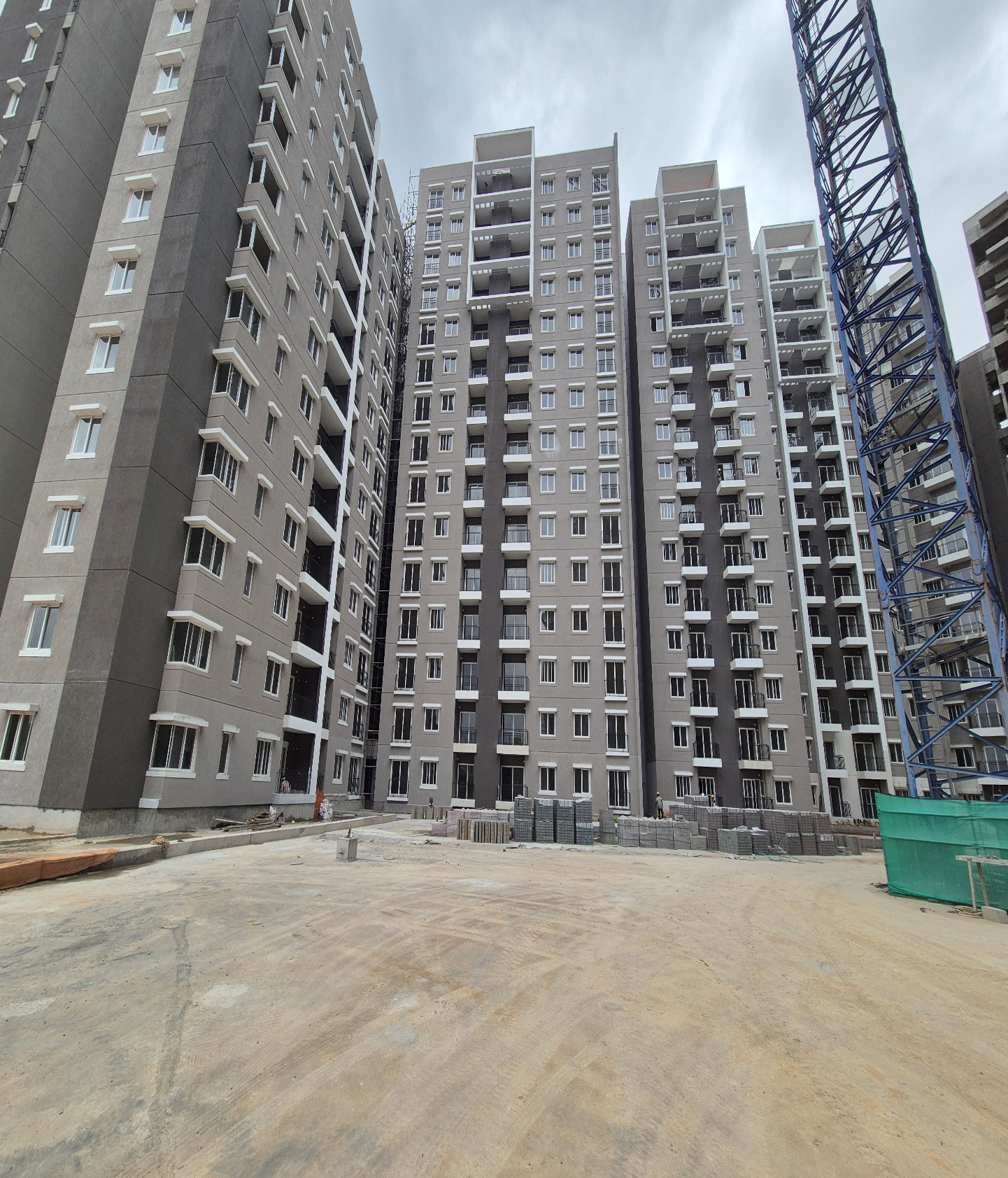

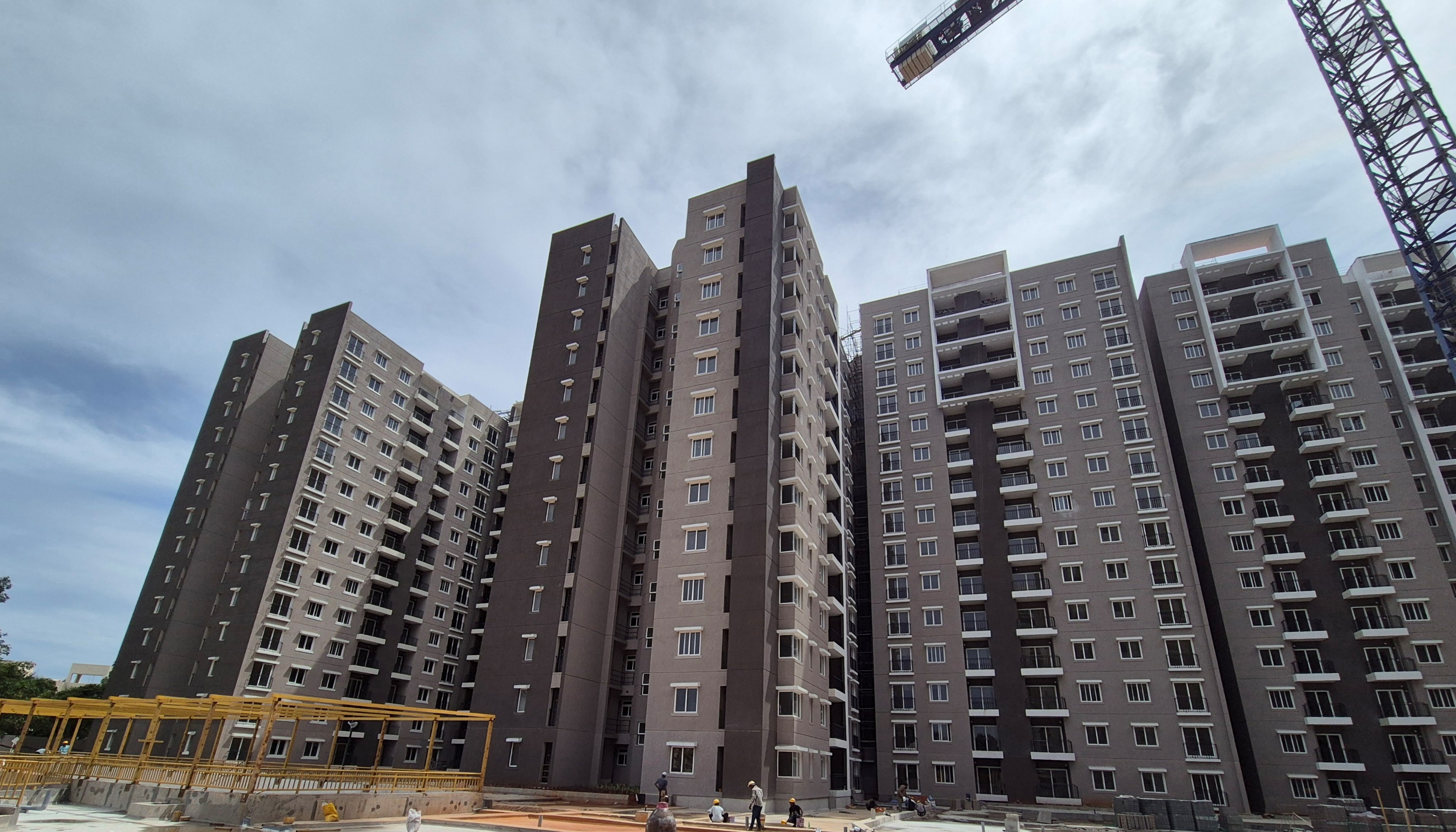

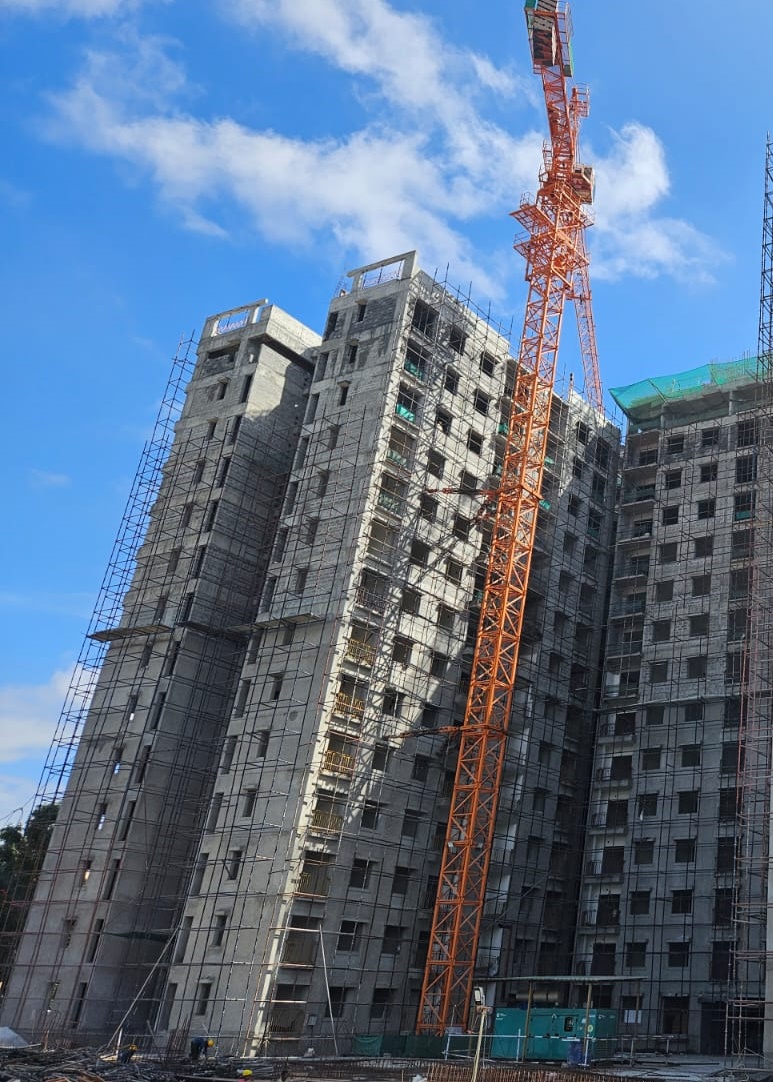

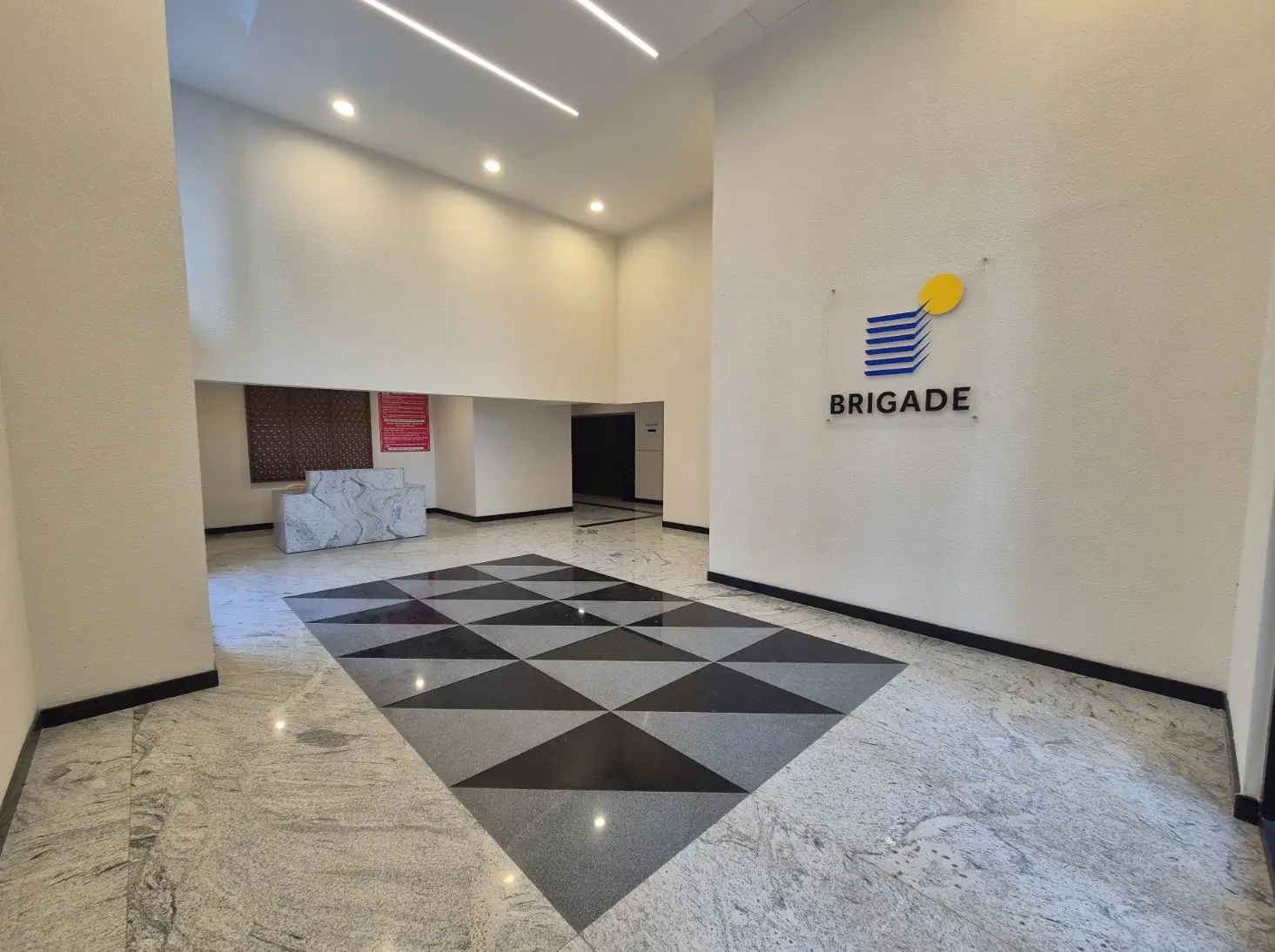

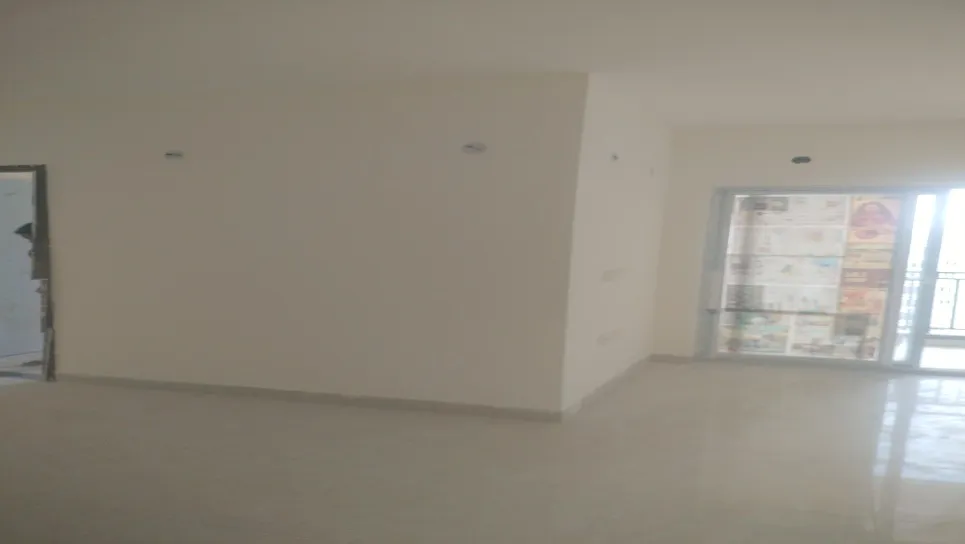

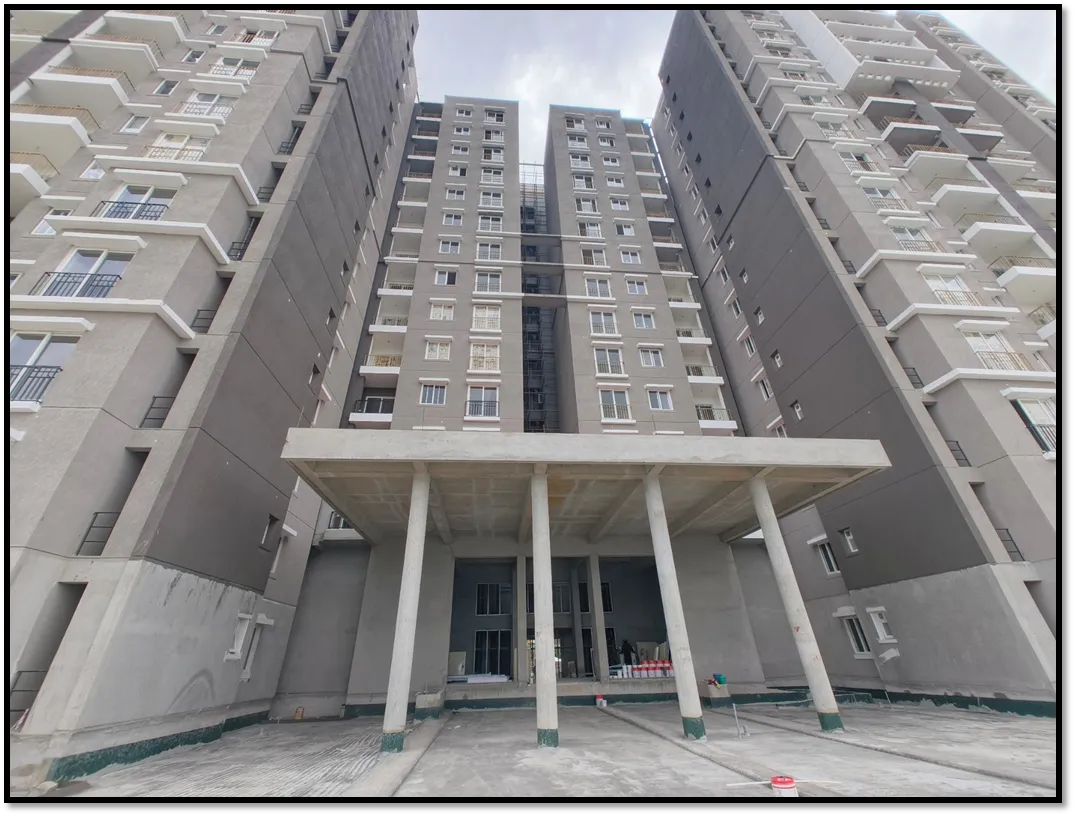

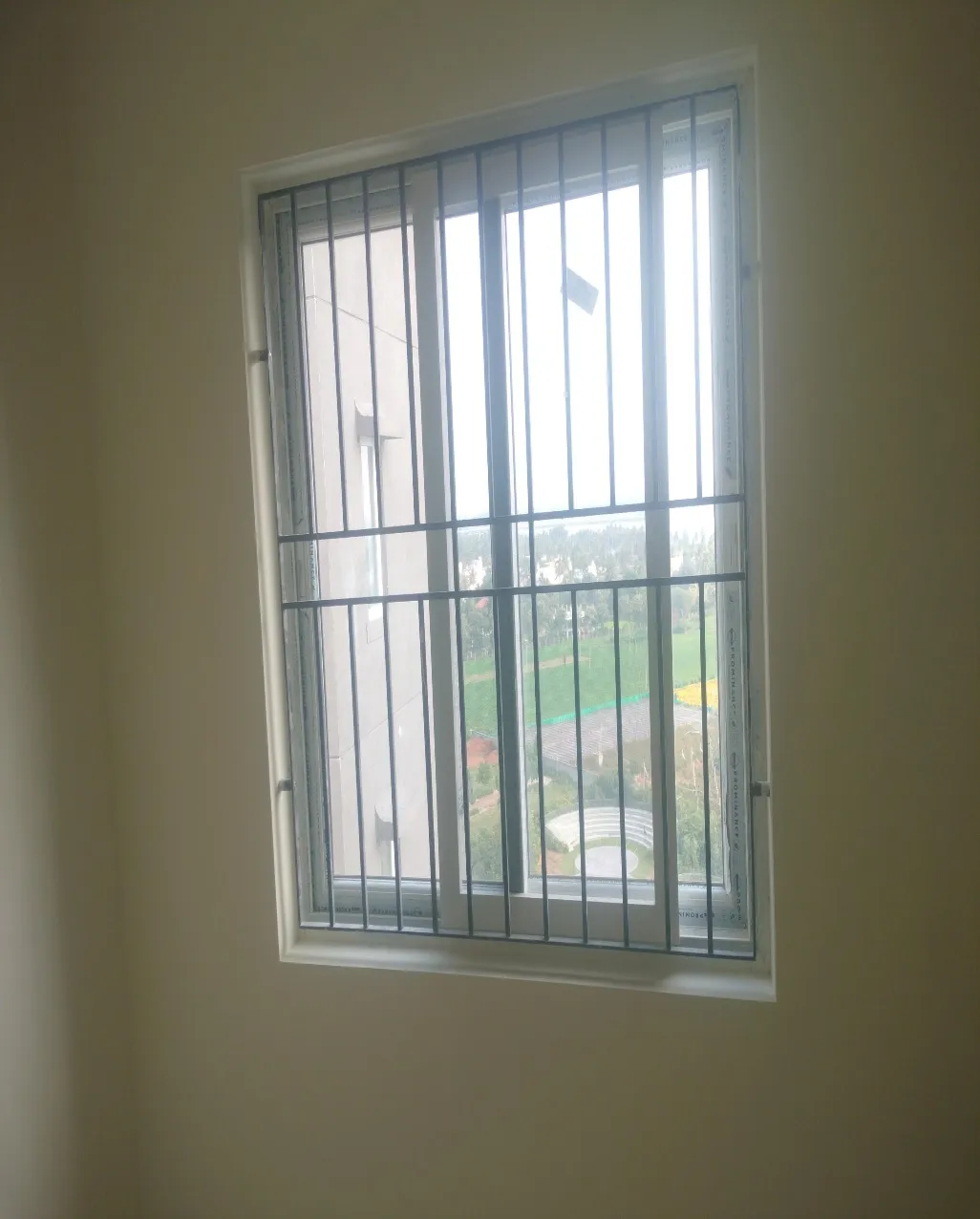

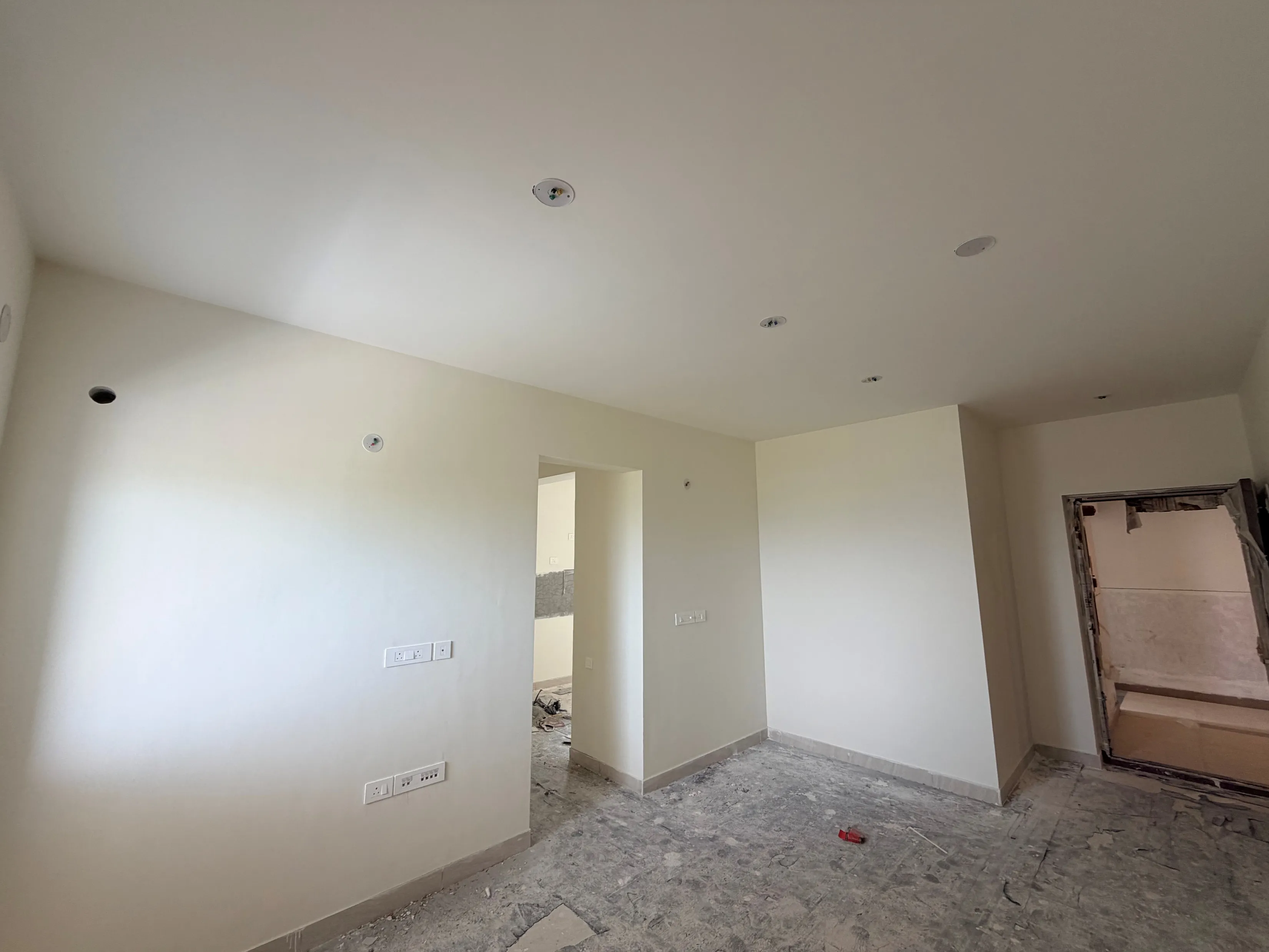

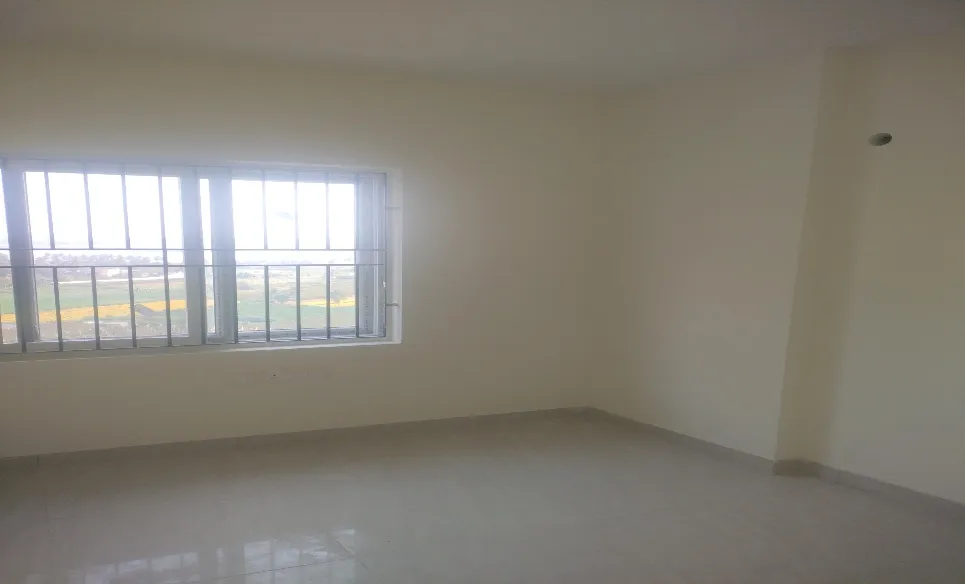

IVORY PHASE 1 I - TOWER -

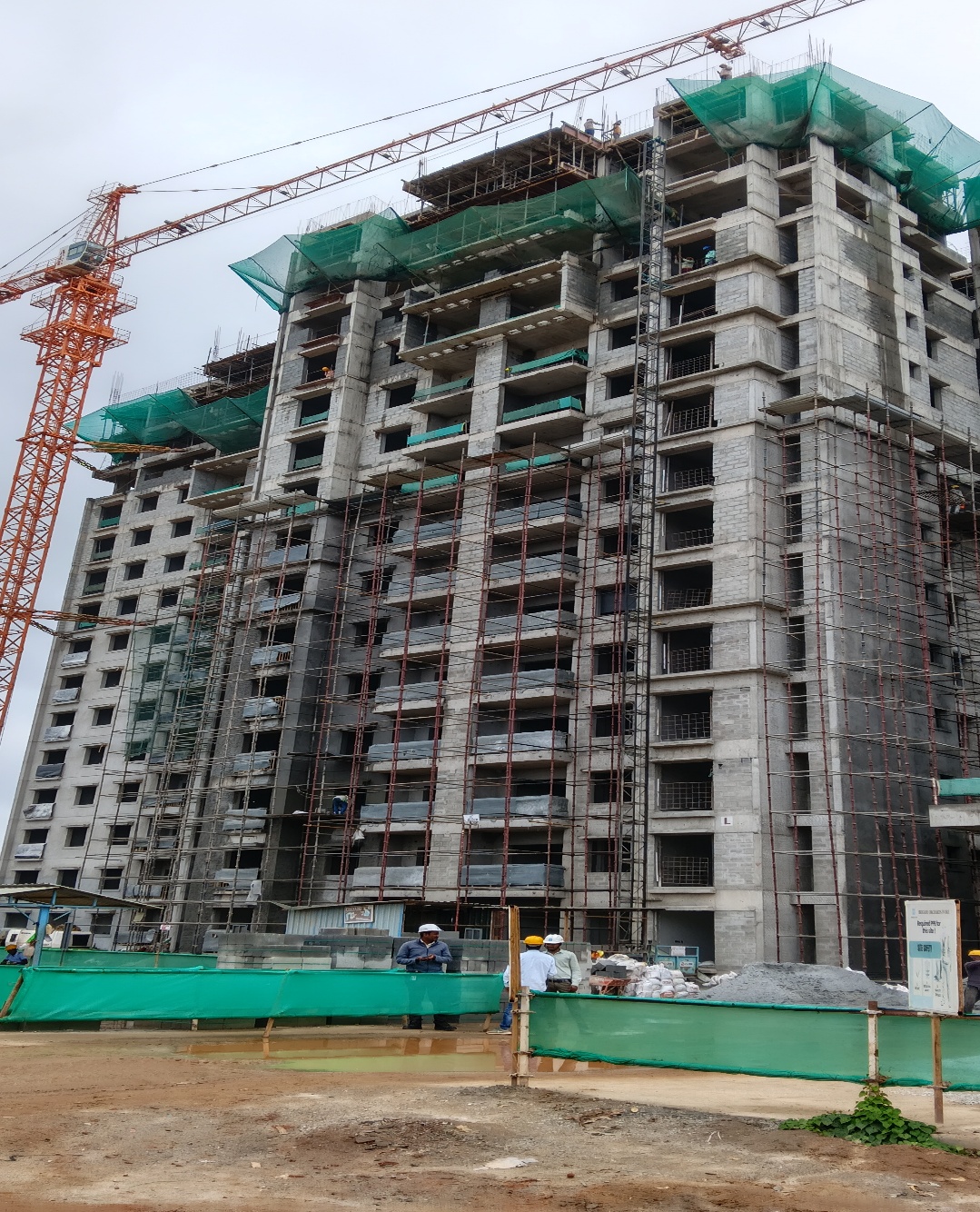

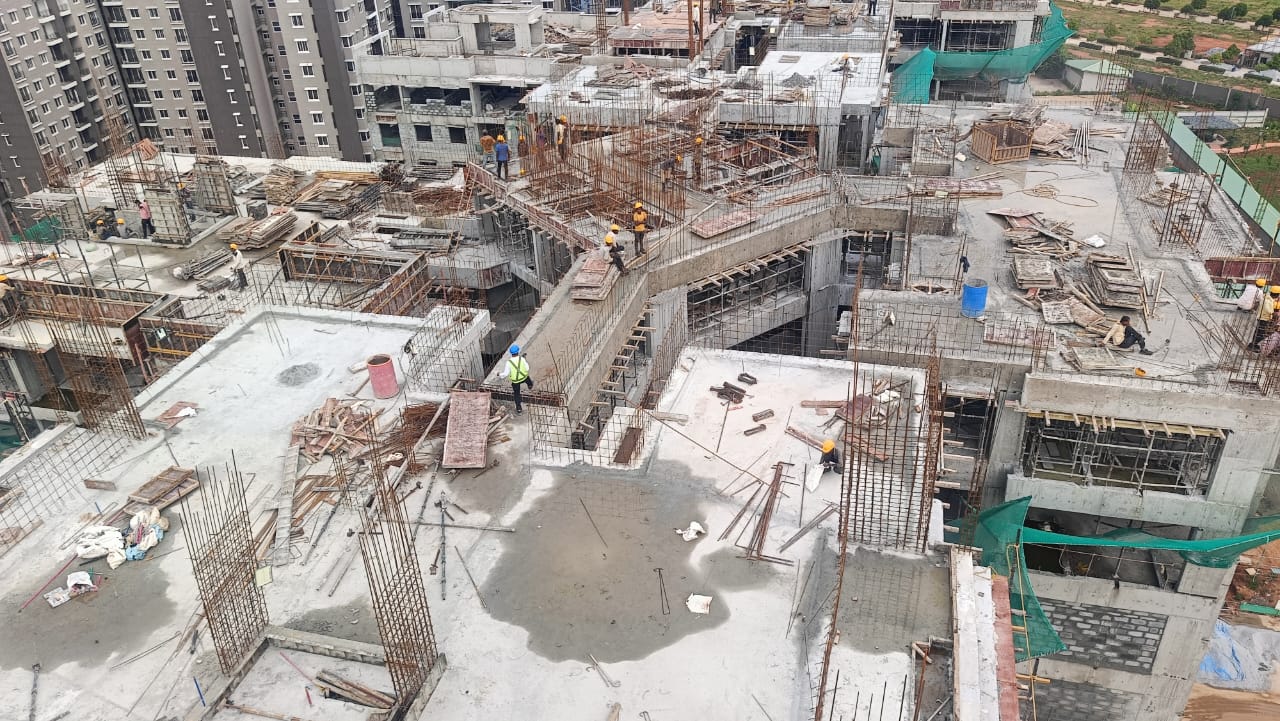

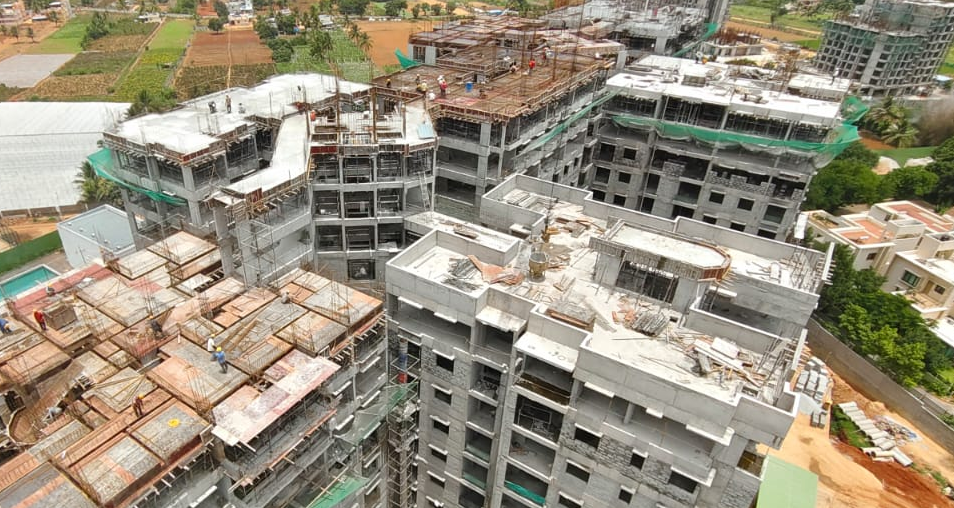

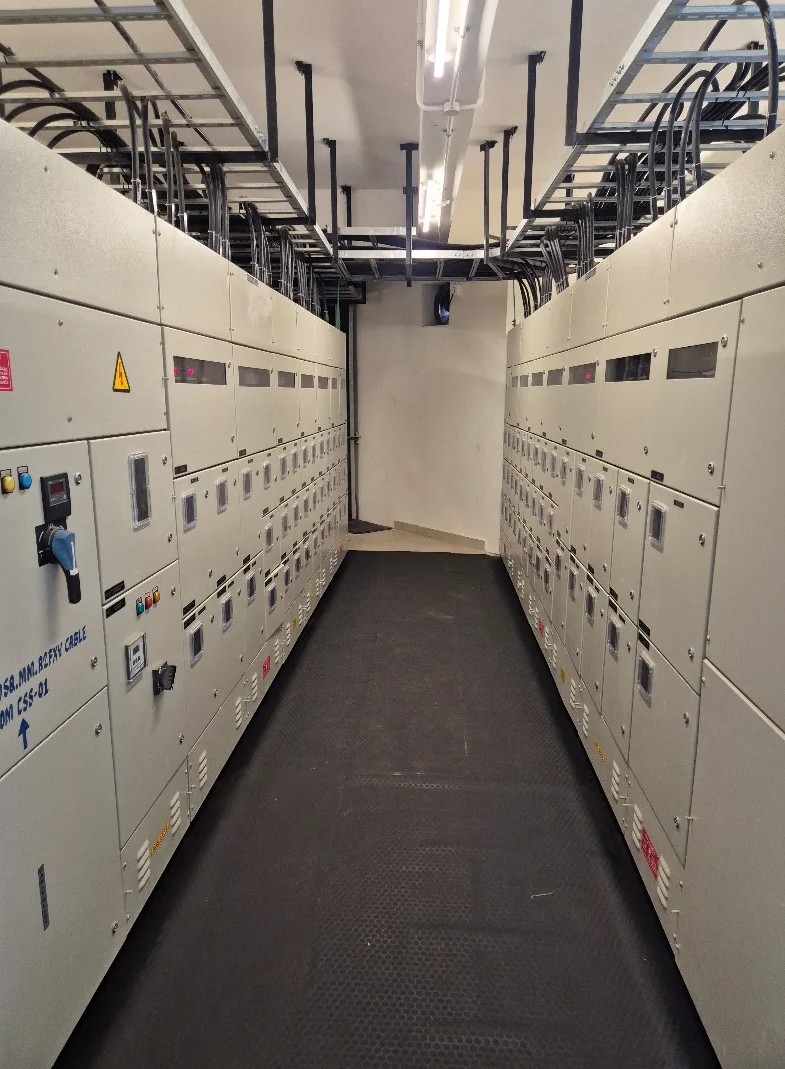

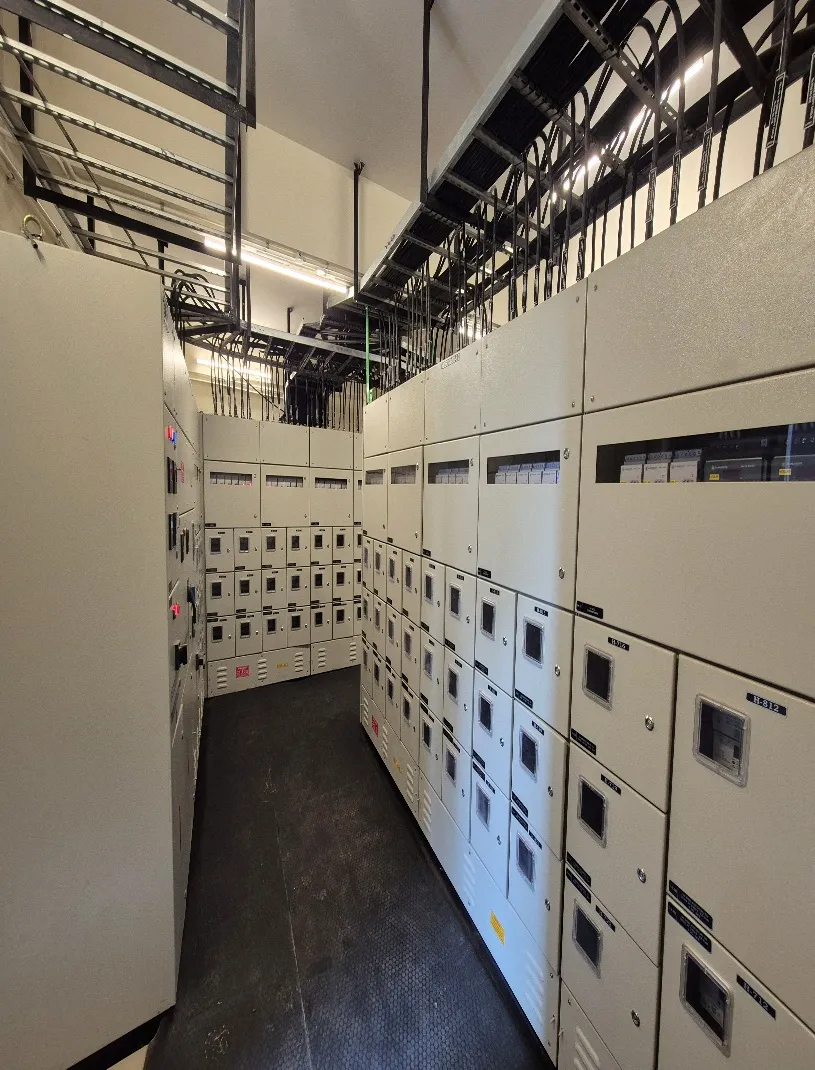

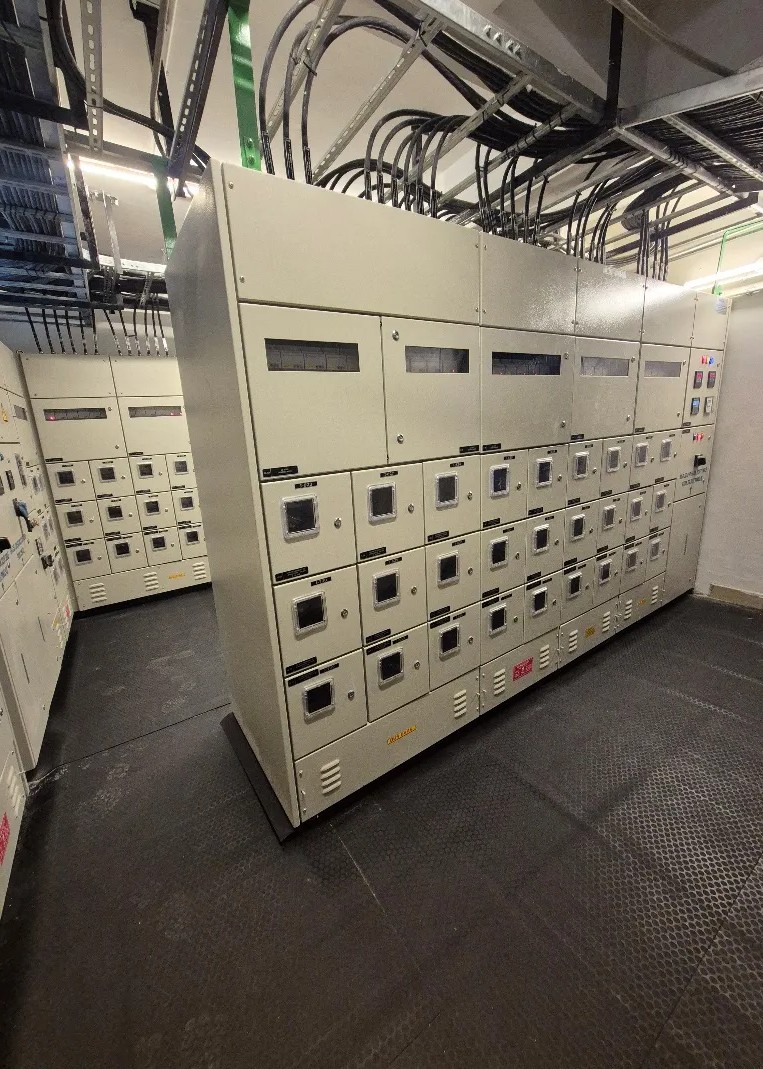

Electrical Panel Rooms - Aug 2026

Electrical Panel Rooms - Aug 2026

Flooring & CP, Sanitary fittings - Aug 2026

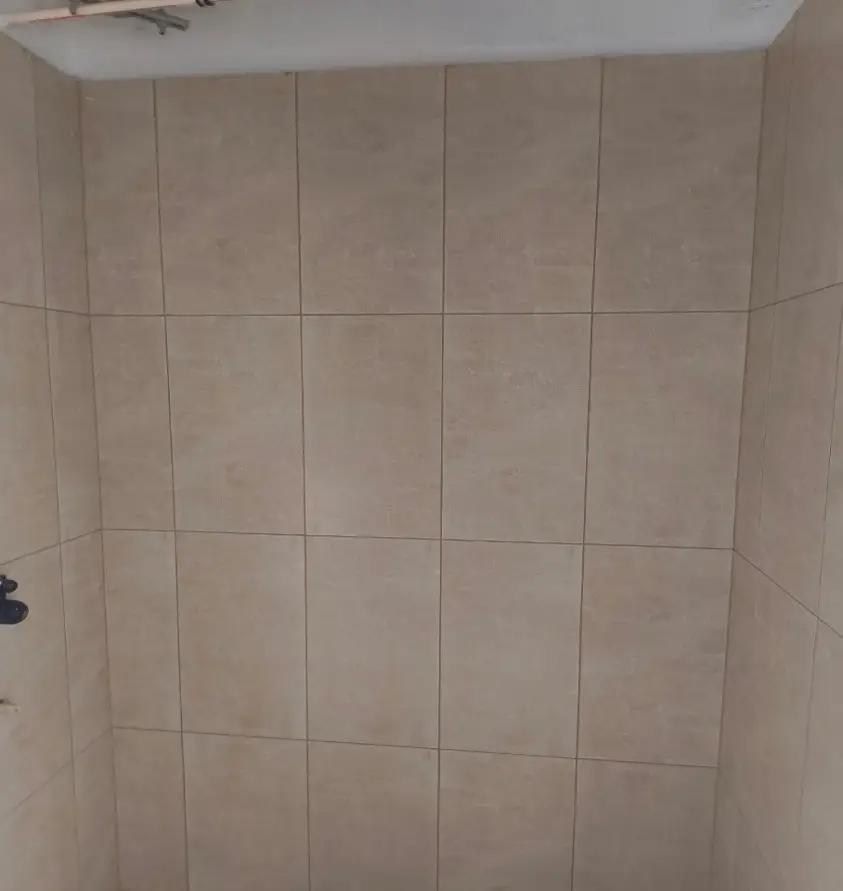

Flooring & CP, Sanitary fittings - Aug 2026

Flooring & CP, Sanitary fittings - Aug 2026

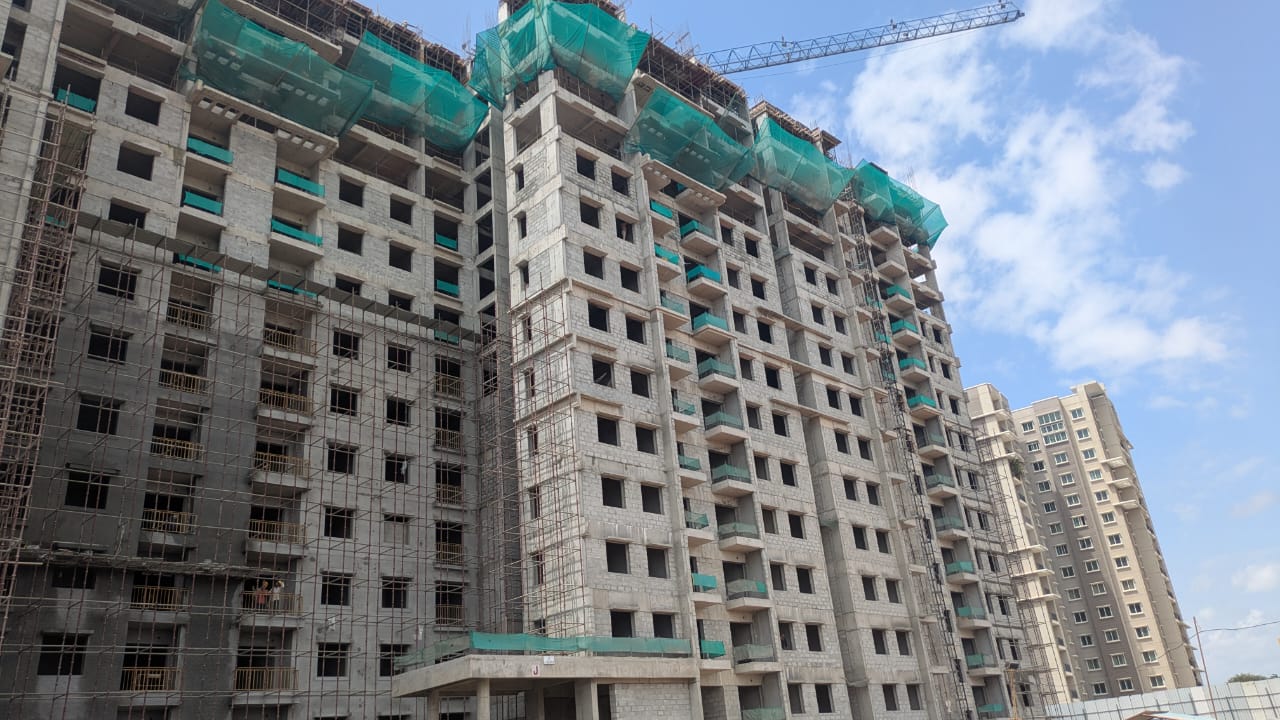

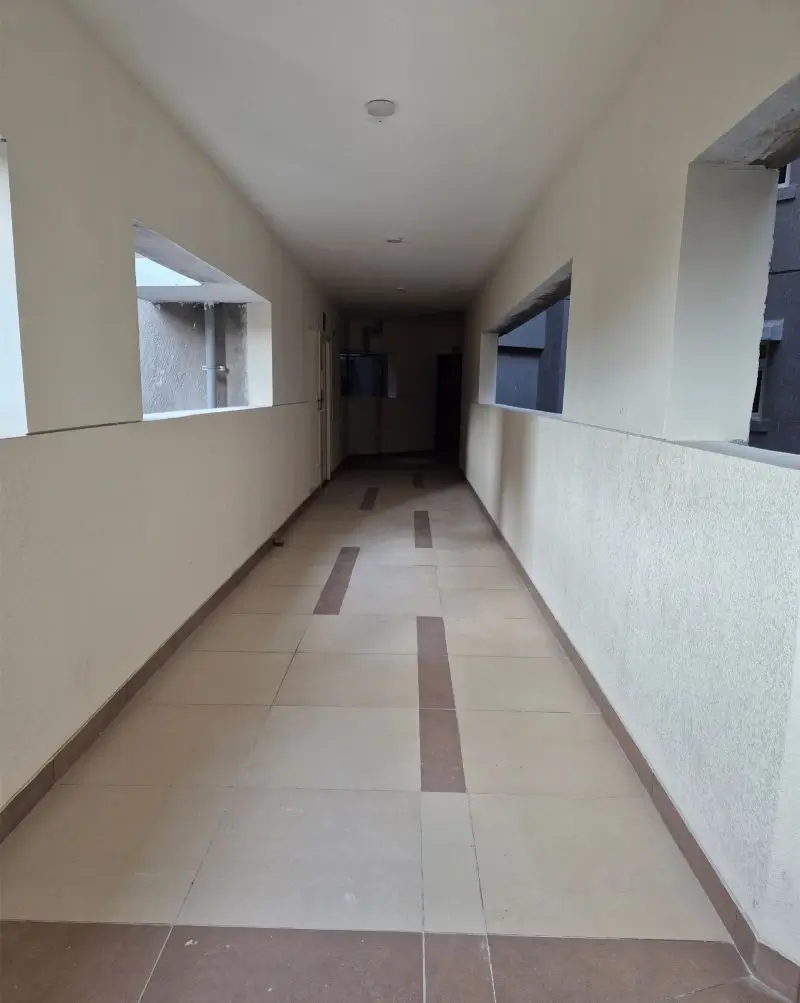

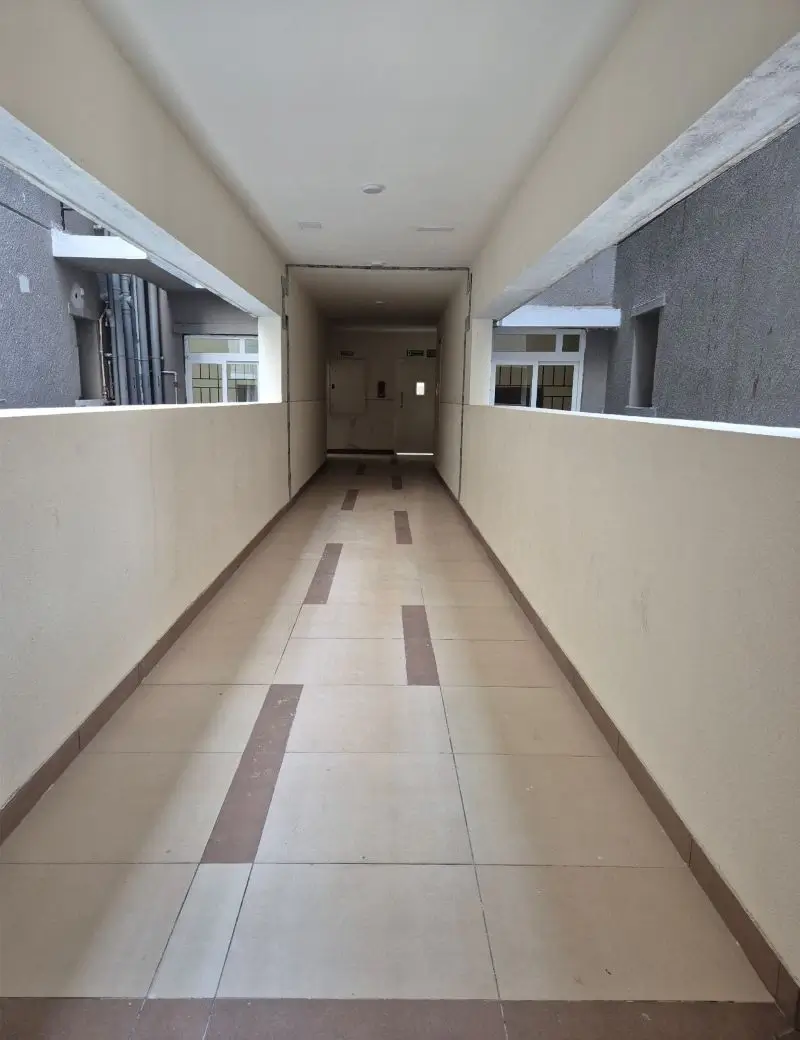

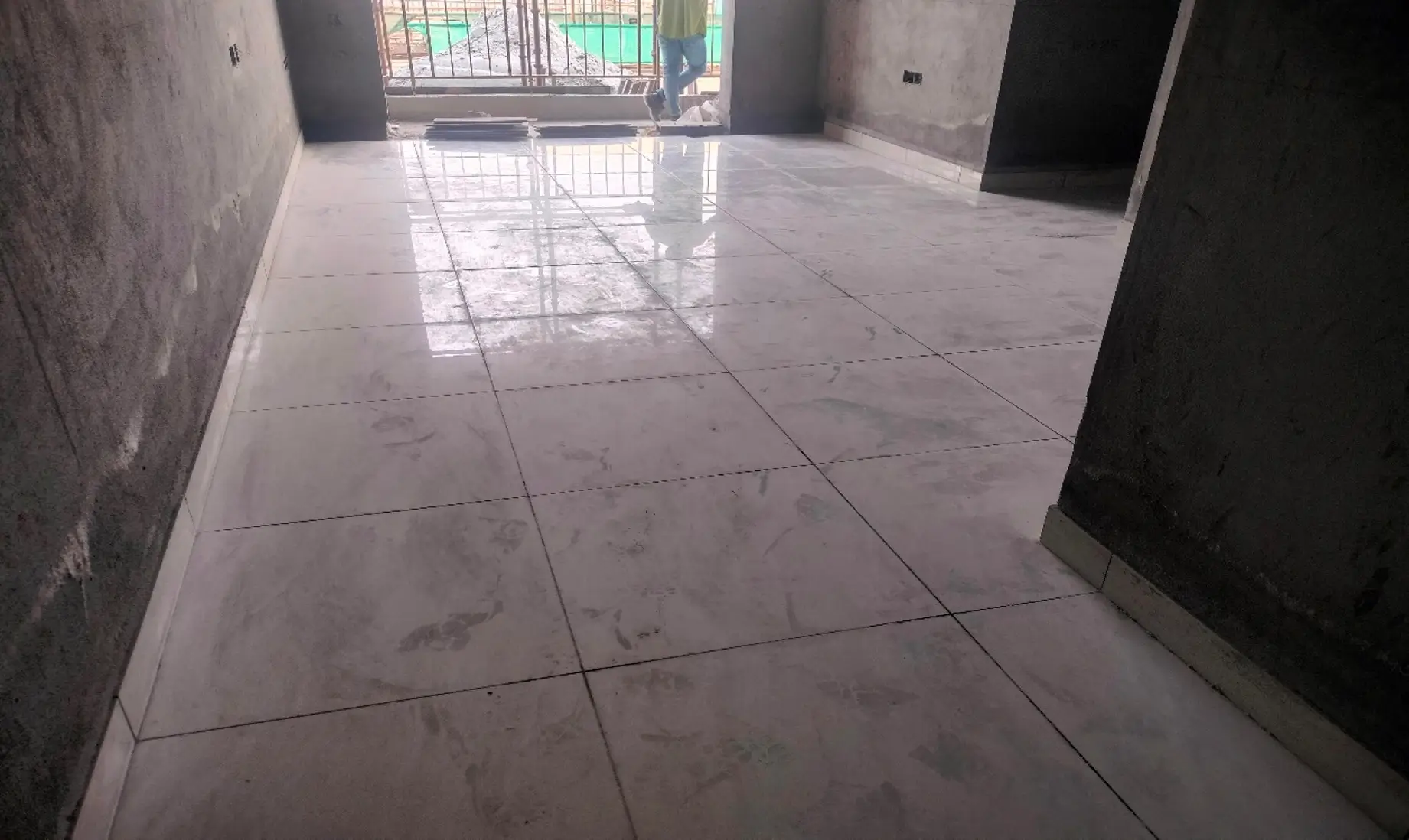

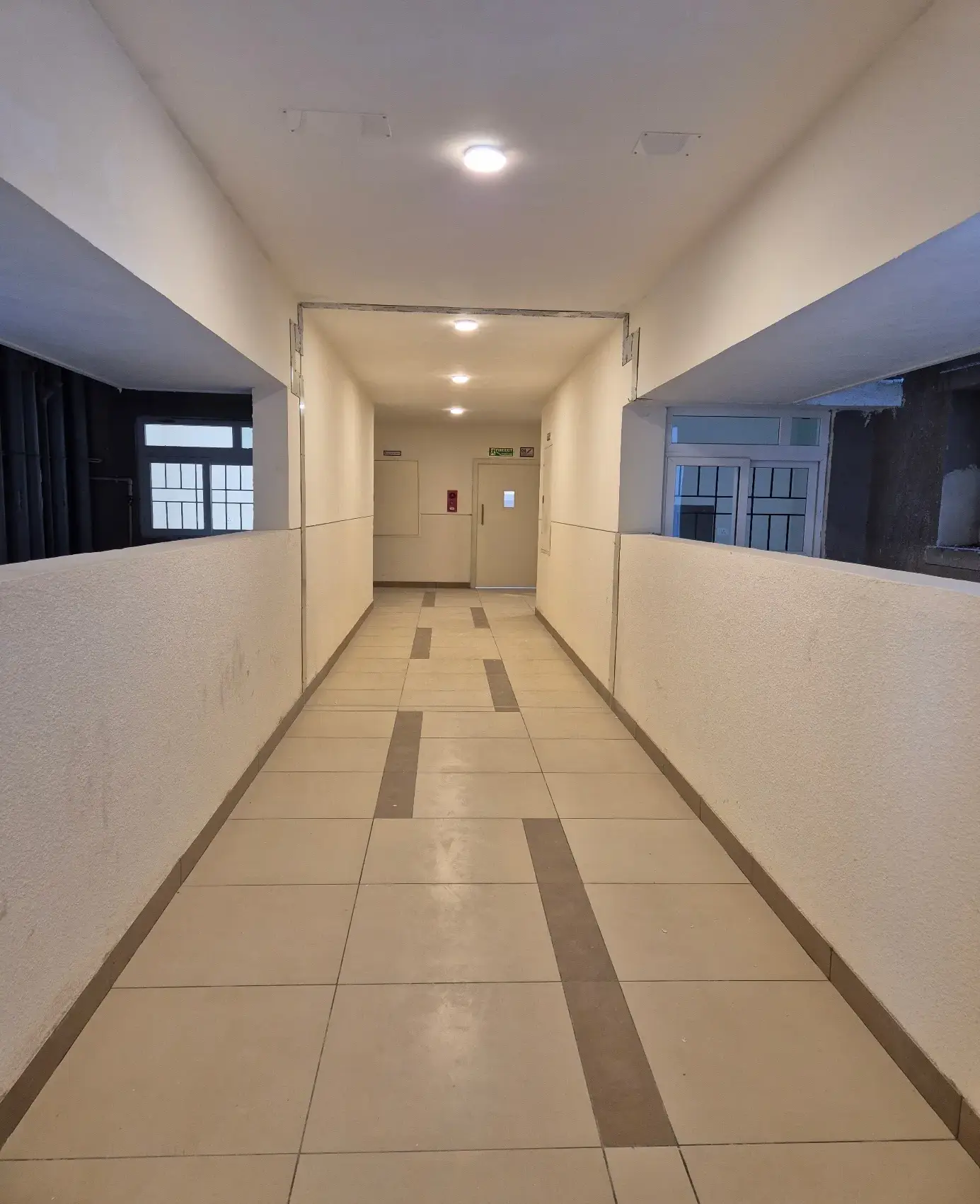

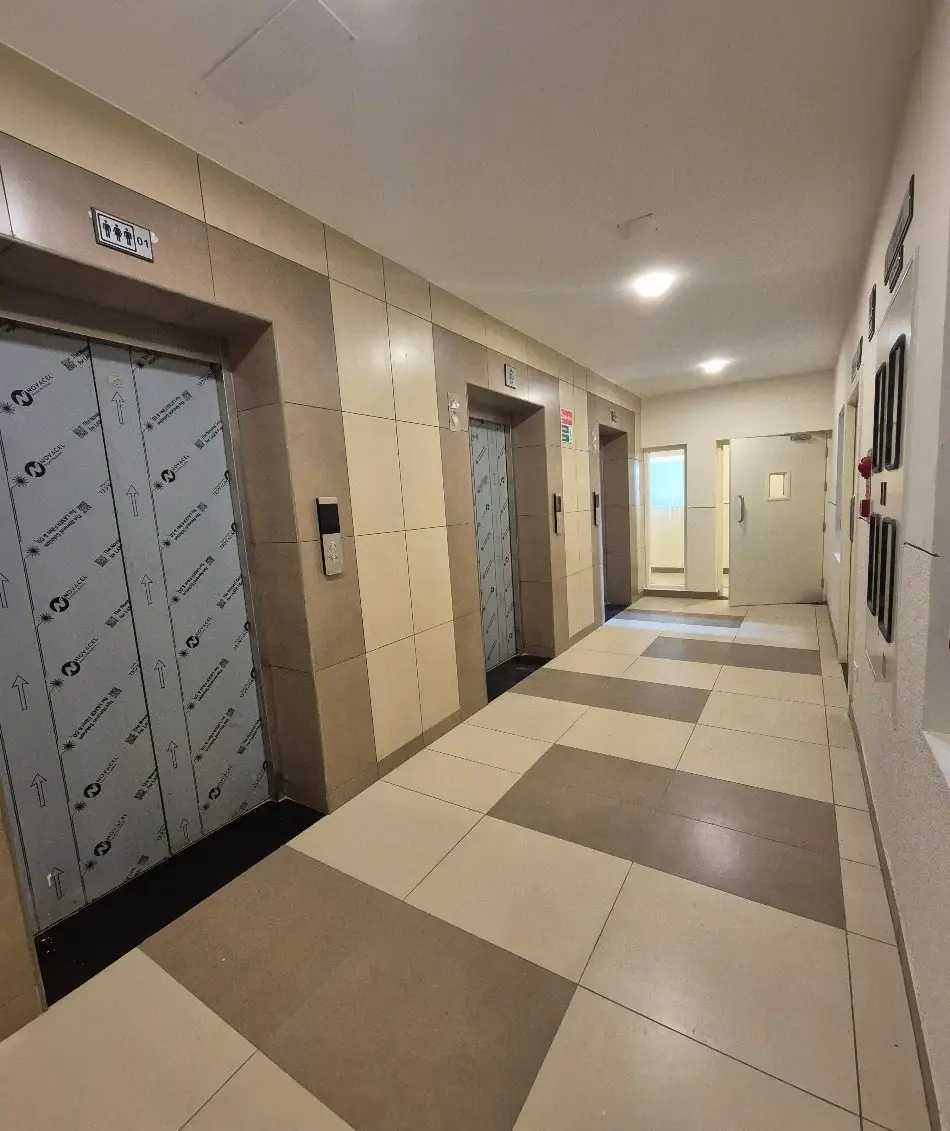

Brigade Orchards IVORY PHASE – 1 Typical floor Lift lobby and Corridor Tower - G, H & I - Aug 2026

Brigade Orchards IVORY PHASE – 1 Typical floor Lift lobby and Corridor Tower - G, H & I - Aug 2026

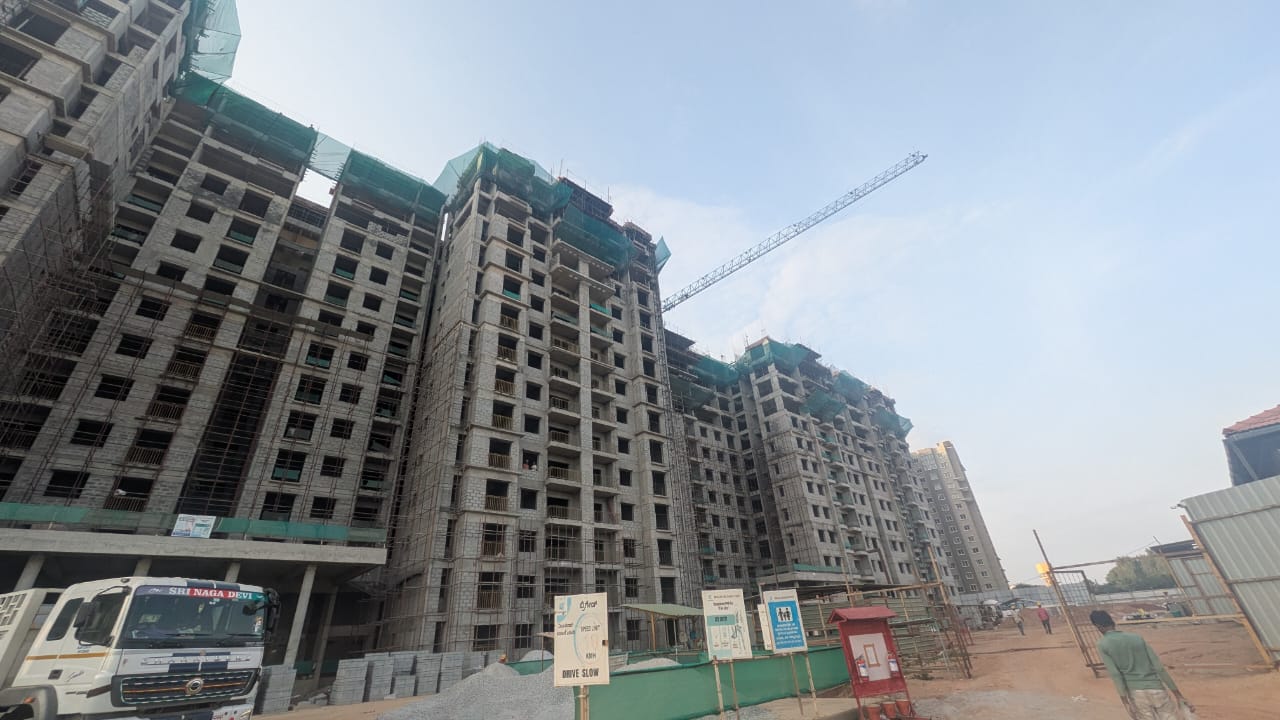

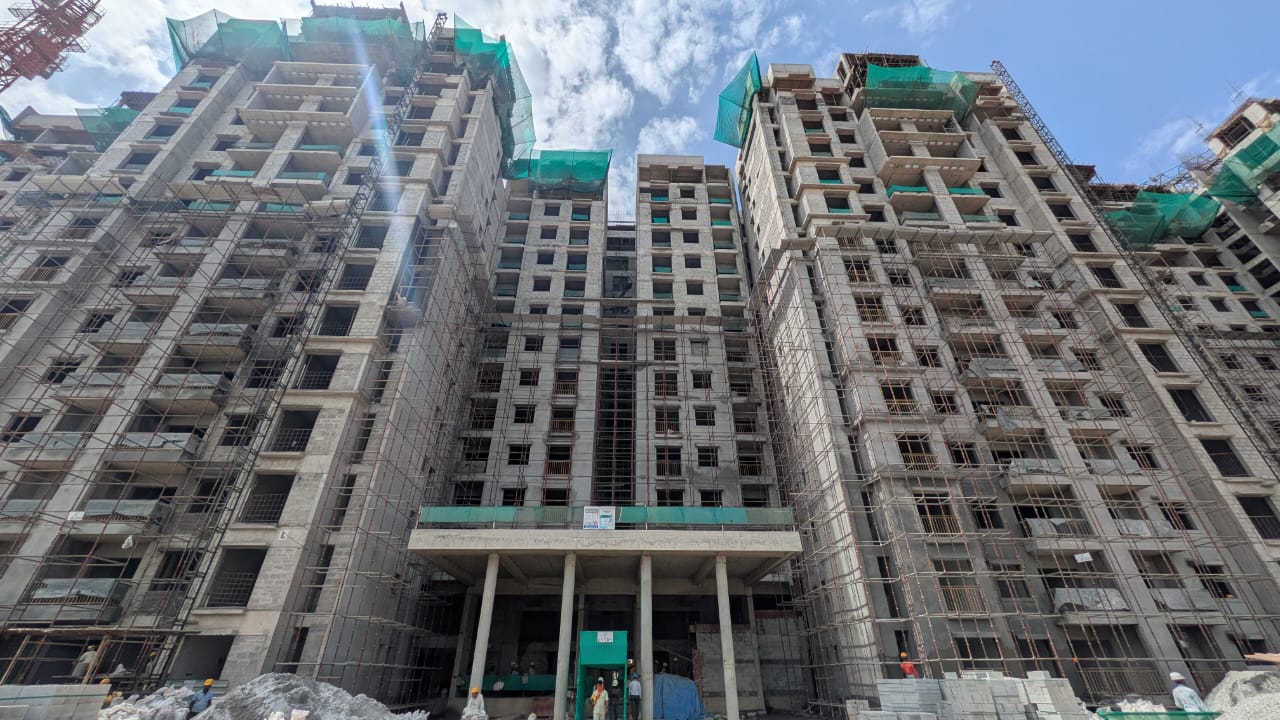

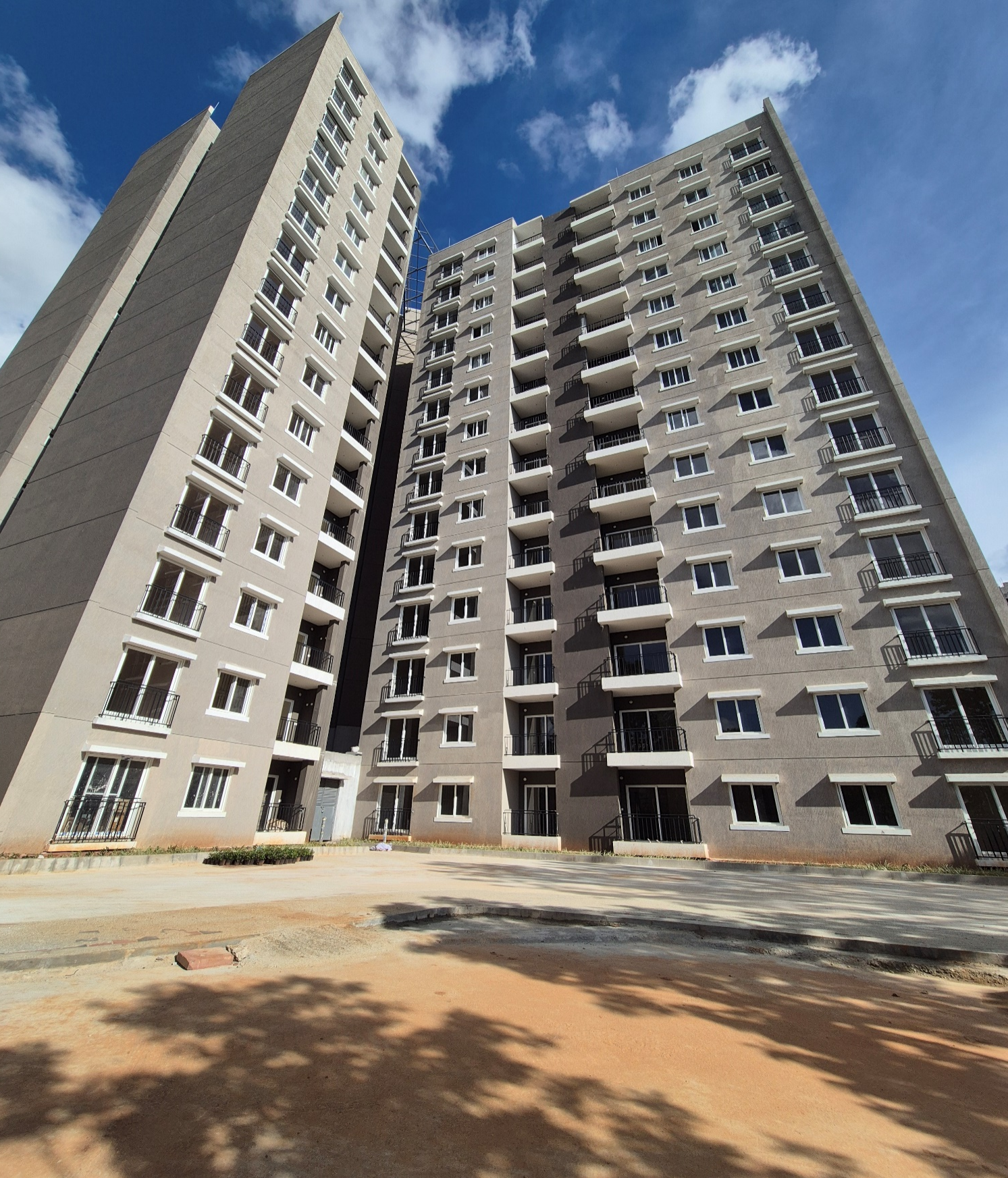

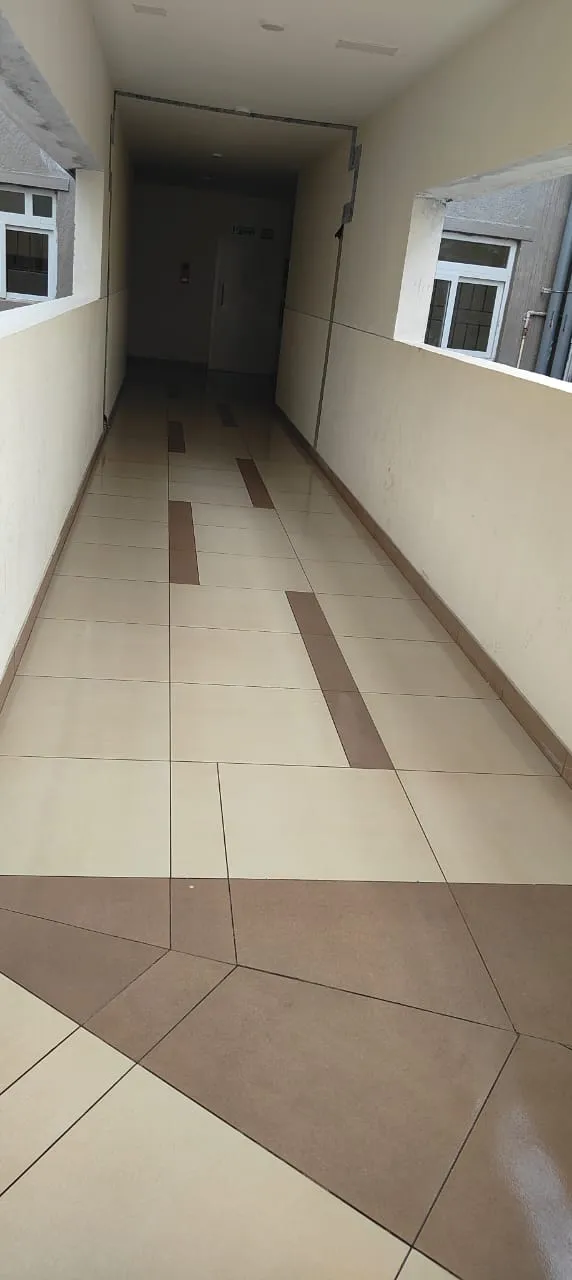

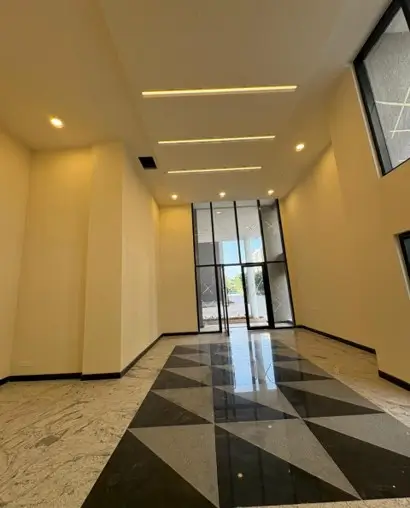

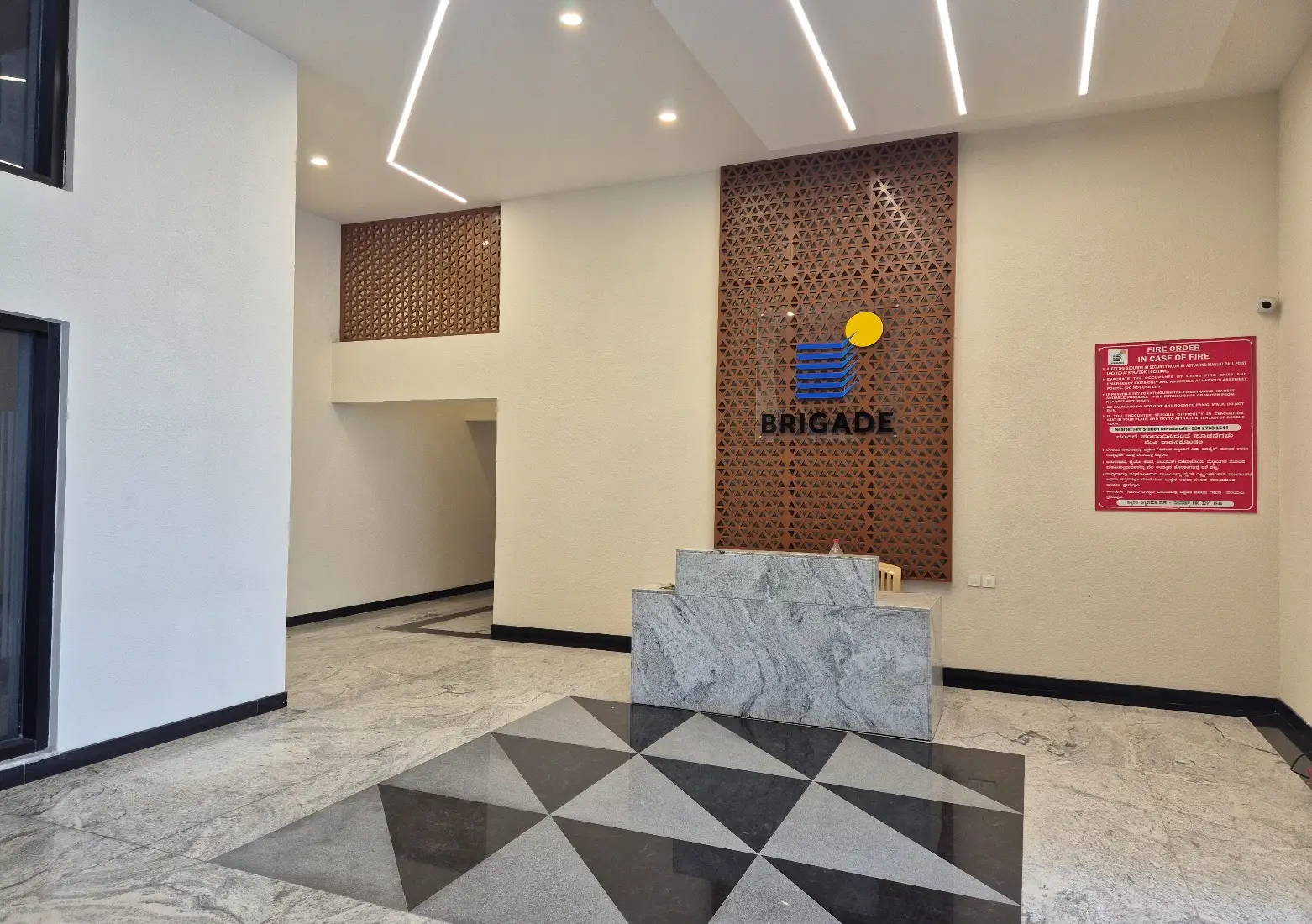

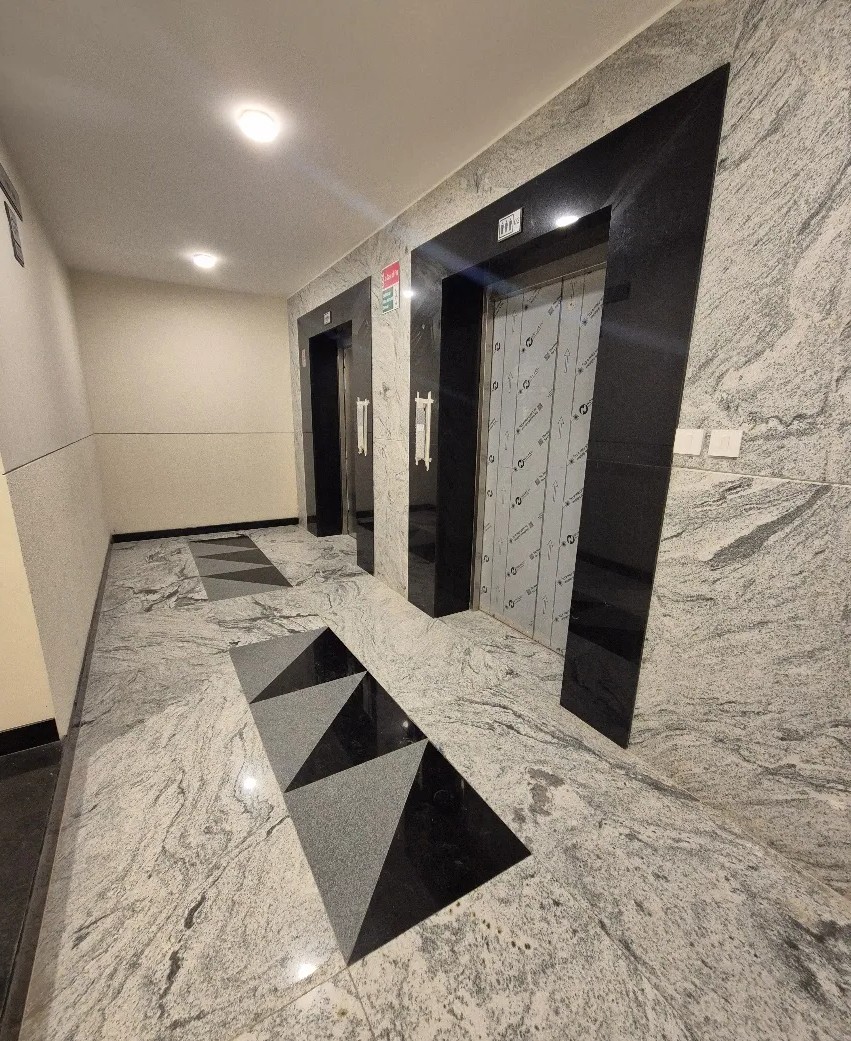

IVORY PHASE – 1 - Tower - G, H & I - Aug 2026

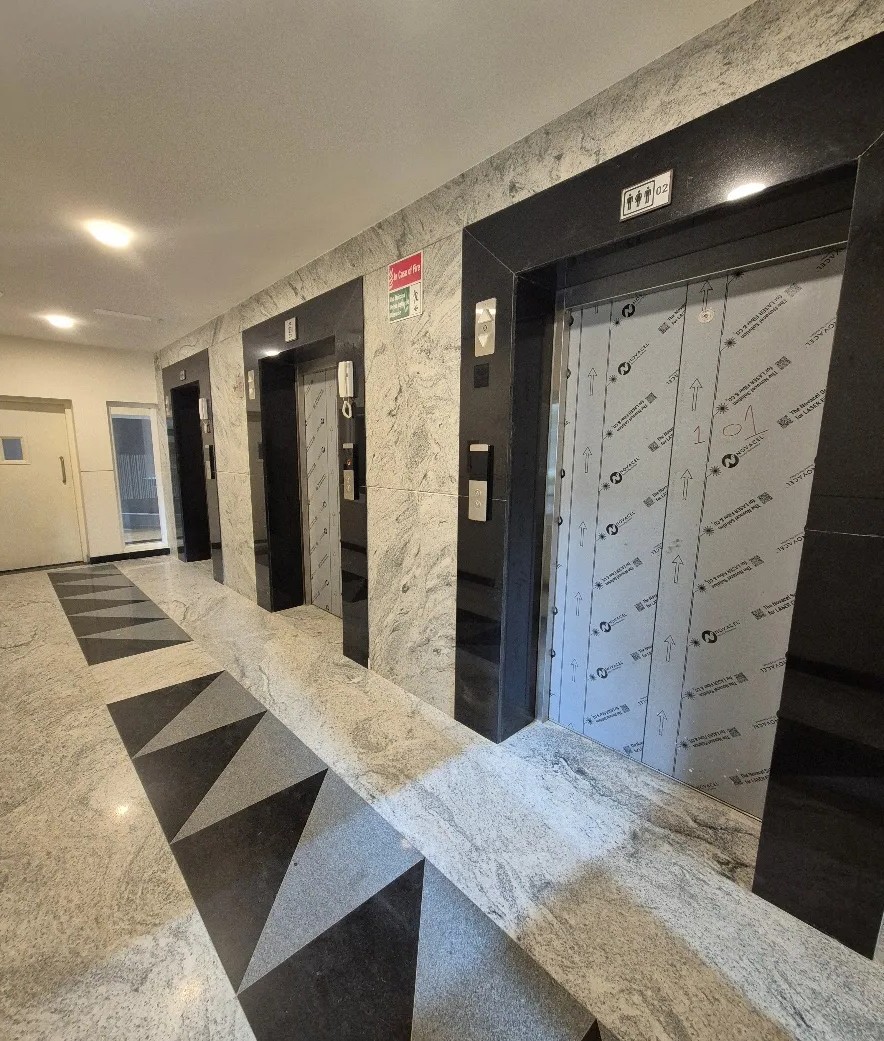

Ground floor Lift lobby and Corridor Tower - G, H & I - Aug 2026

Ground floor Lift lobby and Corridor Tower - G, H & I - Aug 2026

Ground floor Lift lobby and Corridor Tower - G, H & I - Aug 2026

Ground floor Lift lobby and Corridor Tower - G, H & I - Aug 2026

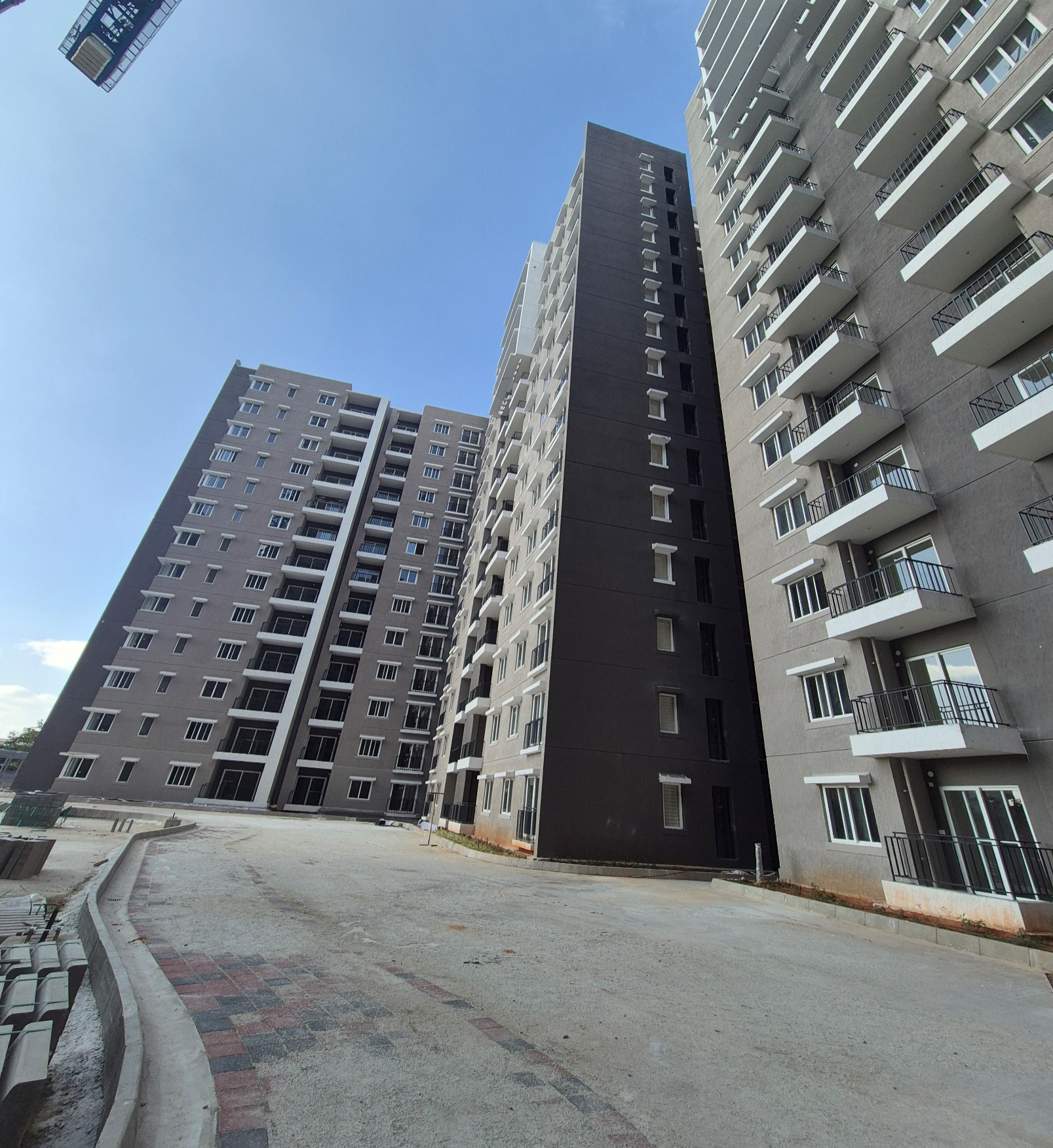

IVORY PHASE – 1 Tower - G, H & I - Aug 2026

IVORY PHASE – 1 Tower - G, H & I - Aug 2026

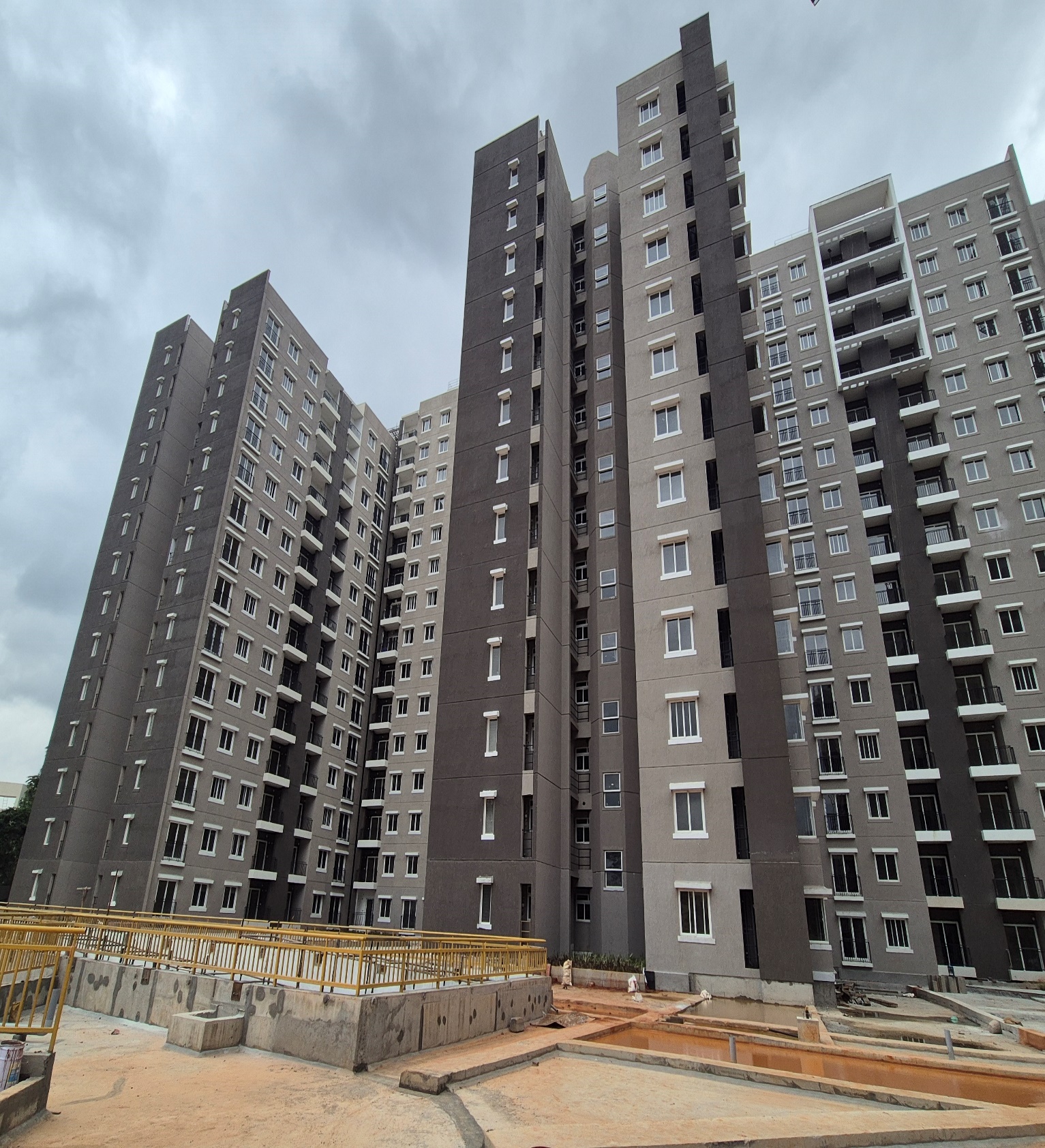

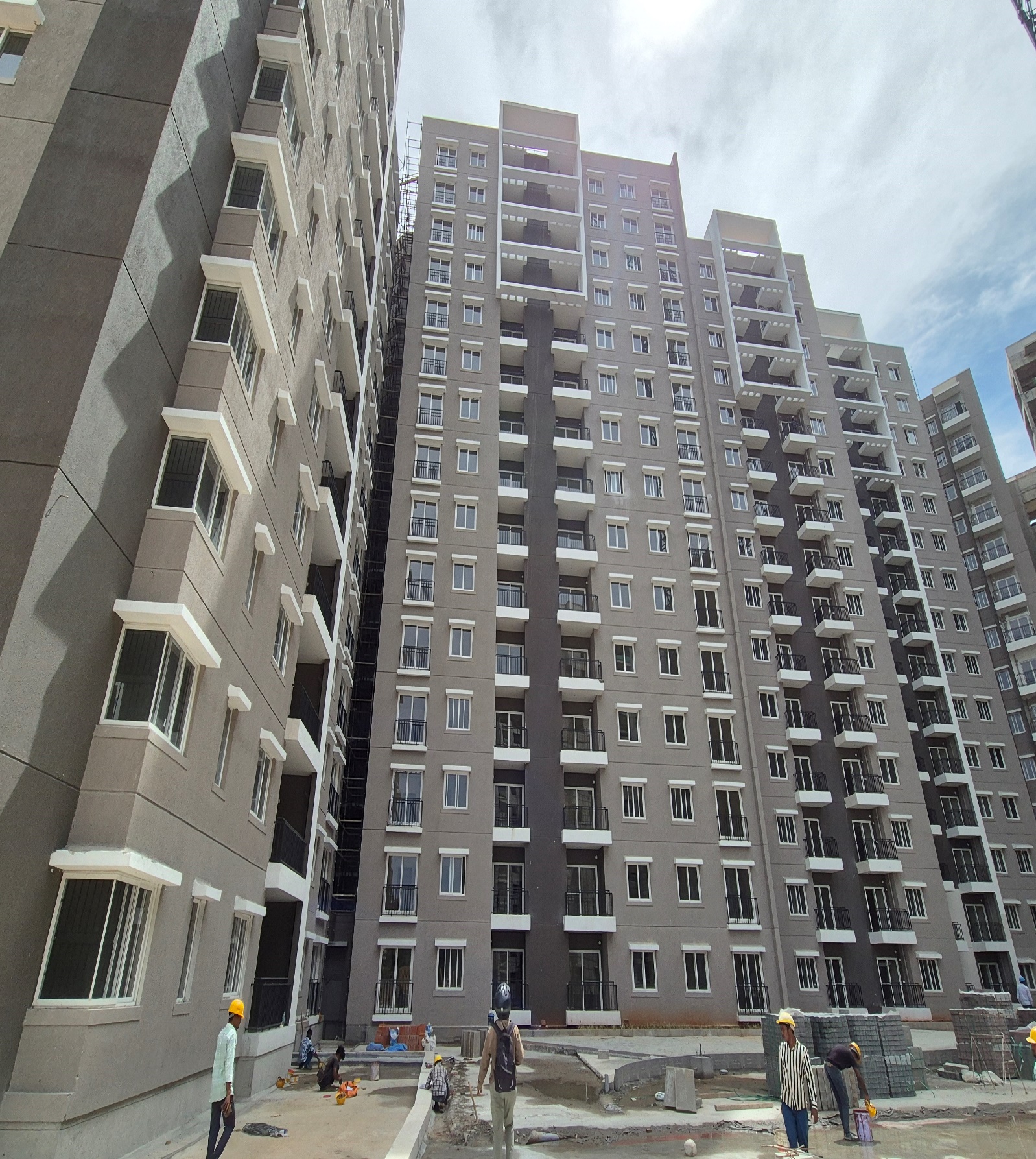

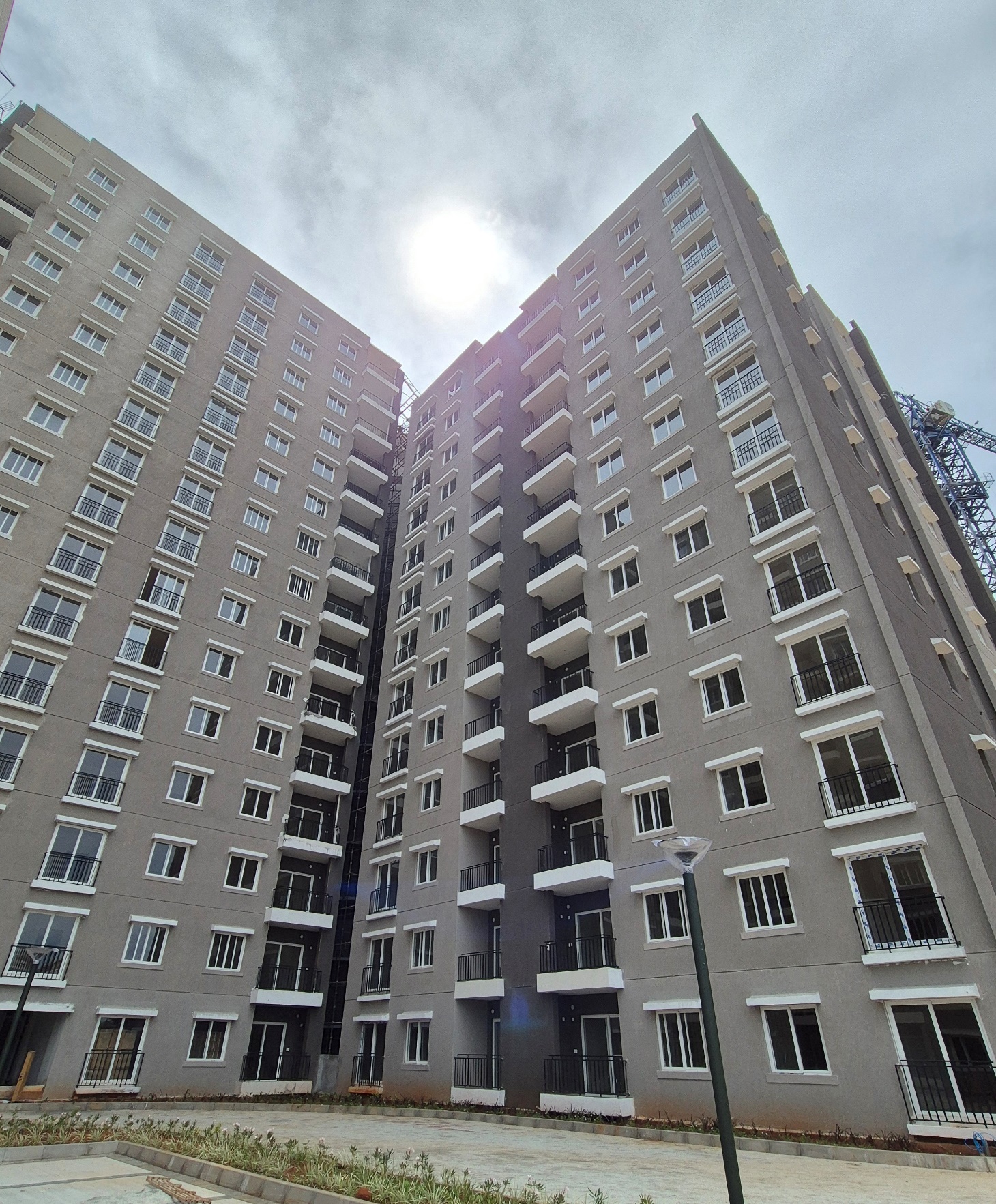

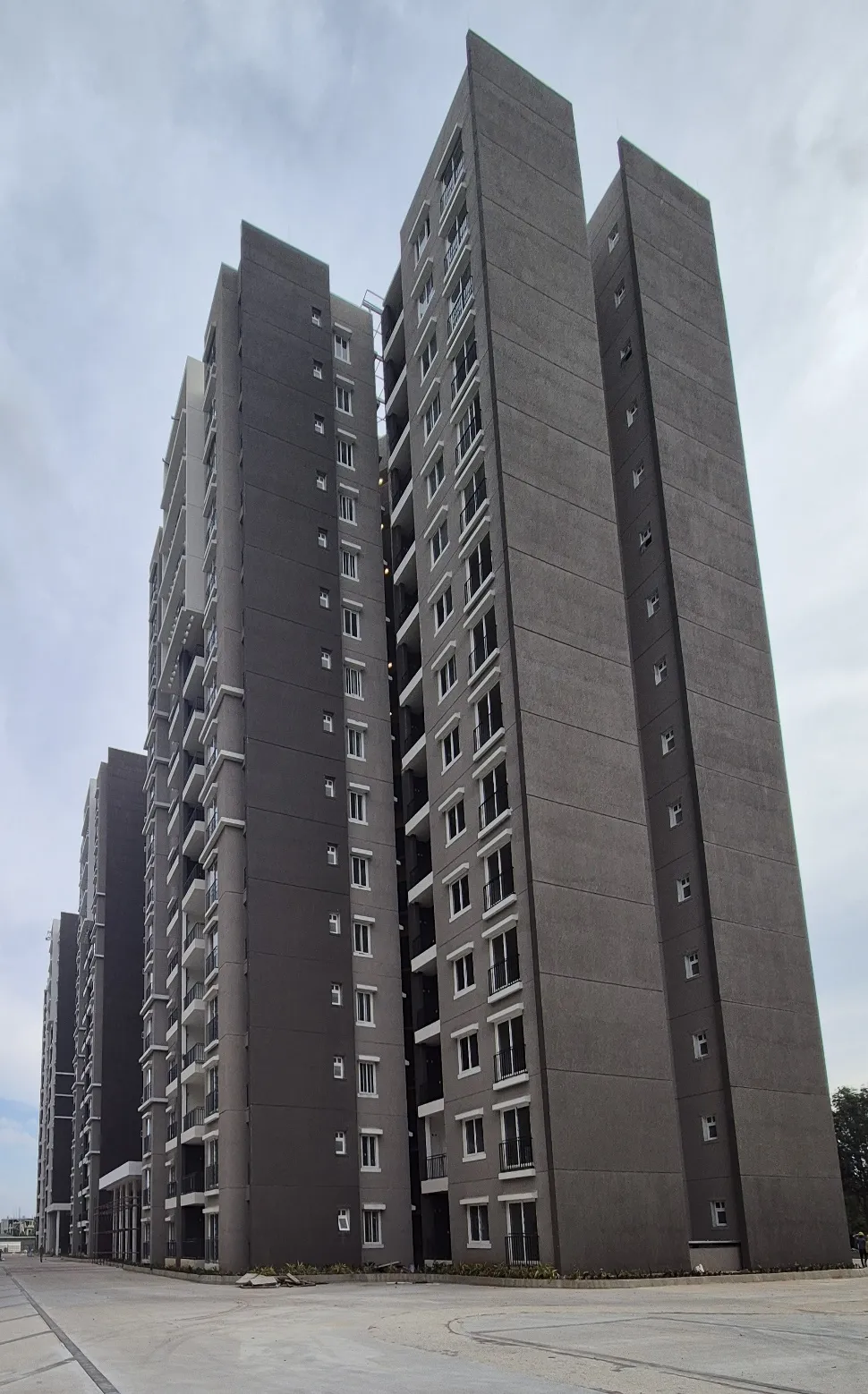

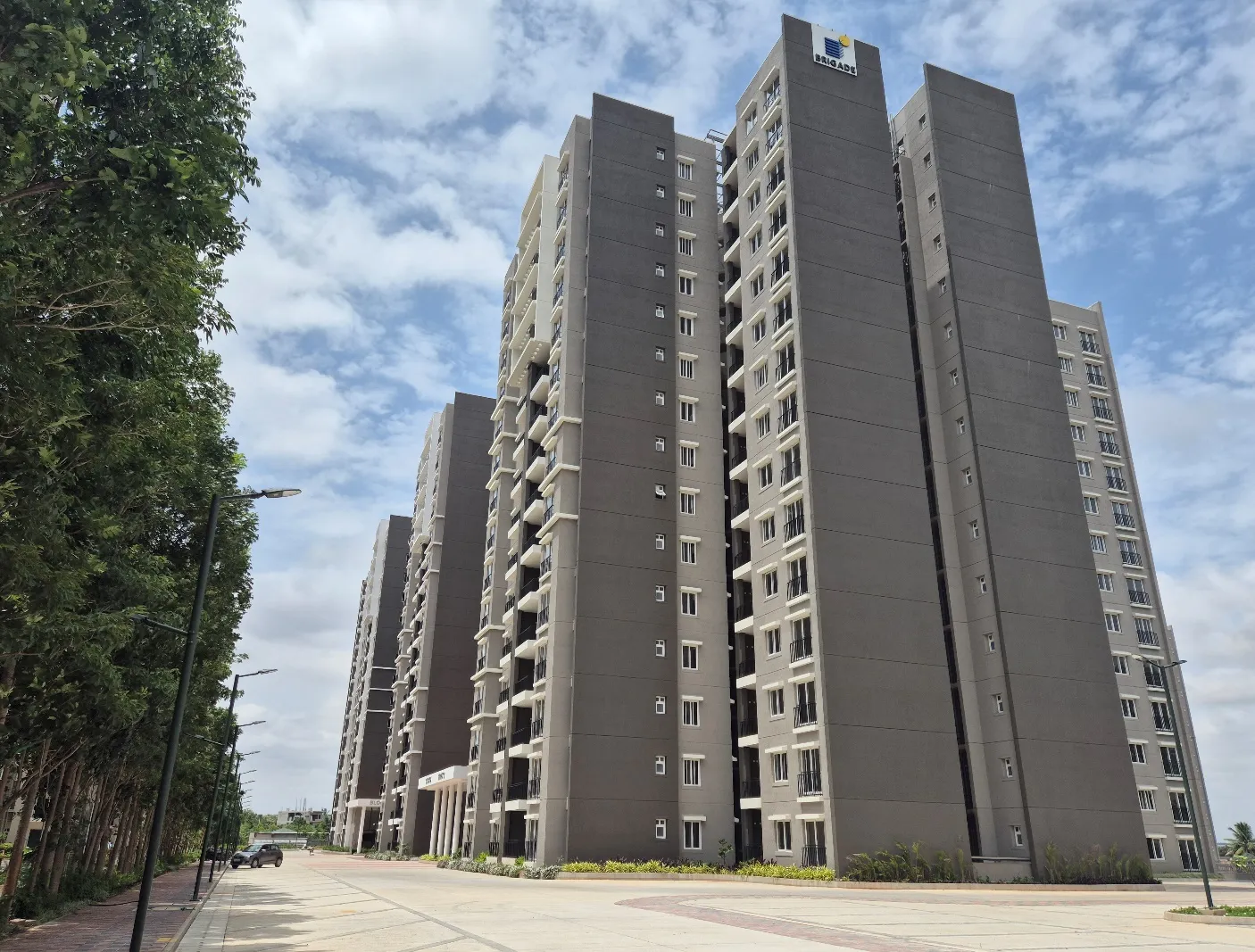

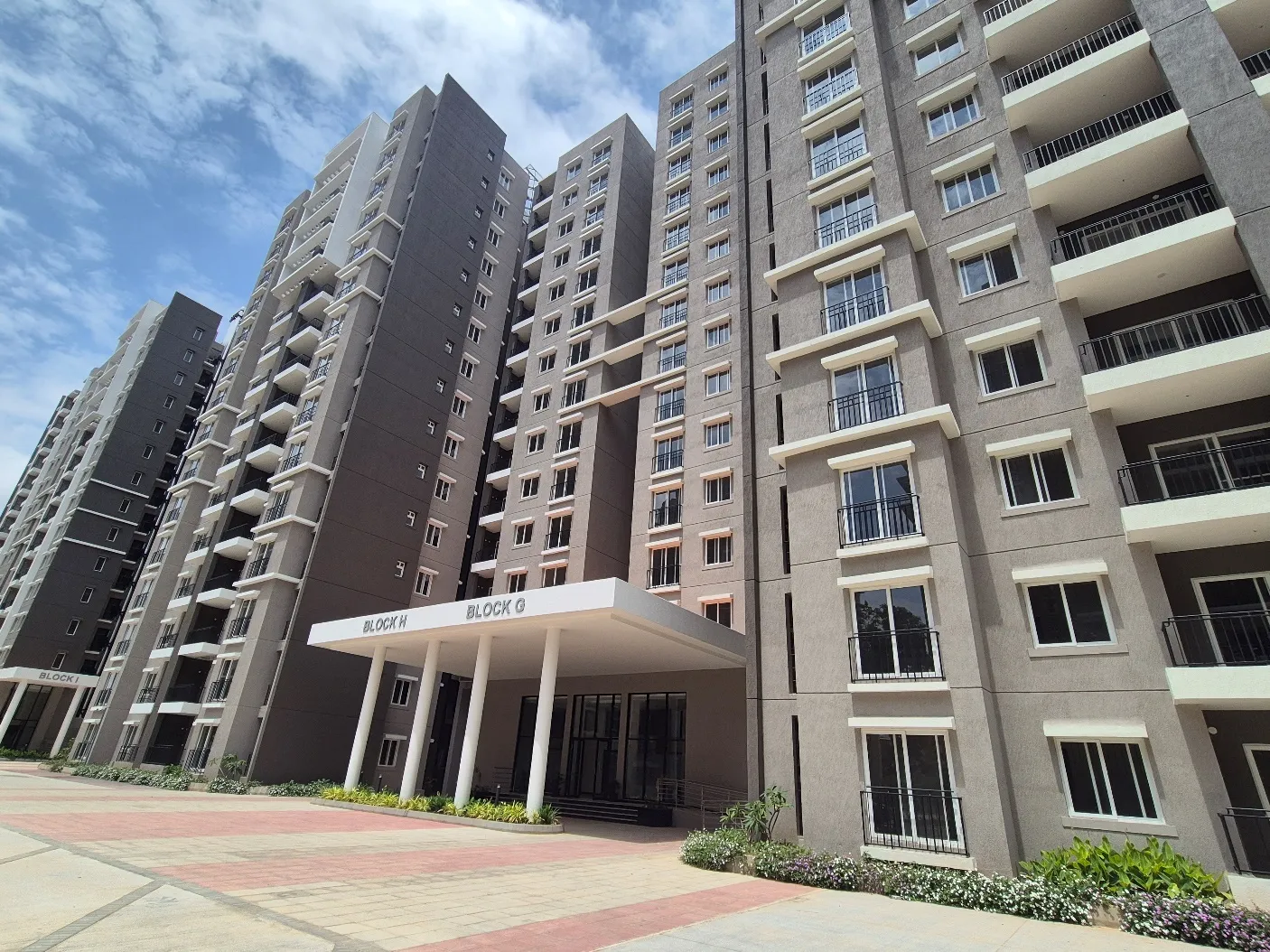

Brigade Orchards IVORY PHASE – 1 ELEVATION TOWER G, H, I - Aug 2026

External plastering - Aug 2026

External plastering - Aug 2026

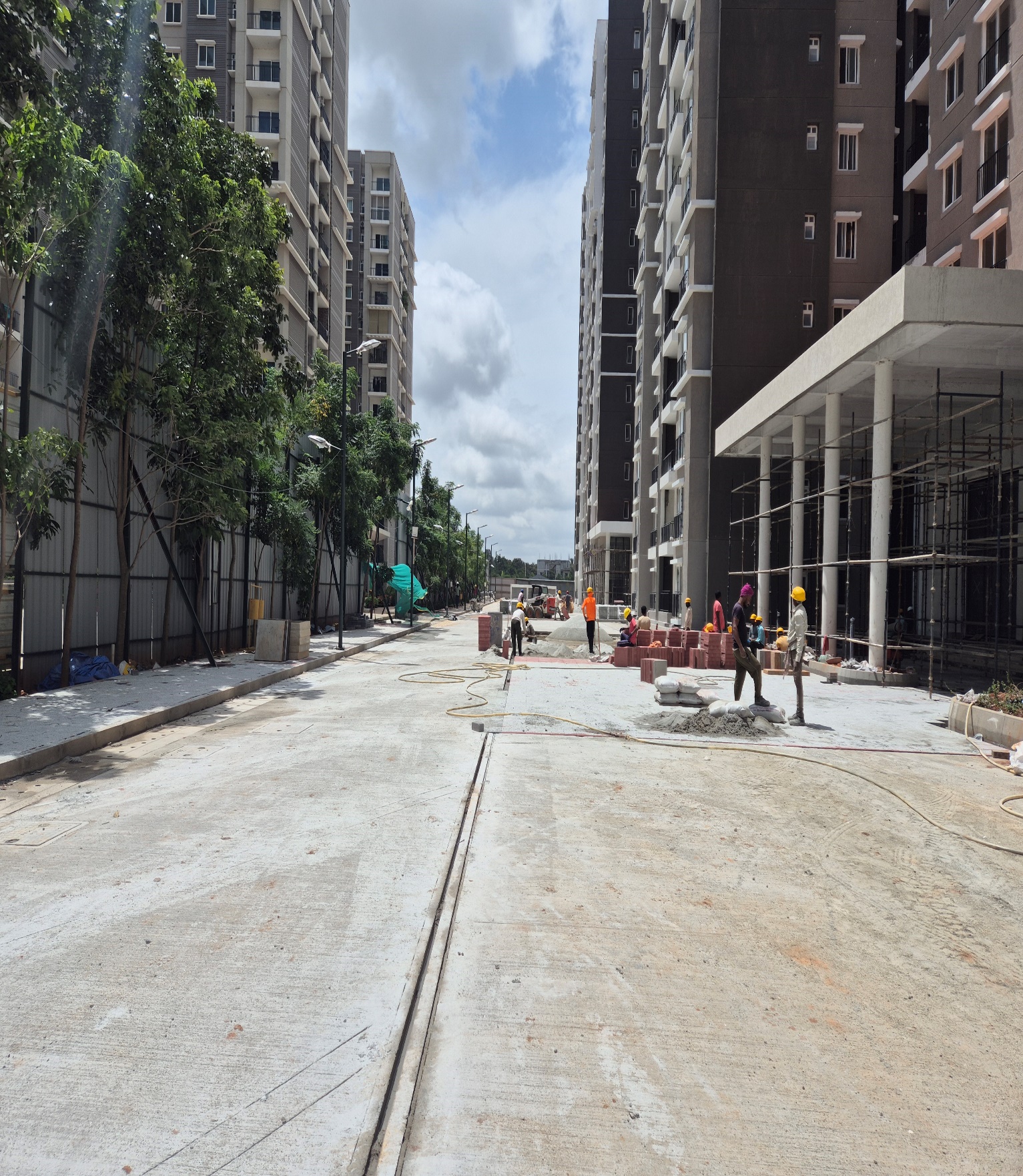

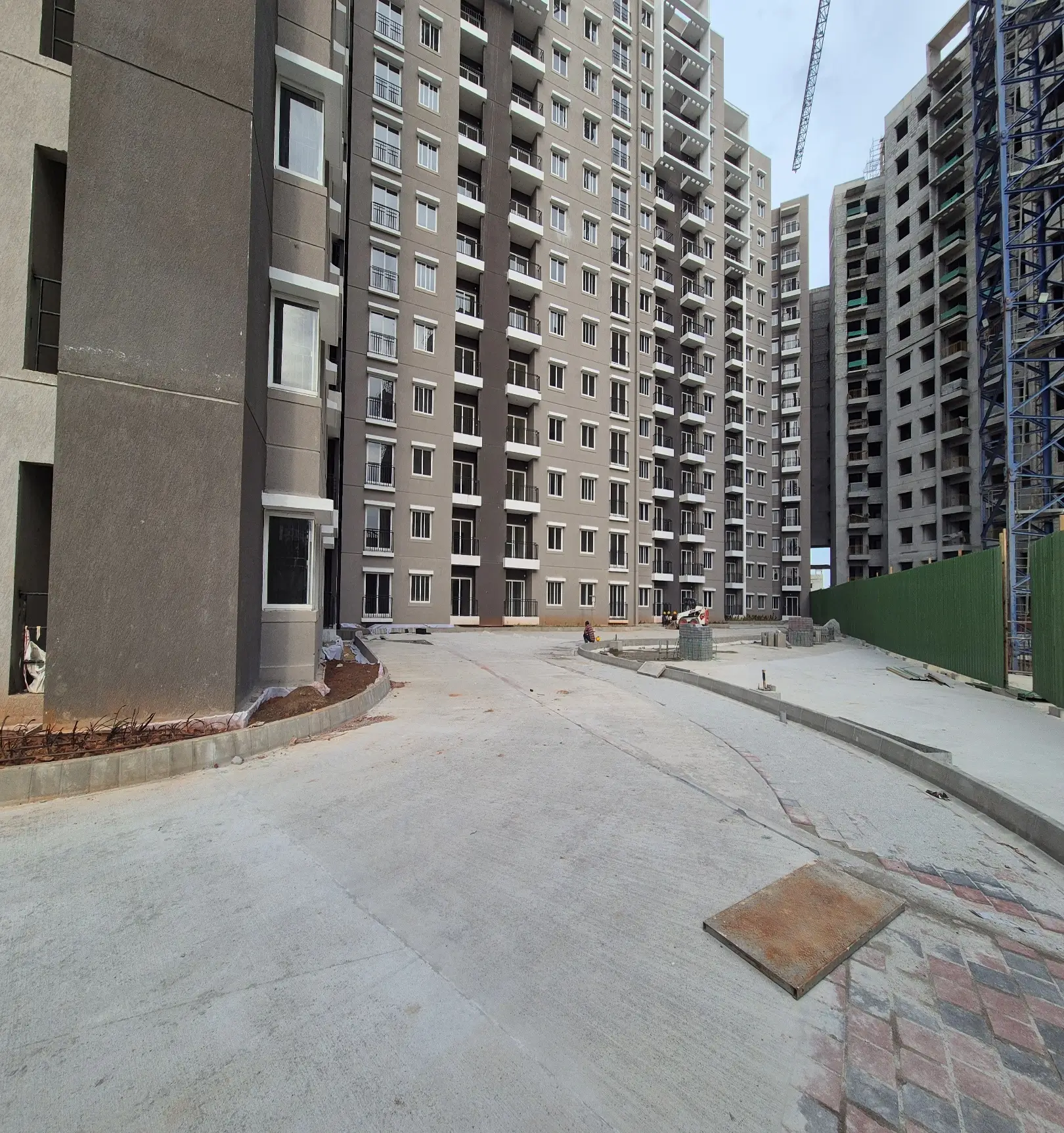

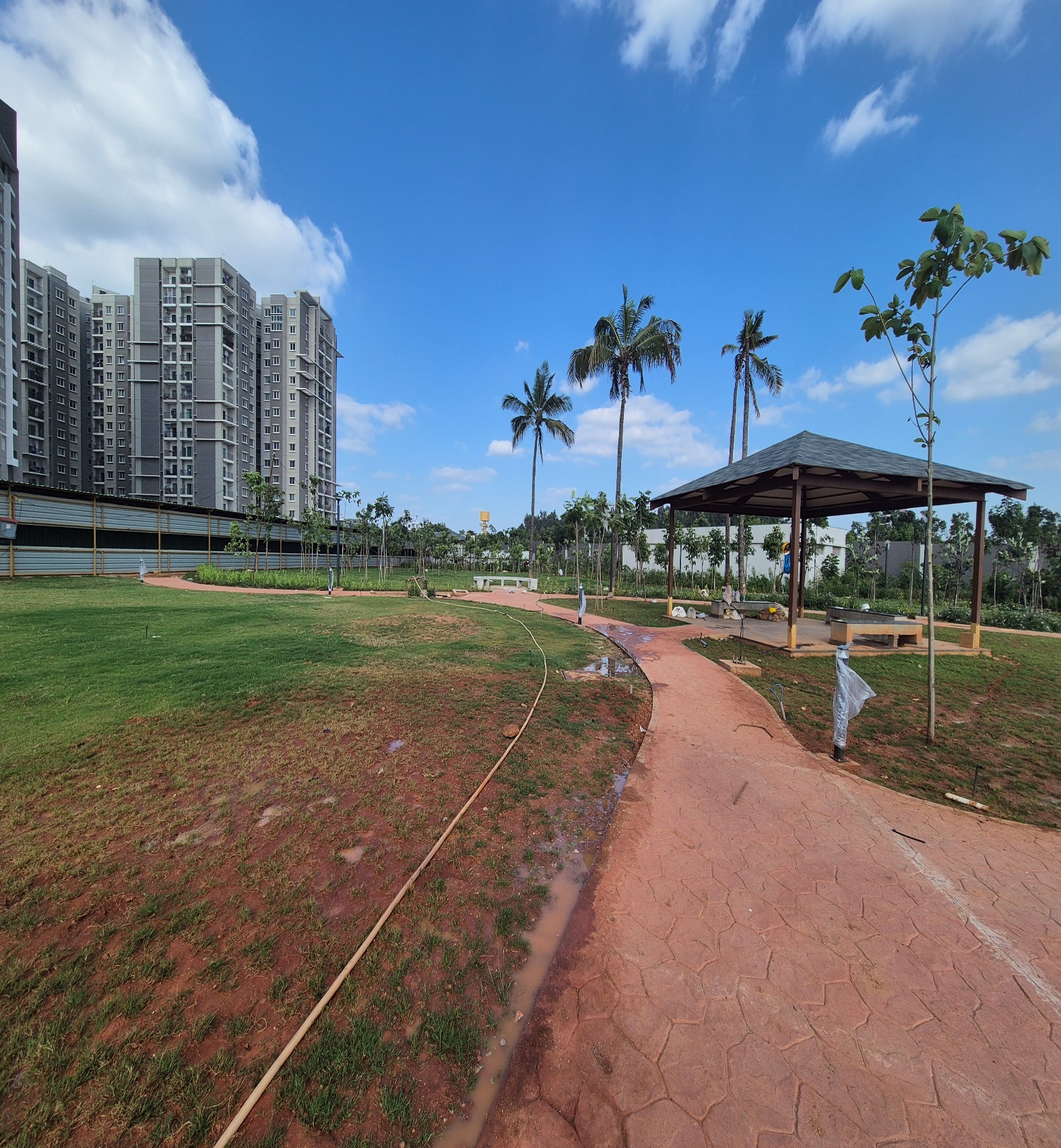

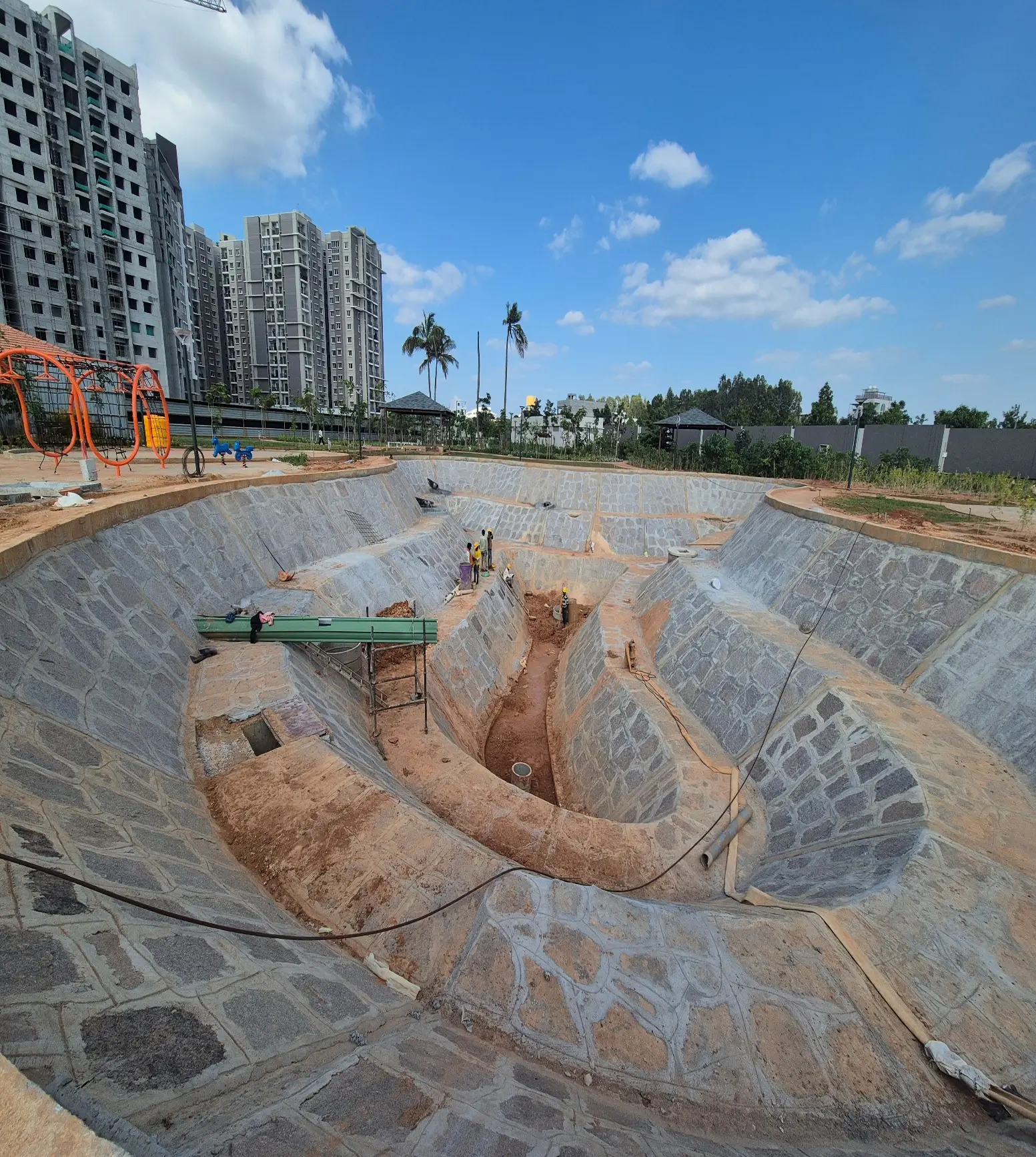

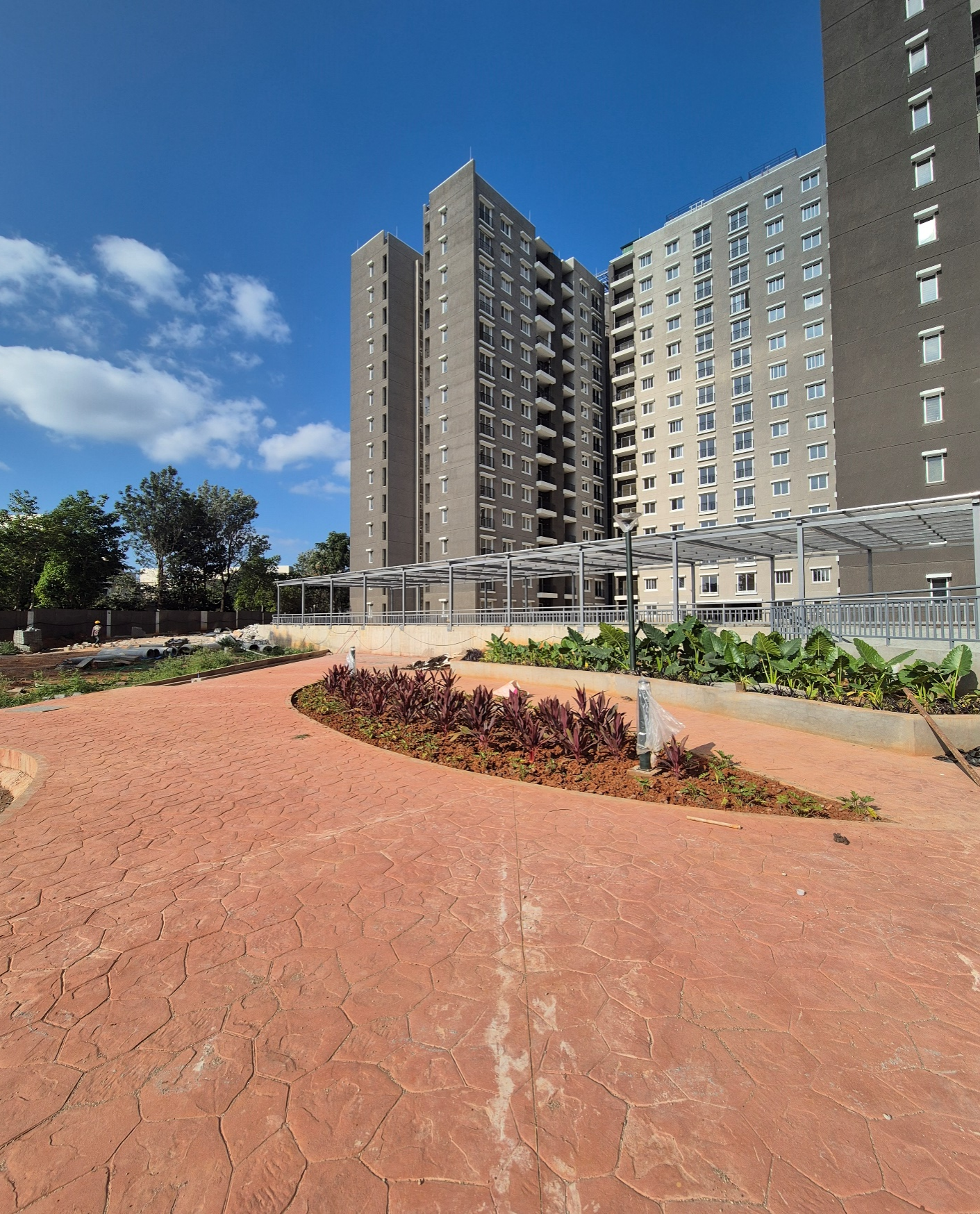

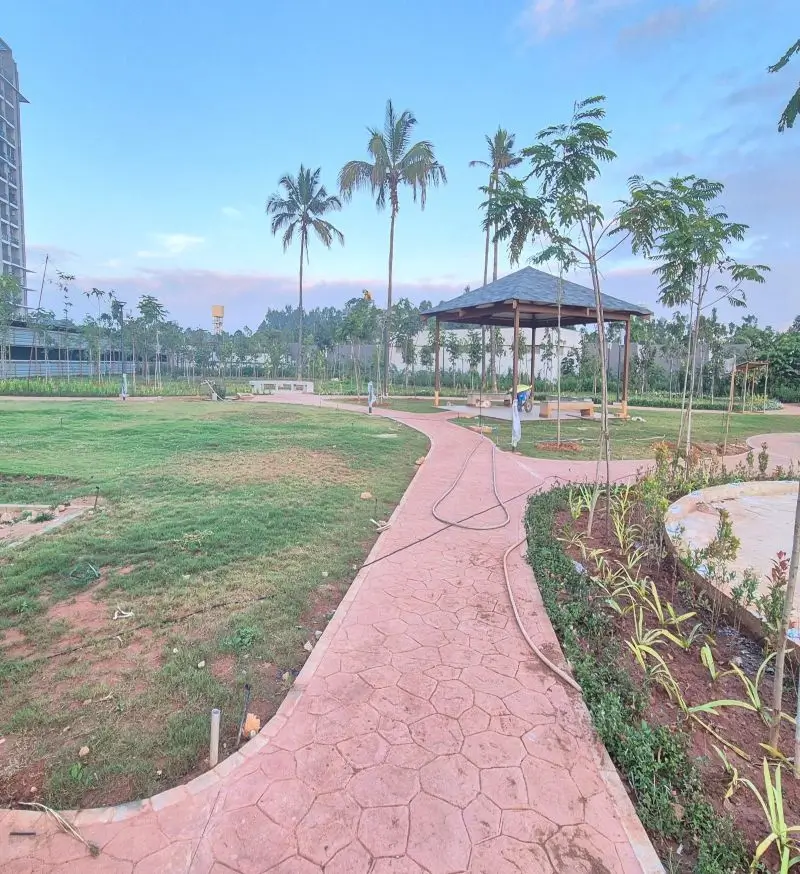

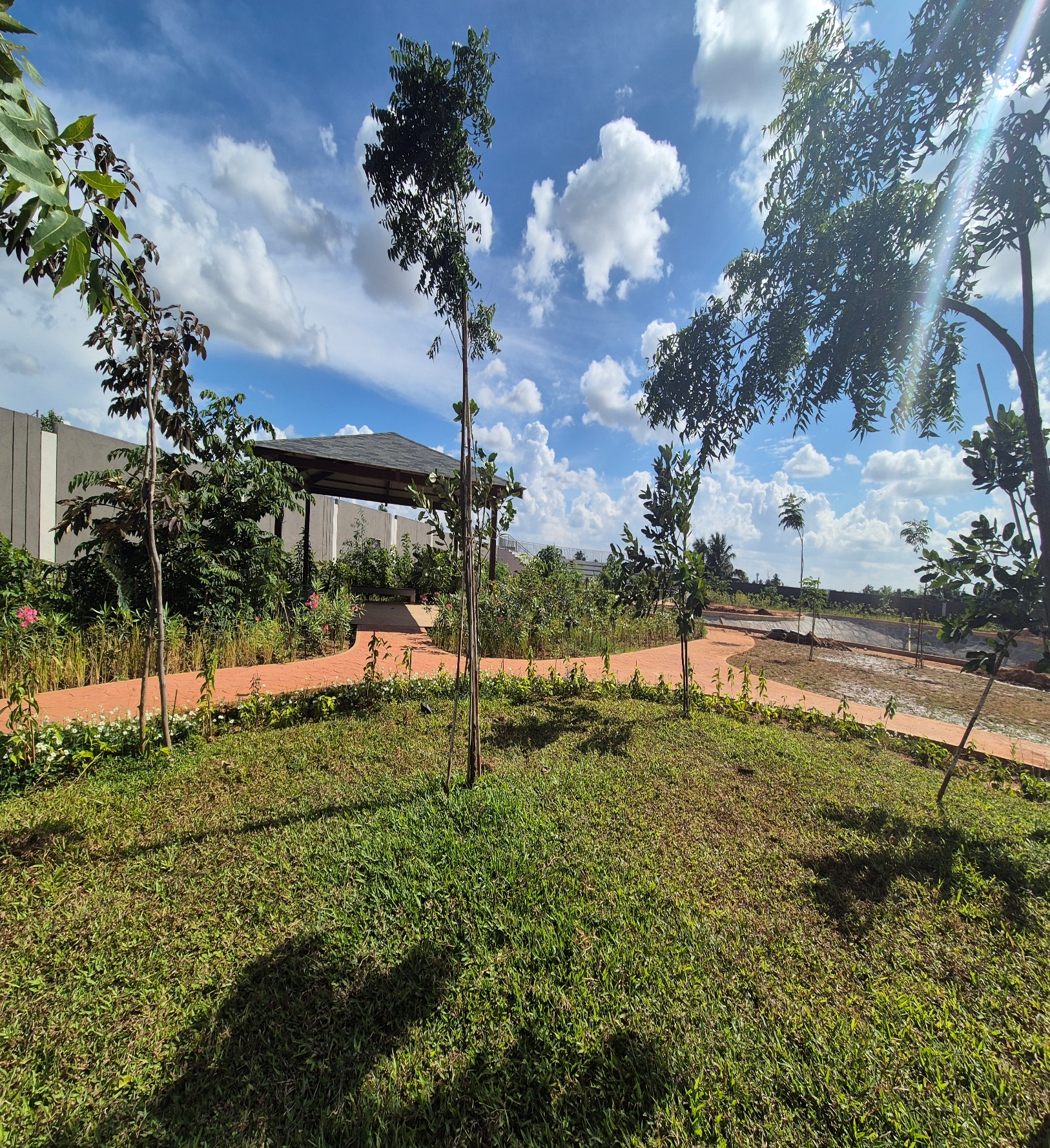

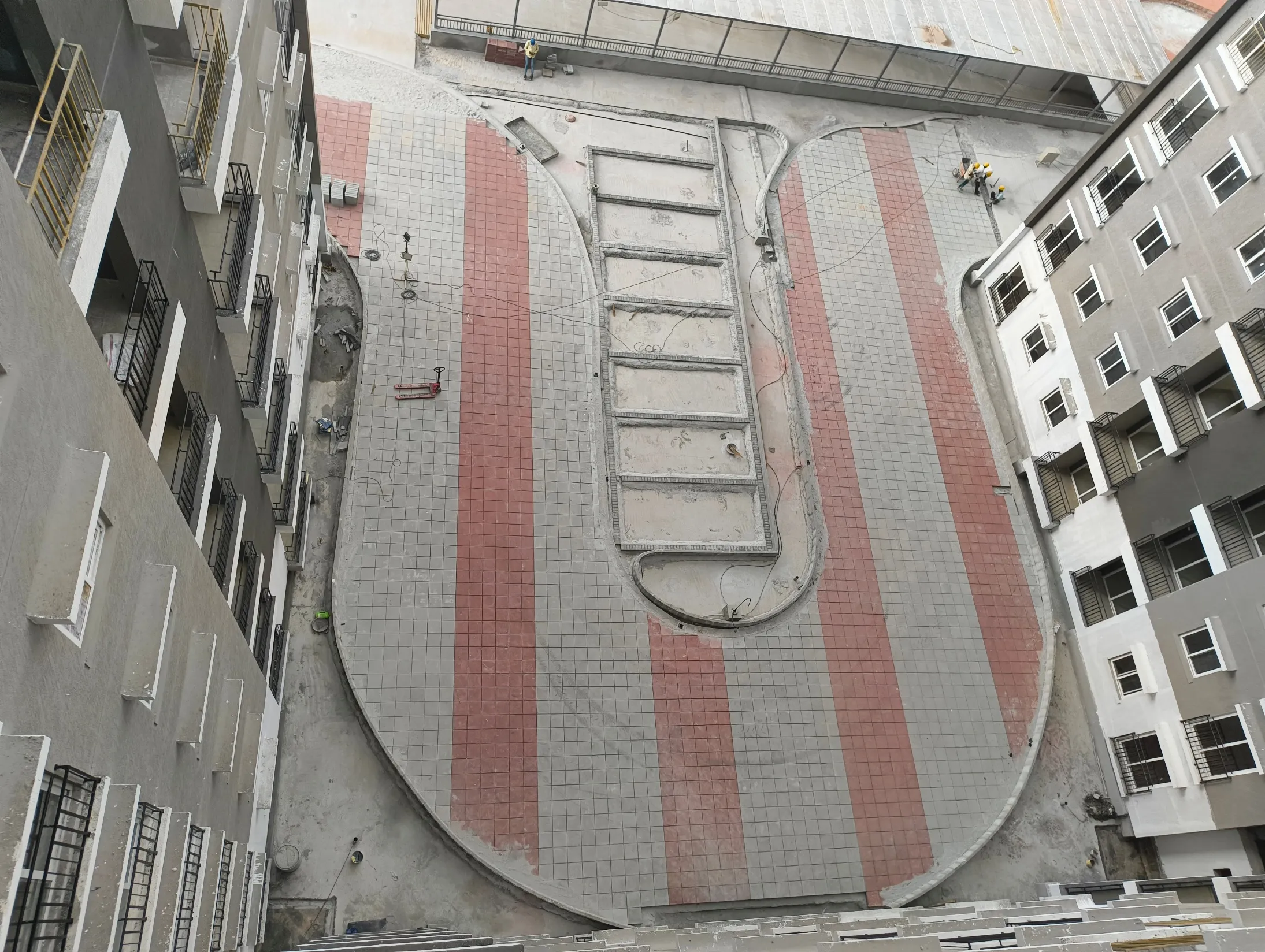

External Development - Aug 2026

External Development - Aug 2026

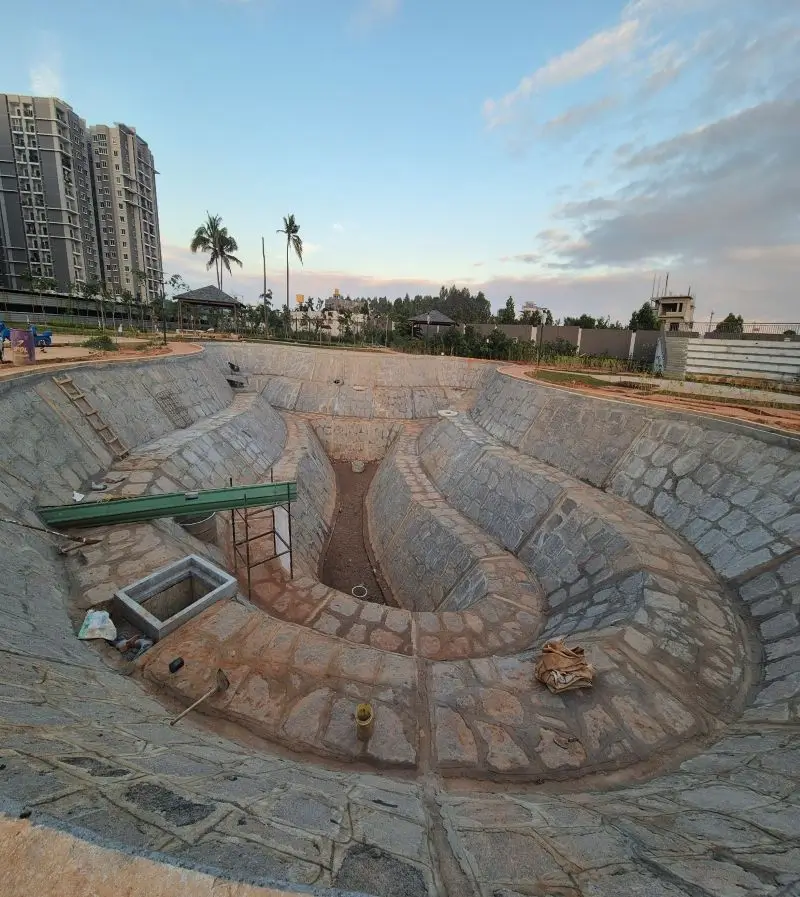

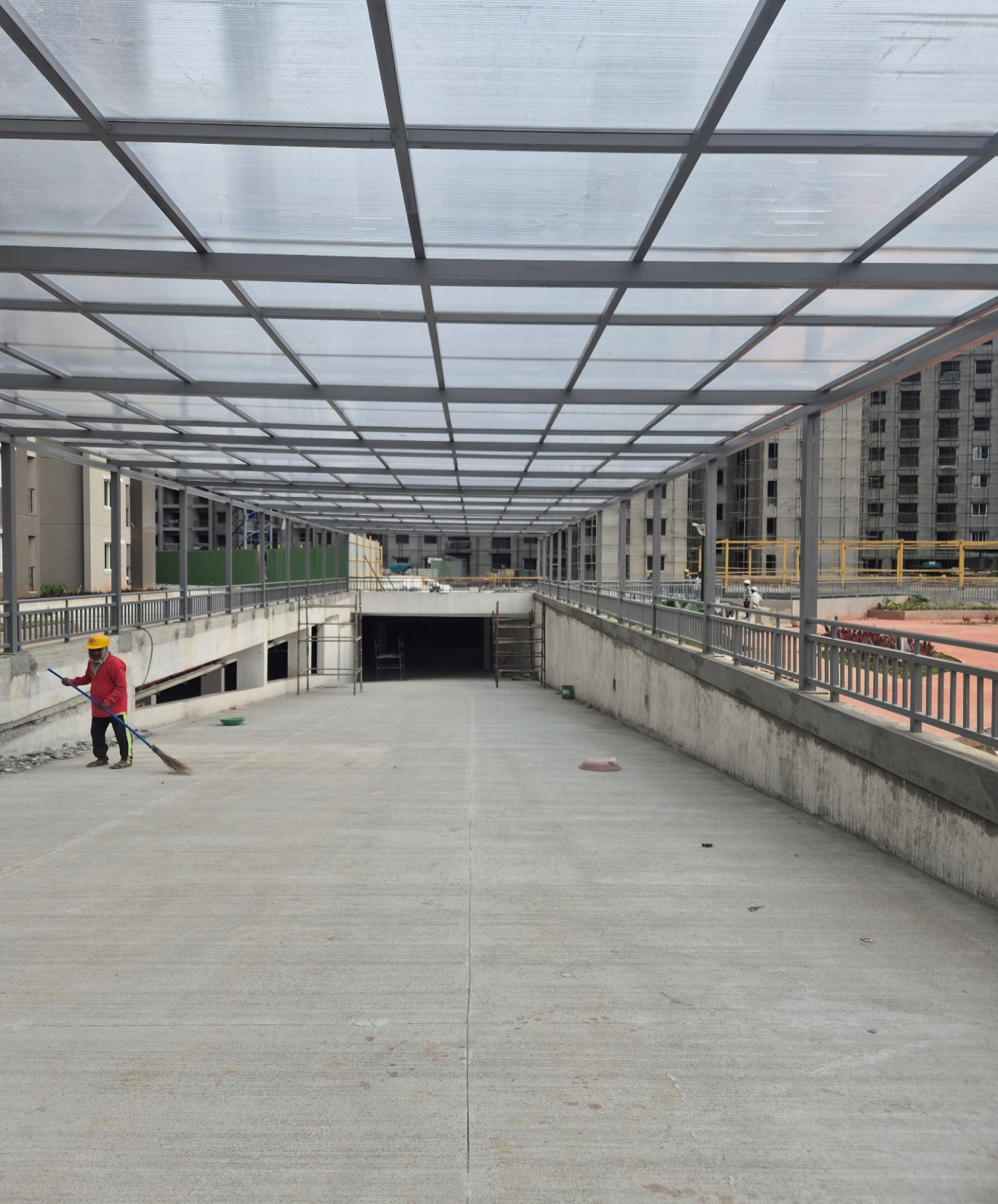

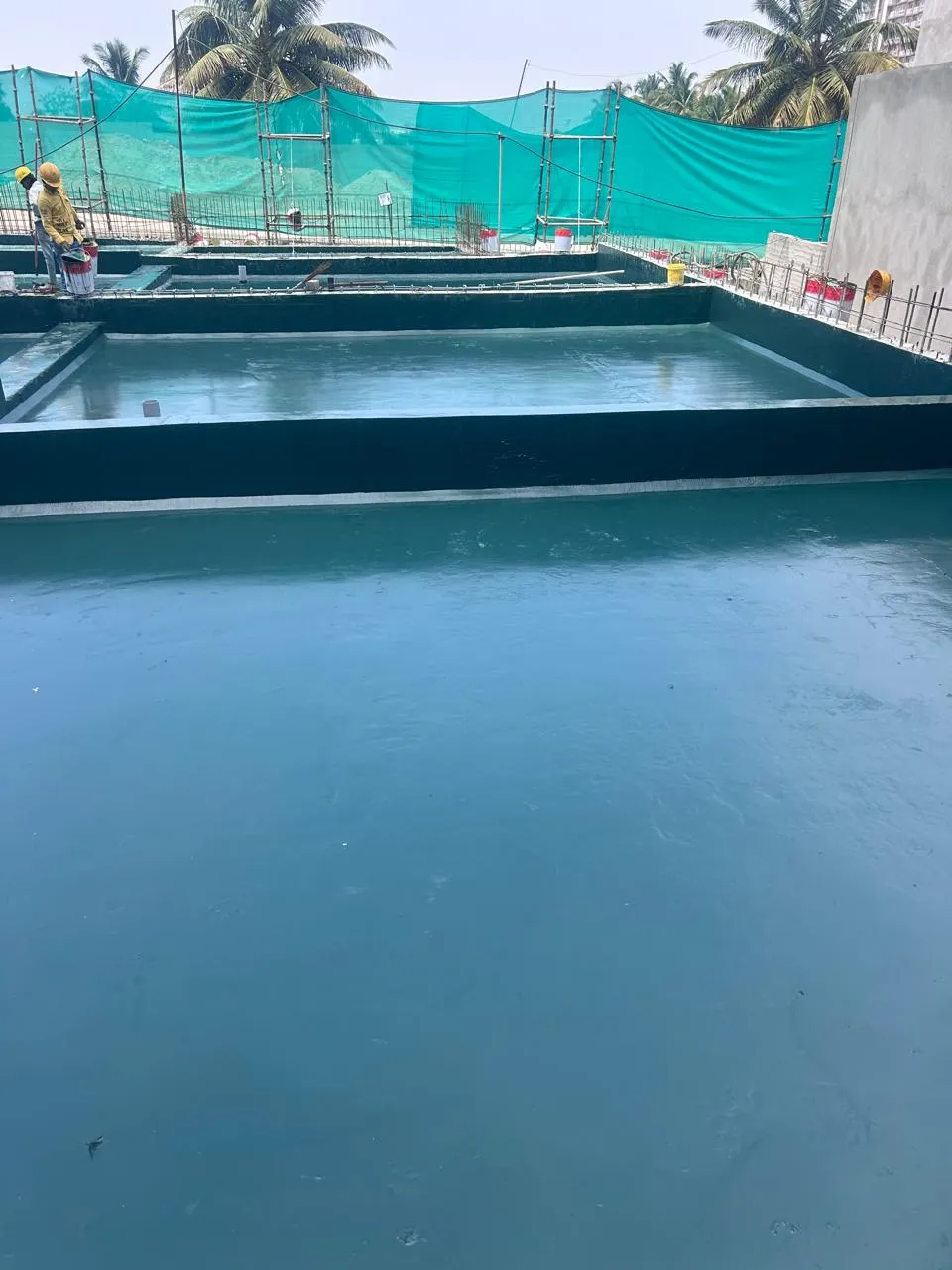

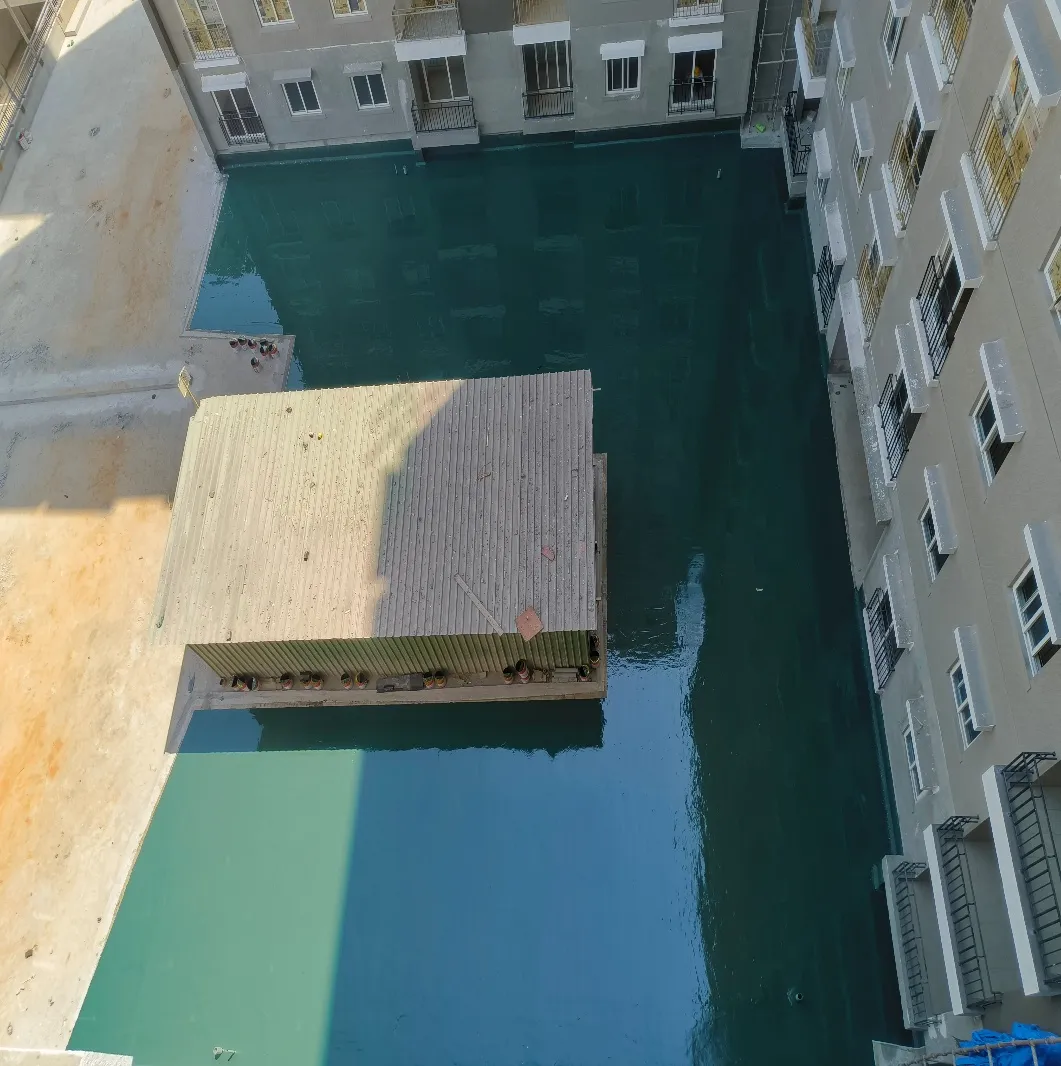

Podium | Waterproofing - Aug 2026

Podium | Waterproofing - Aug 2026

Flooring - Aug 2026

Flooring - Aug 2026

Flooring - Aug 2026

Flooring - Aug 2026

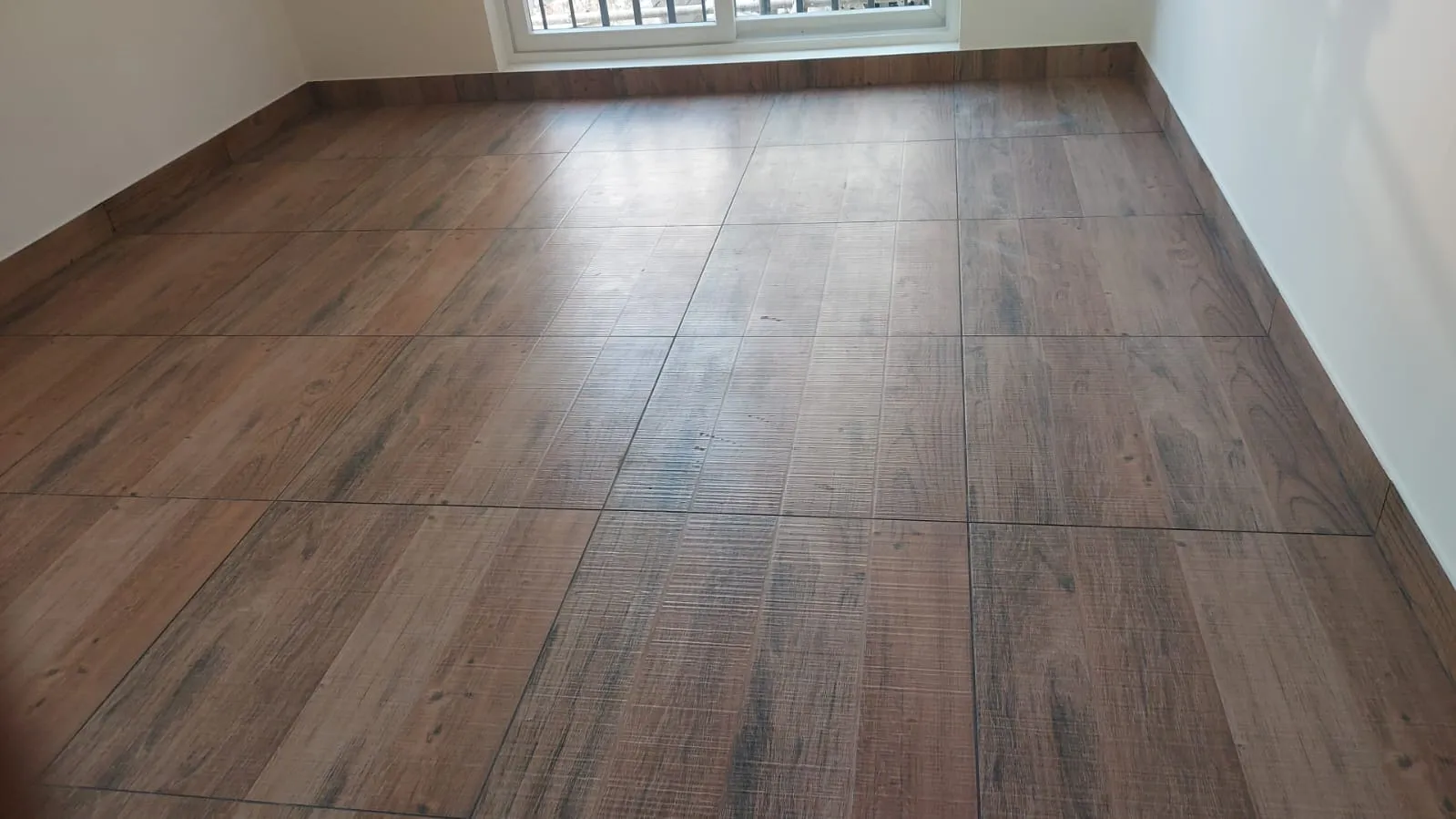

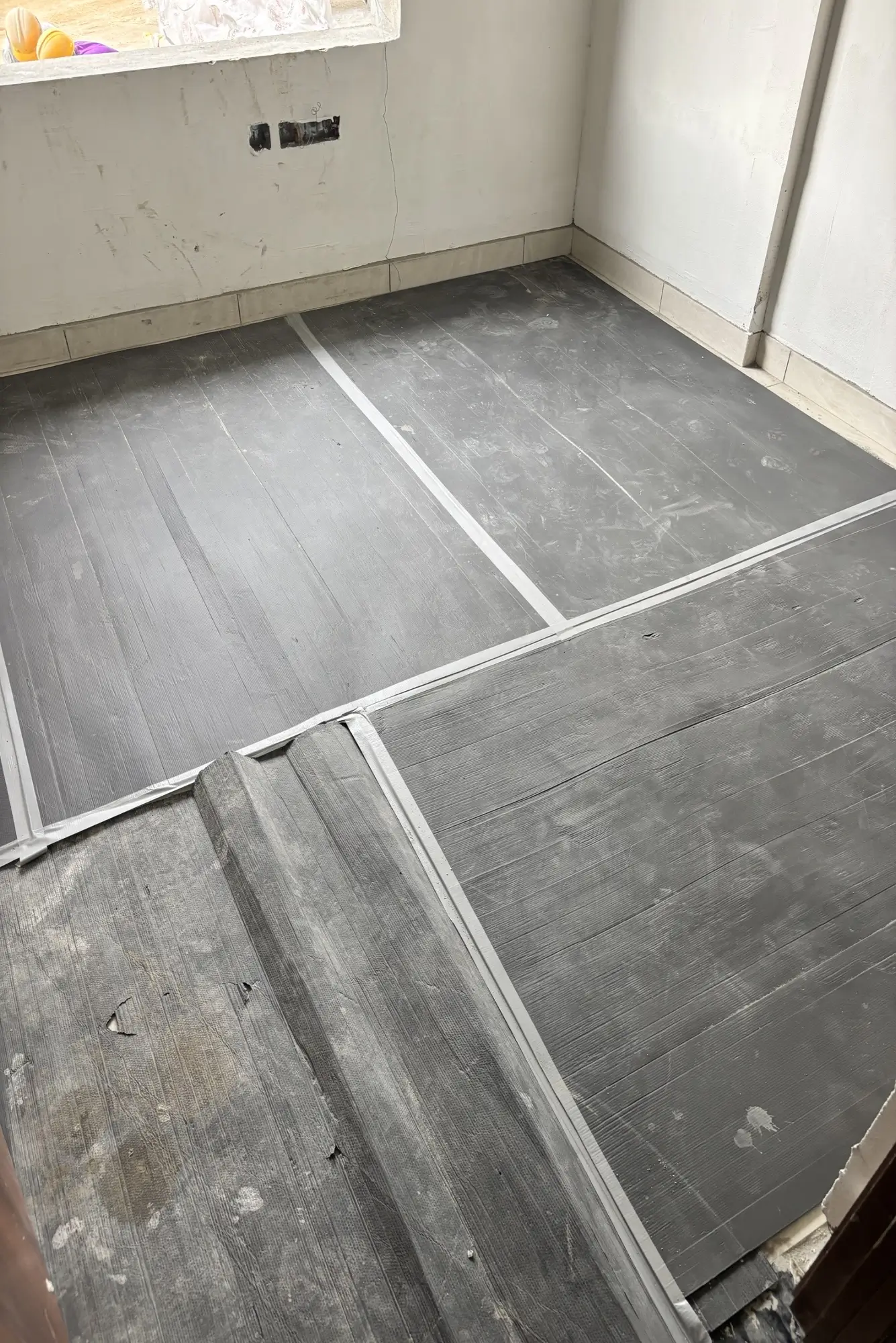

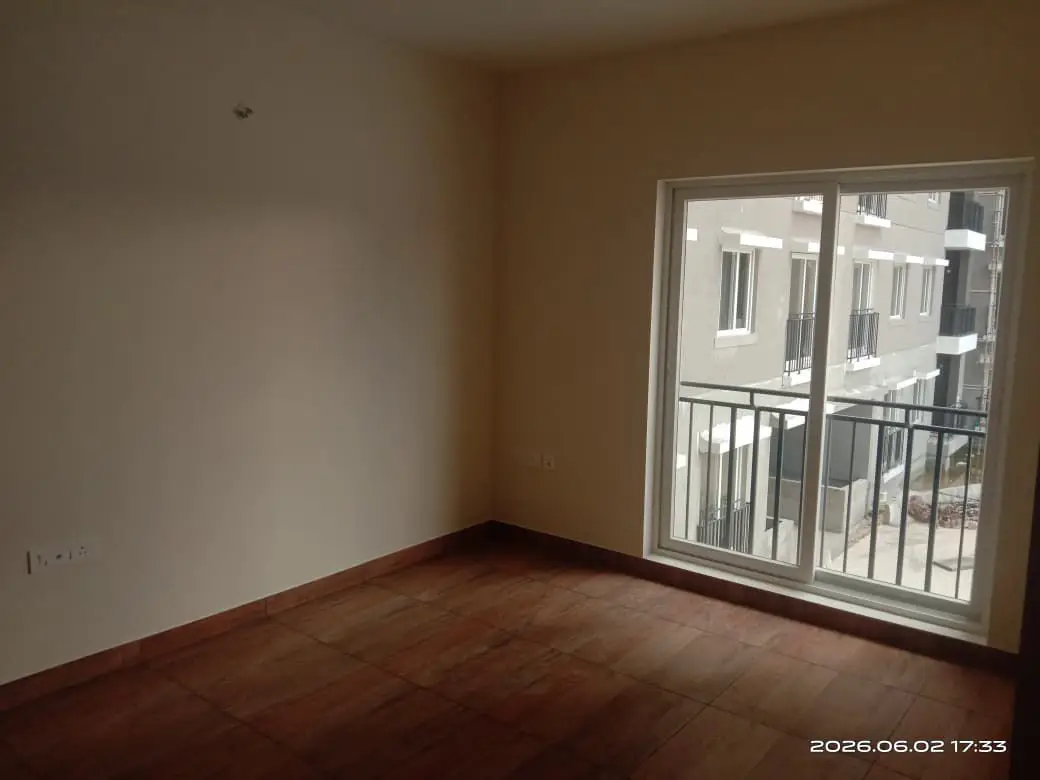

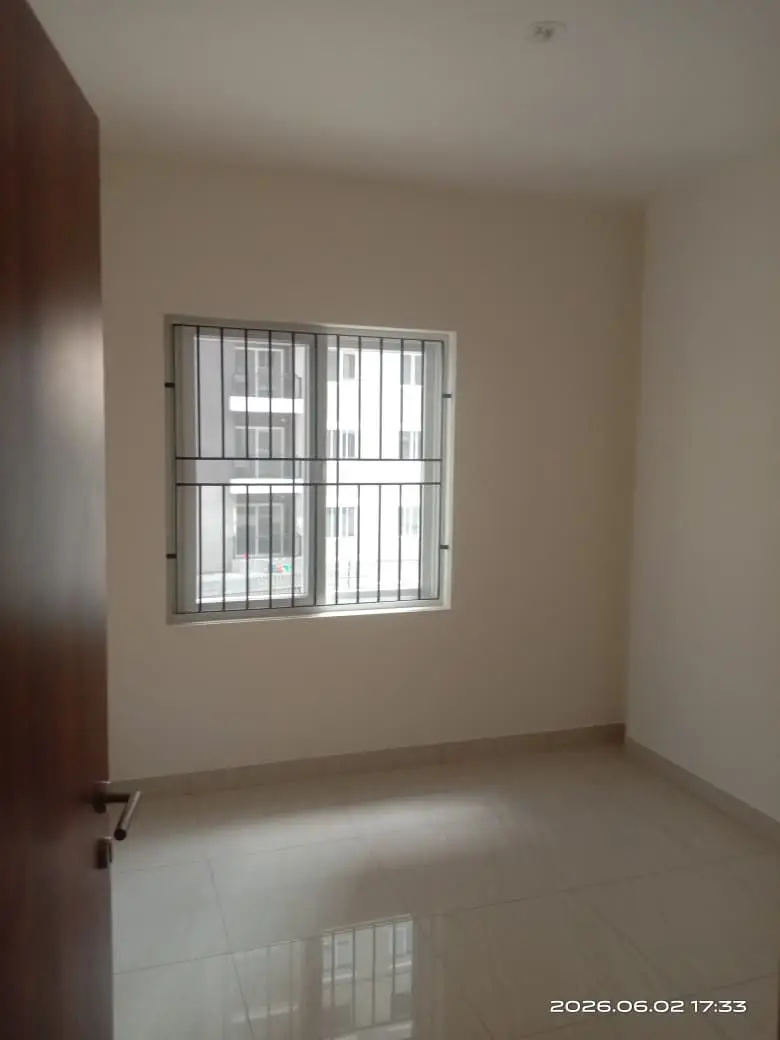

JKL Blocks | Flooring - Aug 2026

JKL Blocks | Flooring - Aug 2026

JKL Blocks | Flooring - Aug 2026

JKL Blocks | Flooring - Aug 2026

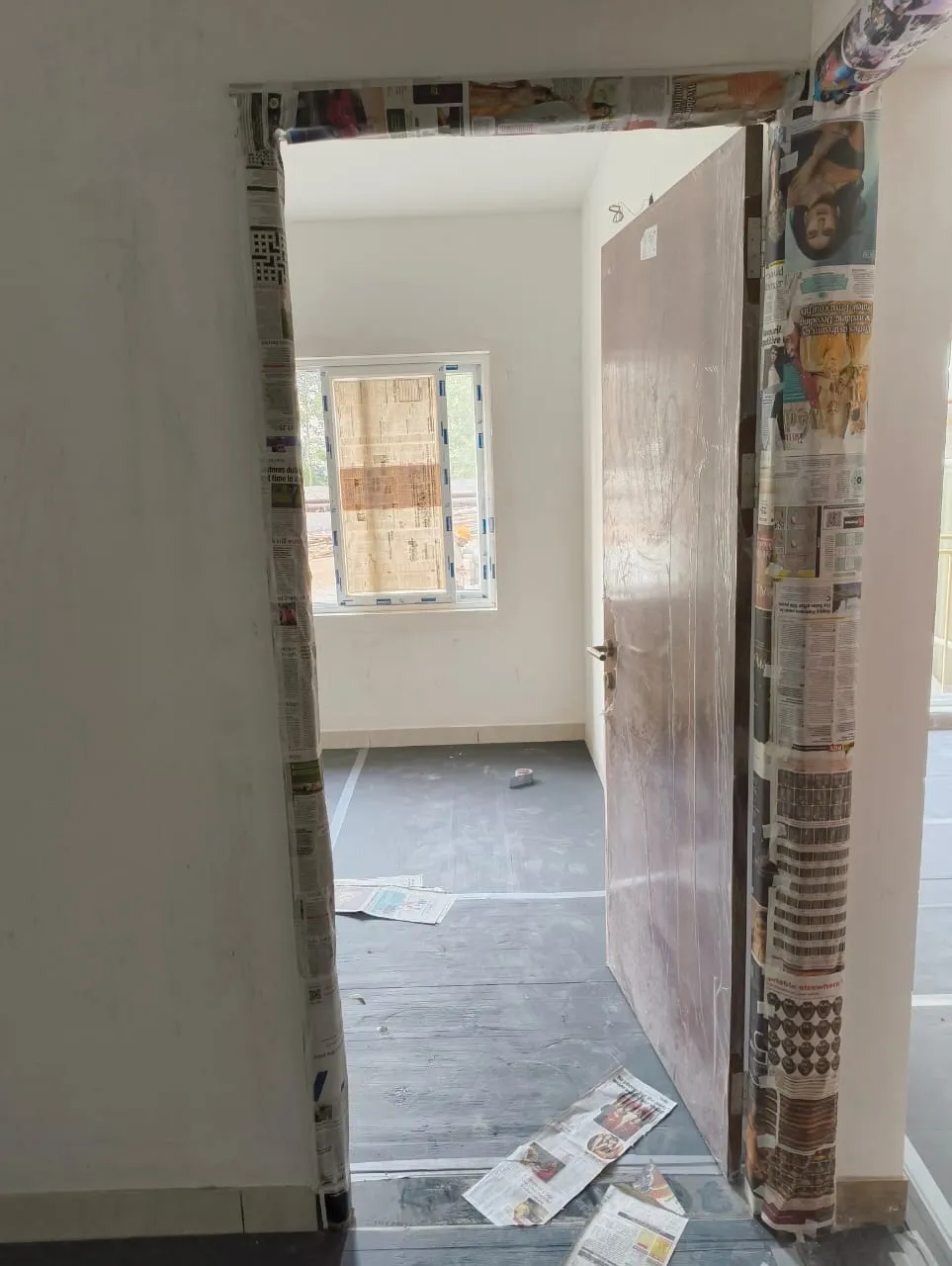

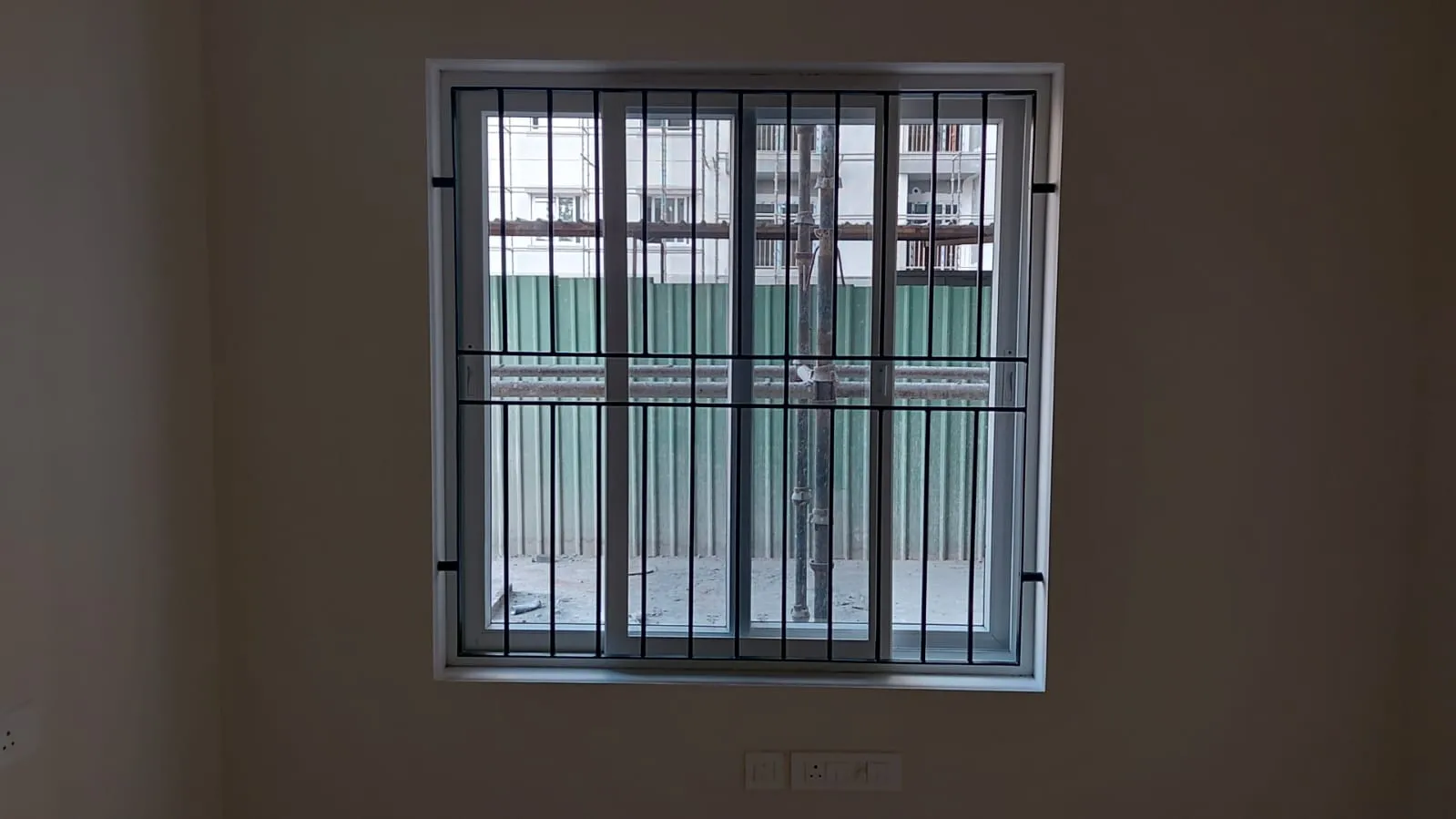

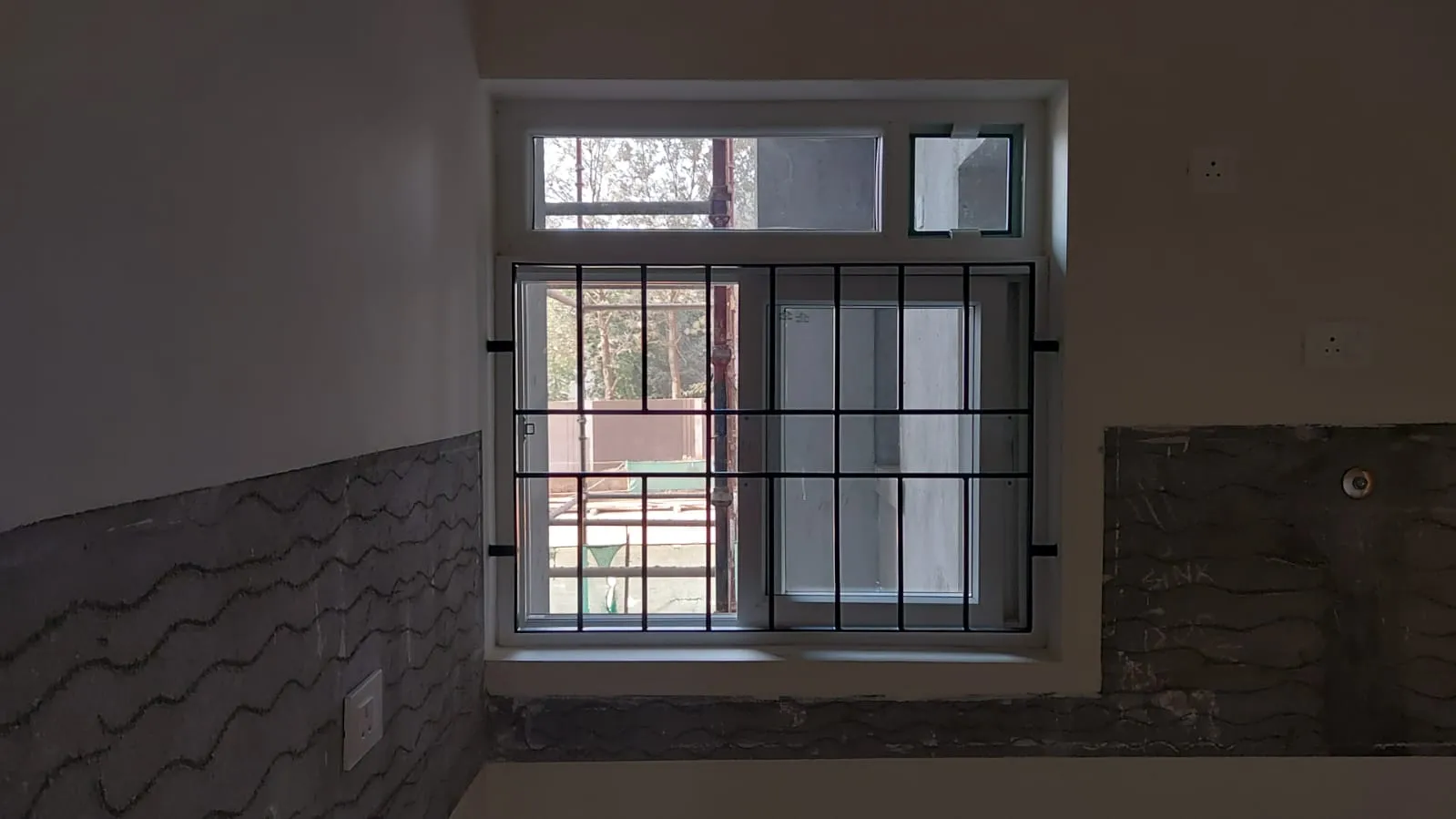

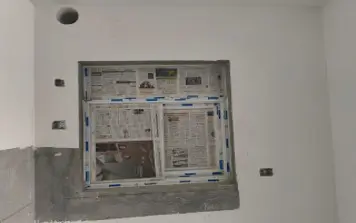

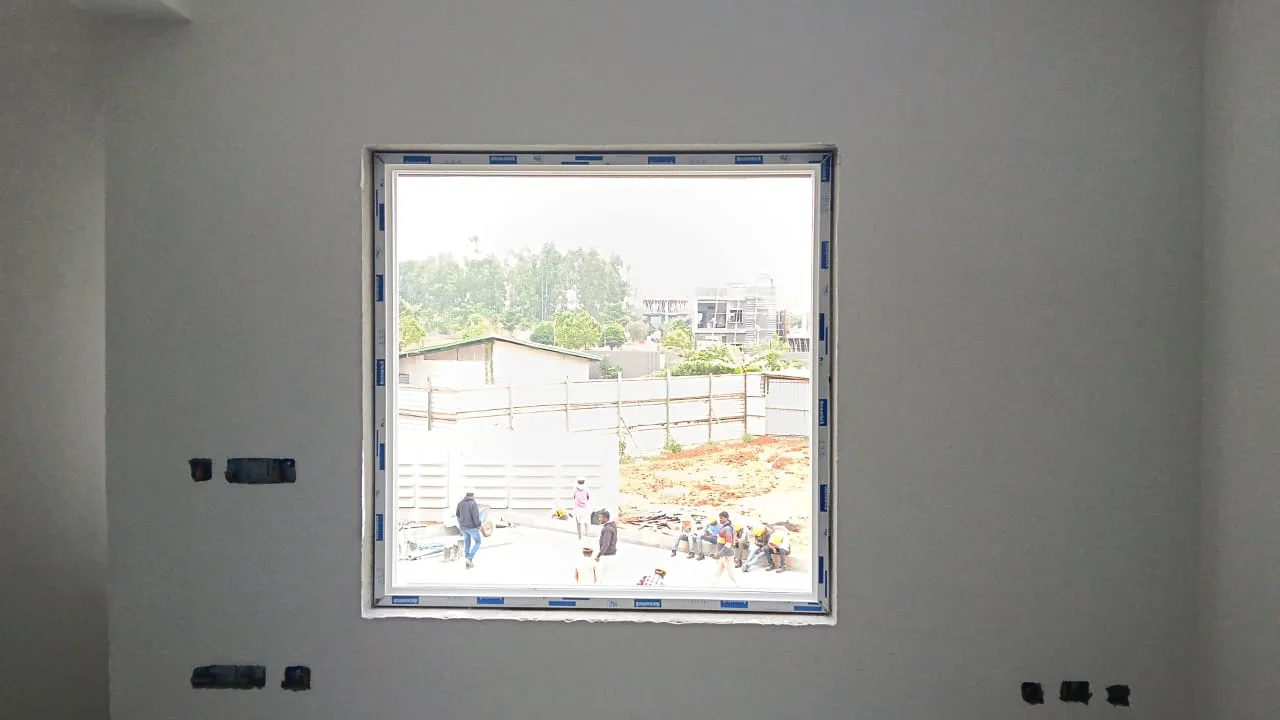

JKL Blocks |Fixing of windows - Aug 2026

JKL Blocks |Fixing of windows - Aug 2026

JKL Blocks |Fixing of windows - Aug 2026

JKL Blocks |Fixing of windows - Aug 2026

JKL Blocks | Fixing of Doors Fixing Completed - Aug 2026

JKL Blocks | Fixing of Doors Fixing Completed - Aug 2026

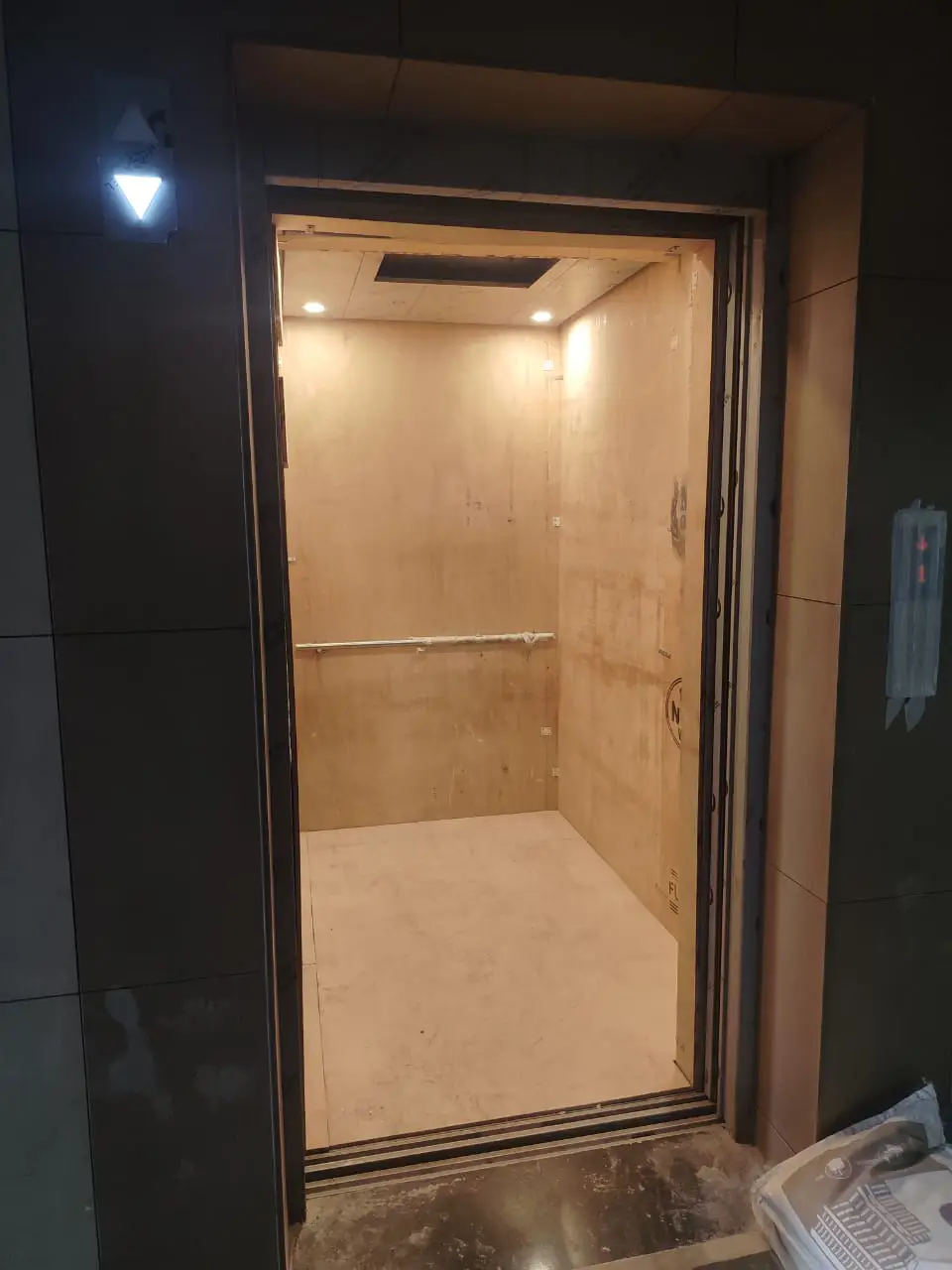

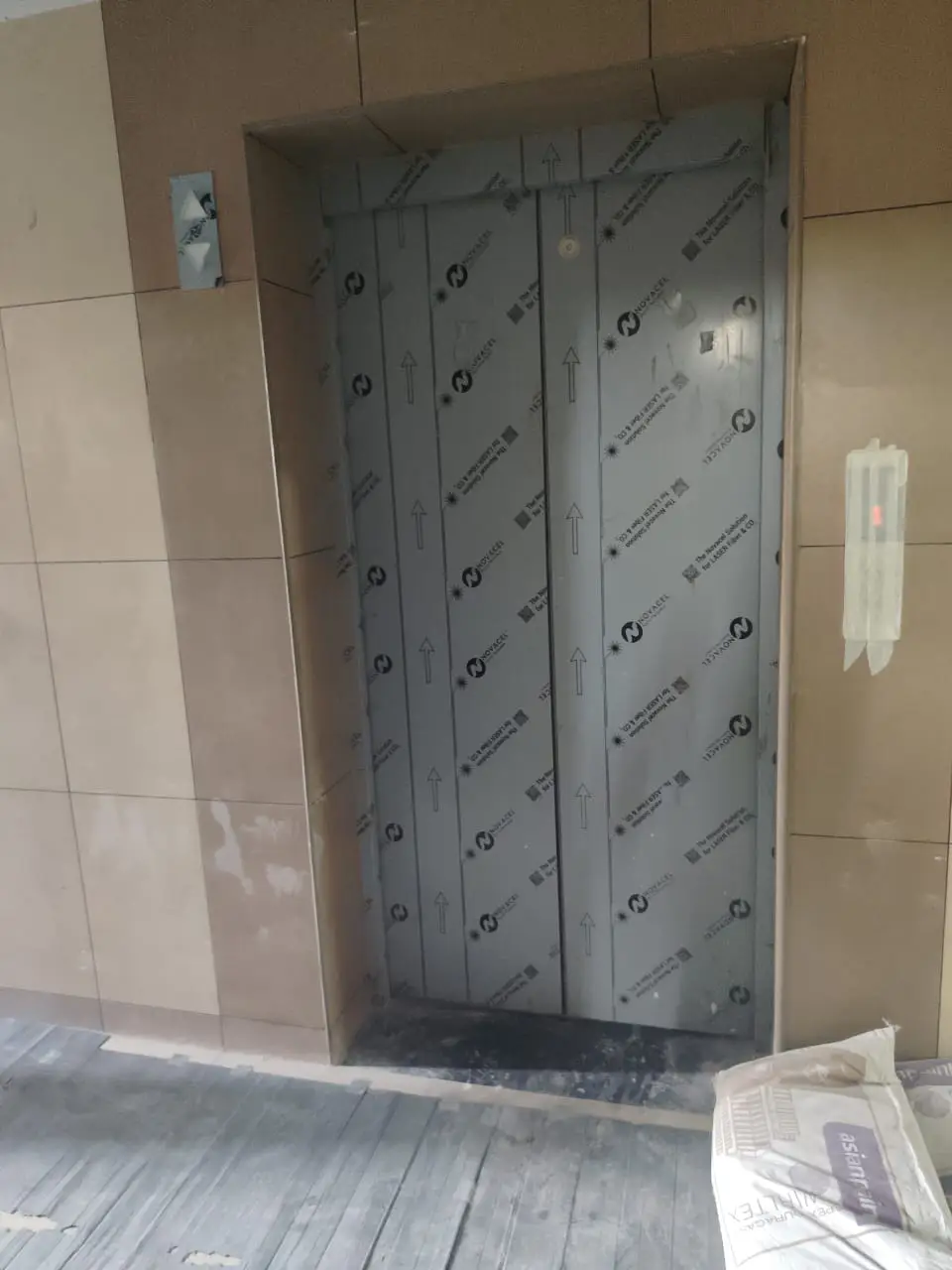

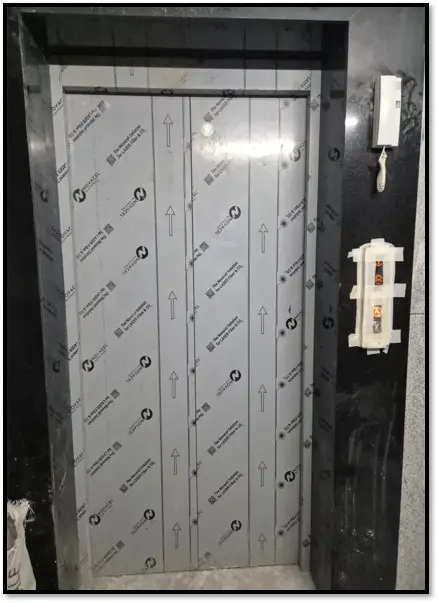

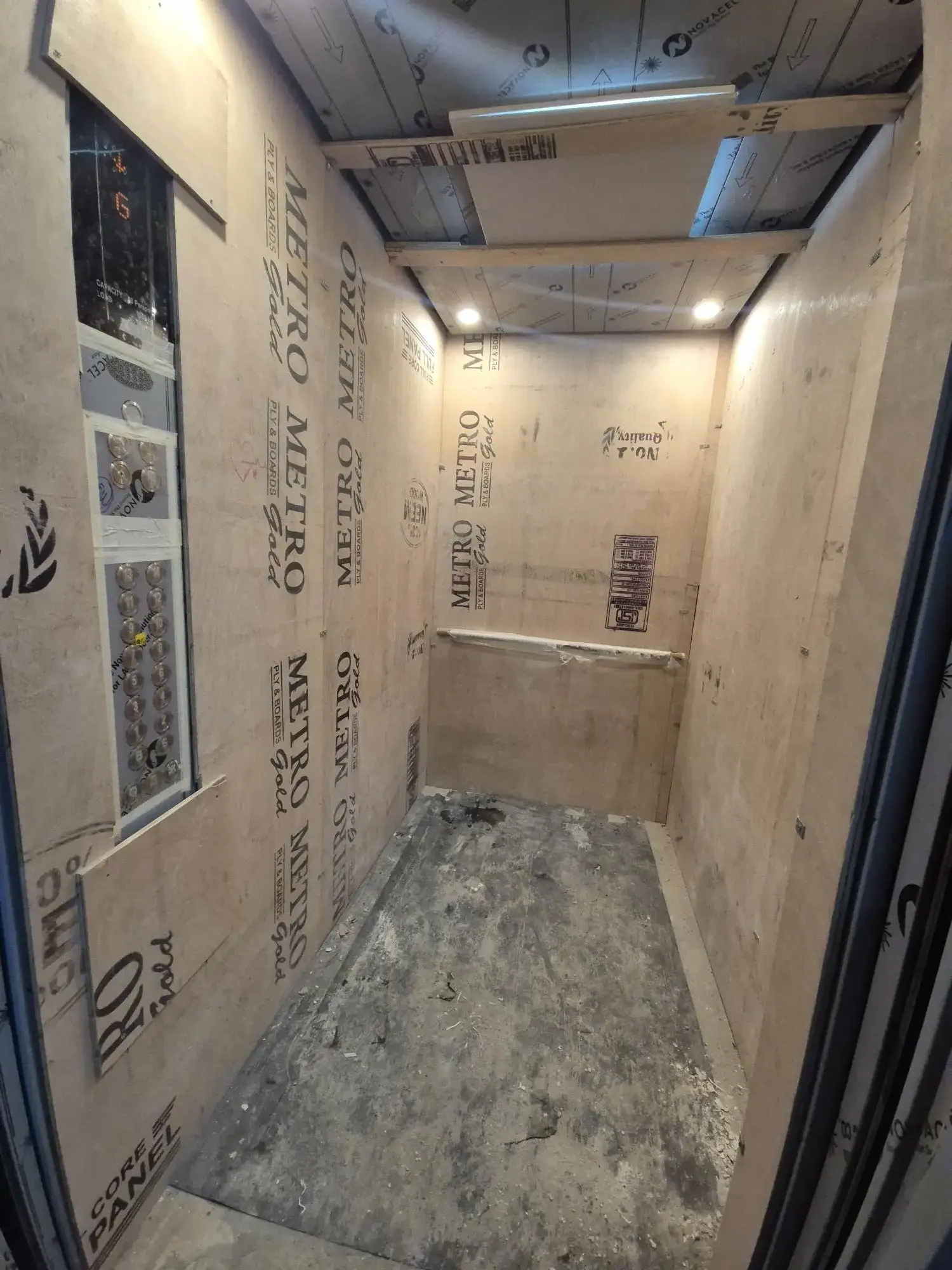

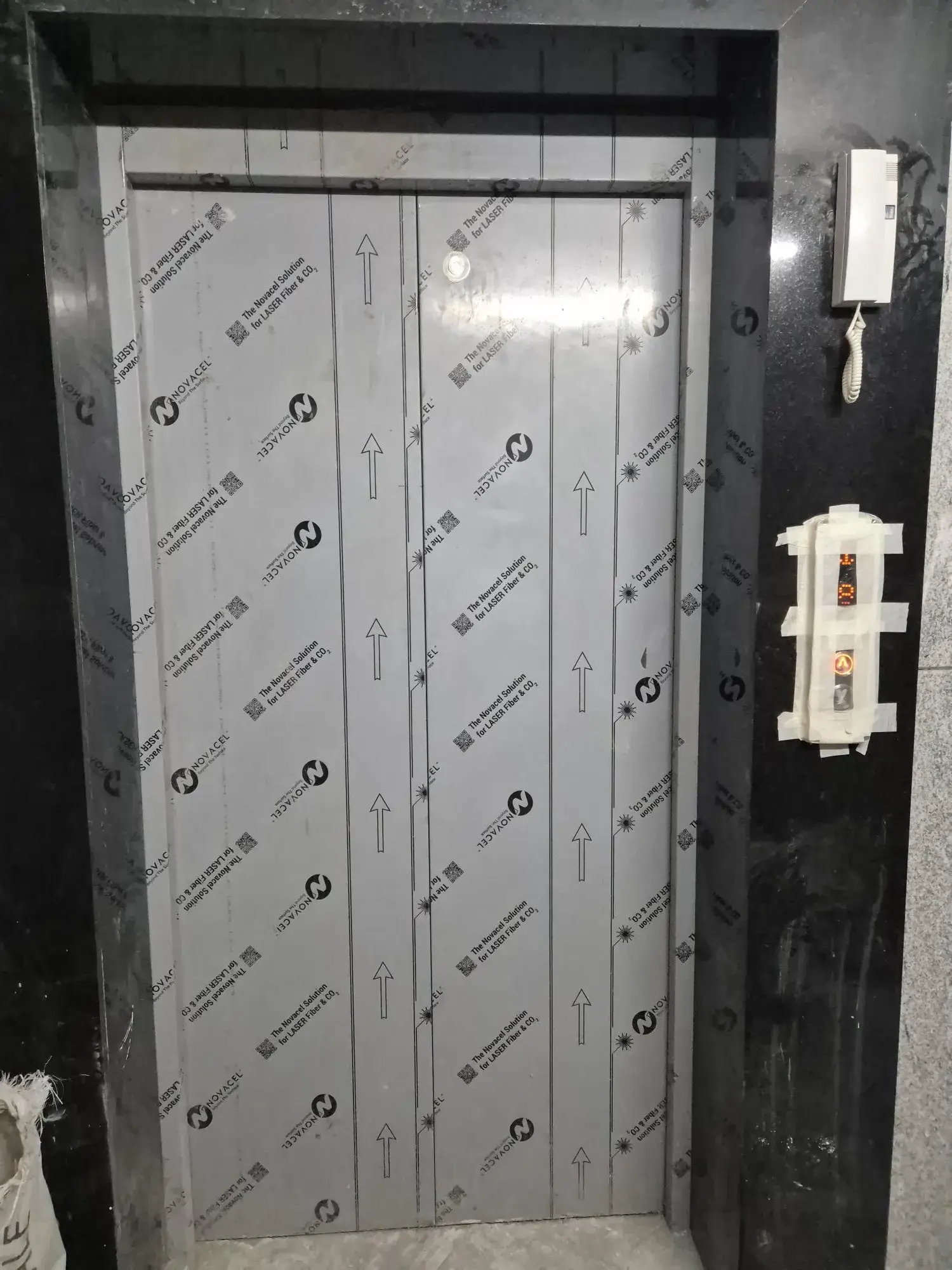

JKL Blocks | Lift Installation - Aug 2026

JKL Blocks | Lift Installation - Aug 2026

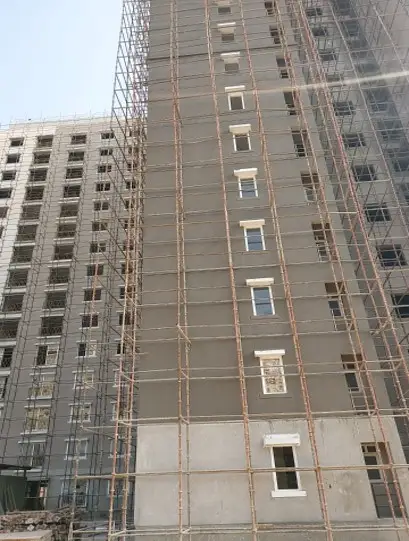

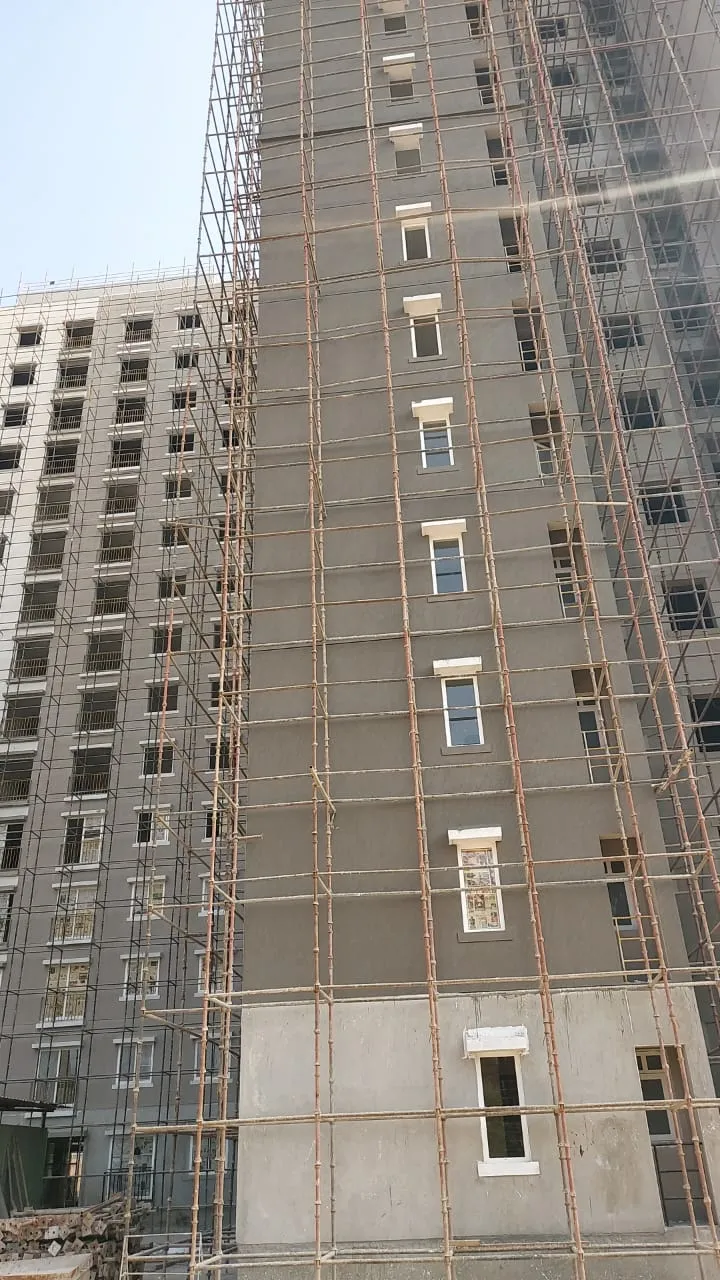

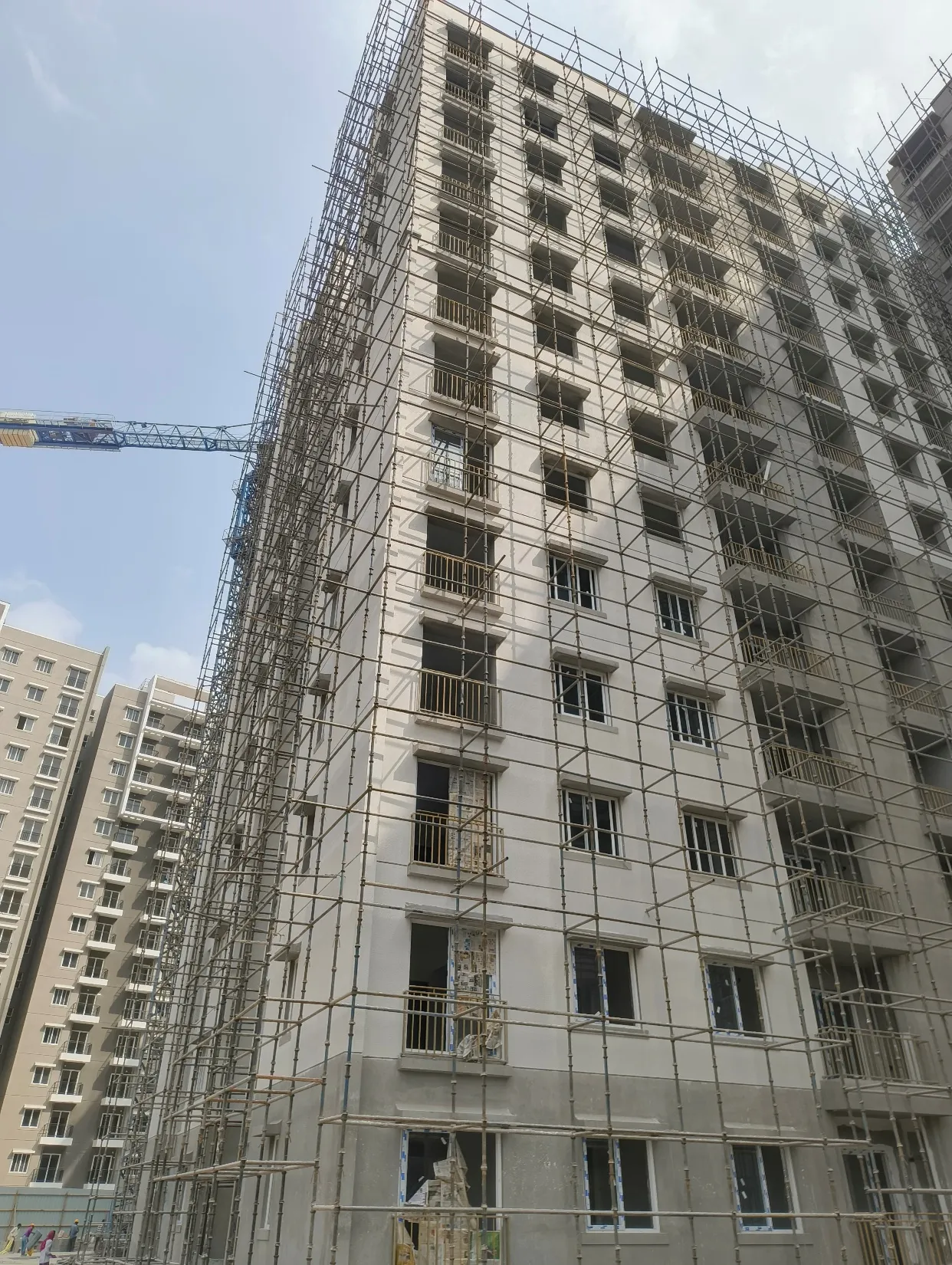

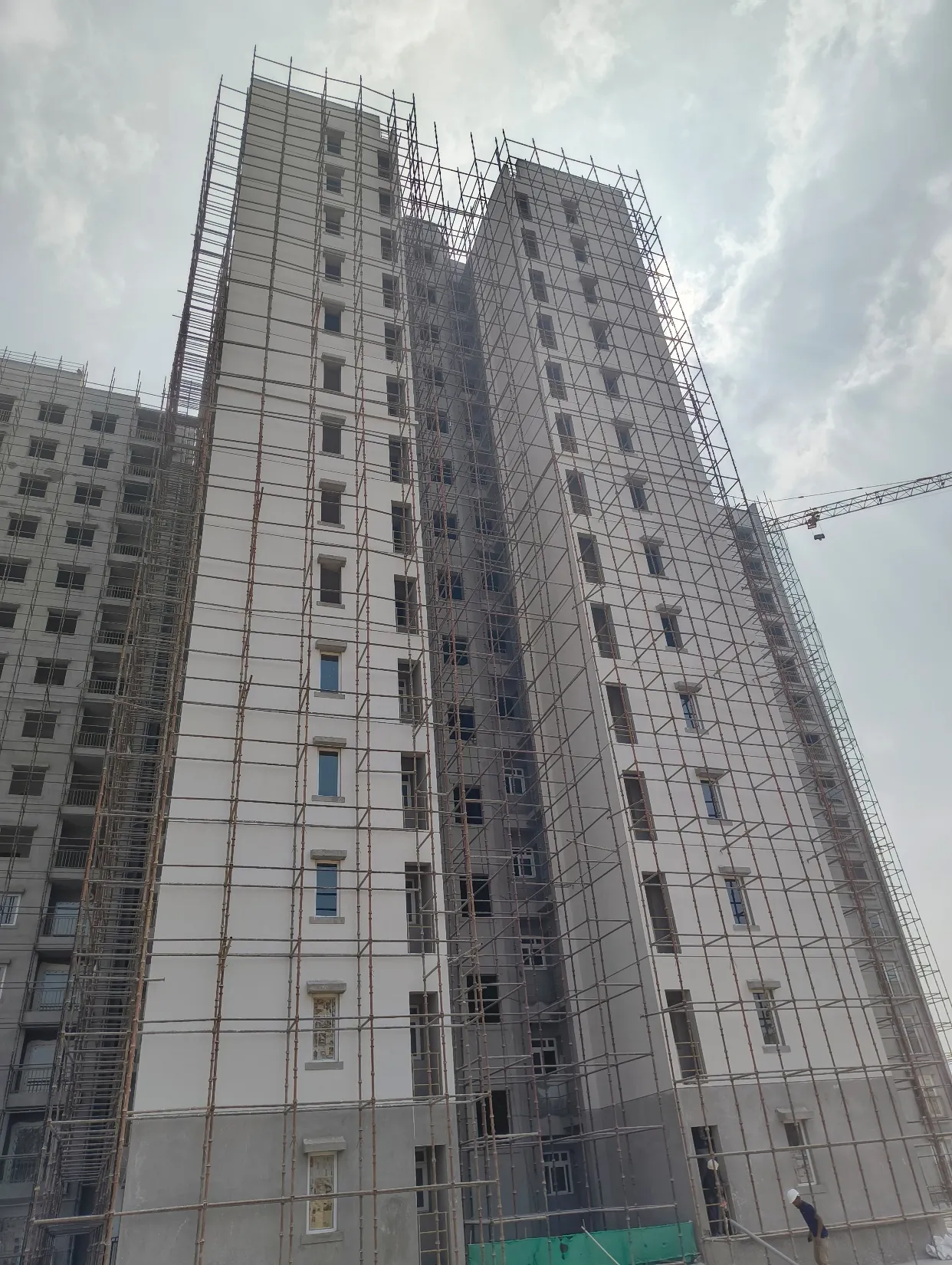

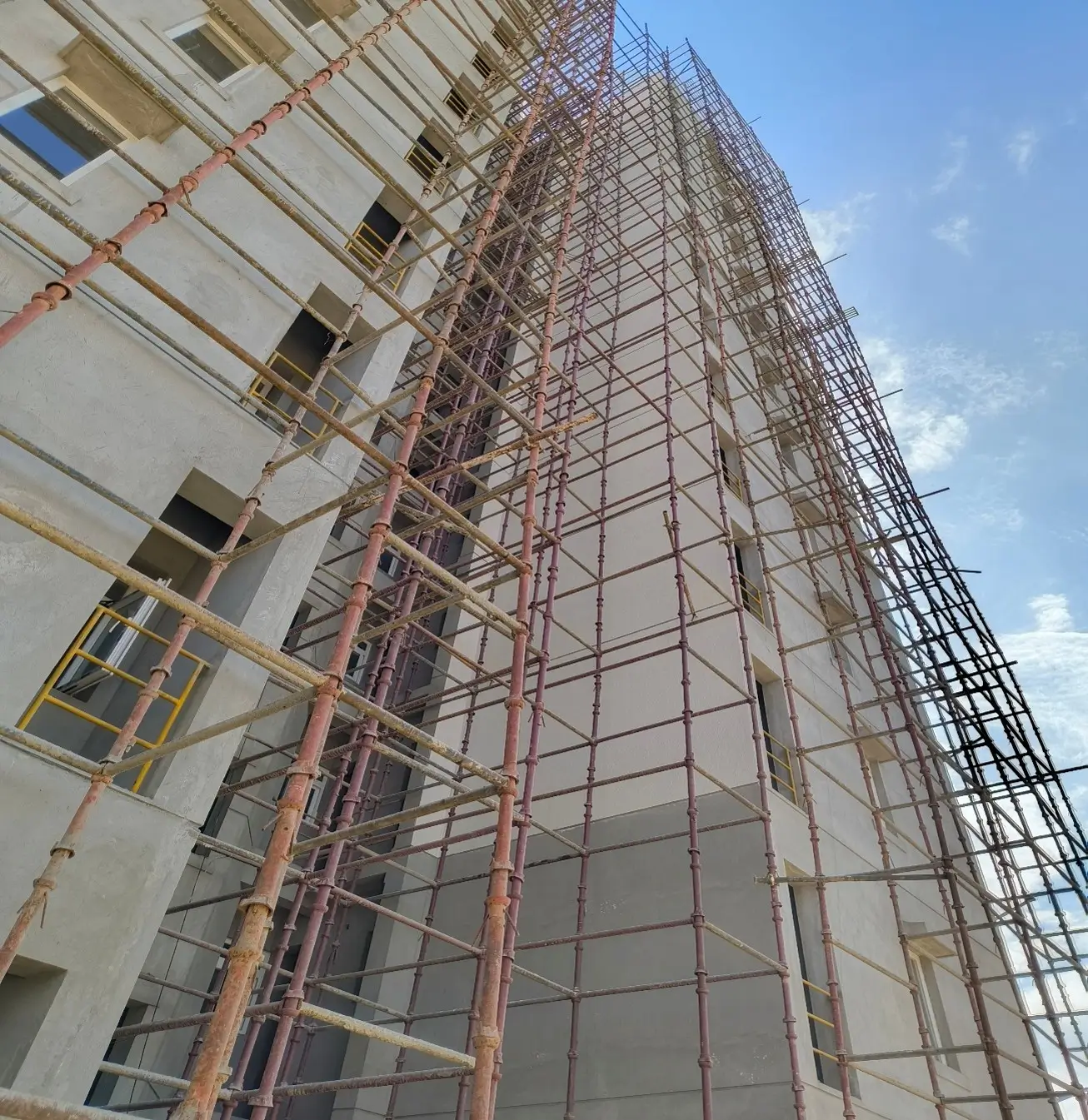

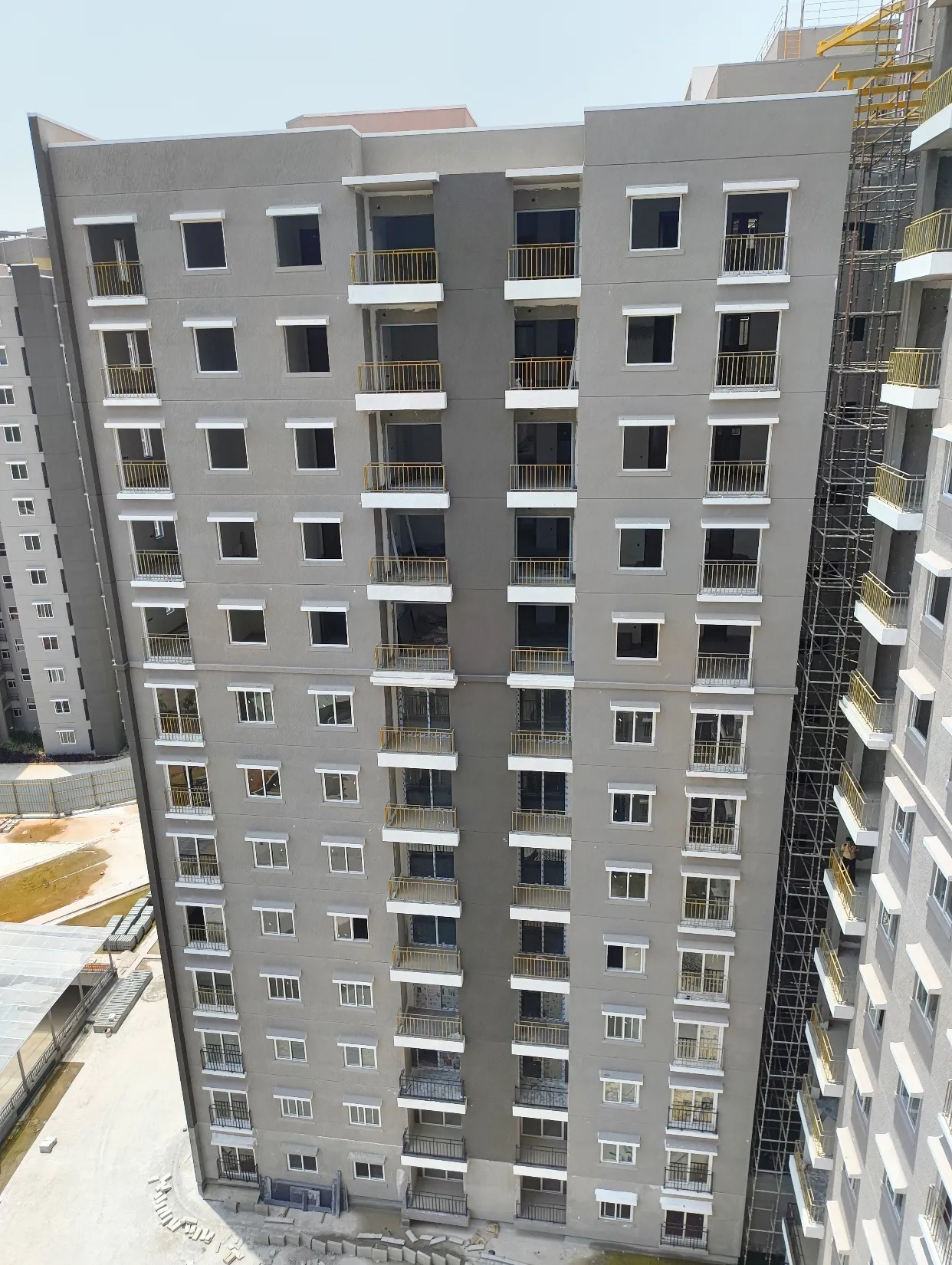

JKL Blocks |Texture & Paint Work In Progress - Aug 2026

JKL Blocks |Texture & Paint Work In Progress - Aug 2026

JKL Blocks |Texture & Paint Work In Progress - Aug 2026

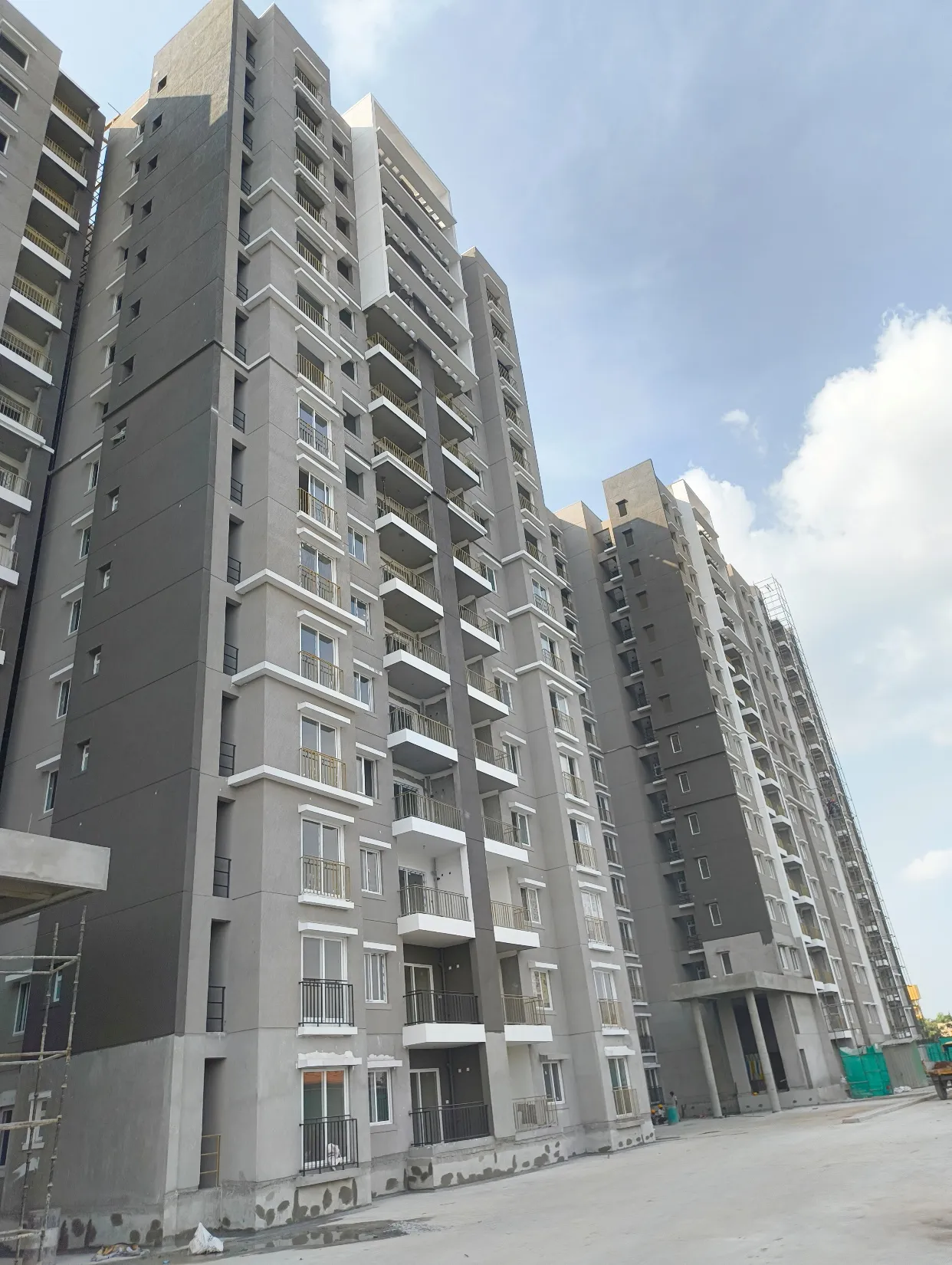

JKL Blocks |Texture & Paint Work In Progress - Aug 2026

JKL Blocks |Texture & Paint Work In Progress - Aug 2026

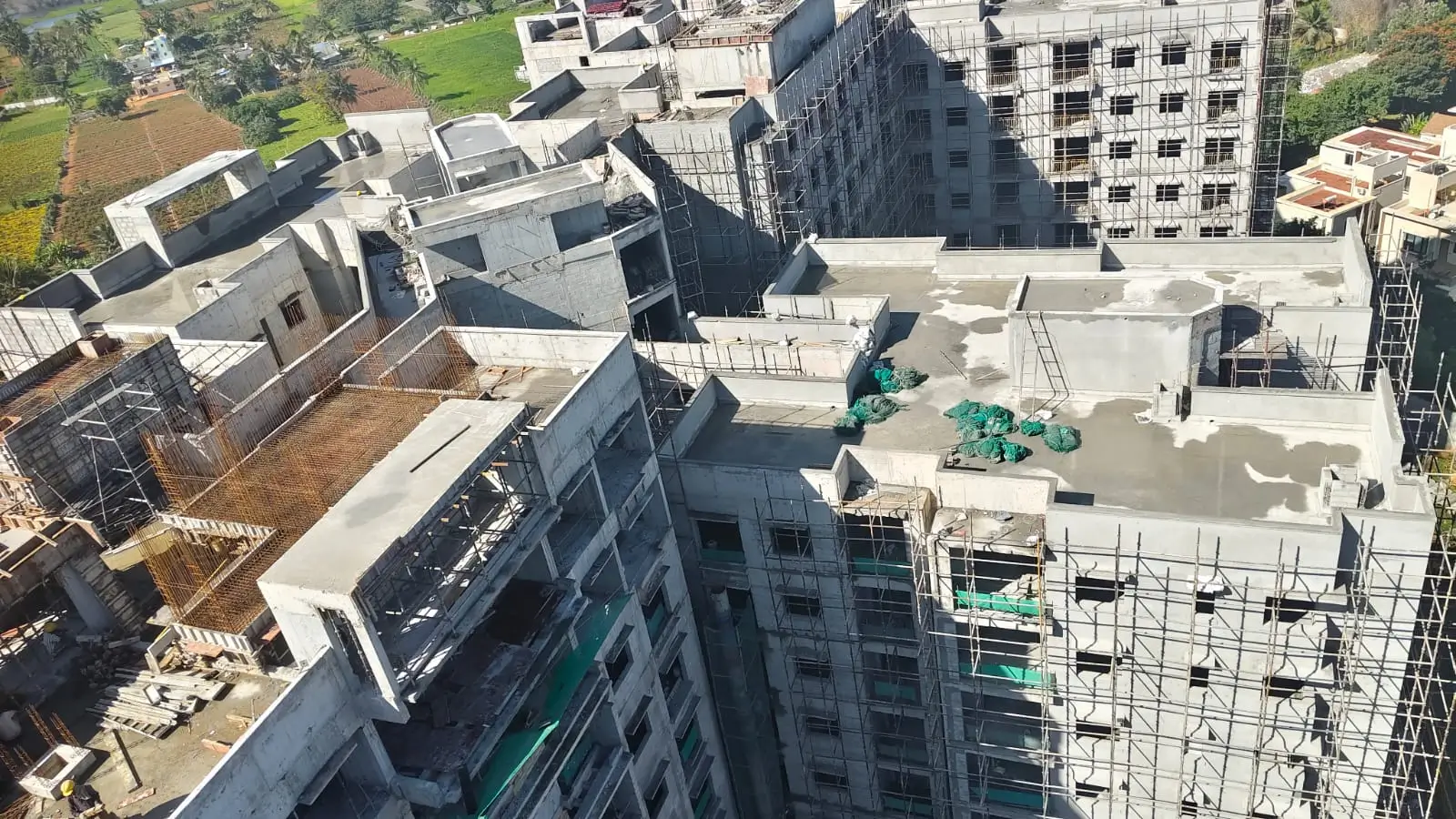

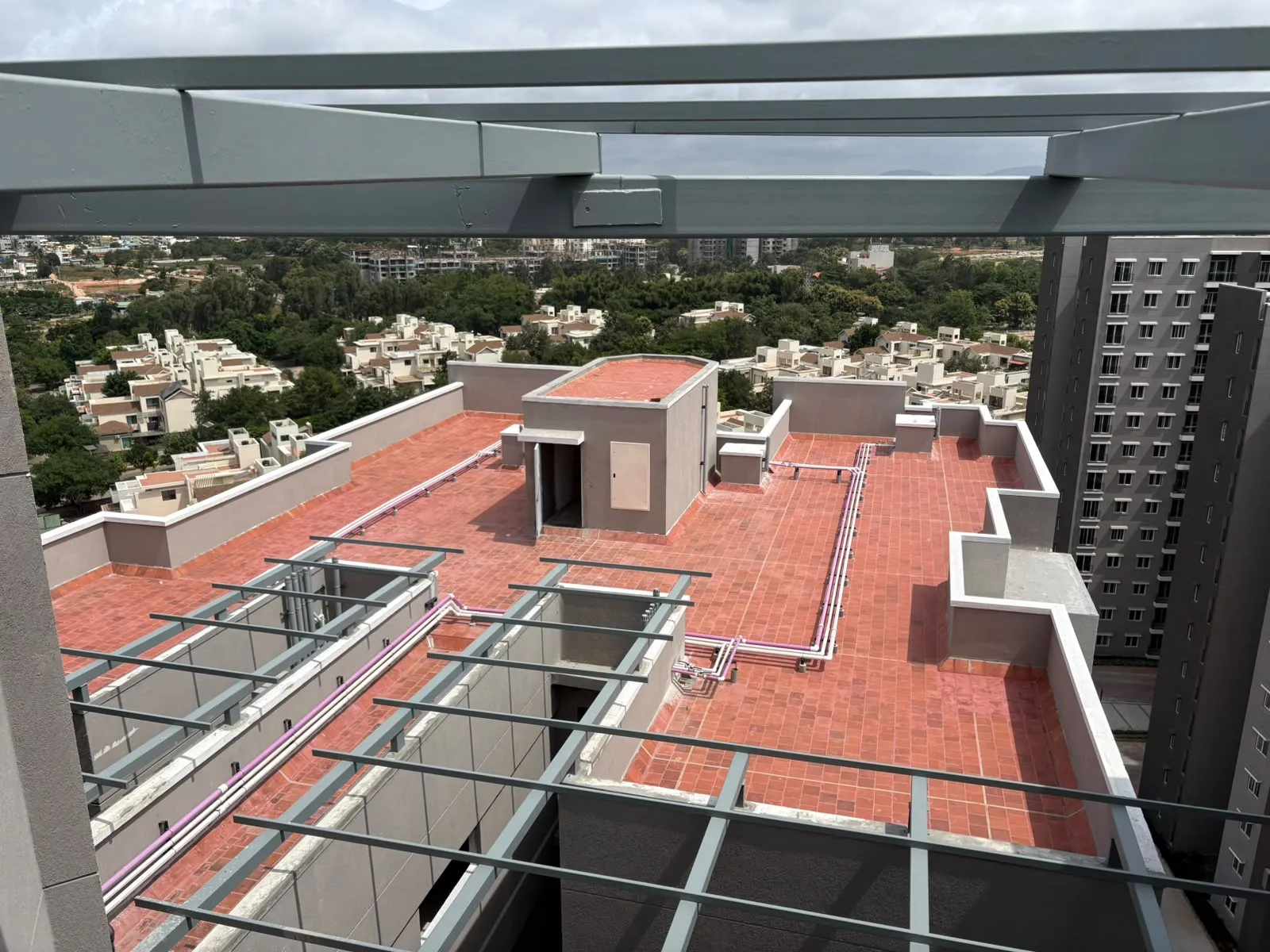

Basement & Terrace - Aug 2026

Basement & Terrace - Aug 2026

Basement & Terrace - Aug 2026

Basement & Terrace - Aug 2026

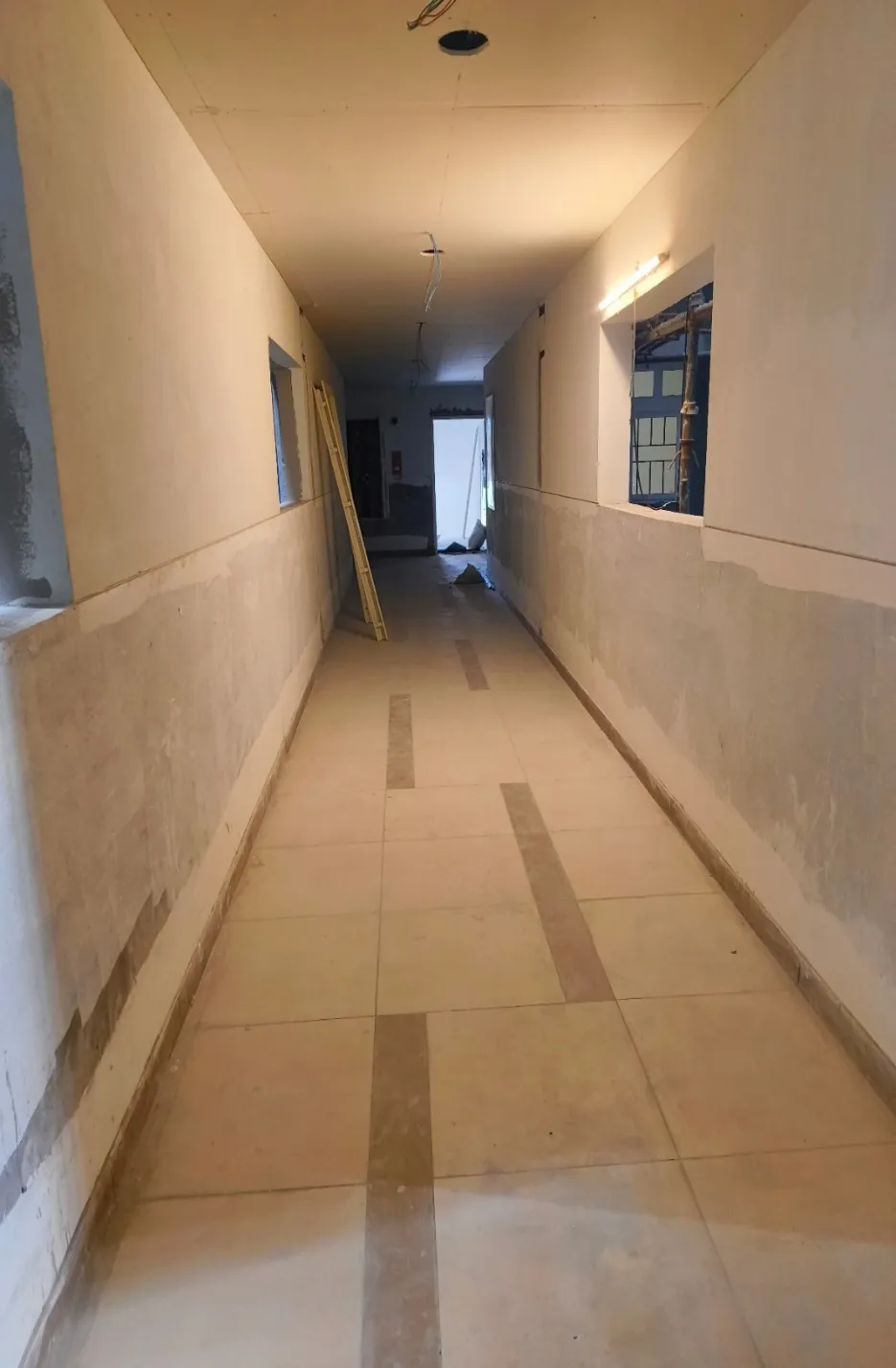

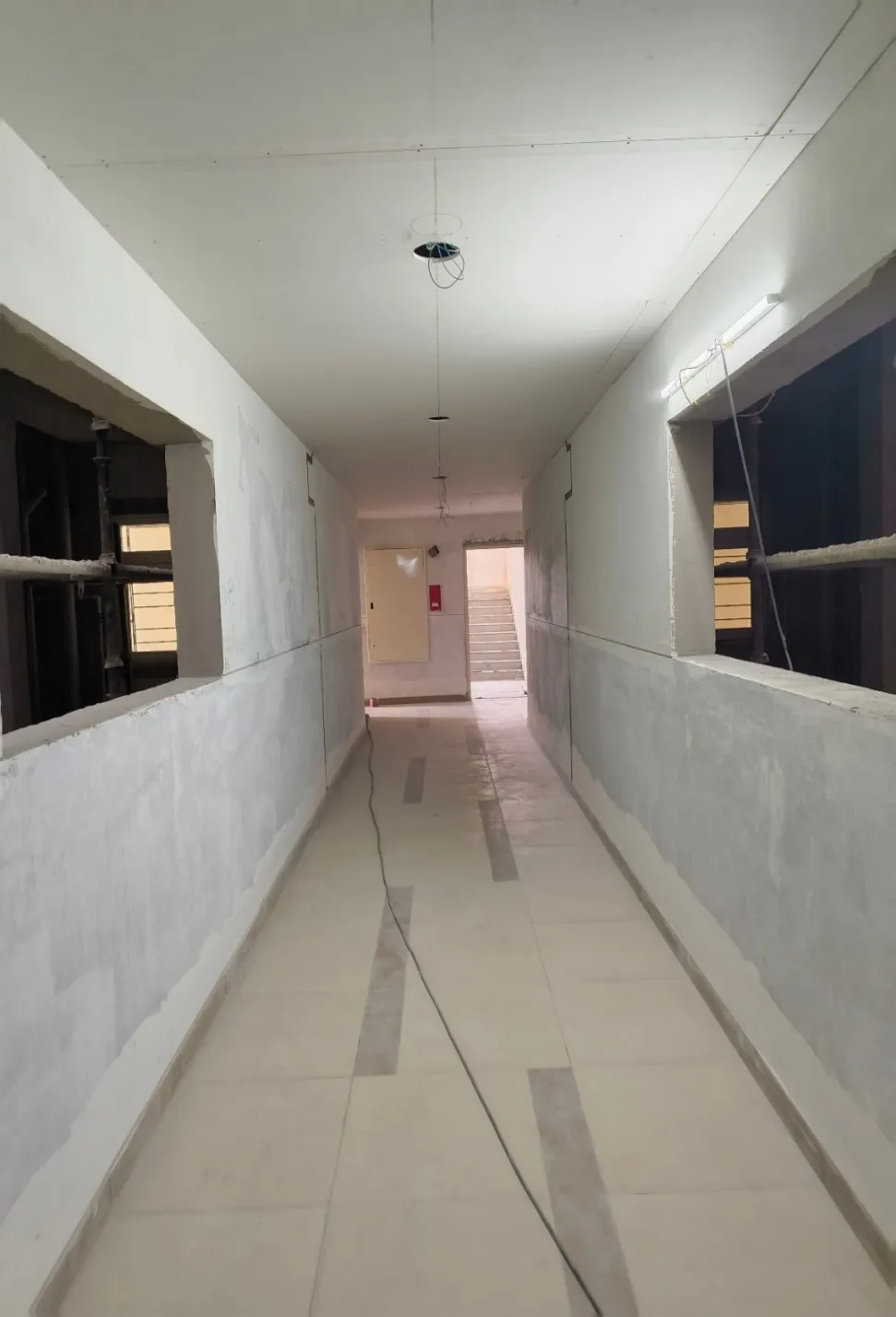

JKL Blocks | Corridor Area - Aug 2026

JKL Blocks | Corridor Area - Aug 2026

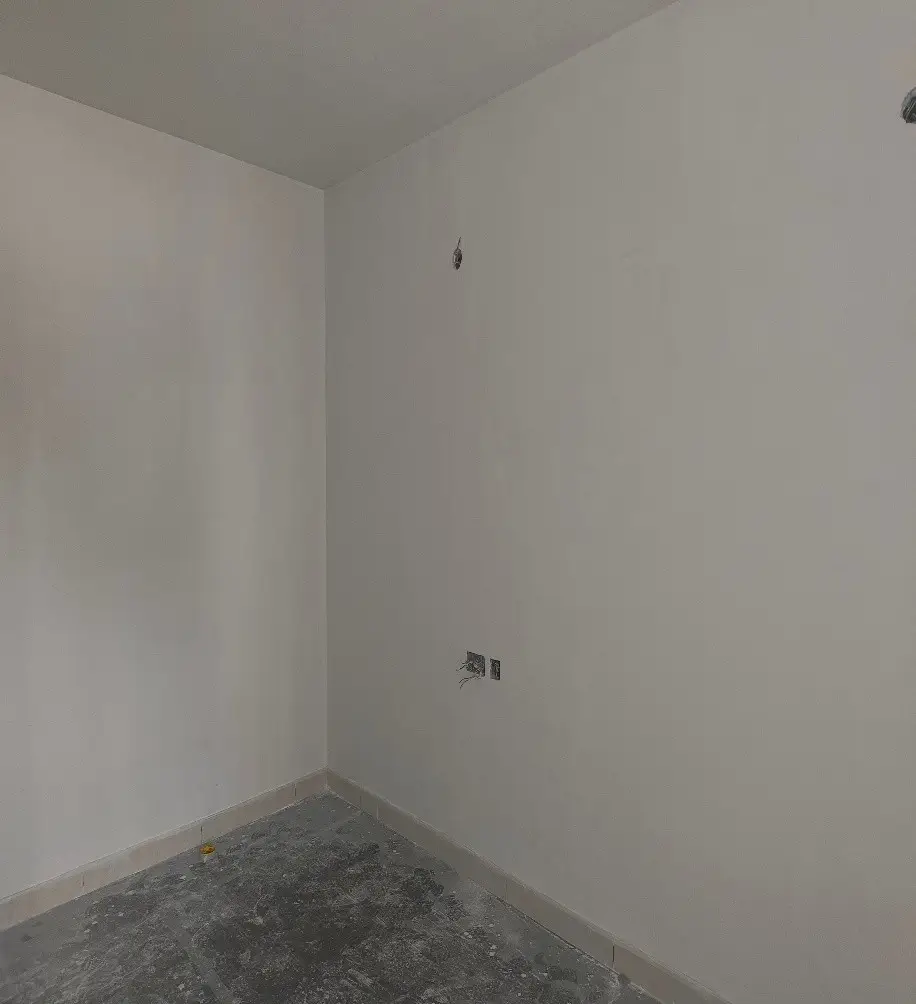

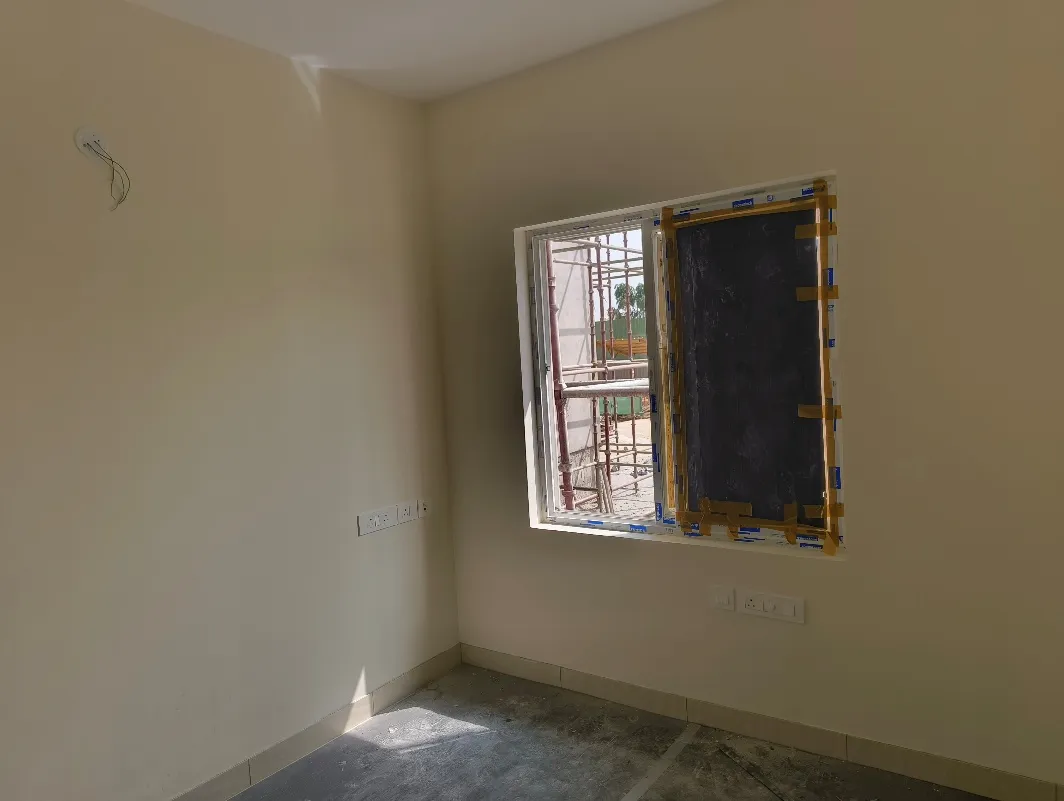

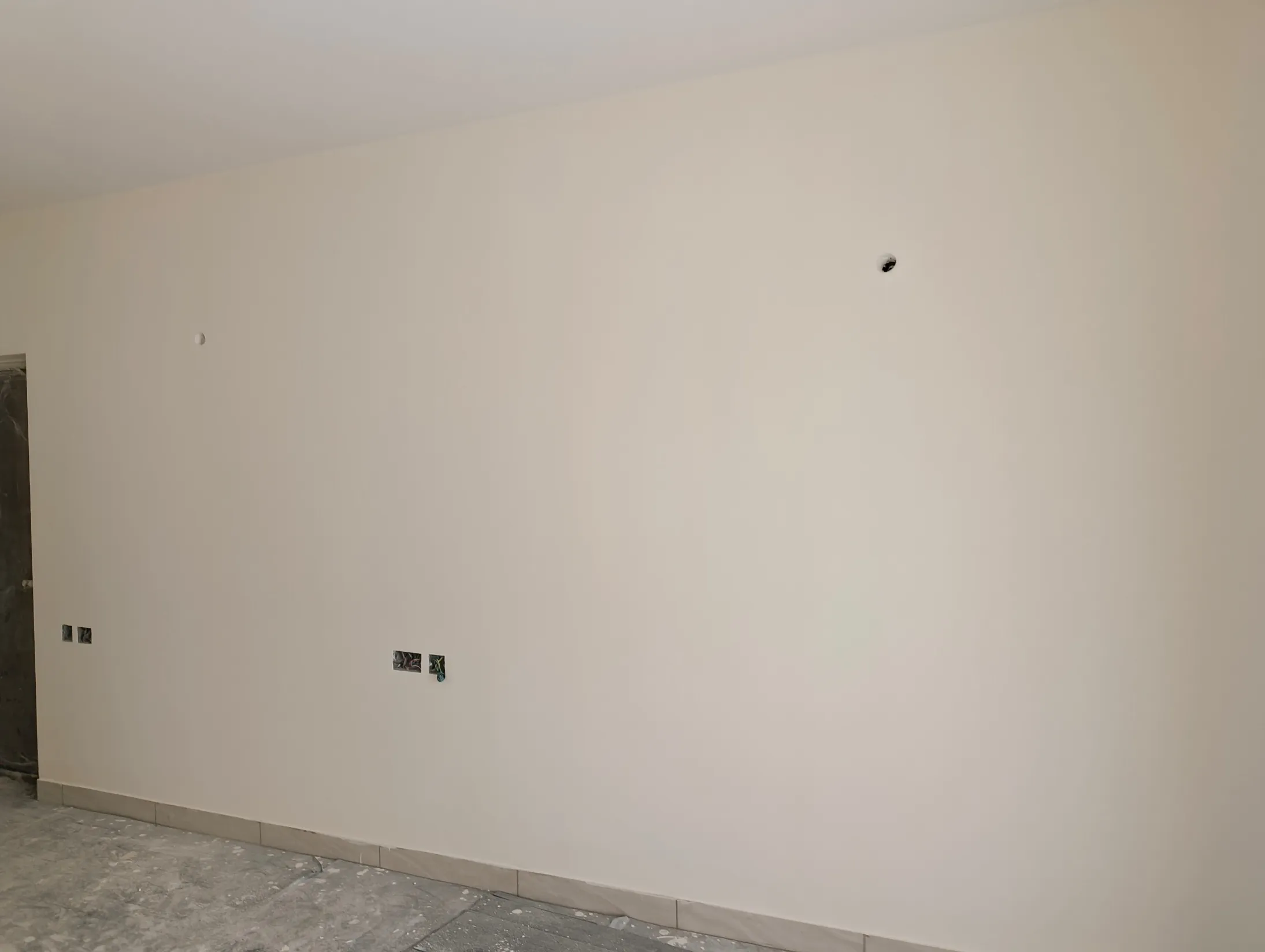

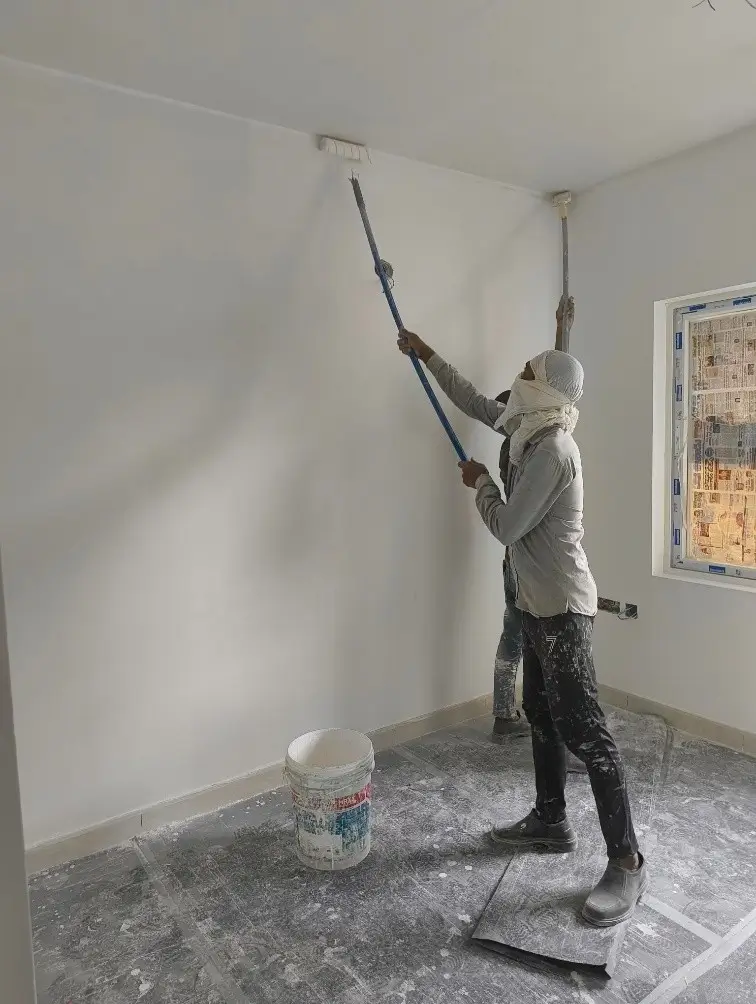

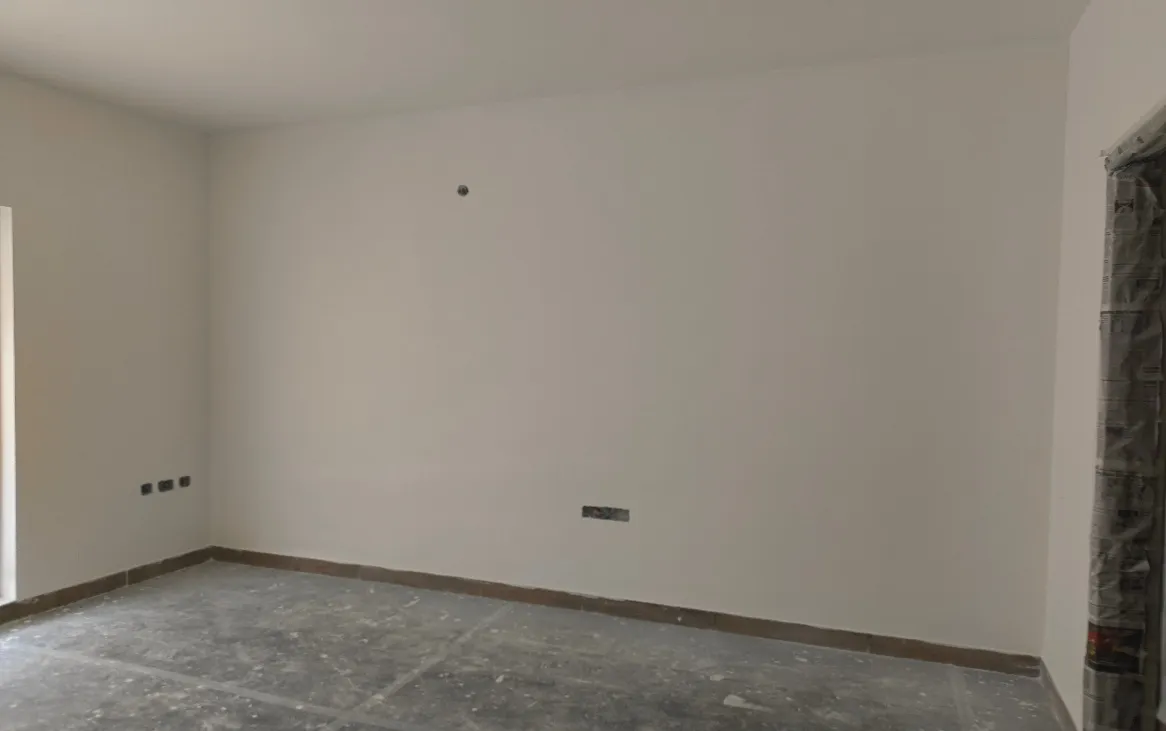

JKL Blocks | Internal Painting - Aug 2026

JKL Blocks | Internal Painting - Aug 2026

JKL Blocks | Internal Painting - Aug 2026

JKL Blocks | Internal Painting - Aug 2026

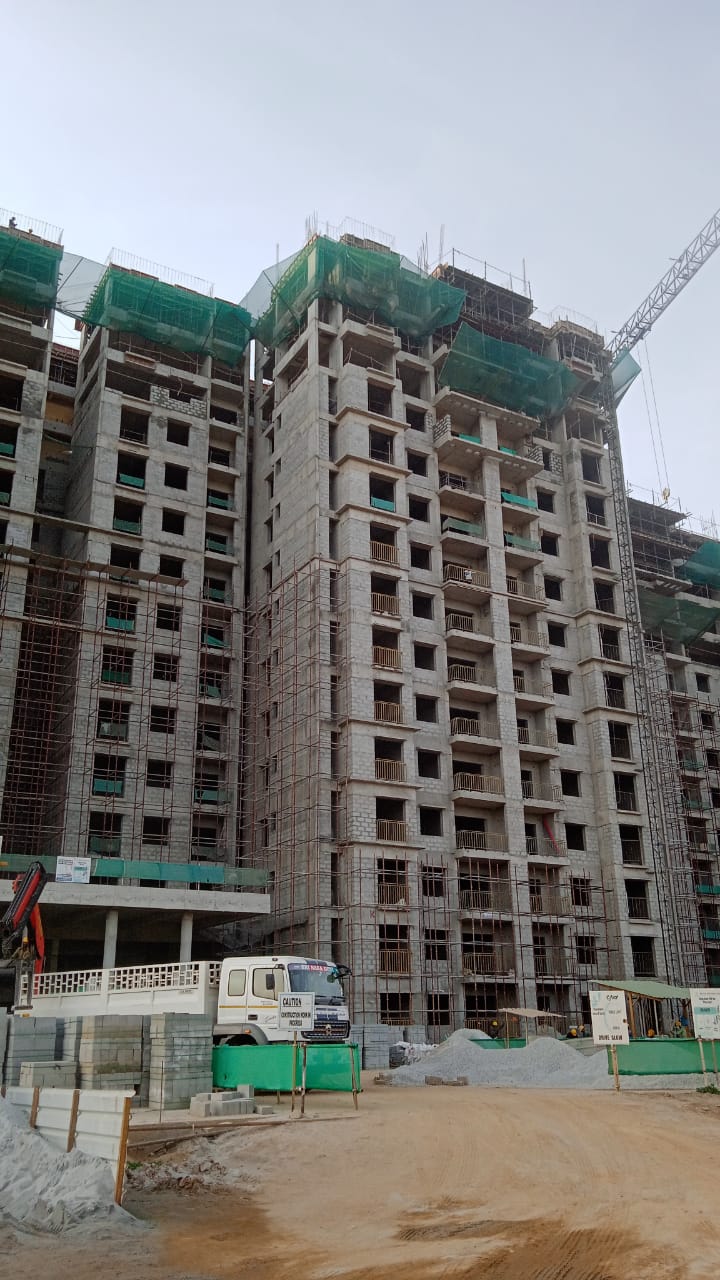

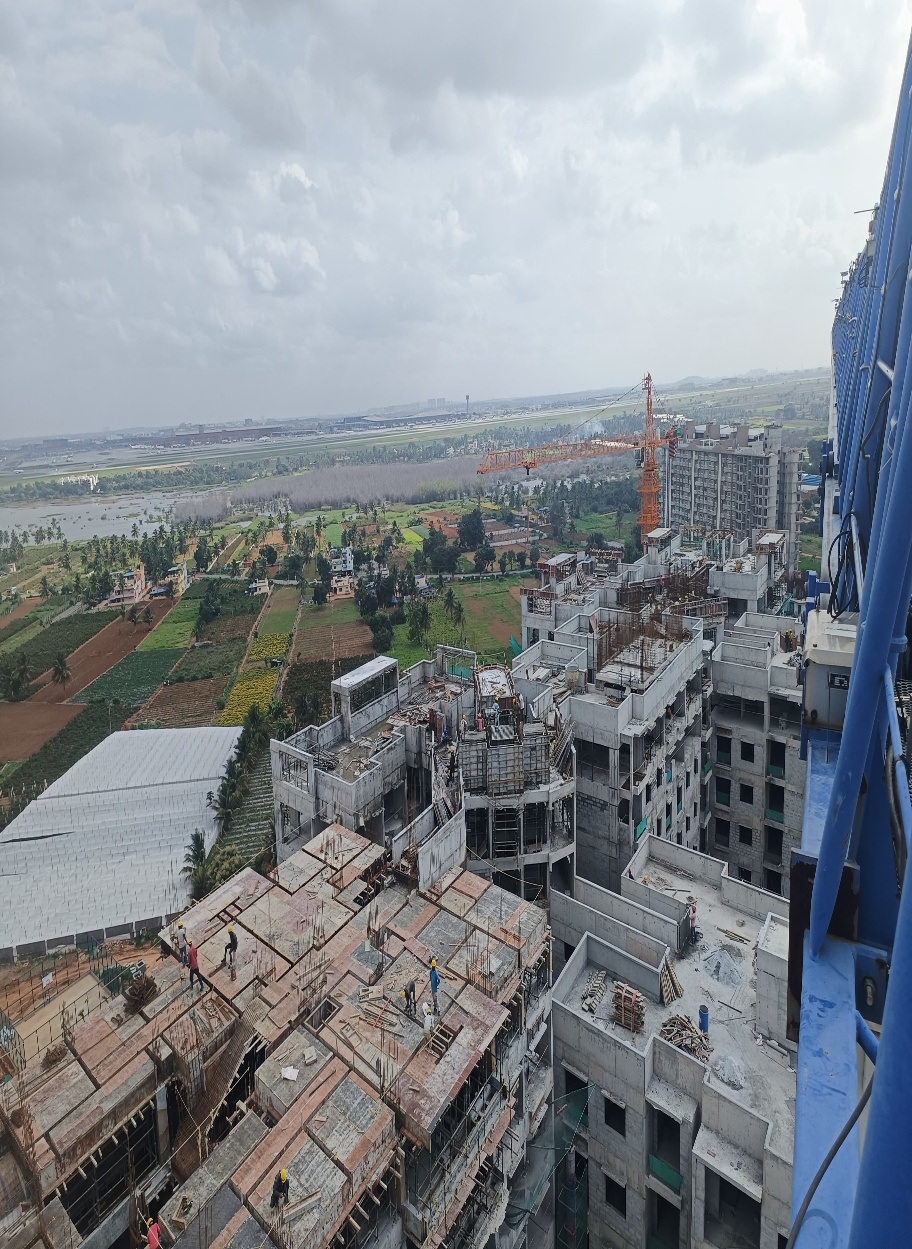

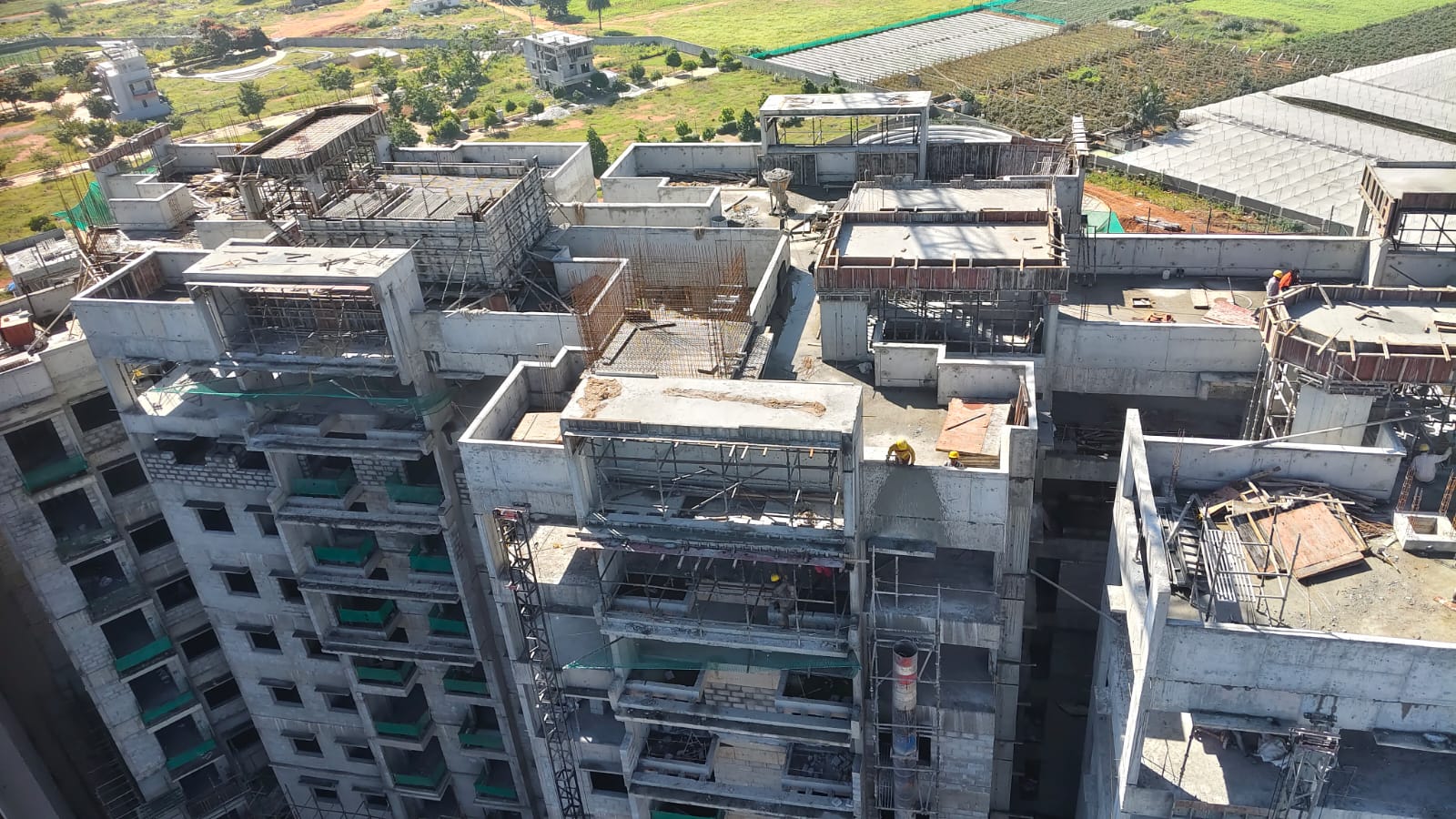

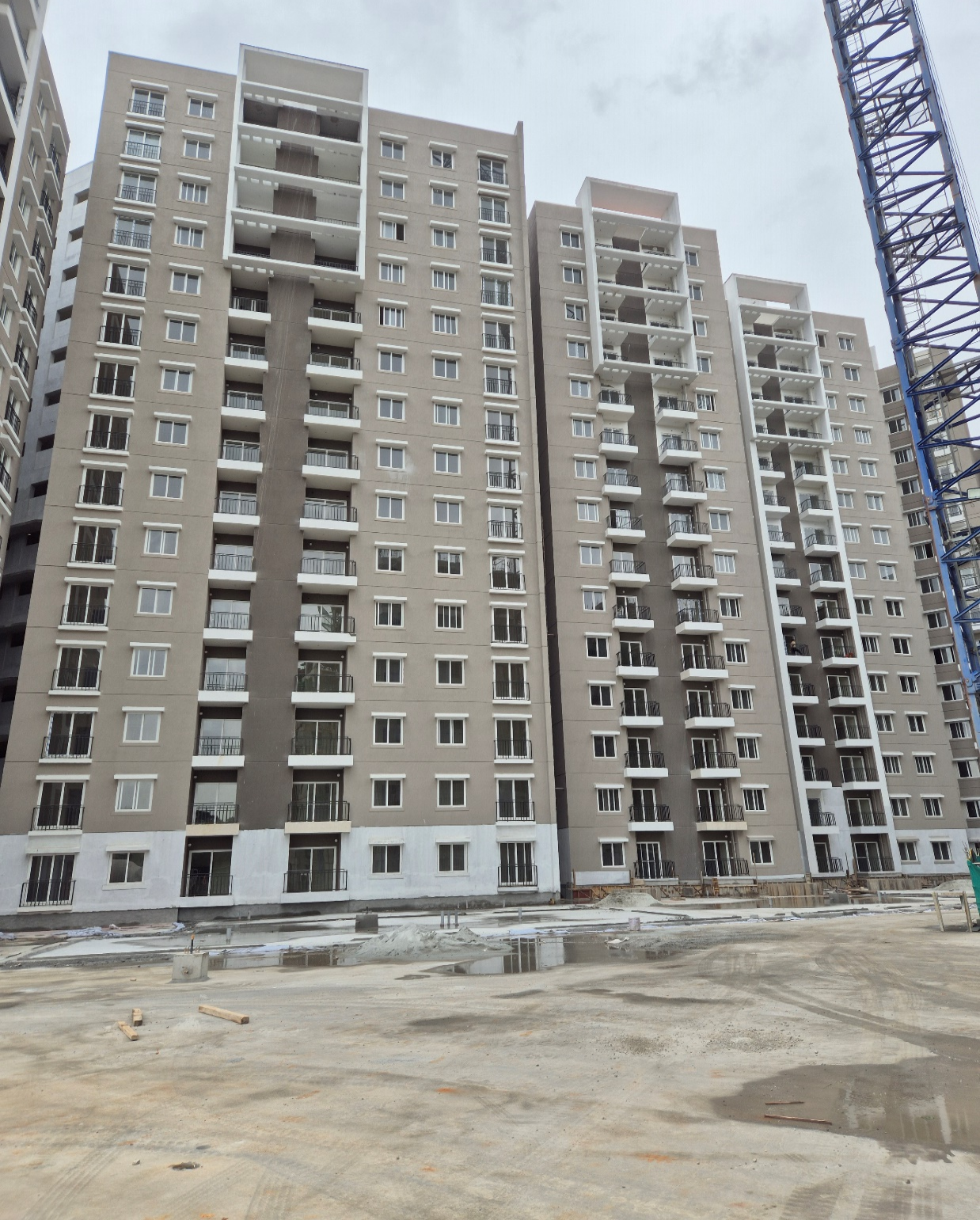

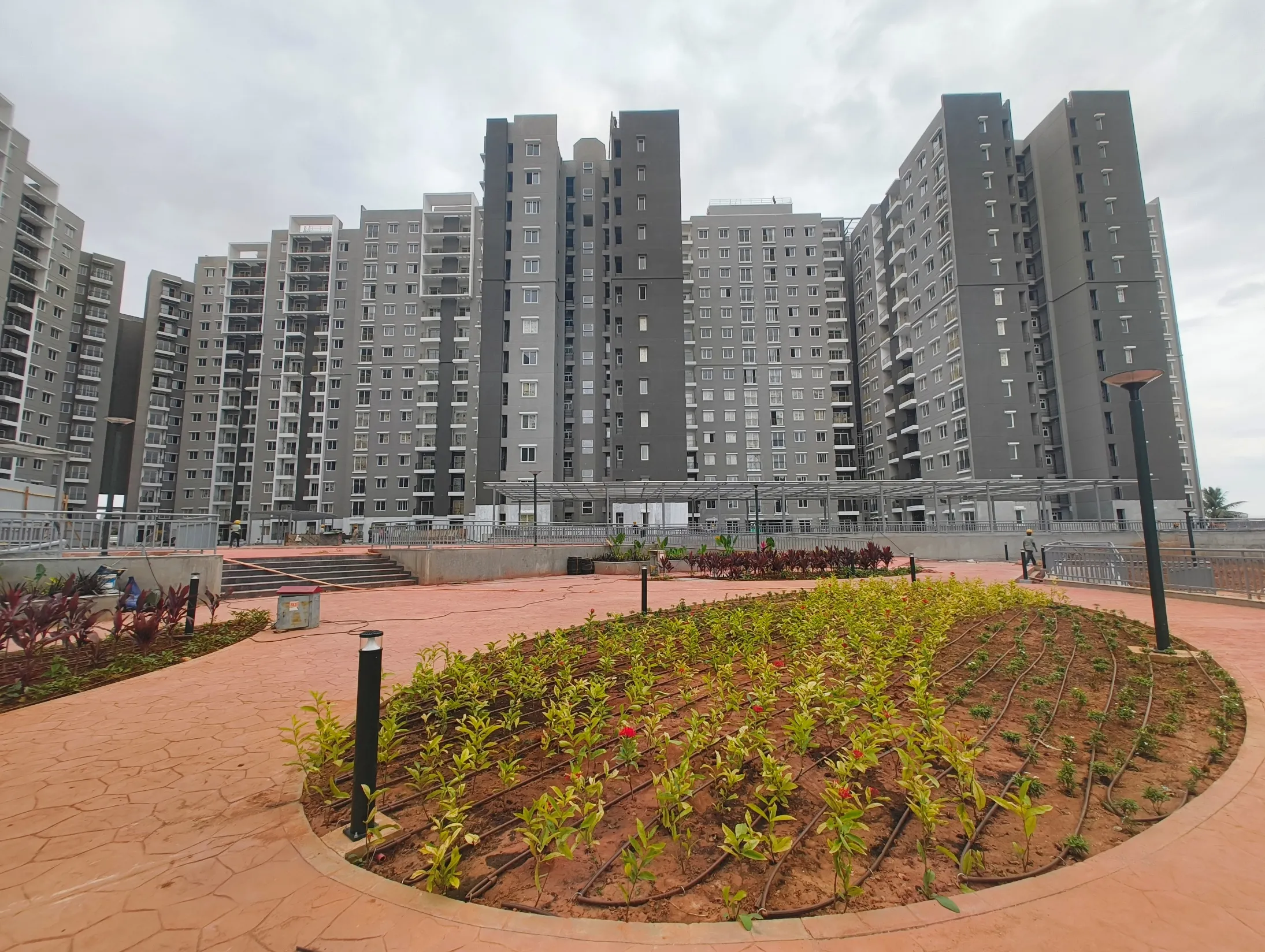

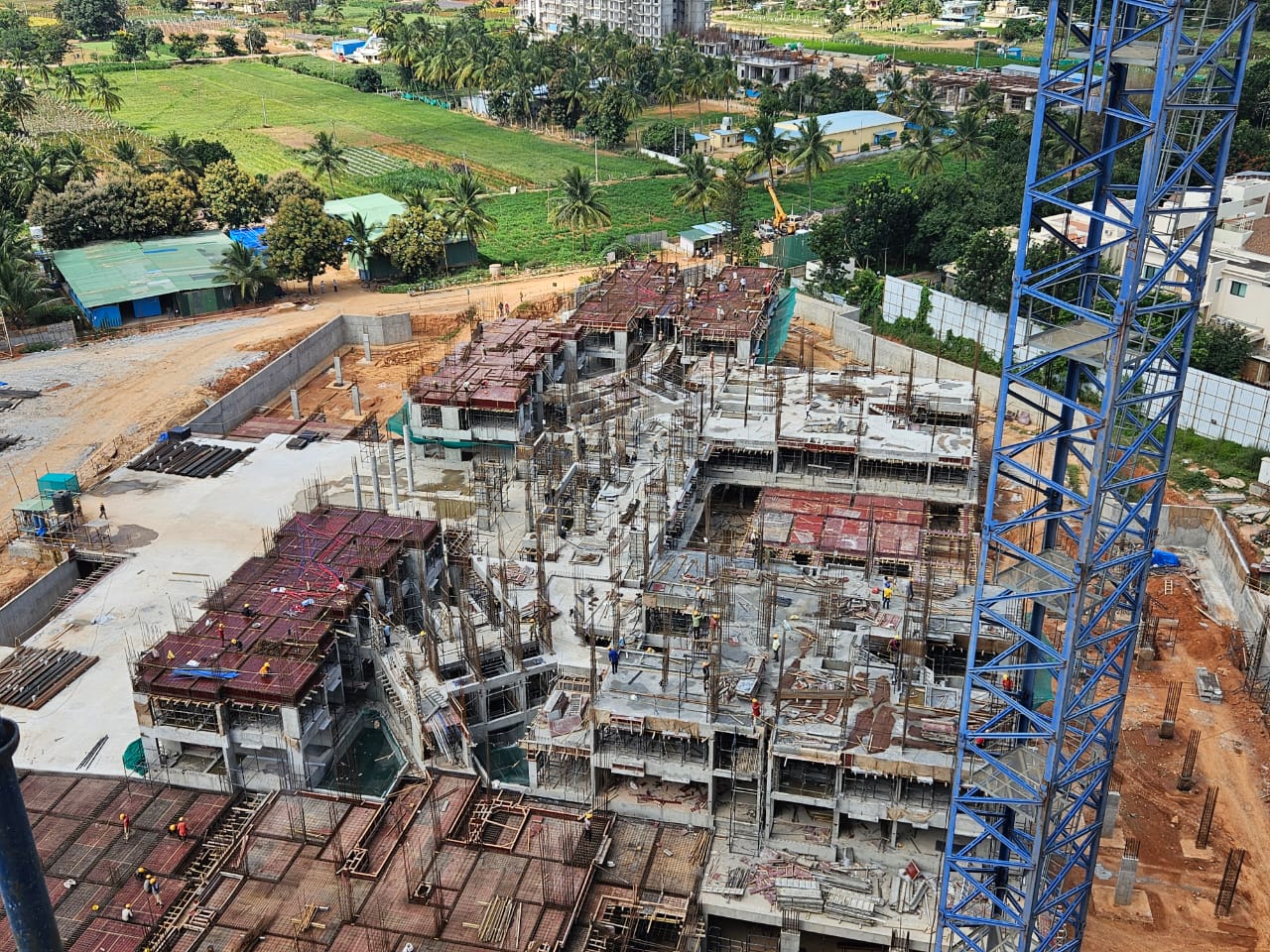

Brigade Ivory Phase-2 - Aug 2026

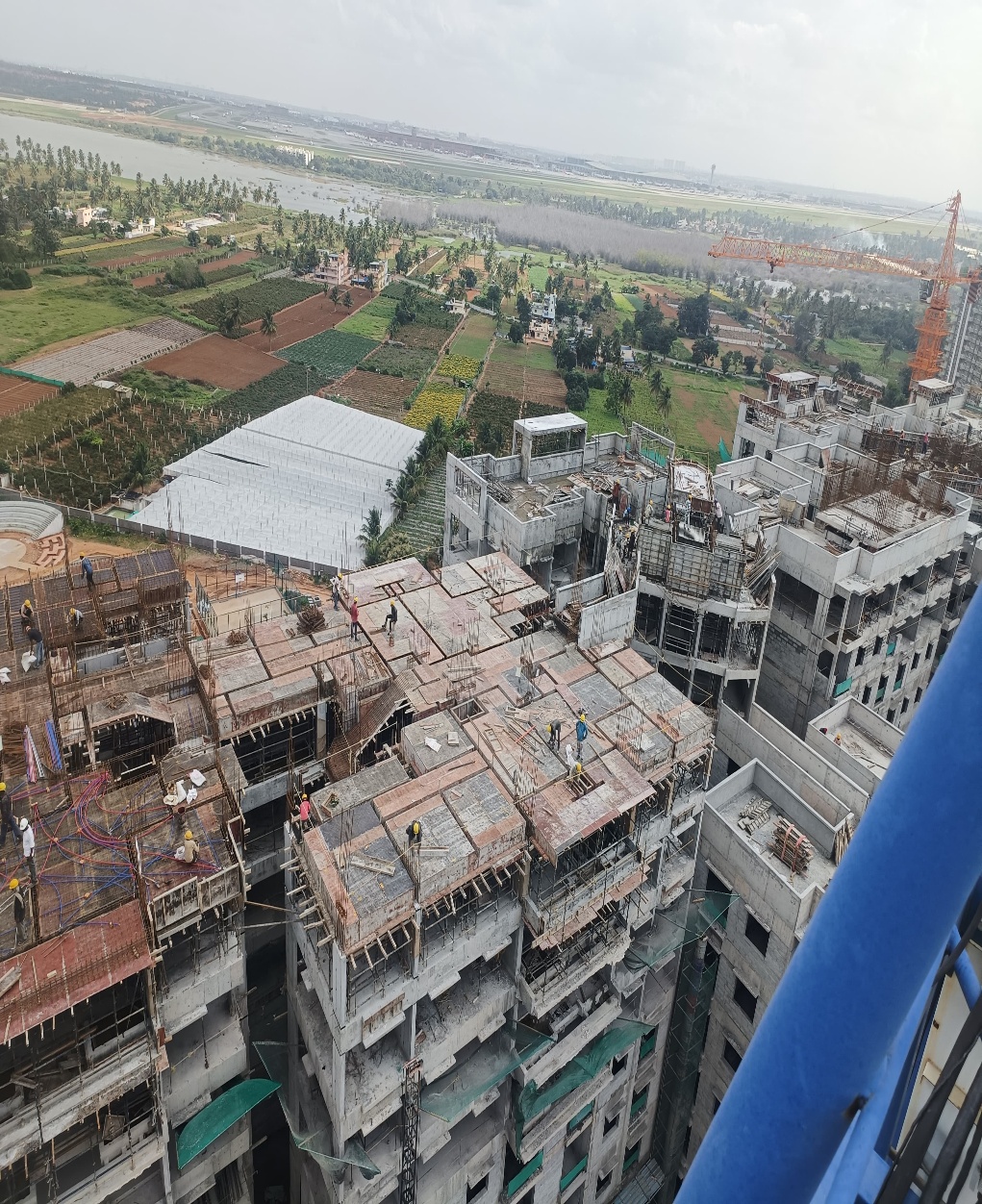

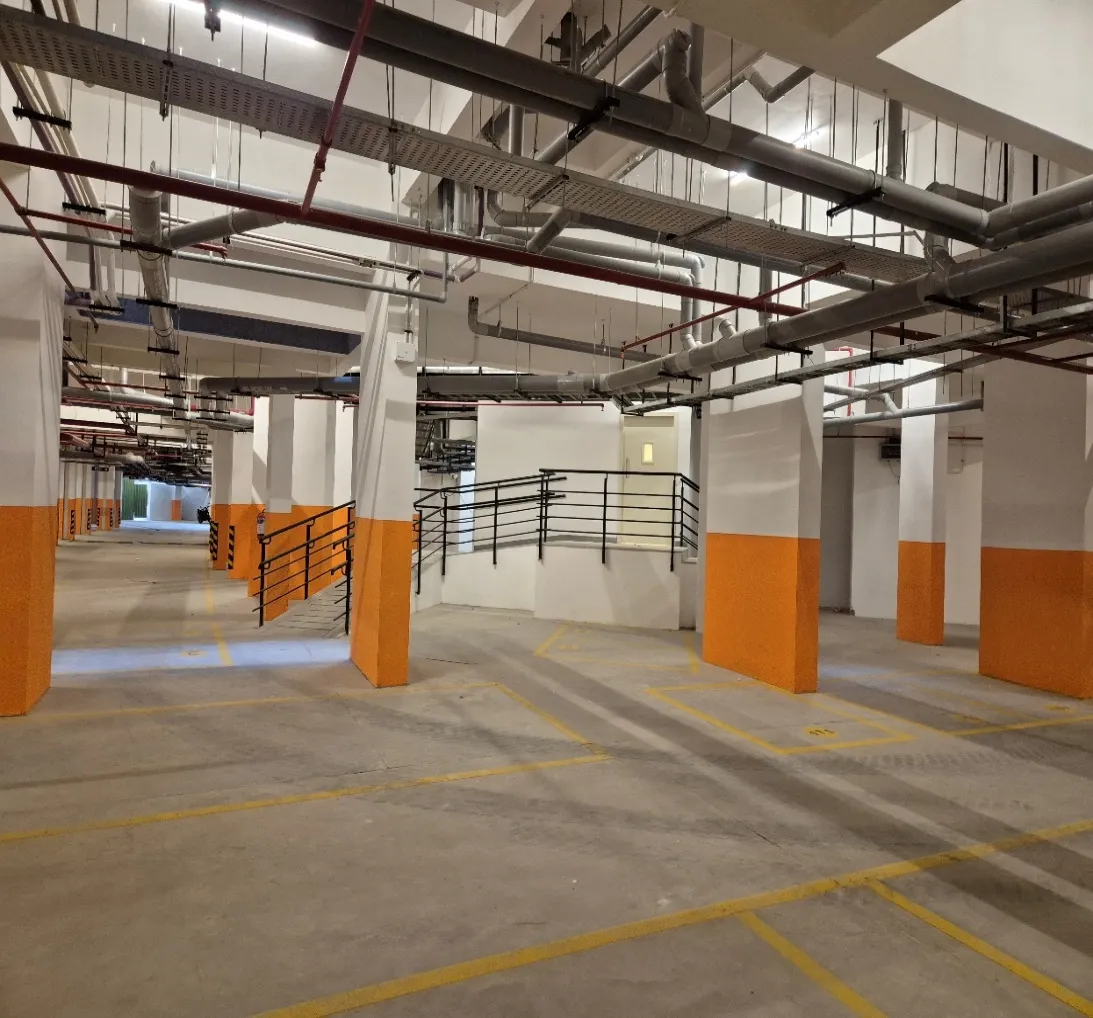

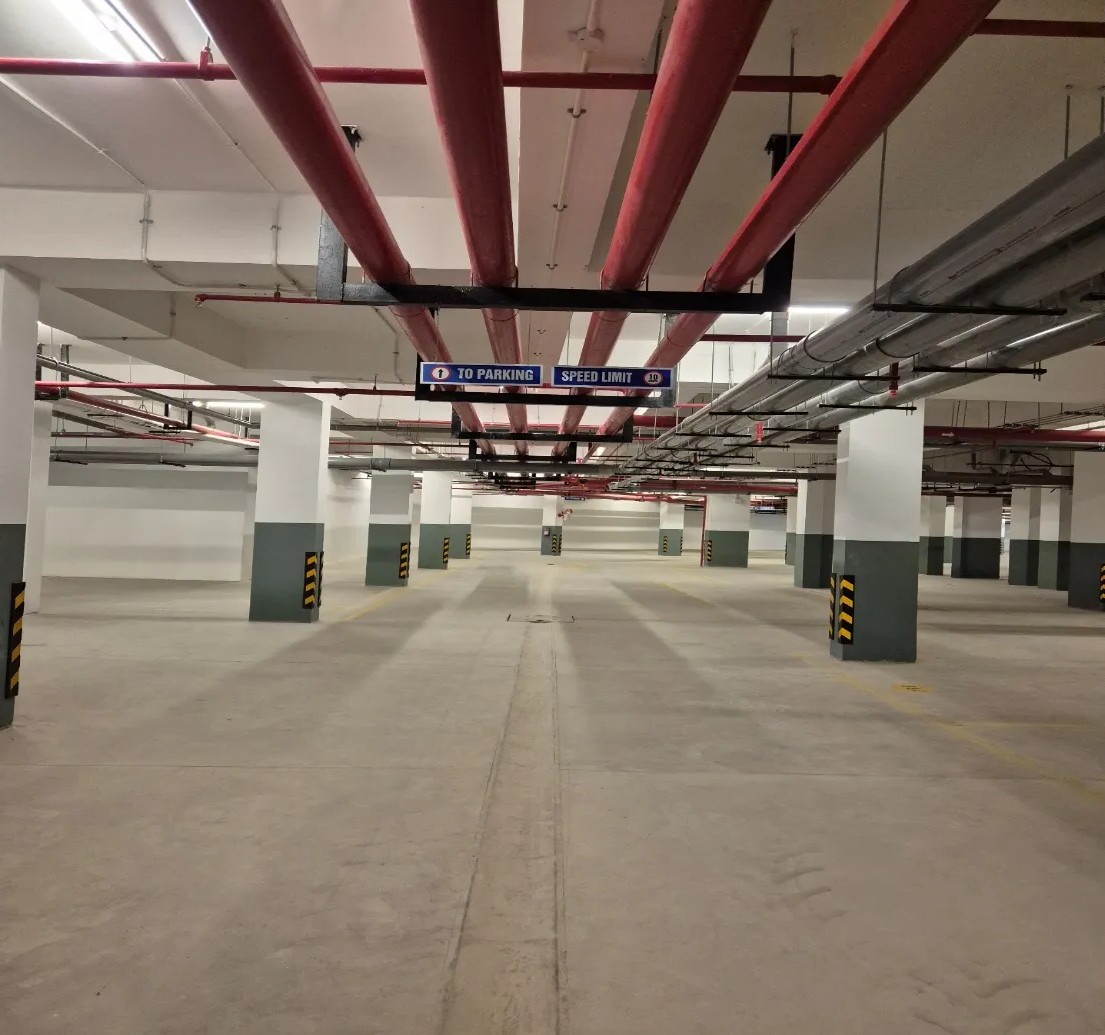

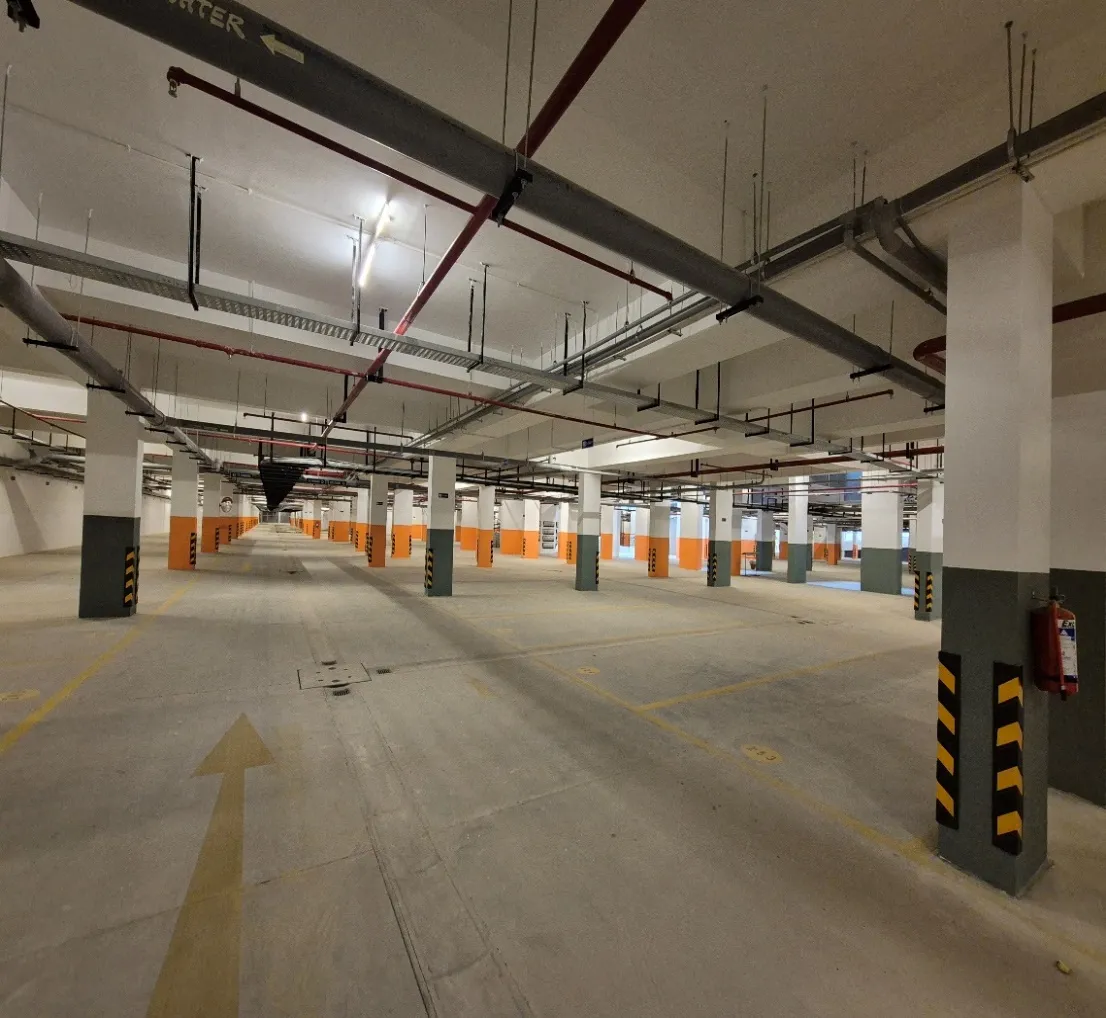

Basement - Aug 2026

Basement - Aug 2026

Basement - Aug 2026

Basement - Aug 2026

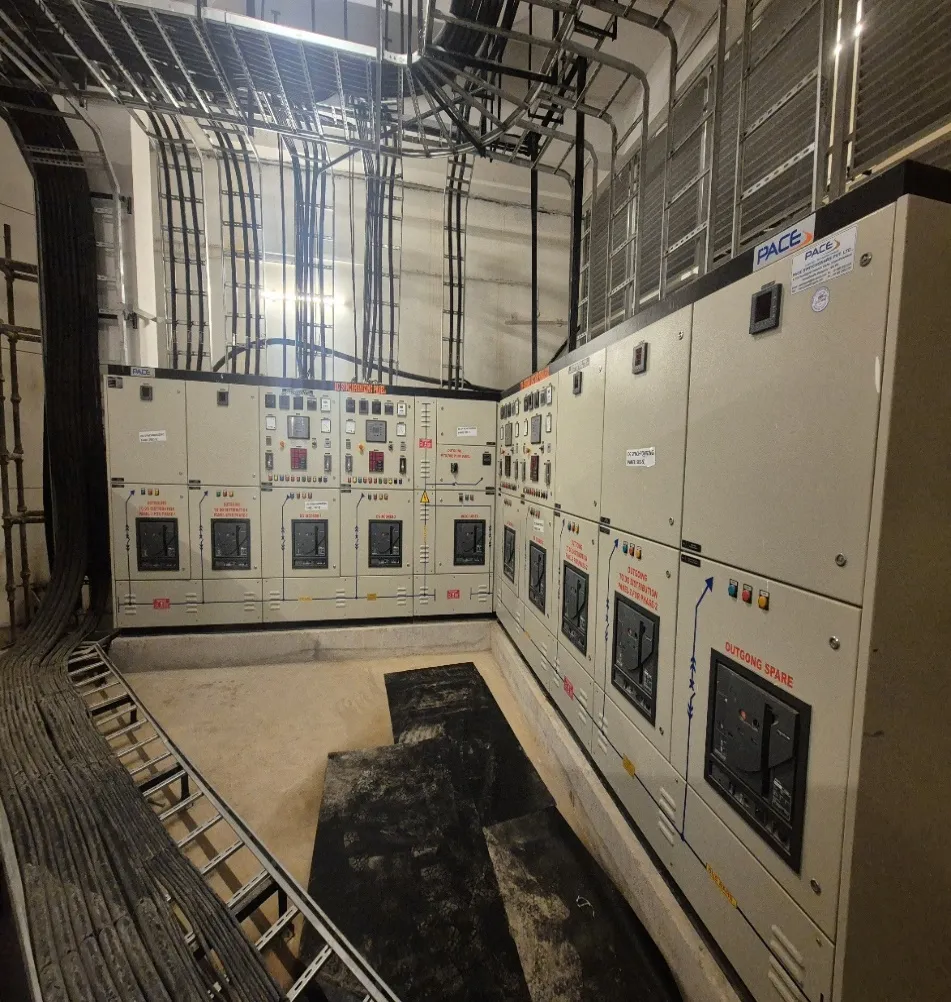

Electrical Panel Rooms - Aug 2026

Electrical Panel Rooms - Aug 2026

Electrical Panel Rooms - Aug 2026

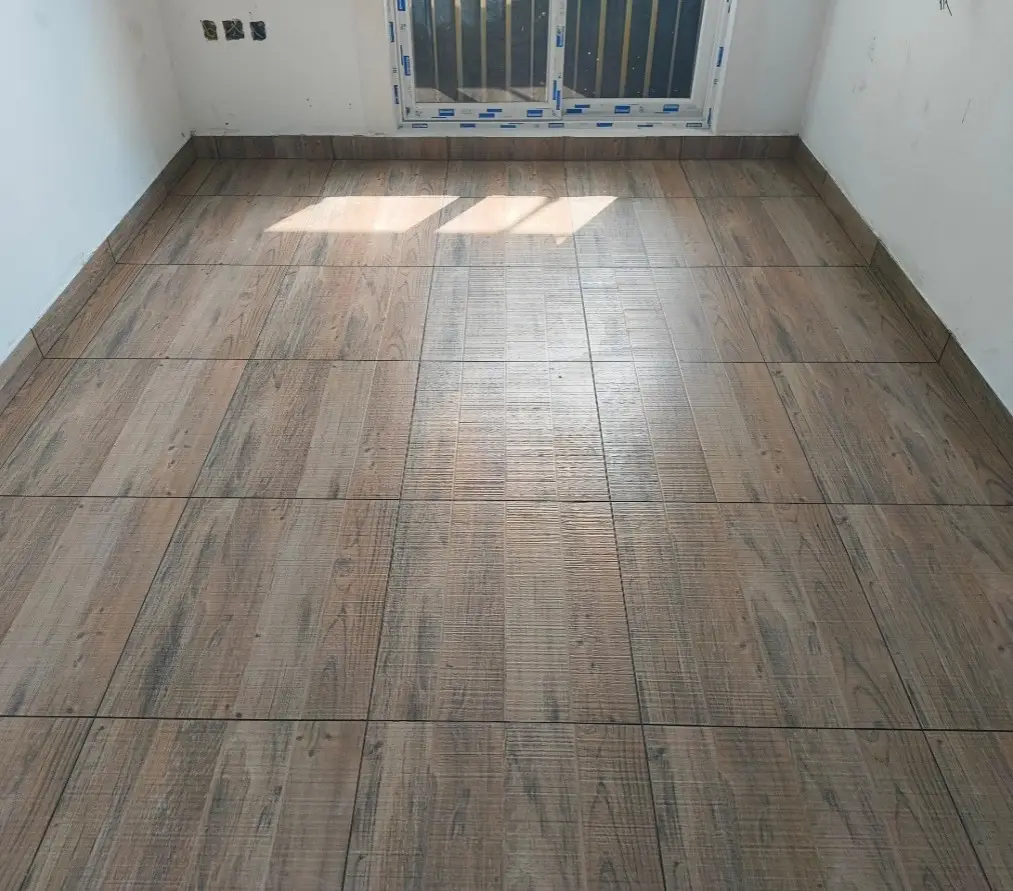

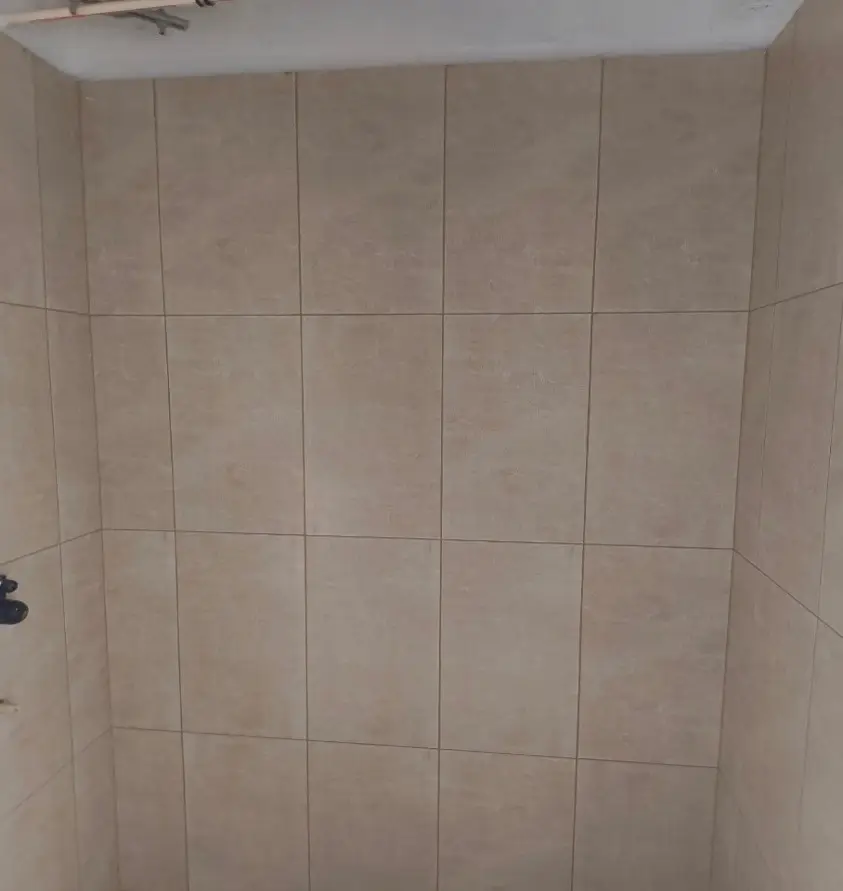

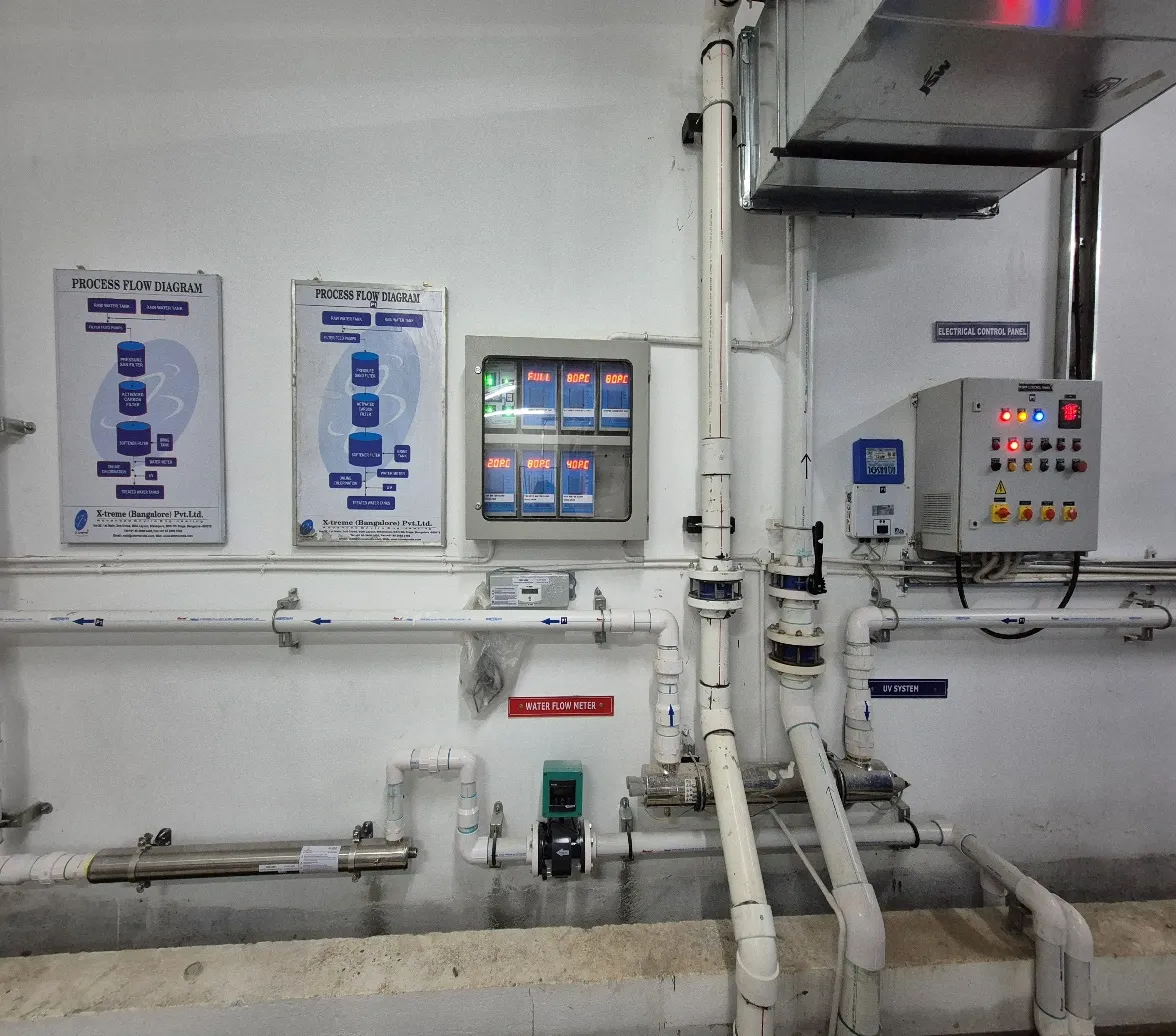

Flooring & CP, Sanitary fittings - Aug 2026

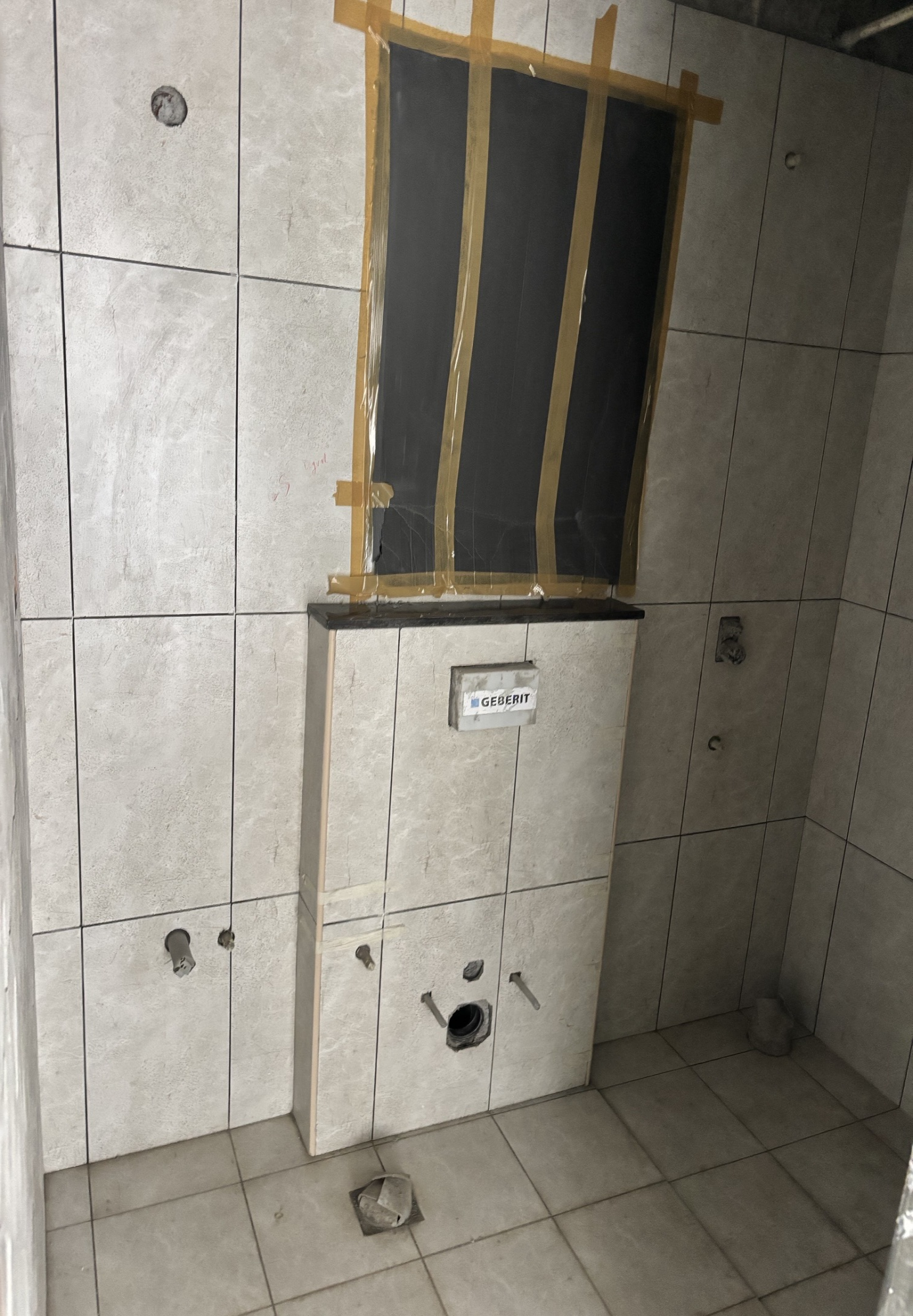

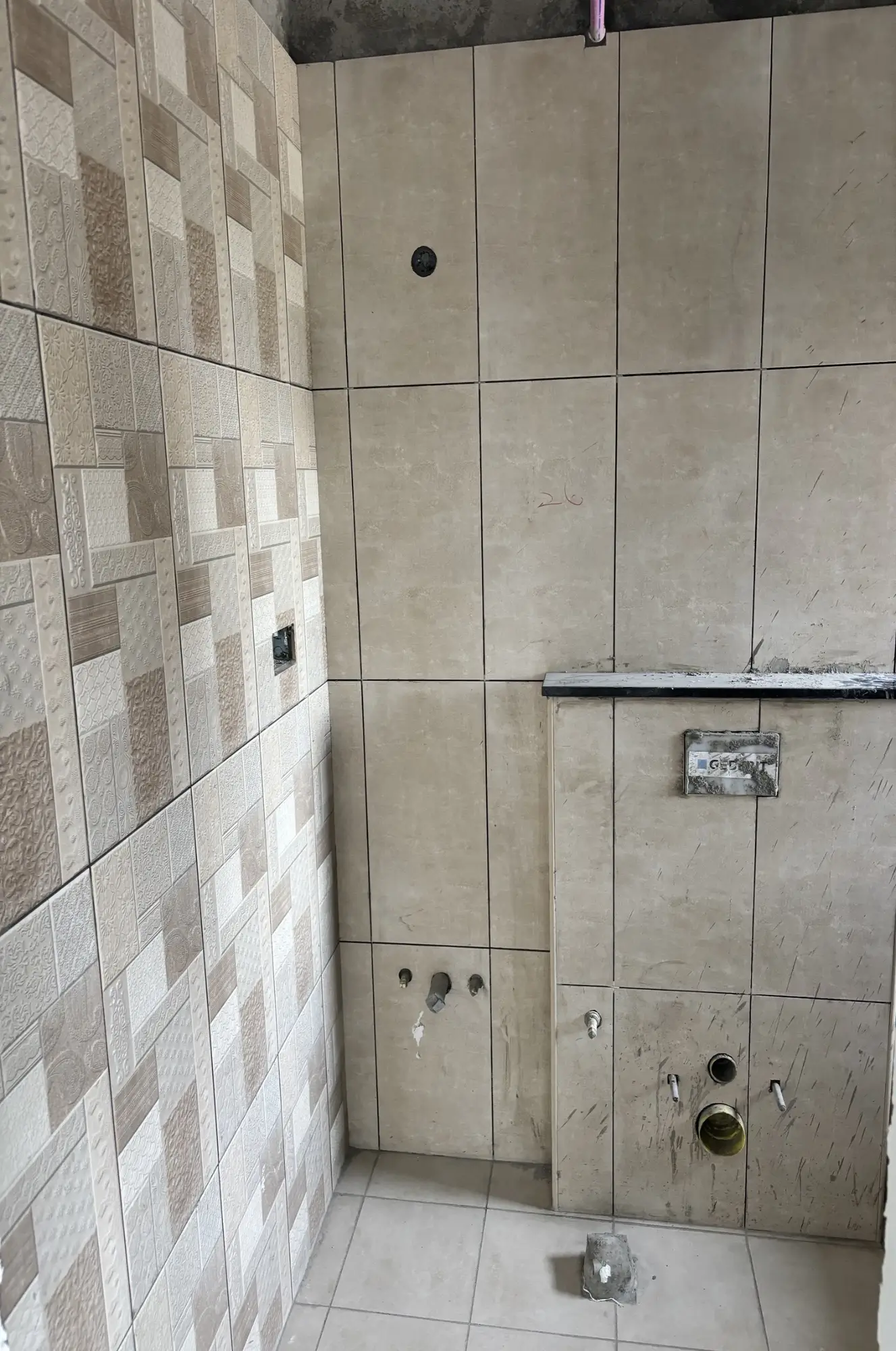

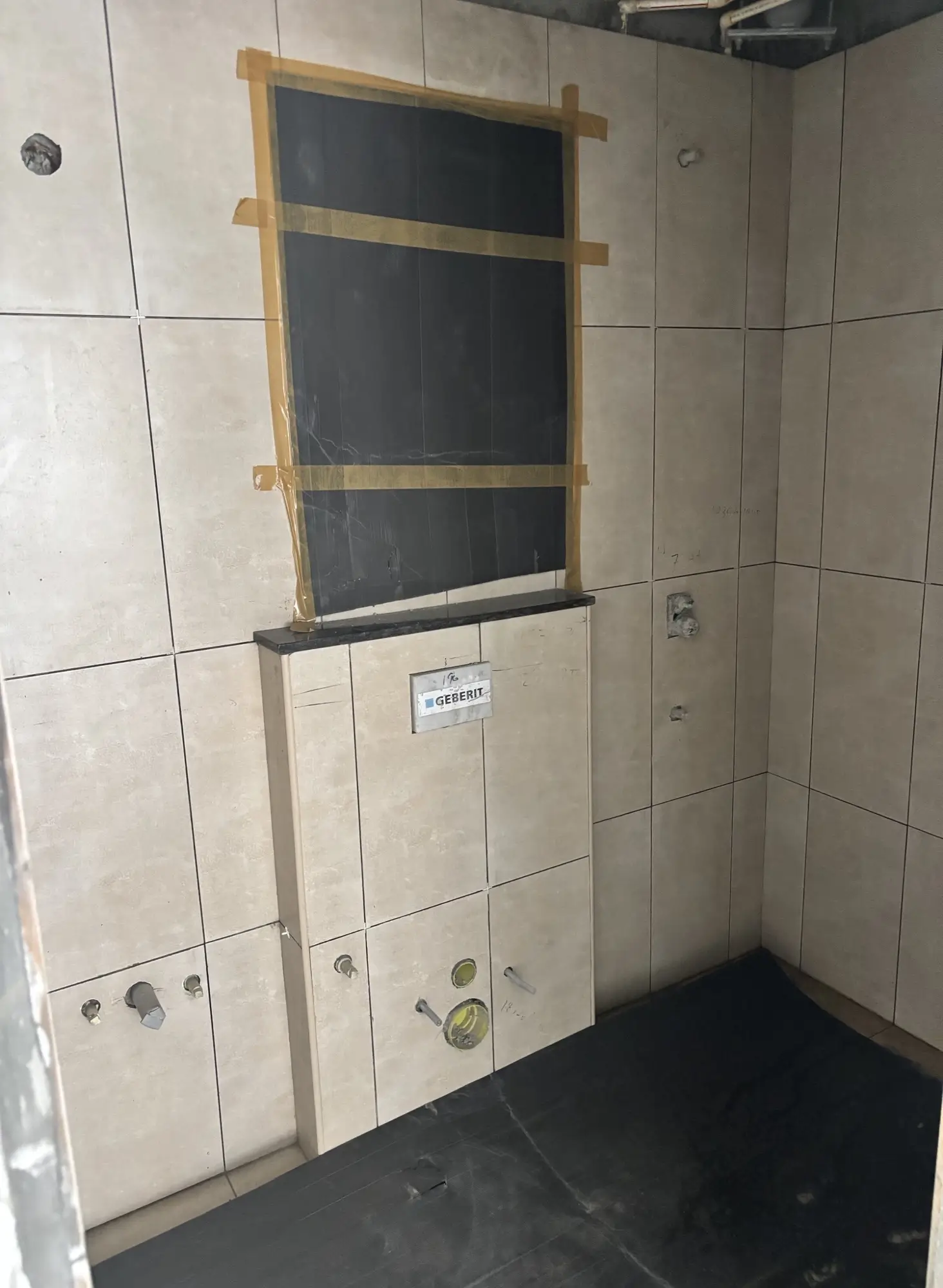

Flooring & CP, Sanitary fittings - Aug 2026

Flooring & CP, Sanitary fittings - Aug 2026

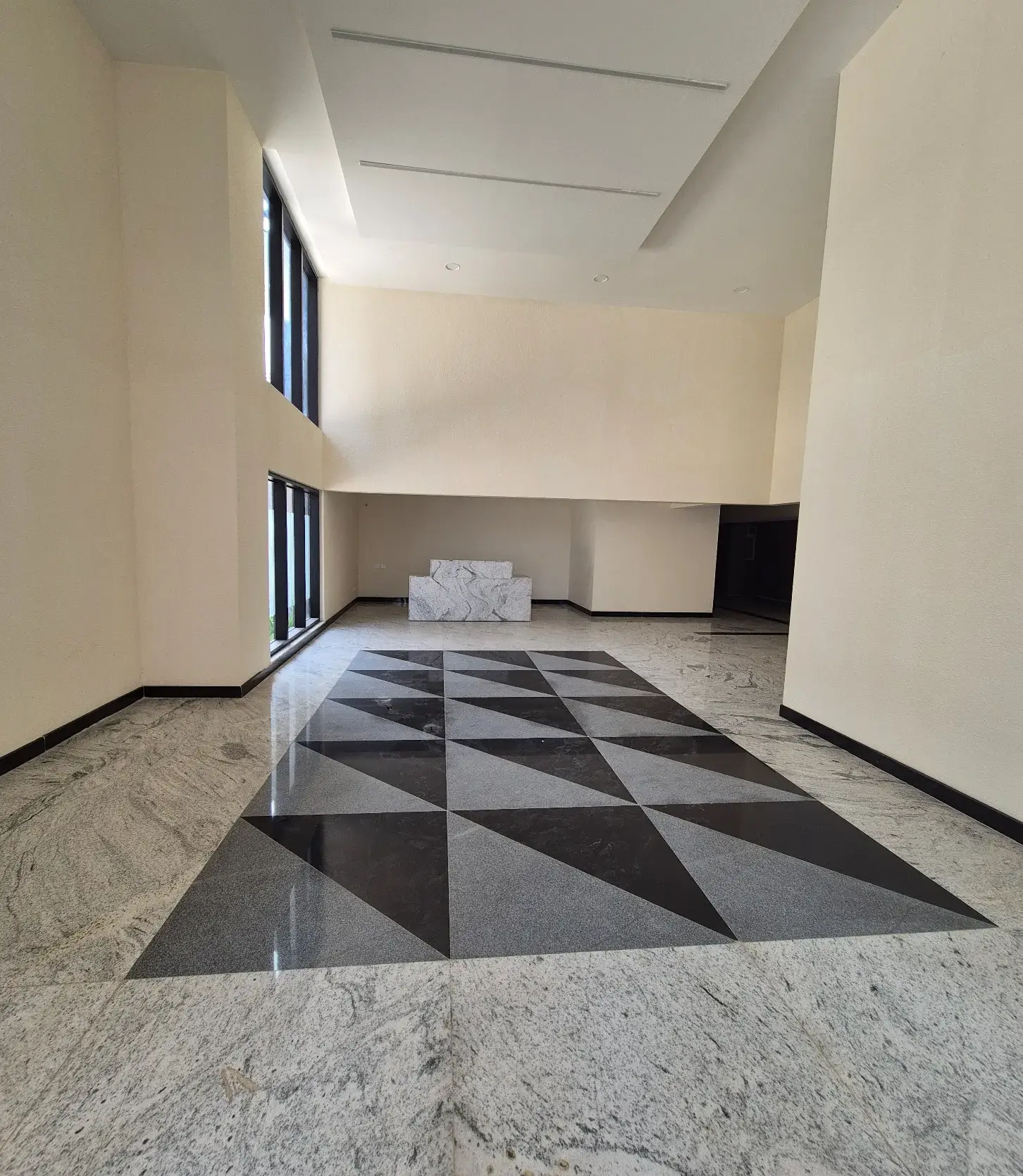

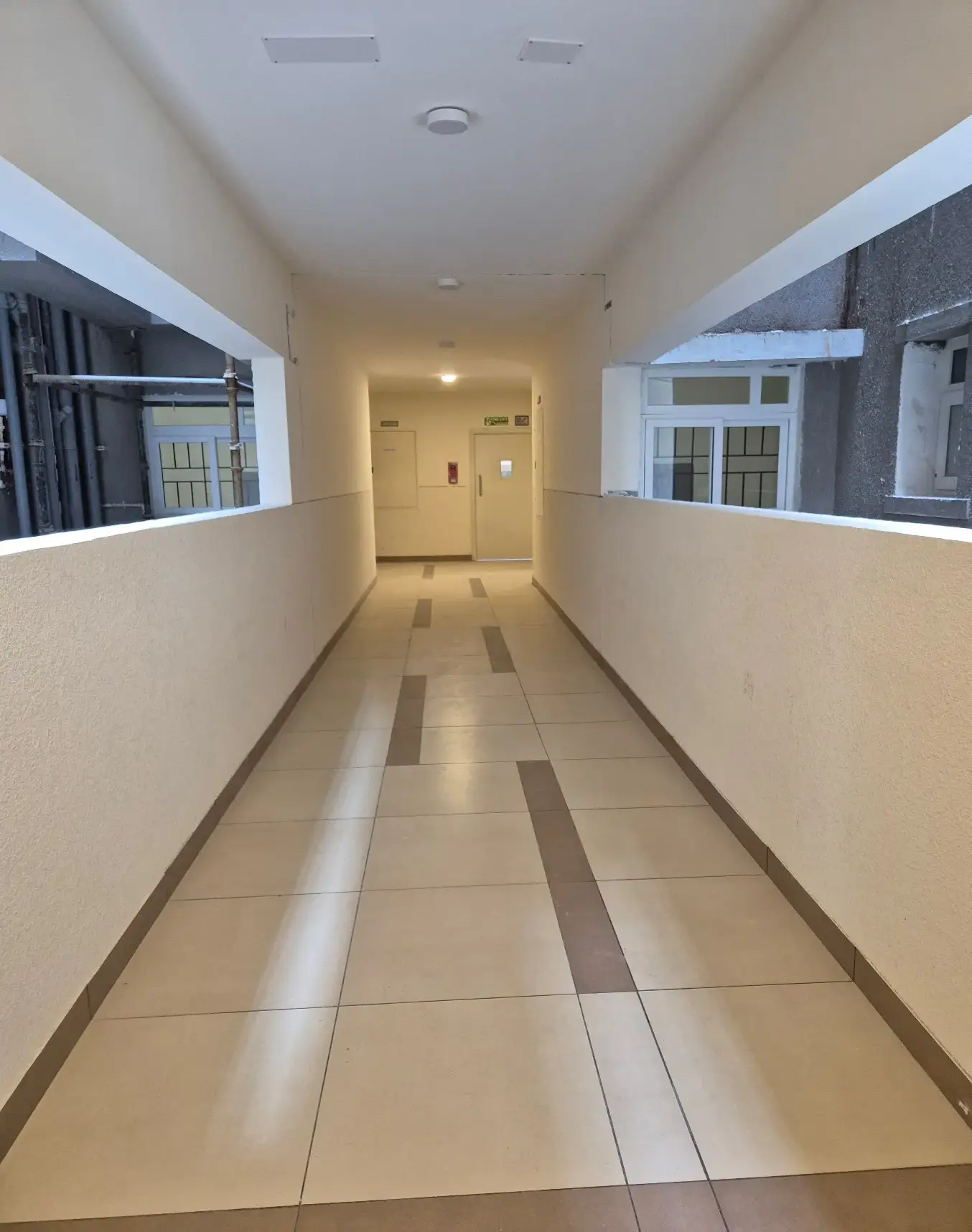

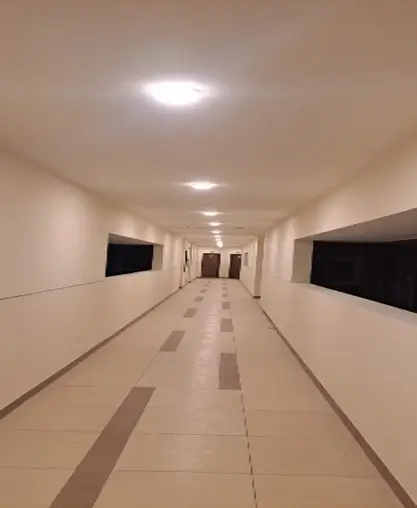

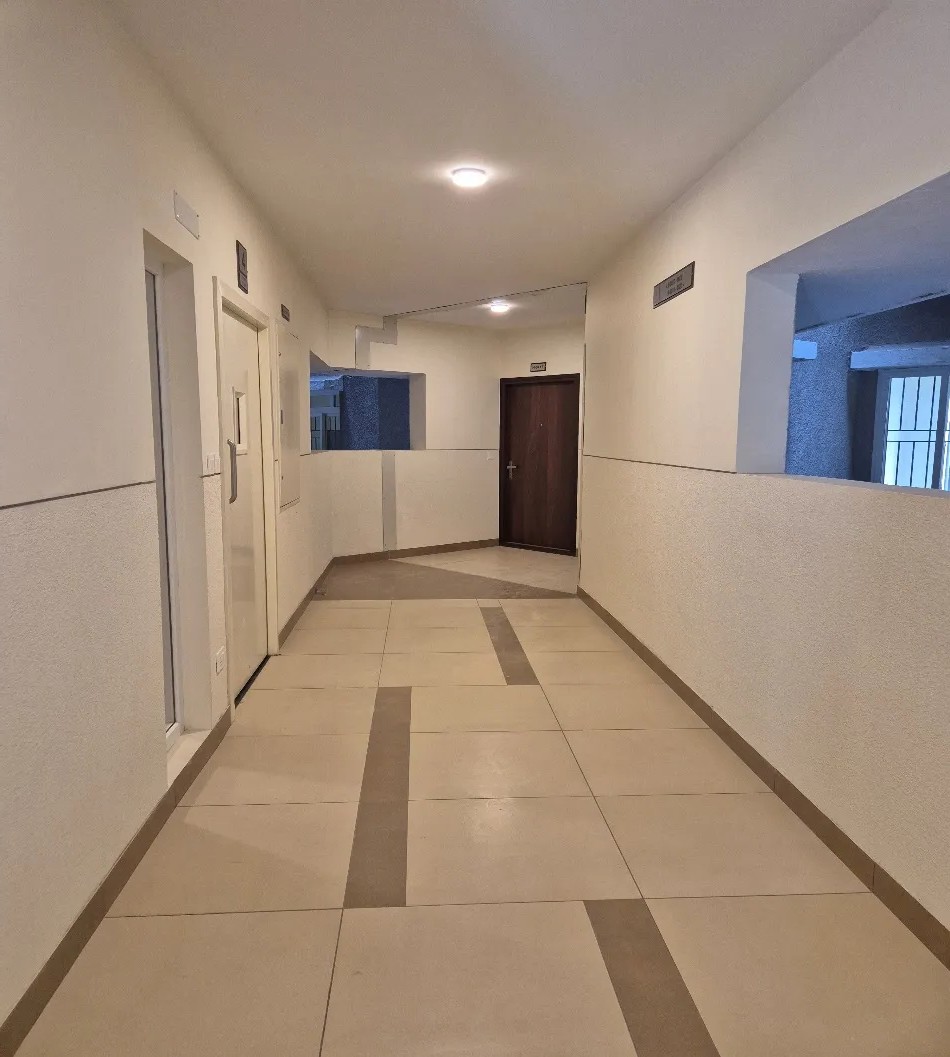

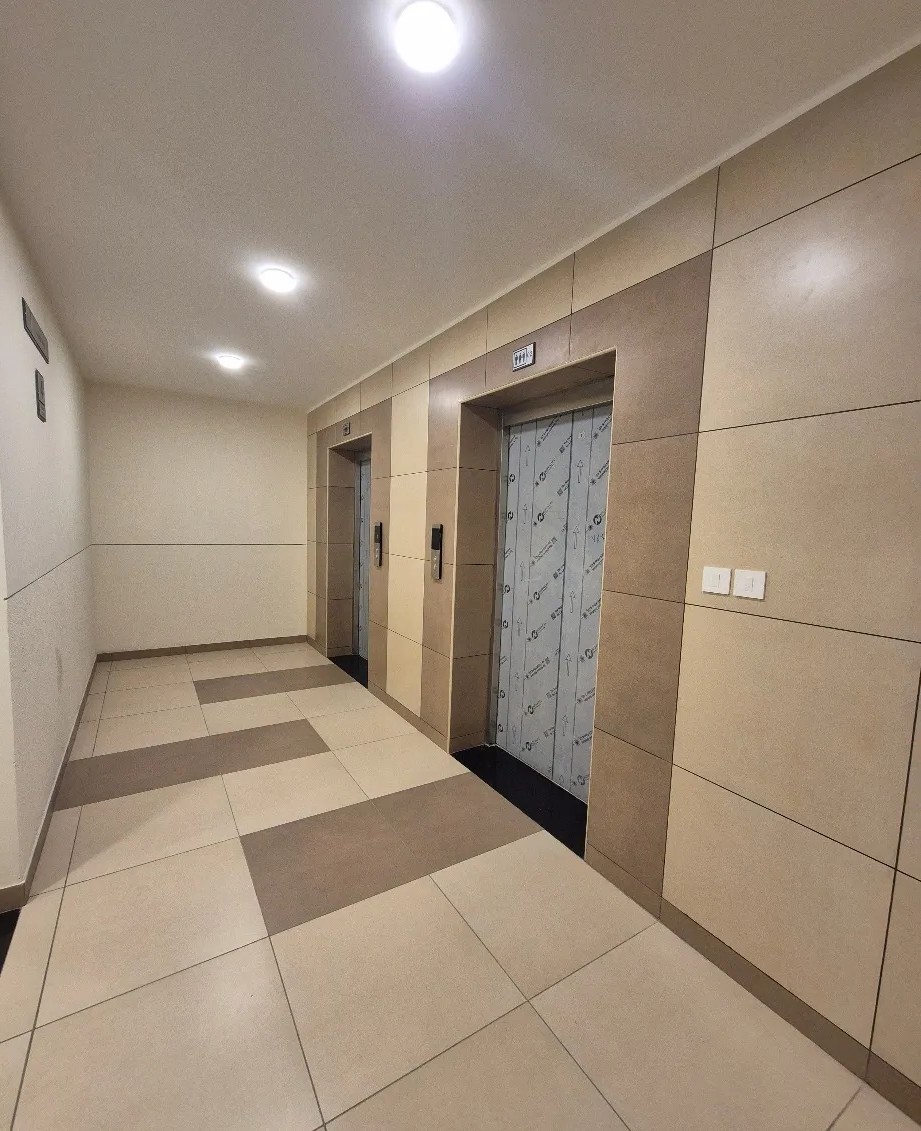

IVORY PHASE – 1 - Typical floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

IVORY PHASE – 1 - Typical floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

IVORY PHASE – 1 - Typical floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

IVORY PHASE – 1 - Typical floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

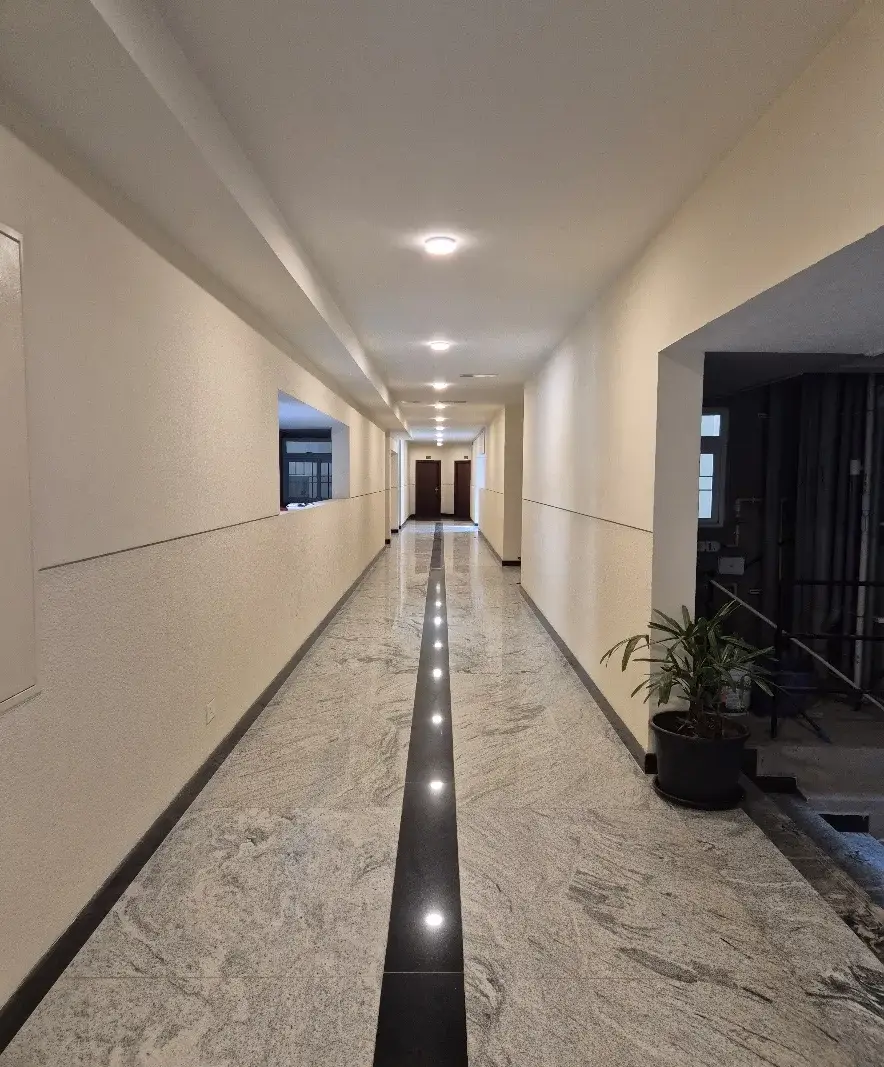

Ground floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

Ground floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

Ground floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

Ground floor Lift lobby and Corridor - Tower - G, H & I - Aug 2026

IVORY PHASE – 1 - Tower - G, H & I - Aug 2026

Electrical Panel Rooms - Aug 2026

IVORY PHASE – 1 - ELEVATION TOWER G, H, I - Aug 2026

IVORY PHASE – 1 - ELEVATION TOWER G, H, I - Aug 2026

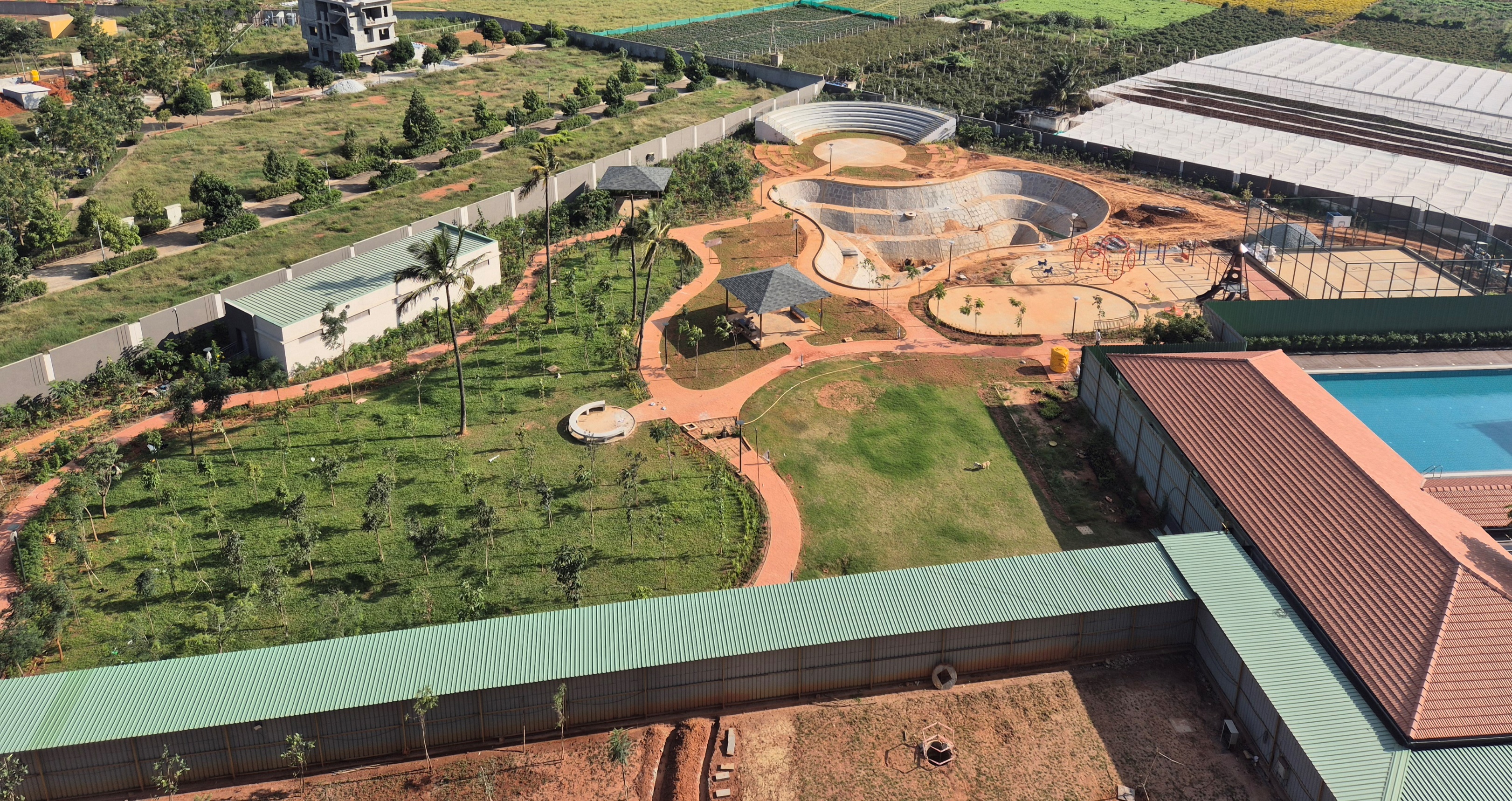

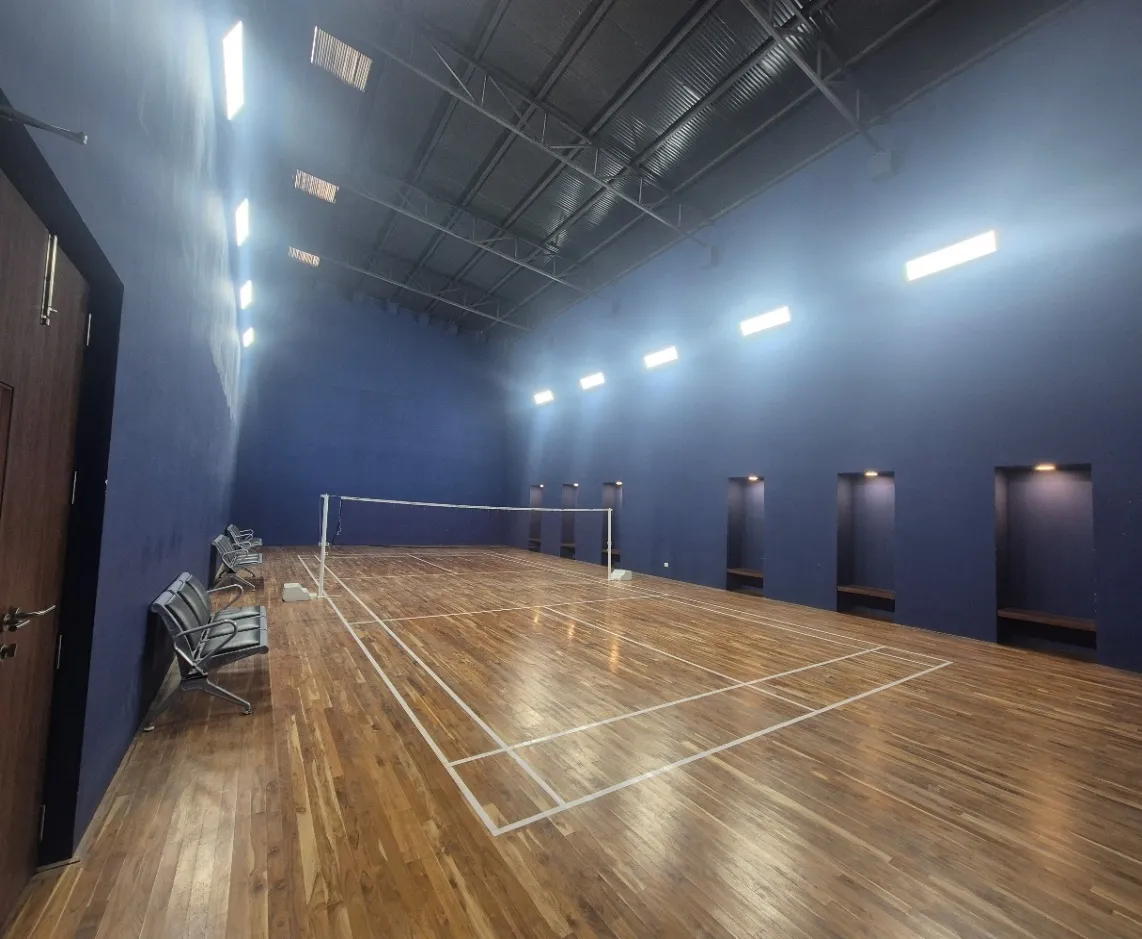

Gym, Badminton court and Swimming pool - Aug 2026

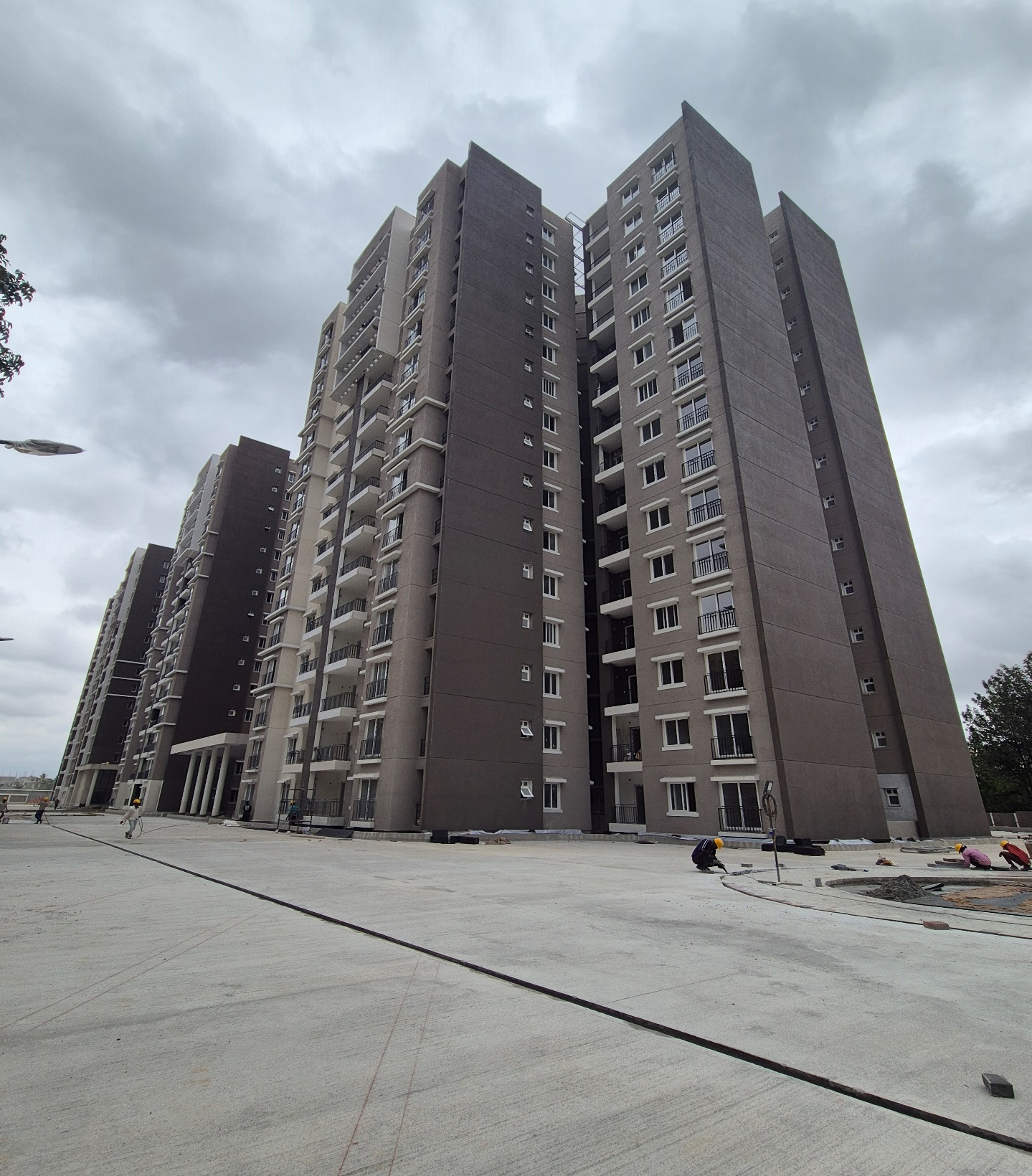

Gym, Badminton court and Swimming pool - Aug 2026

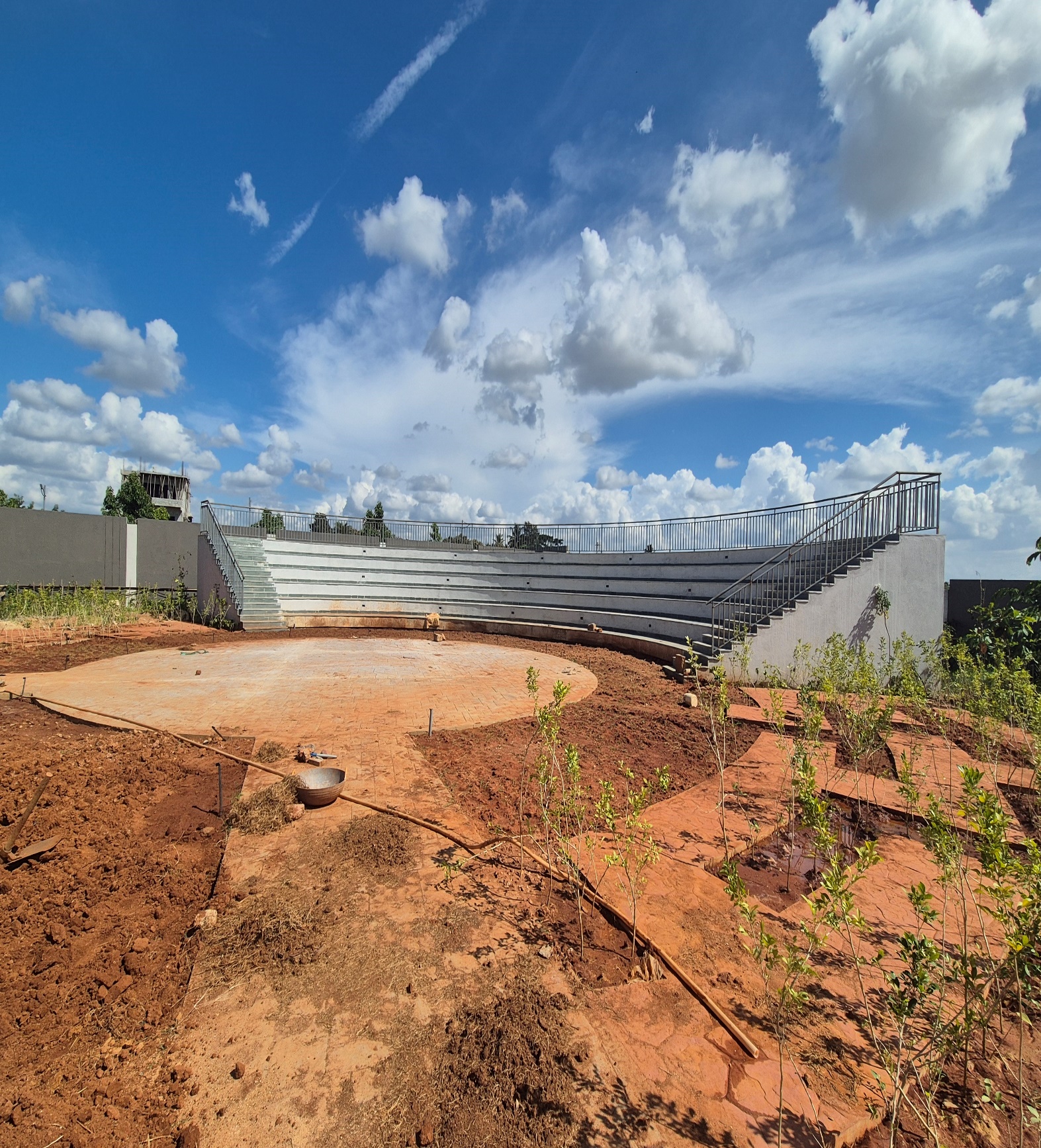

Pond, Amphitheatre & Jogging track - Aug 2026

Pond, Amphitheatre & Jogging track - Aug 2026

Pond, Amphitheatre & Jogging track - Aug 2026

Kids play area & Skating Rink - Aug 2026

Kids play area & Skating Rink - Aug 2026

Half basketball court & Seating pavilion - Aug 2026

Half basketball court & Seating pavilion - Aug 2026

STP and DG room - Aug 2026

STP and DG room - Aug 2026

STP and DG room - Aug 2026

STP and DG room - Aug 2026

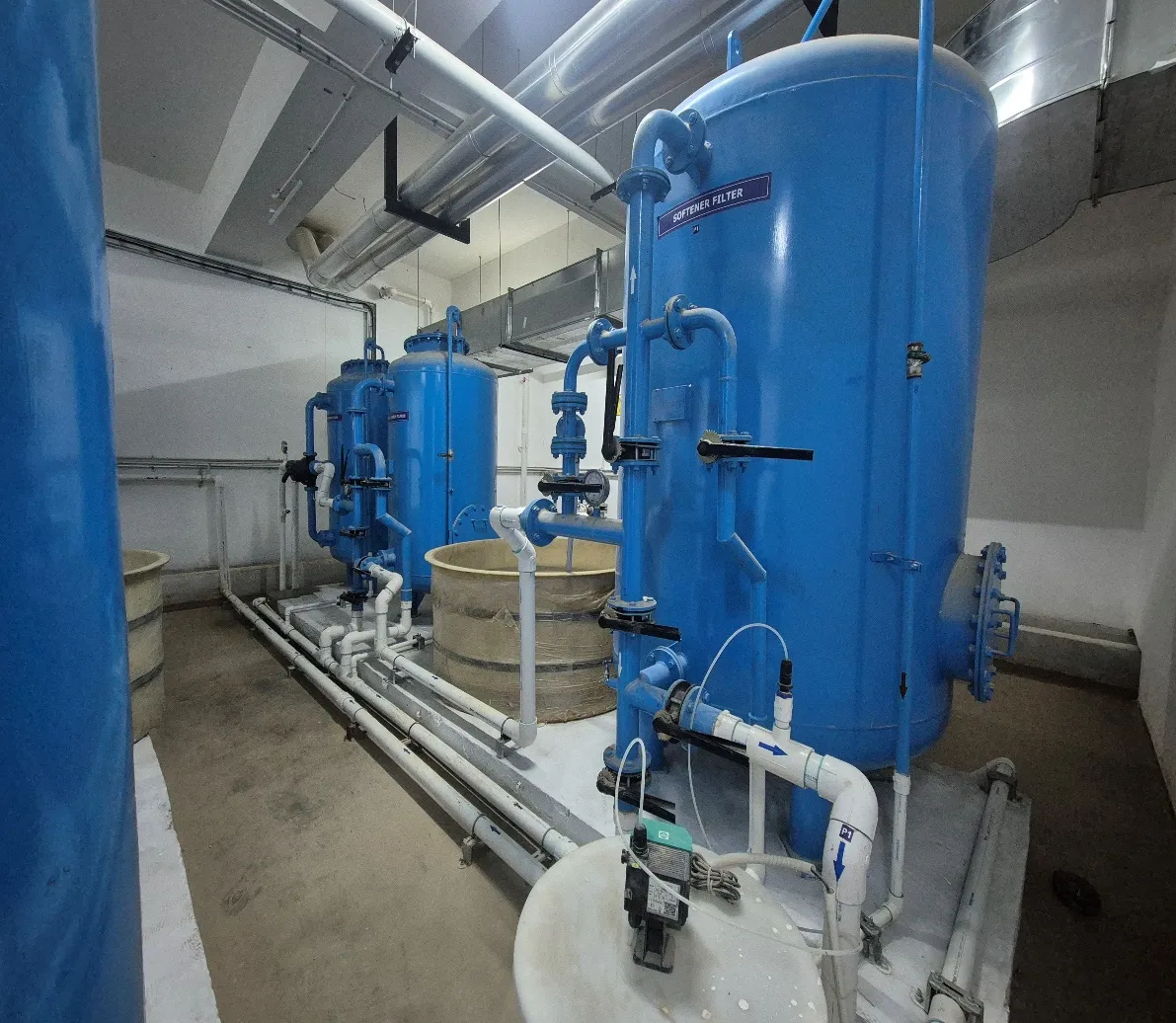

Pump room and WTP - Aug 2026

Pump room and WTP - Aug 2026

Pump room and WTP - Aug 2026

Pump room and WTP - Aug 2026

Basement - Aug 2026

Basement - Aug 2026

Basement - Aug 2026

Basement - Aug 2026

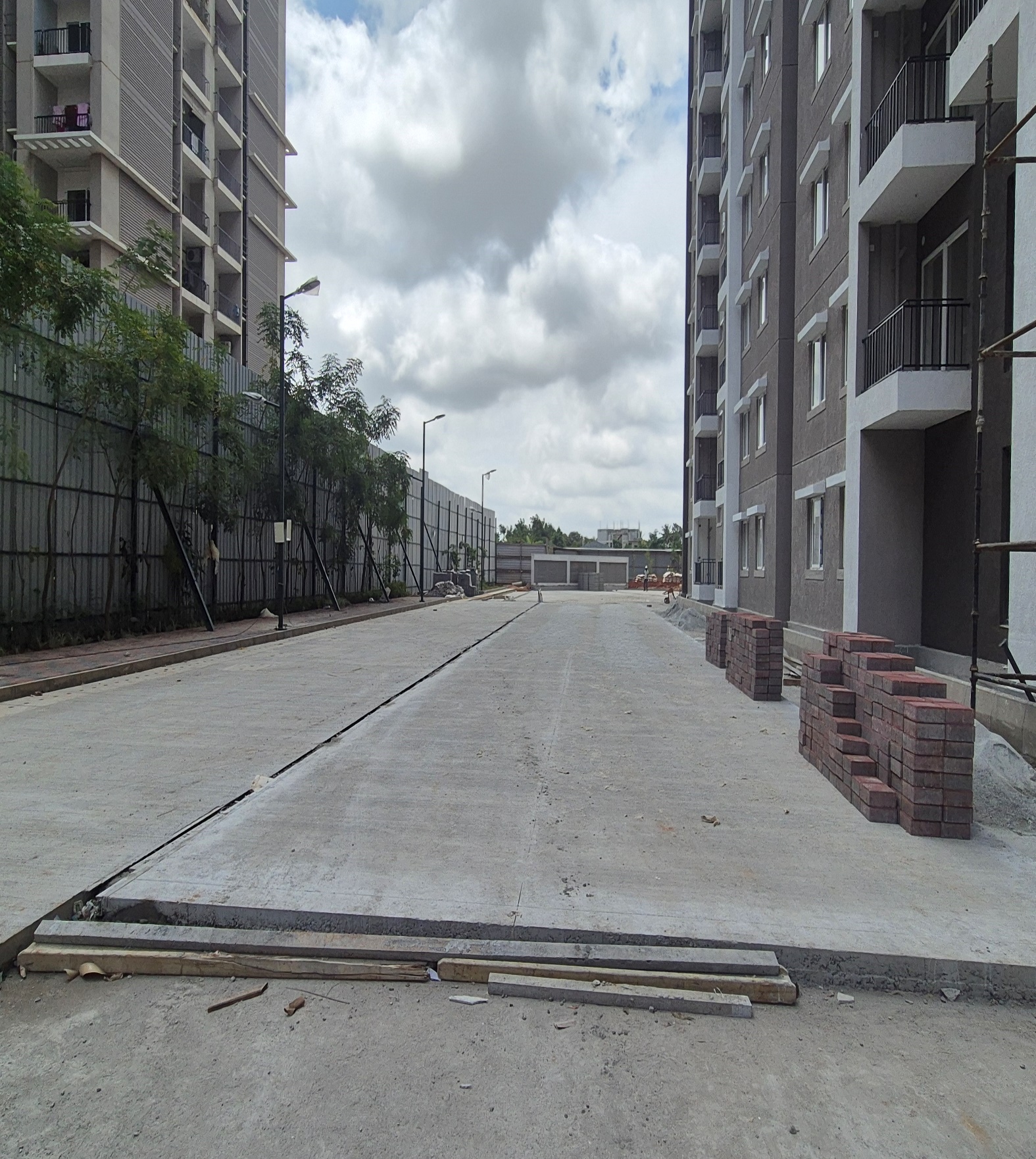

External Development - Jul 2026

Podium Waterproofing - Jul 2026

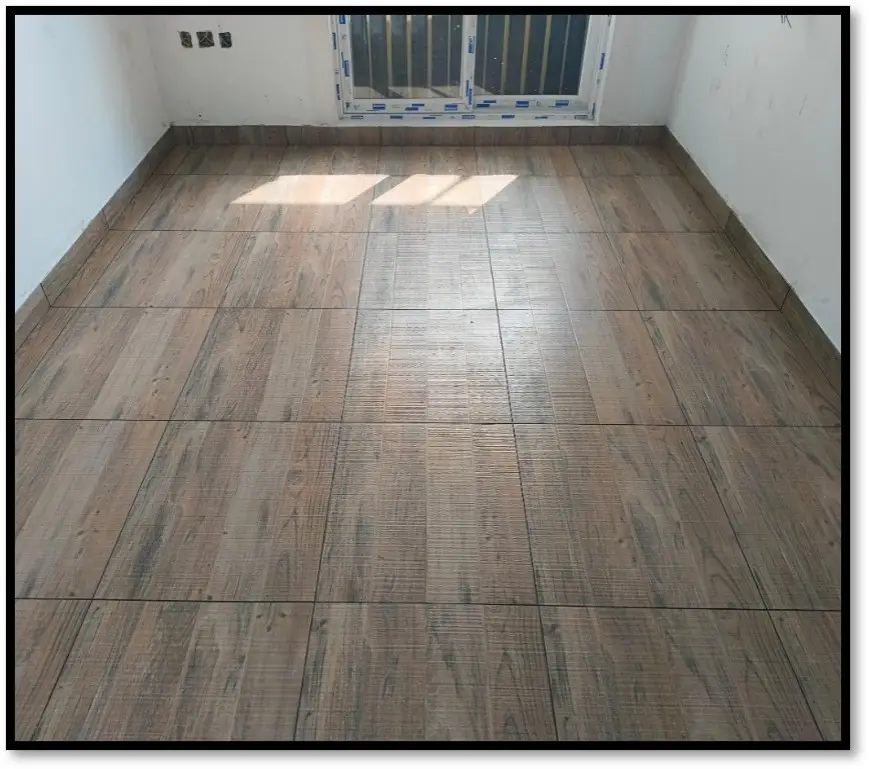

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ | Flooring - Jul 2026

External plastering - Jul 2026

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ | Flooring - Jul 2026

Blocks LKJ| Window Fixing Work In Progress - Jul 2026

Blocks LKJ| Window Fixing Work In Progress - Jul 2026

Blocks LKJ| Window Fixing Work In Progress - Jul 2026

External plastering - Jul 2026

Blocks LKJ| Window Fixing Work In Progress - Jul 2026

Blocks JKL| Fixing of Doors - Jul 2026

Blocks JKL | Internal Painting - Jul 2026

Blocks JKL | Internal Painting - Jul 2026

Blocks JKL | Internal Painting - Jul 2026

External Development - Jul 2026

Podium Waterproofing - Jul 2026

Blocks JKL| Fixing of Doors - Jul 2026

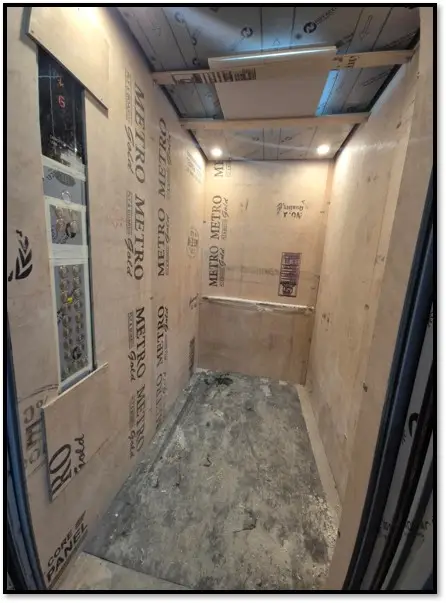

Blocks JKL | Lift Installation Completed - Jul 2026

Blocks JKL | Lift Installation Completed - Jul 2026

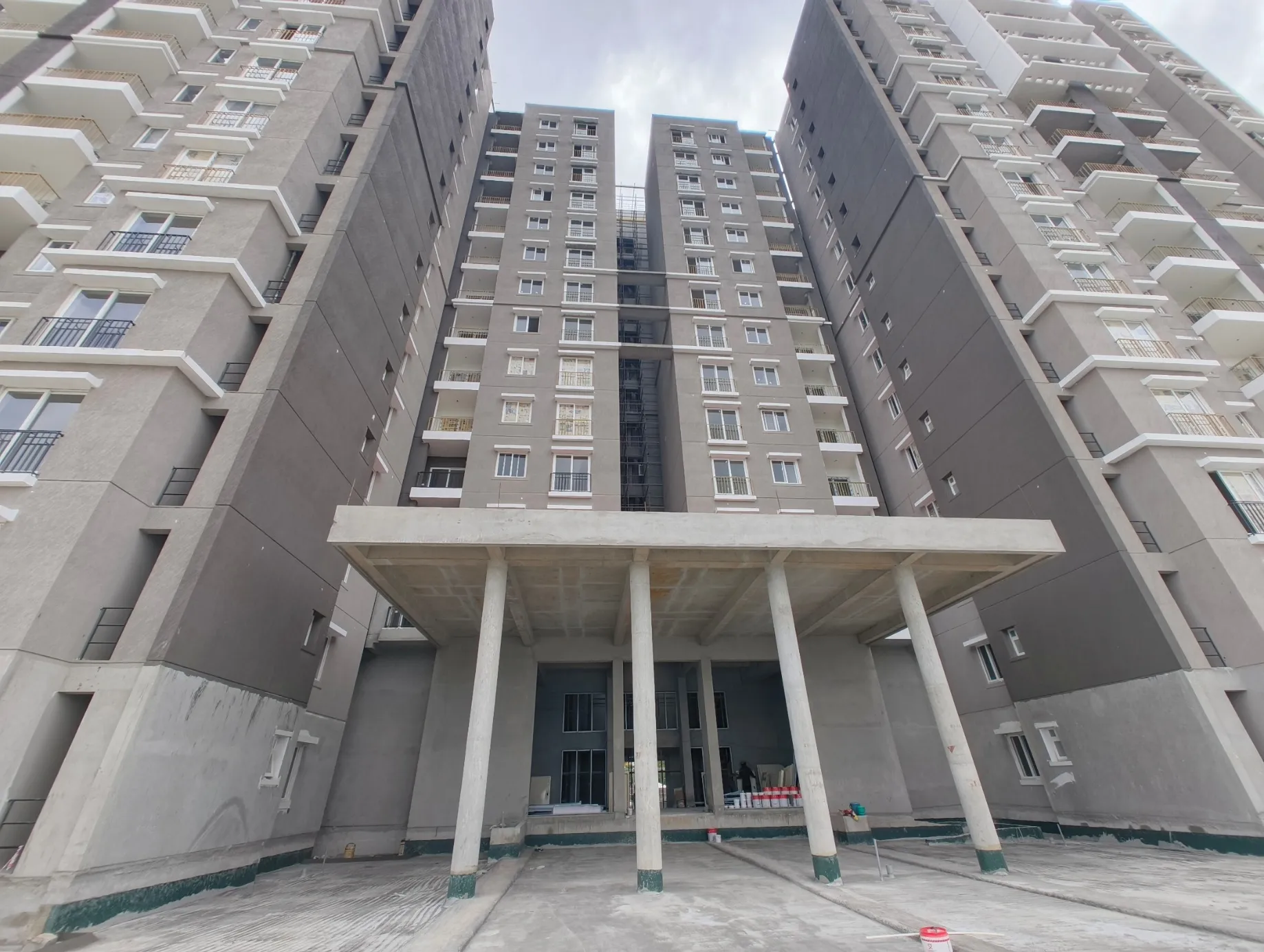

Blocks JKL | Texture paint work - Jul 2026

Block JKL | Texture paint work - Jul 2026

Block JKL | Texture paint work - Jul 2026

Blocks JKL | Texture Paint work - Jul 2026

Blocks JKL | Texture Paint work - Jul 2026

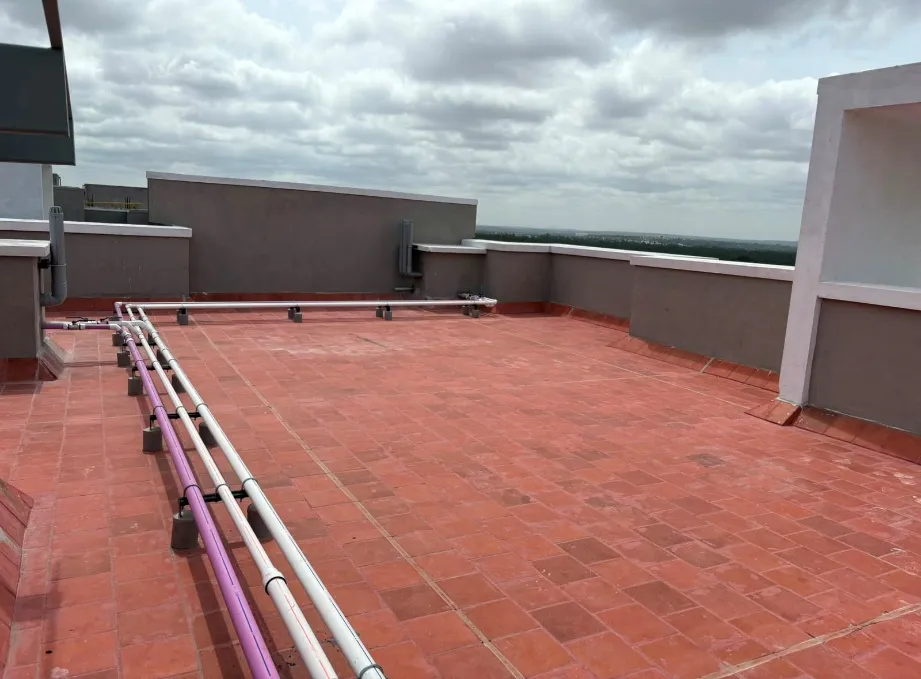

Basement & Terrace - Jul 2026

Basement & Terrace - Jul 2026

Basement & Terrace - Jul 2026

Basement & Terrace - Jul 2026

Blocks JKL |Corridor work - Jul 2026

Blocks JKL |Corridor work - Jul 2026

Blocks JKL | Internal Painting - Jul 2026

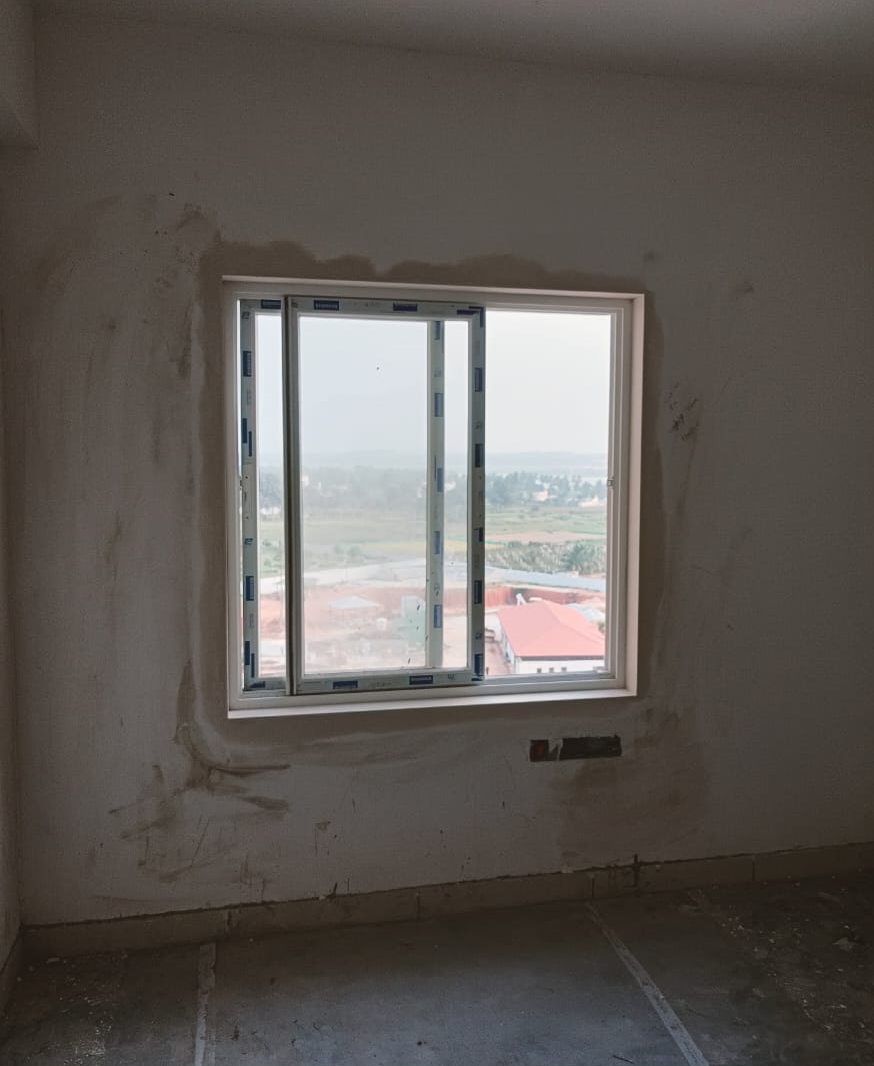

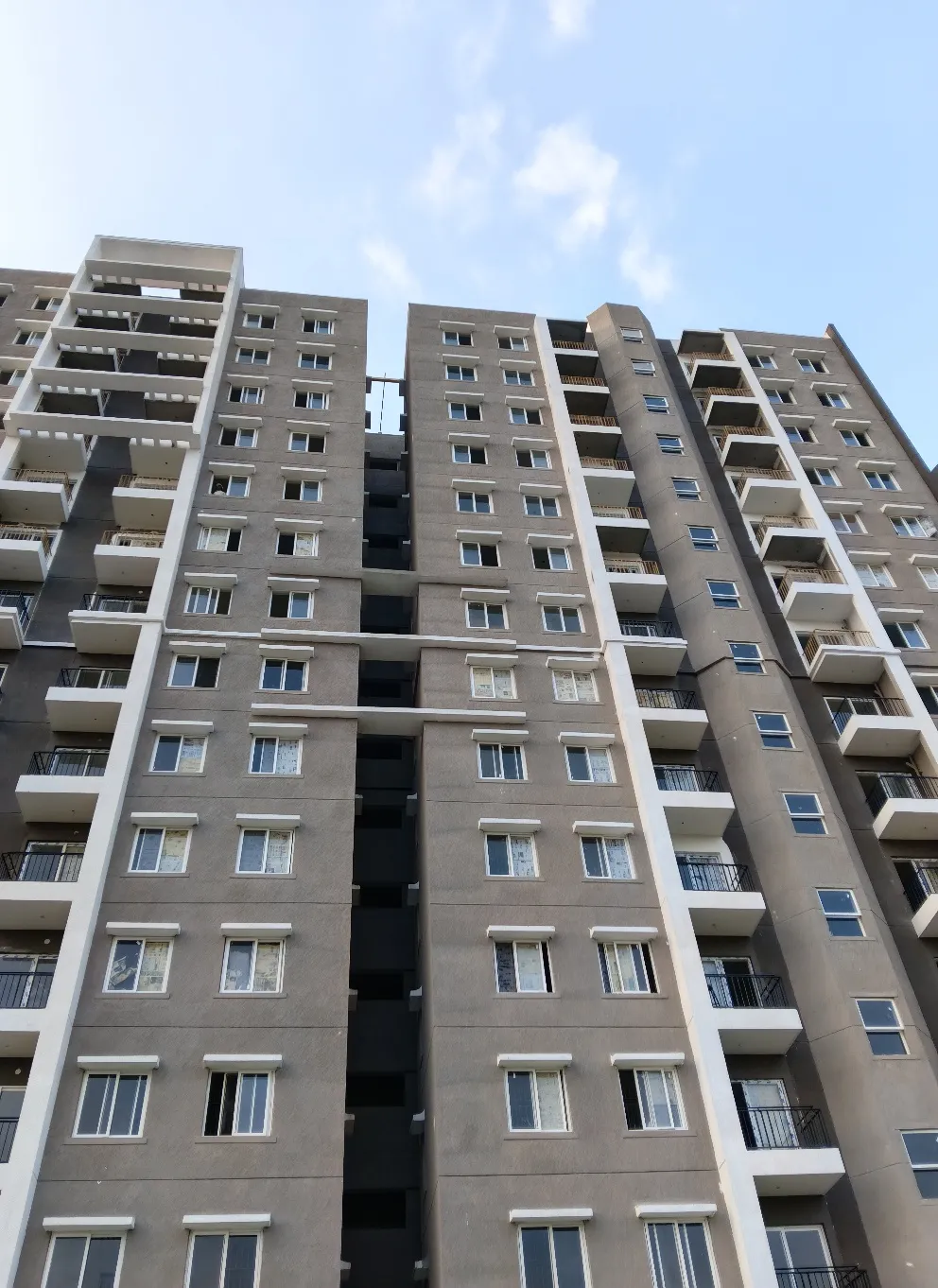

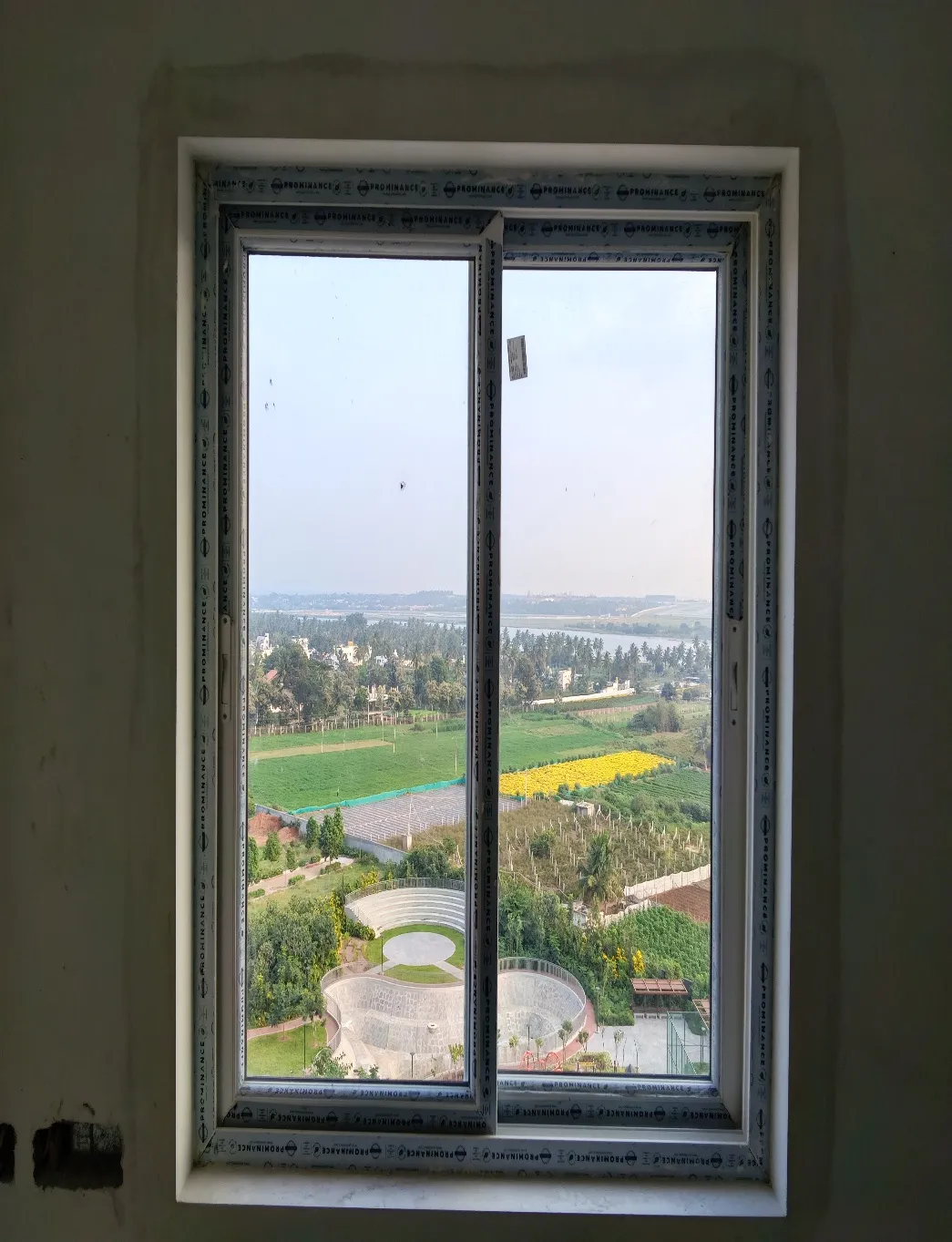

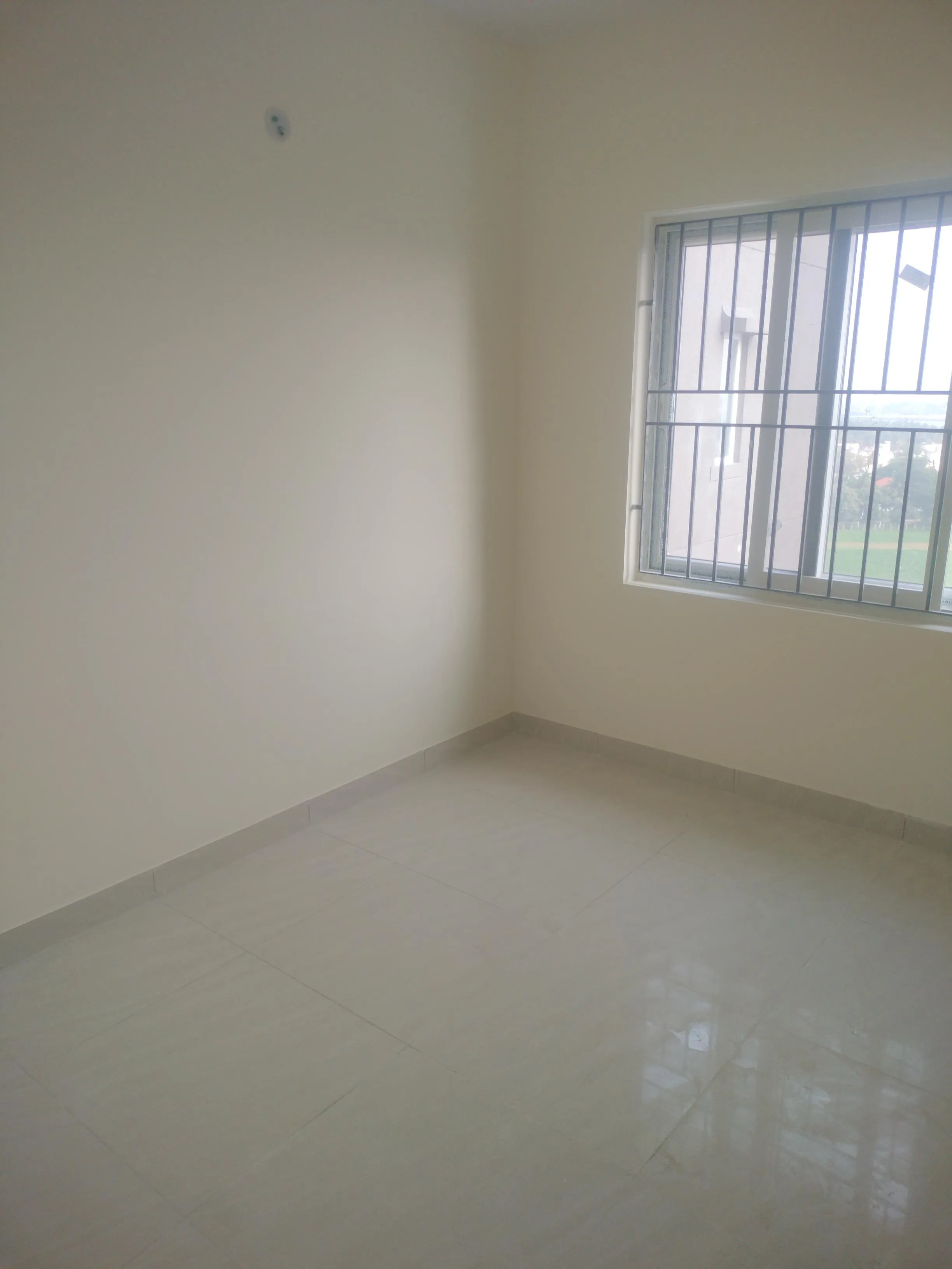

Tower L - Milestone Release -"On commencement of Installation of Lifts" - Status as on 03rd - Jun 2026

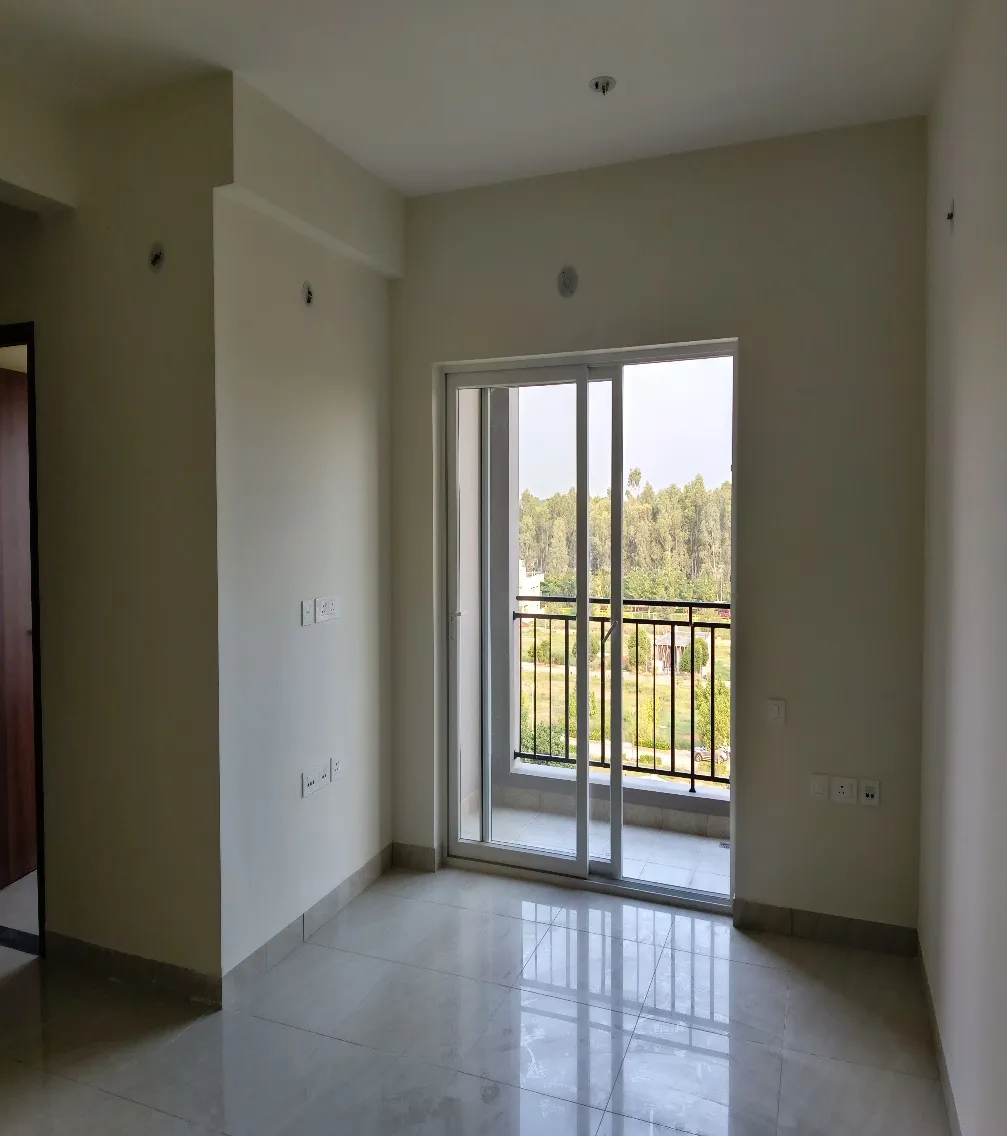

Tower K - Milestone Release -"On Commencement of Flooring (5th -15th Floor)" - Status as on 03rd - Jun 2026

Tower K - Milestone Release -"On commencement of Installation of Lifts" - Status as on 03rd - Jun 2026

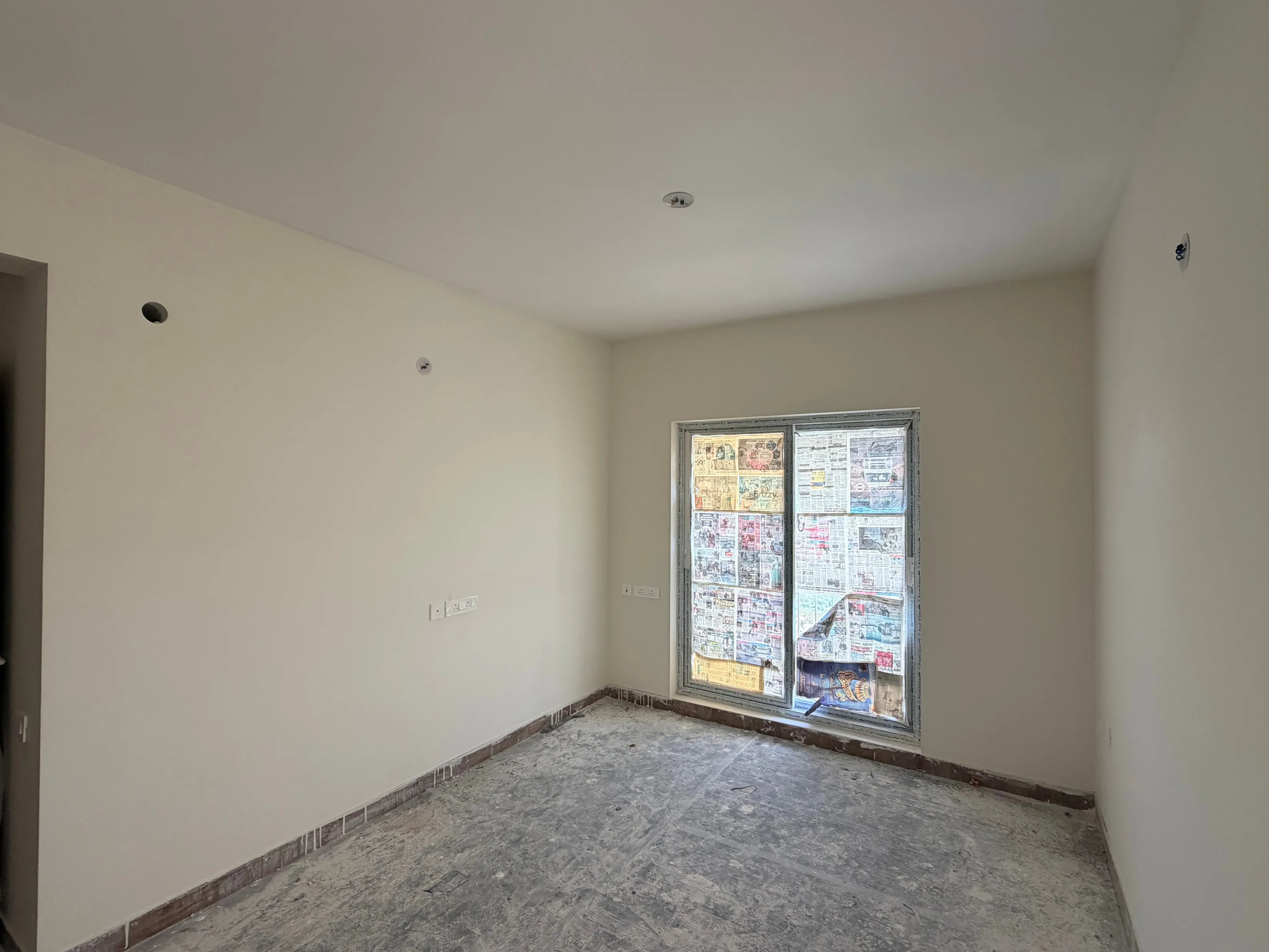

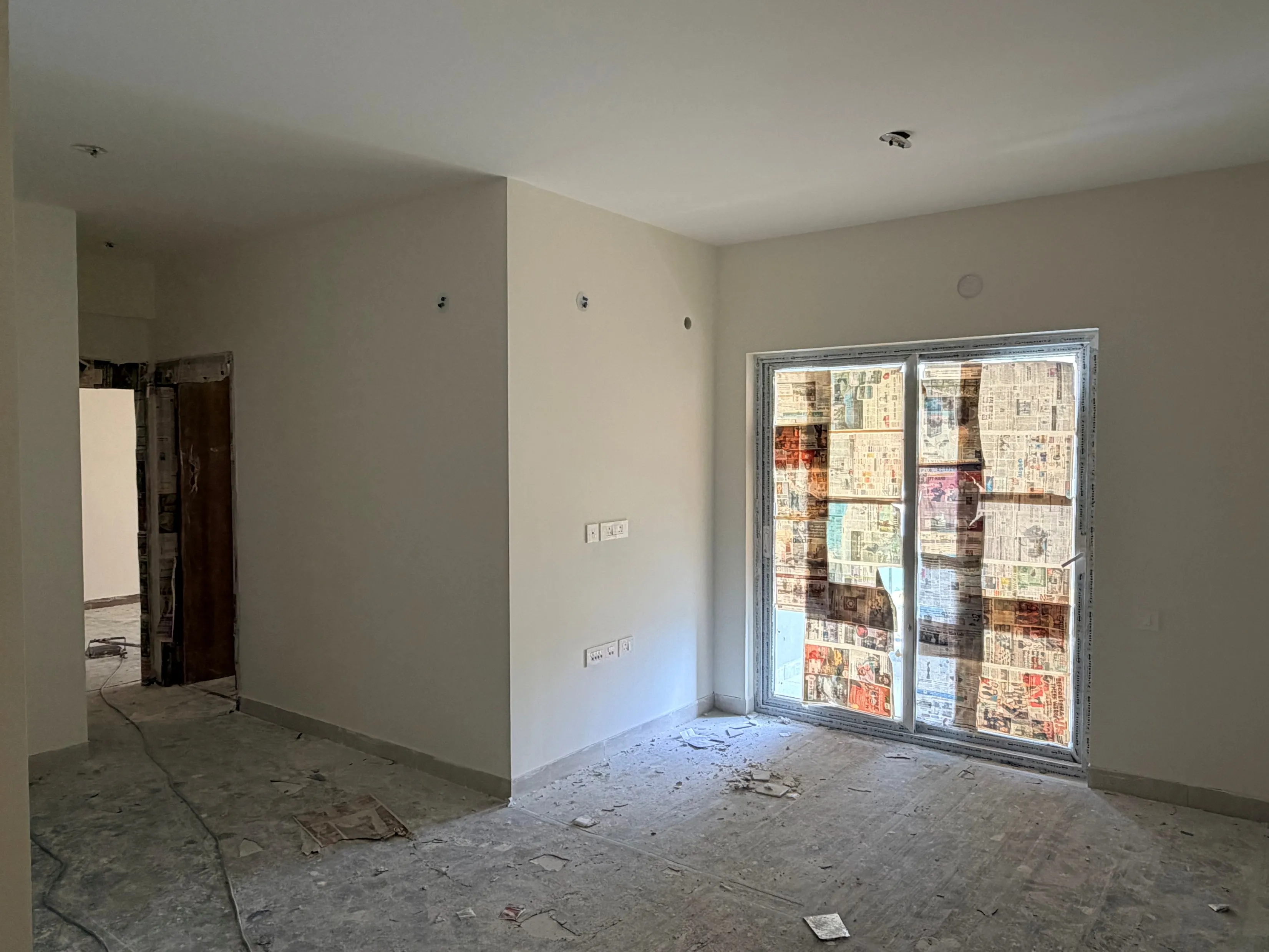

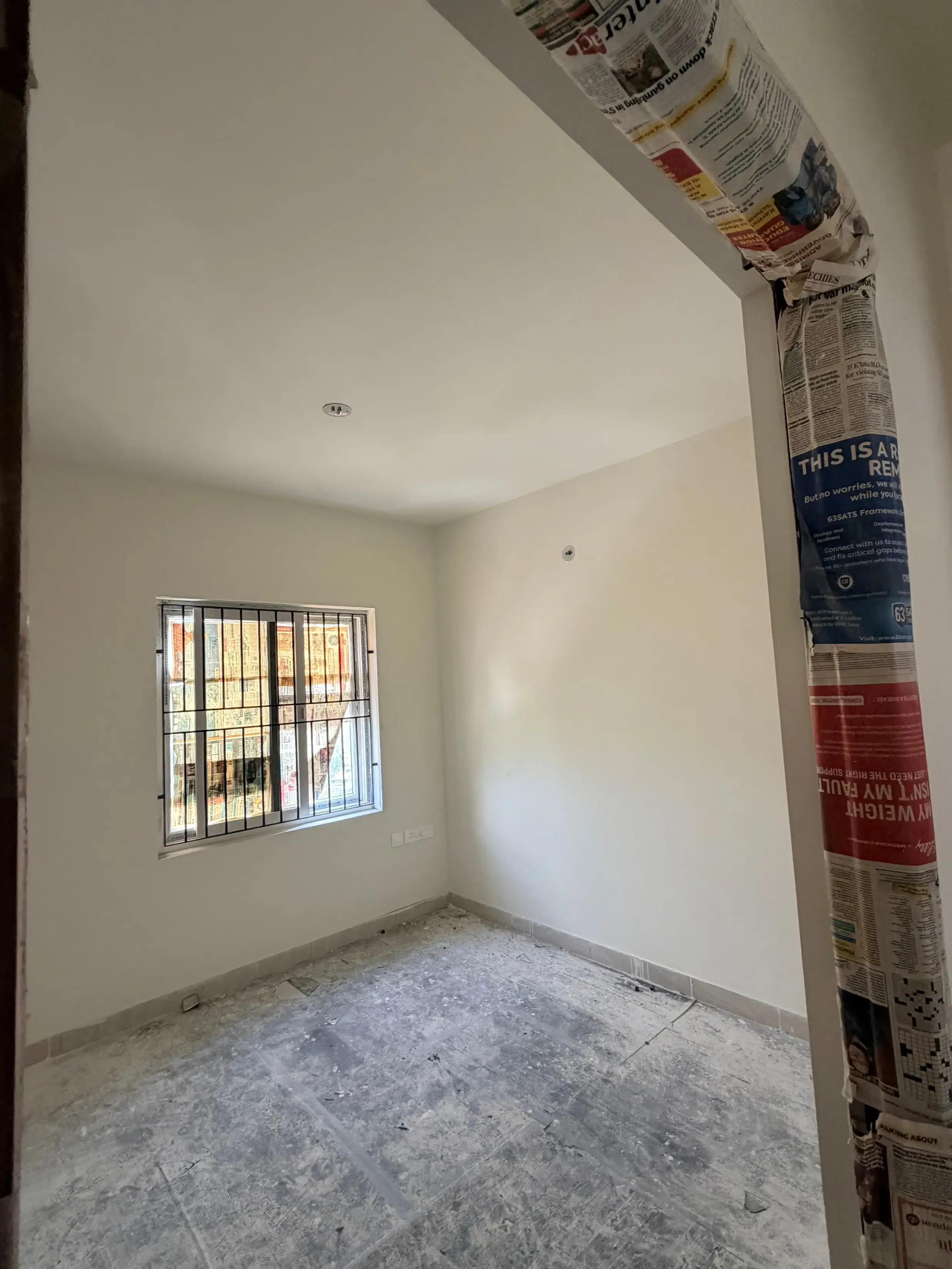

Tower L - Milestone Release -"On Commencement of Flooring (5th -15th Floor)" - Status as on 03rd - Jun 2026

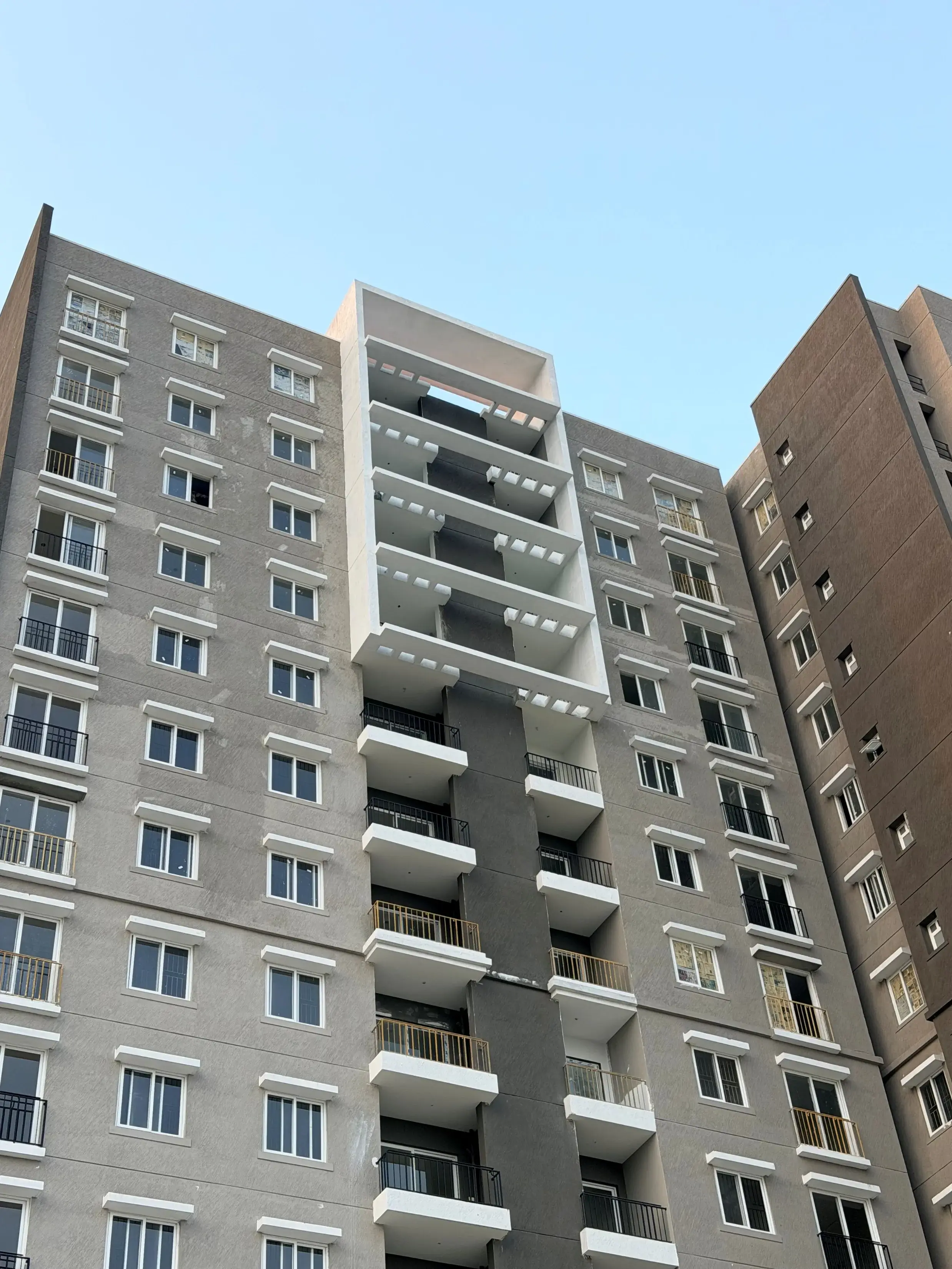

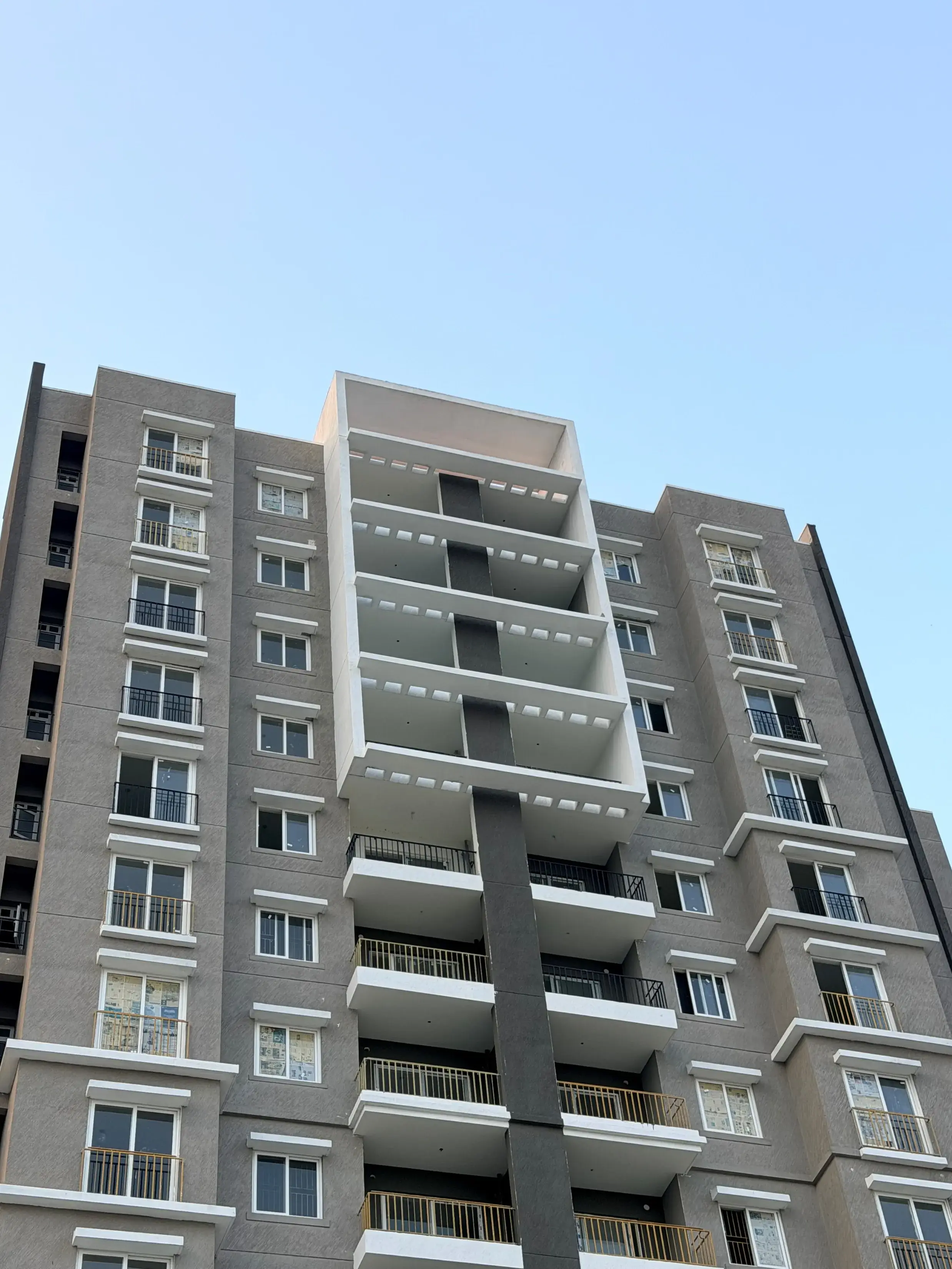

Tower J - Milestone Release -"On Commencement of Flooring (5th -15th Floor)" - Status as on 03rd - Jun 2026

Blocks JKL | Window Fixing Work In Progress - May 2026

External Plaster - GF TO TERRACE - May 2026

Blocks JKL | Flooring completed - May 2026

Blocks JKL | Flooring completed - May 2026

Blocks JKL | Flooring completed - May 2026

Blocks JKL | Flooring completed - May 2026

Blocks JKL | Window Fixing Work In Progress - May 2026

Blocks JKL | Window Fixing Work In Progress - May 2026

Blocks JKL | Window Fixing Work In Progress - May 2026

Blocks JKL | Fixing of doors in progress - May 2026

Blocks JKL | Fixing of doors in progress - May 2026

Blocks JKL | Internal Painting work in progress - May 2026

Blocks JKL | Internal Painting work in progress - May 2026

Blocks JKL | Internal Painting work in progress - May 2026

Blocks JKL | Internal Painting work in progress - May 2026

Blocks JKL | Texture & Painting work In Progress - May 2026

Blocks JKL | Texture & Painting work In Progress - May 2026

Blocks JKL | Texture & Painting Work In Progress - May 2026

Blocks JKL | Texture & Painting Work In Progress - May 2026

External Plaster - GF TO TERRACE - May 2026

Podium Waterproofing - May 2026

Podium Waterproofing - May 2026

External Plastering work is in progress - Apr 2026

External Plastering work is in progress - Apr 2026

Grouting - Apr 2026

Grouting - Apr 2026

JKL Block |Flooring completed - Apr 2026

JKL Block |Flooring completed - Apr 2026

JKL Block |Flooring completed - Apr 2026

JKL Block |Flooring completed - Apr 2026

JKL Blocks |Fixing of Windows In progress - Apr 2026

JKL Blocks |Fixing of Windows In progress - Apr 2026

JKL Blocks |Fixing of Windows In progress - Apr 2026

JKL Blocks |Fixing of Windows In progress - Apr 2026

JKL Blocks | Installation of Doors in progress - Apr 2026

JKL Blocks | Installation of Doors in progress - Apr 2026

JKL Block |Texture & Paint Work In Progress - Apr 2026

JKL Block |Texture & Paint Work In Progress - Apr 2026

JKL Block Internal Painting work in progress - Apr 2026

JKL Block Internal Painting work in progress - Apr 2026

JKL Block Internal Painting work in progress - Apr 2026

Podium Waterproofing work in progress - Apr 2026

Podium Waterproofing work in progress - Apr 2026

External plaster - Mar 2026

External plaster - Mar 2026

External plaster - Mar 2026

L,K& J Window Fixing Work In Progress - Mar 2026

L,K& J Window Fixing Work In Progress - Mar 2026

L,K& J Window Fixing Work In Progress - Mar 2026

L,K& J Window Fixing Work In Progress - Mar 2026

L,K& J Door Work in progress - Mar 2026

L,K& J Door Work in progress - Mar 2026

J,K & L Block Texture & Paint Work In Progress - Mar 2026

J,K & L Block Texture & Paint Work In Progress - Mar 2026

J,K & L Block Internal Painting WIP - Mar 2026

J,K & L Block Internal Painting WIP - Mar 2026

J,K & L Block Internal Painting WIP - Mar 2026

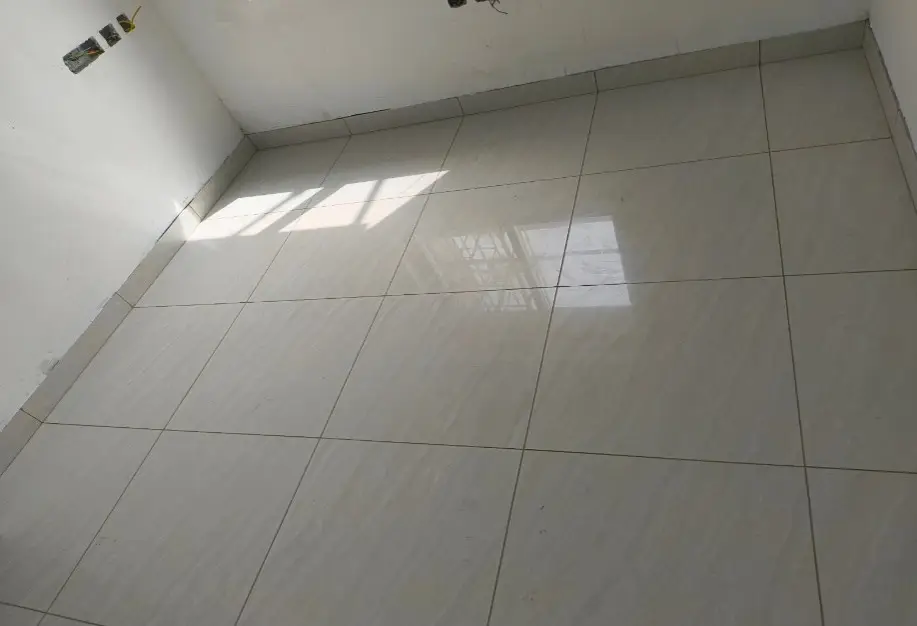

Flooring - Mar 2026

Flooring - Mar 2026

Flooring - Mar 2026

Flooring - Mar 2026

Flooring - Mar 2026

Flooring - Mar 2026

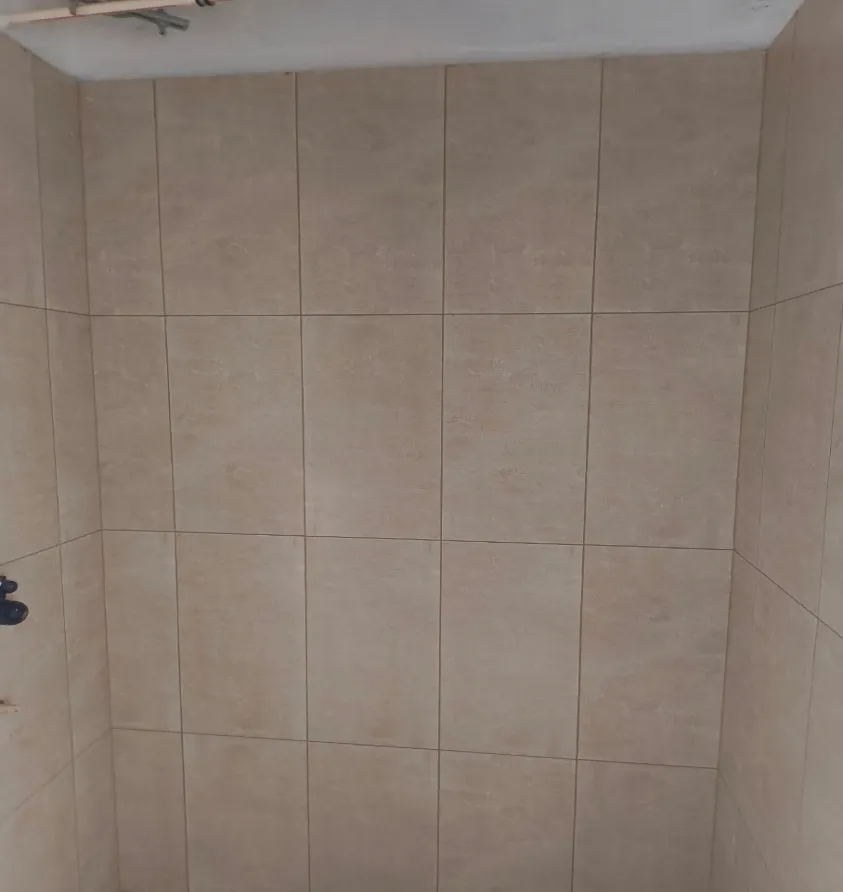

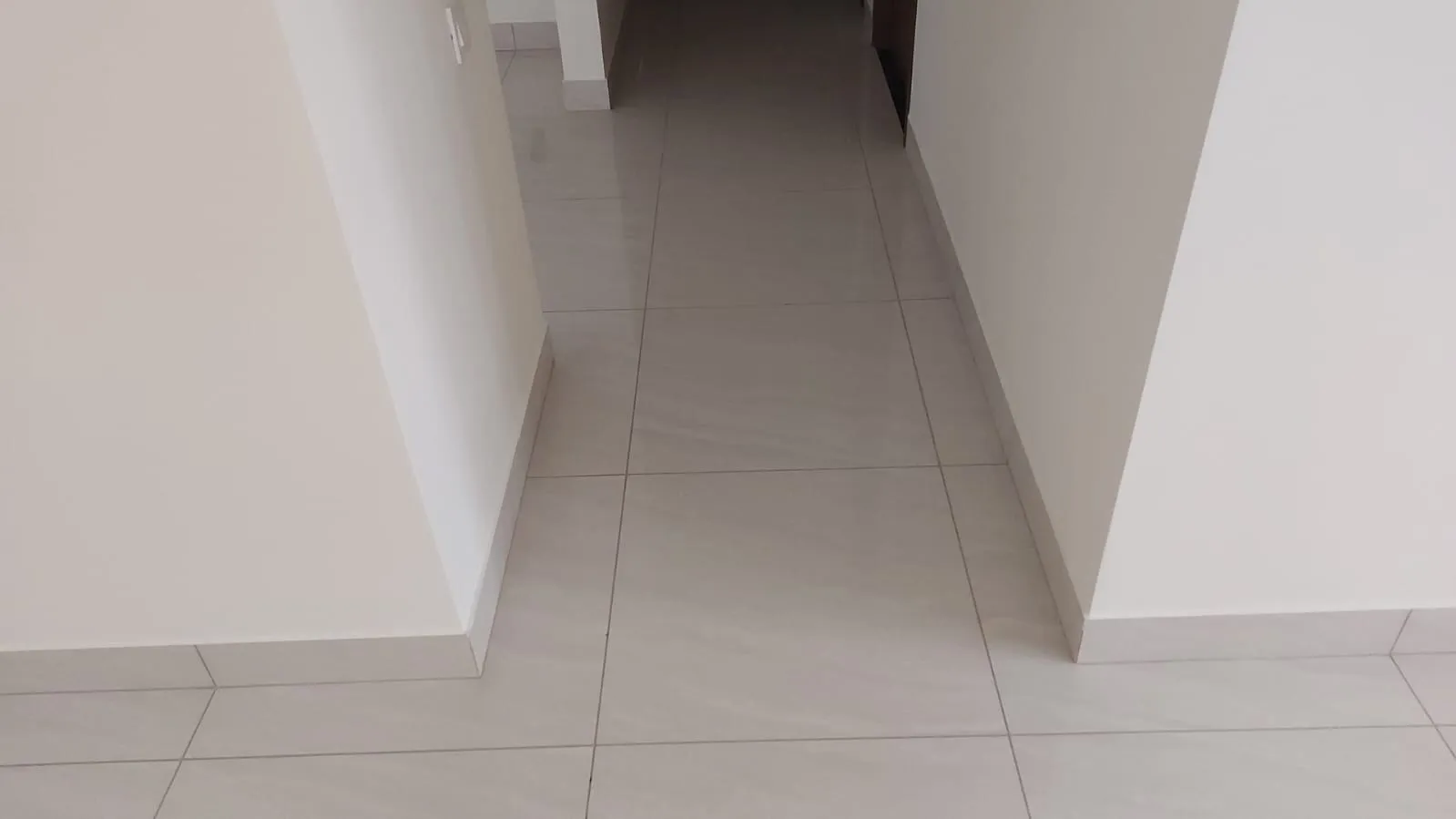

Flooring work - Feb 2026

External Plaster - GF To Terrace in progress - Feb 2026

External Plaster - GF To Terrace in progress - Feb 2026

Flooring work - Feb 2026

Flooring work - Feb 2026

Flooring work - Feb 2026

Flooring work - Feb 2026

Flooring work - Feb 2026

L,K& J |Window Fixing Work In Progress - Feb 2026

L,K& J |Window Fixing Work In Progress - Feb 2026

L,K& J |Window Fixing Work In Progress - Feb 2026

L,K& J |Window Fixing Work In Progress - Feb 2026

L,K& J | Fixing of Doors Work in progress - Feb 2026

L,K& J | Fixing of Doors Work in progress - Feb 2026

J,K & L Block |Texture & Paint Work In Progress - Feb 2026

J,K & L Block |Texture & Paint Work In Progress - Feb 2026

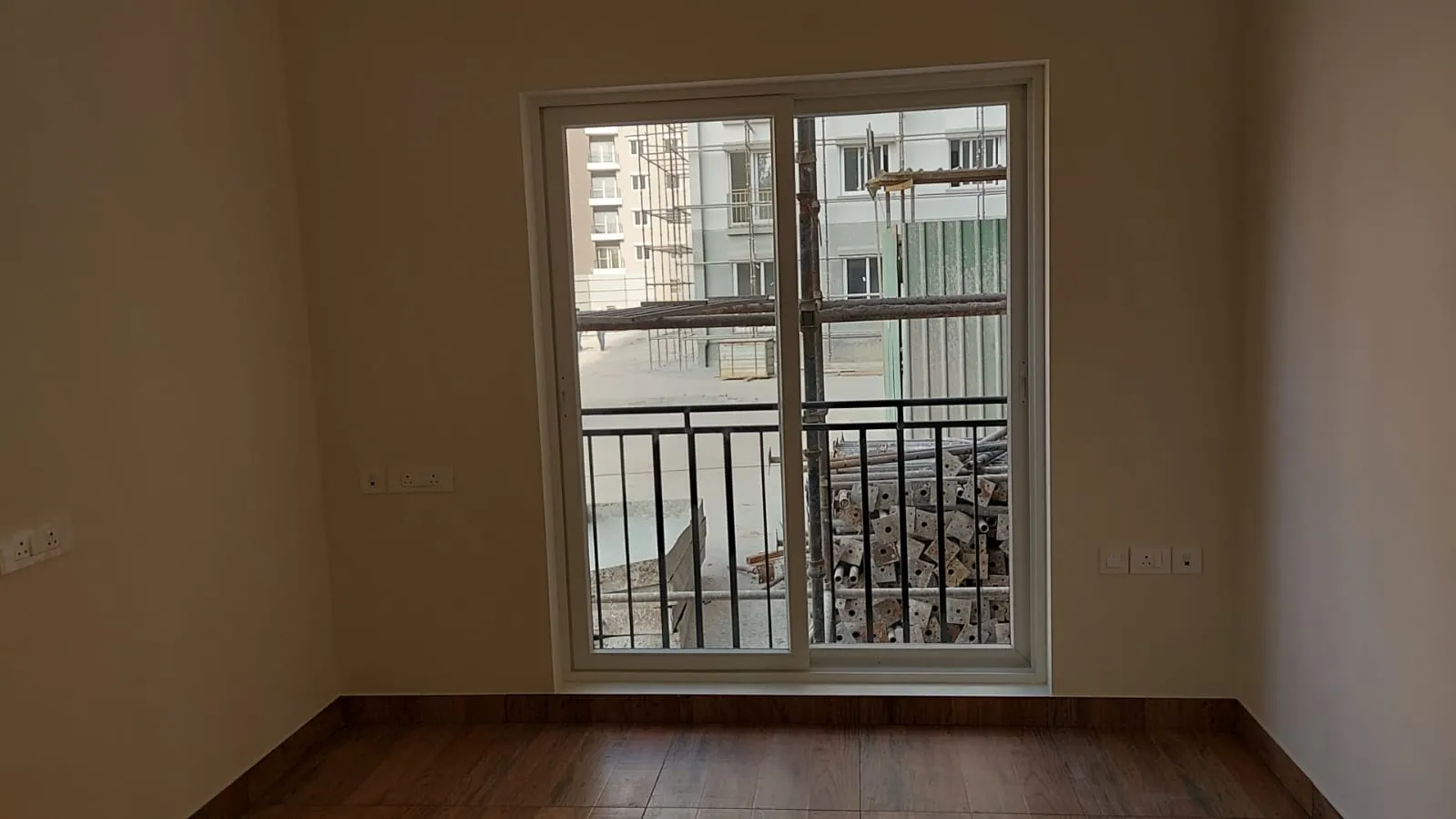

J,K & L Block | Internal Painting Work under progress - Feb 2026

J,K & L Block | Internal Painting Work under progress - Feb 2026

J,K & L Block | Internal Painting Work under progress - Feb 2026

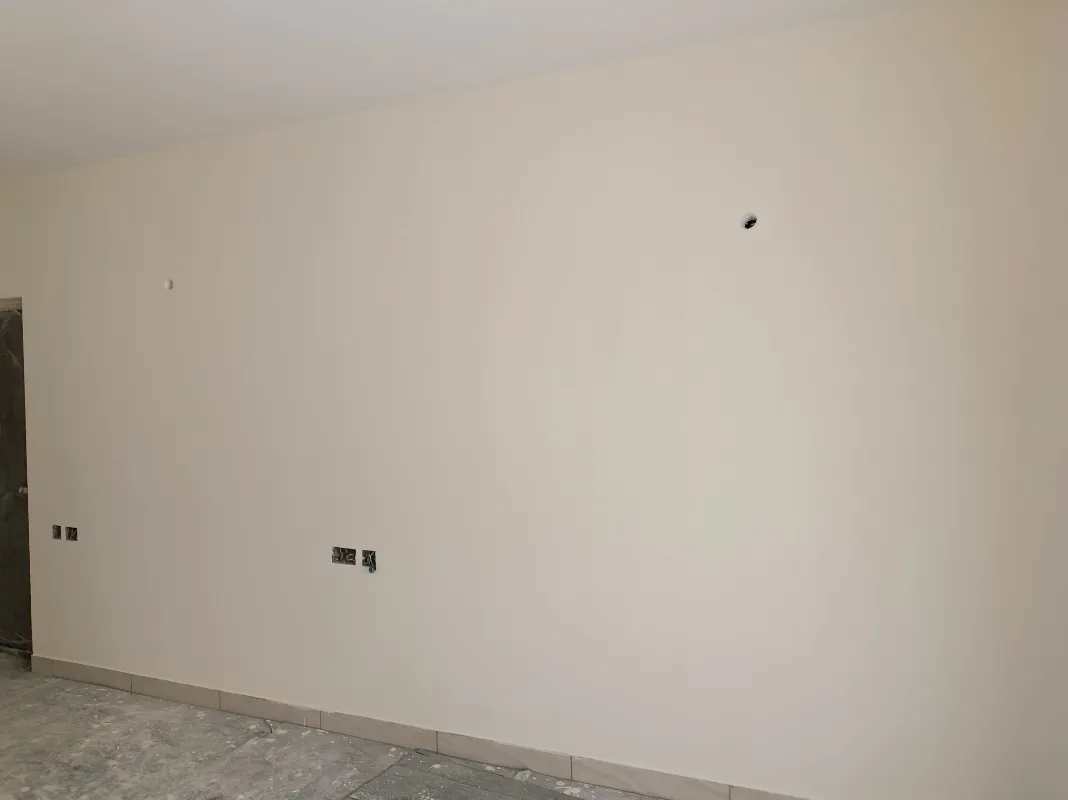

J,K & L Block Internal Painting WIP - Jan 2026

External Plastering - Jan 2026

External Plastering - Jan 2026

External Plastering - Jan 2026

LKJ- Flooring Completed - Jan 2026

LKJ- Flooring Completed - Jan 2026

LKJ- Flooring Completed - Jan 2026

L,K& J Window Fixing Work In Progress - Jan 2026

L,K& J Window Fixing Work In Progress - Jan 2026

L,K& J Window Fixing Work In Progress - Jan 2026

L,K& J Window Fixing Work In Progress - Jan 2026

L,K& J Door Work in progress - Jan 2026

L,K& J Door Work in progress - Jan 2026

J,K & L Block Texture & Paint Work In Progress - Jan 2026

J,K & L Block Texture & Paint Work In Progress - Jan 2026

J,K & L Block Internal Painting WIP - Jan 2026

J,K & L Block Internal Painting WIP - Jan 2026

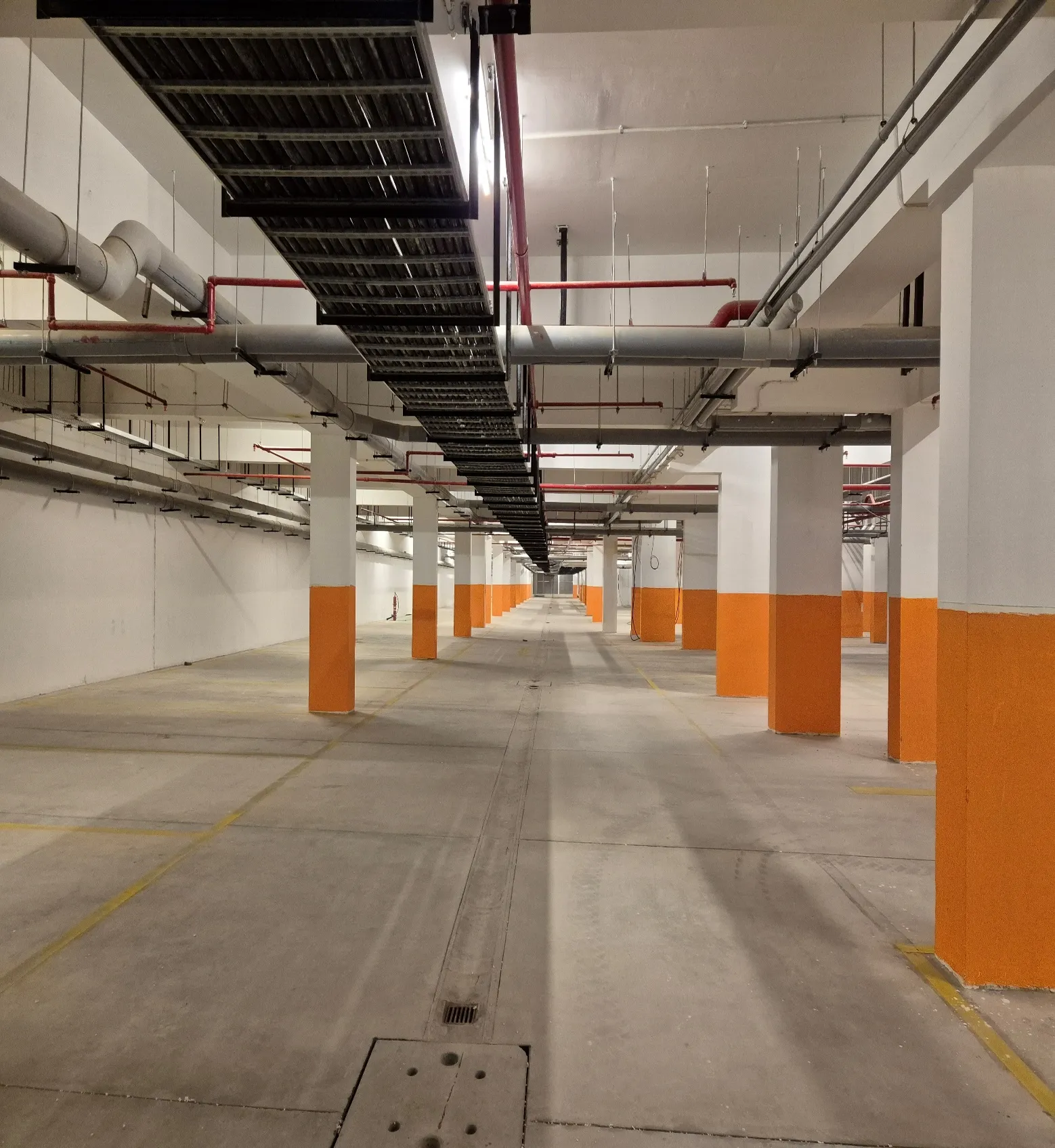

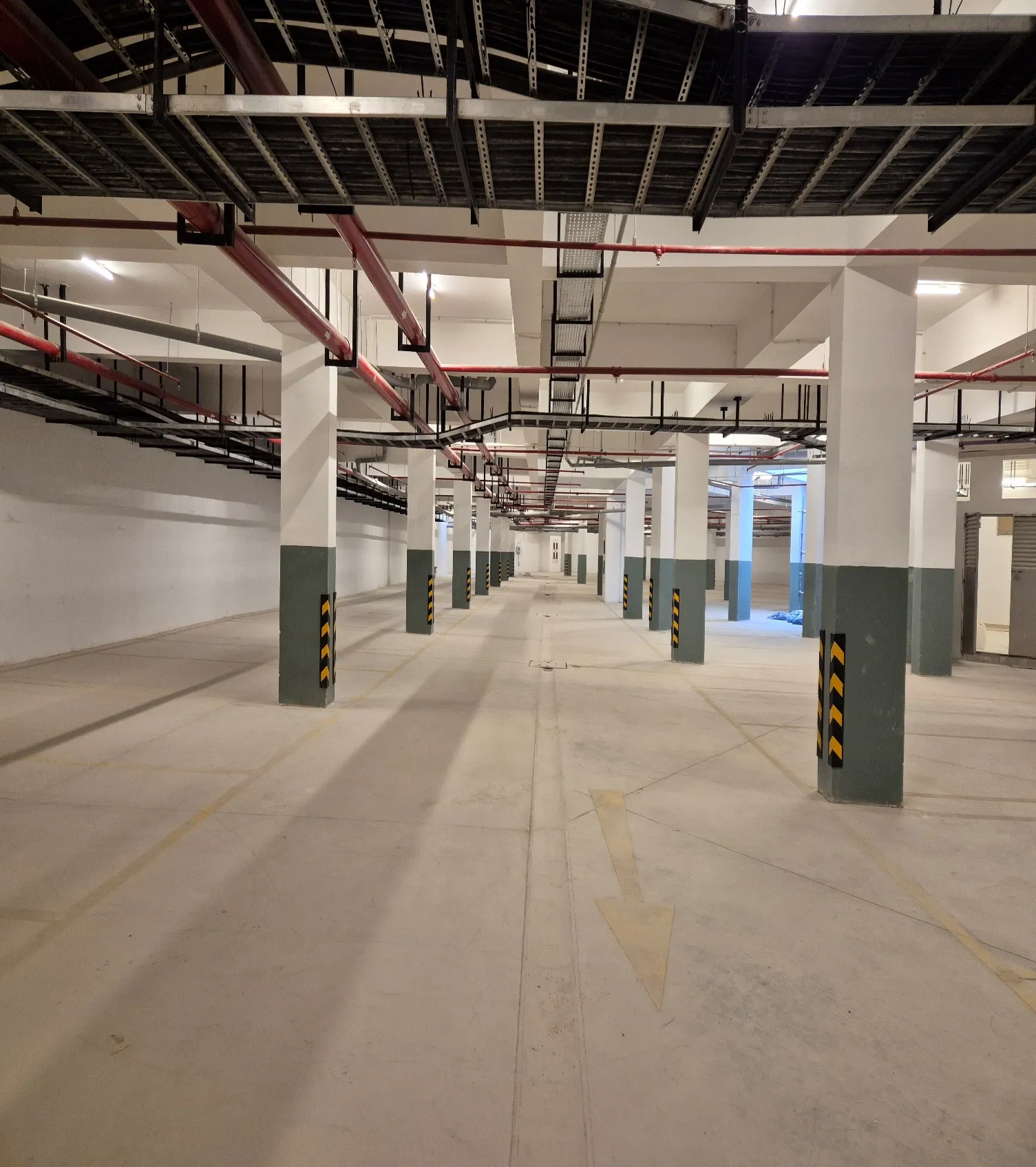

Ivory Phase 1 Basement - Jan 2026

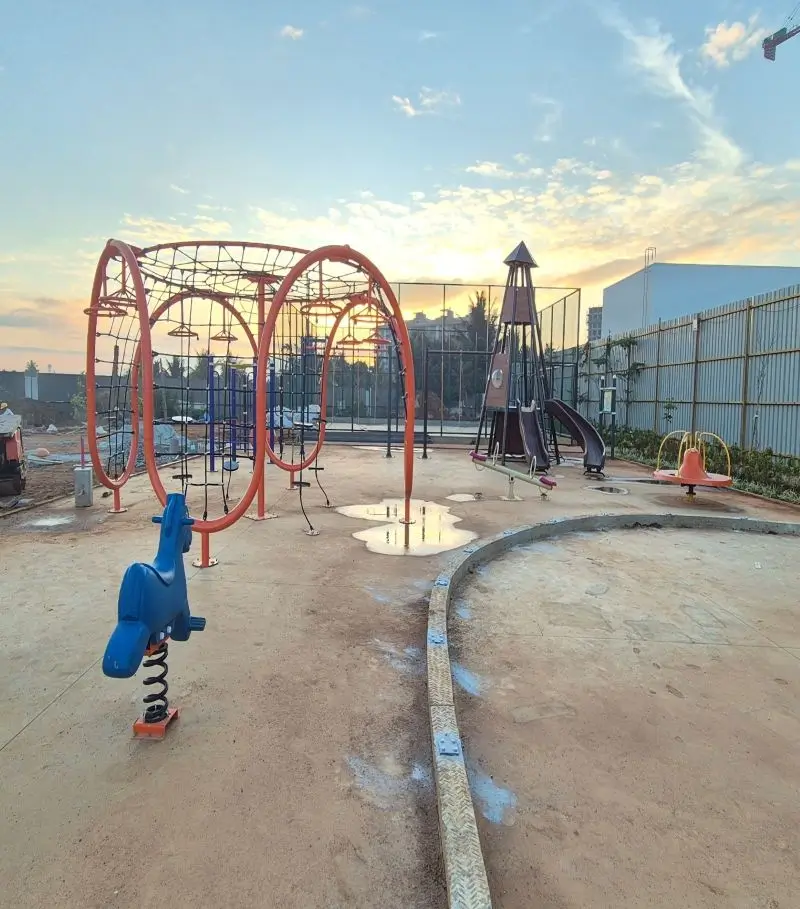

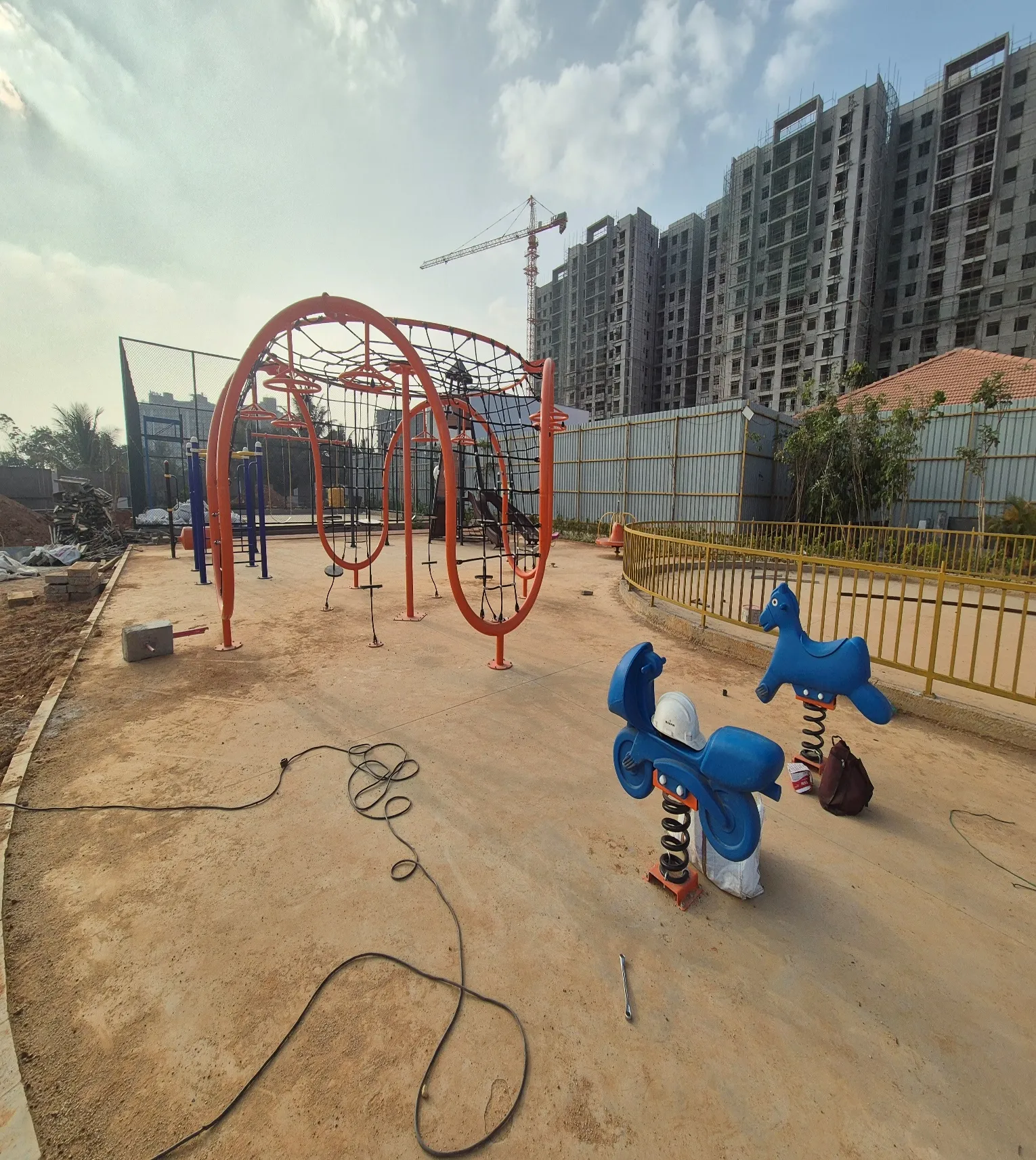

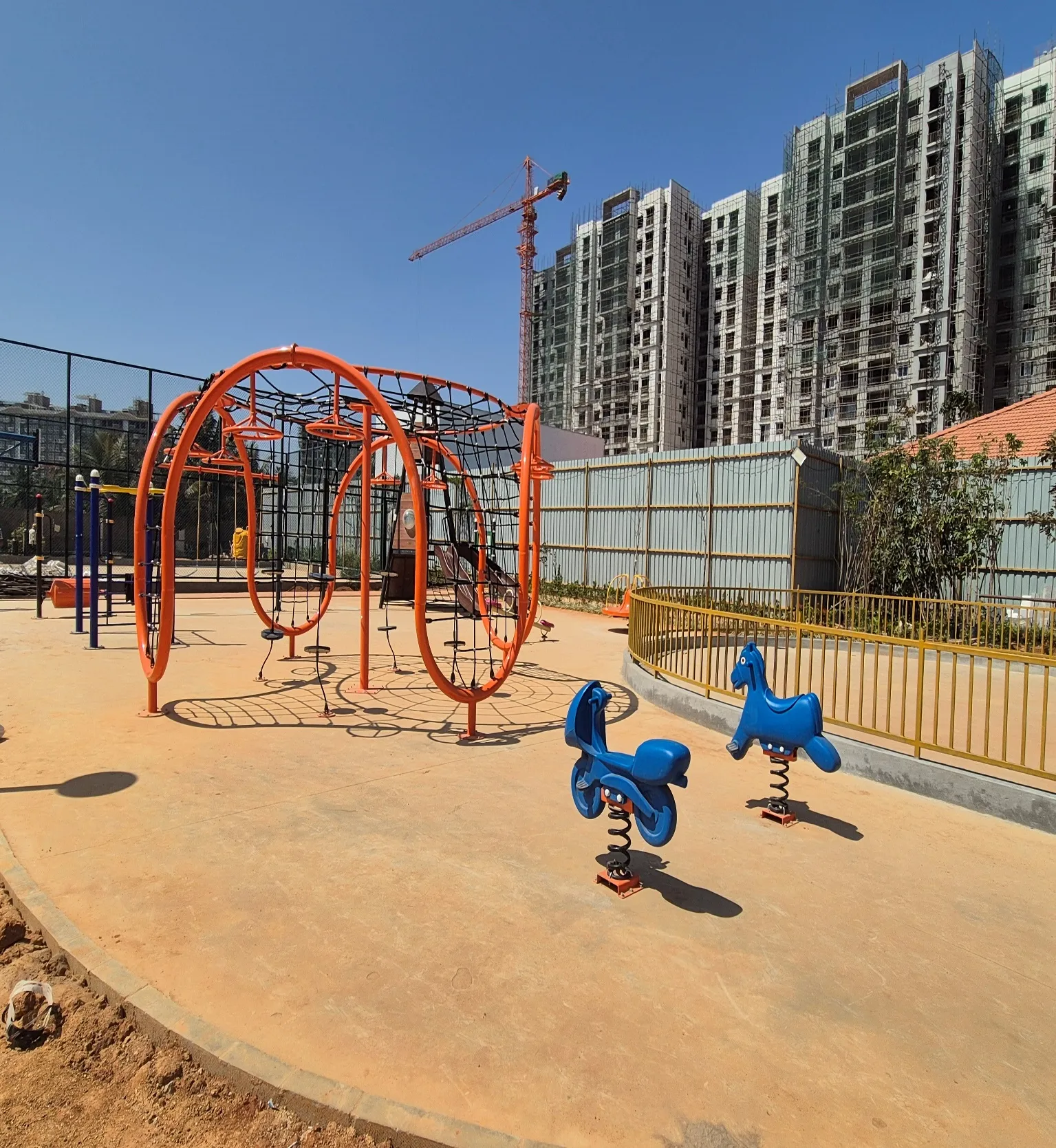

Clubhouse - External Development Works - Jan 2026

Clubhouse - External Development Works - Jan 2026

Clubhouse - External Development Works - Jan 2026

Clubhouse - External Development Works - Jan 2026

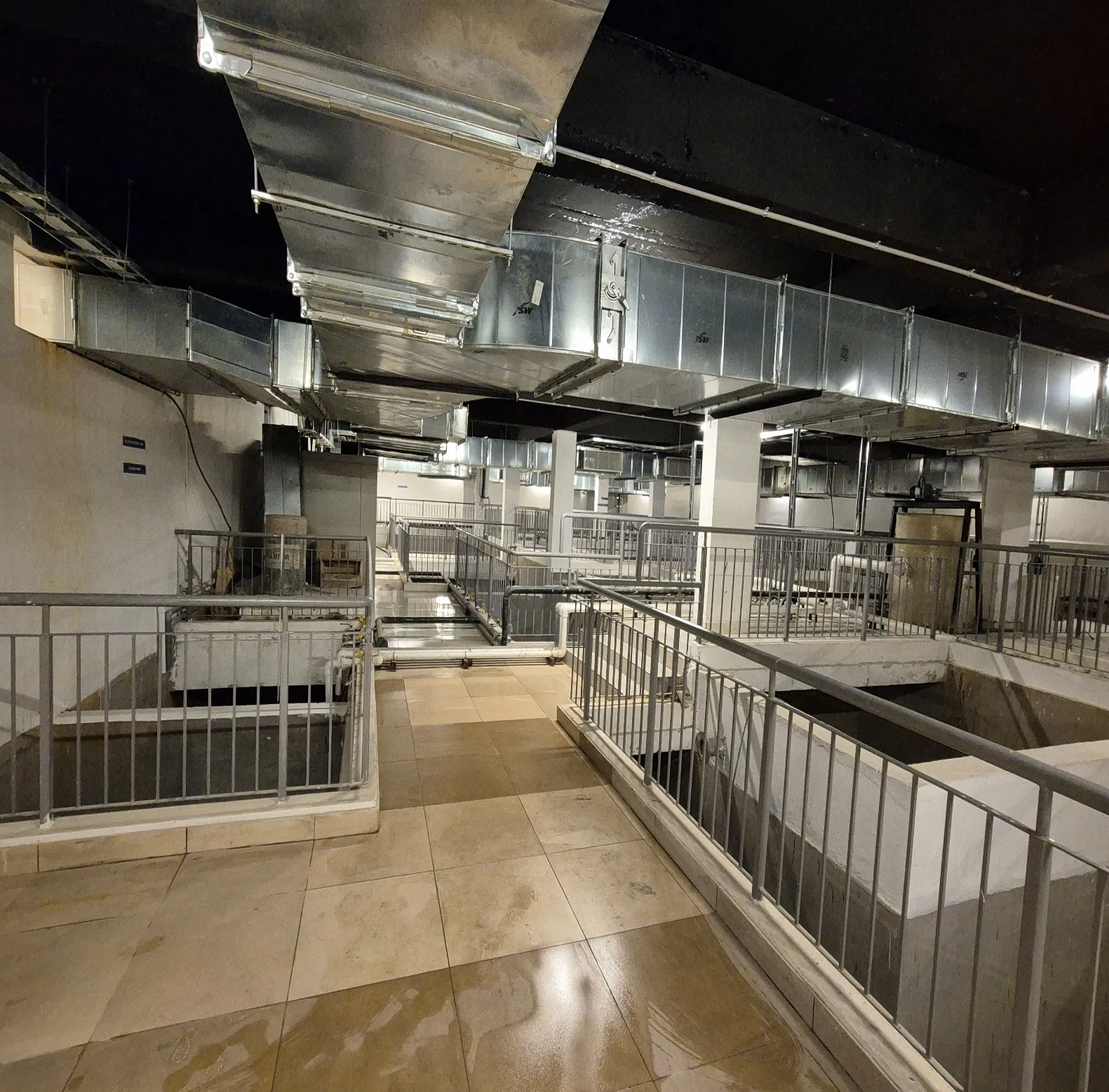

Ivory Phase 1 STP - Jan 2026

Ivory Phase 1 STP - Jan 2026

Ivory Phase 1 Basement - Jan 2026

Ivory Phase 1 - H Tower Corrdior - Jan 2026

Ivory Phase 1 - H Tower Corrdior - Jan 2026

Ivory Phase 1 - H Tower Corrdior - Jan 2026

Ivory Phase 1 - H Tower Corrdior - Jan 2026

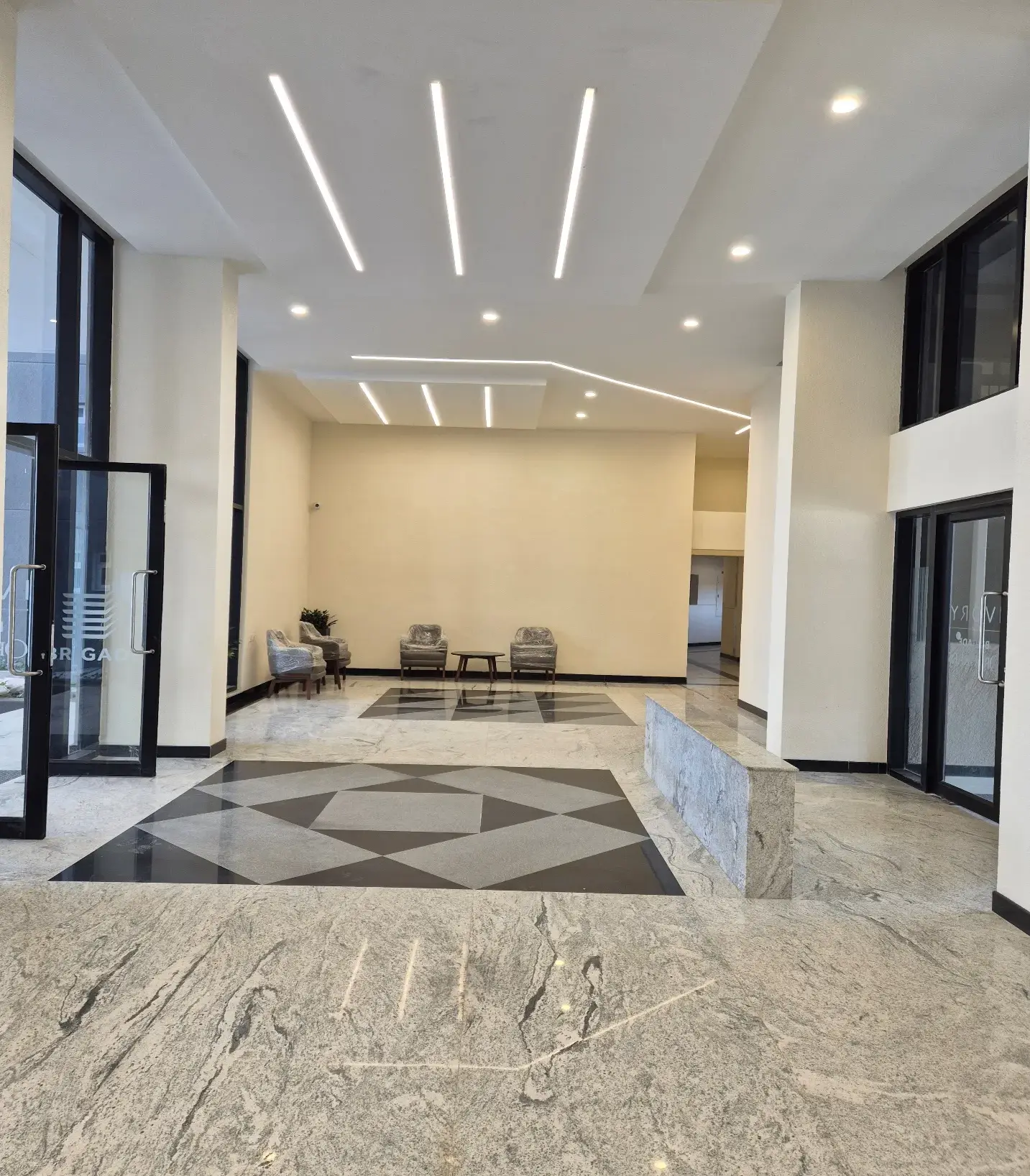

Ivory Phase 1 - G & H Tower Lobby - Jan 2026

Ivory Phase 1 - G & H Tower Lobby - Jan 2026

Ivory Phase 1 - G & H Tower - Jan 2026

Ivory Phase 1 - G & H Tower - Jan 2026

Ivory Phase 1 - G & H Tower - Jan 2026

Ivory Phase 1 - I Tower Lobby Corrdior - Jan 2026

Ivory Phase 1 - I Tower Lobby Corrdior - Jan 2026

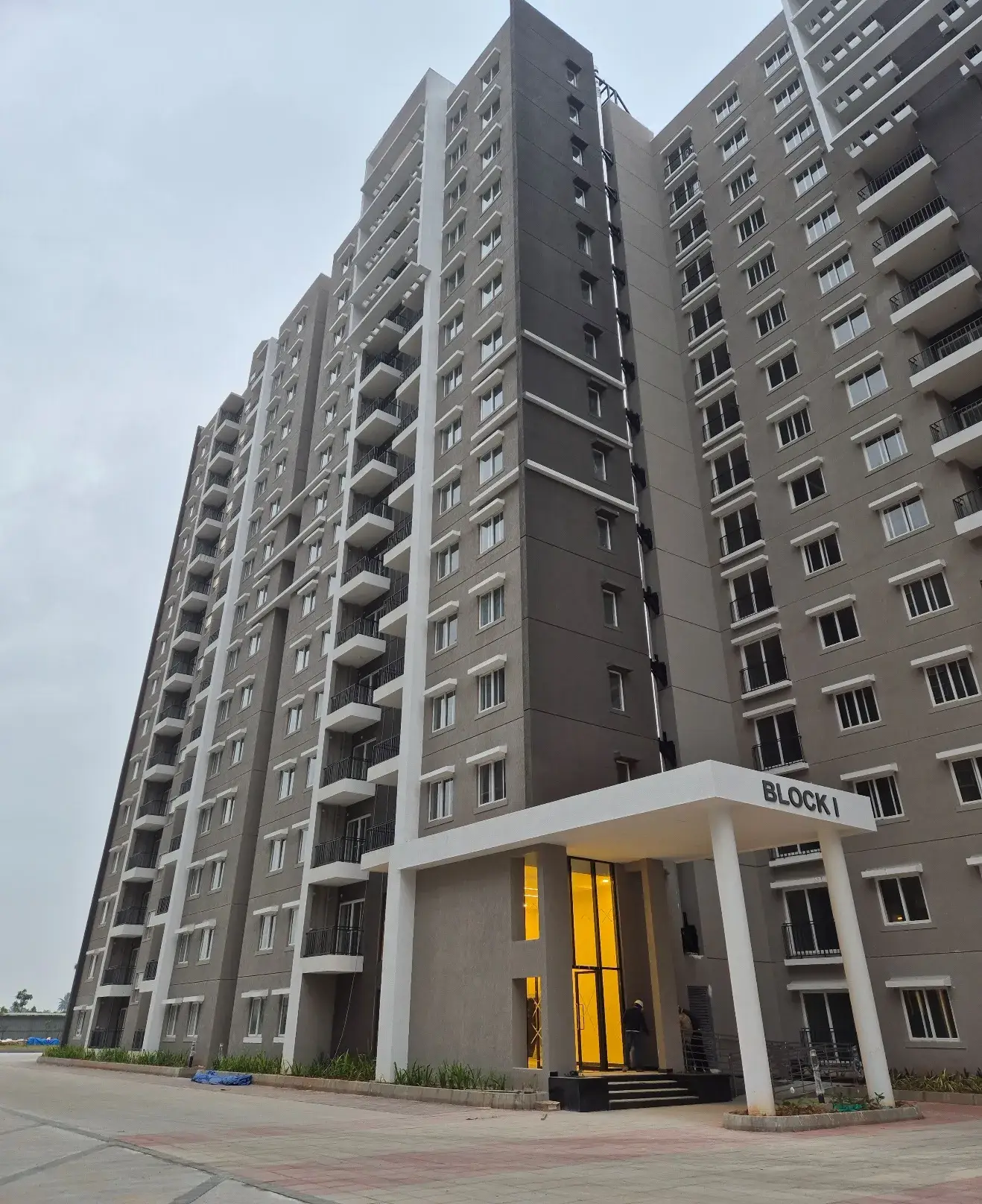

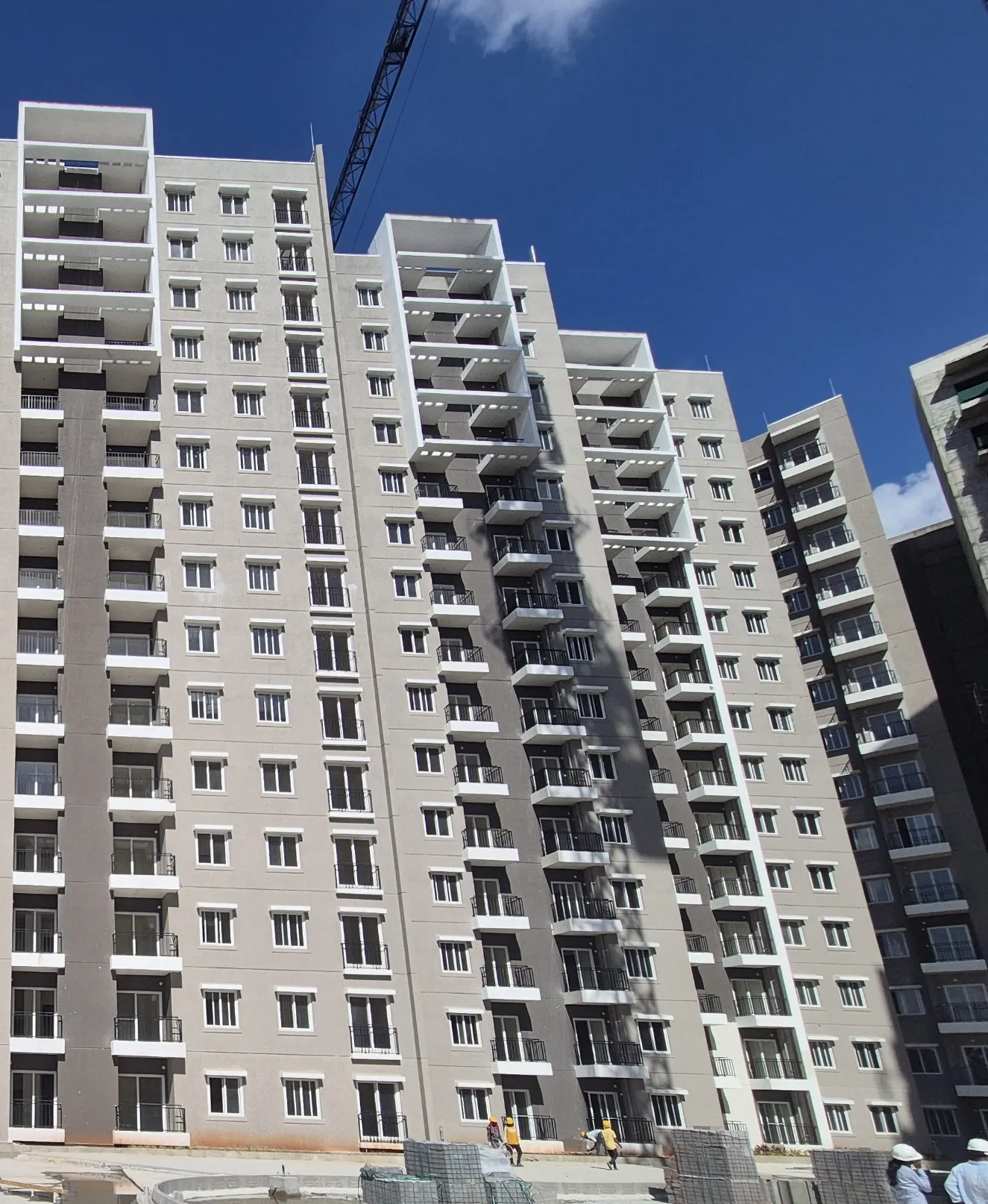

Ivory Phase 1 - I Tower - Jan 2026

Ivory Phase 1 - I Tower - Jan 2026

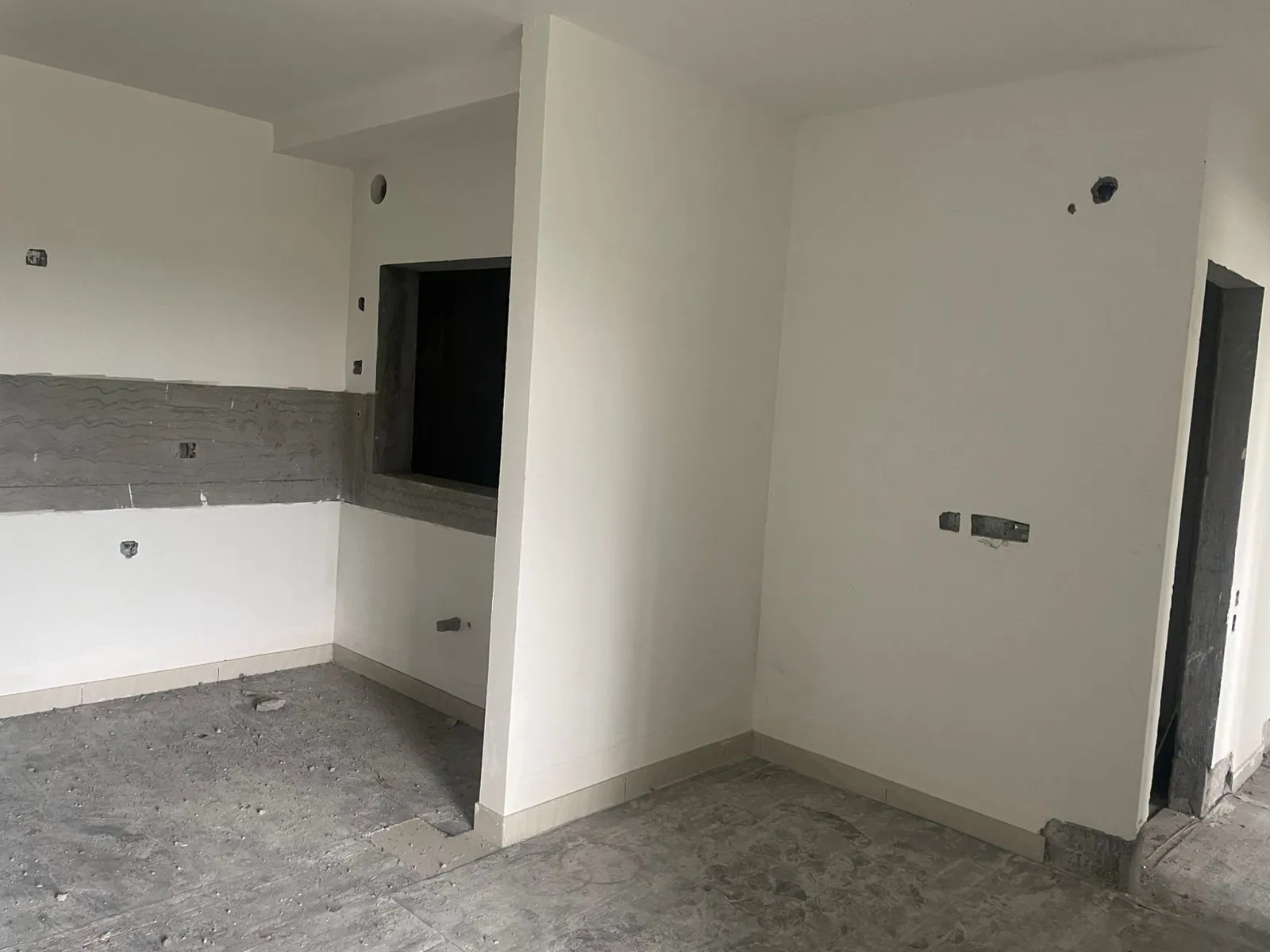

Commencement of Painting in J,K &L - Dec 2025

External Plastering in progress - Dec 2025

External Plastering in progress - Dec 2025

Flooring in progress - Dec 2025

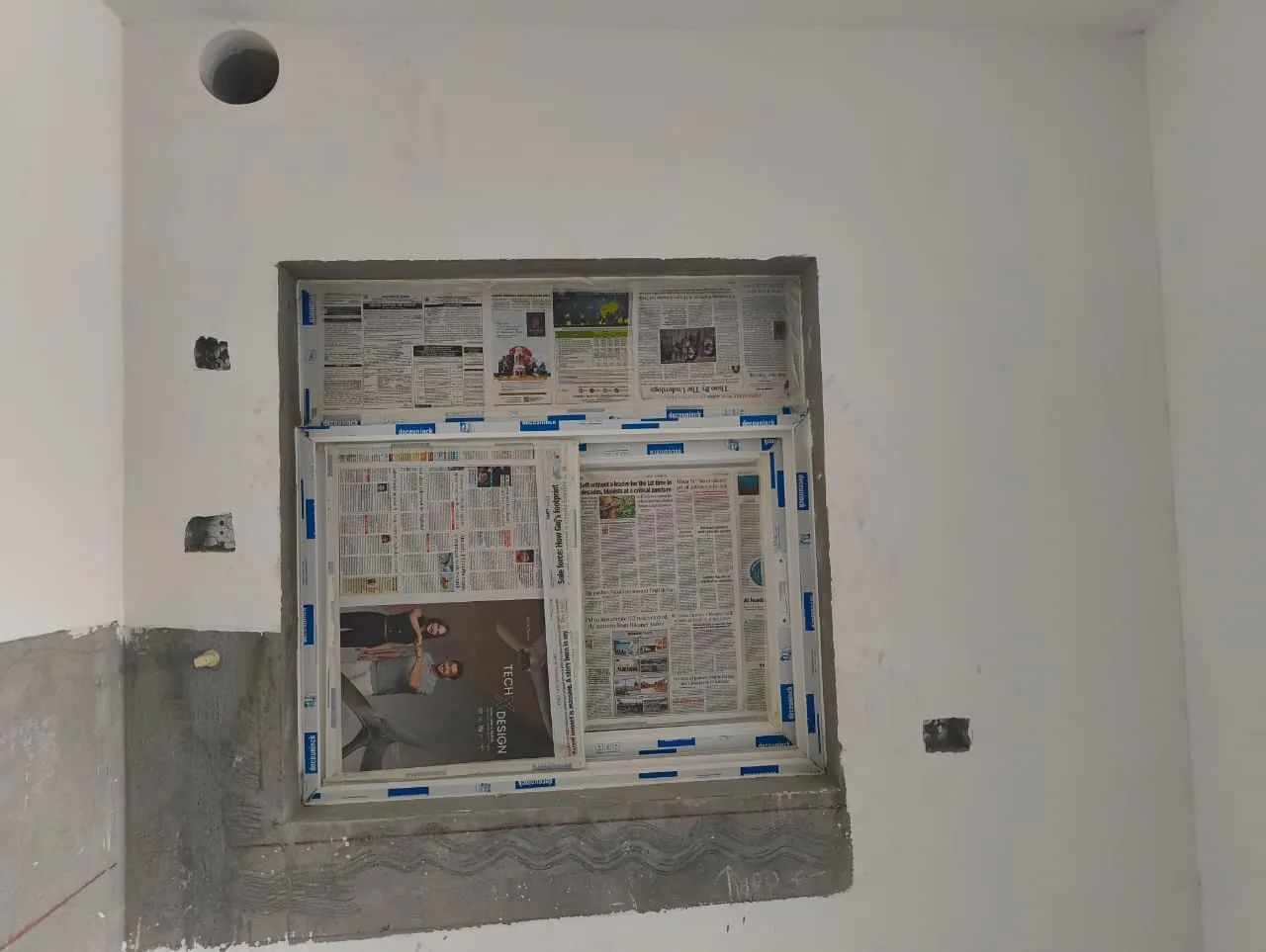

L,K& J Fixing of Doors & Windows In Progress - Dec 2025

L,K& J Fixing of Doors & Windows In Progress - Dec 2025

L,K& J Fixing of Doors & Windows In Progress - Dec 2025

L,K& J Fixing of Doors in progress - Dec 2025

L,K& J Fixing of Doors in progress - Dec 2025

K & L Block Texture Work In Progress - Dec 2025

K & L Block Texture Work In Progress - Dec 2025

J,K & L Block Internal Painting in Progress - Dec 2025

J,K & L Block Internal Painting in Progress - Dec 2025

Ivory Phase 1 - G & H Tower - Dec 2025

Ivory Phase 1 - I Tower - Dec 2025

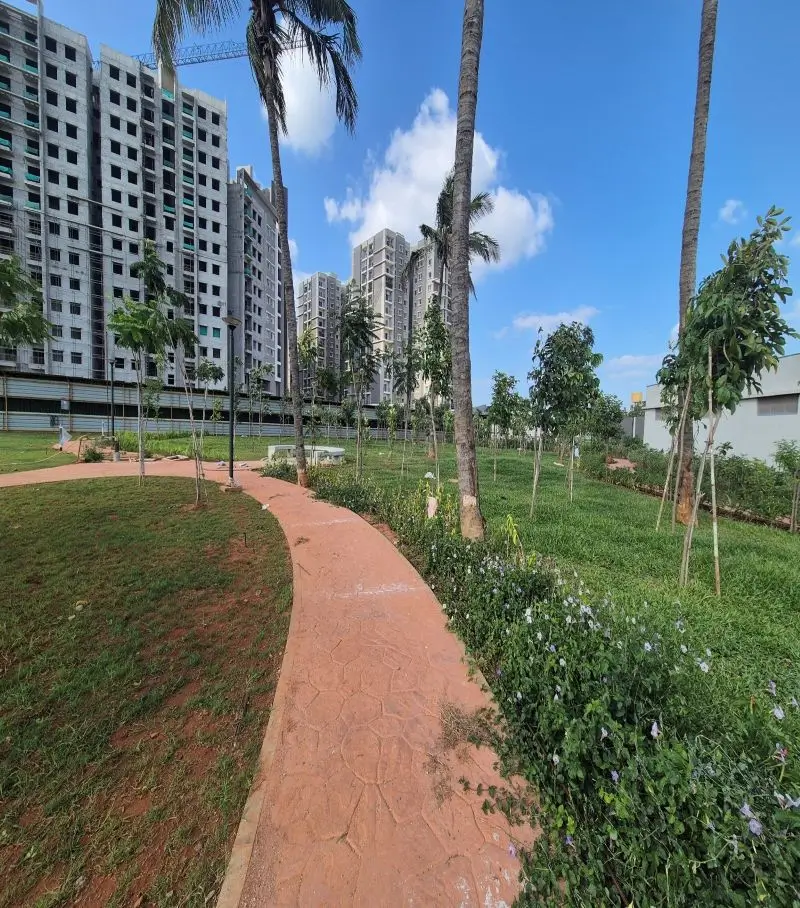

Clubhouse - External Development Works - Dec 2025

Clubhouse - External Development Works - Dec 2025

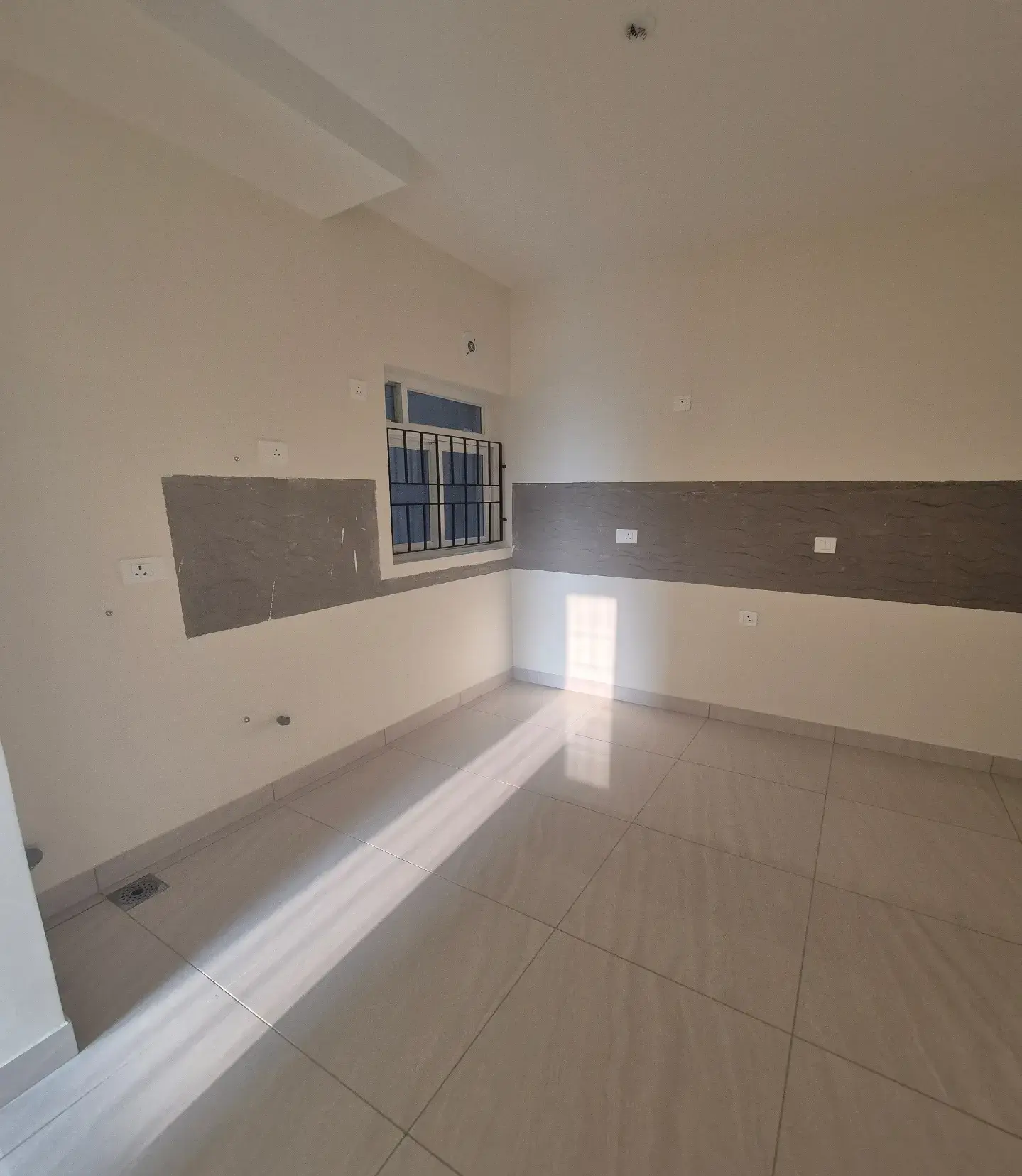

Ivory Phase 1 - G Tower Certified Units - Dec 2025

Clubhouse - External Development Works - Dec 2025

Clubhouse - External Development Works - Dec 2025

Clubhouse - External Development Works - Dec 2025

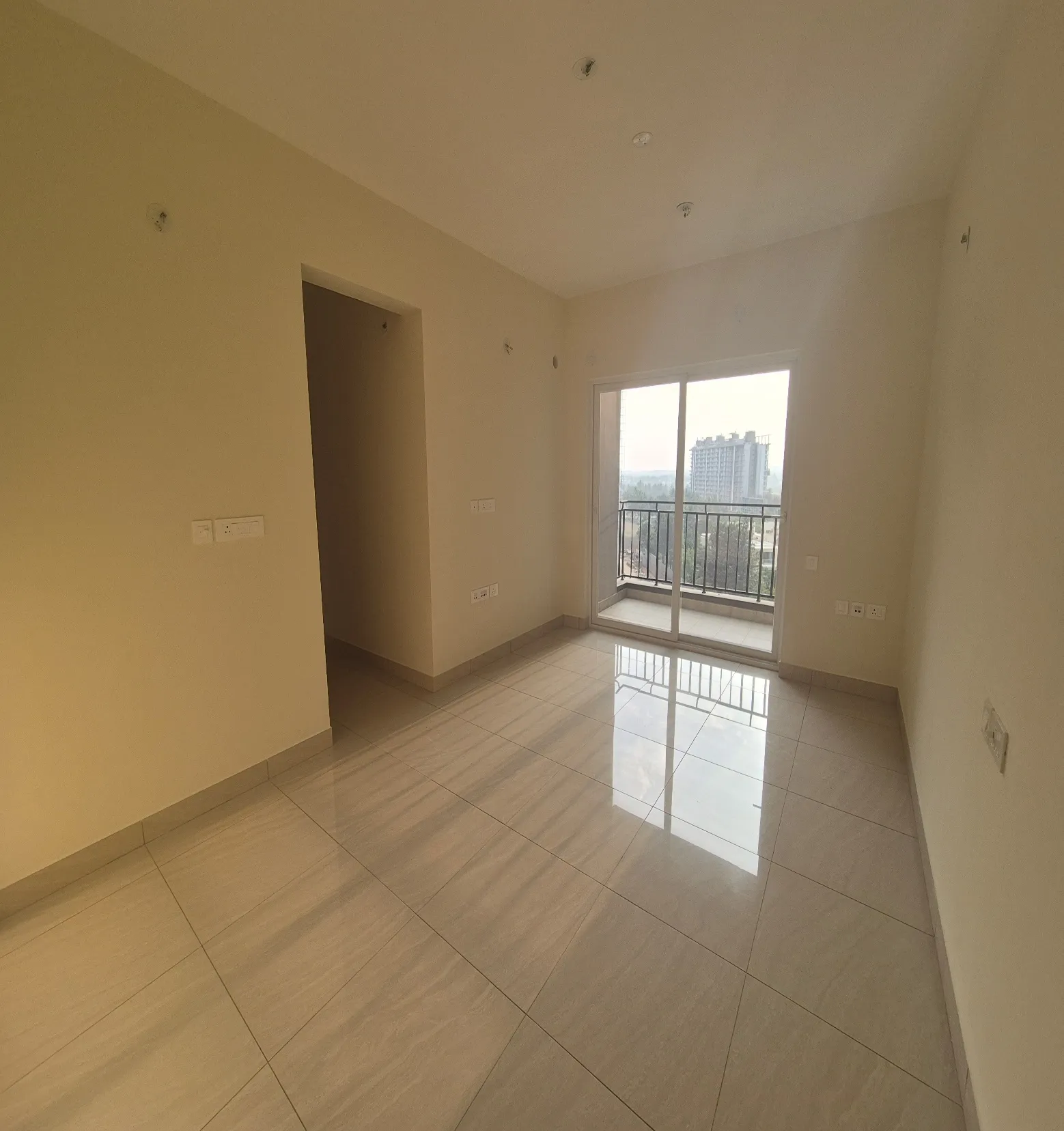

Ivory Phase 1 - G Tower Certified Units - Dec 2025

Ivory Phase 1 - G Tower Certified Units - Dec 2025

Ivory Phase 1 - G Tower Certified Units - Dec 2025

Ivory Phase 1 - G Tower Cordriors - Dec 2025

Ivory Phase 1 - G Tower Cordriors - Dec 2025

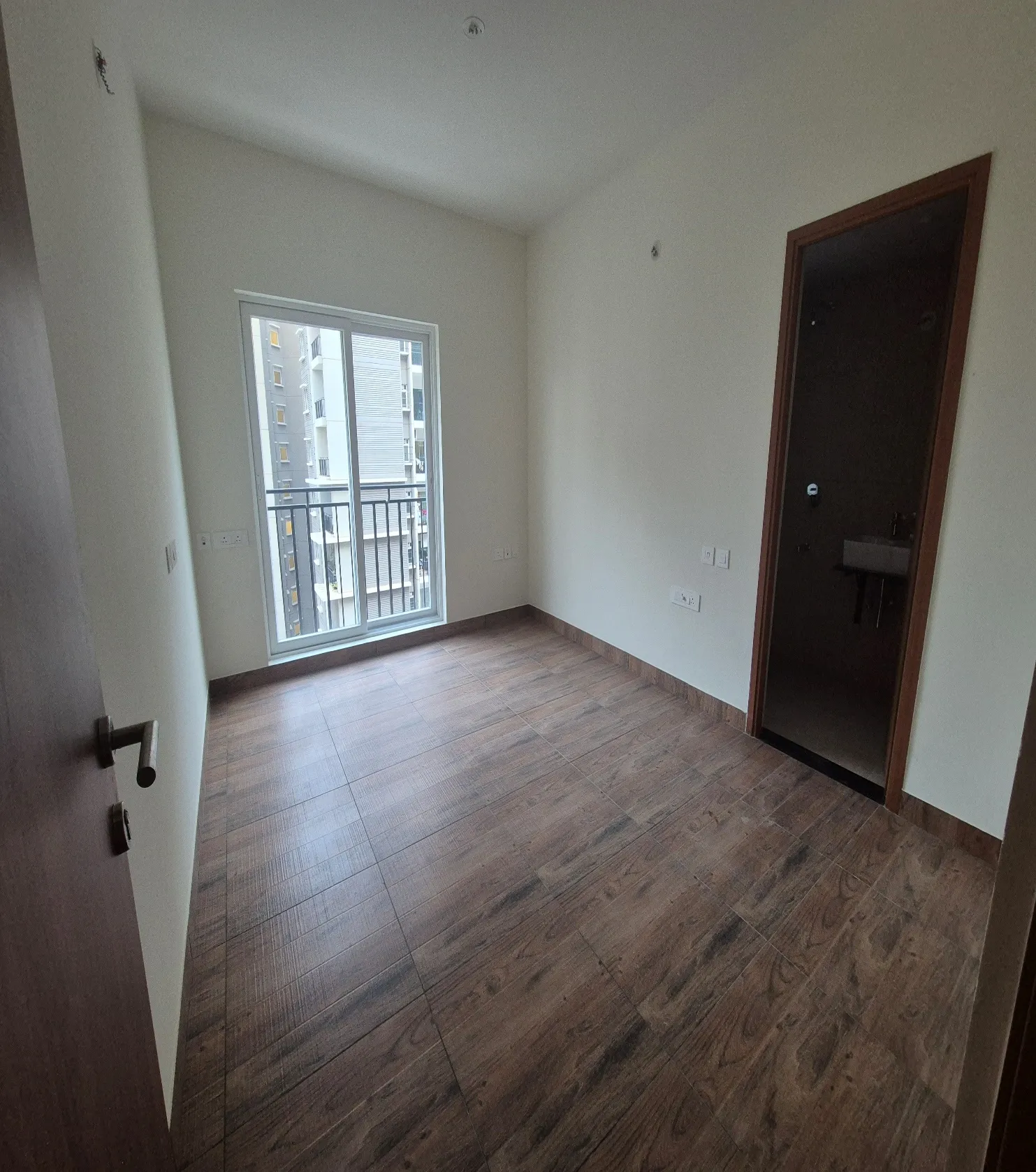

Ivory Phase 1 - H Tower Certified Units - Dec 2025

Ivory Phase 1 - H Tower Certified Units - Dec 2025

Ivory Phase 1 - H Tower Certified Units - Dec 2025

Ivory Phase 1 - H Tower Certified Units - Dec 2025

External Plastering in progress - Dec 2025

Commencement of Painting in J,K &L - Dec 2025

Commencement of Painting in J,K &L - Dec 2025

Commencement of Painting in J,K &L - Dec 2025

Ivory Phase 1 - I Tower Corrdior - Dec 2025

Ivory Phase 1 - I Tower - Dec 2025

Ivory Phase 1 - I Tower Lobby Corrdior - Dec 2025

Ivory Phase 1 - I Tower Lobby Corrdior - Dec 2025

Ivory Phase 1 - I Tower Certified Units - Dec 2025

Ivory Phase 1 - I Tower Corrdior - Dec 2025

Ivory Phase 1 - I Tower Certified Units - Dec 2025

Ivory Phase 1 - G & H Tower - Dec 2025

Ivory Phase 1 - G & H Tower - Dec 2025

Ivory Phase 1 - I Tower Corrdior - Dec 2025

Ivory Phase 1 - I Tower Certified Units - Dec 2025

L,K& J Door Work in progress - Nov 2025

External Plaster - GF TO TERRACE in progress - Nov 2025

External Plaster - GF TO TERRACE in progress - Nov 2025

External Plaster - GF TO TERRACE in progress - Nov 2025

L-block 10th Floor in Progress , K-Block 11th Floor in Progress & J –Block 7nd Floor in progress - Nov 2025

L,K& J | Fixing of Windows In Progress - Nov 2025

L,K& J | Fixing of Windows In Progress - Nov 2025

L,K& J | Fixing of Windows In Progress - Nov 2025

L,K& J Door Work in progress - Nov 2025

L Block Texture Work In Progress - Nov 2025

L,K& J Block Internal Painting Work in progress - Nov 2025

L,K& J Block Internal Painting Work in progress - Nov 2025

IVORY PHASE 1 G TOWER CORRIDORS - Nov 2025

IVORY PHASE 1 I-TOWER LOBBY, CORRIDOR - Nov 2025

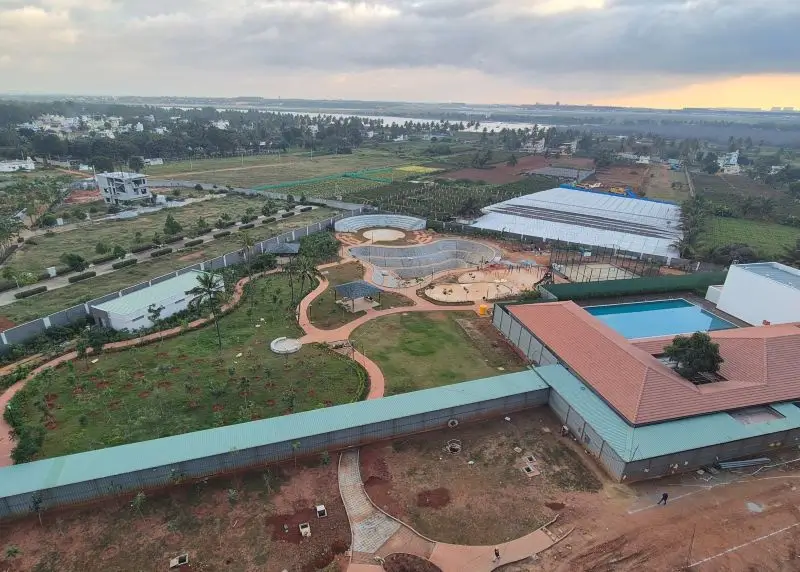

CLUBHOUSE EXTERNAL DEVELOPMENT WORKS - Nov 2025

CLUBHOUSE EXTERNAL DEVELOPMENT WORKS - Nov 2025

CLUBHOUSE EXTERNAL DEVELOPMENT WORKS - Nov 2025

CLUBHOUSE EXTERNAL DEVELOPMENT WORKS - Nov 2025

CLUBHOUSE EXTERNAL DEVELOPMENT WORKS - Nov 2025

IVORY PHASE 1 G TOWER CORRIDORS - Nov 2025

IVORY PHASE 1 H TOWER CORRIDORS - Nov 2025

IVORY PHASE 1 H TOWER CORRIDORS - Nov 2025

IVORY PHASE 1 G & H TOWER - Nov 2025

IVORY PHASE 1 G & H TOWER - Nov 2025

IVORY PHASE 1 I-TOWER LOBBY, CORRIDOR - Nov 2025

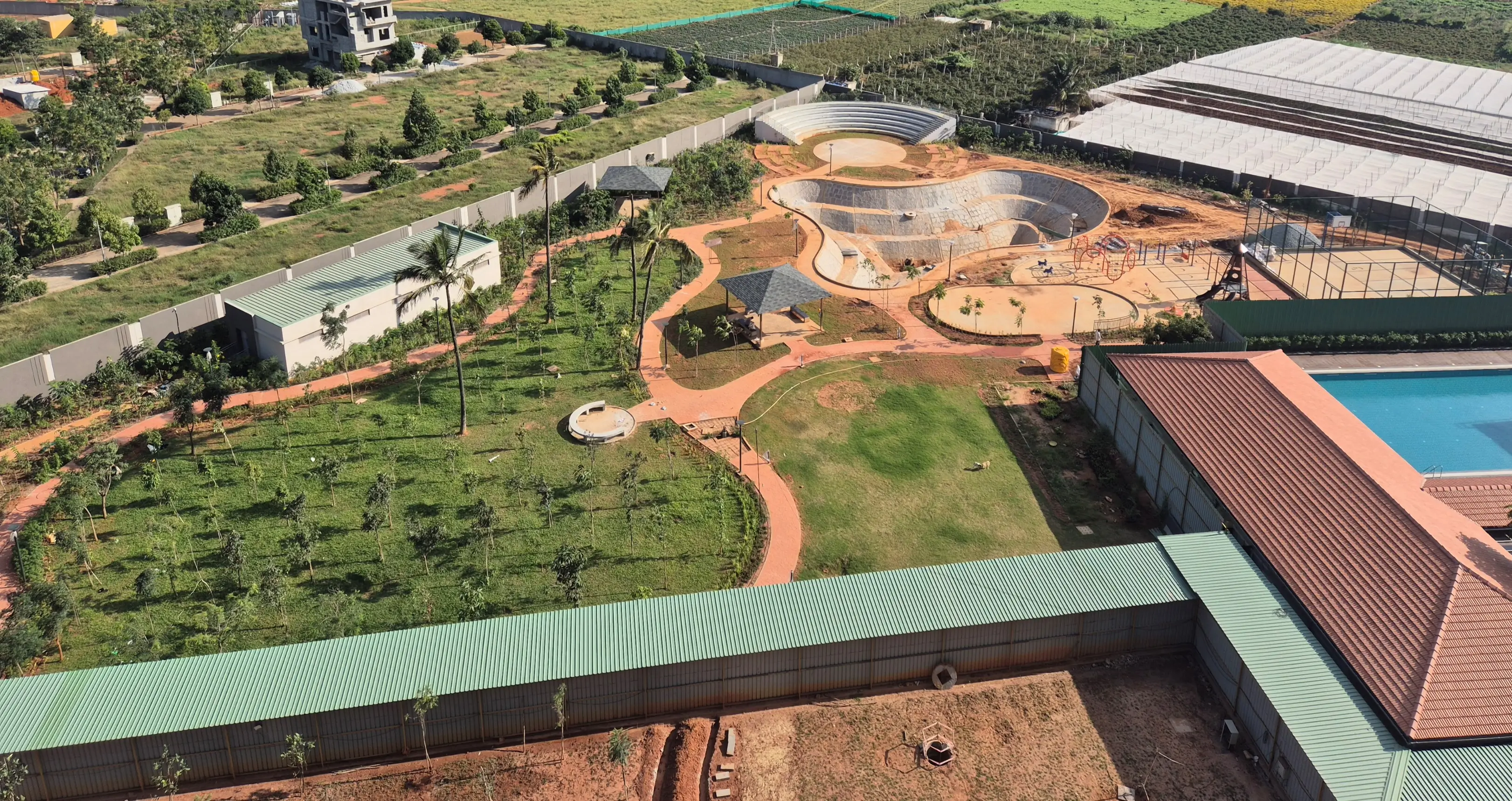

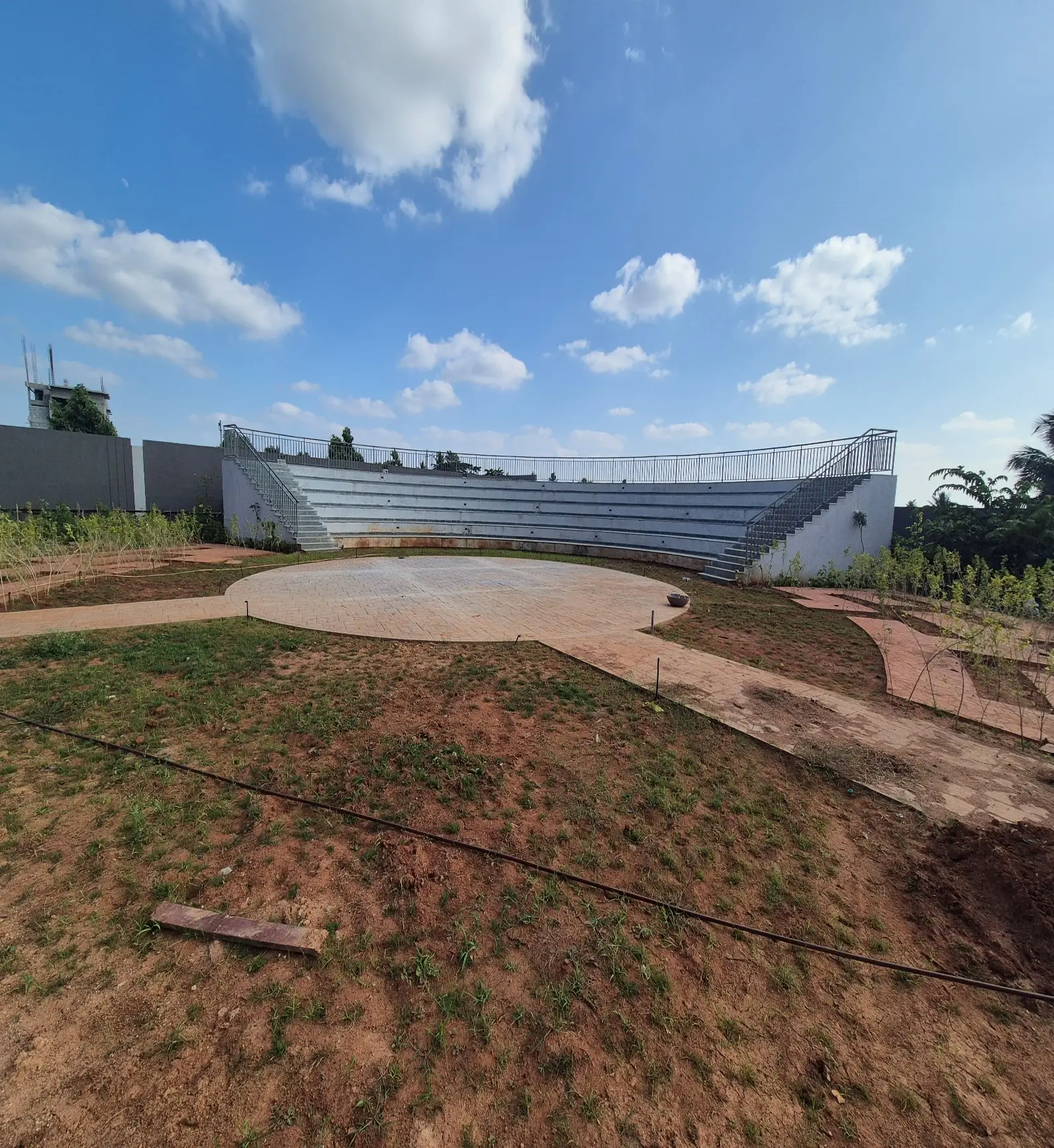

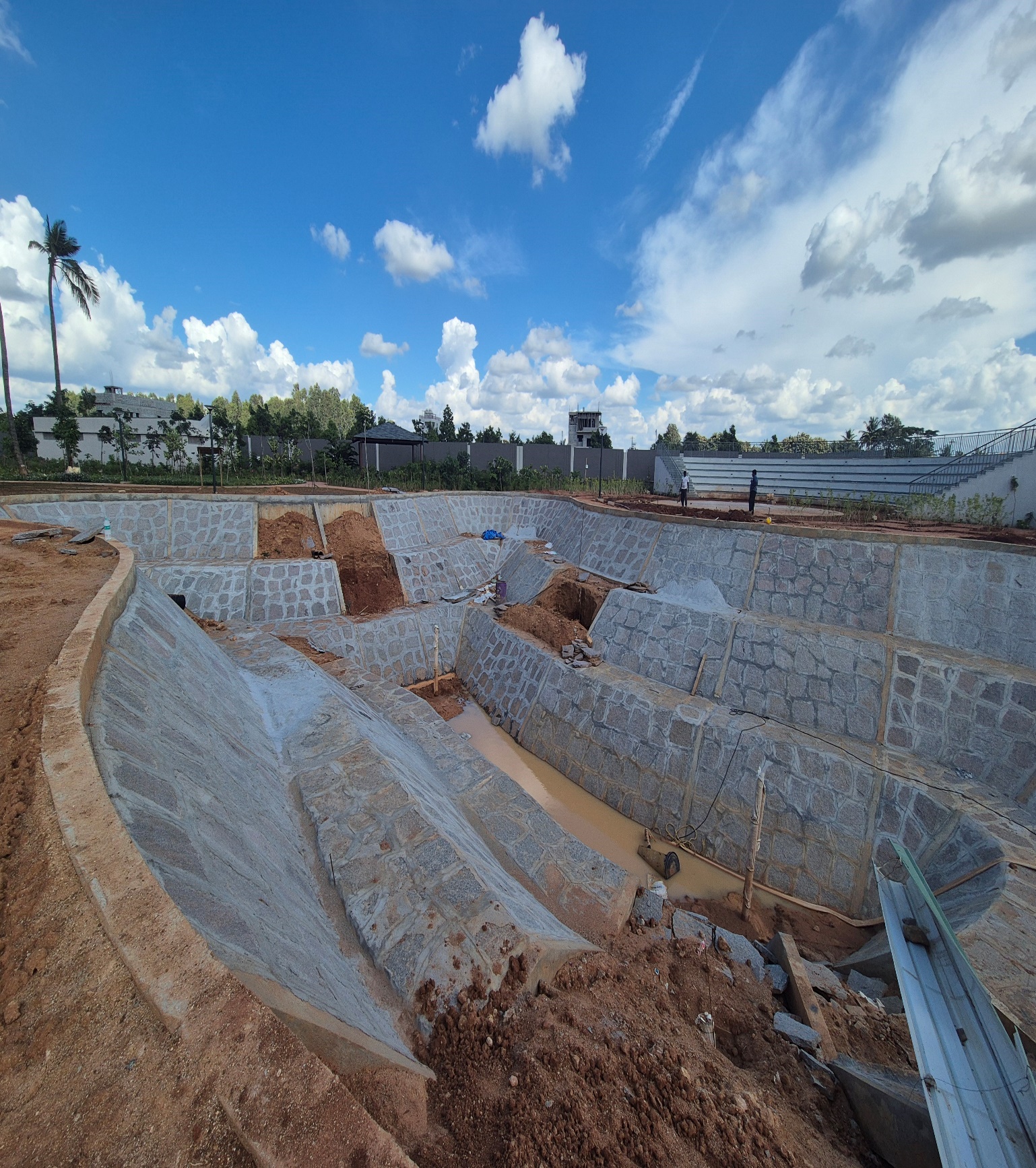

Clubhouse - External Development Work in Progress - Oct 2025

Clubhouse - External Development Work in Progress - Oct 2025

Clubhouse - External Development Work in Progress - Oct 2025

Clubhouse - External Development Work in Progress - Oct 2025

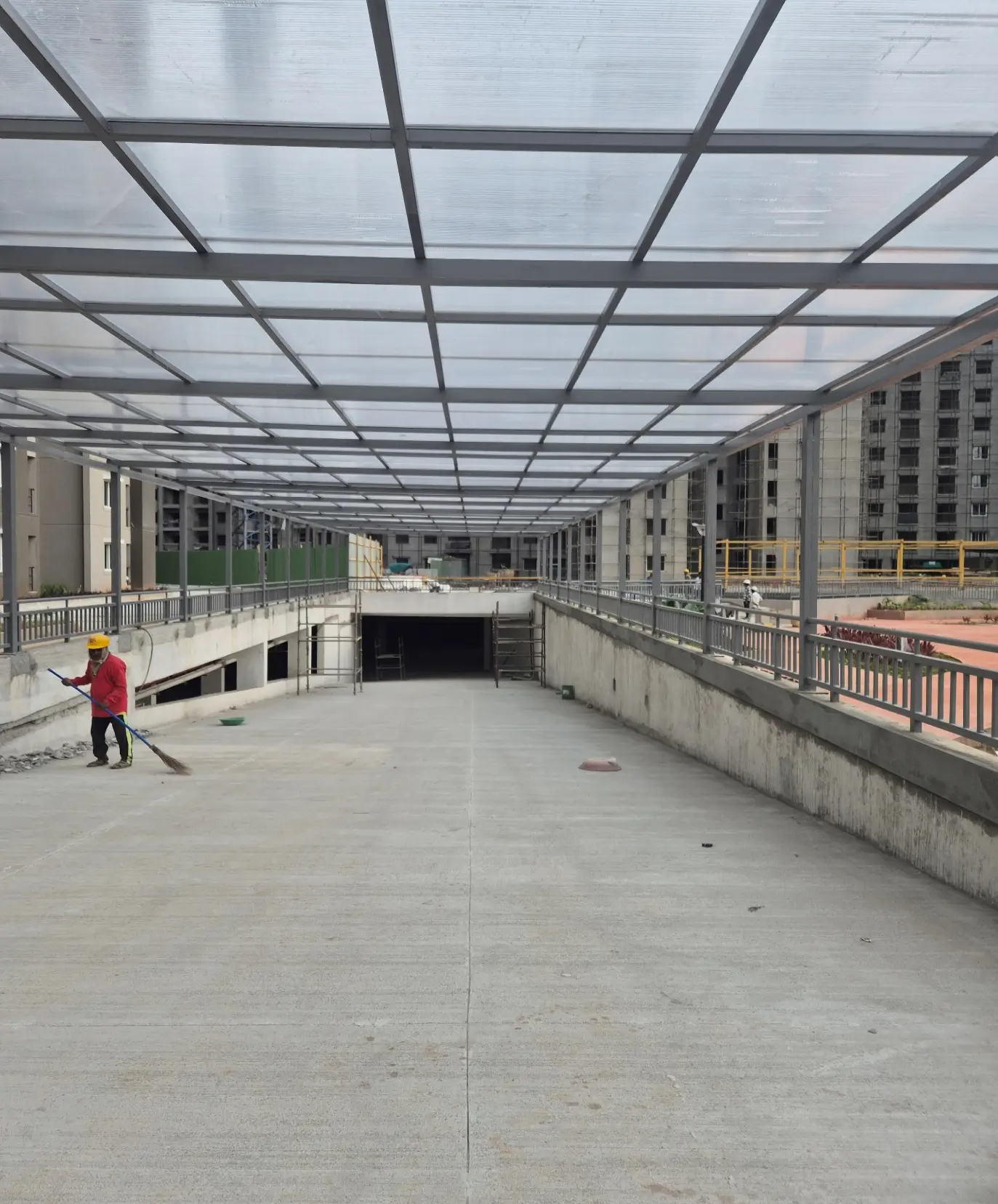

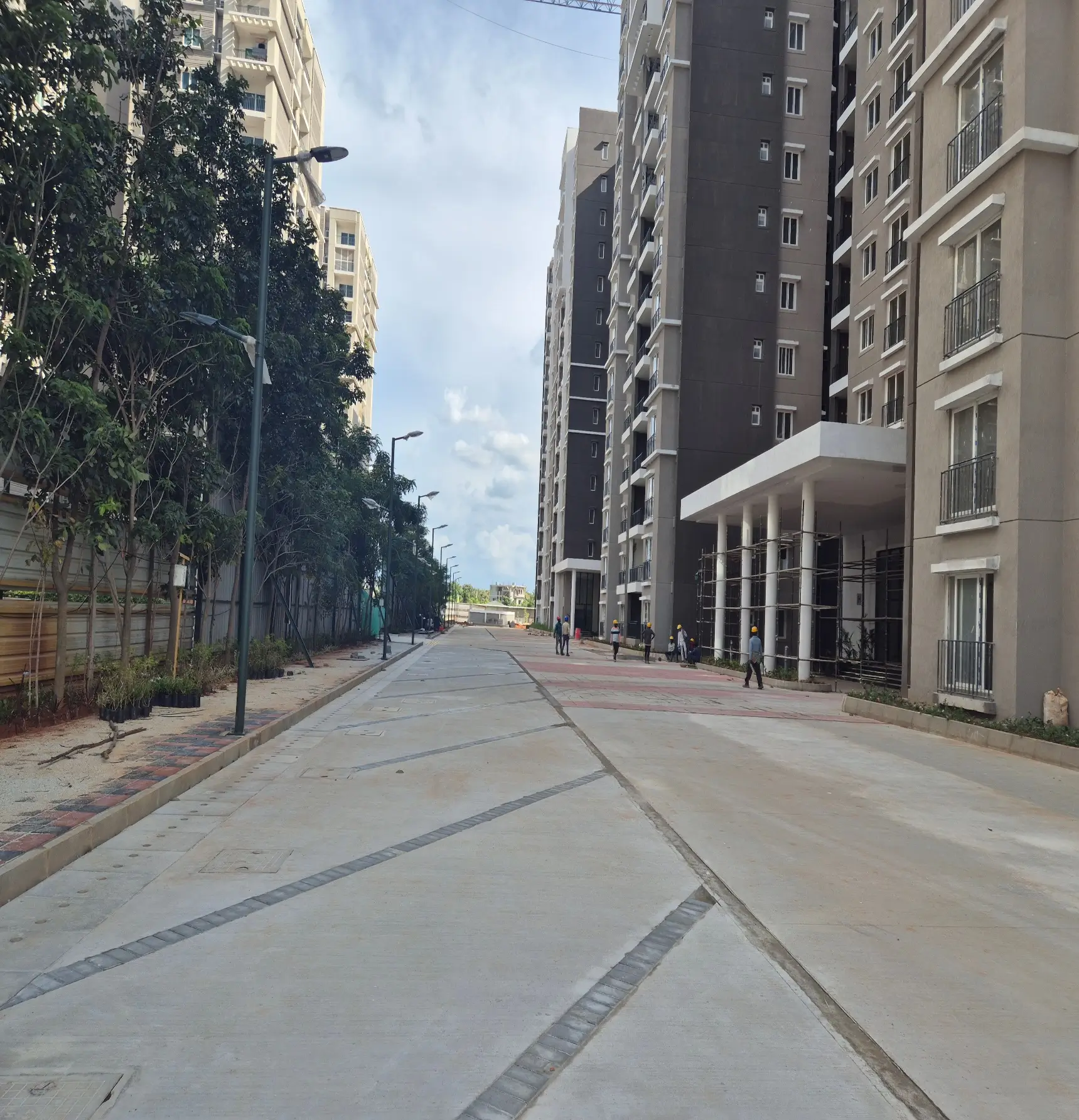

Podium Driveway Works - Oct 2025

Podium Driveway Works - Oct 2025

External Development Work - Oct 2025

External Development Work - Oct 2025

Clubhouse - External Development Work in Progress - Oct 2025

Podium Driveway Works - Oct 2025

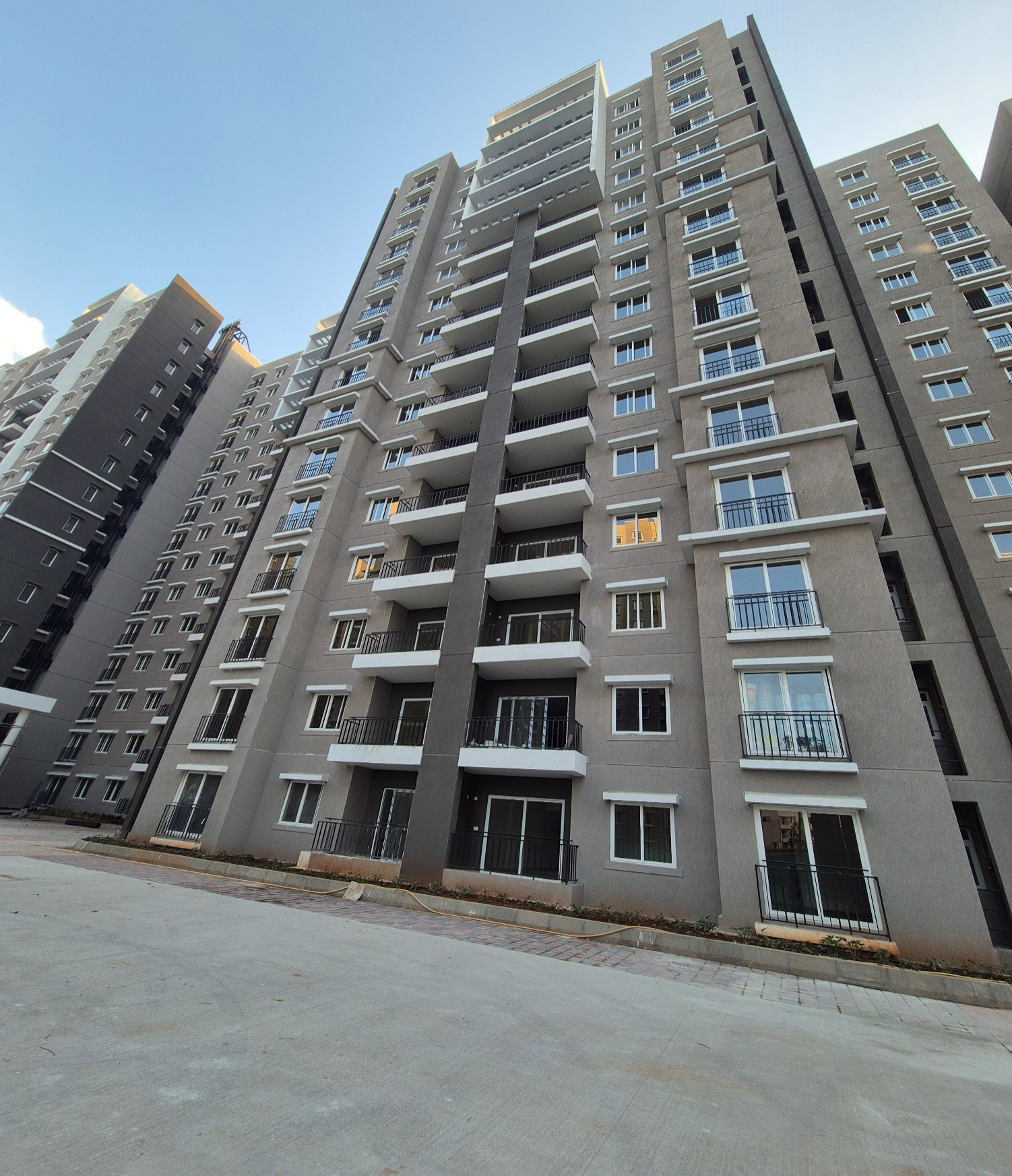

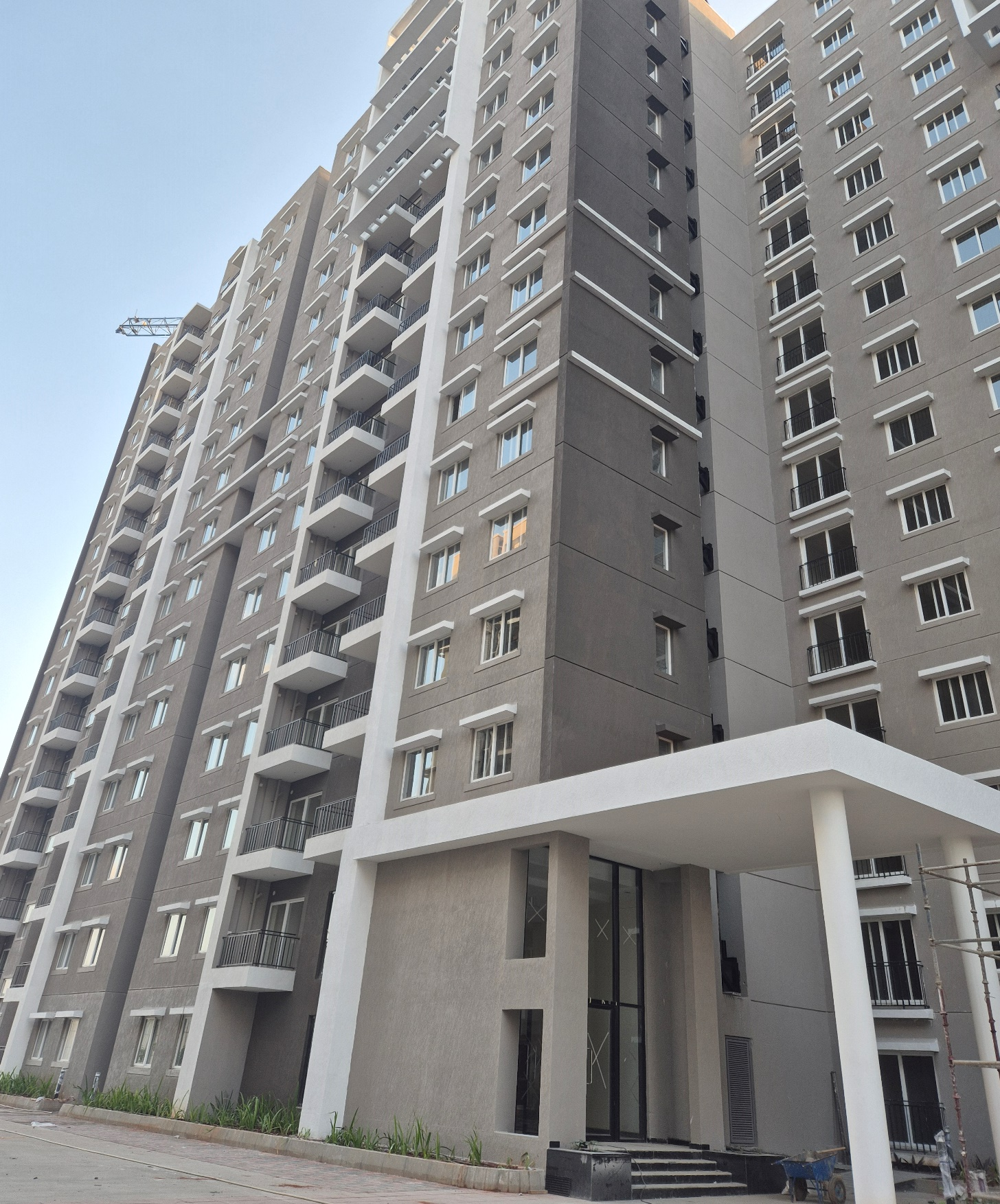

Ivory Phase 1 GHI - Oct 2025

Ivory Phase 1 GHI - Oct 2025

Ivory Phase 1 GHI - Oct 2025

Ivory Phase 1 GHI - Oct 2025

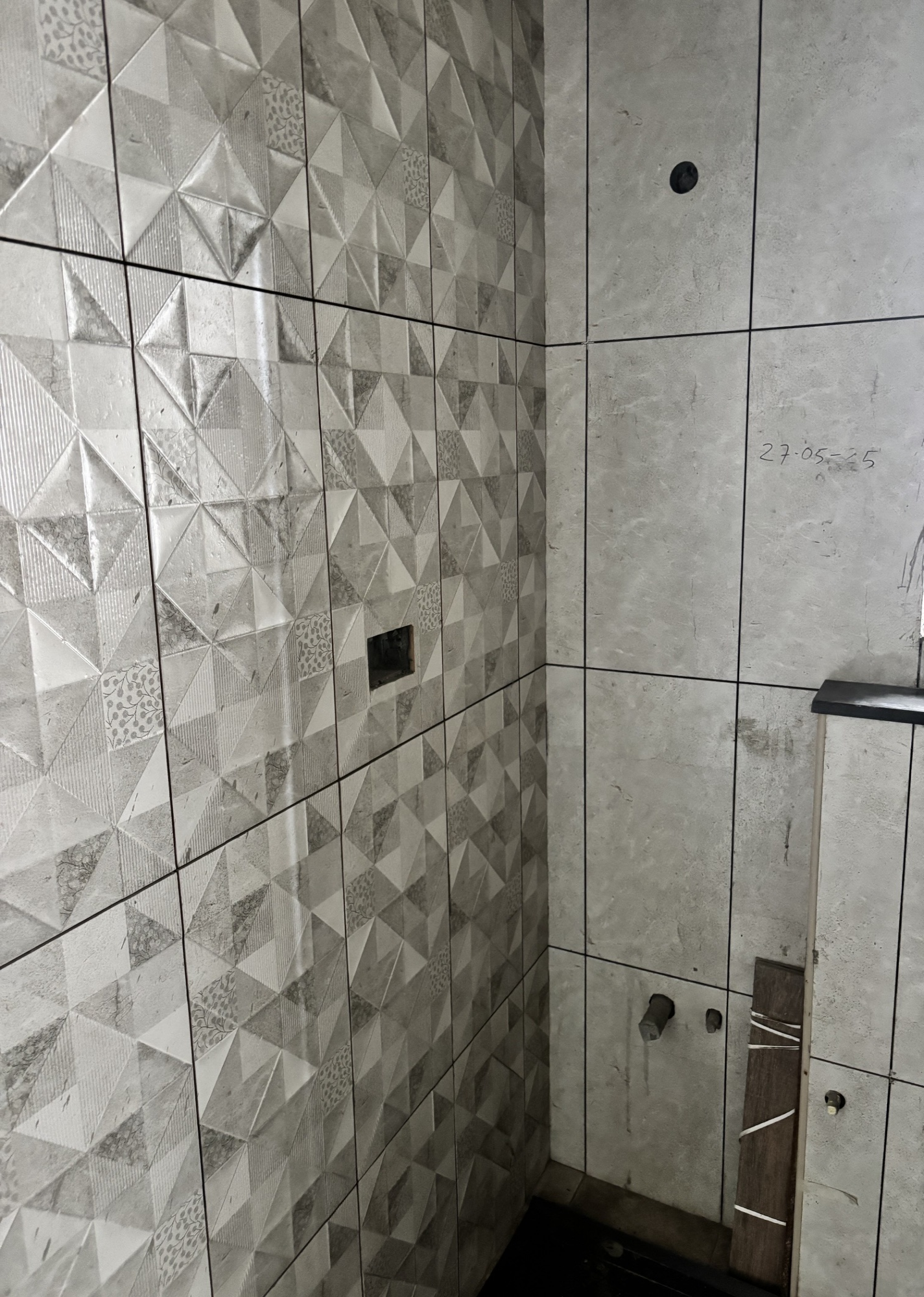

L block ground floor tiles completion - Sep 2025

L block ground floor tiles completion - Sep 2025

L block Ground floor tiles completion - Sep 2025

L block Ground floor tiles completion - Sep 2025

K Block Above Terrace features WIP - Sep 2025

L Block Above Terrace Floor Completed - Sep 2025

External Plastering in progress - Sep 2025

External Plastering in progress - Sep 2025

External Plastering in progress - Sep 2025

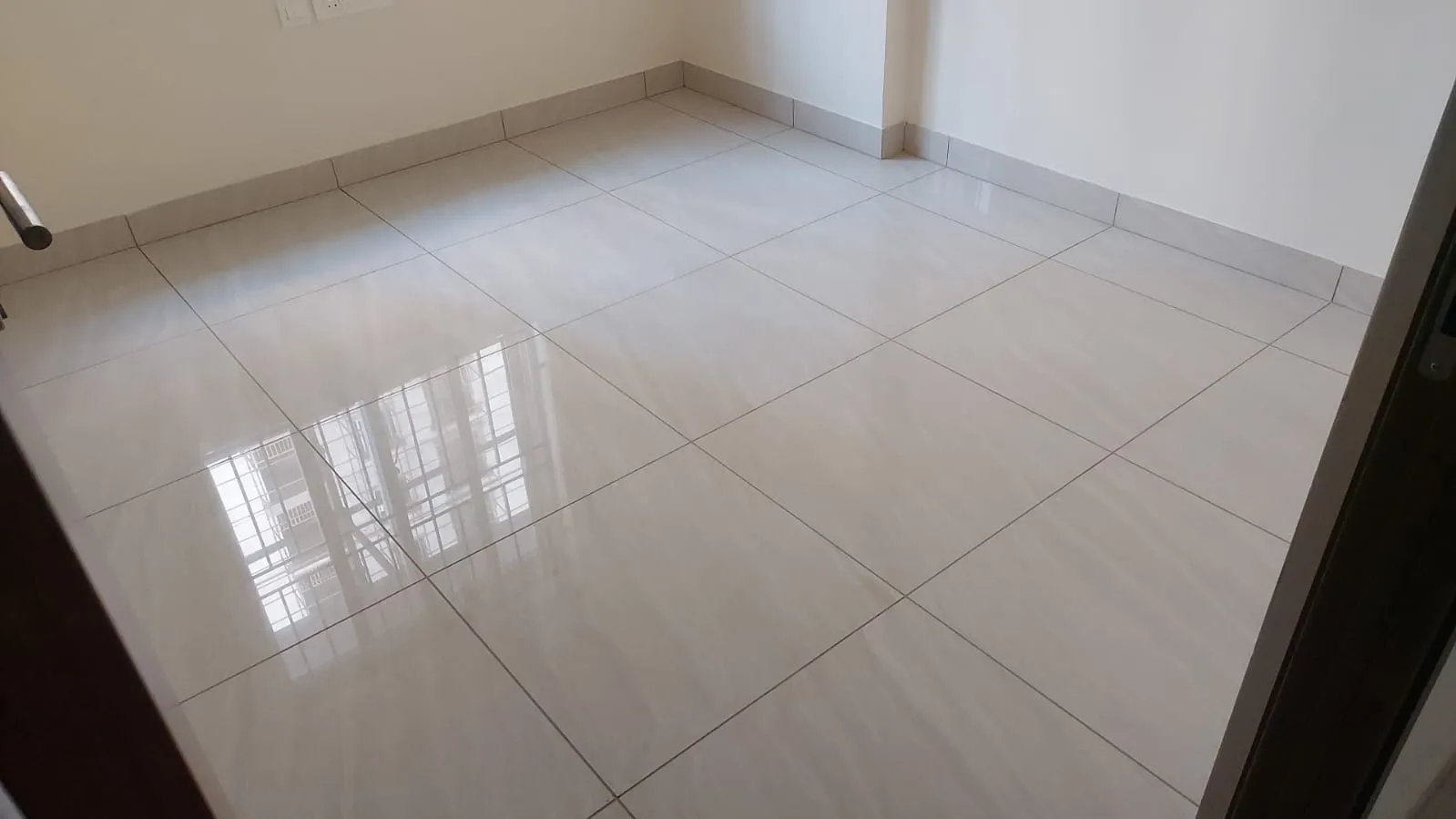

Flooring - Sep 2025

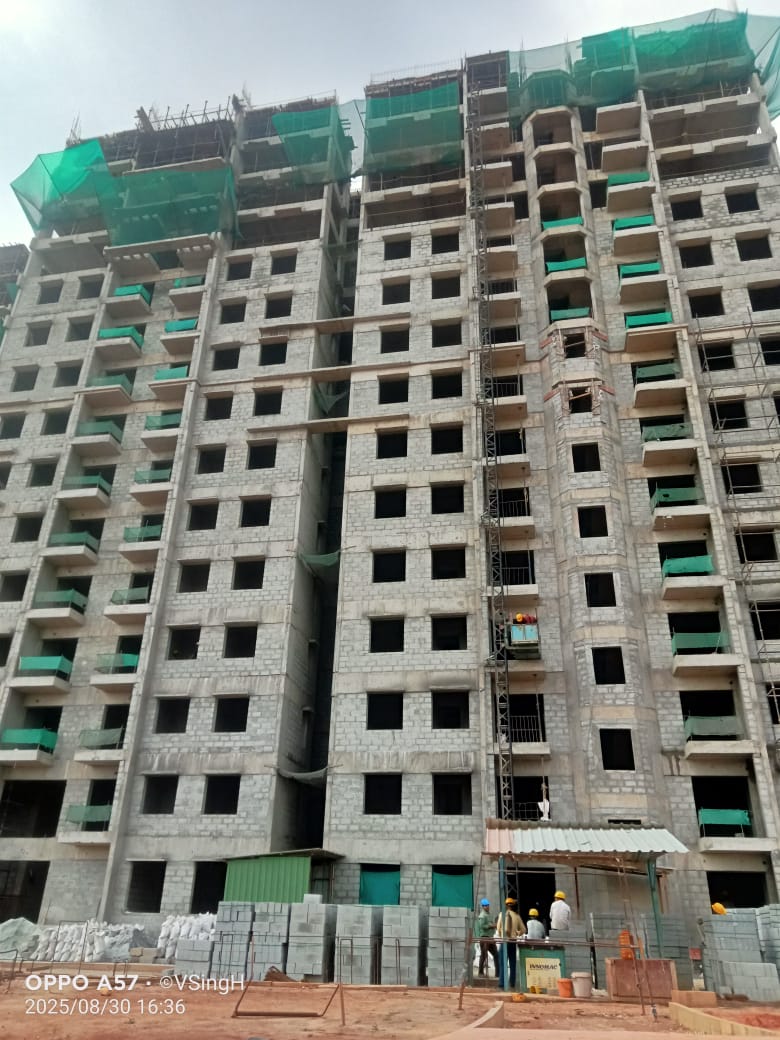

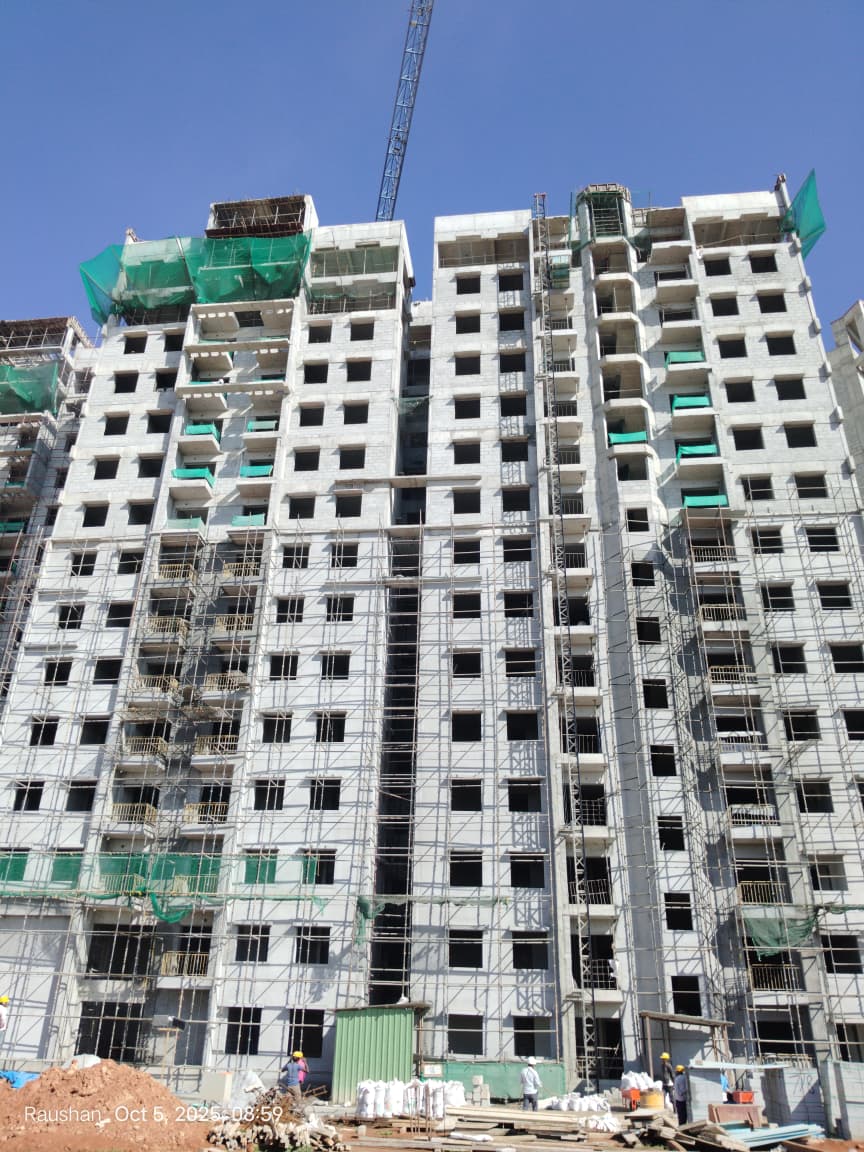

J Tower 13th Floor Blockwork work in progress - Sep 2025

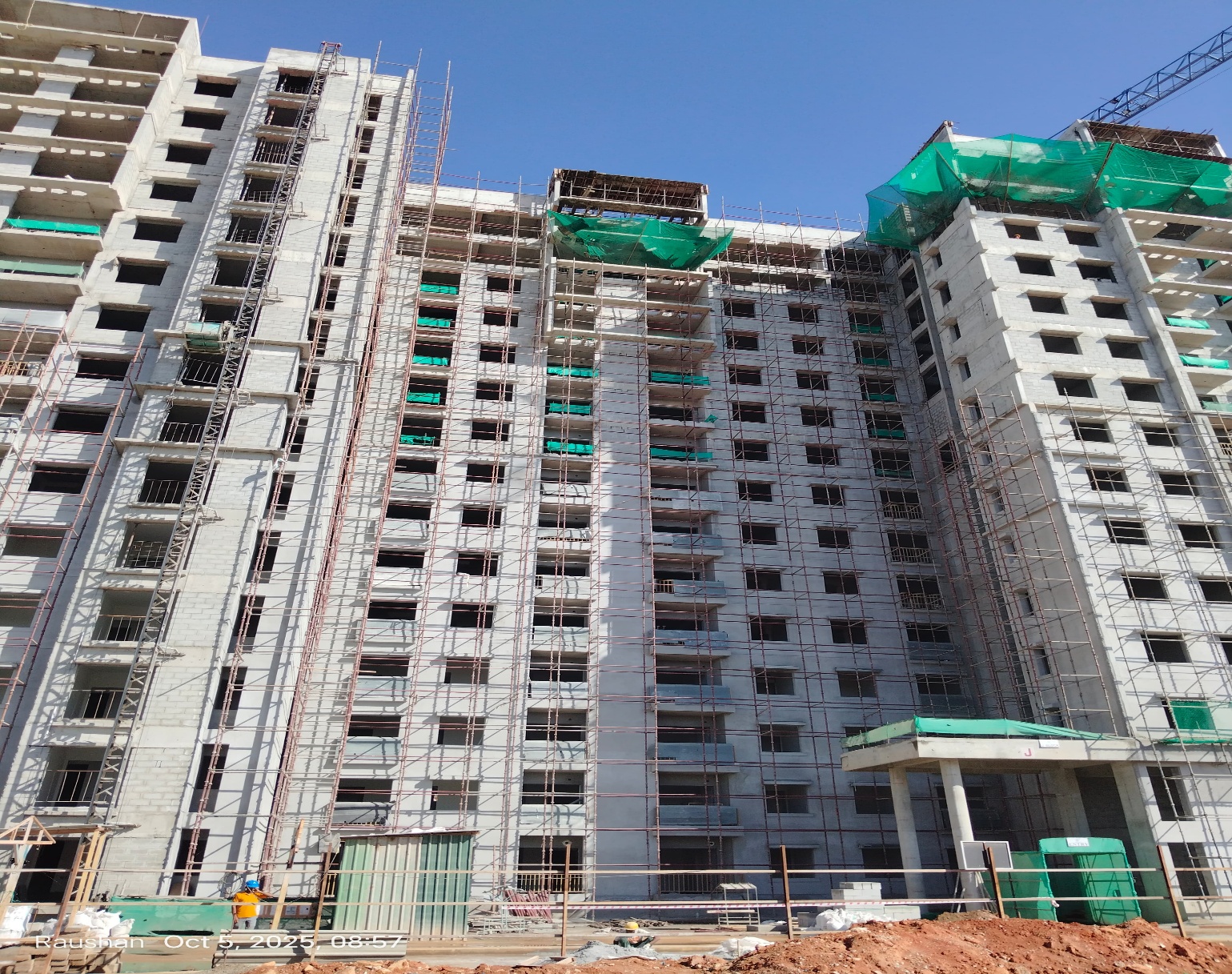

K Tower 13th FLOOR Blockwork in progress - Sep 2025

L Tower Block Work in progress - Sep 2025

J Block Above Terrace features in progress - Sep 2025

External development Work in Progress - Sep 2025

External development Work in Progress - Sep 2025

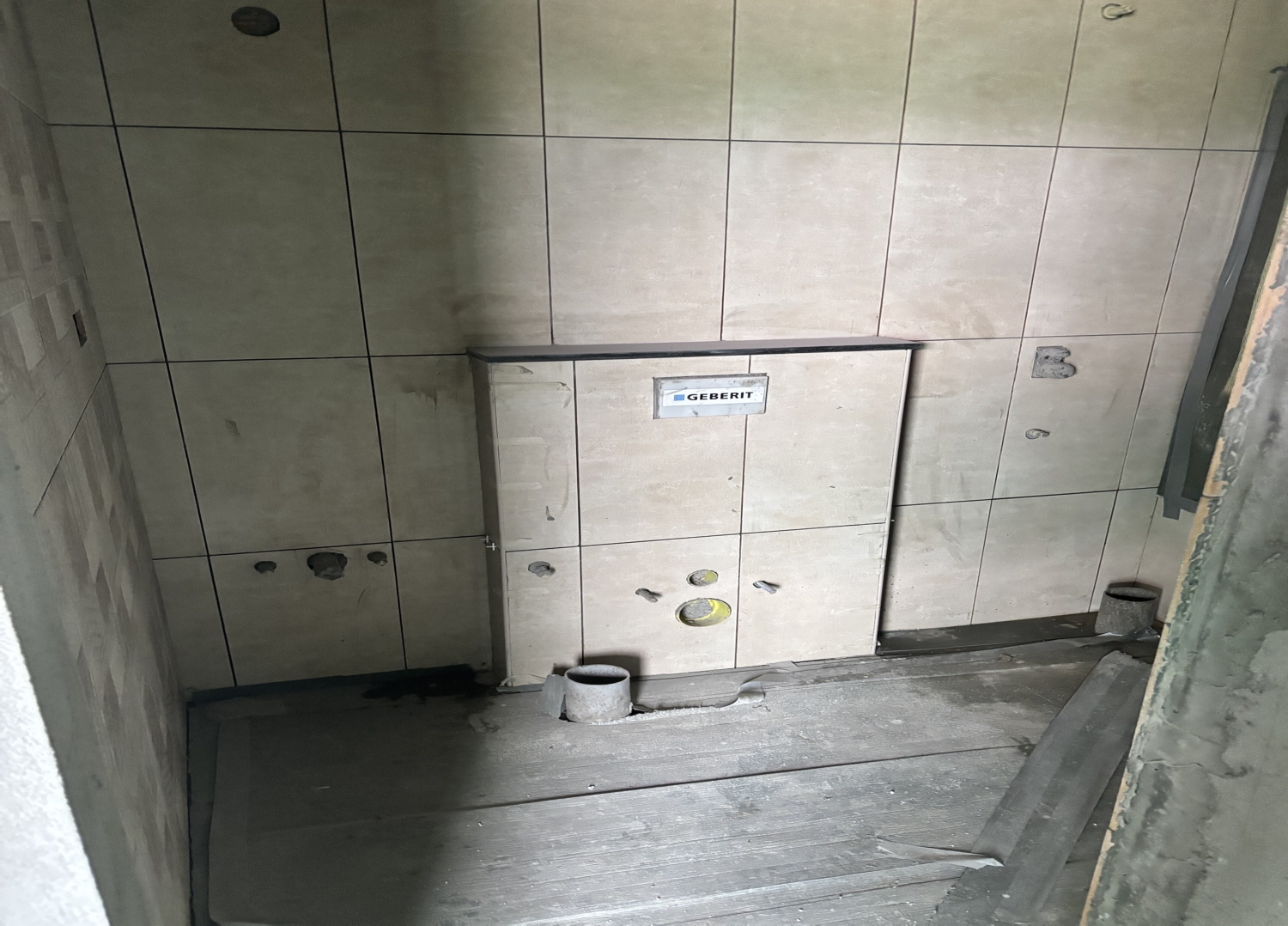

J block ground floor completion - Sep 2025

J block ground floor completion - Sep 2025

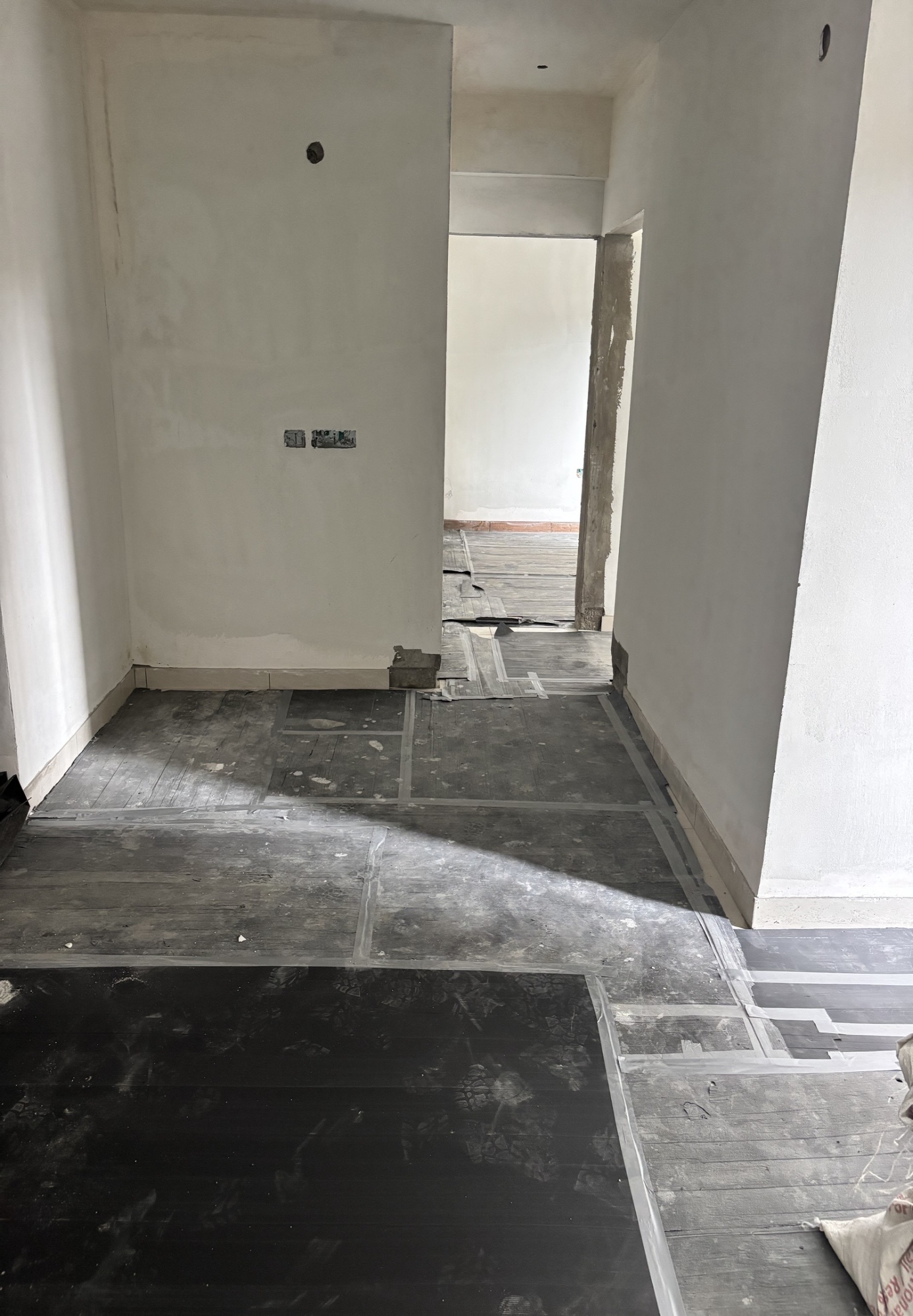

K block ground floor completion - Sep 2025

K block ground floor completion - Sep 2025

K block ground floor completion - Sep 2025

K block ground floor completion - Sep 2025

External development Works - Sep 2025

External development Work in Progress - Sep 2025

External development Work in Progress - Sep 2025

External development Works - Sep 2025

Podium Driveway Works - Sep 2025

Podium Driveway Works - Sep 2025

I Block External Texture Paint Completed - Sep 2025

I Block External Texture Paint Completed - Sep 2025

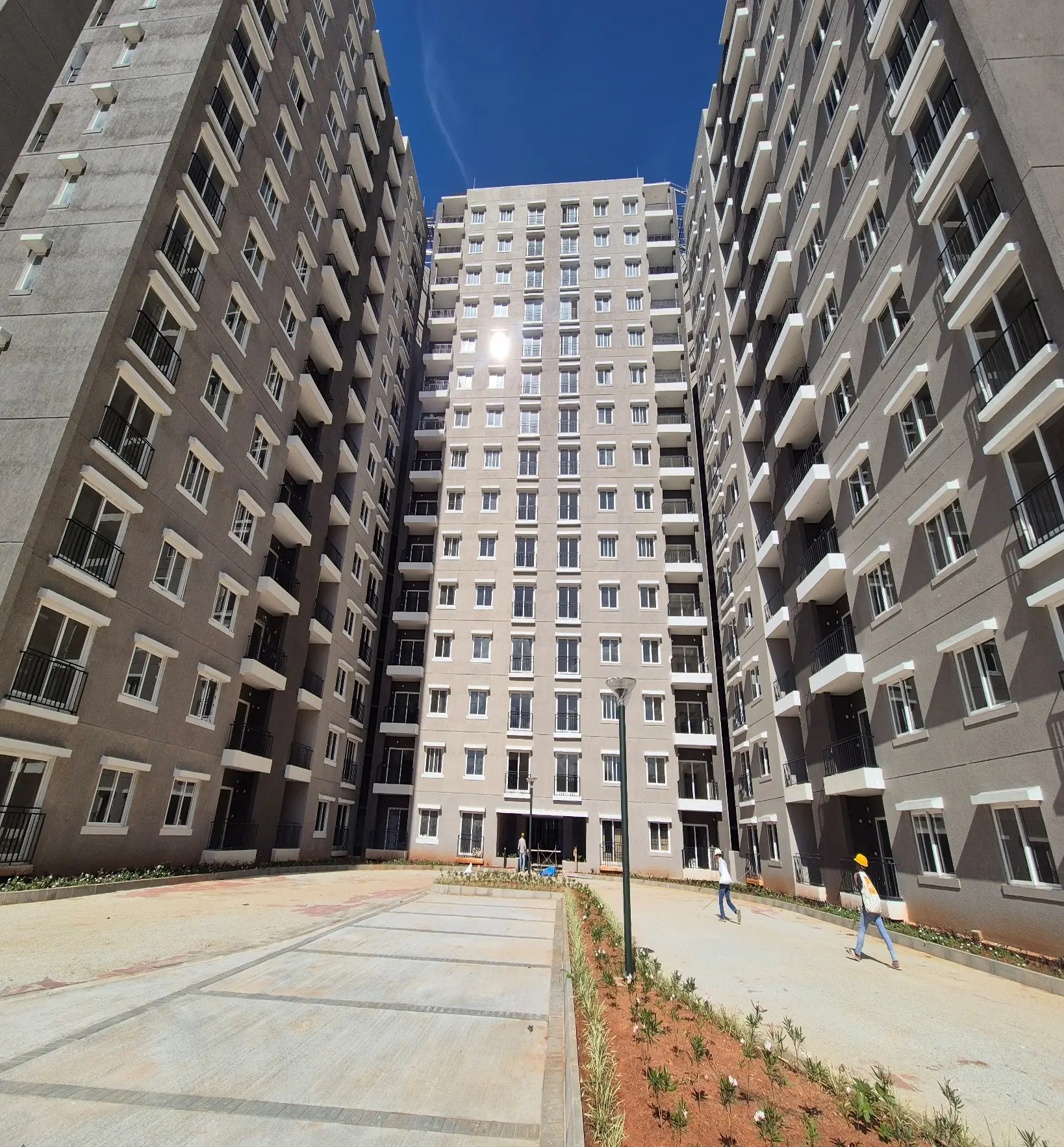

H Block External Texture Paint Completed - Sep 2025

H Block External Texture Paint Completed - Sep 2025

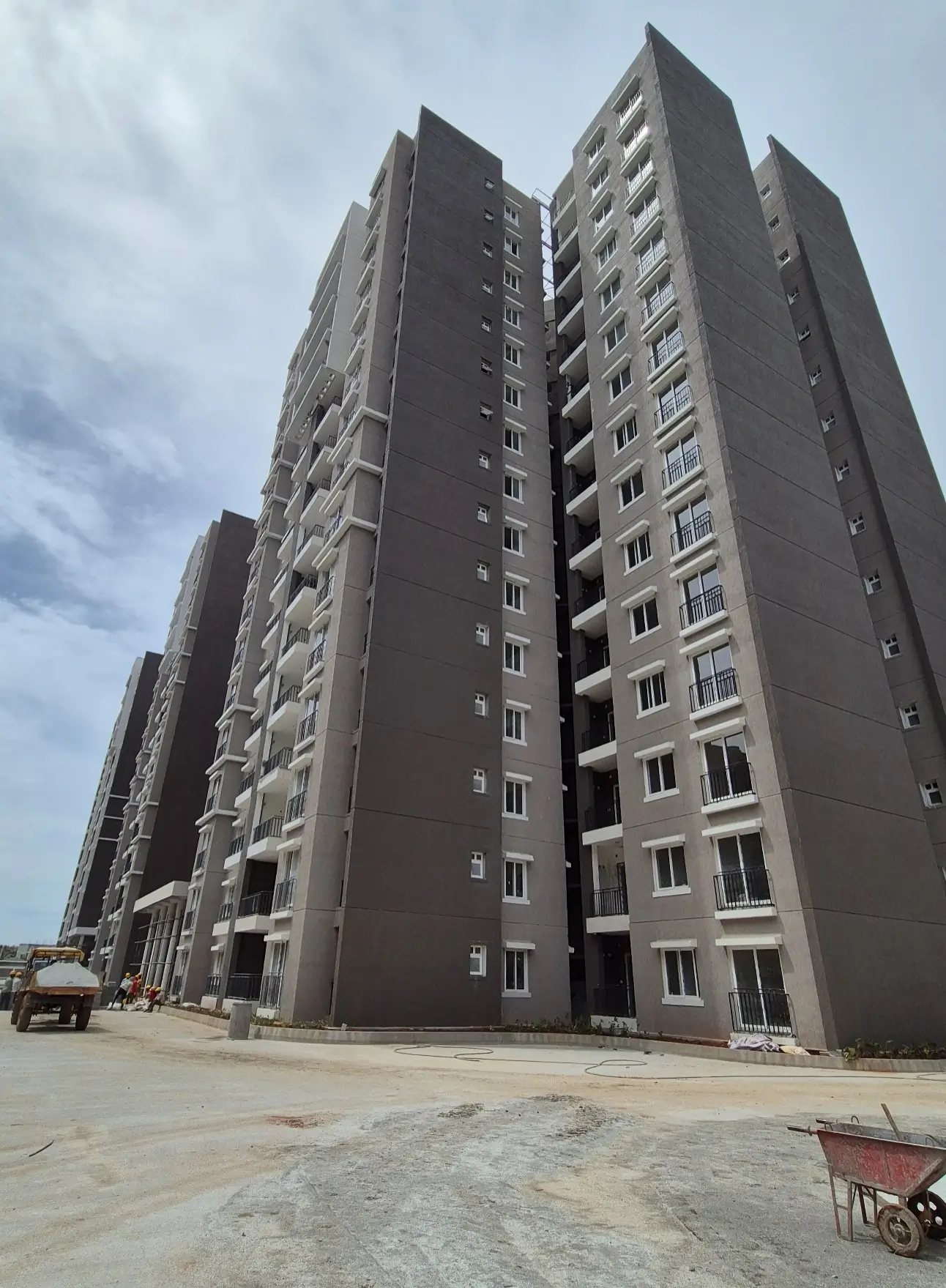

G Block External Texture Paint Completed - Sep 2025

G Block External Texture Paint Completed - Sep 2025

Clubhouse External Development WIP - Aug 2025

L Block Above Terrace Floor WIP - Aug 2025

L Block Above Terrace Floor WIP - Aug 2025

K Block Above Terrace floor WIP - Aug 2025

K Block Above Terrace floor WIP - Aug 2025

J Block Above Terrace floor WIP - Aug 2025

L Tower 13th Floor Blockwork W/P - Aug 2025

L Tower 13th Floor Blockwork W/P - Aug 2025

K Tower 13th Floor Blockwork W/P - Aug 2025

K Tower 13th Floor Blockwork W/P - Aug 2025

J Tower 10th Floor Block Work W/P - Aug 2025

J Tower 10th Floor Block Work W/P - Aug 2025

L, K, L-Block – Flooring work in progress - Aug 2025

External Plastering across Blocks LJK work in progress - Aug 2025

External Plastering across Blocks LJK work in progress - Aug 2025

External Plastering across Blocks LJK work in progress - Aug 2025

Podium Driveway Works - Aug 2025

G Block External Texture Paint Completed - Aug 2025

Ivory Phase 1 GHI - Aug 2025

H Block External Texture Paint Completed - Aug 2025

I Block External Texture Paint Completed - Aug 2025

Podium Driveway Works - Aug 2025

External Development works - Aug 2025

External Development works - Aug 2025

Clubhouse External Development WIP - Aug 2025

Clubhouse External Development WIP - Aug 2025

Clubhouse External Development WIP - Aug 2025

I Block External Texture Paint Completed - Aug 2025

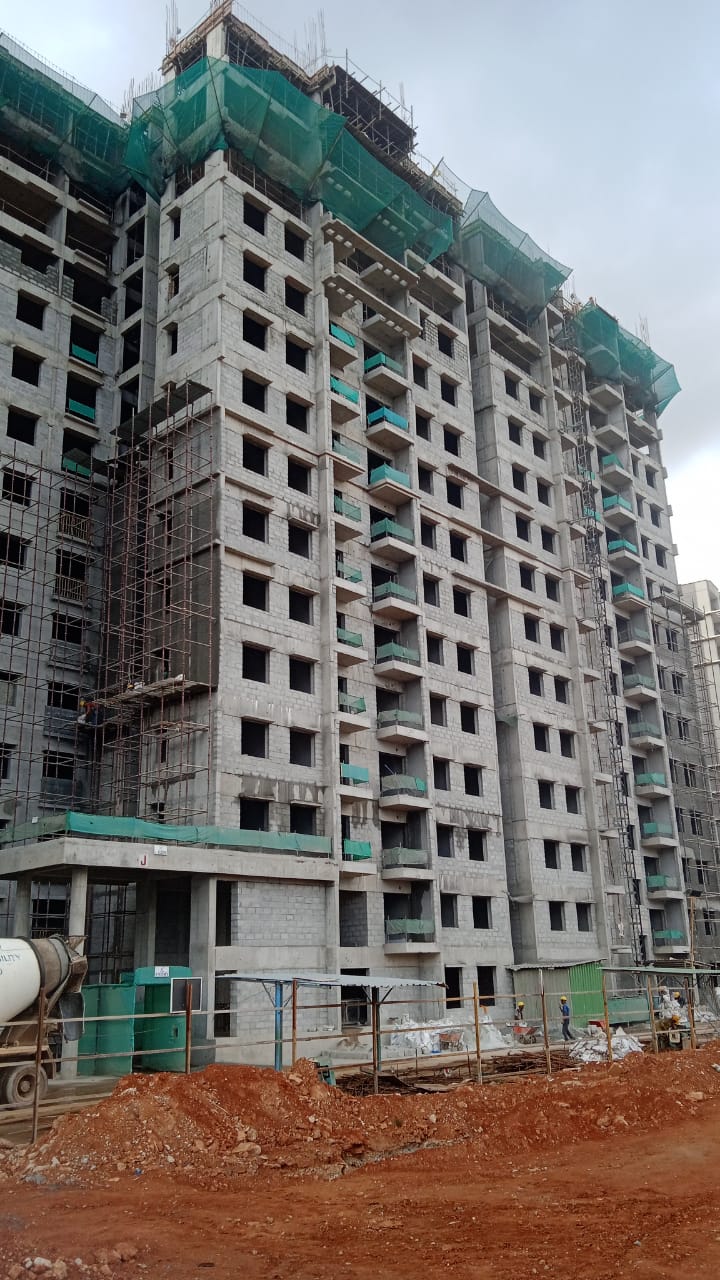

Casting Of Terrace Floor J Tower - Aug 2025

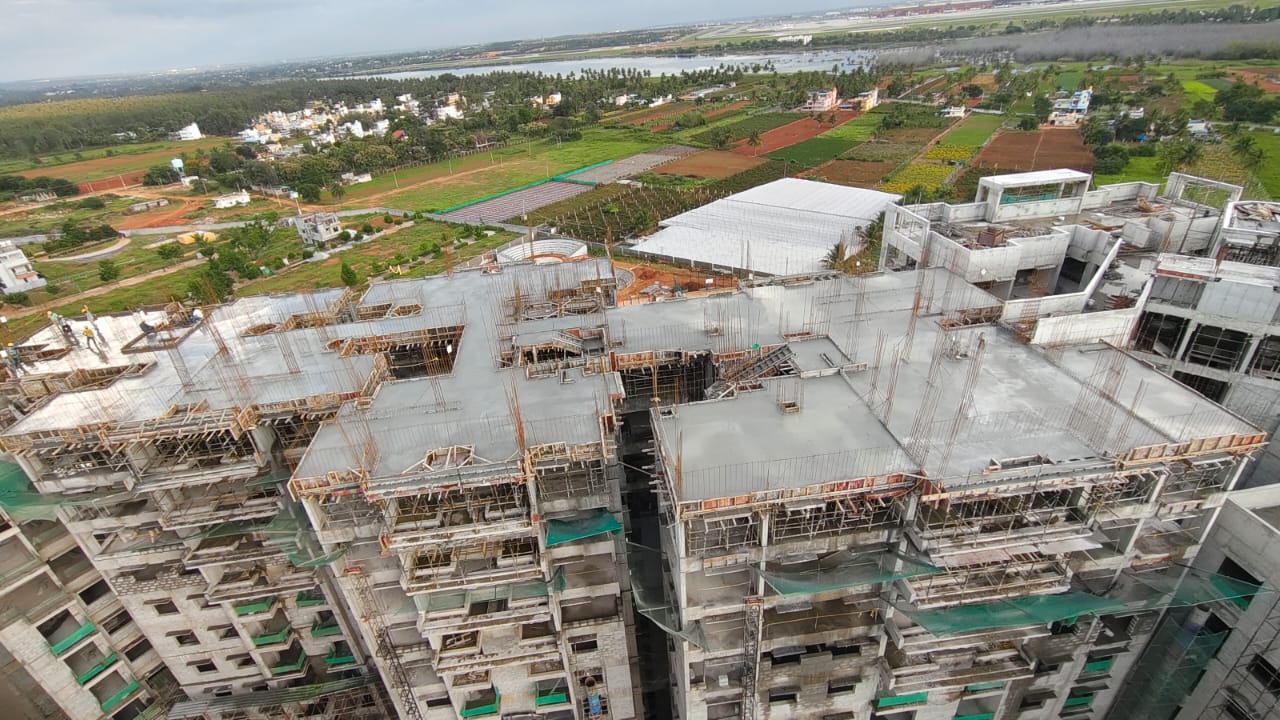

Casting Of Terrace Floor J Tower - Aug 2025

Tower L – Milestone Release –“On Casting of Terrace slab” – Status as on 08th - Aug 2025

Tower L – Milestone Release –“On Casting of Terrace slab” – Status as on 08th - Aug 2025

Tower K – Milestone Release –“ On Casting of Terrace Slab” – Status as on 02nd - Aug 2025

Tower K – Milestone Release –“ On Casting of Terrace Slab” – Status as on 02nd - Aug 2025

K Tower 12th & 9th Floor Blockwork W/P - Jul 2025

L Tower 12th Floor Blockwork W/P - Jul 2025

J Block 11th FLOOR SLAB WIP - Jul 2025

K Block Above Terrace floor WIP - Jul 2025

L BLOCK Terrace Floor & Above Terrace FLOOR WIP - Jul 2025

External Development Works - Jul 2025

Podium Driveway Works - Jul 2025

H Block External Texture Paint Completed - Jul 2025

I Block External Texture Paint Completed - Jul 2025

G Block External Texture Paint Completed - Jul 2025

G Block External Texture Paint Completed - Jul 2025

Ivory Phase 1 GHI - Jul 2025

Clubhouse External Development WIP - Jul 2025

Clubhouse External Development WIP - Jul 2025

Podium Driveway Works - Jul 2025

Ivory Phase 1 GHI - Jul 2025

Clubhouse External Development WIP - Jul 2025

External Development Works - Jul 2025

Clubhouse External Development WIP - Jul 2025

External plaster - Jul 2025

L-block 3rd Floor in Progress ,k-Block 2nd Floor in Progress & j –Block ground Floor in progress - Jul 2025

J Tower 9th Floor Blockwork W/P - Jul 2025

G Block External Texture Paint WIP - Jun 2025

Clubhouse - External Development WIP - Jun 2025

Clubhouse - External Development WIP - Jun 2025

Clubhouse - External Development WIP - Jun 2025

Clubhouse - External Development WIP - Jun 2025

External Development Works - Jun 2025

Podium Waterproofing Works - Jun 2025

Podium Waterproofing Works - Jun 2025

I Block External Texture Paint Completed - Jun 2025

H Block External Texture Paint Completed - Jun 2025

H Block External Texture Paint Completed - Jun 2025

G Block External Texture Paint WIP - Jun 2025

Ivory Phase 1 GHI - Jun 2025

Tower J – Milestone Release –“On Casting of 10th Floor Slab” – Status as on 25th - Jun 2025

Tower J – Milestone Release –“On Casting of 10th Floor Slab” – Status as on 25th - Jun 2025

J Tower 4st Floor Blockwork WIP - May 2025

K Tower 8th & 5th Floor Blockwork WIP - May 2025

L Tower 9th Floor Blockwork WIP - May 2025

J Block 10th Floor Slab WIP - May 2025

K Block 10, 12th & 13 Floor WIP - May 2025

L Block 12th & 13th Floor WIP - May 2025

Ivory Phase 1 GHI - May 2025

G Block External Texture Paint WIP - May 2025

I Block External Texture Paint Completed - May 2025

I Block External Texture Paint Completed - May 2025

Clubhouse External Development WIP - May 2025

Clubhouse External Development WIP - May 2025

Clubhouse External Development WIP - May 2025

Clubhouse External Development WIP - May 2025

External Development Works - May 2025

Podium Waterproofing Works - May 2025

Podium Waterproofing Works - May 2025

H Block External Texture Paint Completed - May 2025

H Block External Texture Paint Completed - May 2025

G Block External Texture Paint WIP - May 2025

J Tower 4th Floor Block Work W/P - May 2025

K Tower 8th and 5th Floor Block Work W/P - May 2025

L Tower 9th Floor Block Work W/P - May 2025

J Block 10th Floor Slab WIP - May 2025

K Block 10,12th and 13th Floor WIP - May 2025

L Block 11th & 12th Floor WIP - May 2025

Casting of 10th Floor in L-Wing - Apr 2025

J Tower 1st Floor Block Work W/P - Apr 2025

K Tower 5th Floor Block Work W/P - Apr 2025

L Tower 7th Floor Block Work W/P - Apr 2025

J Block 7th & 8th Floor Slab WIP - Apr 2025

K Block 11th Floor WIP - Apr 2025

L Block 11th & 12th Floor WIP - Apr 2025

G Block External Texture Paint WIP - Apr 2025

G Block External Texture Paint WIP - Apr 2025

Ivory Phase 1 GHI - Apr 2025

Casting of 10th Floor in K-Wing - Apr 2025

Casting of 10th Floor in K-Wing - Apr 2025

Casting of 10th Floor in L-Wing - Apr 2025

Clubhouse Interior WIP - Mar 2025

Clubhouse External Development WIP - Mar 2025

Clubhouse External Development WIP - Mar 2025

Clubhouse External Development WIP - Mar 2025

Clubhouse Interior WIP - Mar 2025

Clubhouse WIP - Mar 2025

I Block External Texture Paint Completed - Mar 2025

I Block External Texture Paint Completed - Mar 2025

H Block External Texture Paint Completed - Mar 2025

H Block External Texture Paint Completed - Mar 2025

G Block External Texture Paint WIP - Mar 2025

G Block External Texture Paint WIP - Mar 2025

Ivory Phase 1 GHI - Mar 2025

L Block 8th & 9th Floor Slab WIP - Feb 2025

Casting of 5th floor J Block - Feb 2025

J Block Front Elevation - Feb 2025

J Tower 1st Floor Blockwork W/P - Feb 2025

K Tower 5rd Floor Blockwork W/P - Feb 2025

L Tower 5th& 6th Floor Blockwork W/P - Feb 2025

J Block 6th and 8th Floor Slab WIP - Feb 2025

K Block 6th and 8th Floor Slab WIP - Feb 2025

L Block 9th & 10th Floor Slab WIP - Feb 2025

Clubhouse WIP - Feb 2025

Clubhouse External Development WIP - Feb 2025

Clubhouse External Development WIP - Feb 2025

Clubhouse External Development WIP - Feb 2025

Clubhouse Interior WIP - Feb 2025

Clubhouse Interior WIP - Feb 2025

H Block External Texture Paint WIP - Feb 2025

H Block External Texture Paint WIP - Feb 2025

H Block External Texture Paint WIP - Feb 2025

G Block External Texture Paint WIP - Feb 2025

G Block External Texture Paint WIP - Feb 2025

G Block External Texture Paint WIP - Feb 2025

Ivory Phase 1 GHI - Feb 2025

J Tower GFnd Floor Blockwork W/P - Feb 2025

K Tower 4rd Floor Blockwork W/P - Feb 2025

L Tower 4rd Floor Blockwork W/P - Feb 2025

J Block 3nd, 4rd Floor Slab WIP - Feb 2025

K Block 6th and 8th Floor Slab WIP - Feb 2025

Ivory Ph-01 G - Block: On Commencement of Fixing of D&W (11-14F) - Jan 2025

Ivory Phase 1 GHI - Jan 2025

K Tower 3rd Floor Blockwork WIP - Jan 2025

J Block 2nd, 3rd Floor Slab WIP - Jan 2025

K Block 5th and 7th Floor Slab WIP - Jan 2025

L Block 7th Floor Slab WIP - Jan 2025

L Tower 3rd Floor Blockwork WIP - Jan 2025

Podium Slab Completed - Jan 2025

Clubhouse External Development WIP - Jan 2025

Clubhouse External Development WIP - Jan 2025

Clubhouse External Development WIP - Jan 2025

Club House Interior WIP - Jan 2025

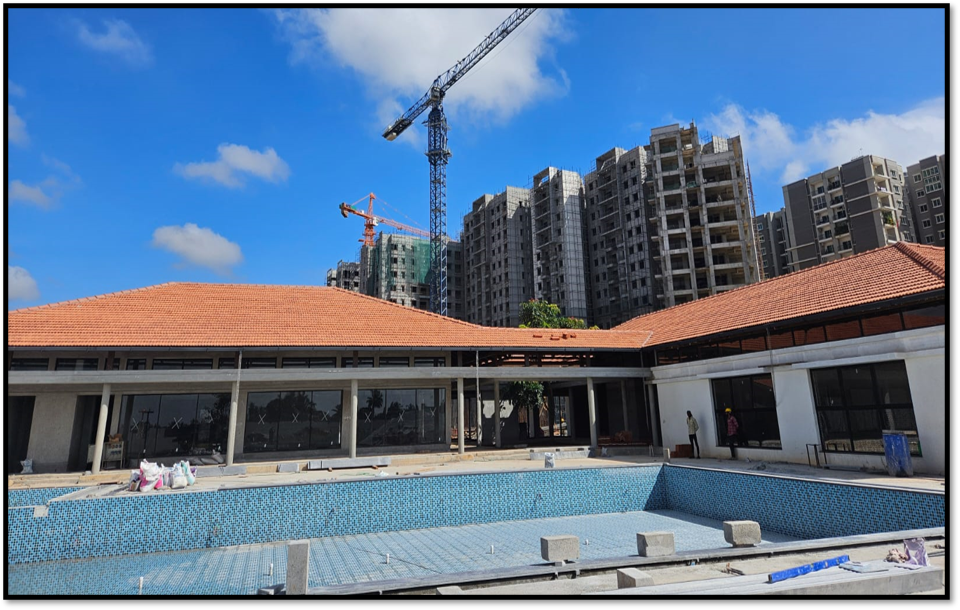

Clubhouse WIP - Jan 2025

I Block External Texture Paint WIP - Jan 2025

I Block External Texture Paint WIP - Jan 2025

H Block External Texture Paint WIP - Jan 2025

H Block External Texture Paint WIP - Jan 2025

G Block External Texture Paint WIP - Jan 2025

G Block External Texture Paint WIP - Jan 2025

Ivory Ph-01 G - Block: On Commencement of Fixing of D&W (11-14F) - Jan 2025

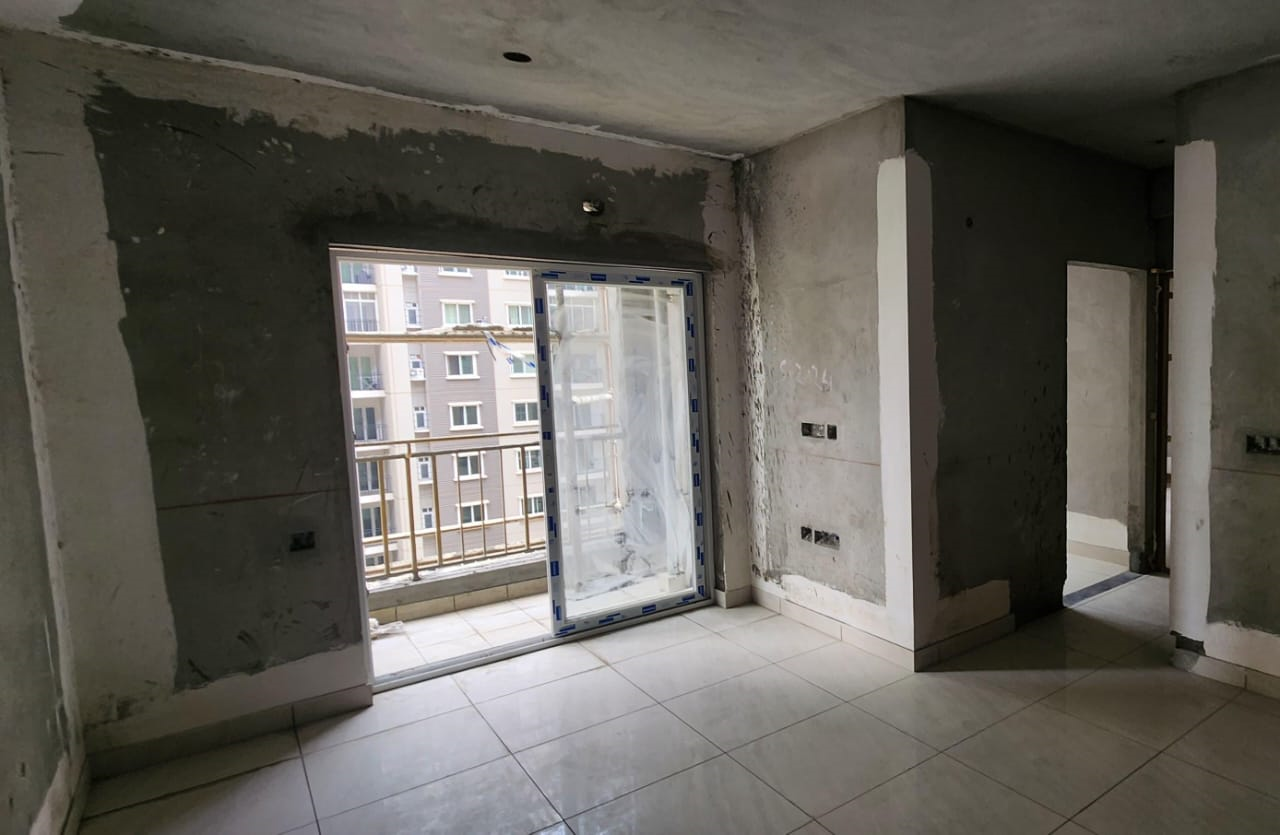

Ivory Ph-01 G - Block: On Commencement of Fixing of D&W (11-14F) - Jan 2025

Ivory Ph-01 G - Block: On Commencement of Fixing of D&W (11-14F) - Jan 2025

Tower K – Milestone Release –“On Casting of 5th Floor Slab” – Status as on 16th - Jan 2025

Tower K – Milestone Release –“On Casting of 5th Floor Slab” – Status as on 16th - Jan 2025

Casting of 5th Floor Slab in L-Tower - Jan 2025

Casting of 5th Floor Slab in L-Tower - Jan 2025

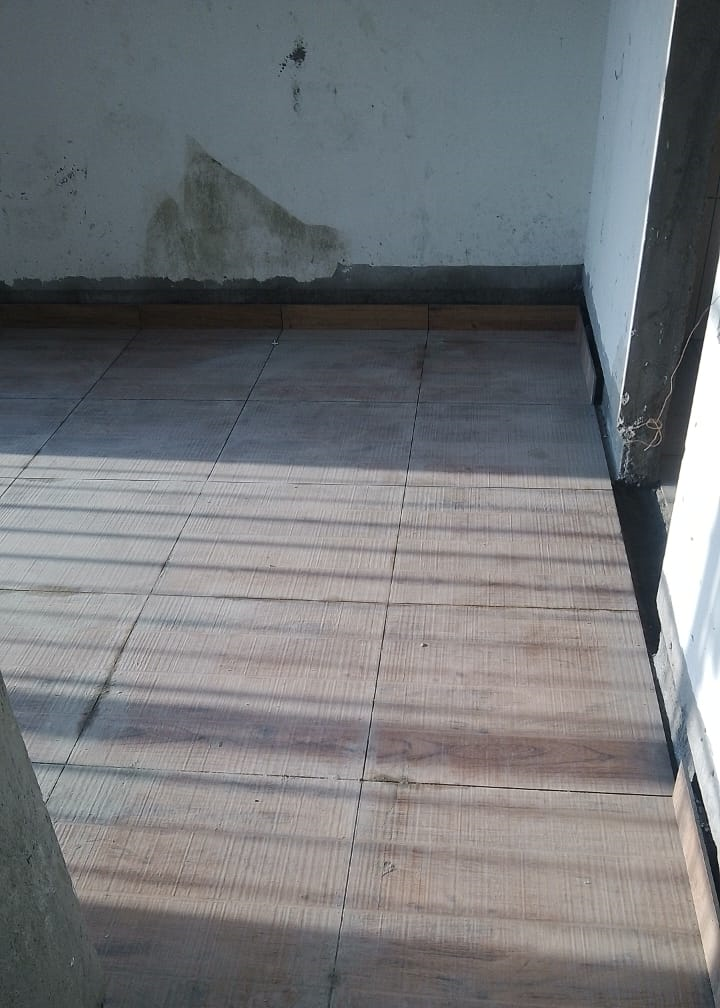

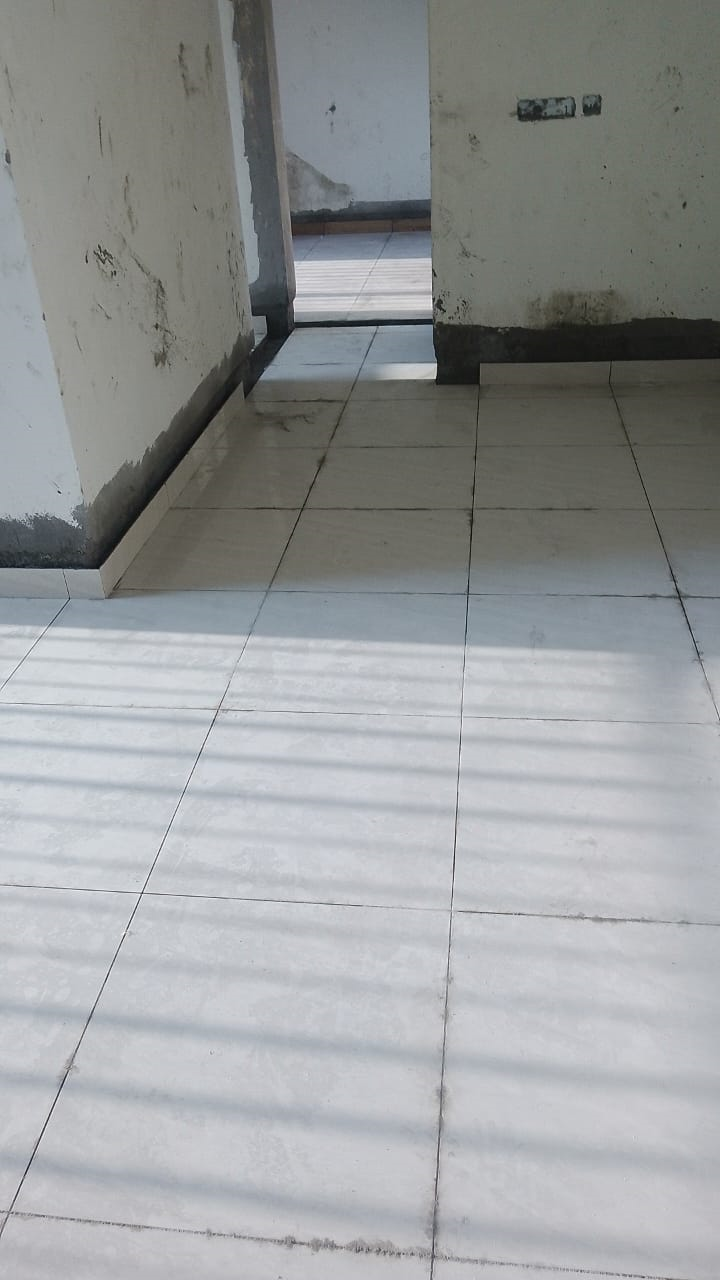

Tower G – Milestone Release –“On Commencement of Flooring 11th to 14th Floor” – Status as on 24th - Dec 2024

Tower G – Milestone Release –“On Commencement of Flooring 11th to 14th Floor” – Status as on 24th - Dec 2024

Club House External Development WIP - Dec 2024

Club House External Development WIP - Dec 2024

Clubhouse Interior WIP - Dec 2024

Clubhouse - Dec 2024

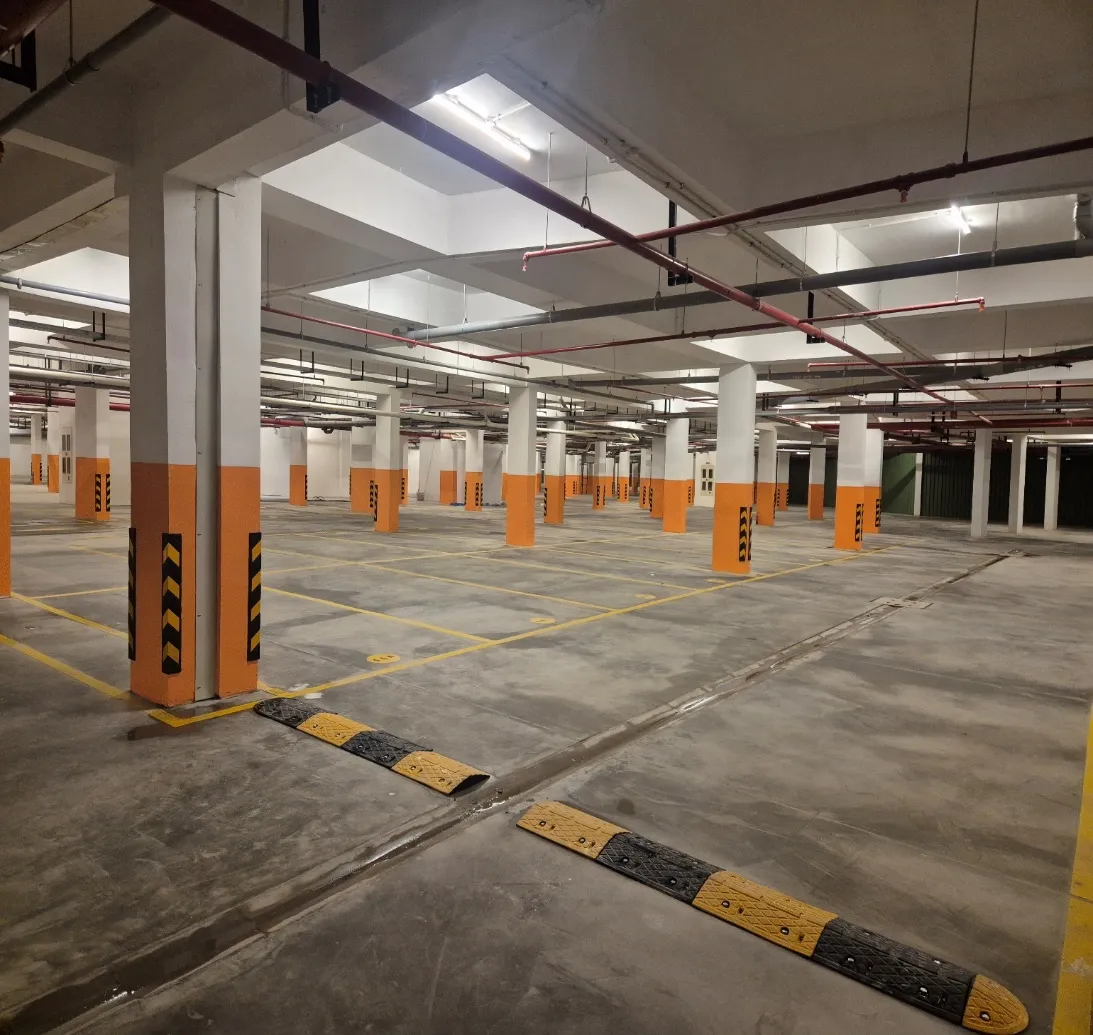

UG Sump Pump Room WIP - Dec 2024

I Block External Texture Paint WIP - Dec 2024

I Block External Texture Paint WIP - Dec 2024

H Block External Texture Paint WIP - Dec 2024

H Block External Texture Paint WIP - Dec 2024

G Block External Plastering WIP - Dec 2024

G Block External Plastering WIP - Dec 2024

Ivory Phase -1 GHI - Dec 2024

Podium 3 Slab - Dec 2024

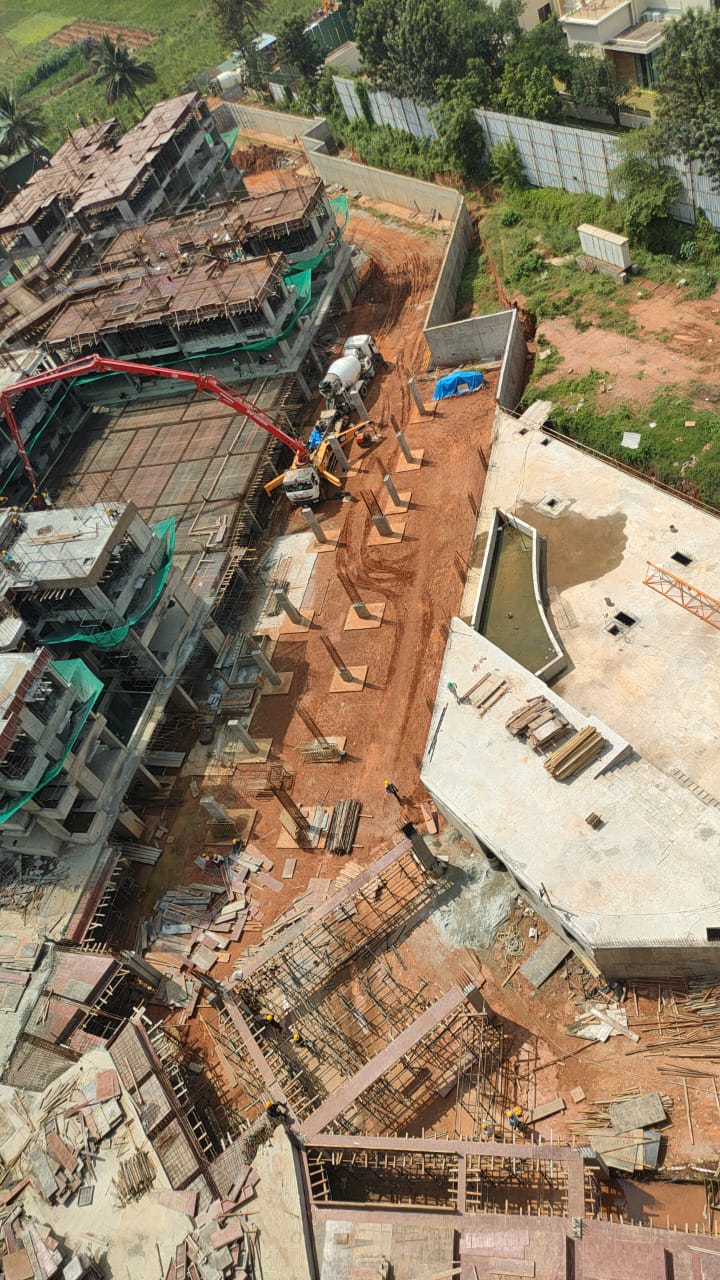

Podium Slab Grade slab pcc and slab shuttering WIP - Dec 2024

J Block 2nd Floor SLAB WIP - Dec 2024

K Block 3rd, 5th and 6th Floor SLAB WIP - Dec 2024

L Block 5th Floor SLAB WIP - Dec 2024

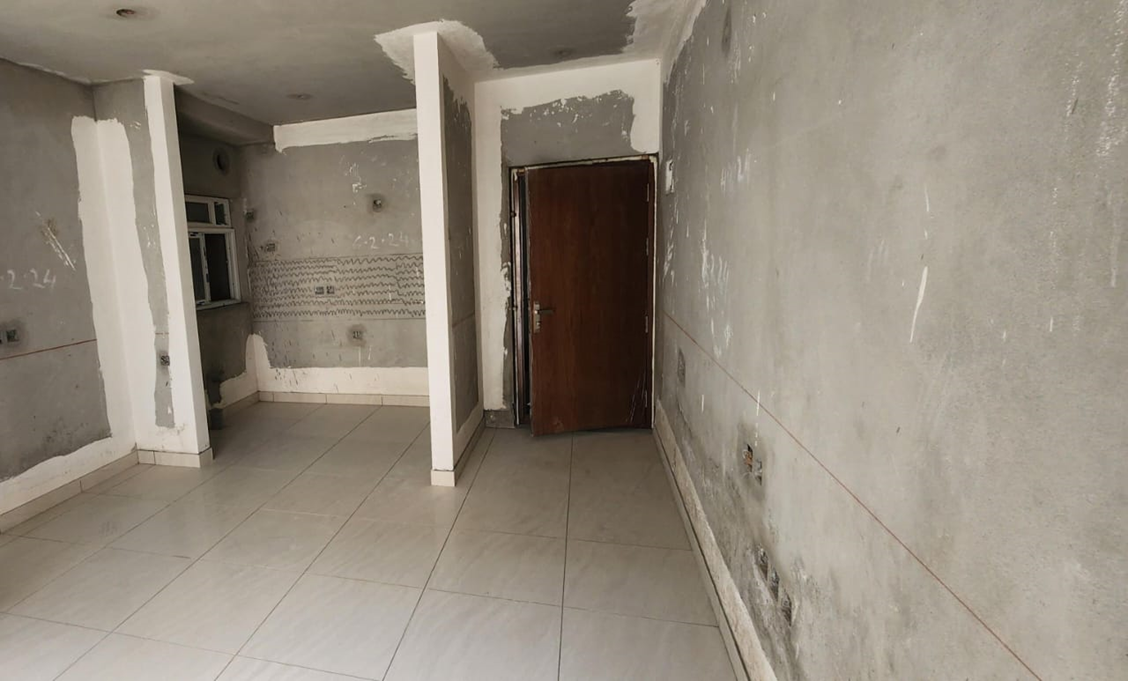

Tower G – Milestone Release –“On Commencement of Flooring 11th to 14th Floor” – Status as on 24th - Dec 2024

Tower G – Milestone Release –“On Commencement of Flooring 11th to 14th Floor” – Status as on 24th - Dec 2024

Tower G – Milestone Release –“On Commencement of Flooring 11th to 14th Floor” – Status as on 24th - Dec 2024

Tower G – Milestone Release –“On Installation of Lifts” – Status as on 10th - Dec 2024

Tower G – Milestone Release –“On Installation of Lifts” – Status as on 10th - Dec 2024

Tower G – Milestone Release –“On Installation of Lifts” – Status as on 10th - Dec 2024

J Block 1st & 2nd and 3rd Floor Slab WIP - Nov 2024

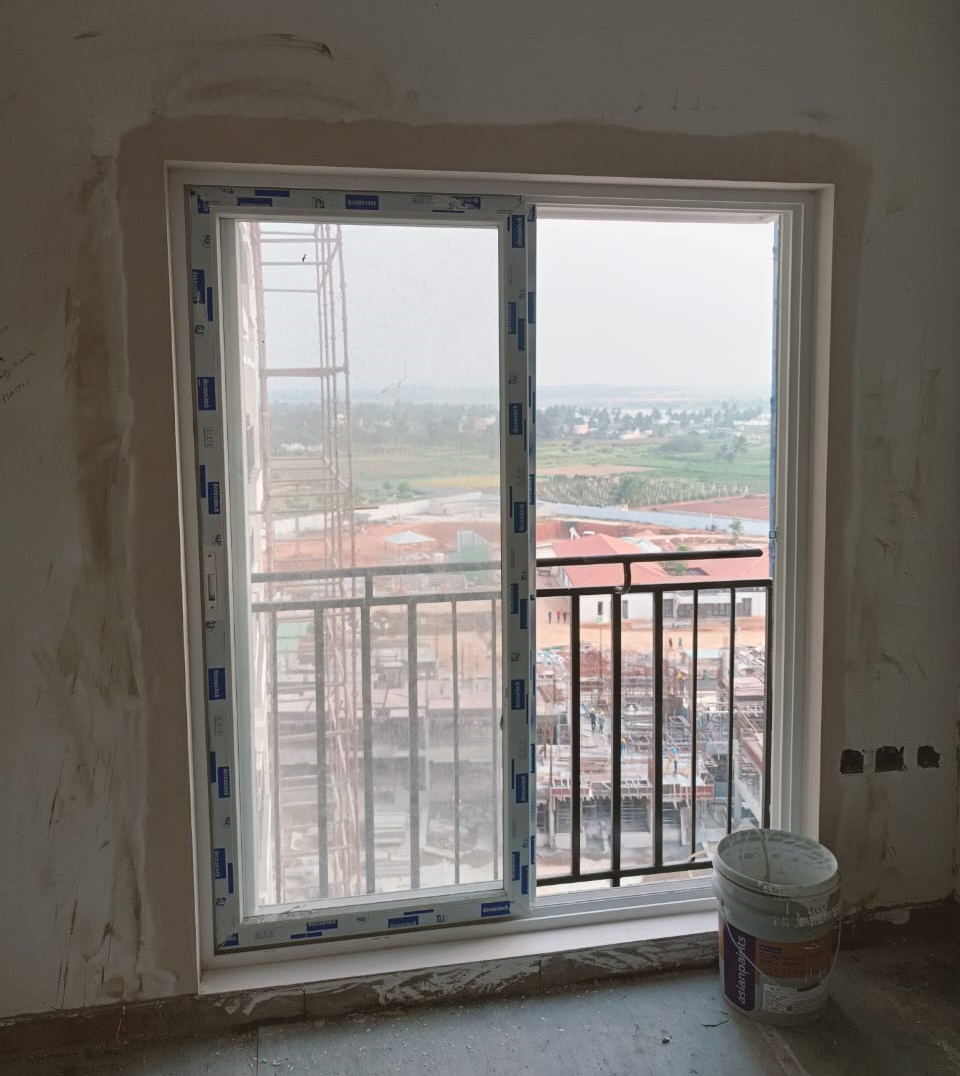

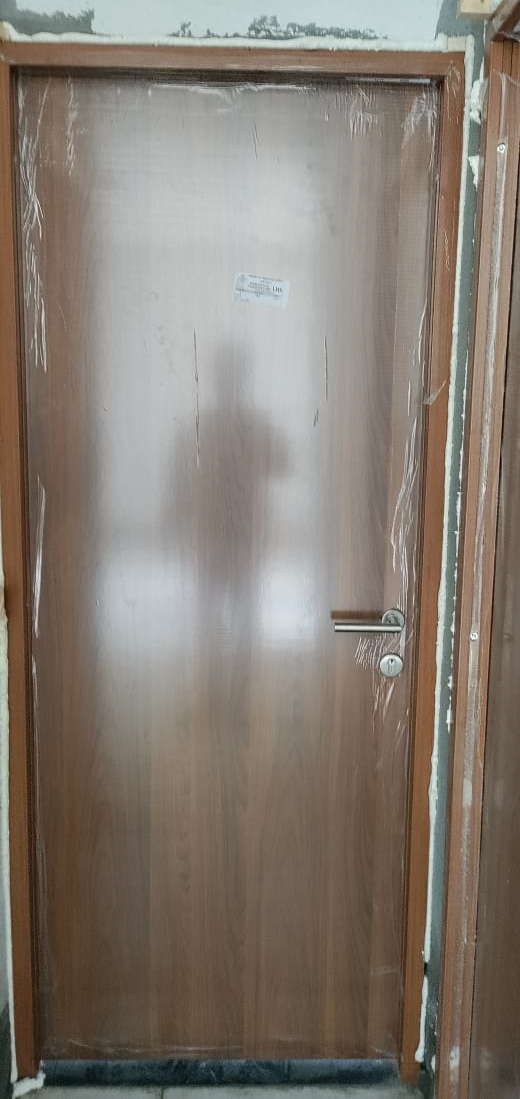

Tower H – Milestone Release –“On Commencement of Fixing of doors & Windows” -Status as on 11th - Nov 2024

Tower H – Milestone Release –“On Commencement of Fixing of doors & Windows” -Status as on 11th - Nov 2024

Tower H – Milestone Release –“On Commencement of Fixing of doors & Windows” -Status as on 11th - Nov 2024

L and K Block GF Blockwork WIP - Nov 2024

L and K Block GF Blockwork WIP - Nov 2024

Podium Slab Shuttering WIP - Nov 2024

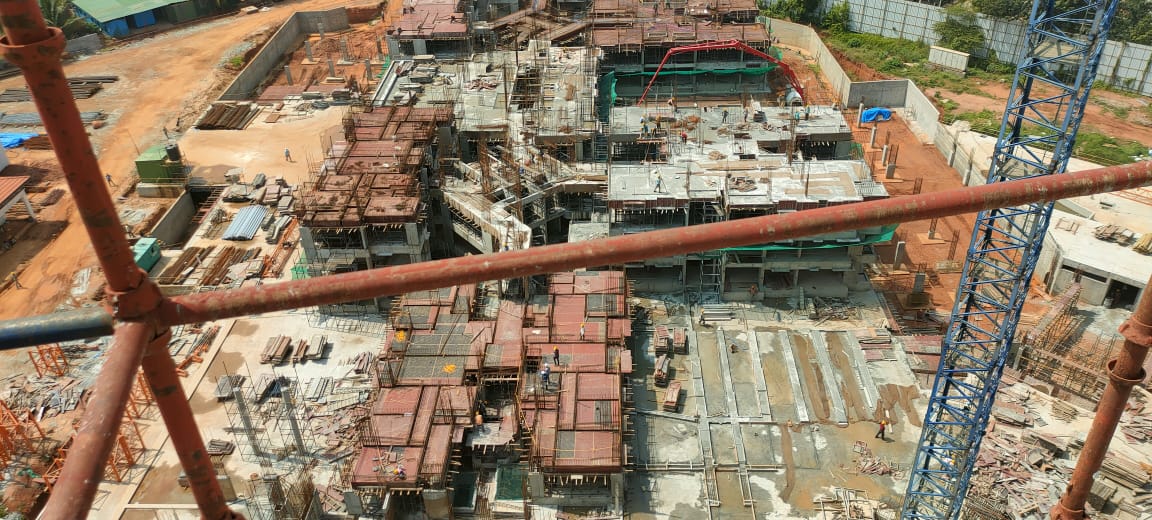

K Block 2nd and 3rd Floor Slab WIP - Nov 2024

L Block 4th Floor Slab WIP - Nov 2024

Clubhouse Interior WIP - Nov 2024

Clubhouse WIP - Nov 2024

I block external texture paint WIP - Nov 2024

I block external texture paint WIP - Nov 2024

H block external texture paint WIP - Nov 2024

H block external texture paint WIP - Nov 2024

G Block External Plastering WIP - Nov 2024

G Block External Plastering WIP - Nov 2024

Ivory Phase -1 GHI - Nov 2024

Tower I – Milestone Release – “On Commencement of fixing of Doors and Windows -11th to 14th Floor” – Status as on 25th - Nov 2024

Tower I – Milestone Release – “On Commencement of fixing of Doors and Windows -11th to 14th Floor” – Status as on 25th - Nov 2024

I- Block: On commencement of Painting (11 to 14F) - Nov 2024

I- Block: On commencement of Painting (11 to 14F) - Nov 2024

I- Block: On commencement of flooring (11 to 14F) - Nov 2024

I- Block: On commencement of flooring (11 to 14F) - Nov 2024

L BLOCK 2nd and 3rd FLOOR SLAB WIP - Oct 2024

Ivory Phase -1 GHI - Oct 2024

I block external texture paint WIP - Oct 2024

I block external texture paint WIP - Oct 2024

H block external texture paint WIP - Oct 2024

H block external texture paint WIP - Oct 2024

G Block External Plastering WIP - Oct 2024

G Block External Plastering WIP - Oct 2024

Ivory Phase -1 GHI - Oct 2024

Tower J – Milestone Release –“On Casting of Ground Floor slab” – Status as on 28th - Oct 2024

Tower I –“ On Commencement of fixing of Doors and Windows 06th to 10th Floor” – Status as on 29th - Oct 2024

G- Block: On commencement of Painting (6 to 10F) - Oct 2024

G- Block: On commencement of Painting (6 to 10F) - Oct 2024

G- Block: On commencement of Painting (6 to 10F) - Oct 2024

Tower G –“ On Commencement of Painting 06th to 10th Floor” – Status as on 29th - Oct 2024

H- Block: On commencement of Painting (6 to 10F) - Oct 2024

H- Block: On commencement of Painting (6 to 10F) - Oct 2024

Tower H – Milestone Release –“On Commencement of Fixing of Doors & Windows 06th to 10th Floor – Status as on 30th - Oct 2024

Tower H – Milestone Release –“On Commencement of Painting 06th to 10th Floor – Status as on 30th Oct - Oct 2024

Clubhouse - WIP - Oct 2024

PODIUM 3 SLAB WIP - Oct 2024

Podium Slab Grade slab pcc and slab shuttering WIP - Oct 2024

J BLOCK 1st FLOOR SLAB WIP - Oct 2024

K BLOCK 2nd and 3rd FLOOR SLAB WIP - Oct 2024

Tower K – Milestone Release –“On Casting of Ground Floor Slab” – Status as on 08th - Oct 2024

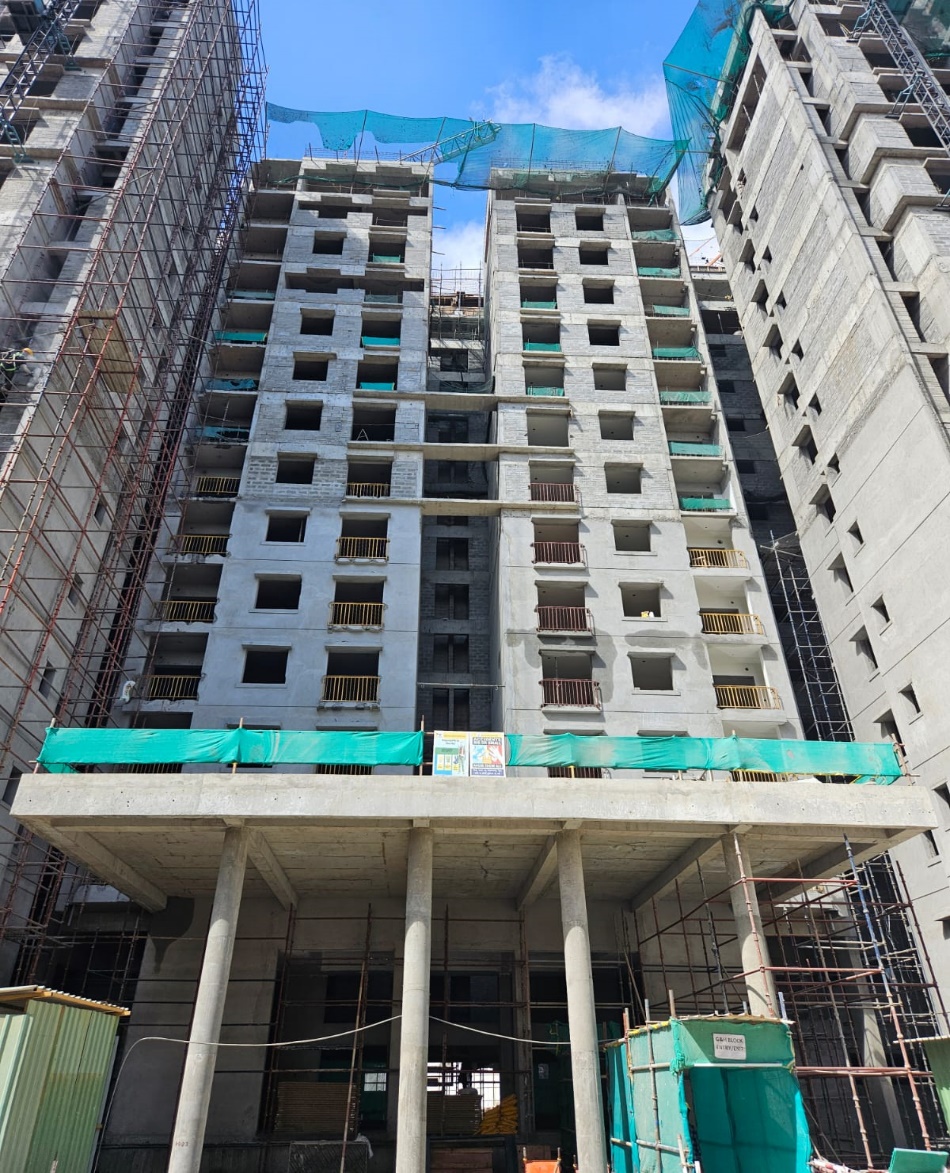

G Block Structure Completed - Sep 2024

Ivory Phase -1 GHI - Sep 2024

Clubhouse WIP - Sep 2024

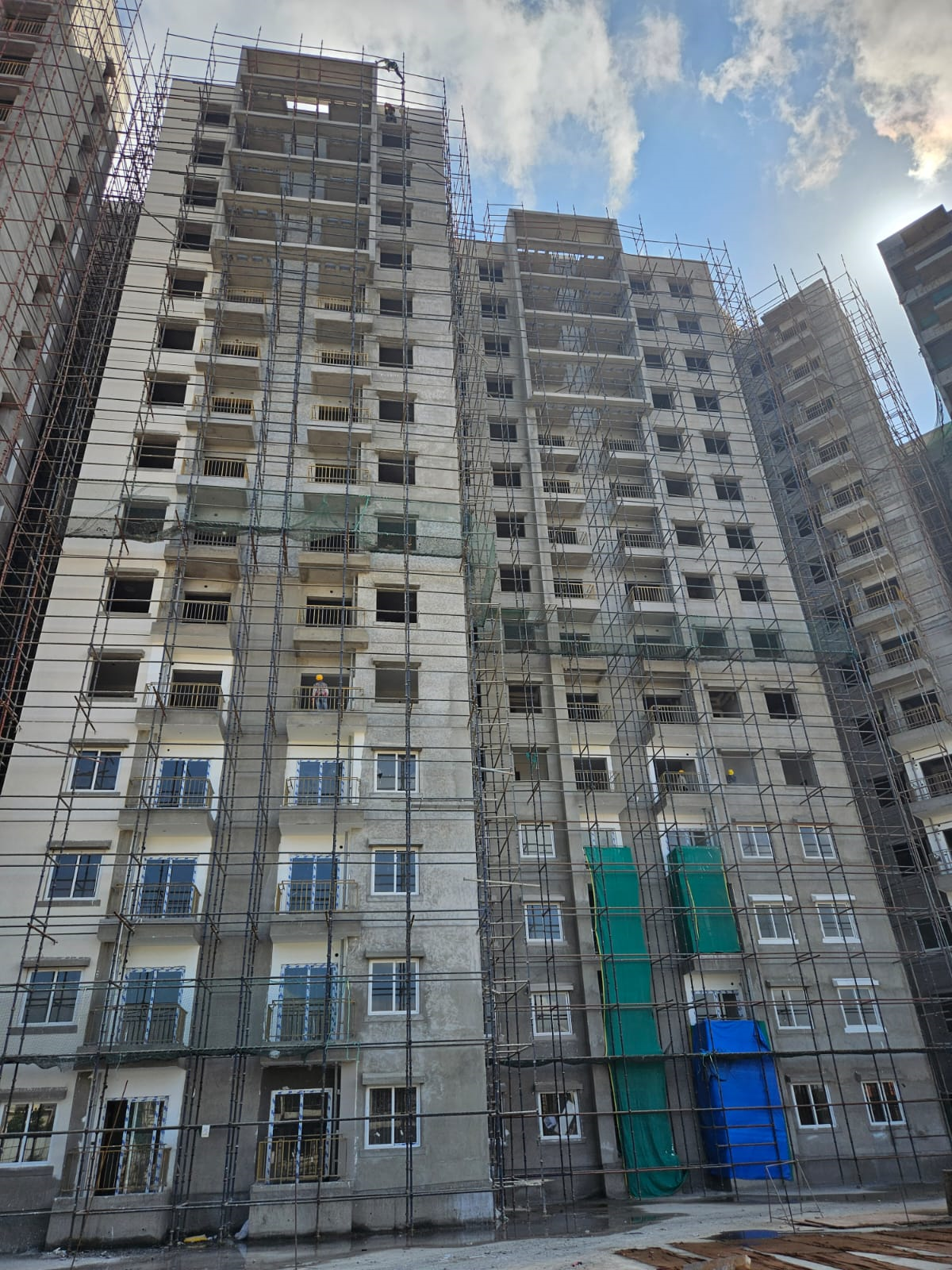

I Block Structure completed - Sep 2024

I Block Structure completed - Sep 2024

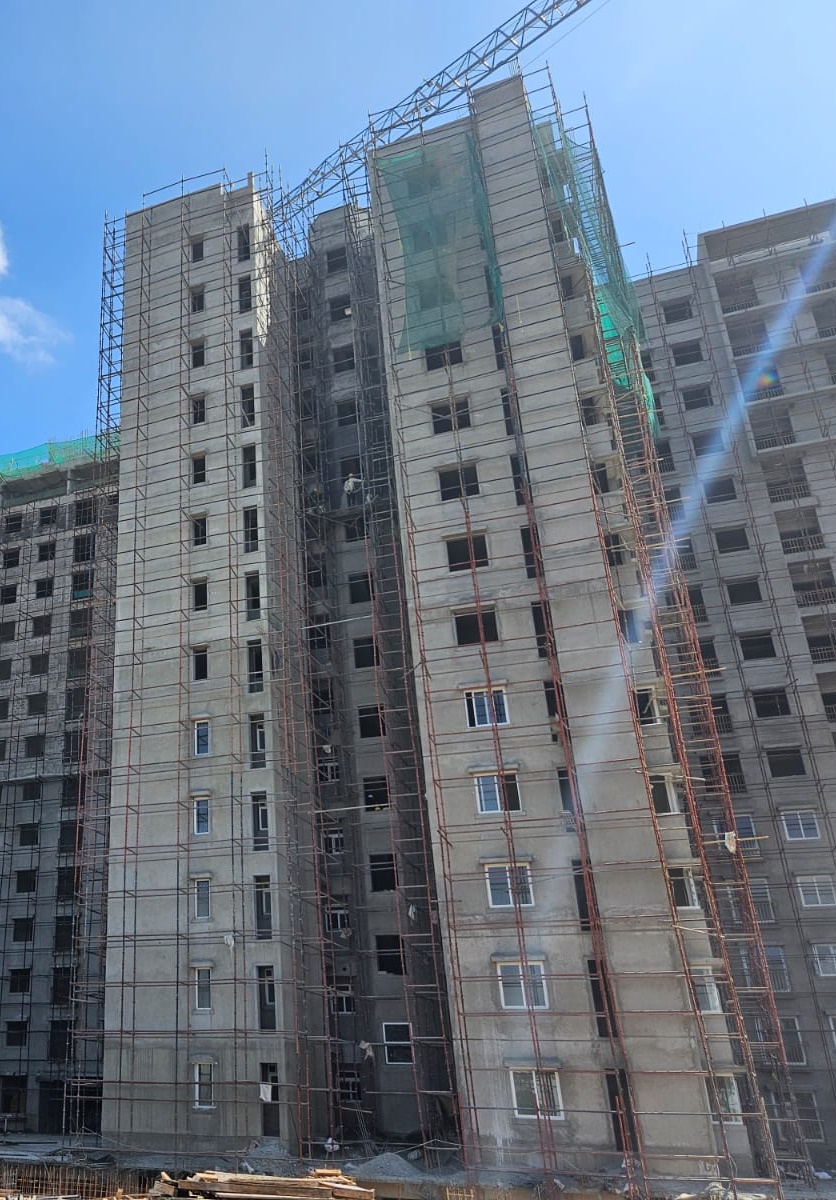

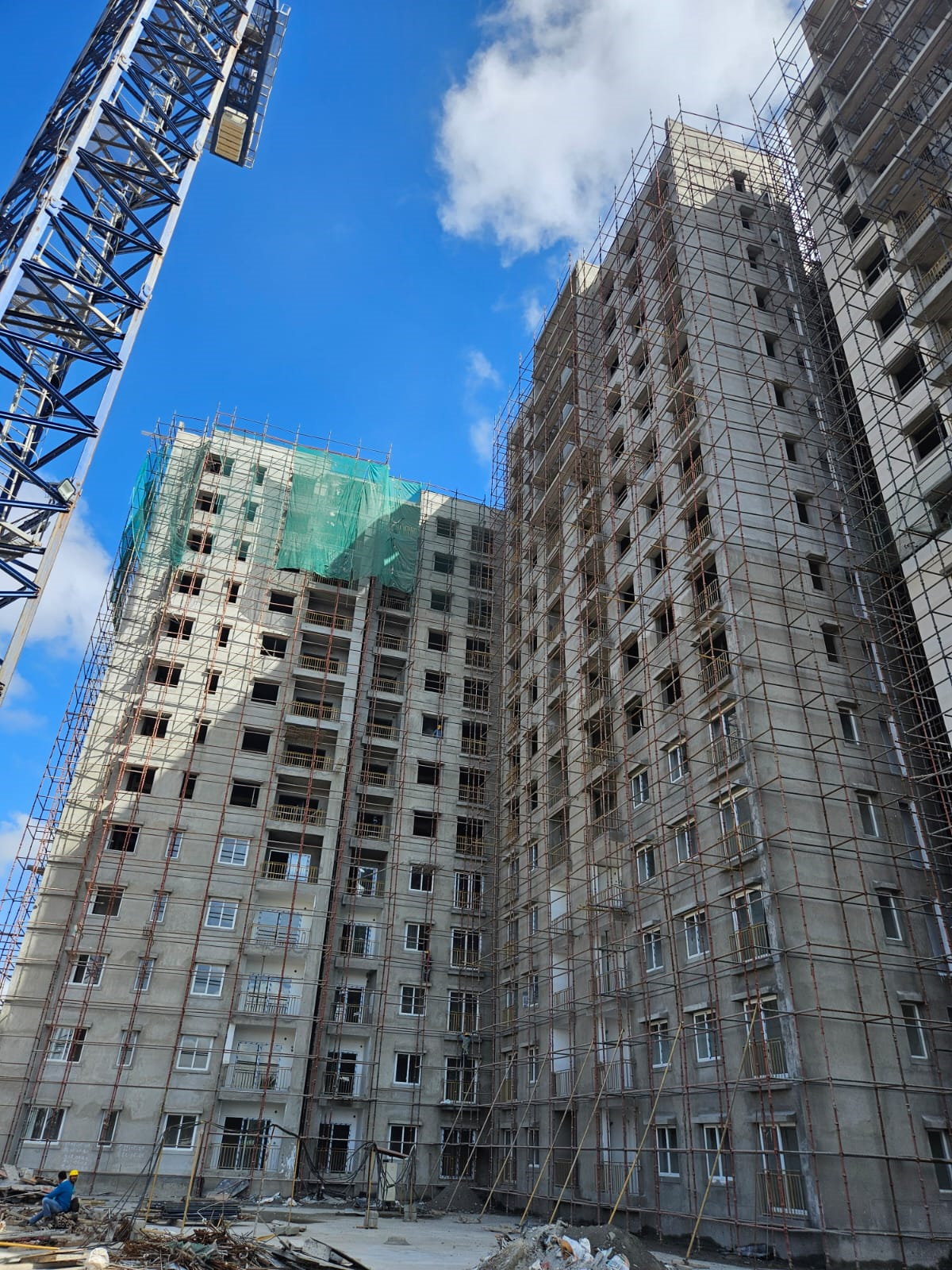

H Block Structure Completed - Sep 2024

H Block Structure Completed - Sep 2024

G Block Structure Completed - Sep 2024

Podium 3 Slab WIP - Sep 2024

K Block 2nd Floor Slab WIP - Sep 2024

Podium 2 Slab WIP - Sep 2024

J Block GF Slab WIP - Sep 2024

L Block 2nd Floor Slab WIP - Sep 2024

Ivory Phase -2 JKL - Sep 2024

Ivory pH-01 g- block: on commencement of flooring (6 to 10F) - Sep 2024

Ivory pH-01 g- block: on commencement of flooring (6 to 10F) - Sep 2024

Ivory pH-01 g- block: on commencement of flooring (6 to 10F) - Sep 2024

Ivory pH-01 g- block: on commencement of flooring (6 to 10F) - Sep 2024

I Block – Milestone Release –“On Installation of Lifts” – Status as on - Aug 2024

Tower G – Milestone Release –“ On Casting of Terrace floor slab” Status as on -31st - Aug 2024

Tower G – Milestone Release –“ On Casting of Terrace floor slab” Status as on -31st - Aug 2024

L BLock 1st Floor Slab WIP (Pour 3,4) - Aug 2024

Clubhouse - WIP - Aug 2024

Clubhouse - WIP - Aug 2024

I Block Structure Completed - Aug 2024

I Block Structure Completed - Aug 2024

H Block Structure Completed - Aug 2024

H Block Structure Completed - Aug 2024

G Block Structure Completed - Aug 2024

G Block Structure Completed - Aug 2024

Ivory Phase -1 GHI - Aug 2024

Ivory Phase -1 GHI - Aug 2024

Tower G – Milestone Release –“ On Casting of Terrace floor slab” Status as on -31st - Aug 2024

Tower G – Milestone Release –“ On Casting of Terrace floor slab” Status as on -31st - Aug 2024

Tower G – Milestone Release –“ On Casting of Terrace floor slab” Status as on -31st - Aug 2024

Ivory Phase -1 JKL - Aug 2024

Podium 3 Slab WIP - Aug 2024

I Block – Milestone Release –“On Installation of Lifts” – Status as on - Aug 2024

L Block – Milestone Release –“ On Casting of Ground Floor Slab” – Status as on 30th - Aug 2024

Tower H – Milestone Release – “On Installation of Lifts” – Status as on - Aug 2024

Tower H – Milestone Release – “On Installation of Lifts” – Status as on - Aug 2024

J Block GF Slab WIP - Aug 2024

Podium 2 Slab WIP - Aug 2024

K Block 1st Floor Shuttering WIP - Aug 2024

K Block GF Floor Shuttering WIP - Aug 2024

Clubhouse WIP - Jul 2024

Clubhouse WIP - Jul 2024

I Block Structure Completed - Jul 2024

H Block Structure Completed - Jul 2024

H Block Structure Completed - Jul 2024

G Block 14th Floor Completed - Jul 2024

Ivory Phase 1 GHI - Jul 2024

J Block GF Slab WIP - Jul 2024

L BLock GF Slab WIP (Pour 3,5) - Jul 2024

K Block 1st Floor Shuttering WIP - Jul 2024

Podium 3 Slab and Footing WIP - Jul 2024

Ivory Phase -2 JKL - Jul 2024

Tower G – Milestone Release –“On Commencement of Painting - GF to 5th Floor – Status as on 14th - Jul 2024

Tower G – Milestone Release –“On Commencement of Painting - GF to 5th Floor – Status as on 14th - Jul 2024

L Block 1st Floor Shuttering WIP - Jul 2024

Podium 2 Slab WIP - Jul 2024

Ivory Ph-01 G- BLOCK: Commencement of fixing of Doors & Windows G - 5F. - Jul 2024

Ivory Ph-01 G- BLOCK: Commencement of fixing of Doors & Windows G - 5F. - Jul 2024

Ivory Ph-01 G- BLOCK: Commencement of fixing of Doors & Windows .G - 5F. - Jul 2024

Ivory Ph-01 G- BLOCK: Commencement of fixing of Doors & Windows .G - 5F. - Jul 2024

Ivory Ph-01 H - BLOCK 6th Floor Tile works Started - Jul 2024

Ivory Ph-01 H - BLOCK 6th Floor Tile works Started - Jul 2024

Ivory Ph-01 H - BLOCK 6th Floor Tile works Started - Jul 2024

Ivory Ph-01 H - BLOCK 6th Floor Tile works Started - Jul 2024

Ivory Ph-01 I- BLOCK 6thFloor Painting works Started - Jul 2024

Ivory Ph-01 I- BLOCK 6thFloor Painting works Started - Jul 2024

Ivory Ph-01 I- BLOCK 6thFloor Tile works Started - Jul 2024

Ivory Ph-01 I- BLOCK 6thFloor Painting works Started - Jul 2024

G Block 12th floor completed - Jun 2024

G Block 12th floor completed - Jun 2024

L BLOCK 1st FLOOR SHUTTERING WIP - Jun 2024

J BLOCK SLAB AND COLUMN WIP - Jun 2024

K BLOCK GF SLAB WIP (Pour 1,2,3) - Jun 2024

L BLOCK GF SLAB WIP (POUR 1,2,4) - Jun 2024

Ivory Phase -2 JKL - Jun 2024

I Block Structure completed - Jun 2024

Clubhouse WIP - Jun 2024

Clubhouse WIP - Jun 2024

I Block Structure completed - Jun 2024

H Block Structure completed - Jun 2024

H Block Structure completed - Jun 2024

Phase 1 – Tower G – Milestone Release –“On Commencement of Painting - GF to 5th Floor – Status as on 14th - Jun 2024

Phase 1 – Tower G – Milestone Release –“On Commencement of Painting - GF to 5th Floor – Status as on 14th - Jun 2024

Tower J – Milestone Release – “On Casting of raft/footing” – Status as on 03.06.2024.

Tower J – Milestone Release – “On Casting of raft/footing” – Status as on 03.06.2024.

Tower J – Milestone Release – “On Casting of raft/footing” – Status as on 03.06.2024.

Ivory Phase -1 GHI - May 2024

Ivory Phase -1 GHI - May 2024

Clubhouse WIP - May 2024

I Block Structure completed - May 2024

H Block Structure completed - May 2024

G Block Pour 1,2,3, 11th floor concrete completed - May 2024

May 2024 - Tower G - Milestone Release On Casting of Tenth floor slab

J BLOCK FOOTING AND COLUMN WIP - May 2024

Ivory Phase -2 JKL - May 2024

May 2024 - Brigade Ivory Phase 2: Tower K – Milestone Release – On Casting of Footing/raft

Apr 2024 - Tower L Milestone Release On Casting of Footing/raft

Apr 2024 - Retaining Wall Waterproofing WIP

Apr 2024 - West Side Retaining Wall WIP

Apr 2024 - Block J - Footing and Column WIP

Apr 2024 - Block K - Slab Shuttering WIP

Apr 2024 - Block L - Slab Shuttering WIP

Apr 2024 - JKL

Apr 2024 - GHI

Apr 2024 - Tower L Milestone Release On Casting of Footing/raft

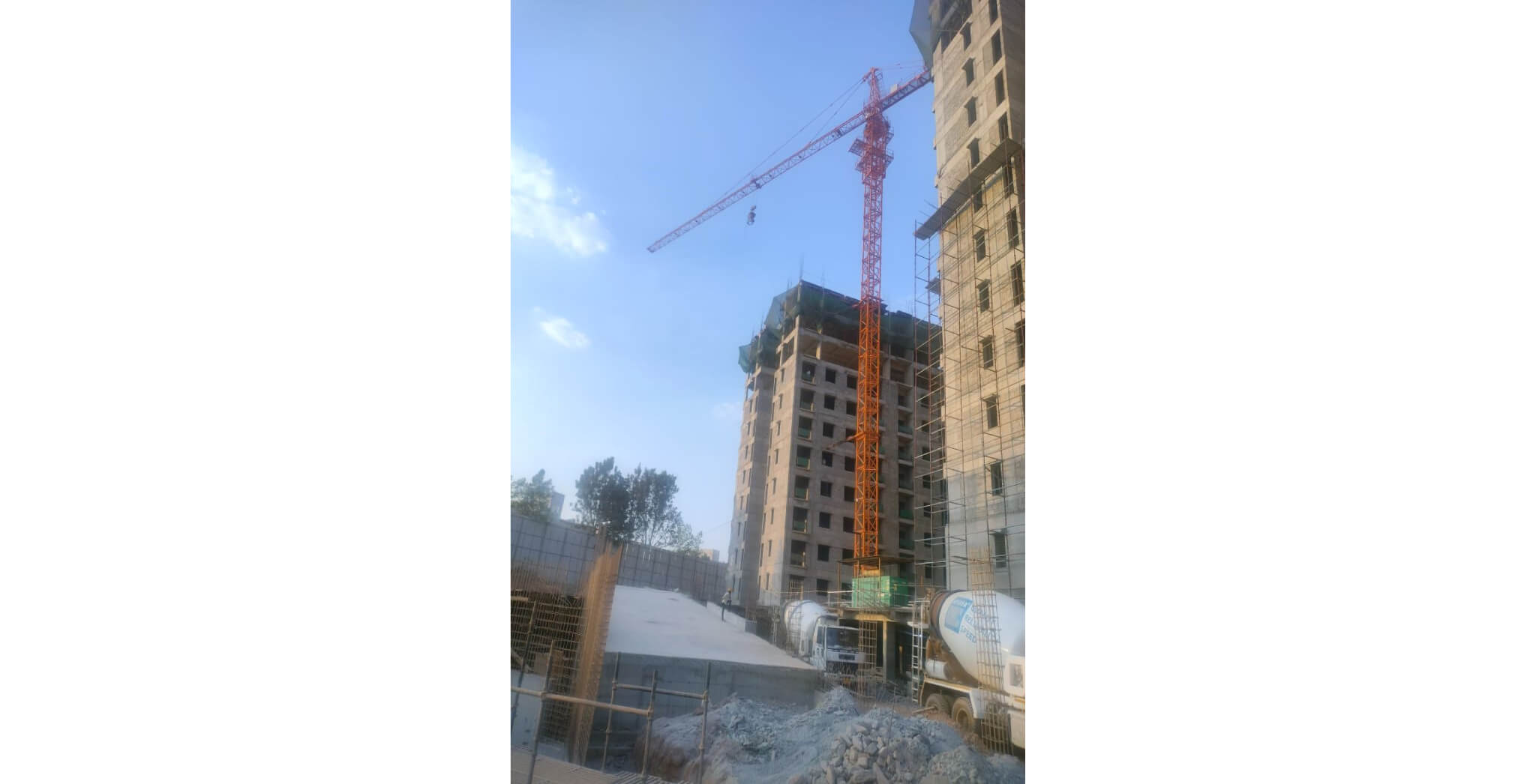

Mar 2024 - G Block Pour 5, 10th floor Getting ready for concrete

Mar 2024 - GHI

Mar 2024 - H Block pour 1, 14th floor

Mar 2024 - I BLOCK 14TH FLOOR WIP

Mar 2024 - J Block lift pit waterproofing WIP

Mar 2024 - J Block footing WIP

Mar 2024 - Retaining wall waterproofing WIP

Mar 2024 - J Block column WIP

Mar 2024 - JKL

Mar 2024 - K Block slab shuttering WIP

Mar 2024 - K Block column 2nd lift WIP

Mar 2024 - L Block slab shuttering WIP (Pour 1)

Mar 2024 - L Block column 2nd lift shuttering WIP

Mar 2024 - CLUBHOUSE WIP

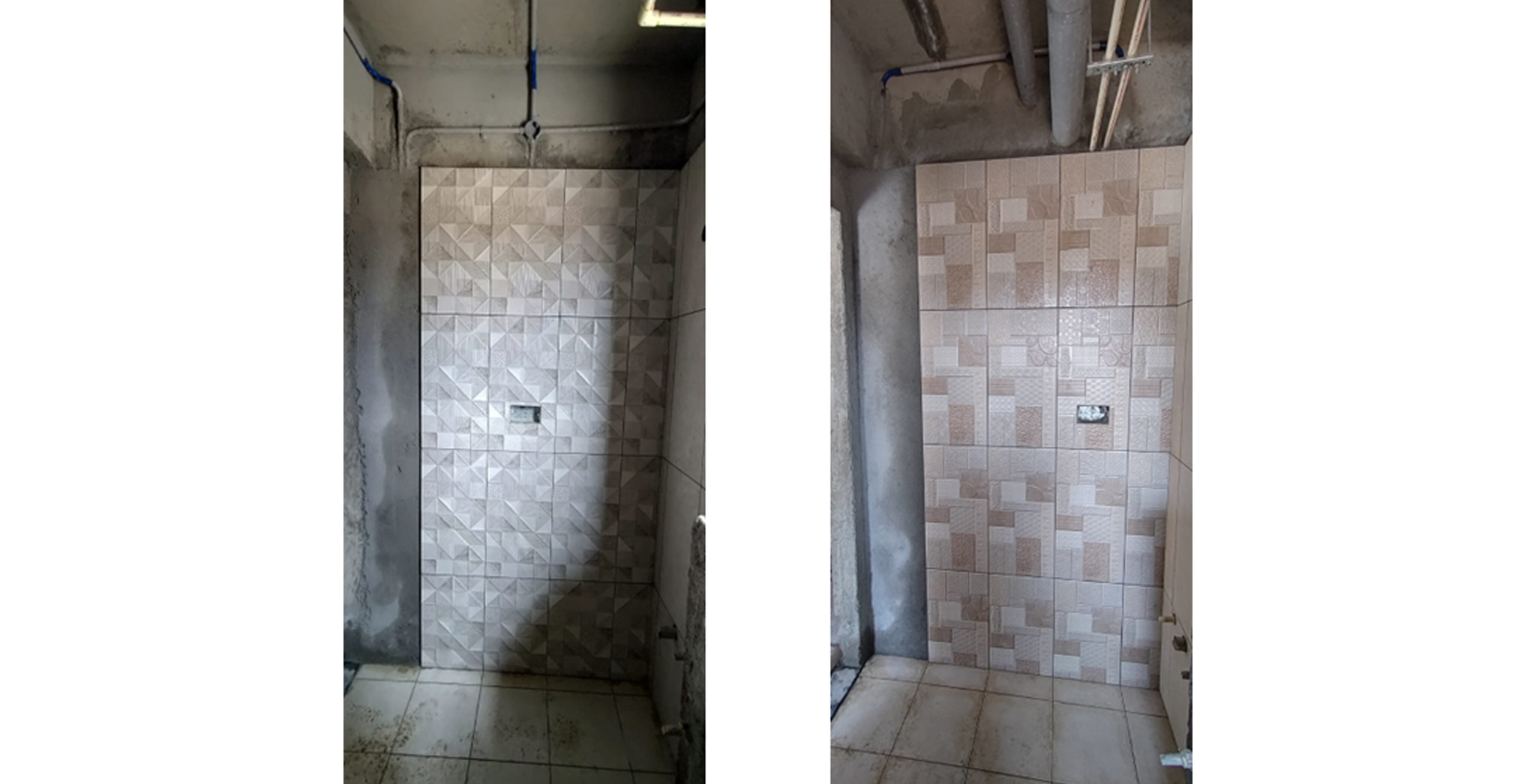

Feb 2024 - Brigade Orchards Ivory Tower H: Milestone Release On Commencement of Flooring (GF to 5th Floor)

Feb 2024 - Brigade Ivory Phase 1: Block G - Pour 3, 10th Floor Getting Ready for Concrete

Feb 2024 - Brigade Ivory Phase 1: I Block 13th Floor WIP

Feb 2024 - Brigade Ivory Phase 2: Block J - Footing WIP

Feb 2024 - Brigade Ivory Phase 2: Block K - Footing WIP

Feb 2024 - Brigade Ivory Phase 2: Block L - Slab Shuttering WIP (Pour 1)

Feb 2024 - Brigade Ivory Phase 2: Block L - Column 2nd Lift Shuttering WIP

Feb 2024 - Brigade Ivory Phase 2: Retaining Wall WIP

Feb 2024 - Brigade Ivory Phase 2: Block K - Column 2nd Lift WIP

Feb 2024 - Brigade Ivory Phase 1: Tower H (GHI) - Milestone Release On Commencement of Painting Ground to 5th Floor

Feb 2024 - Brigade Ivory Phase 1: Clubhouse WIP

Brigade Orchards Ivory Tower H: Milestone Release On Commencement of Flooring (GF to 5th Floor) - Feb 2023
Frequently Asked Questions
Ivory Phase 2 at Brigade Orchards offers 1, 1.5, 2 and 3 BHK apartments.
Here’s a lowdown of the floor plans of the Phase 2 residential units:
Super Built-Up Area:
1 BHK: 46.87 - 57.96 Sq.m (505 - 624 Sq.ft.)
1.5 BHK: 70.97 - 71.69 Sq.m (764 - 771.66 Sq.ft.)
2 BHK: 81.59 - 88.04 Sq.m (878 - 948 Sq.ft.)
3 BHK: 105.12 - 124.32 Sq.m (1131 - 1338.16 Sq.ft.)
Carpet Area:
1 BHK: 31.00 - 33.71 Sq.m (333.68 - 362.85 Sq.ft.)
1.5 BHK: 42.00 - 42.50 Sq.m (452.08 - 457.46 Sq.ft.)
2 BHK: 51.36 - 58.46 Sq.m (51.36 - 629.25 Sq.ft.)
3 BHK: 69.40 - 82.52 Sq.m (747.01 - 888.23 Sq.ft.)
Ivory Phase 2 at Brigade Orchards is one of the highest-rated smart townships in India and one of the first smart-tech-enabled homes set in popular Devanahalli. The residential complex is just 20 minutes from Bengaluru International Airport.
RERA NUMBERS
Ivory Phase 1: PRM/KA/RERA/1250/303/PR/220104/004626
Ivory Phase 2: PRM/KA/RERA/1250/303/PR/151223/006485
